Project Details
Land Number
1431
Region
The Area 29, El Sadat City
HOMEi Price
8,500.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 15% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
195 m²
Delivery
Unit Delivery Date
March 2027
Average Unit Price
1,174,500 EGP
Project Location
Map View
The Area 29, El Sadat City
HOMEi Timeline
License office contract
June 25, 2025
Submitting the license
August 12, 2025

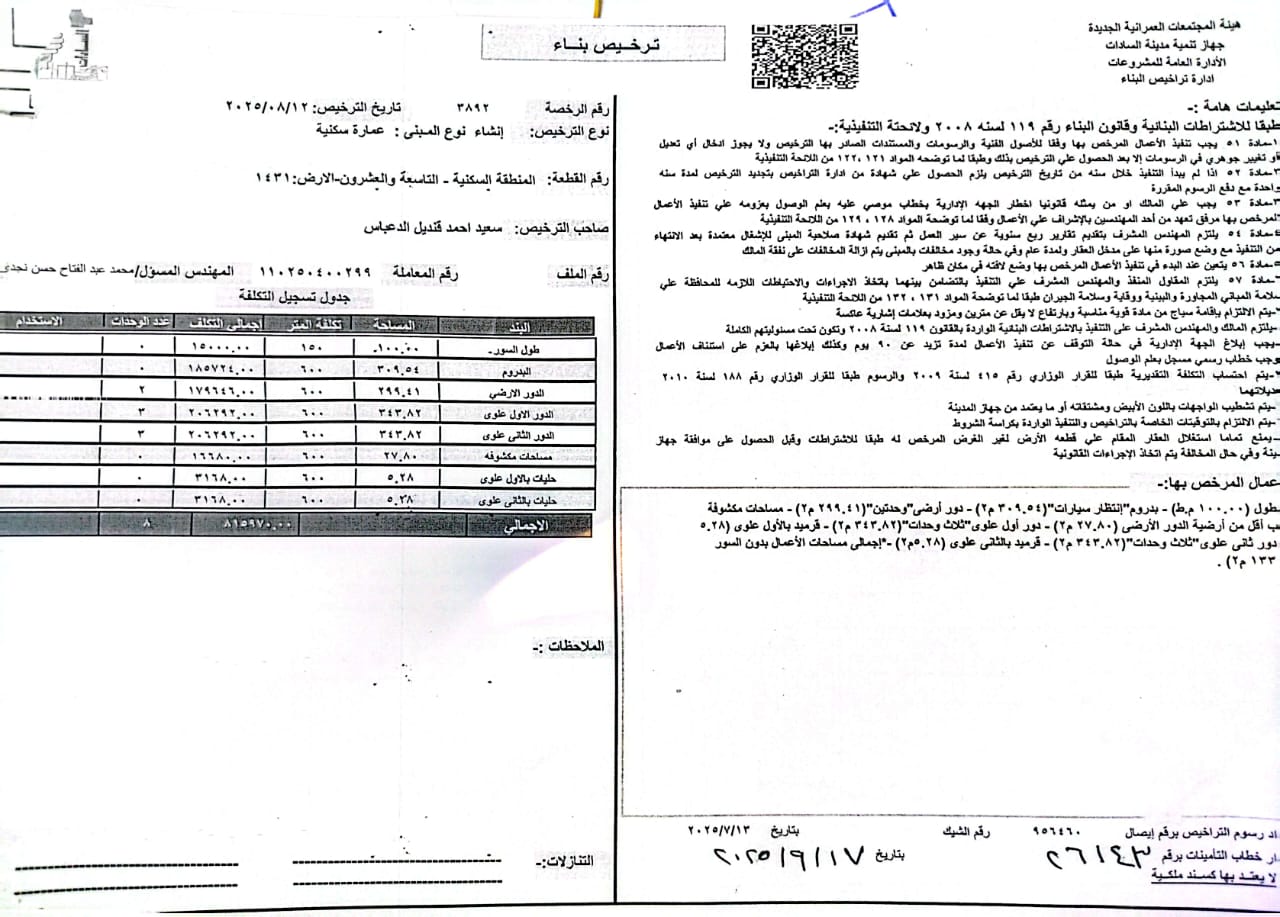

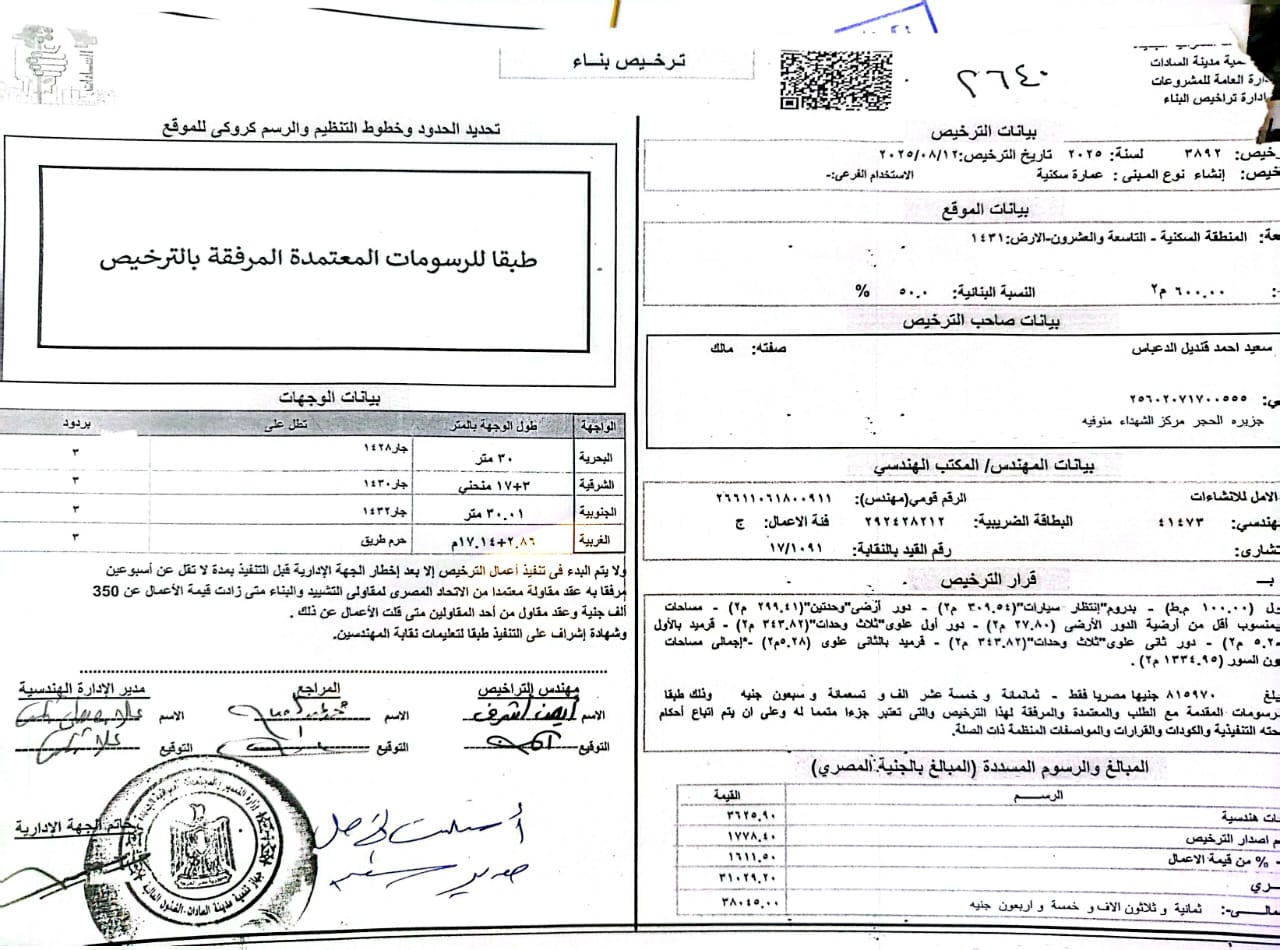

Receiving the license
August 12, 2025

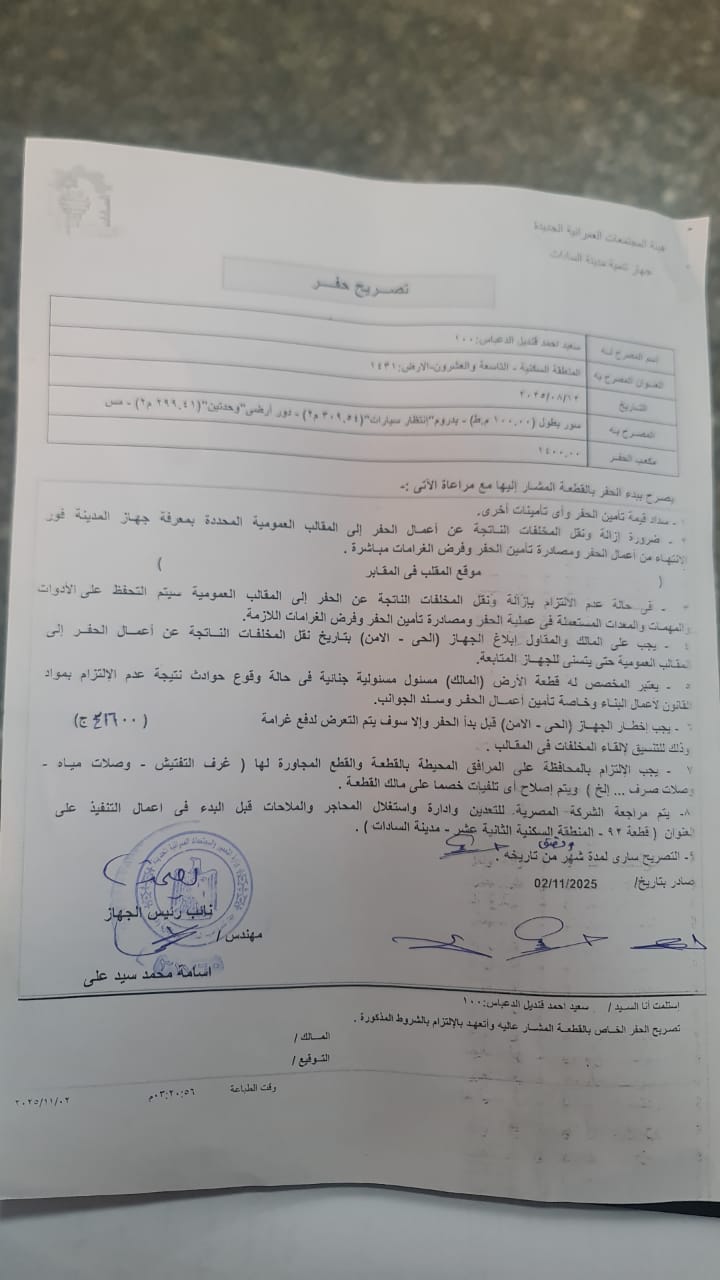

Excavation permit
October 1, 2025

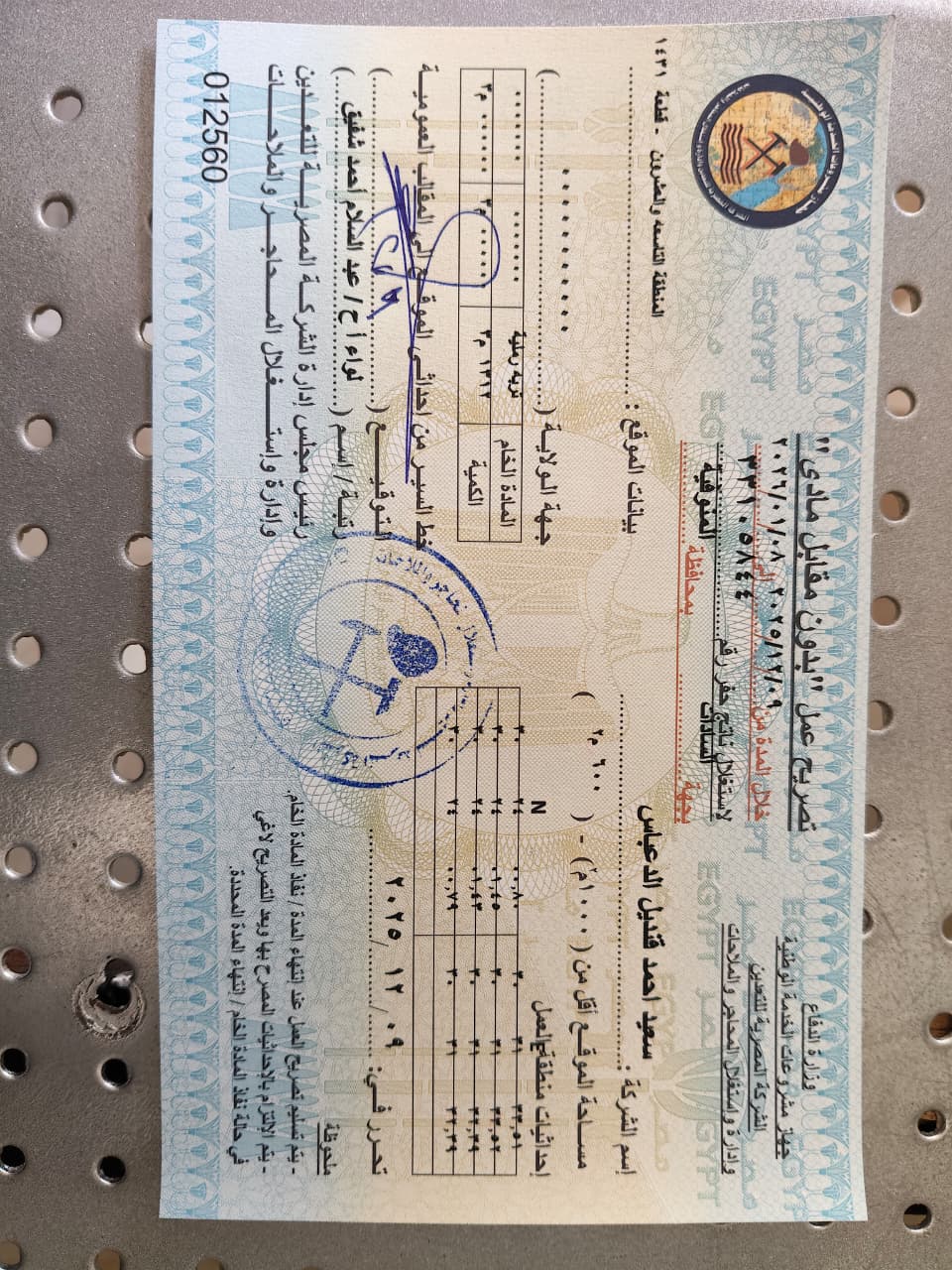

Mining permit
October 4, 2025
Construction contract in progress
October 5, 2025
Construction contract signed
October 6, 2025

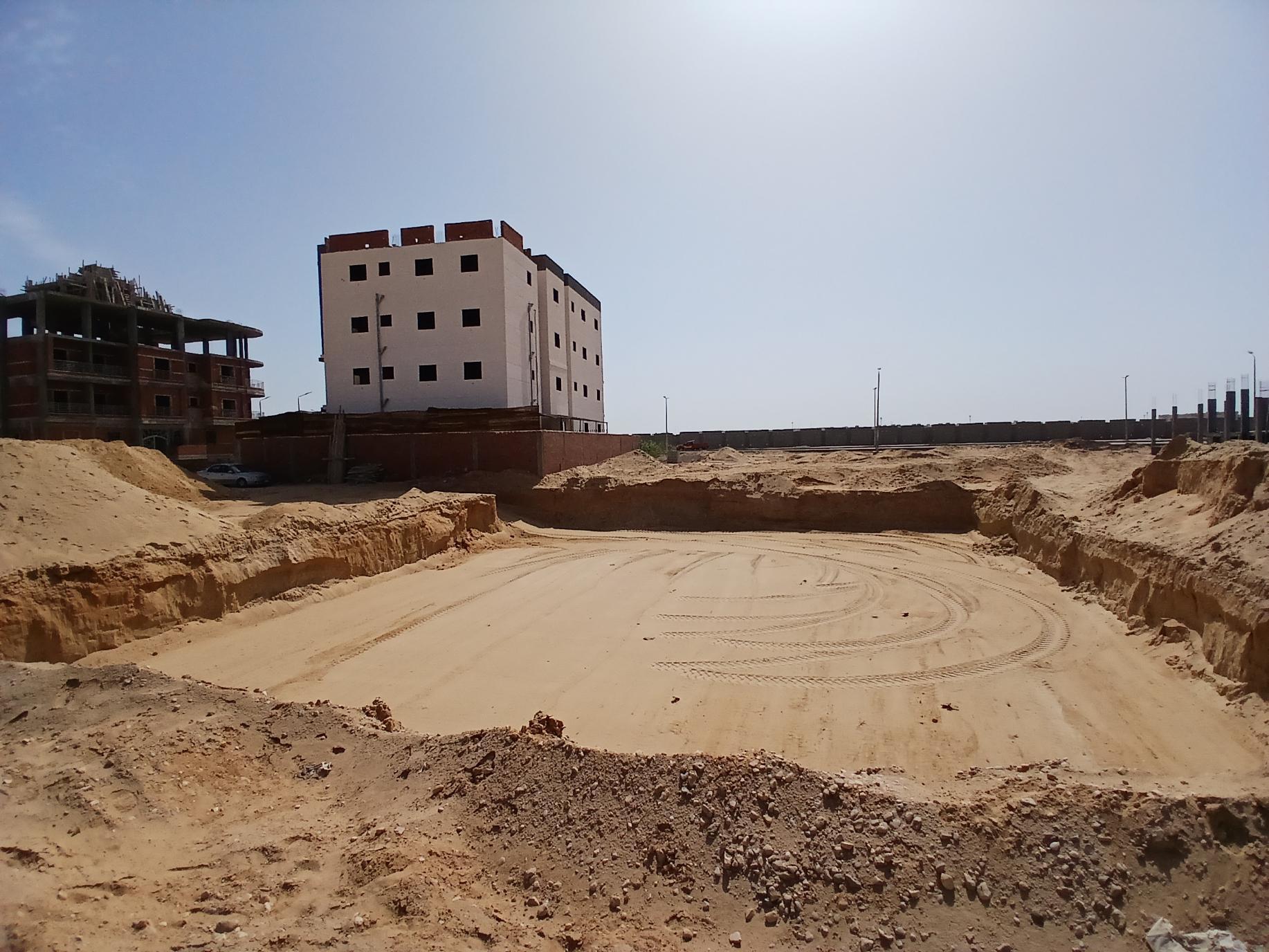

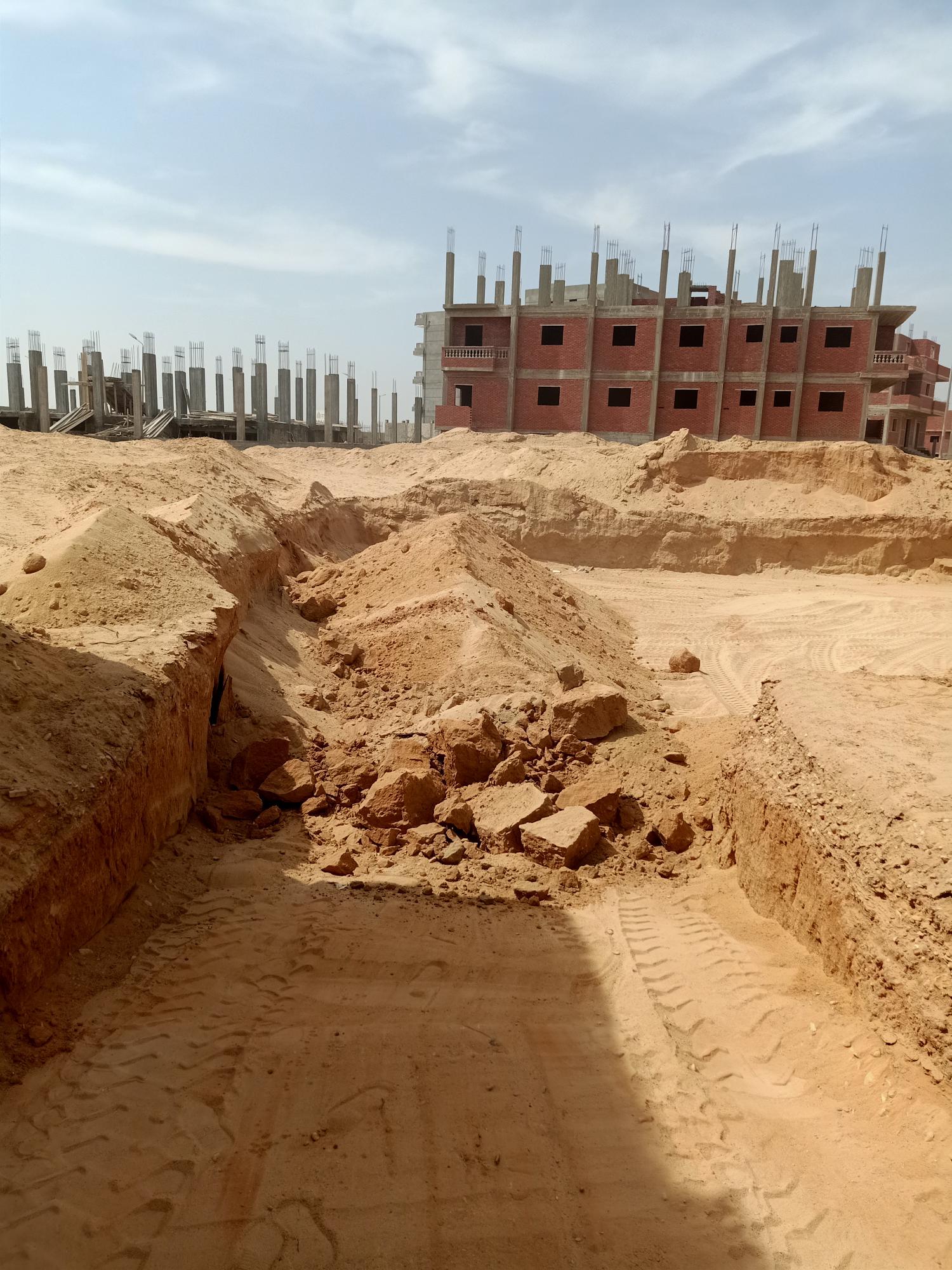

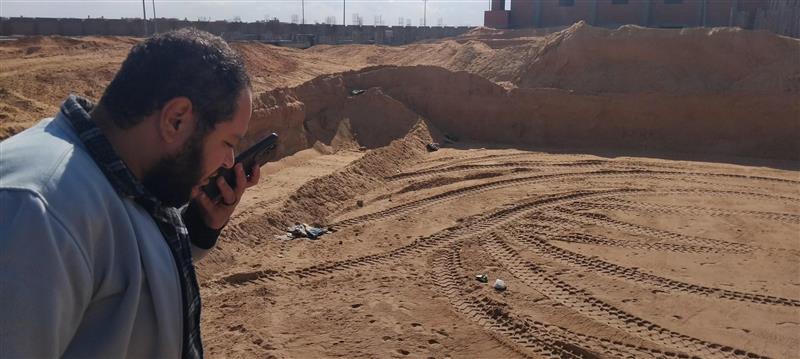

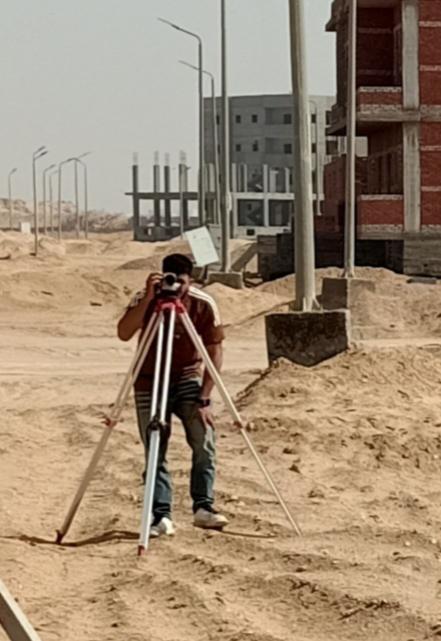

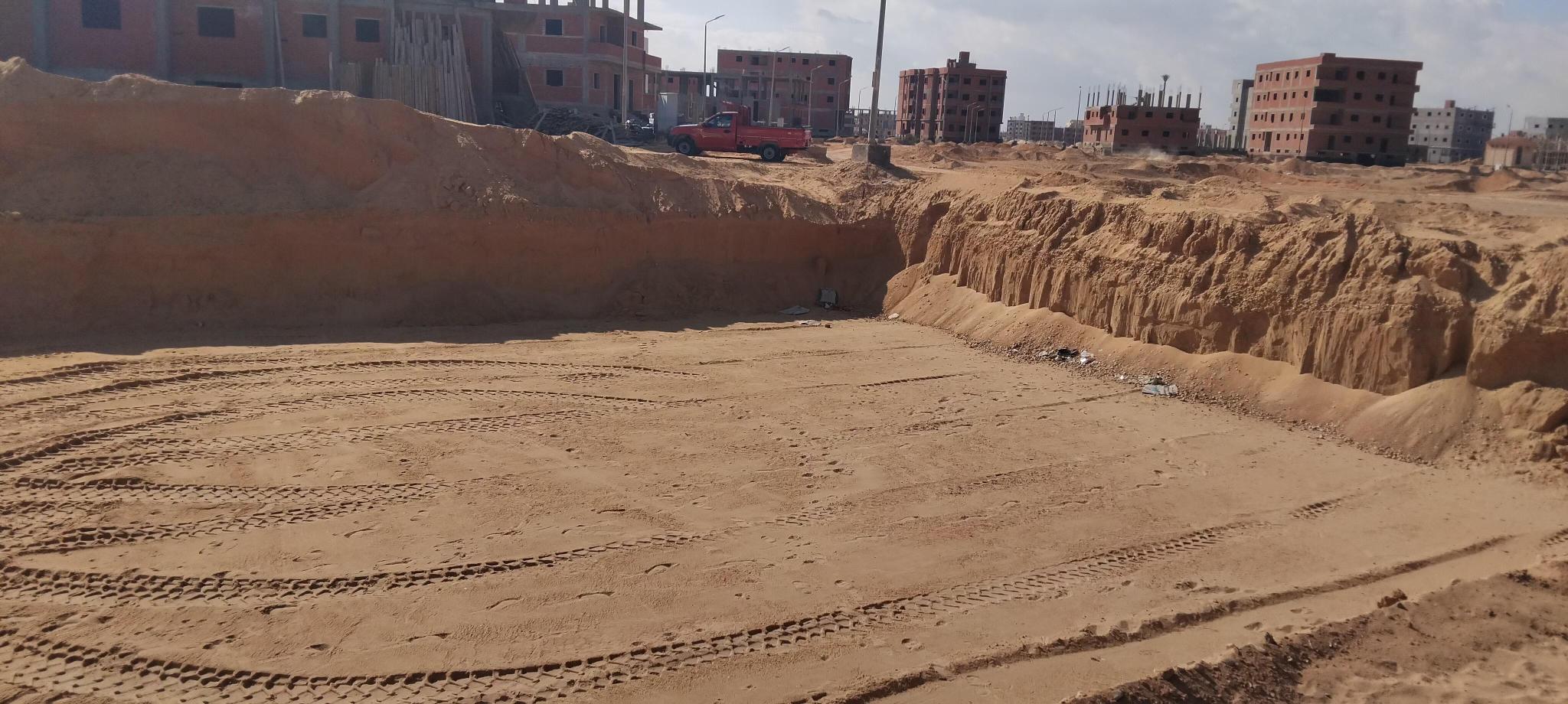

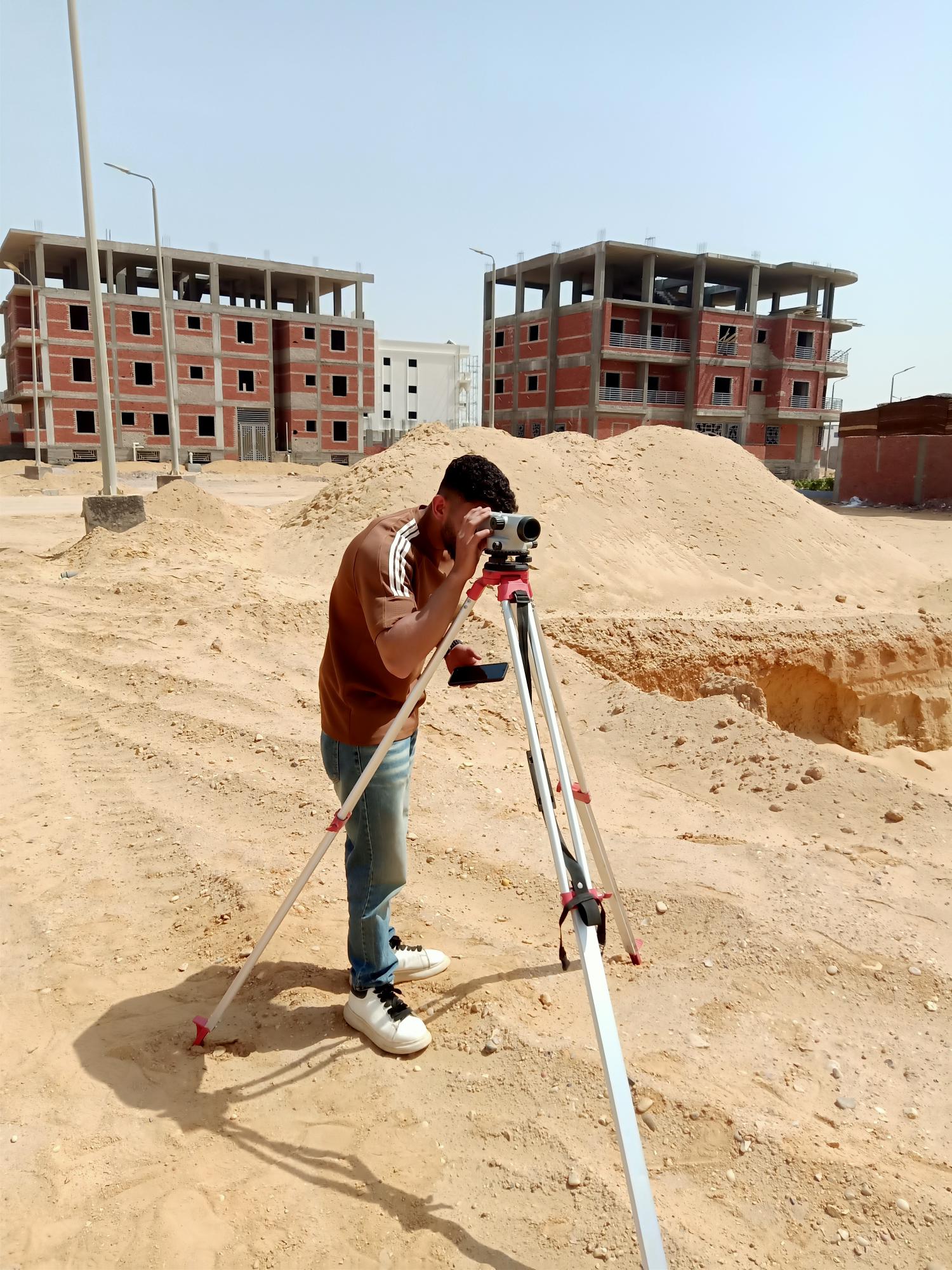

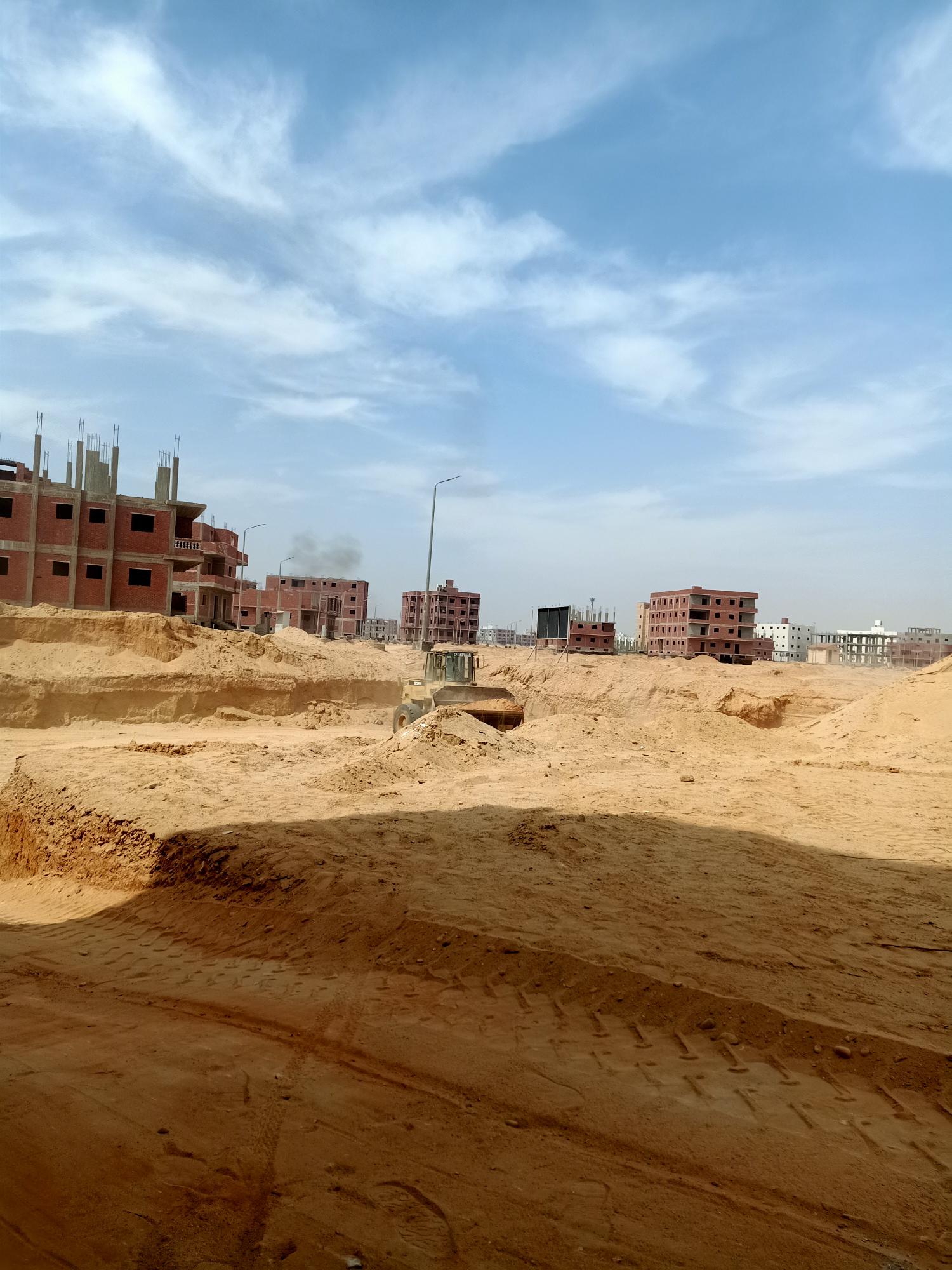

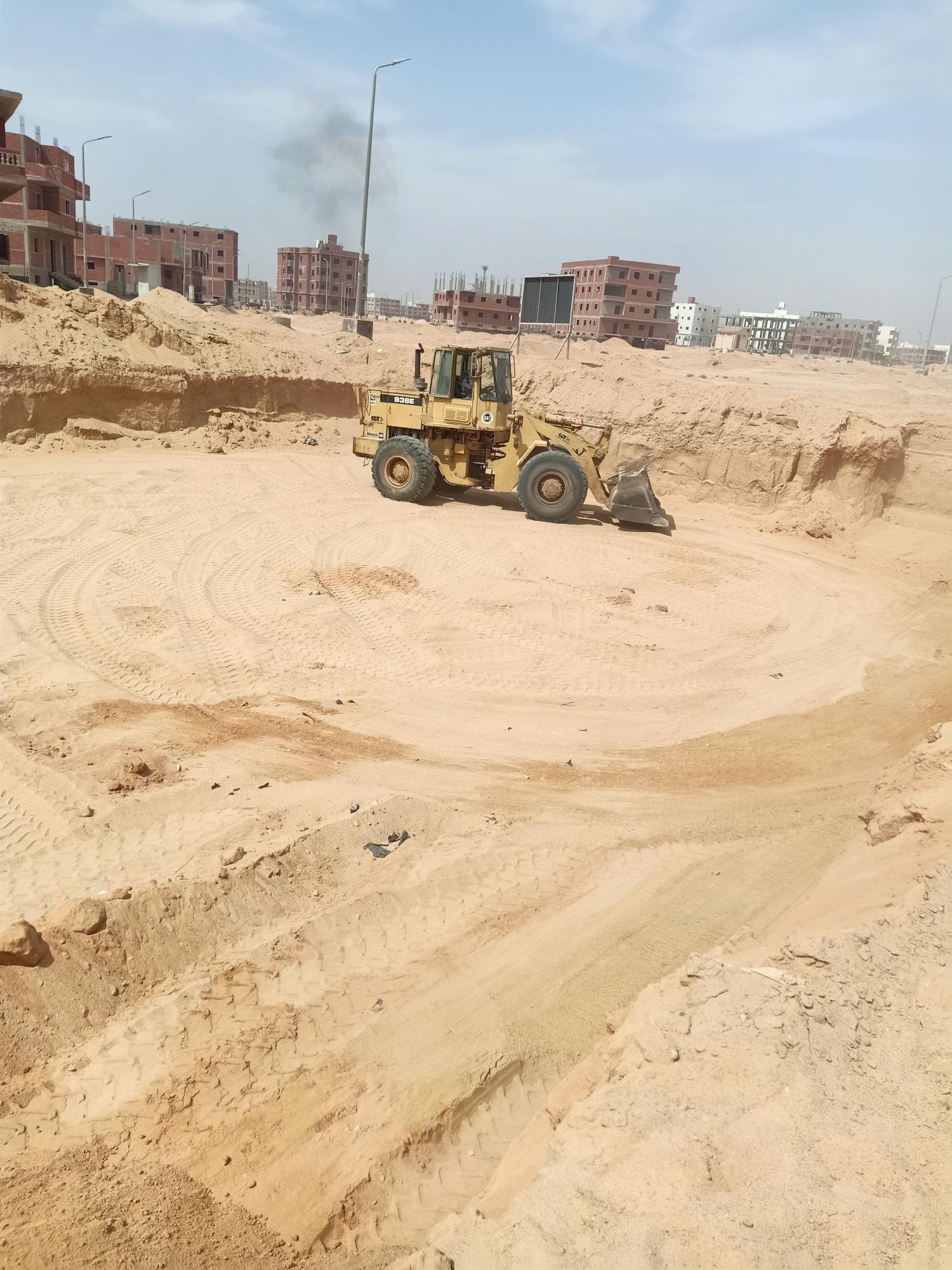

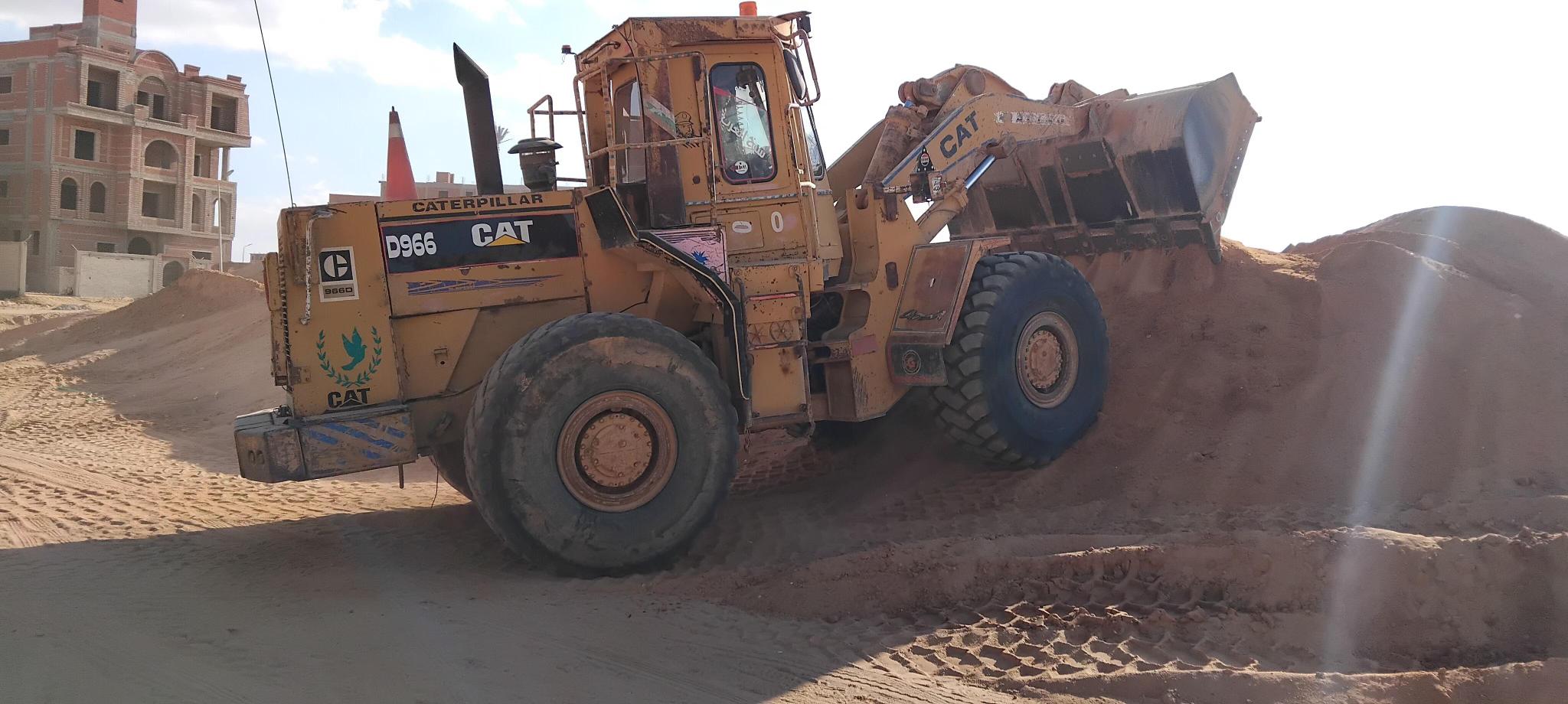

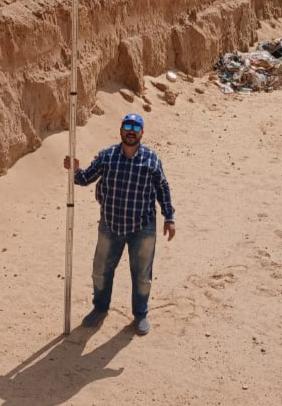

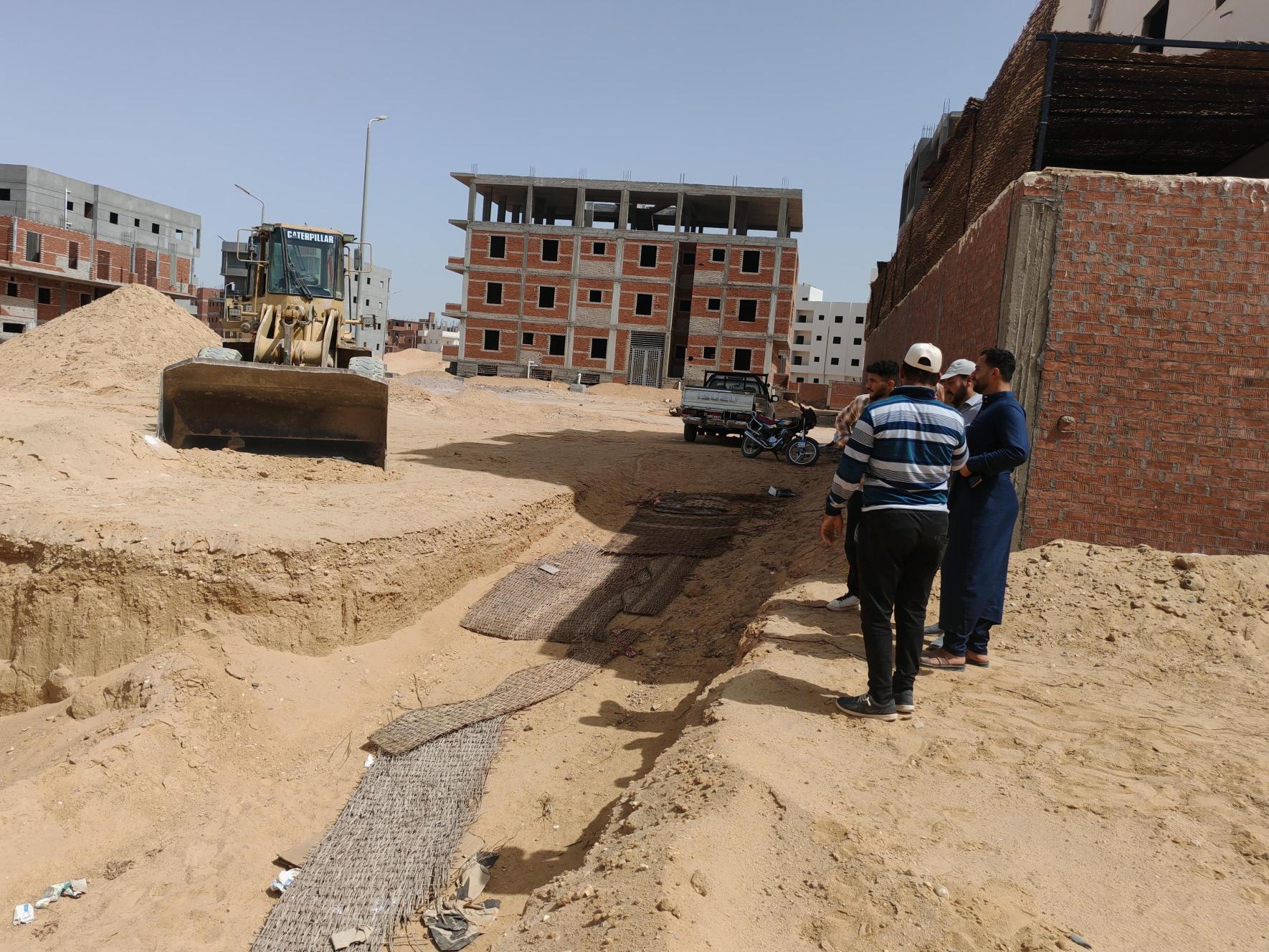

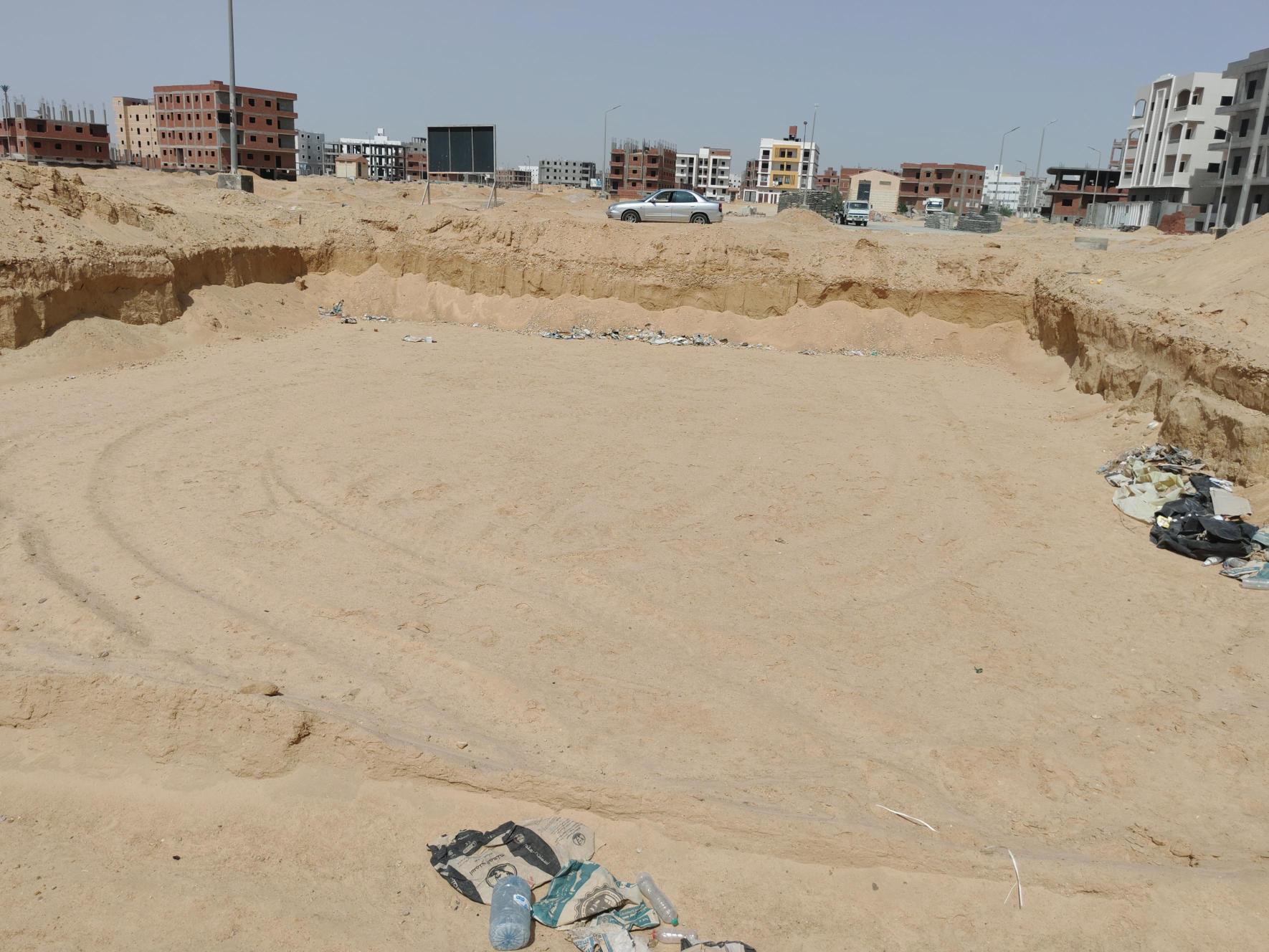

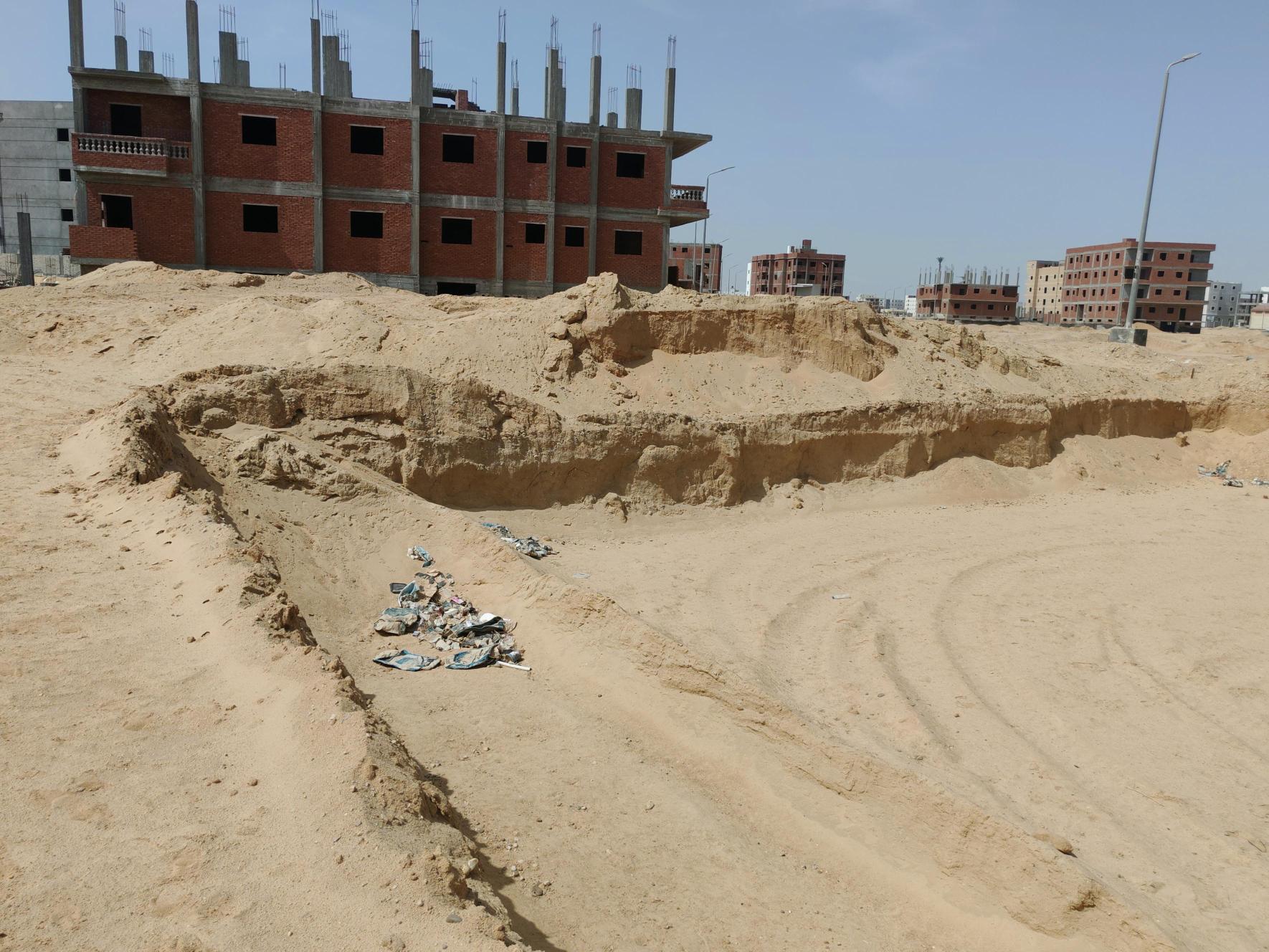

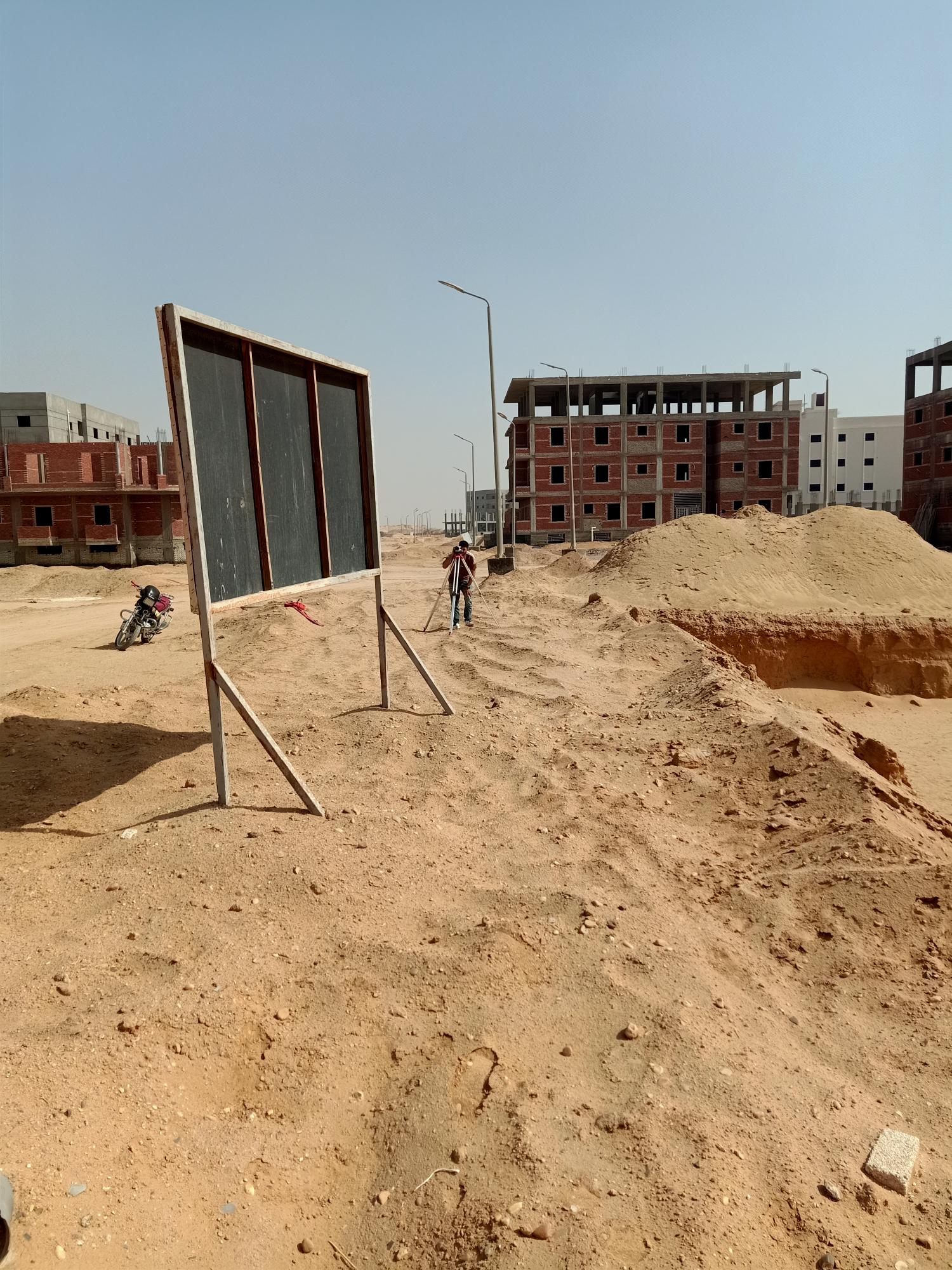

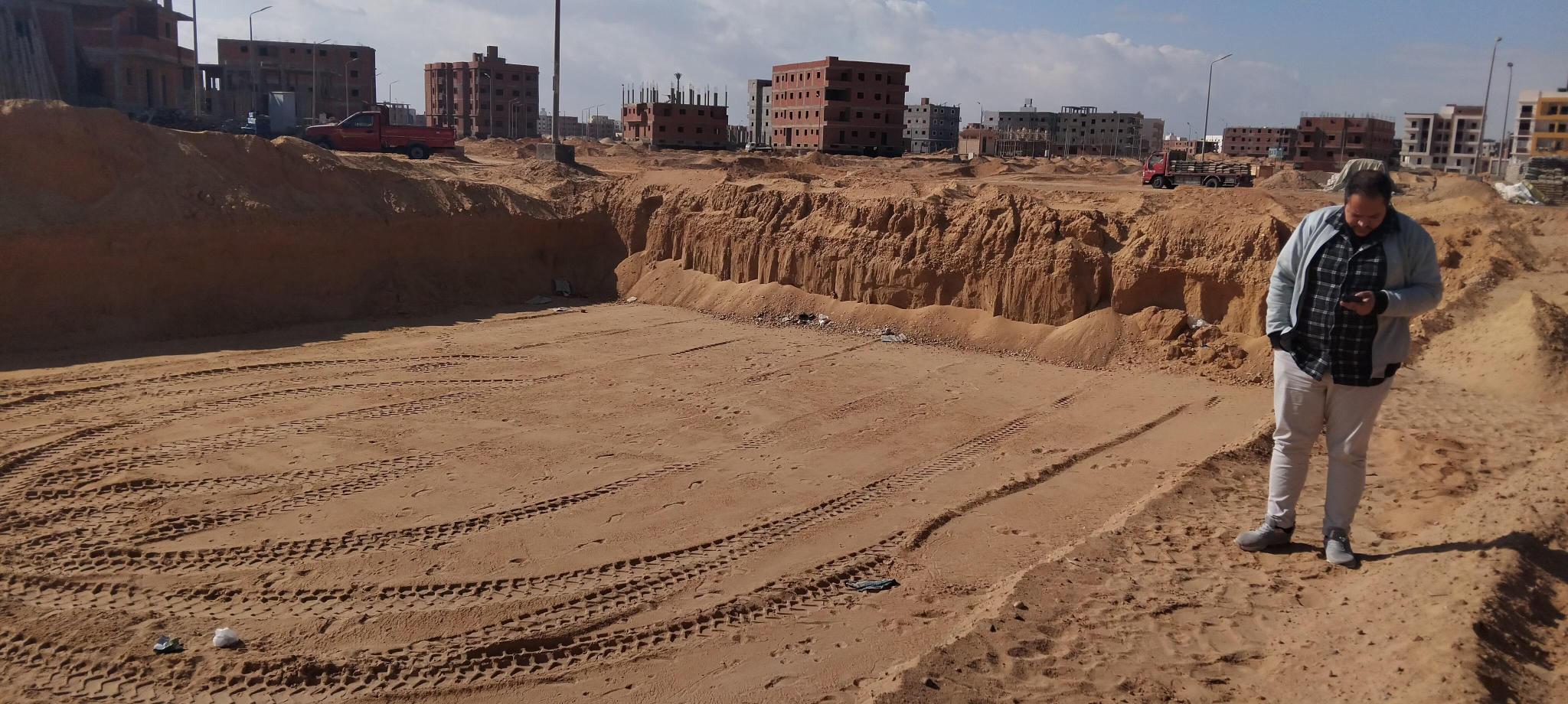

Excavation
December 15, 2025

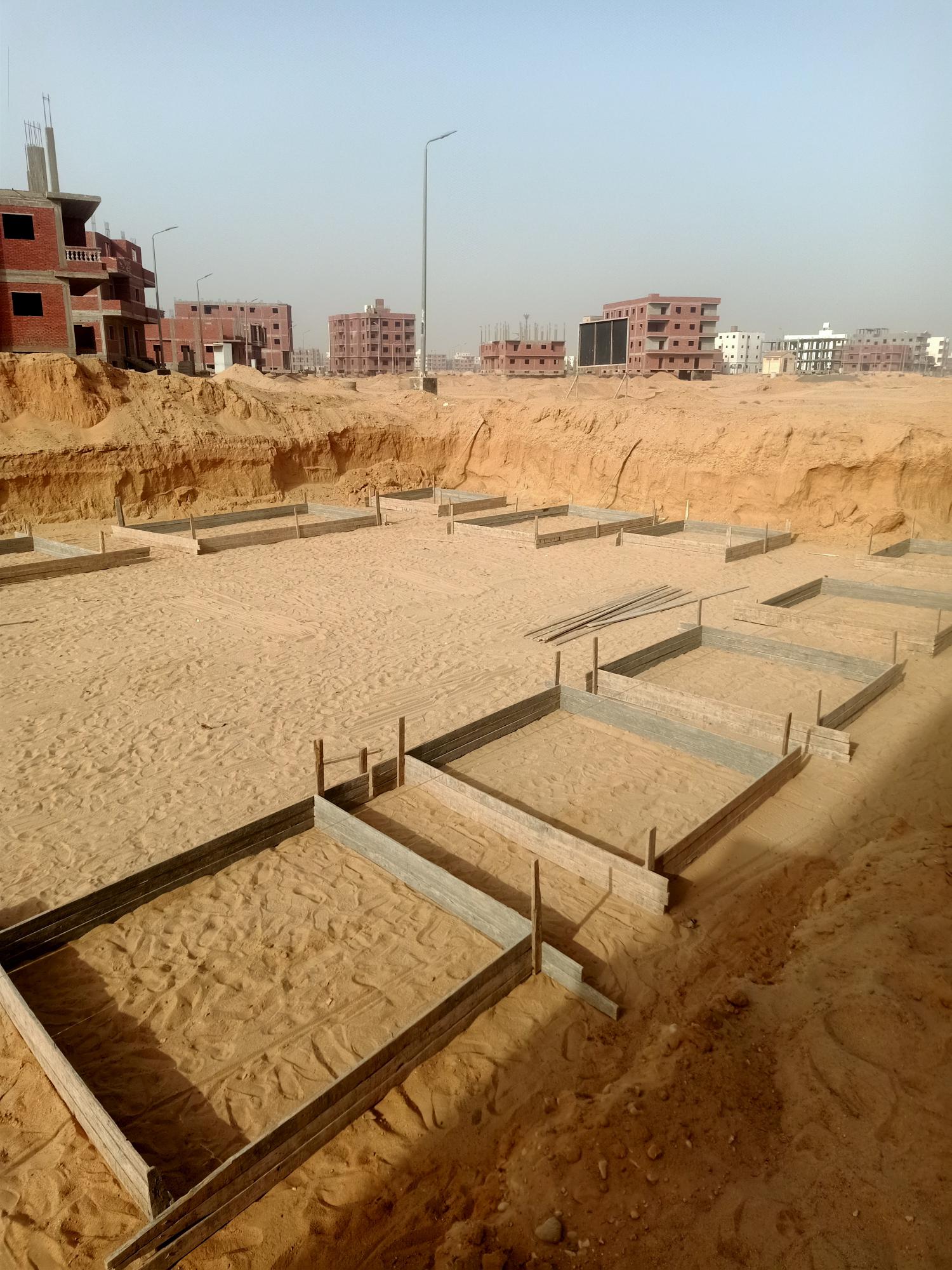

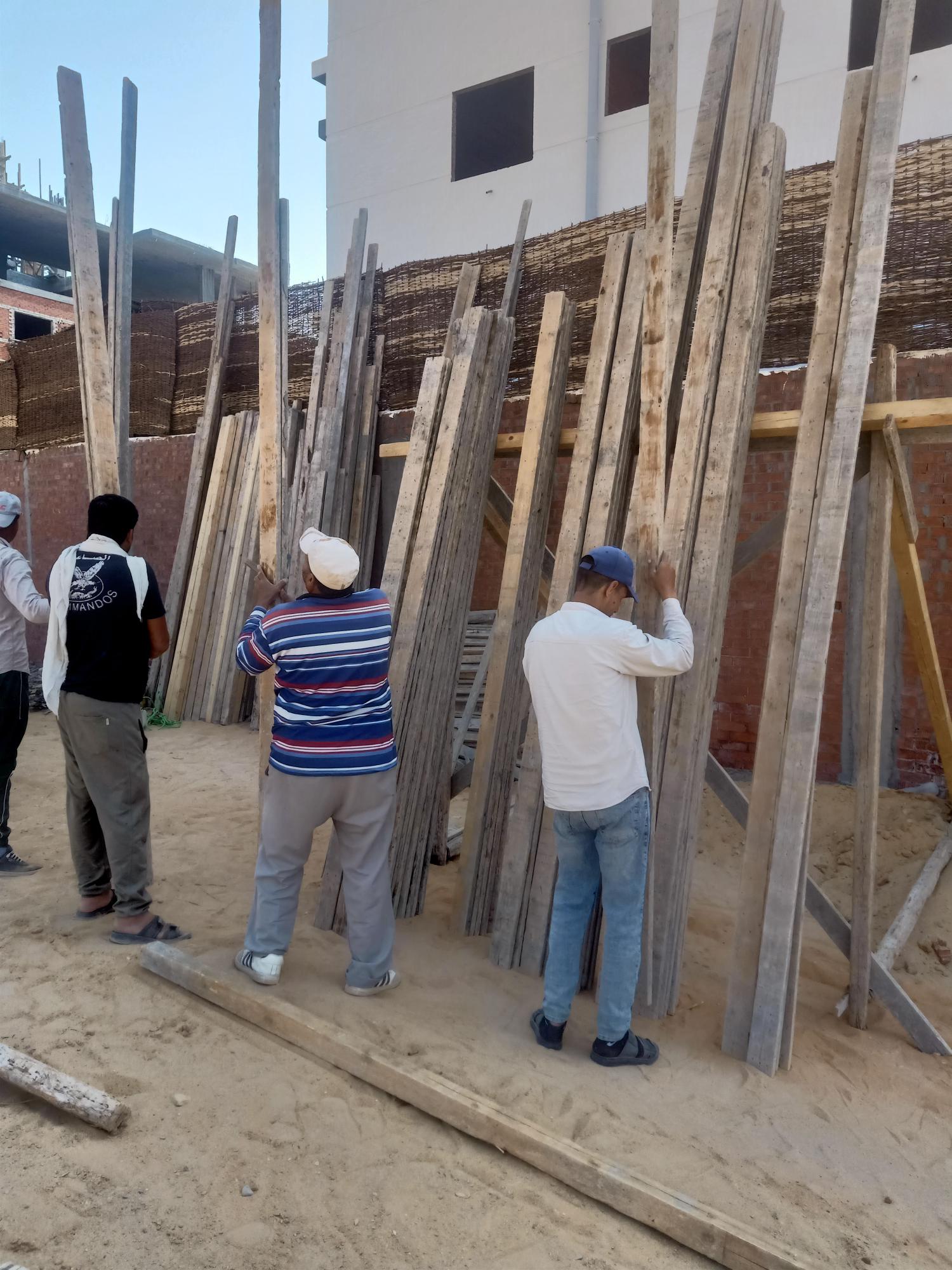

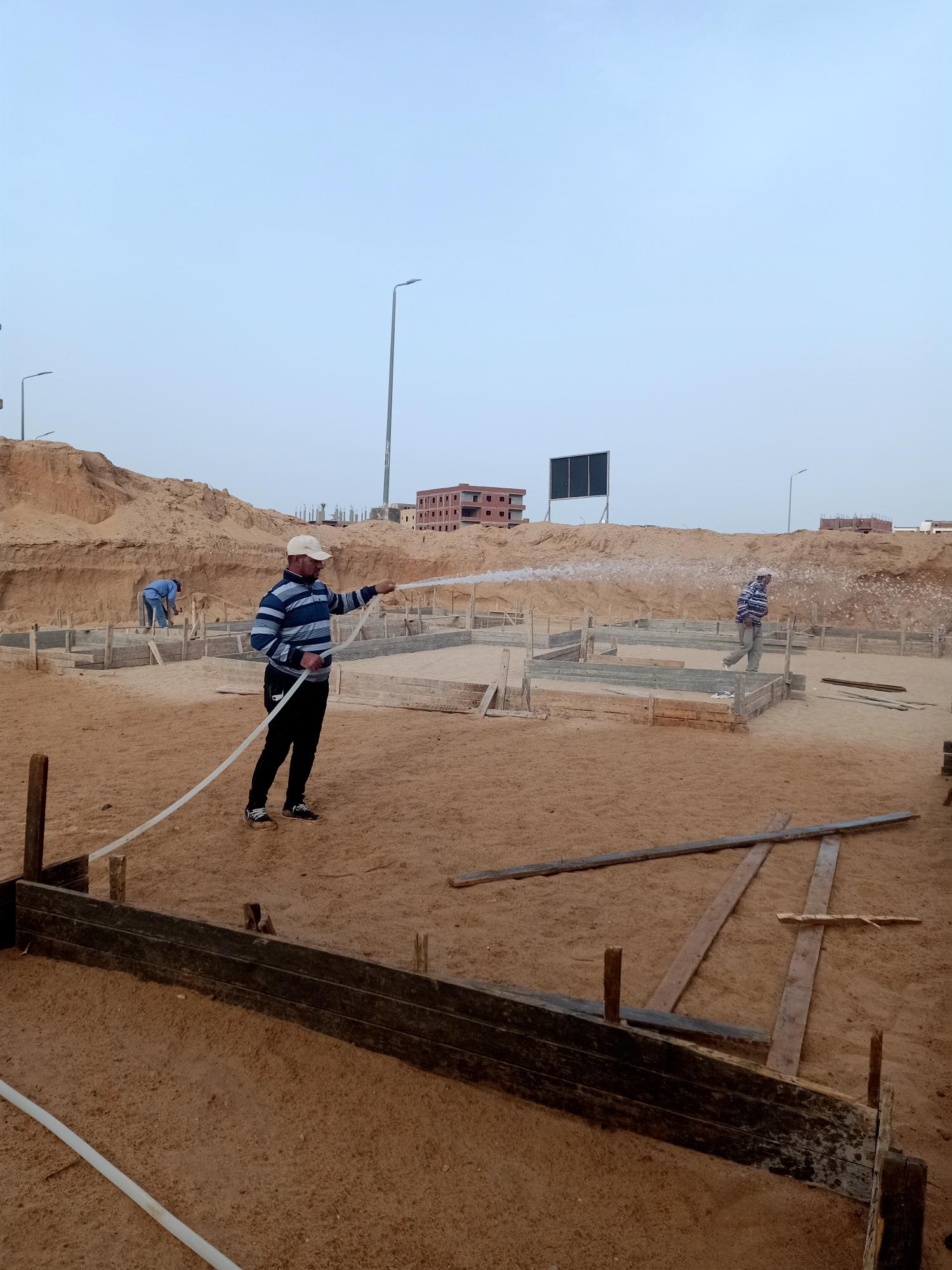

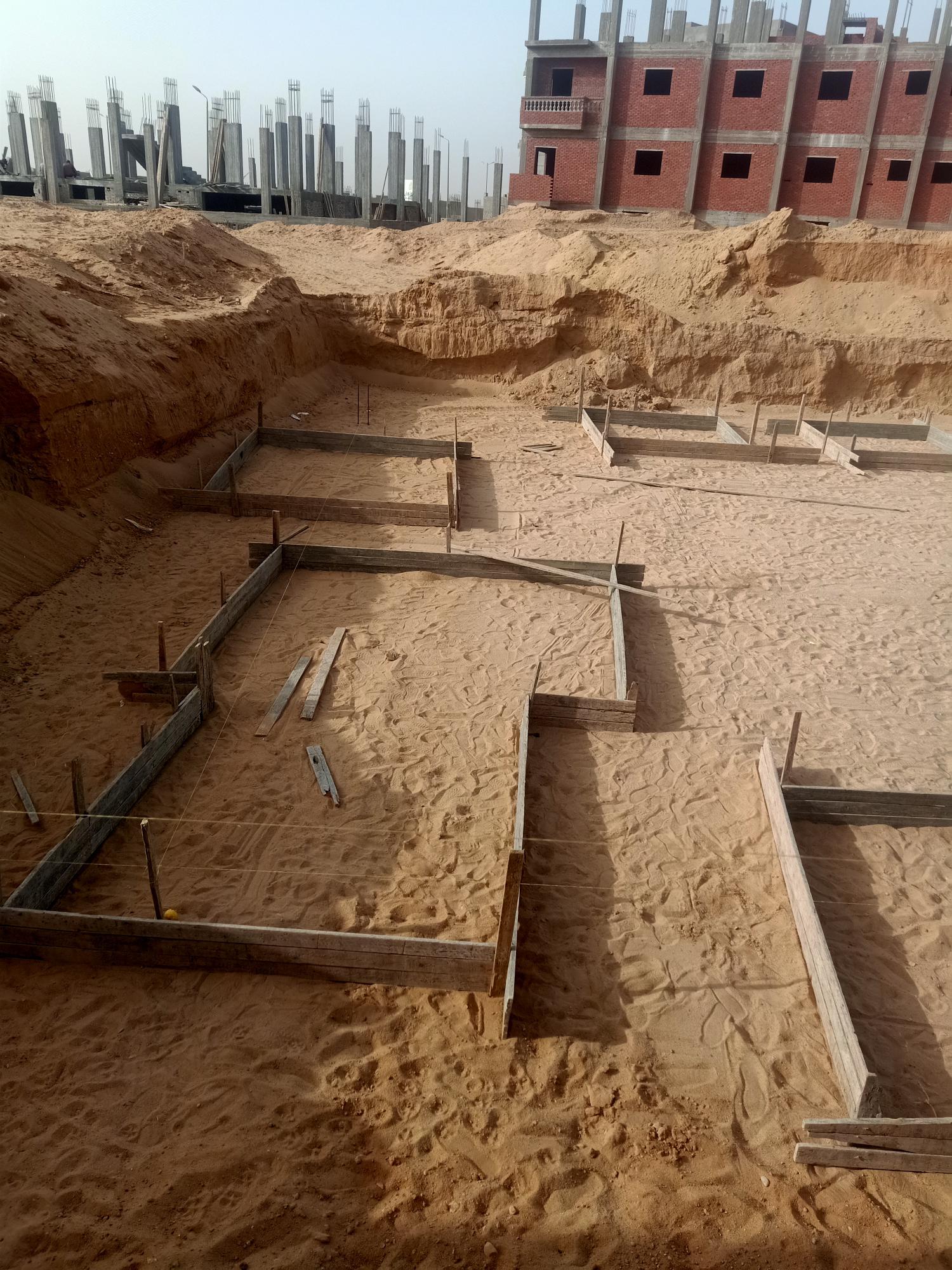

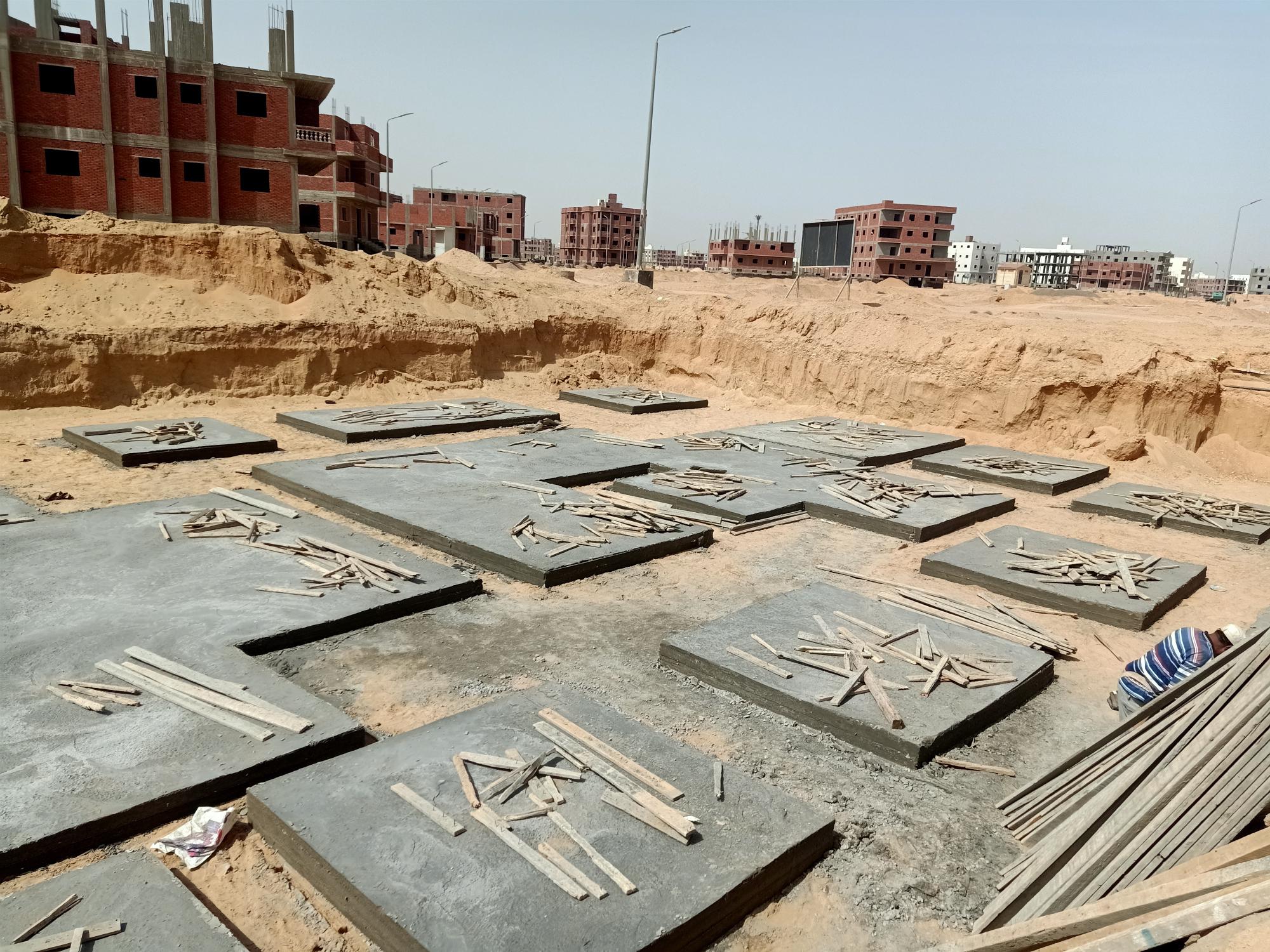

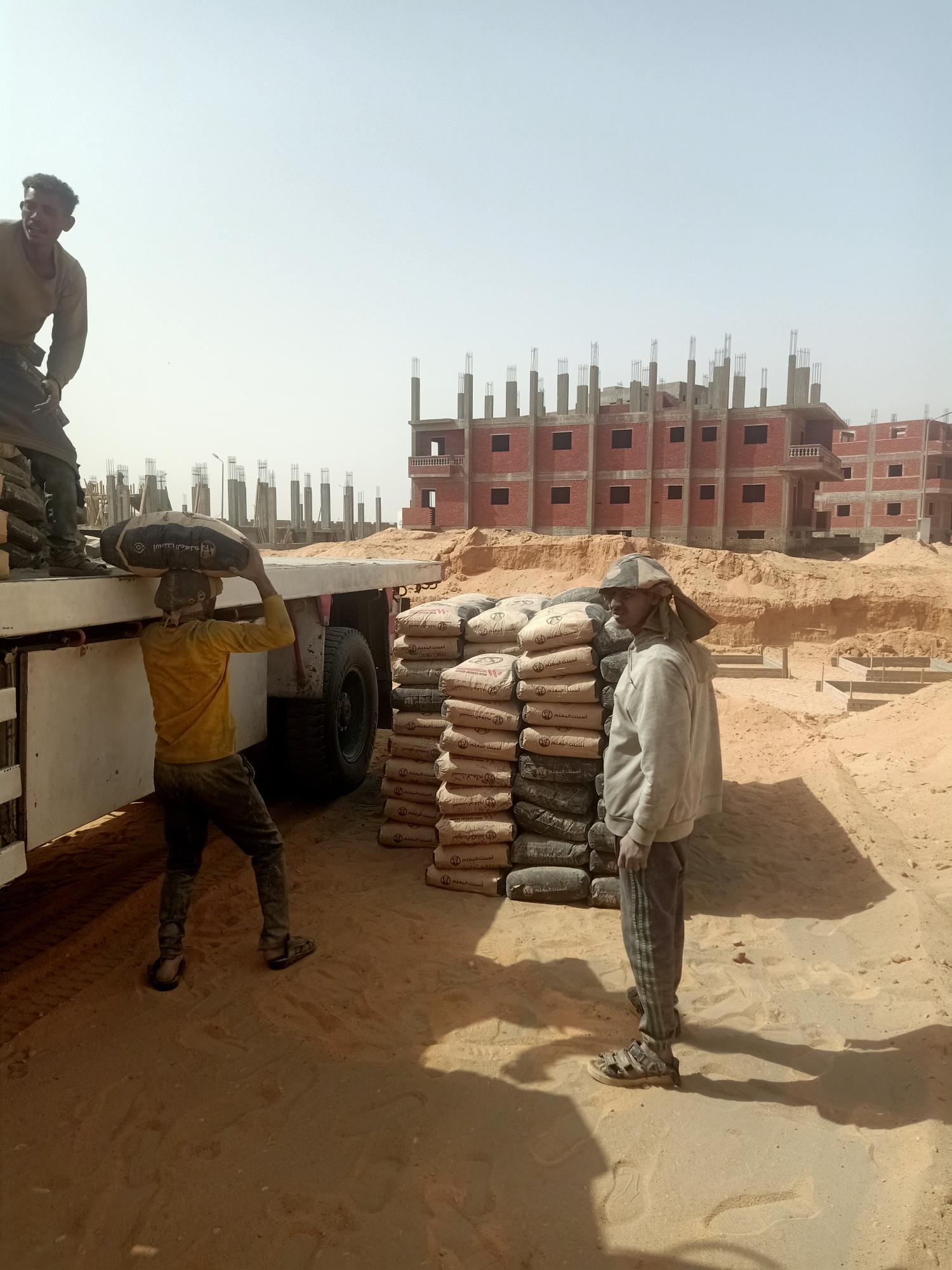

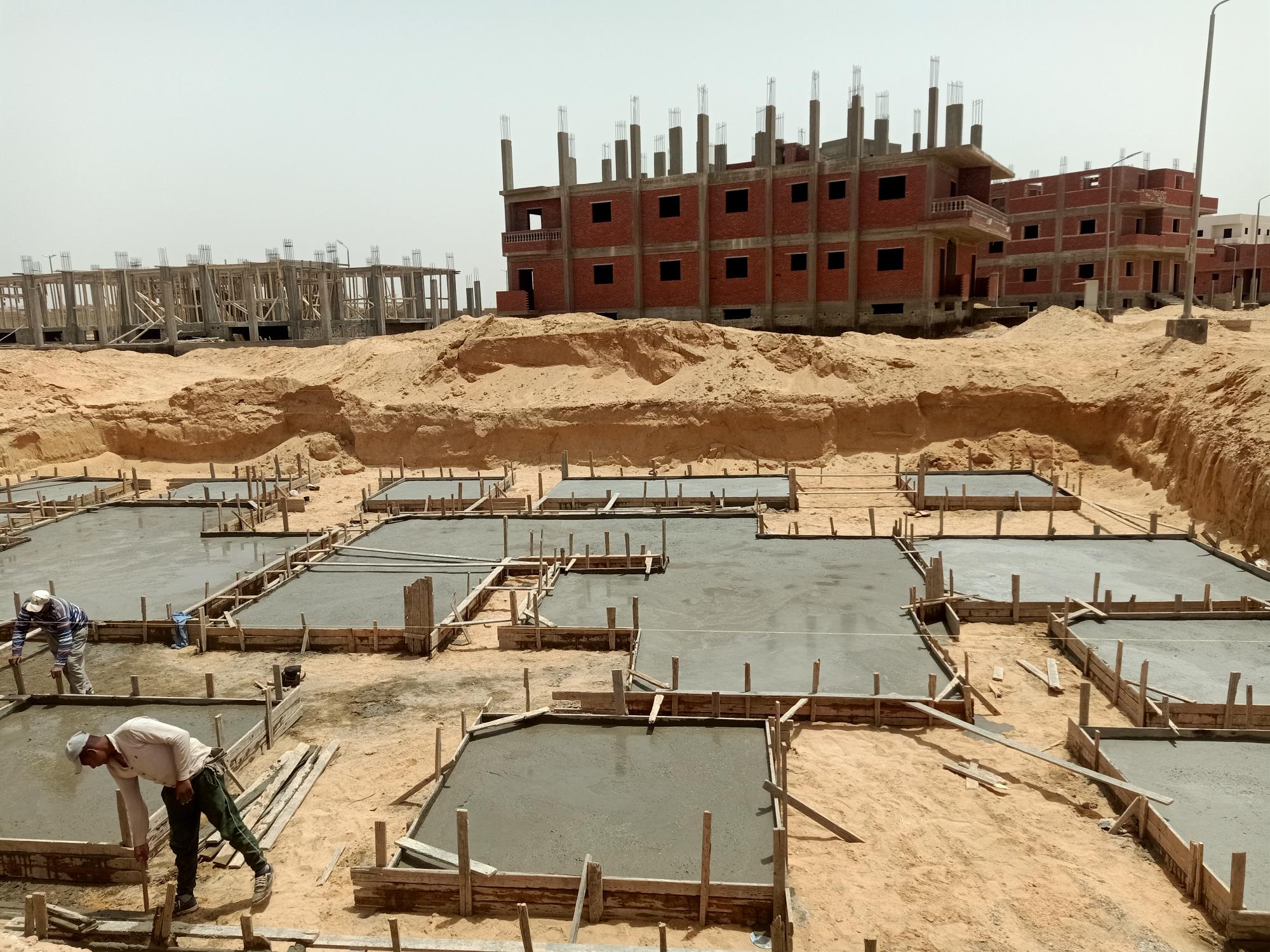

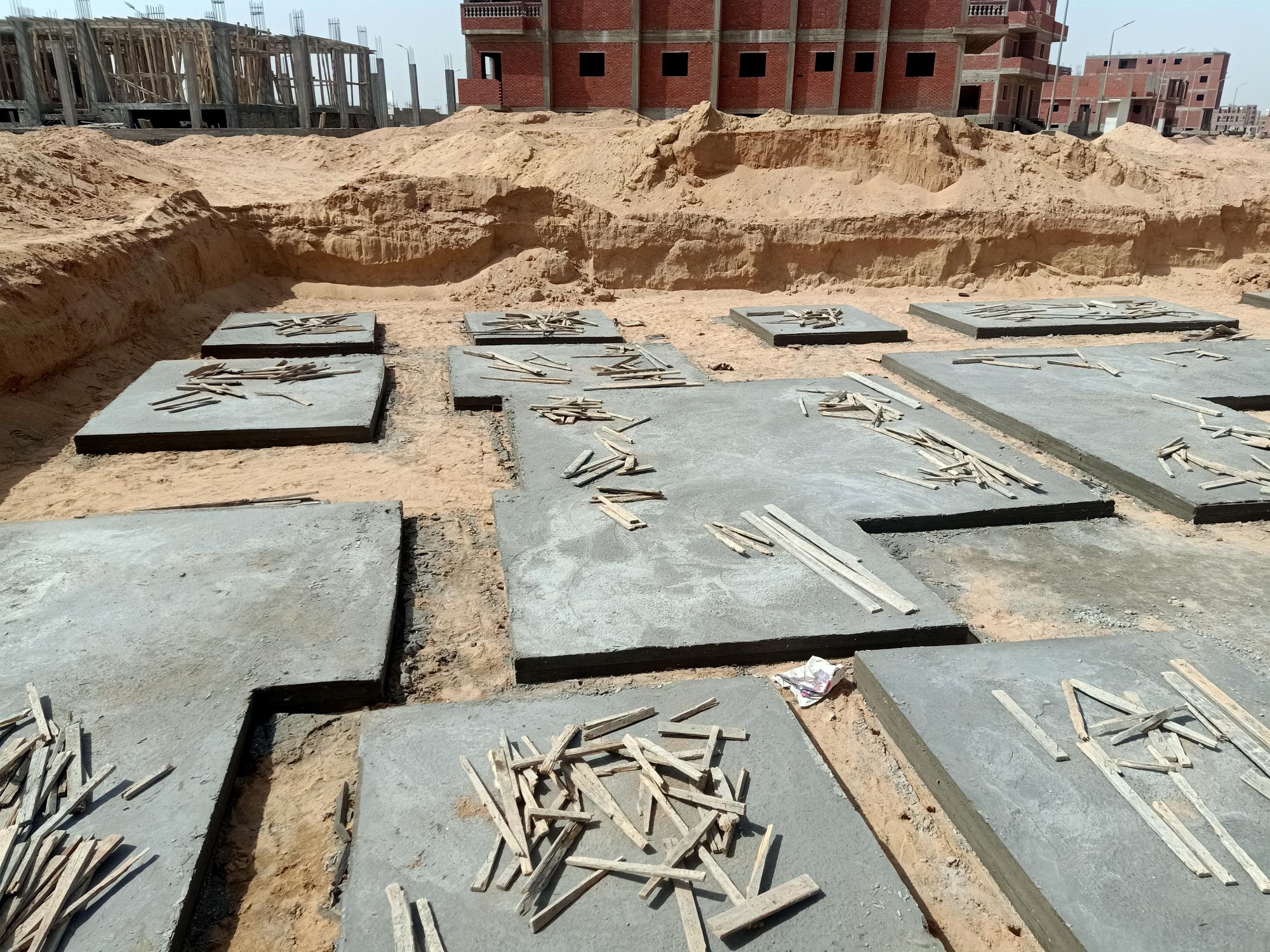

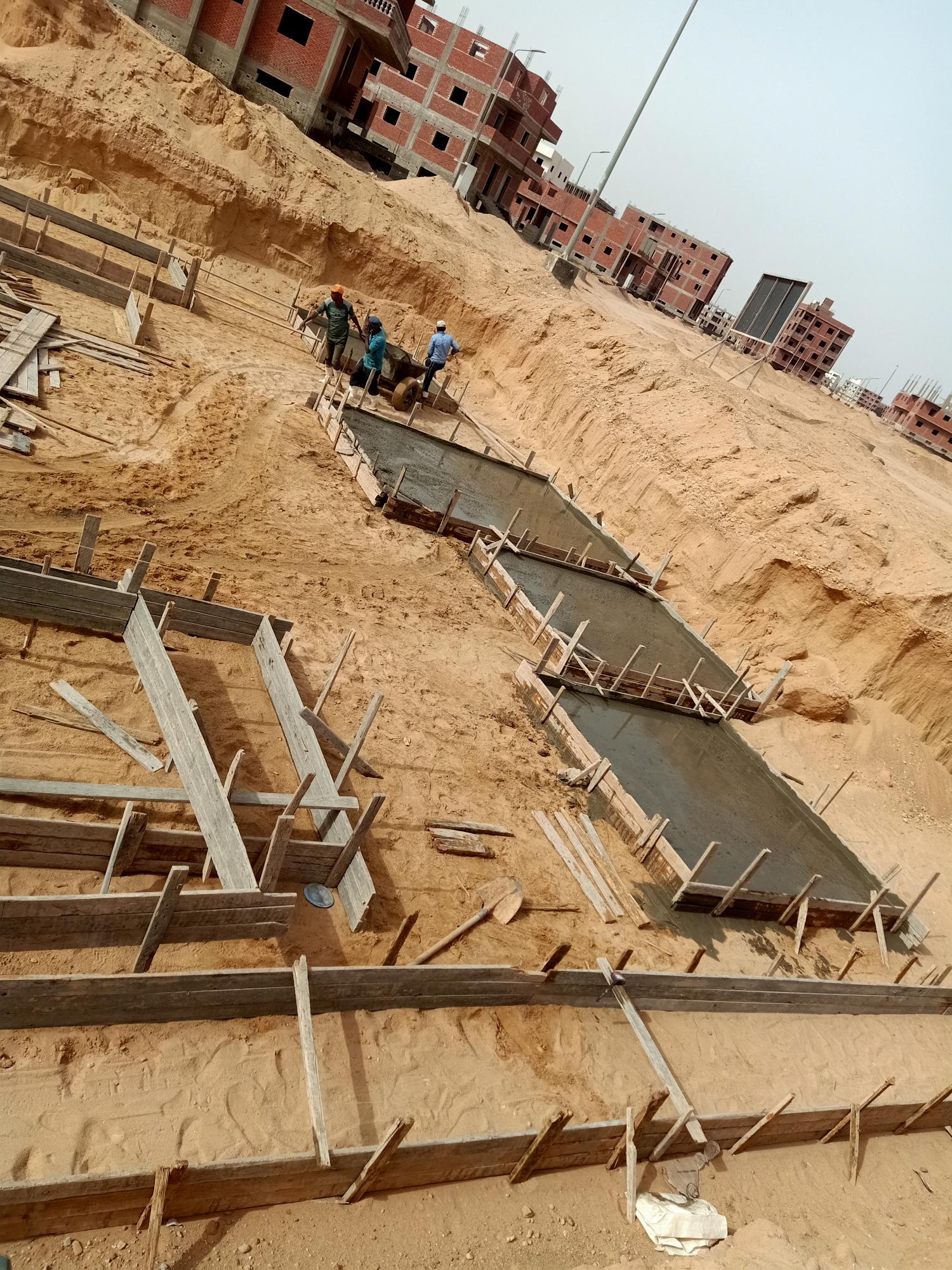

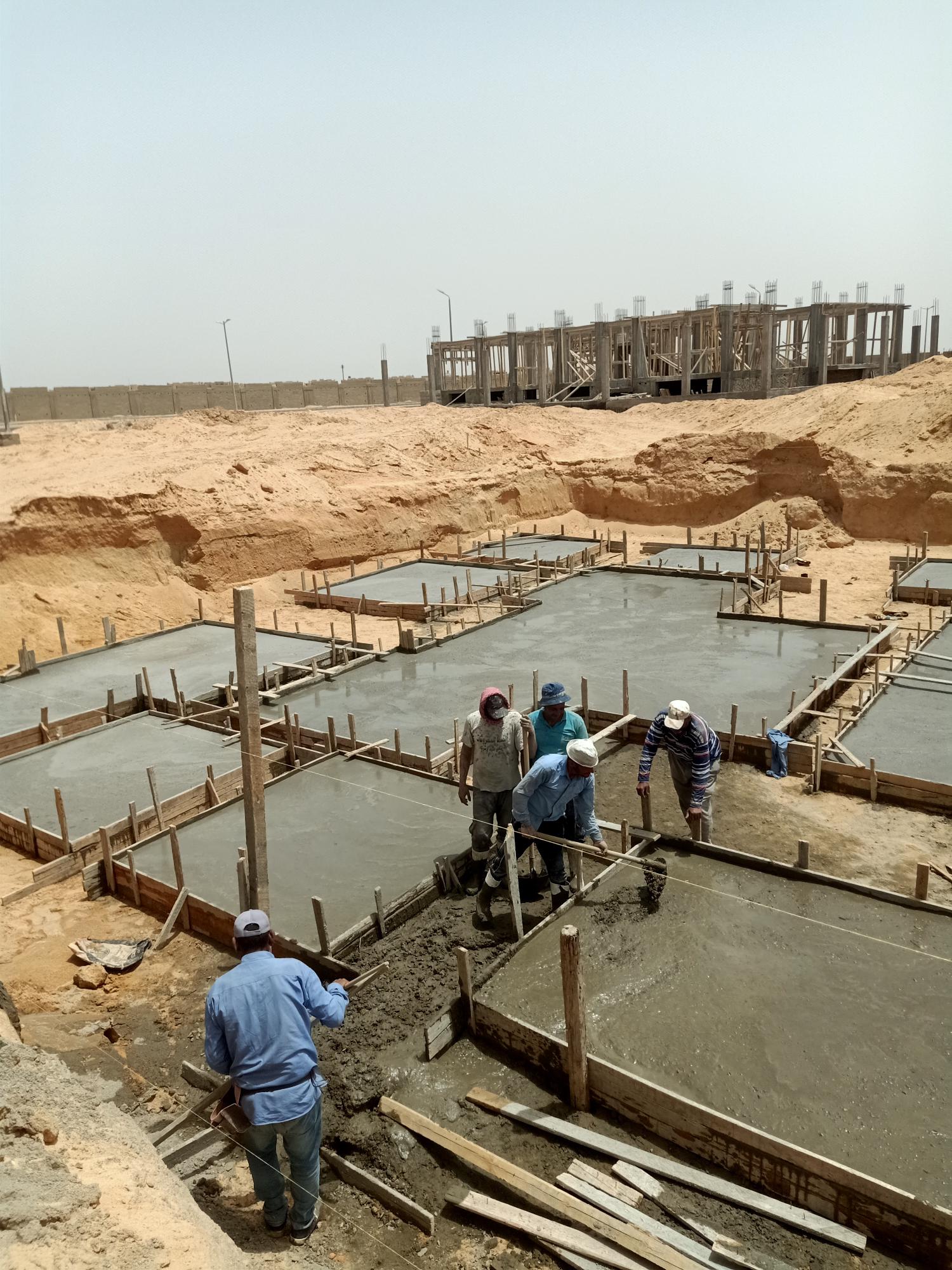

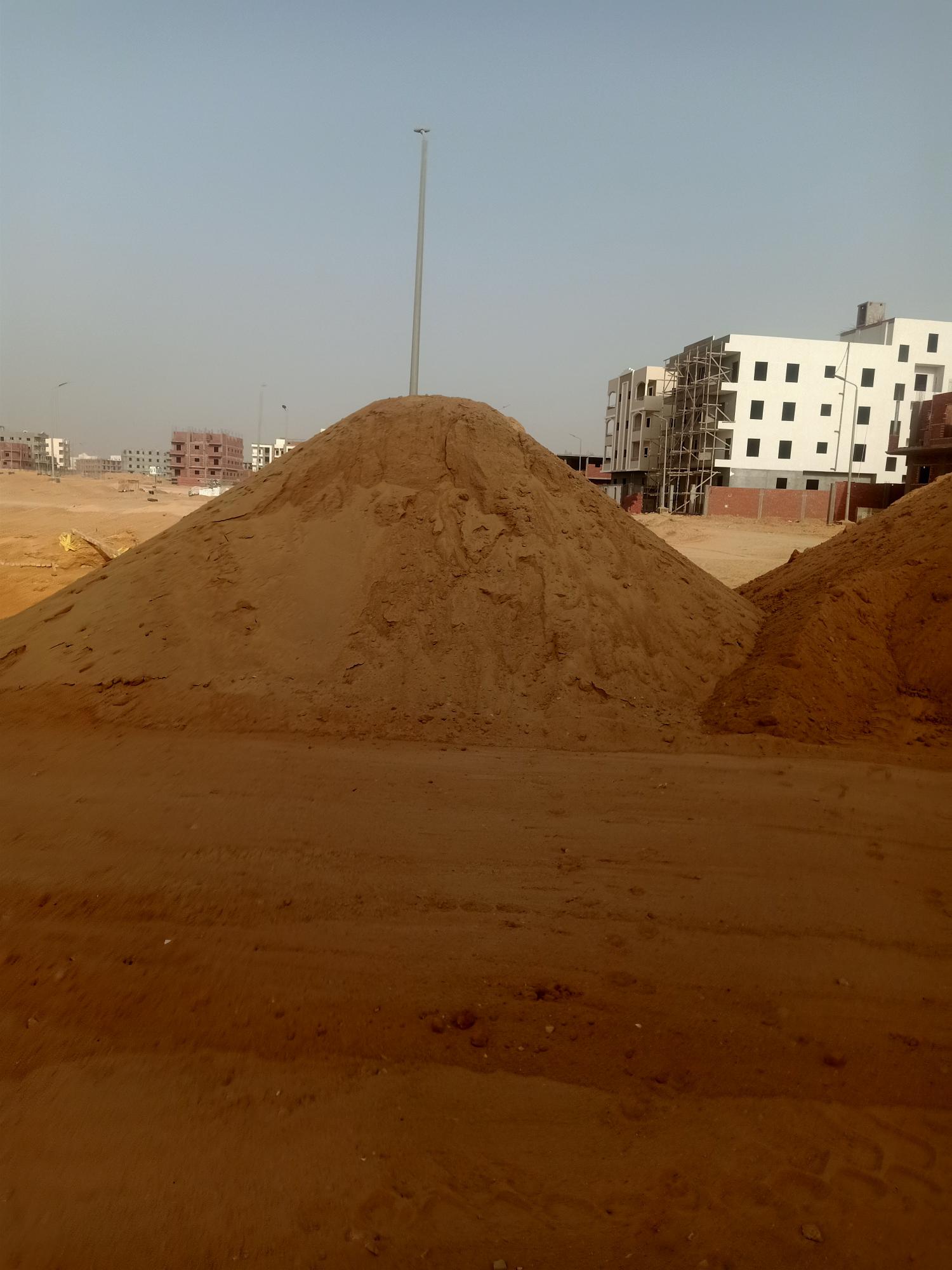

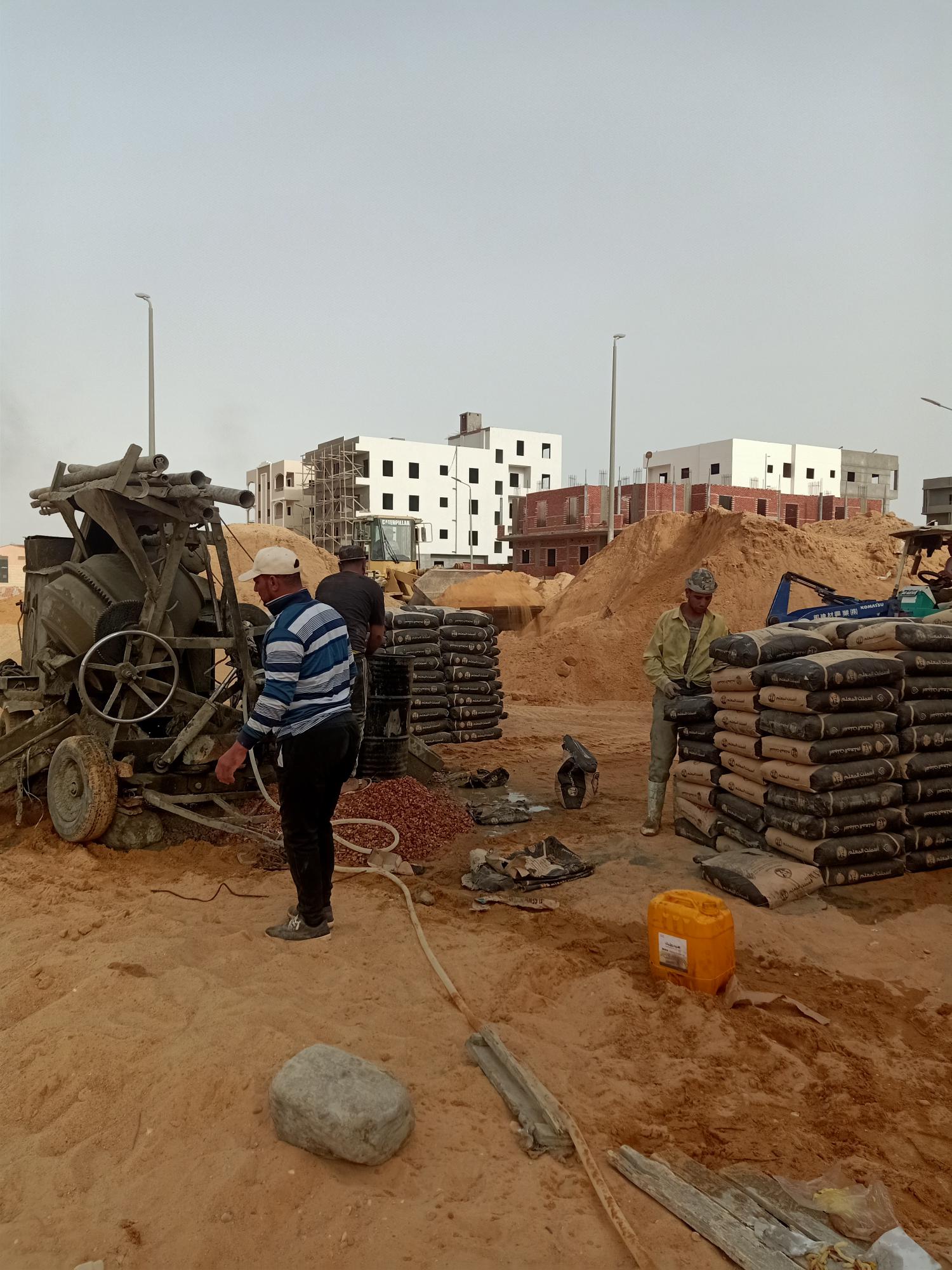

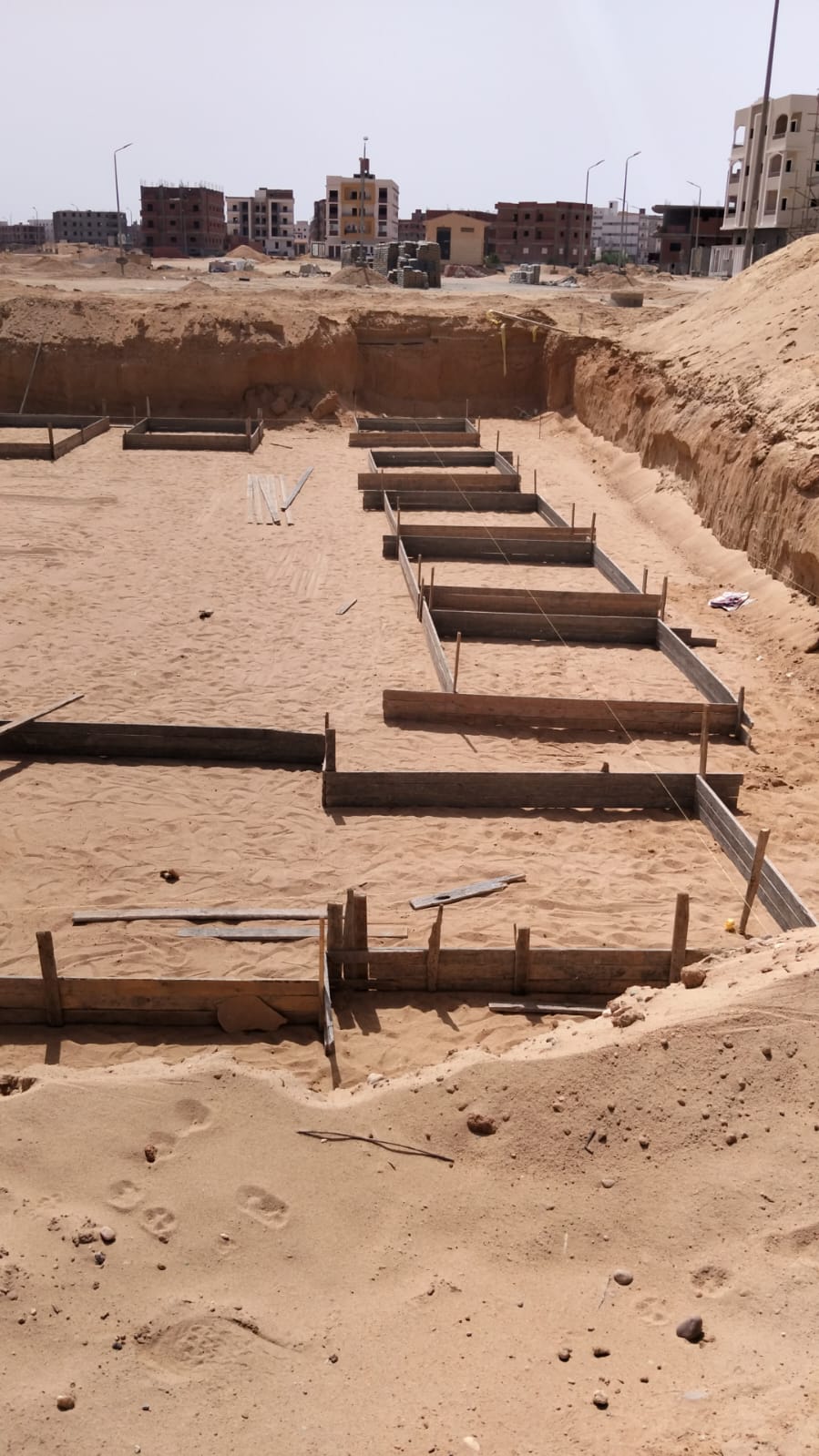

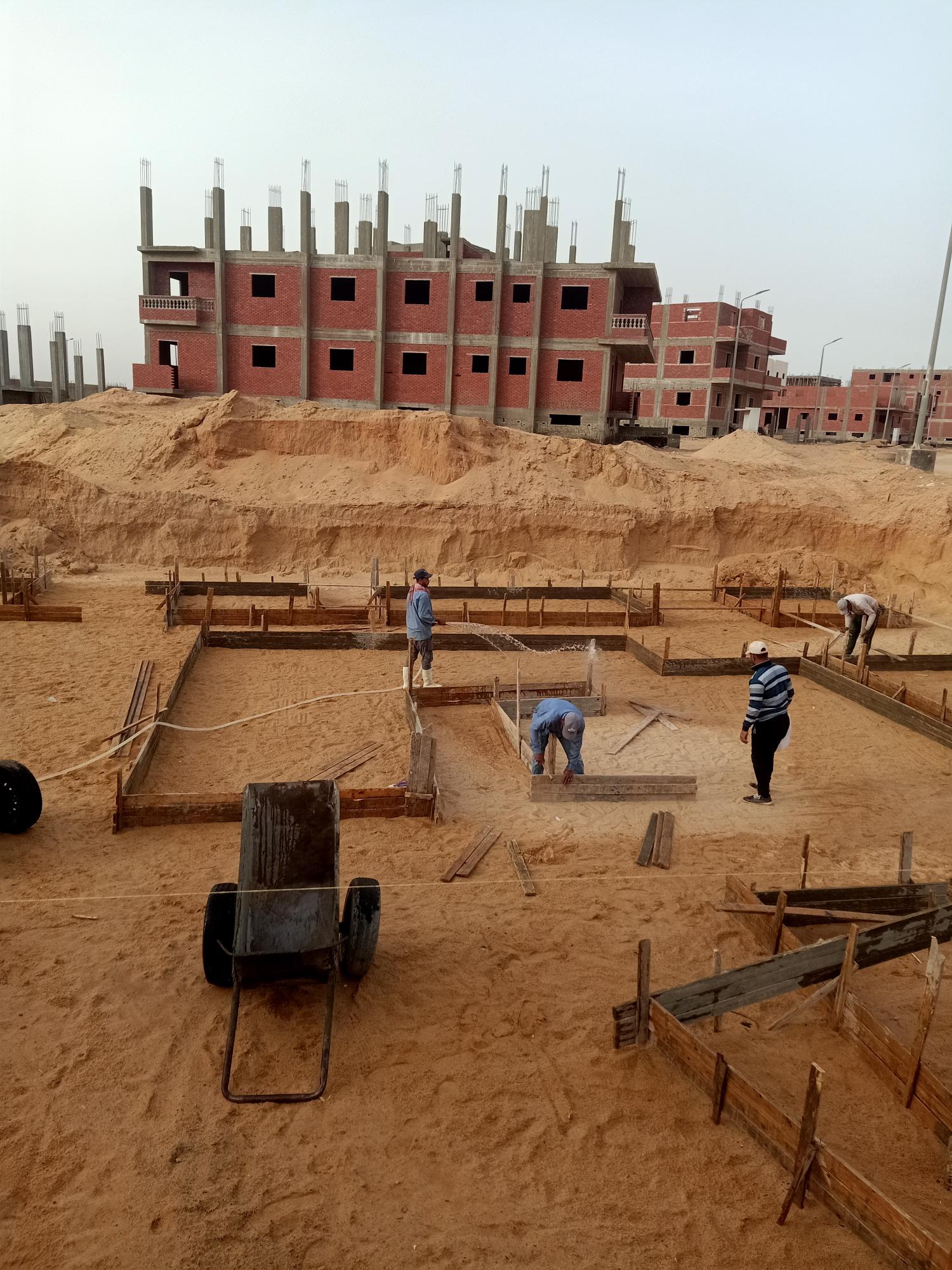

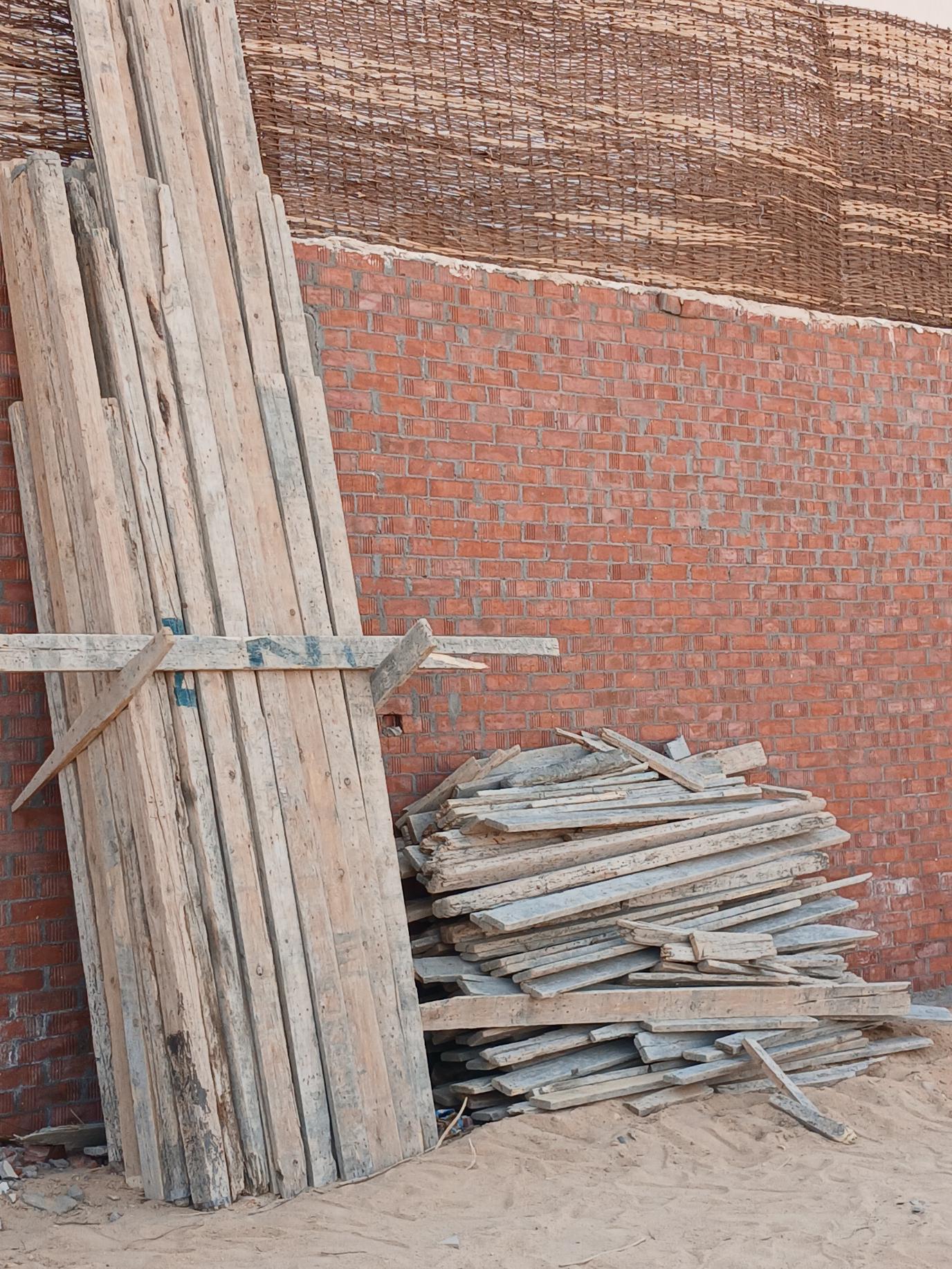

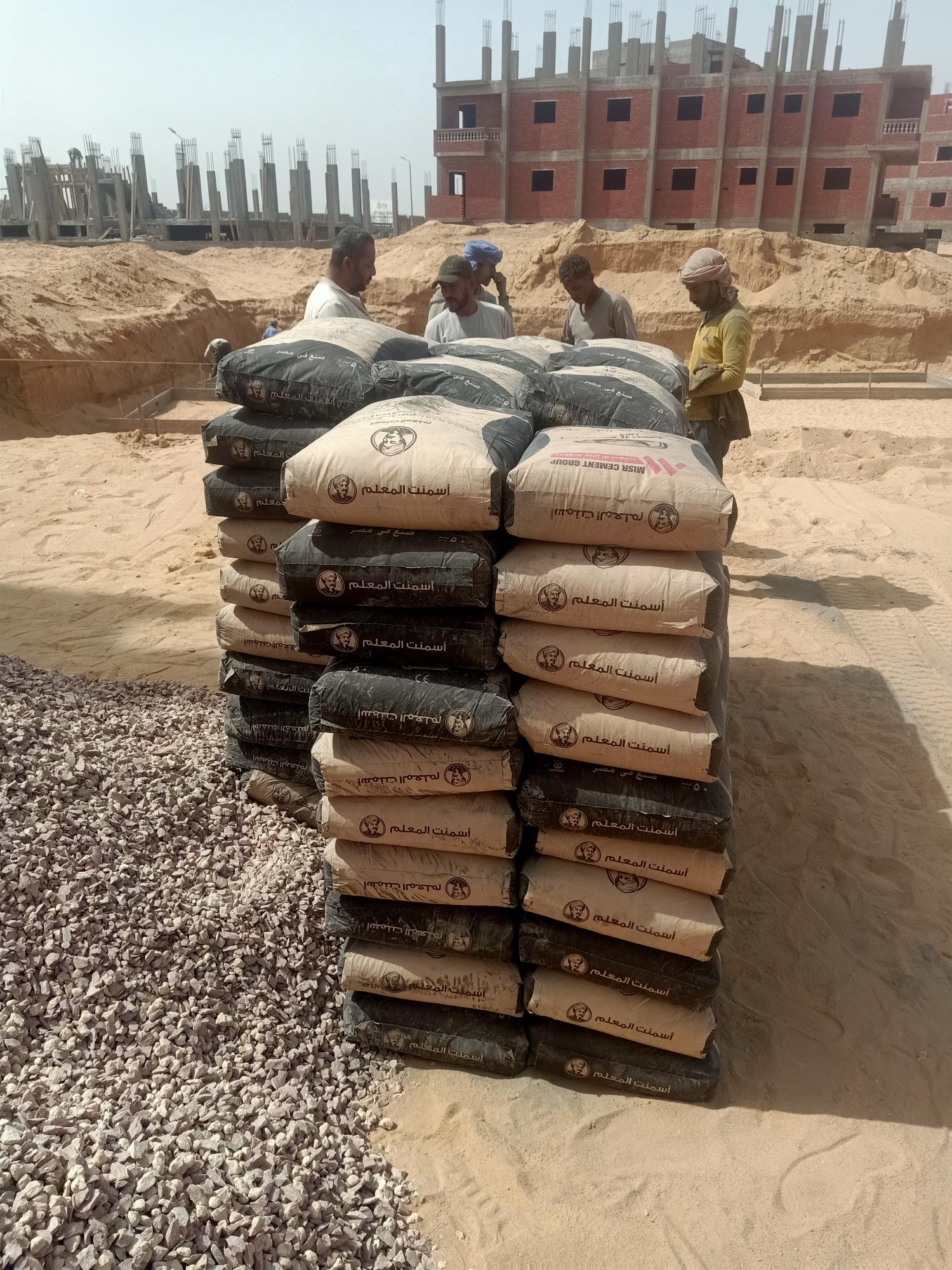

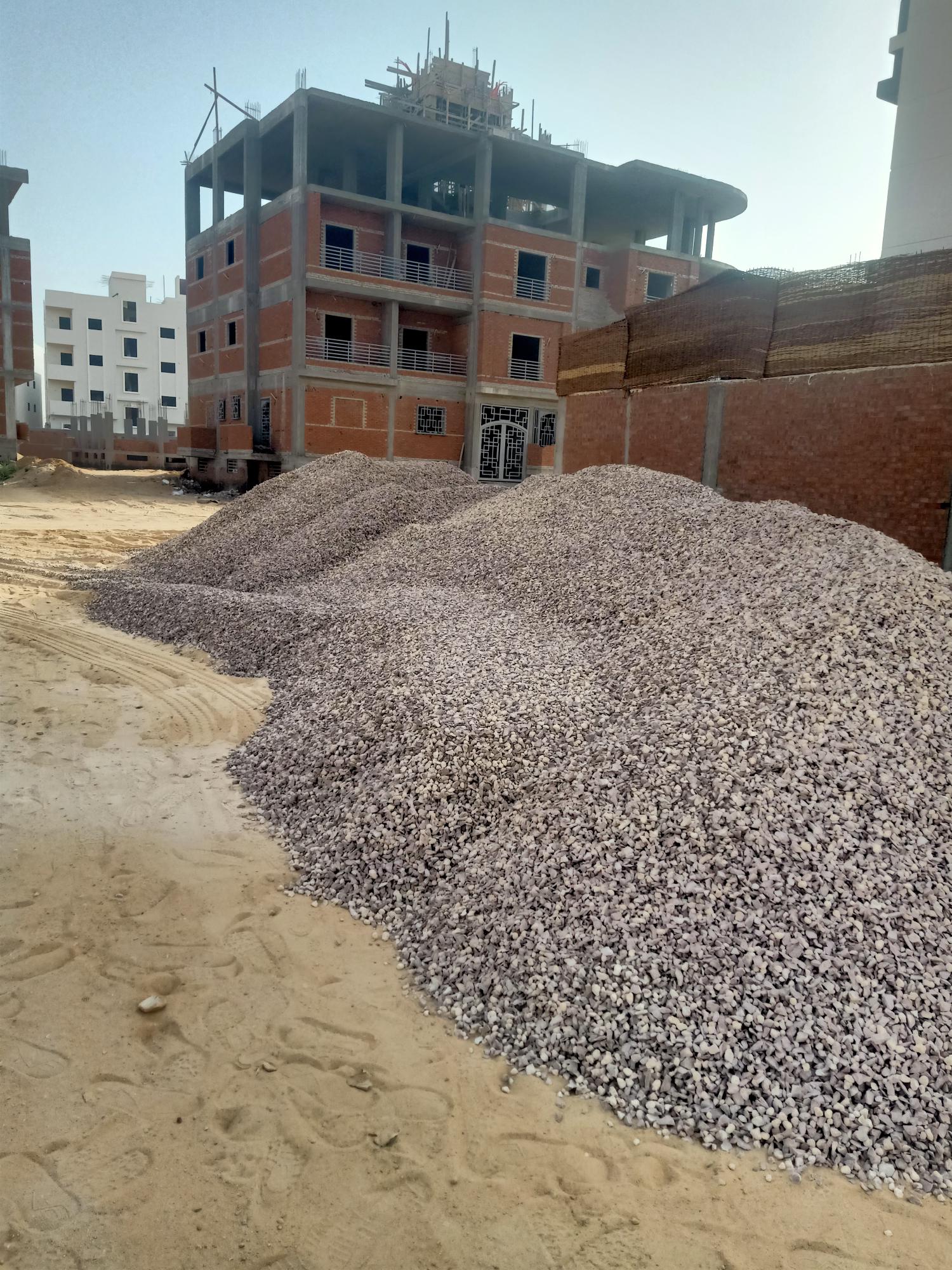

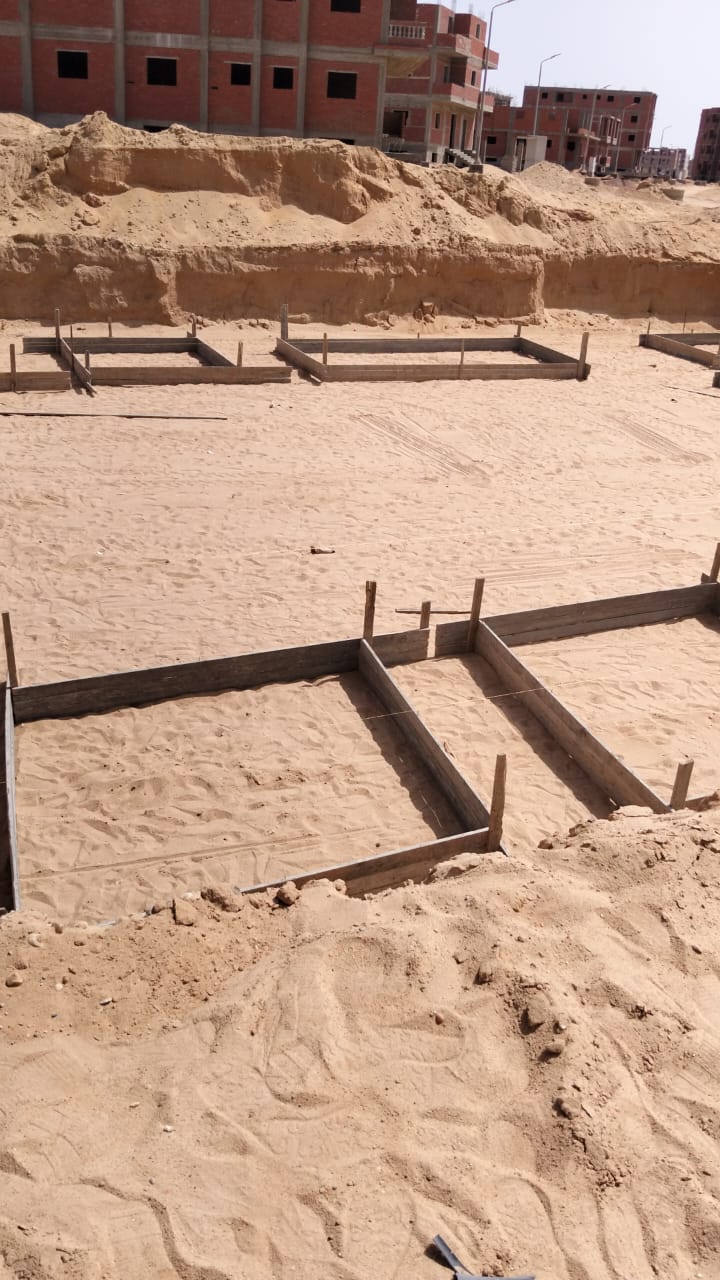

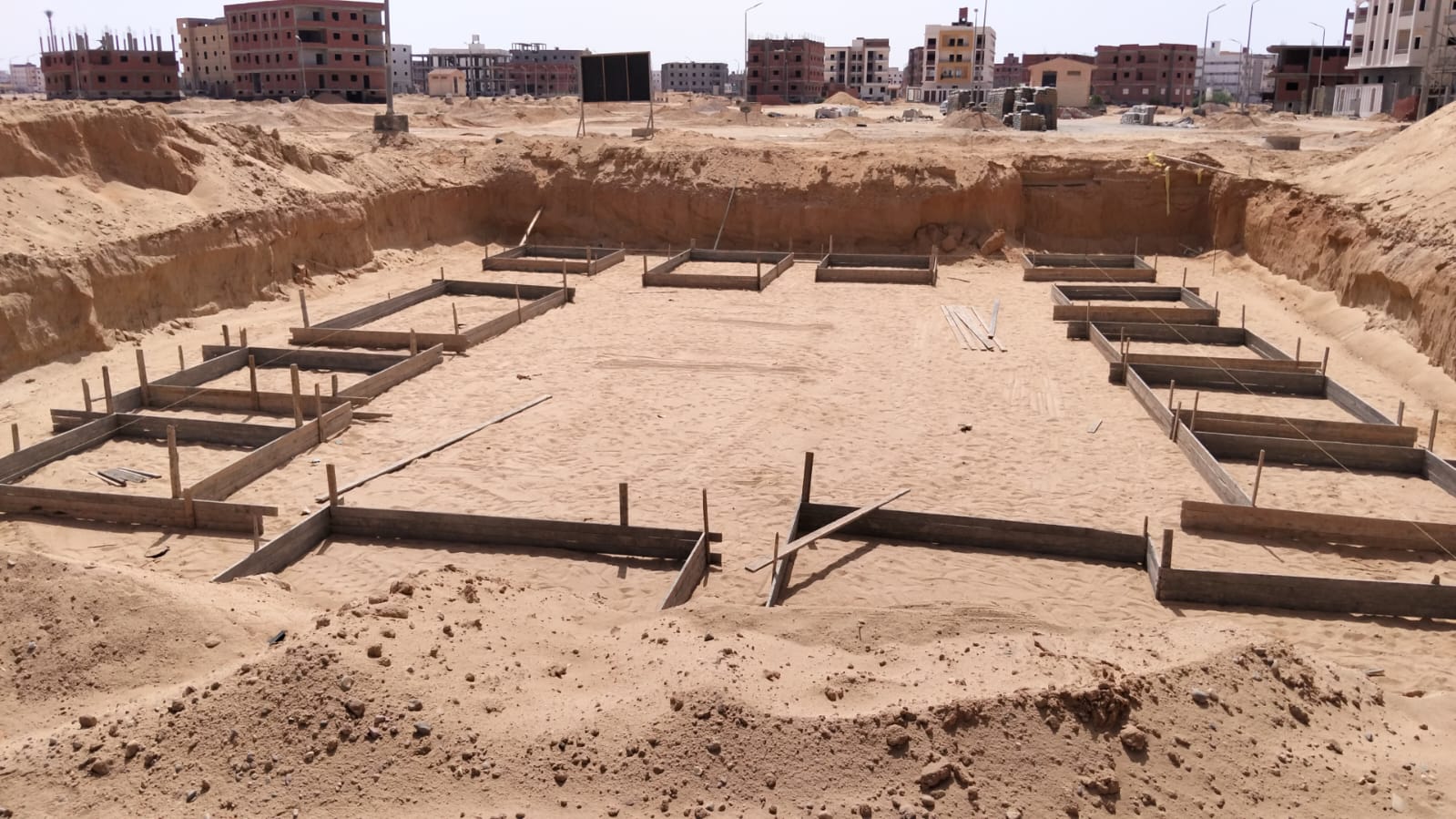

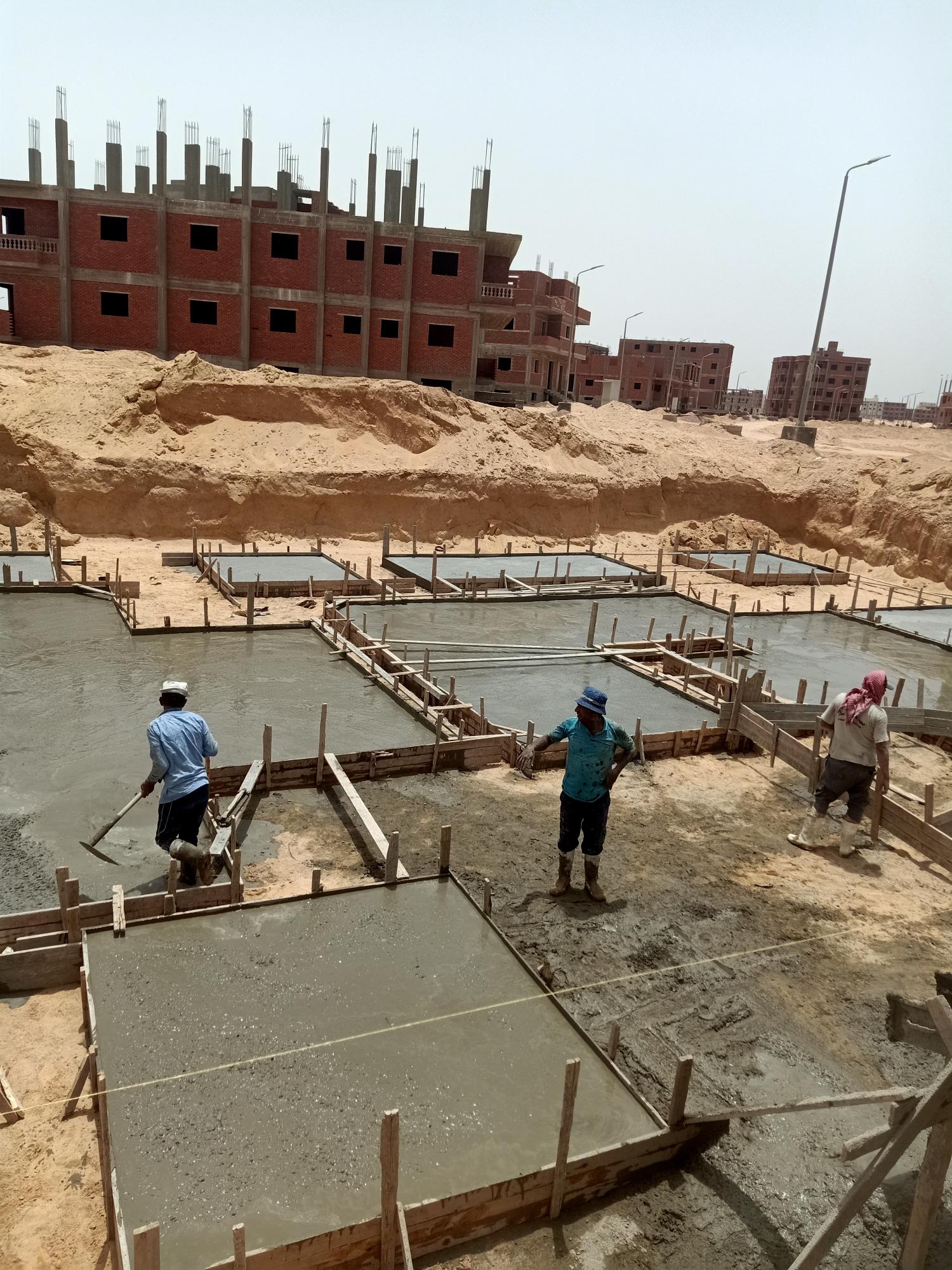

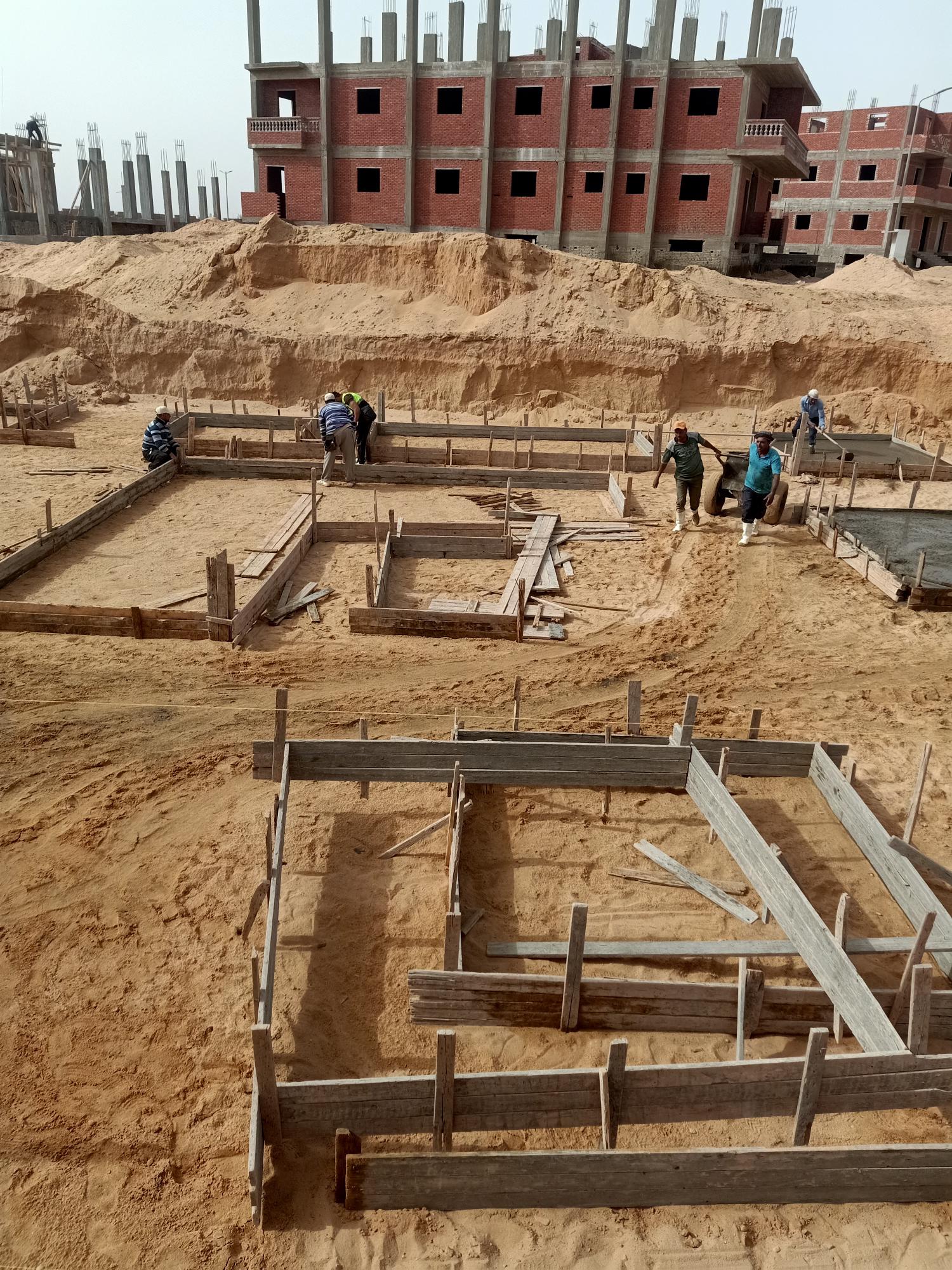

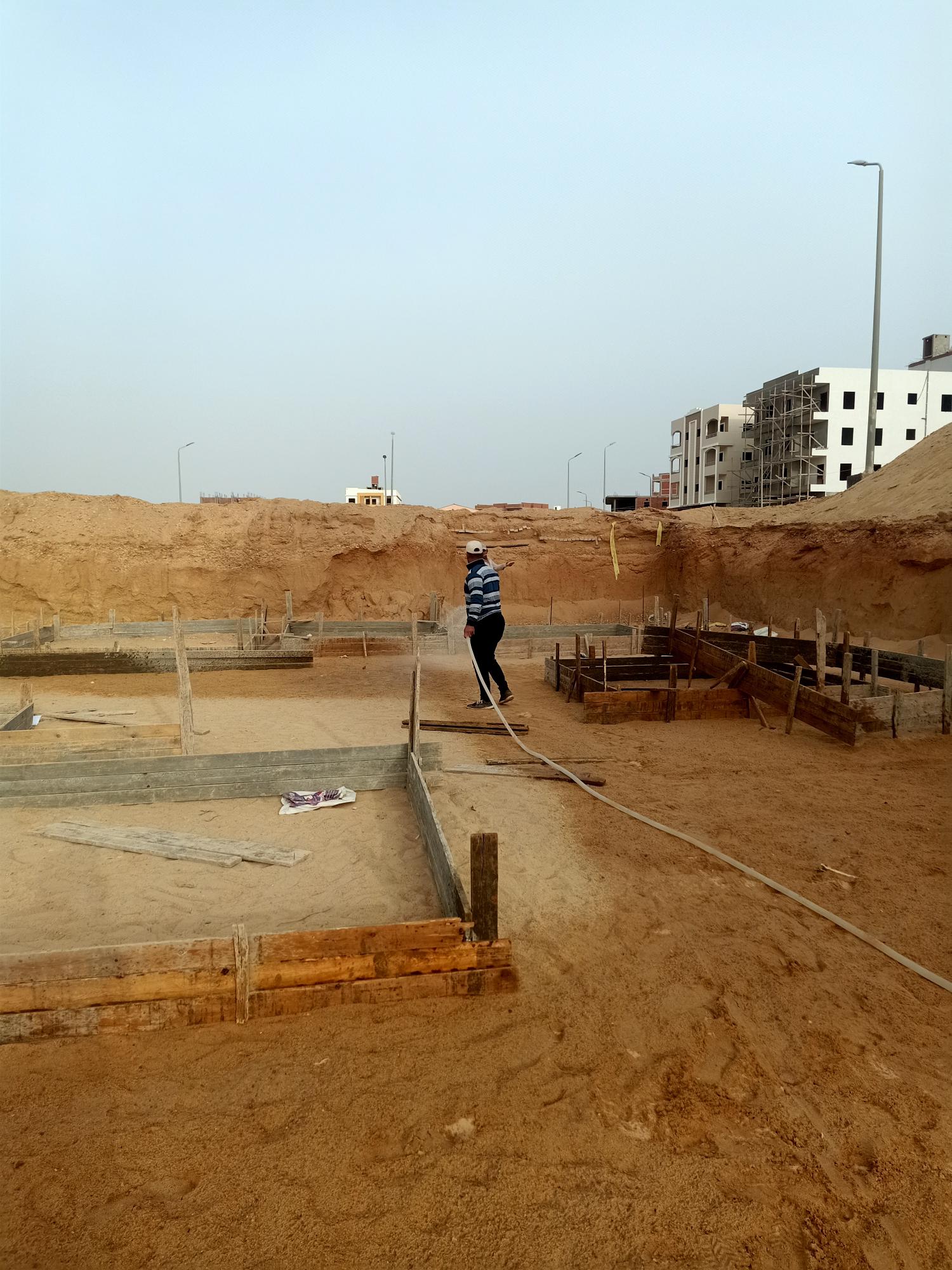

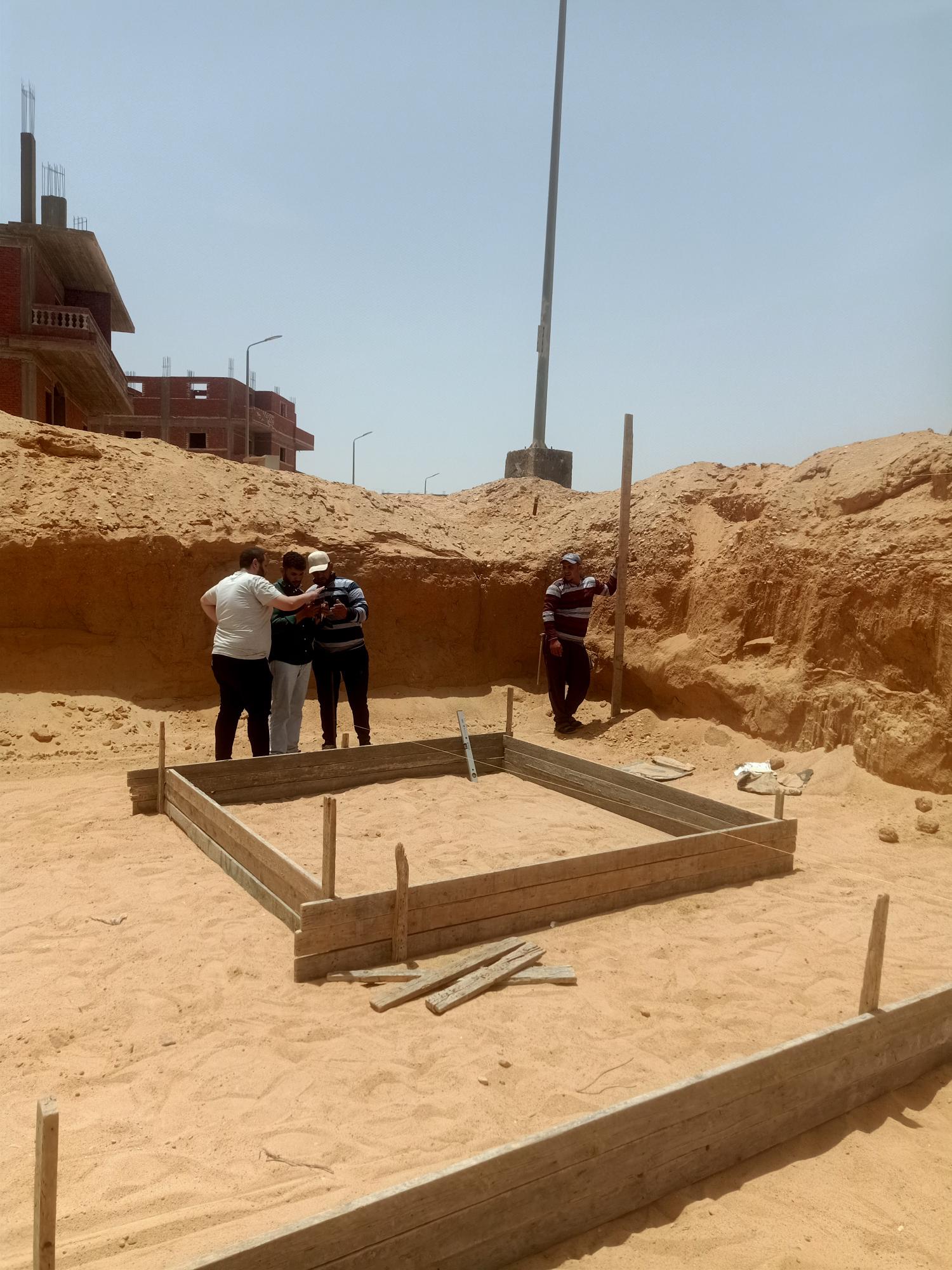

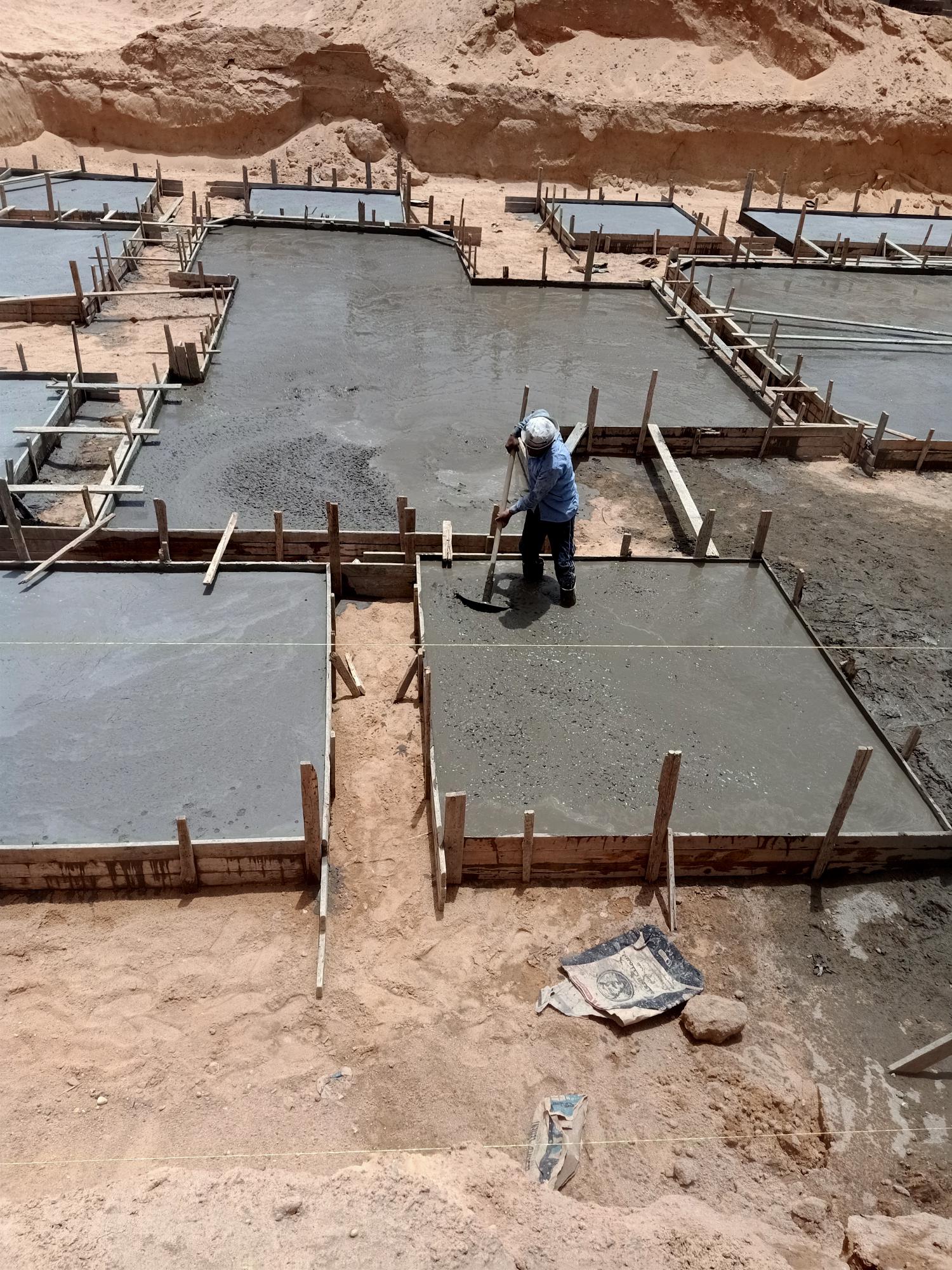

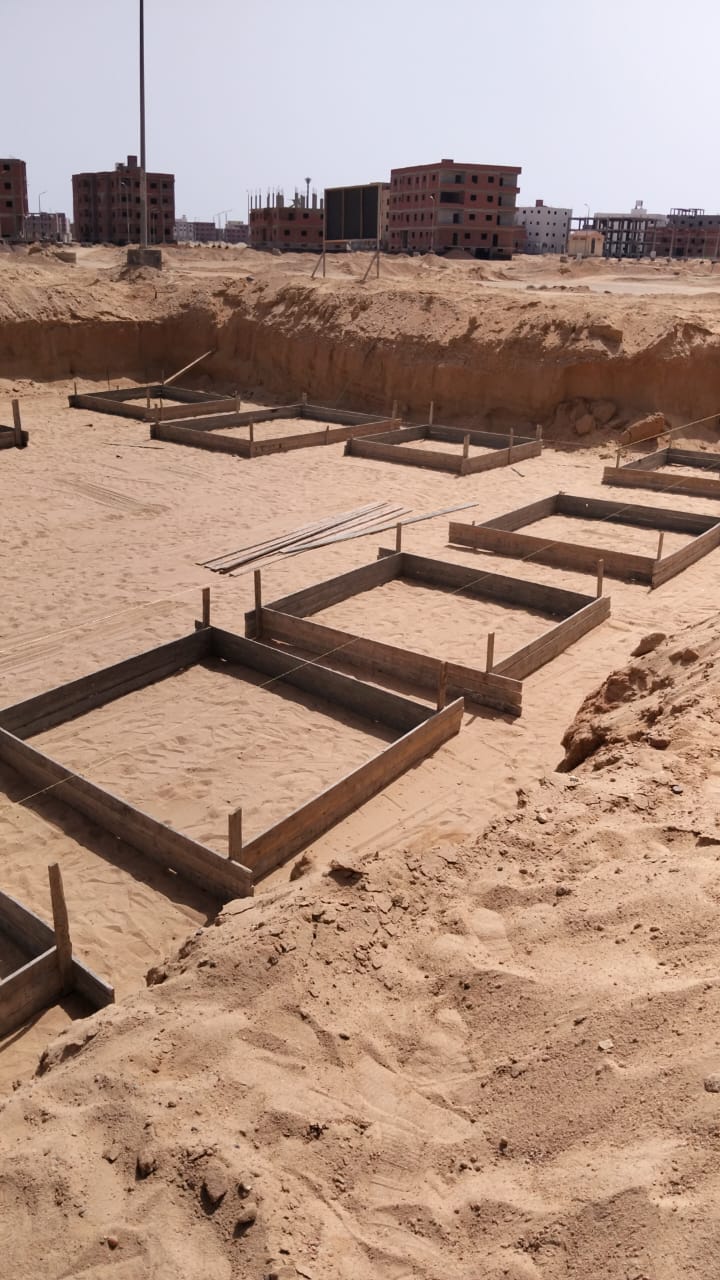

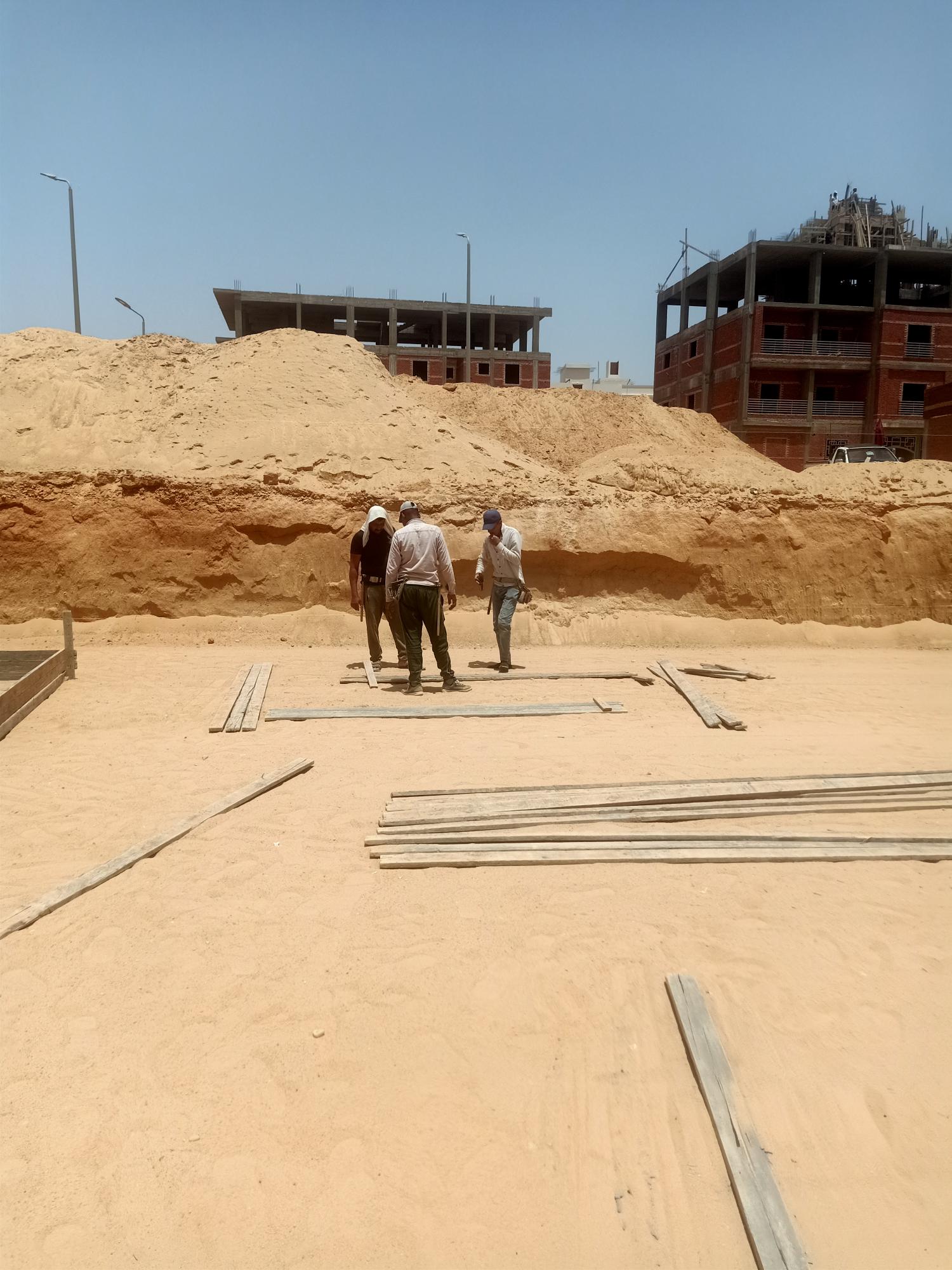

Plain foundations
October 9, 2025
Reinforced foundations
October 24, 2025
Basement columns
November 3, 2025
Basement slab
December 3, 2025
Ground floor columns
December 10, 2025
Ground floor slab
December 31, 2025
Footings insulation
January 3, 2026
Backfilling around foundations
January 3, 2026
First floor columns
January 10, 2026
First floor slab
January 31, 2026
Second floor columns
February 7, 2026
Second floor slab
February 22, 2026
Submitting third-floor extension license
February 22, 2026
Third floor columns
May 30, 2026
Third floor slab
May 30, 2026
Roof extension license
June 2, 2026
Roof concrete works
June 3, 2026
Fence columns
June 14, 2026
Basement walls
October 22, 2026
Ground floor walls
November 1, 2026
First floor walls
November 11, 2026
Second floor walls
November 21, 2026
Third floor walls
December 1, 2026
Roof walls
December 11, 2026
Wooden door frames
December 16, 2026
Plumbing main works
December 26, 2026
Electrical final finishes
December 27, 2026
Plaster and putty
February 10, 2027
Plumbing finishing
February 17, 2027
Aluminum & glass works (Krital)
February 20, 2027
Marble finishing
March 2, 2027
Electrical finishing
March 9, 2027
Elevator
March 22, 2027
Project handover to the authority
March 24, 2027
Utilities meter installation
March 25, 2027
