Project Details
Land Number
1114
Region
The Area 22, El Sadat City
HOMEi Price
3,850.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
| 2 |
|
- | Finished |
| 3 |
|
- | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 25% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
170 m²
Delivery
Unit Delivery Date
July 2025
Average Unit Price
533,250 EGP
Project Location
Map View
The Area 22, El Sadat City
HOMEi Timeline
License office contract
February 15, 2023

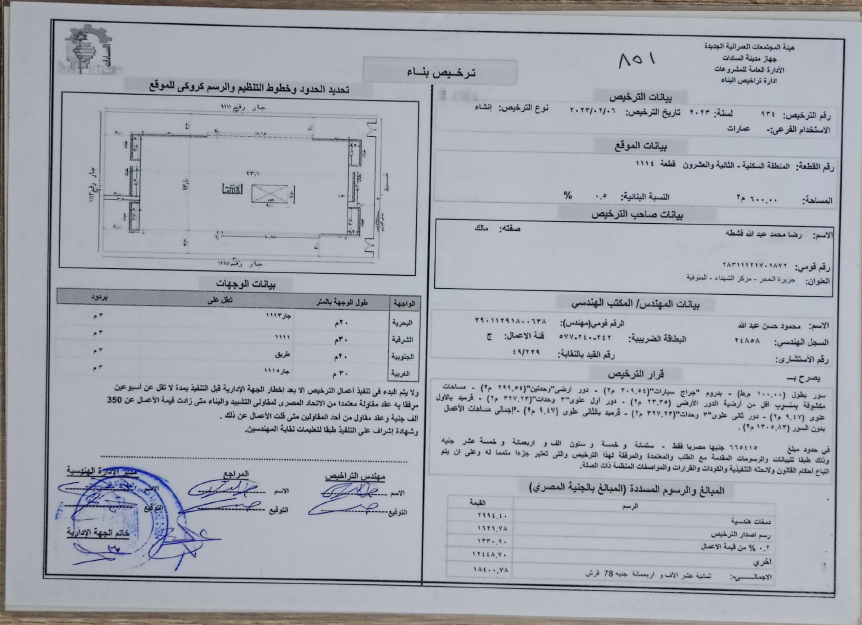

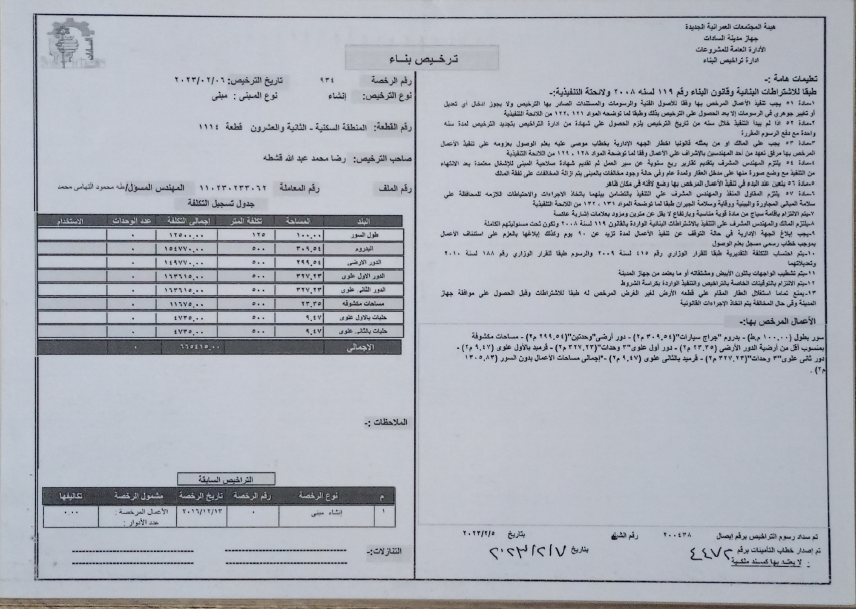

Building permit
February 16, 2023

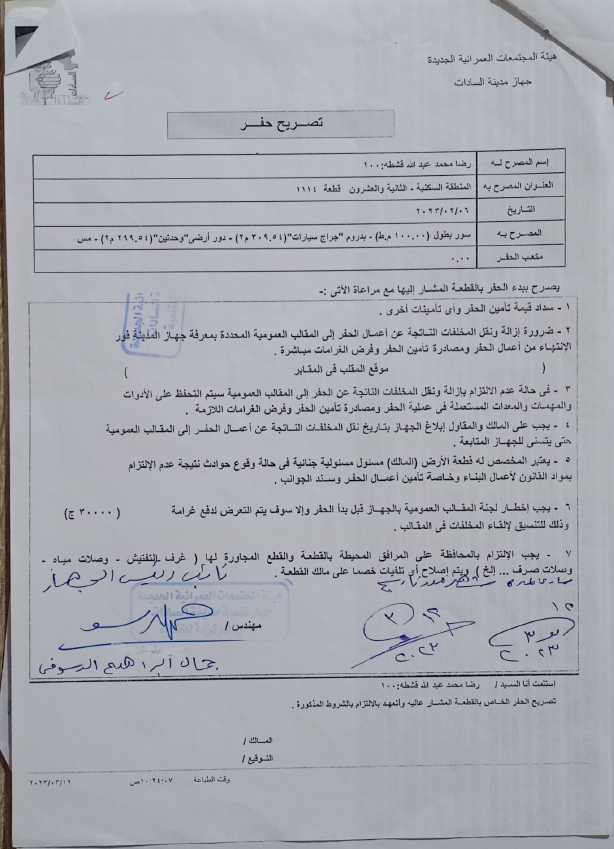

Excavation permit
February 18, 2023
Mining permit
February 19, 2023
Construction contract in progress
February 20, 2023
Construction contract signed
February 25, 2023

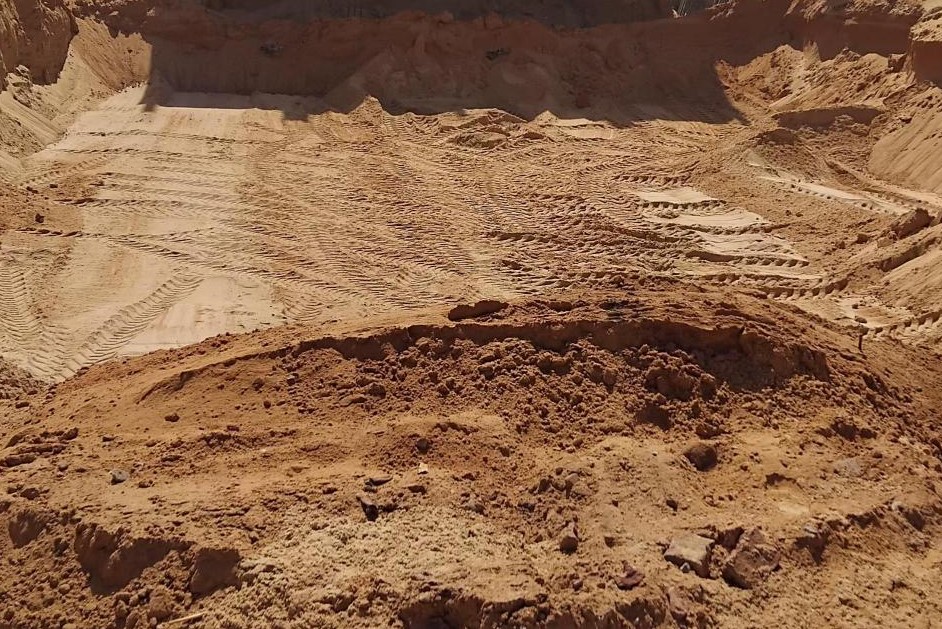

Excavation
January 1, 2024

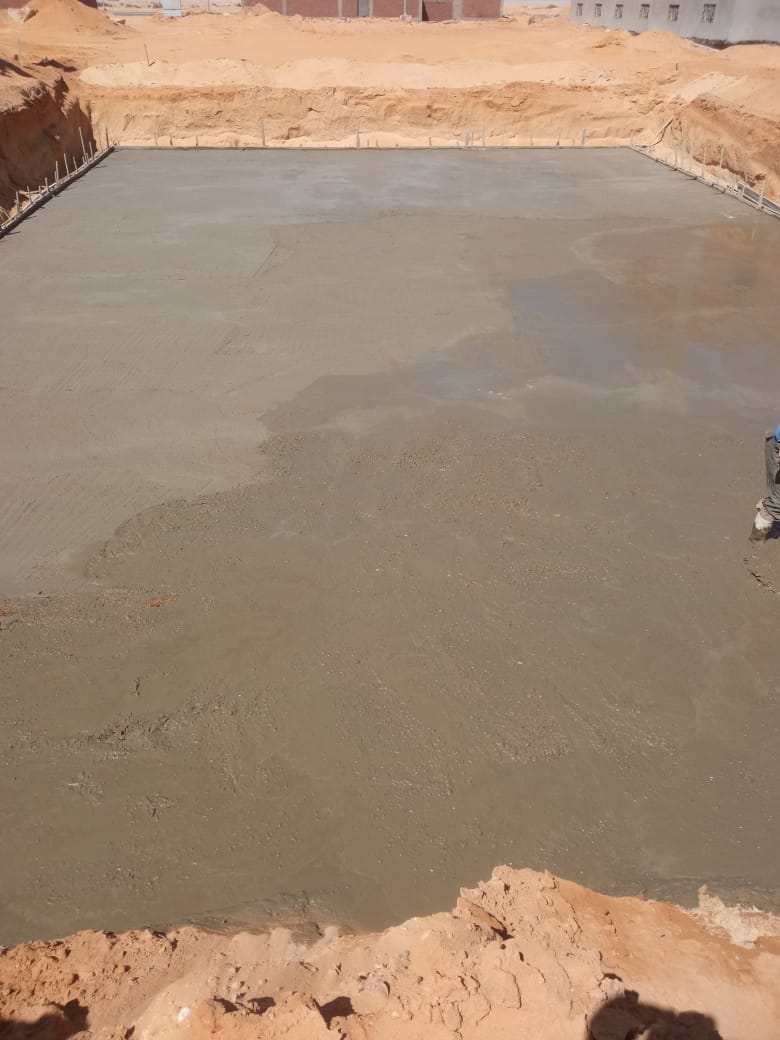

Plain concrete
January 15, 2024

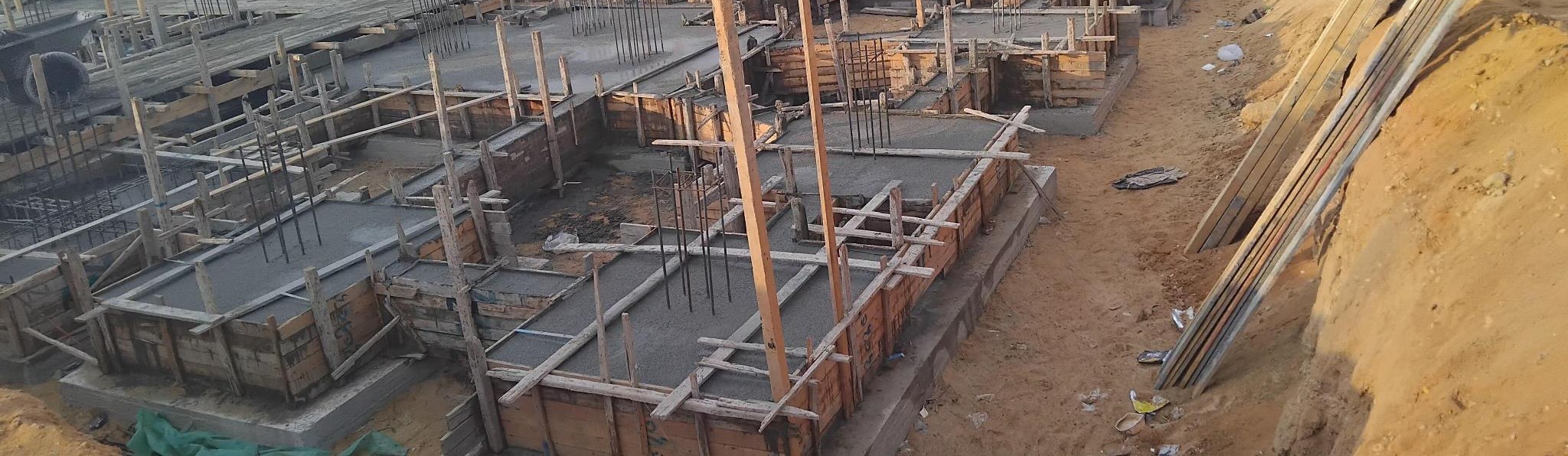

Reinforced foundations
January 25, 2024

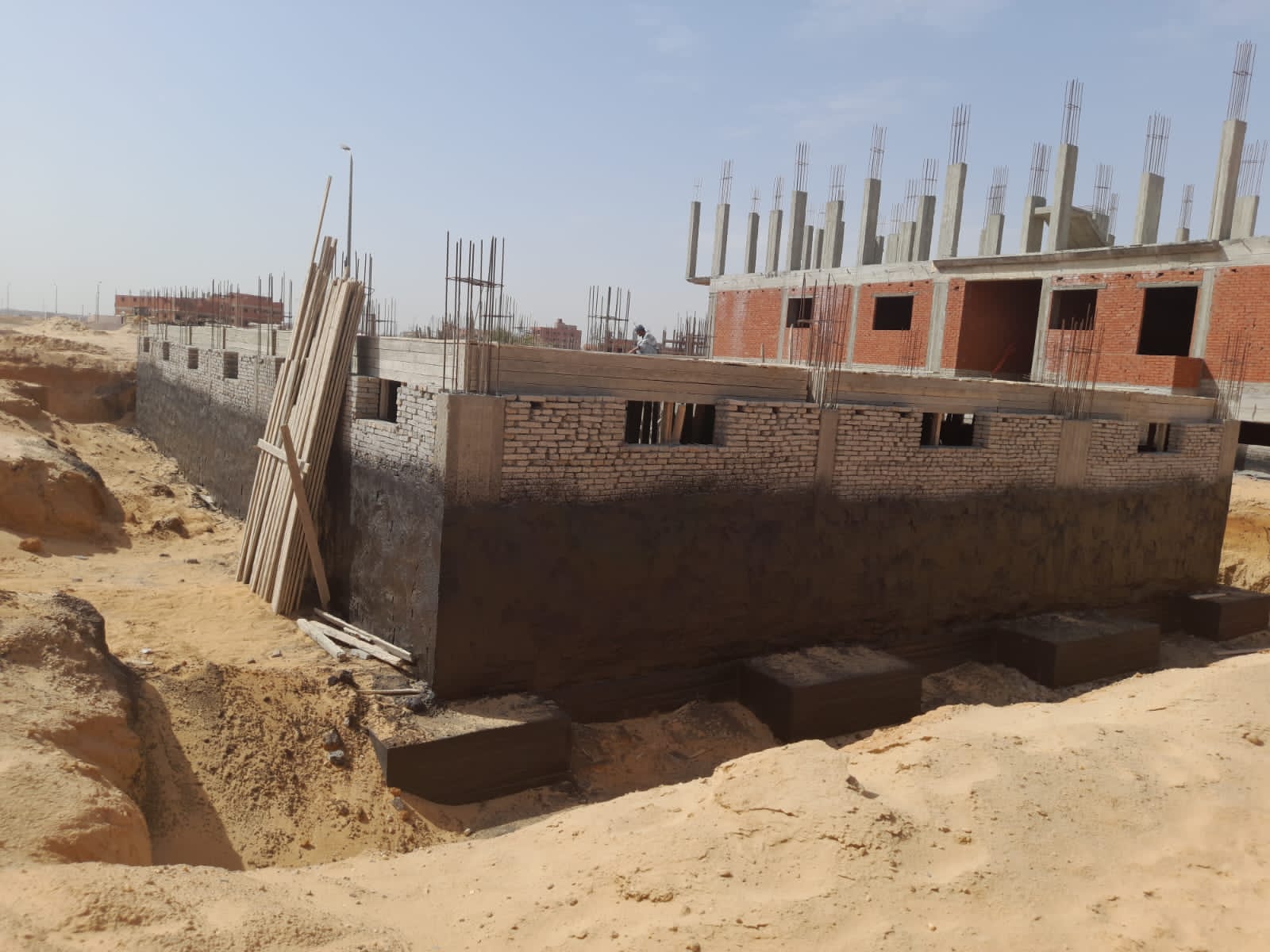

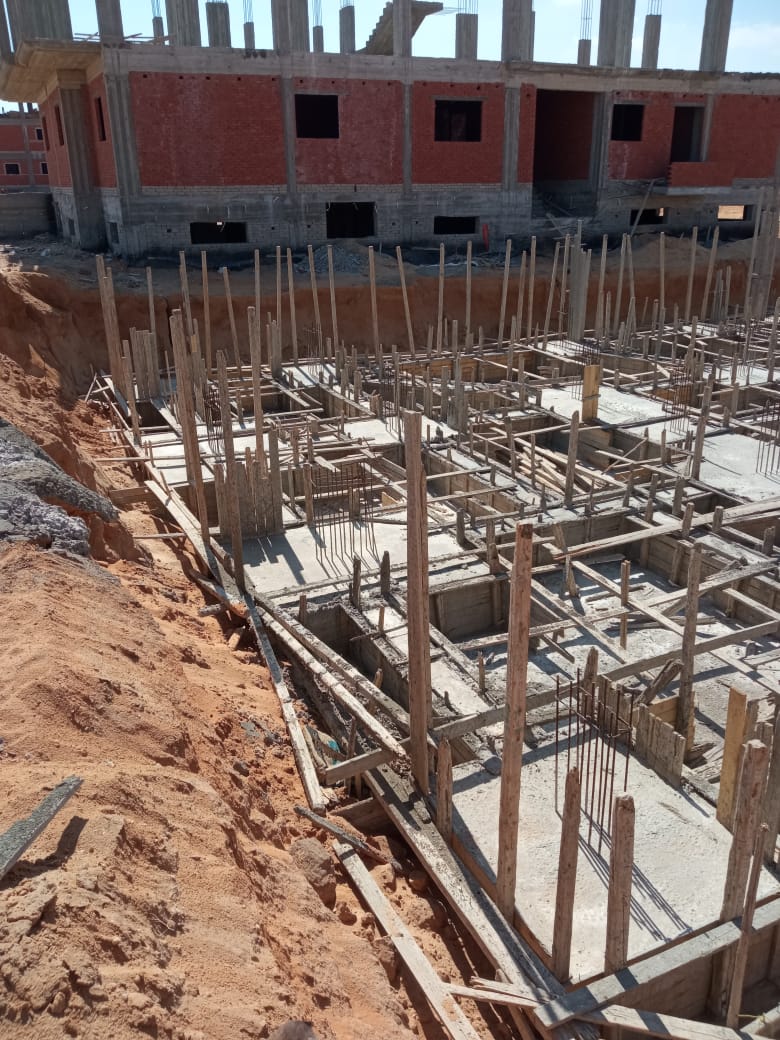

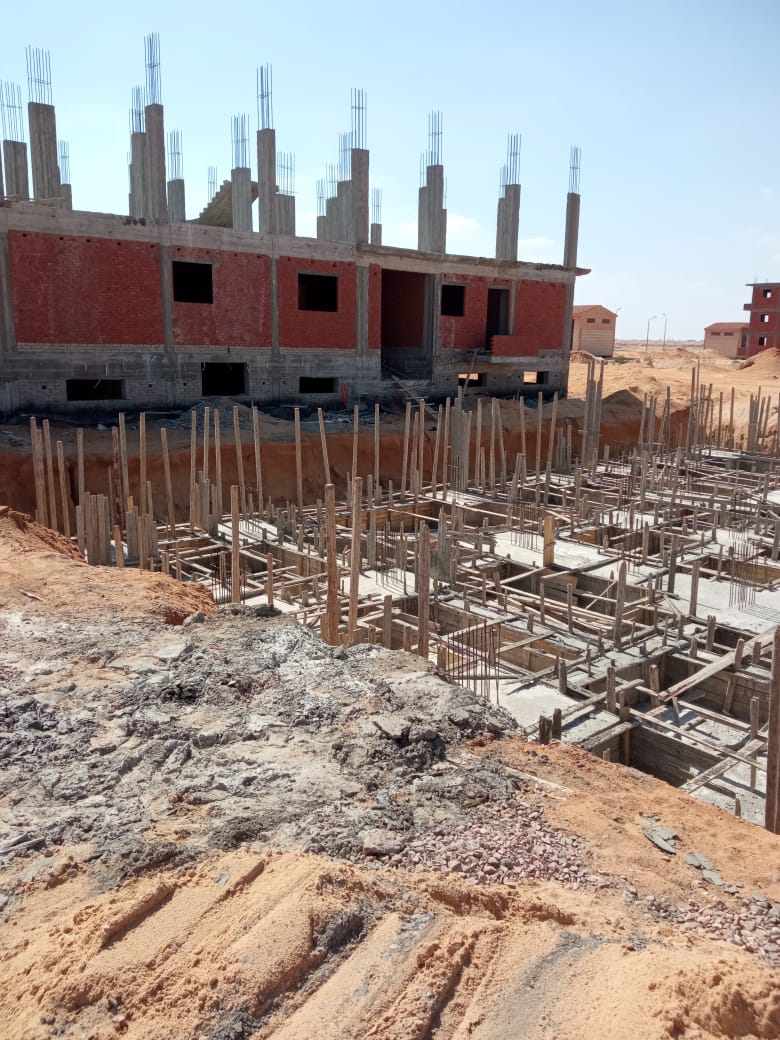

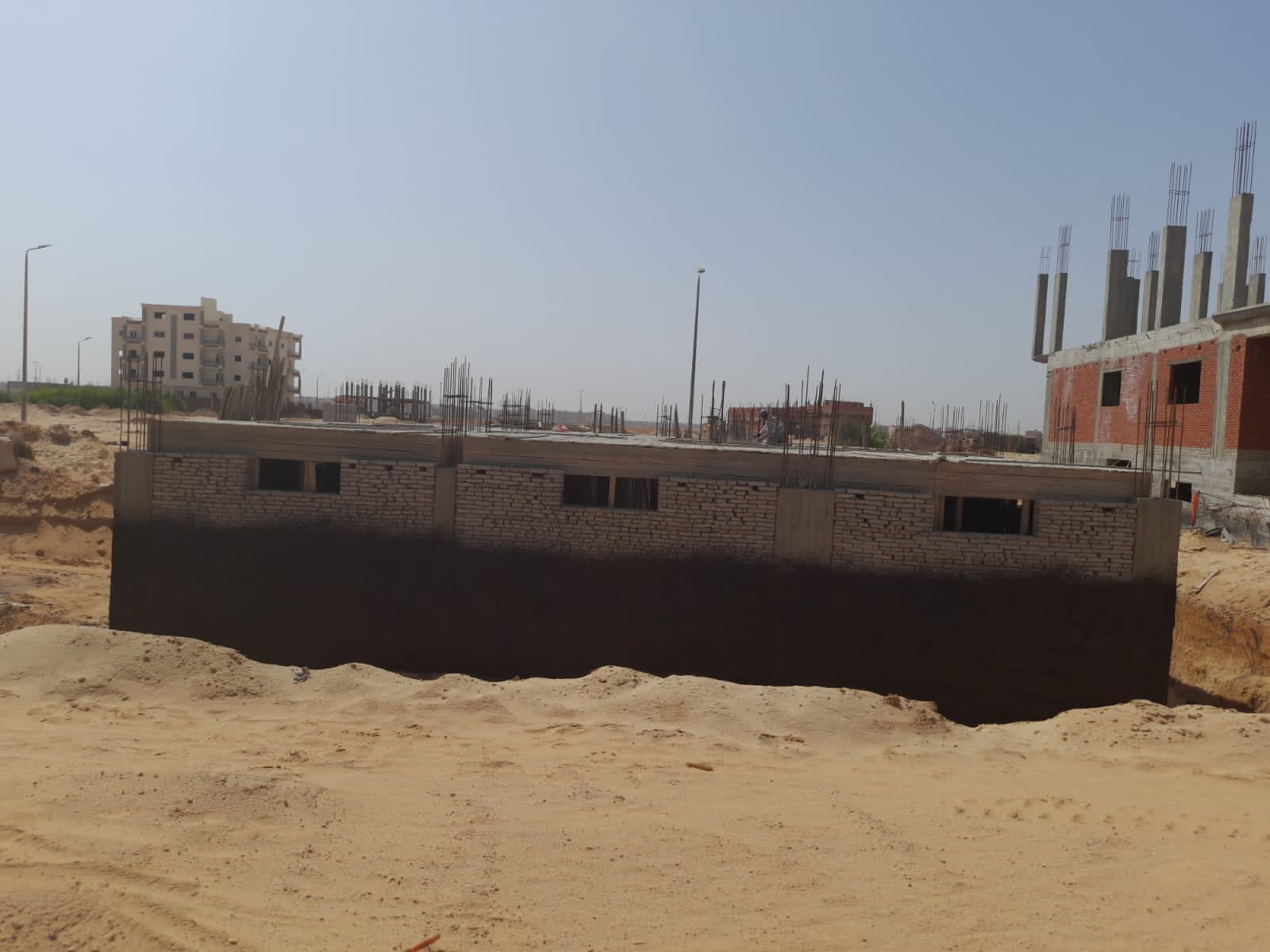

Footings insulation
February 2, 2024

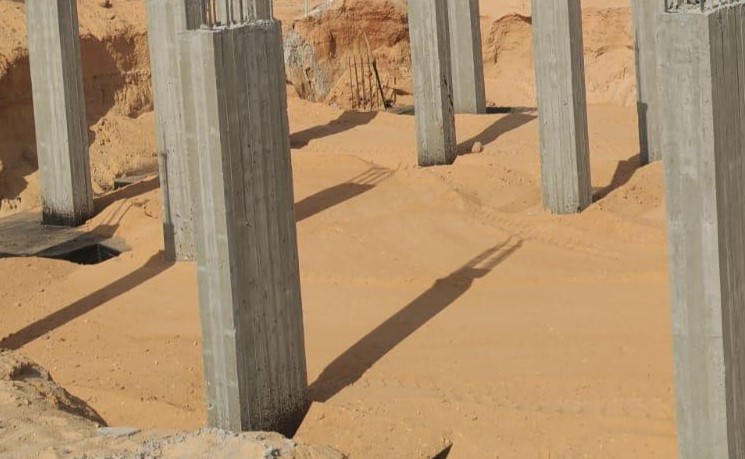

Backfilling around foundations
February 10, 2024

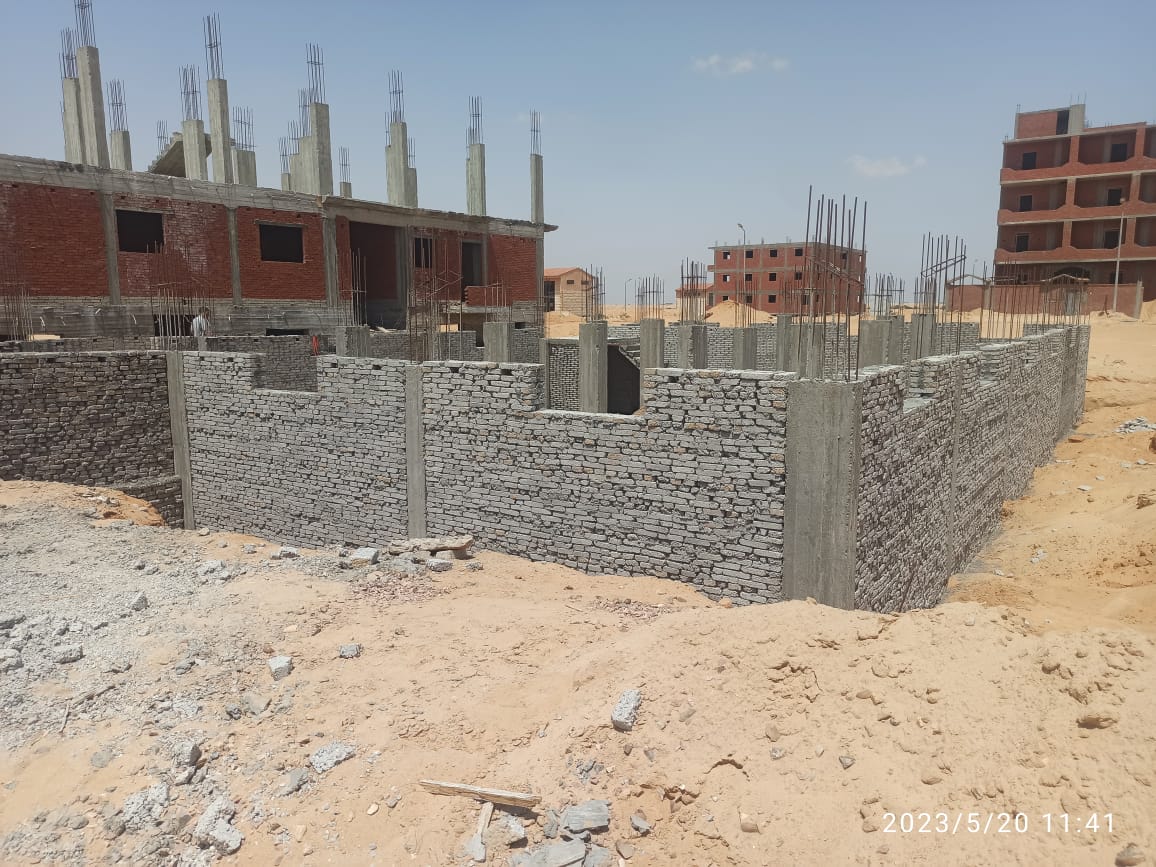

Basement columns
February 11, 2024

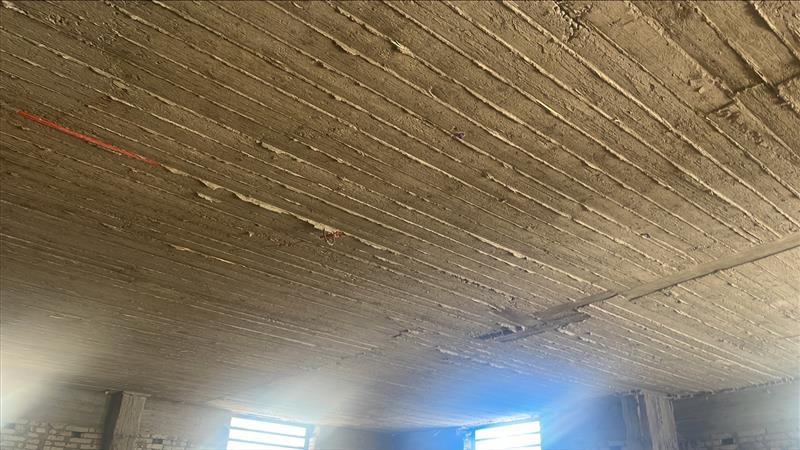

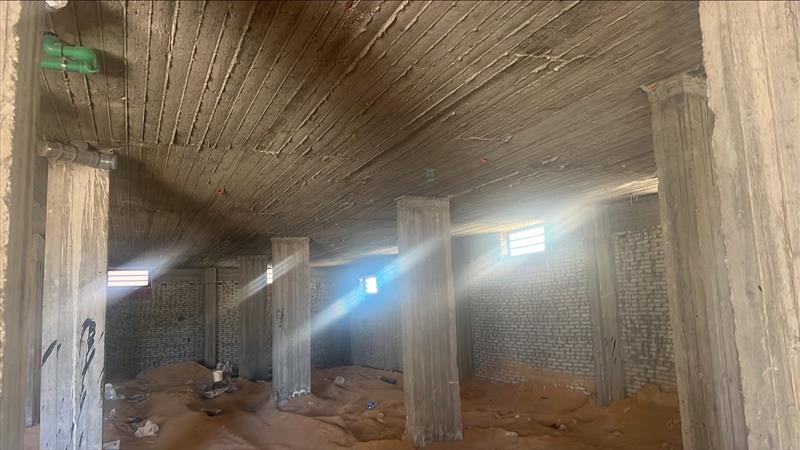

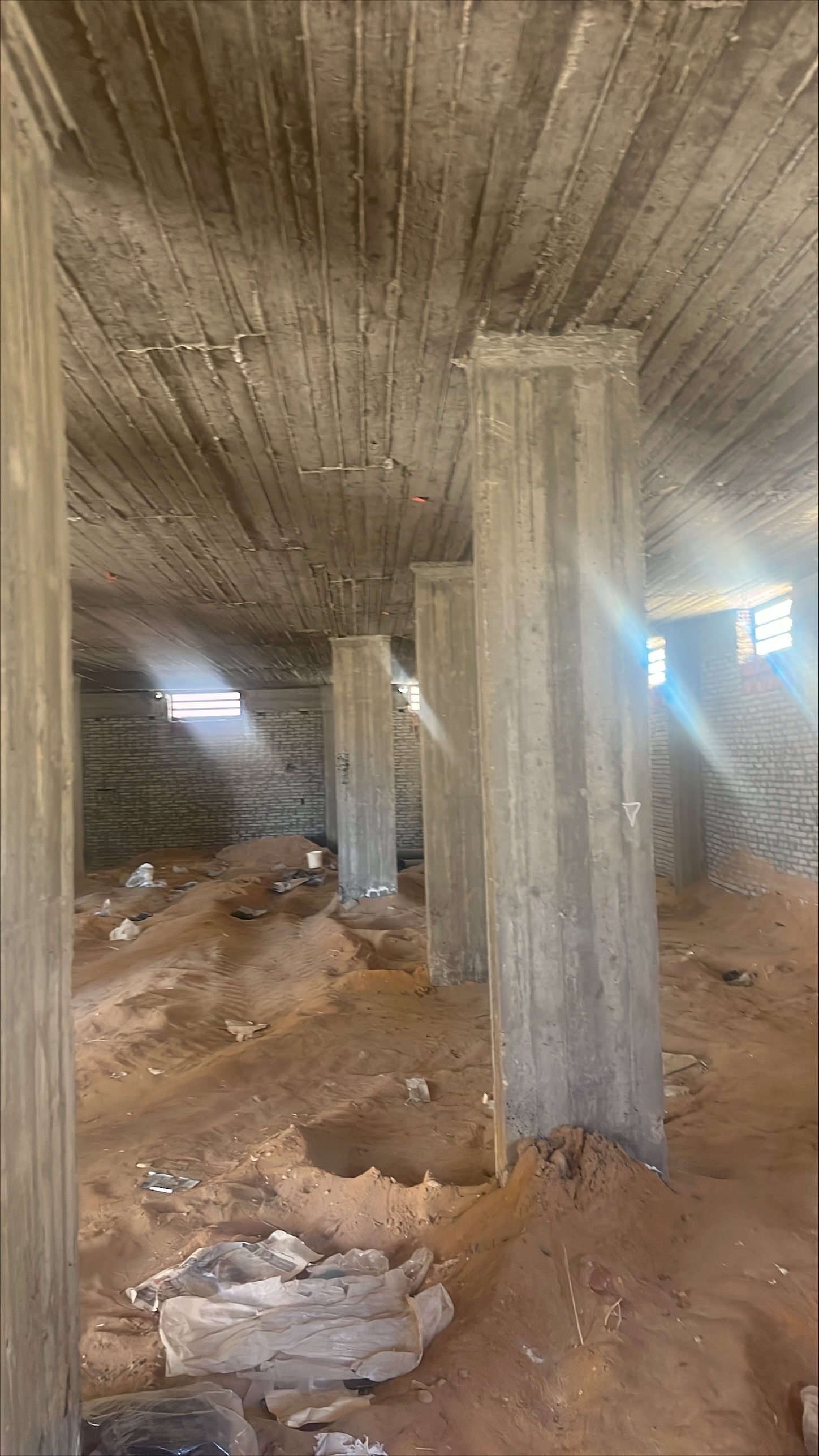

Basement slab
March 21, 2024

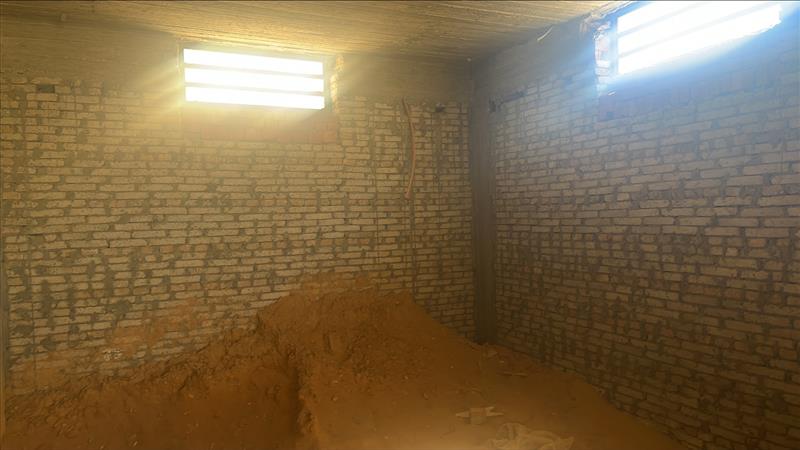

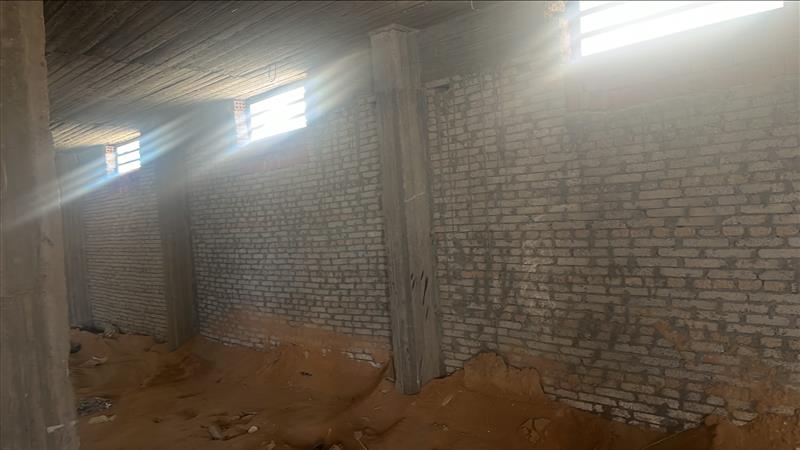

Basement walls
April 2, 2024

Concrete works for the external wall
April 7, 2024

Wall Building works
April 8, 2024

Ground floor columns
April 19, 2024

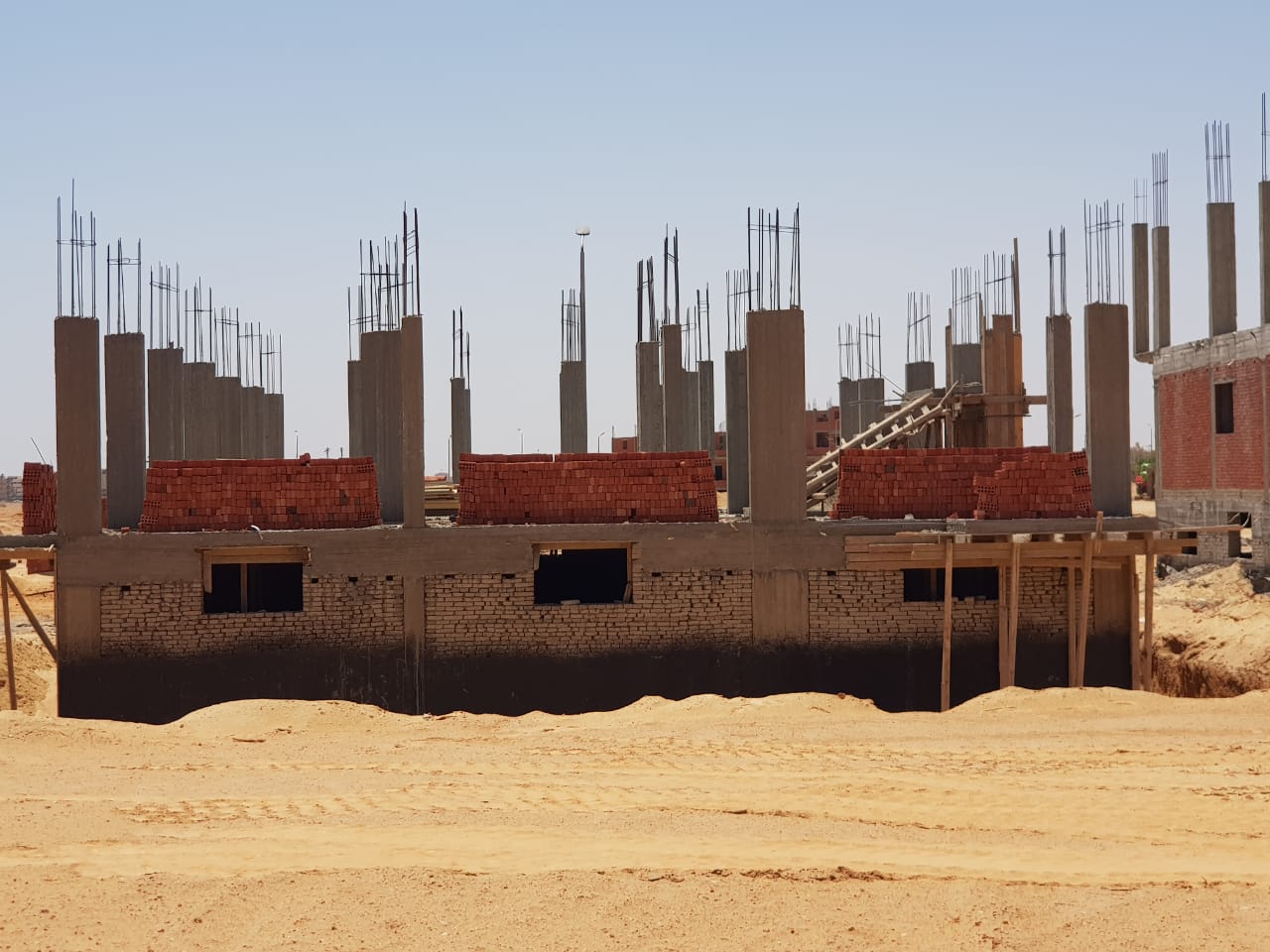

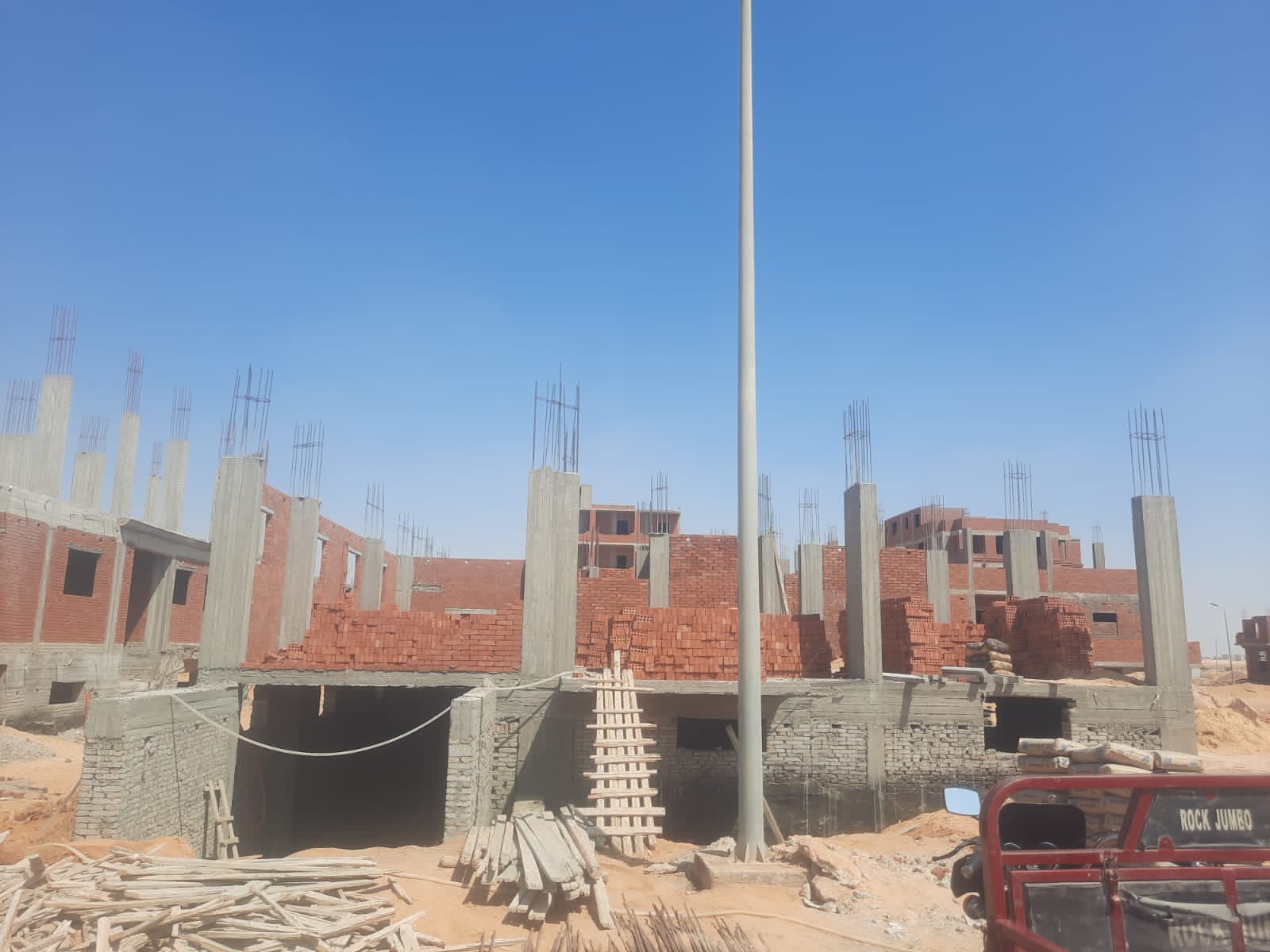

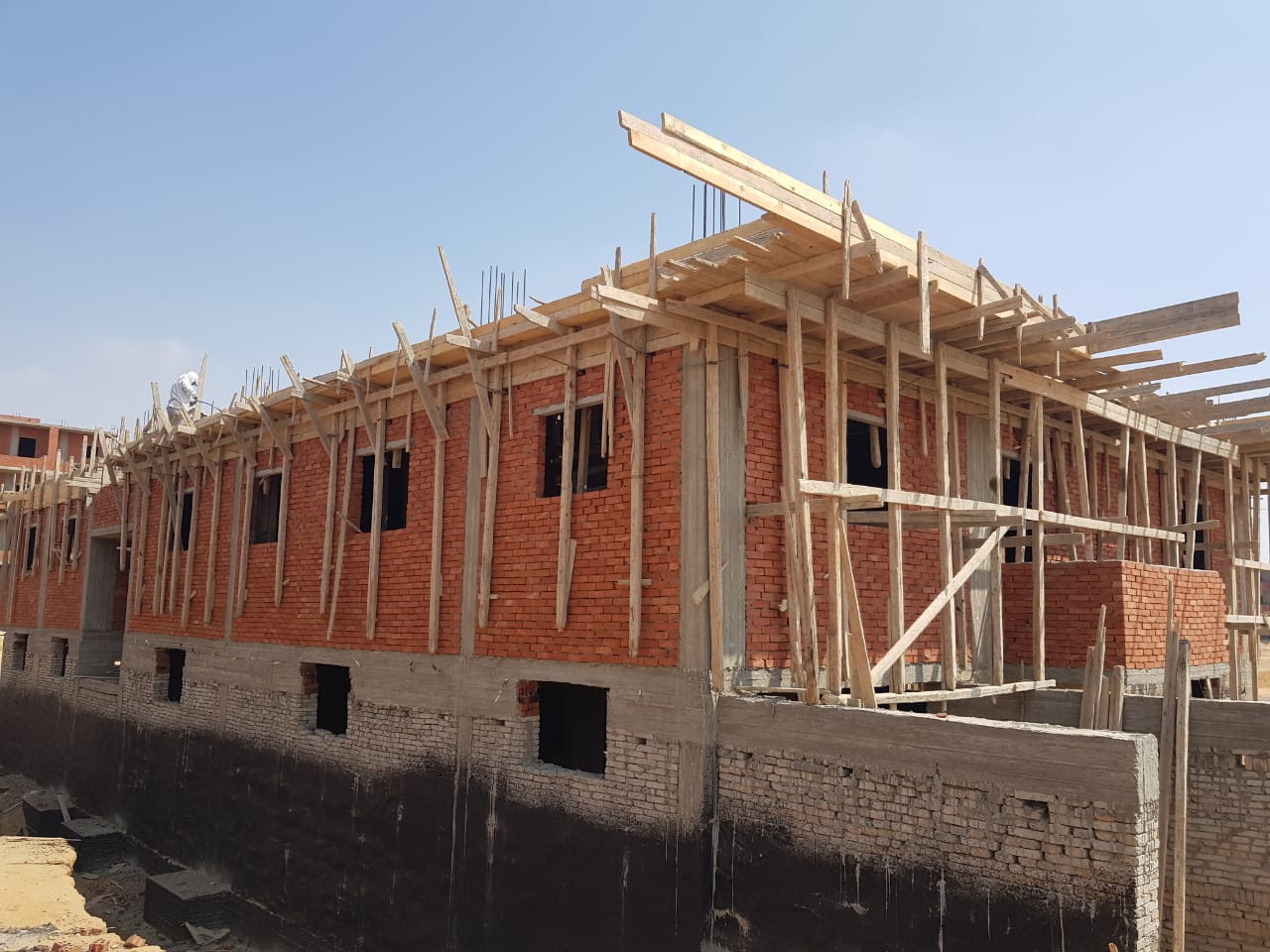

Ground floor walls
April 25, 2024

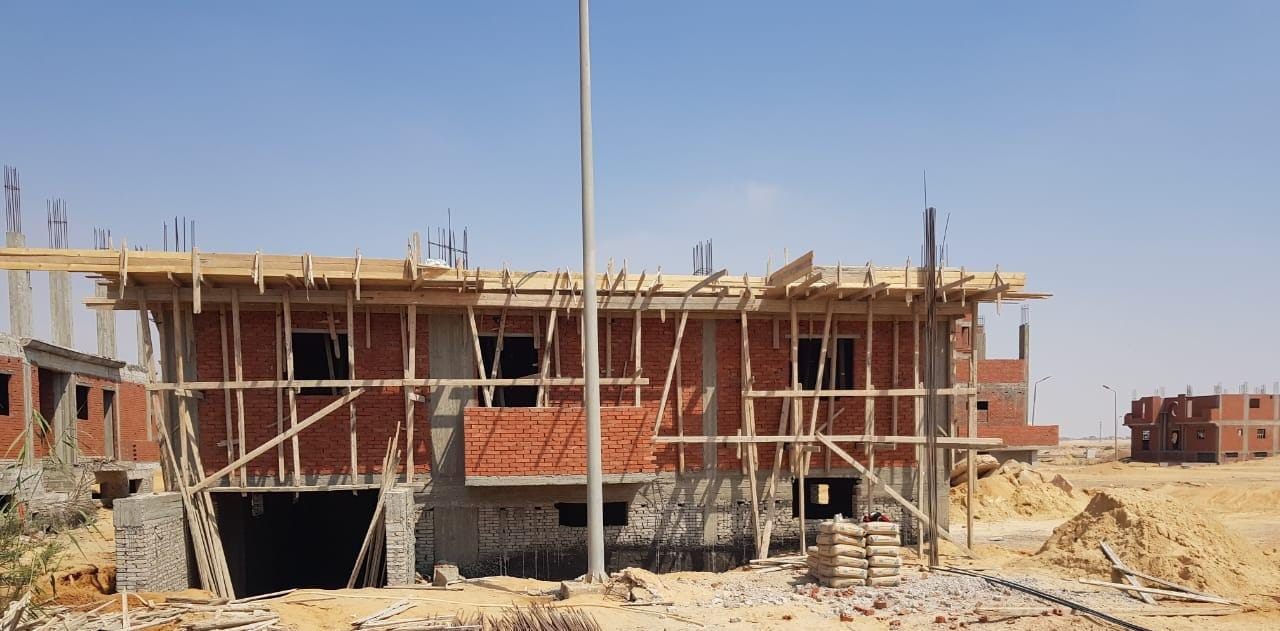

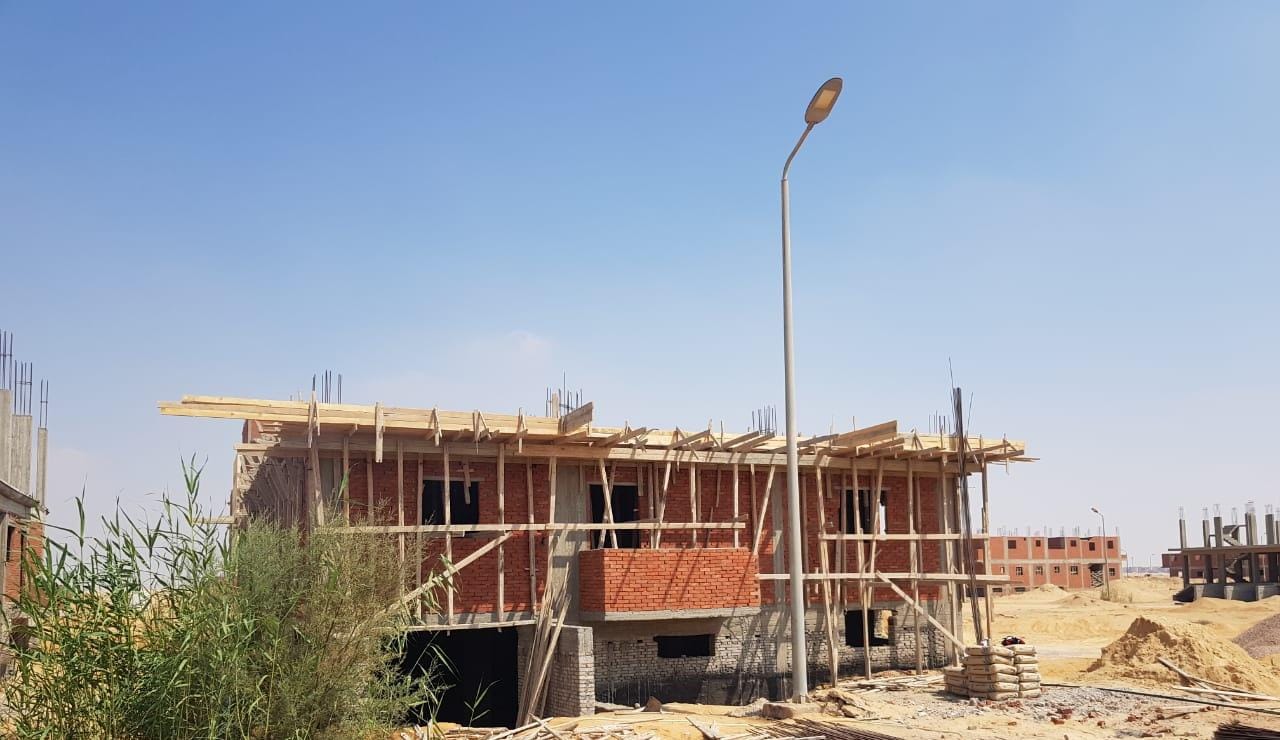

Ground floor slab
May 5, 2024

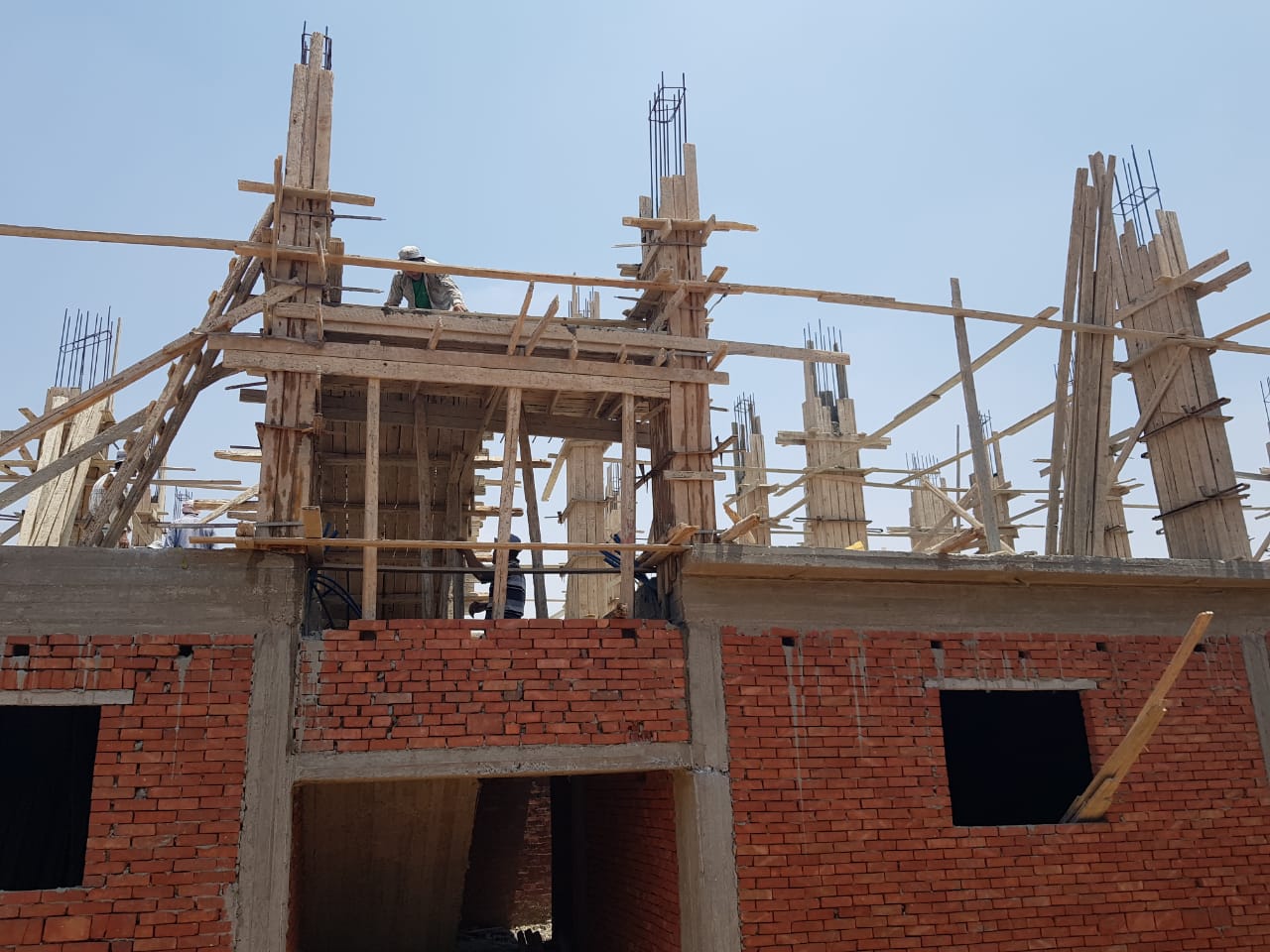

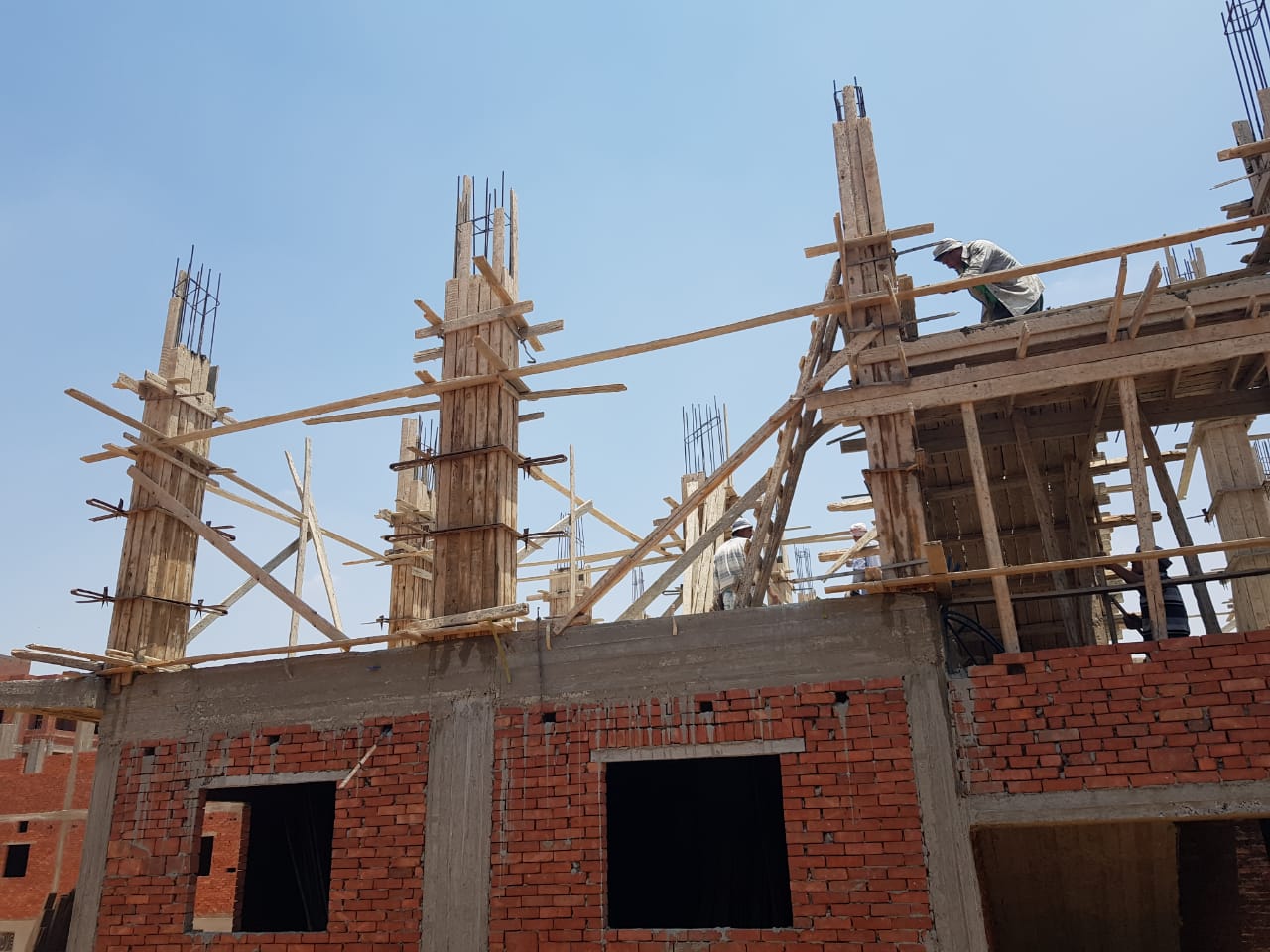

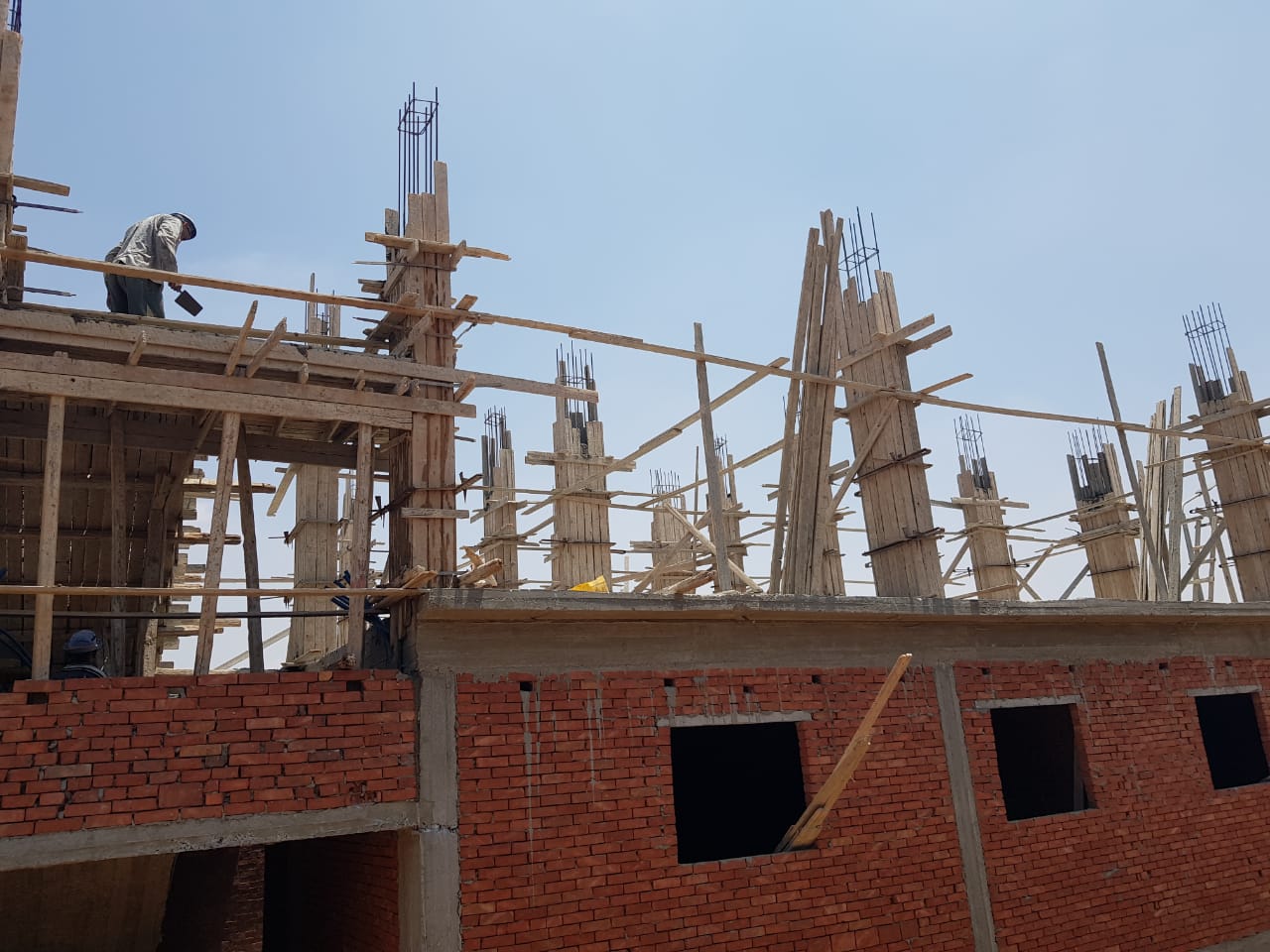

First floor columns
May 15, 2024

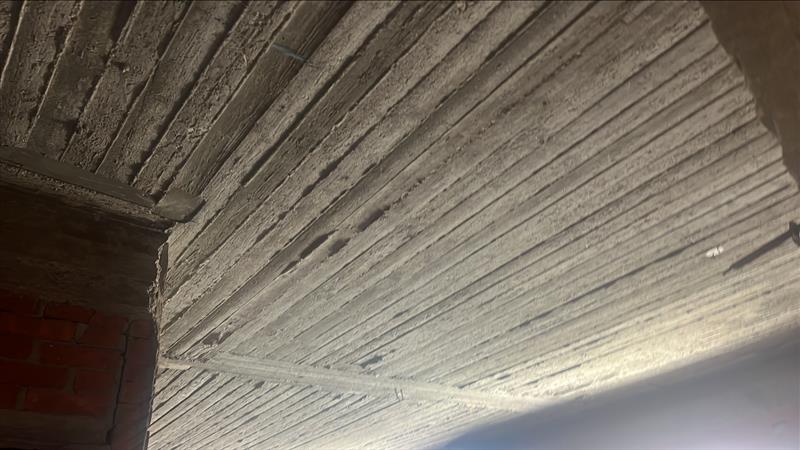

First floor slab

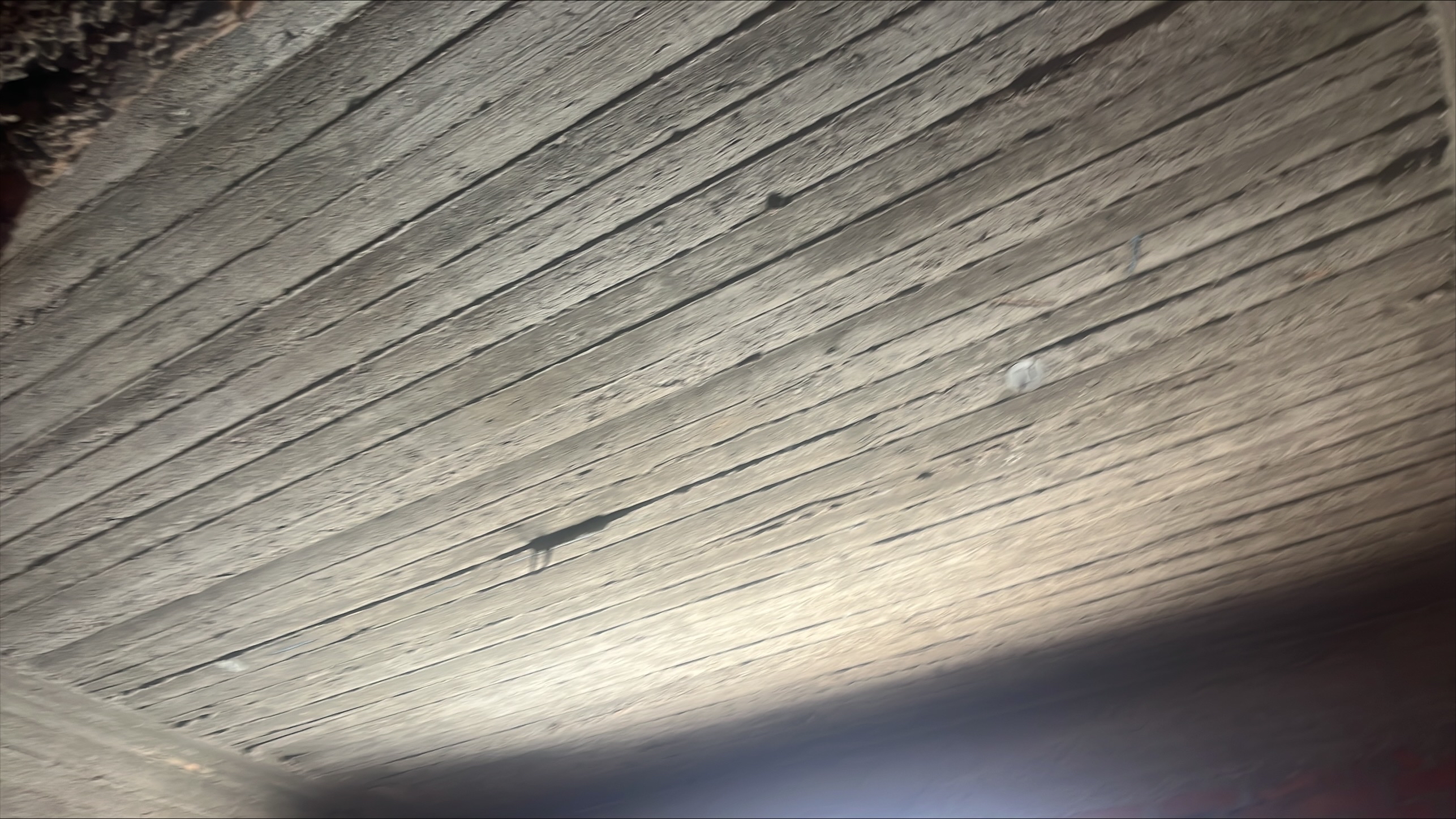

May 23, 2024

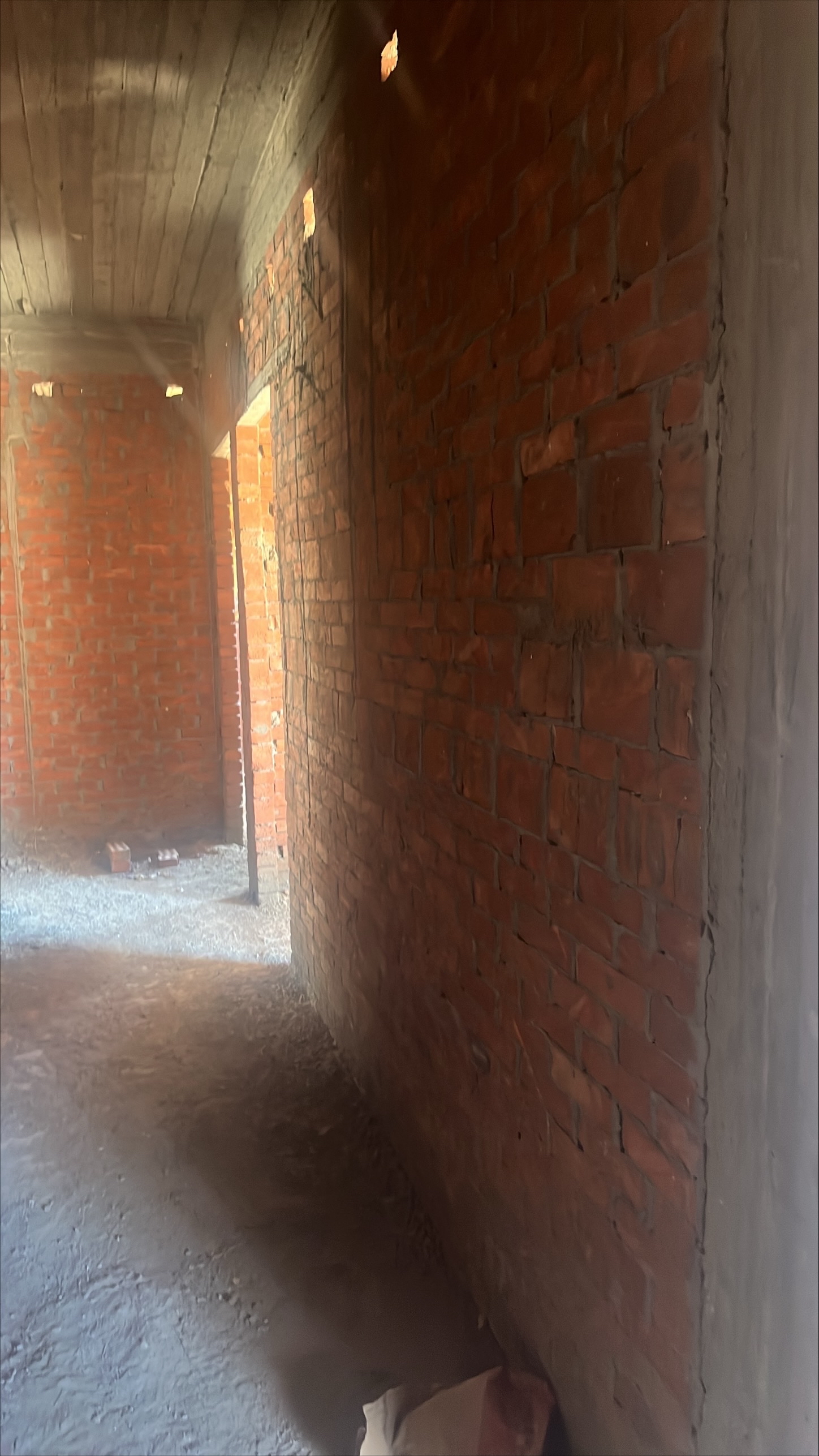

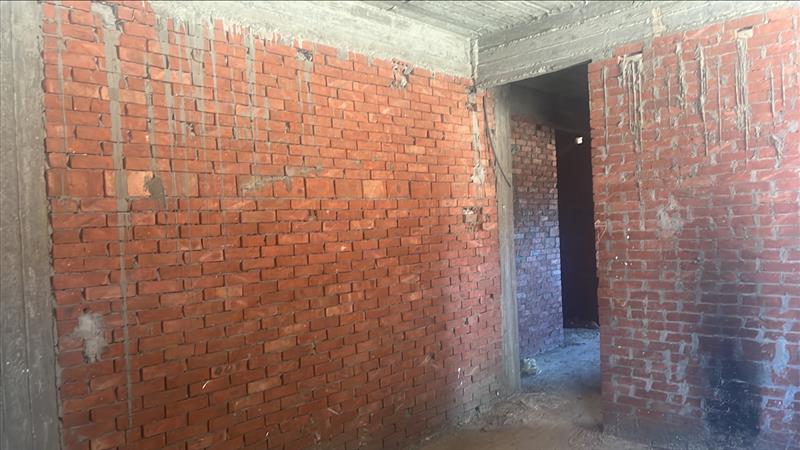

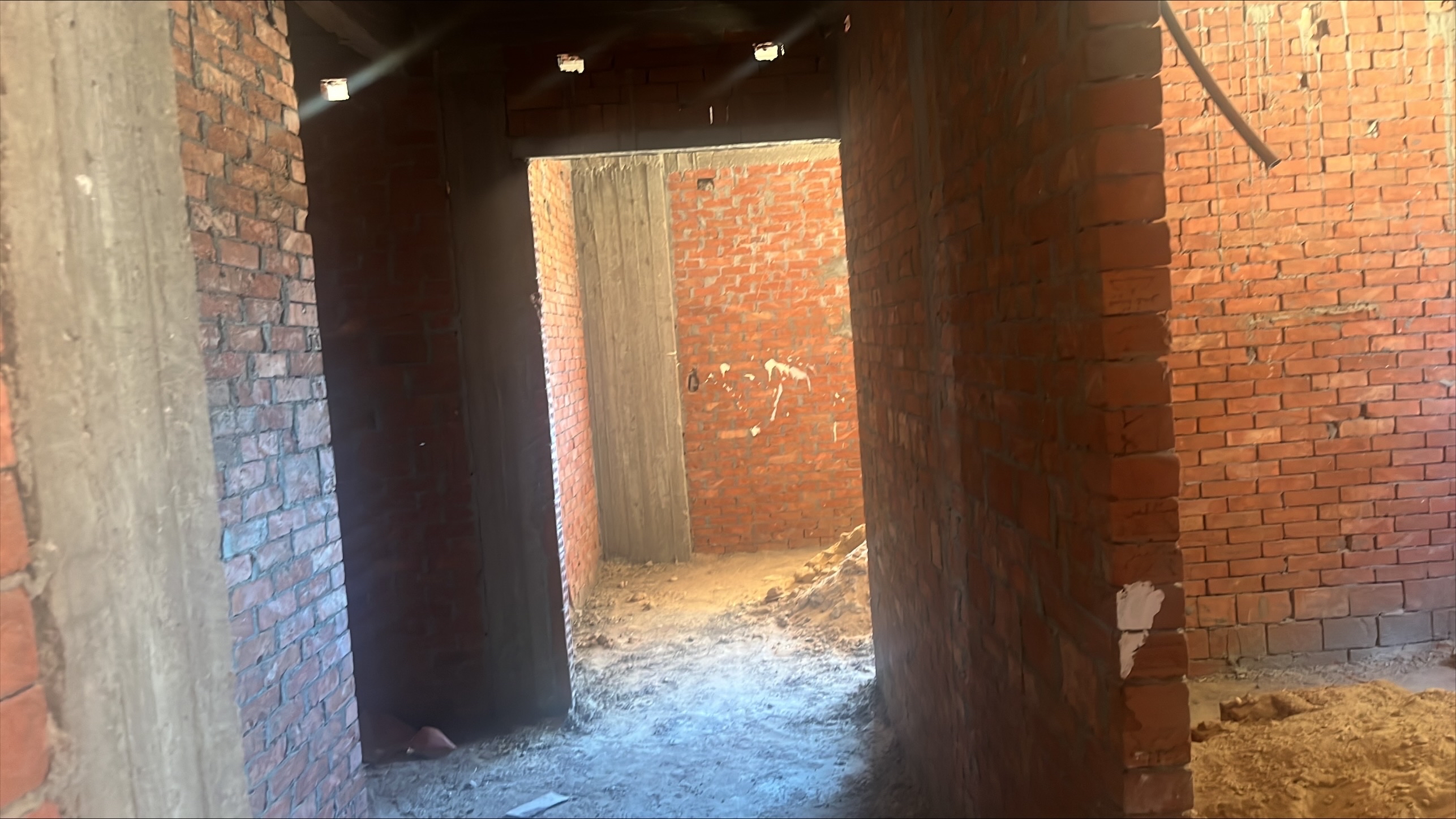

First floor walls
June 1, 2024

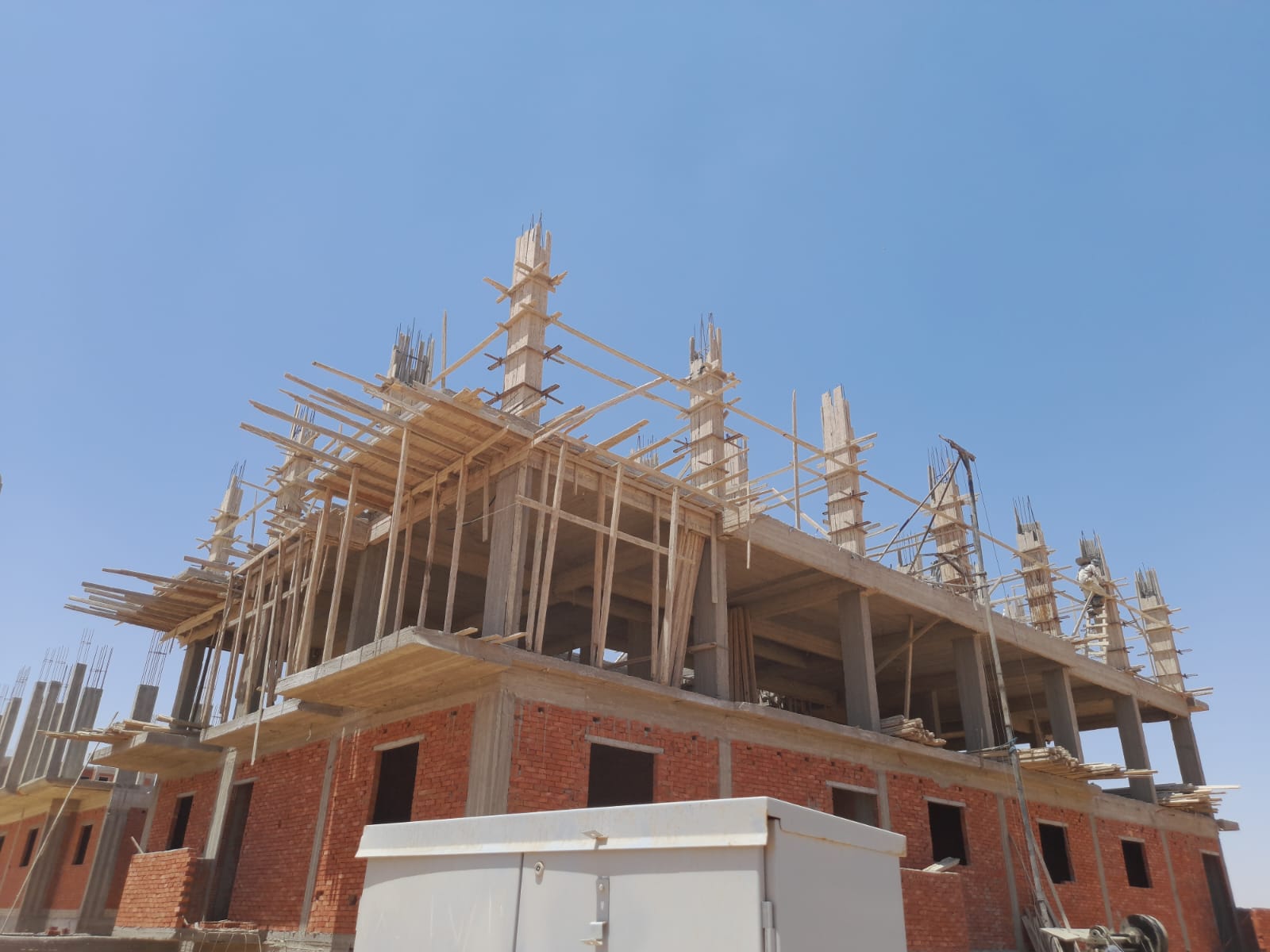

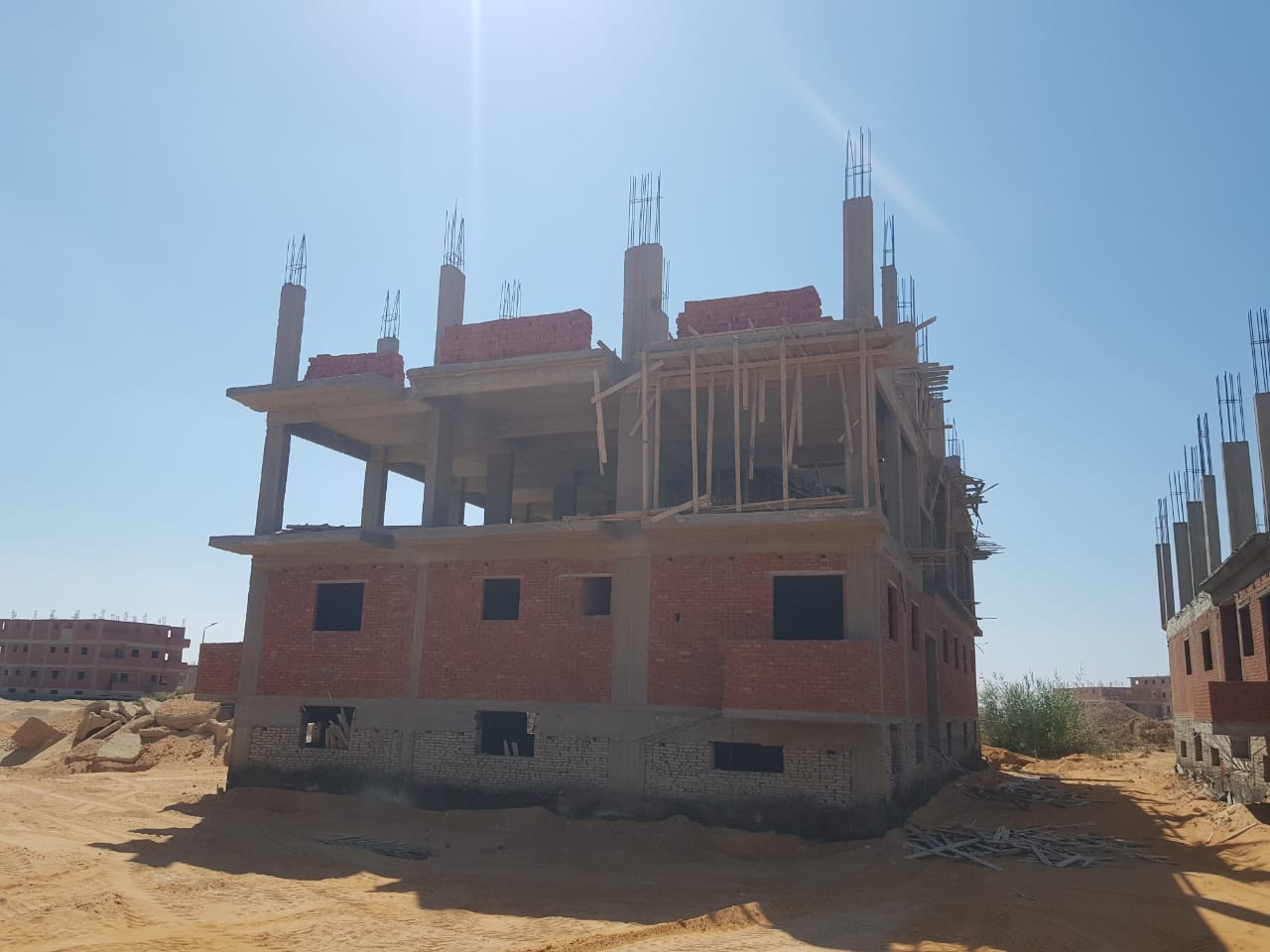

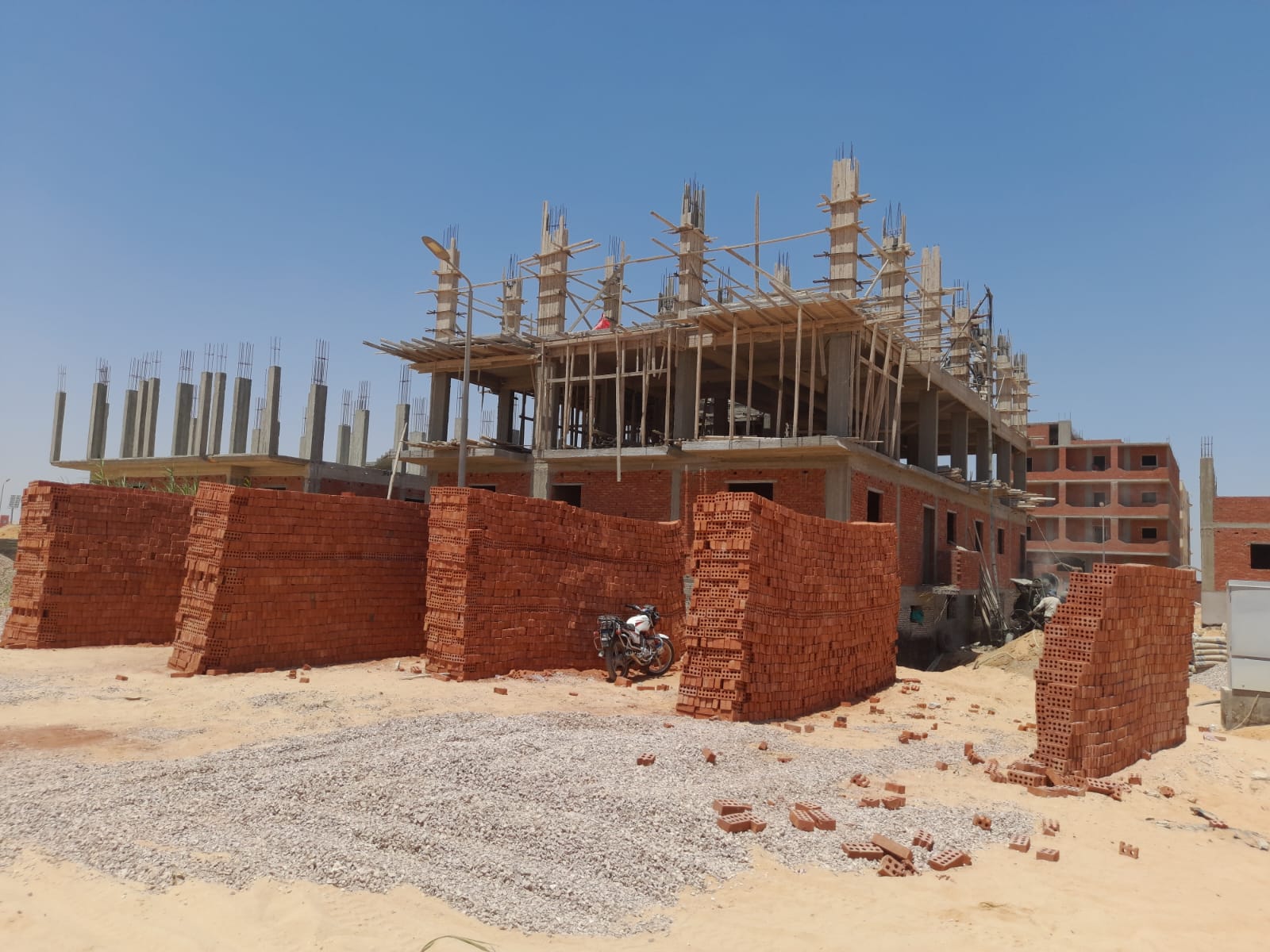

Second floor columns
June 14, 2024

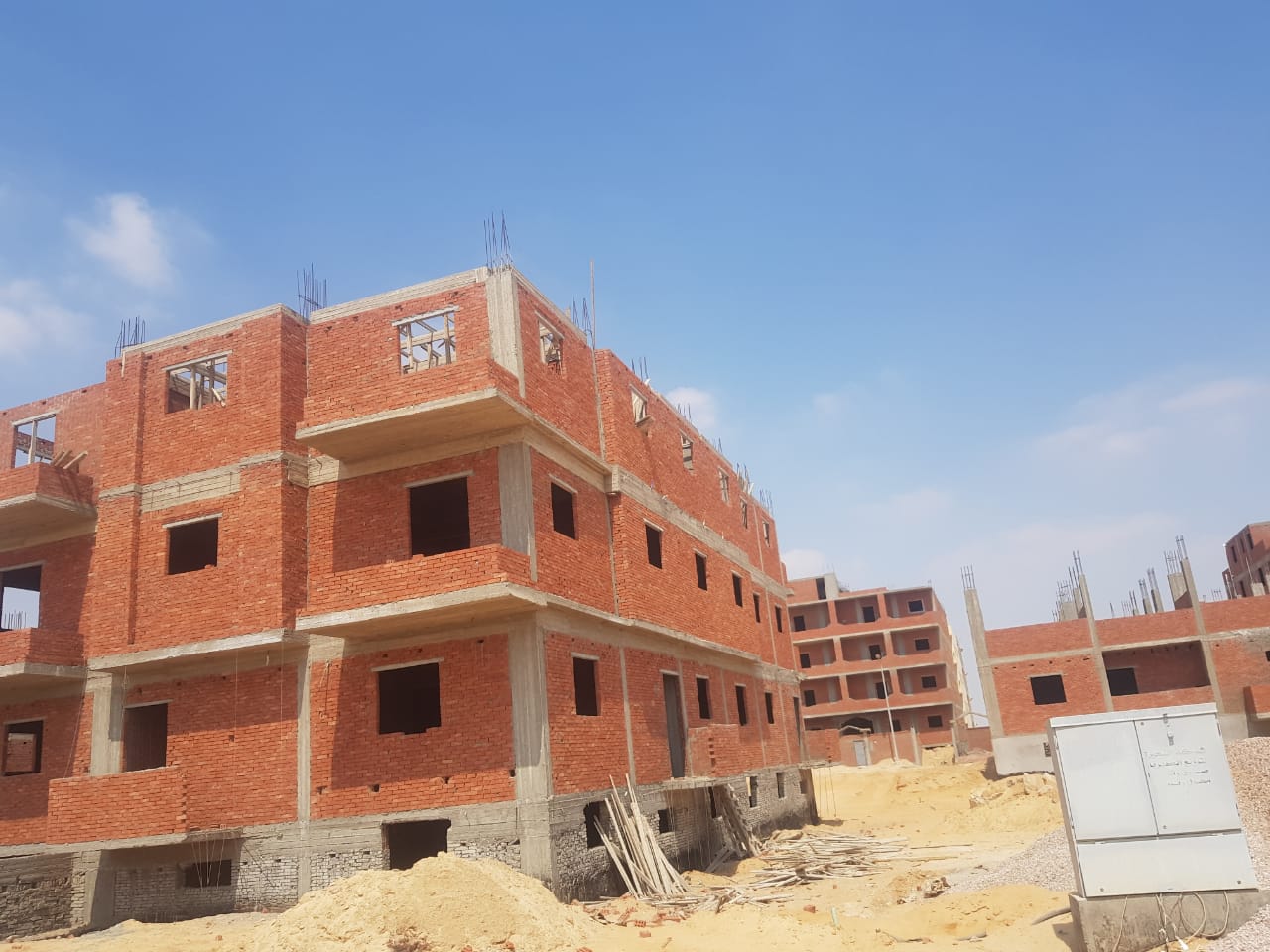

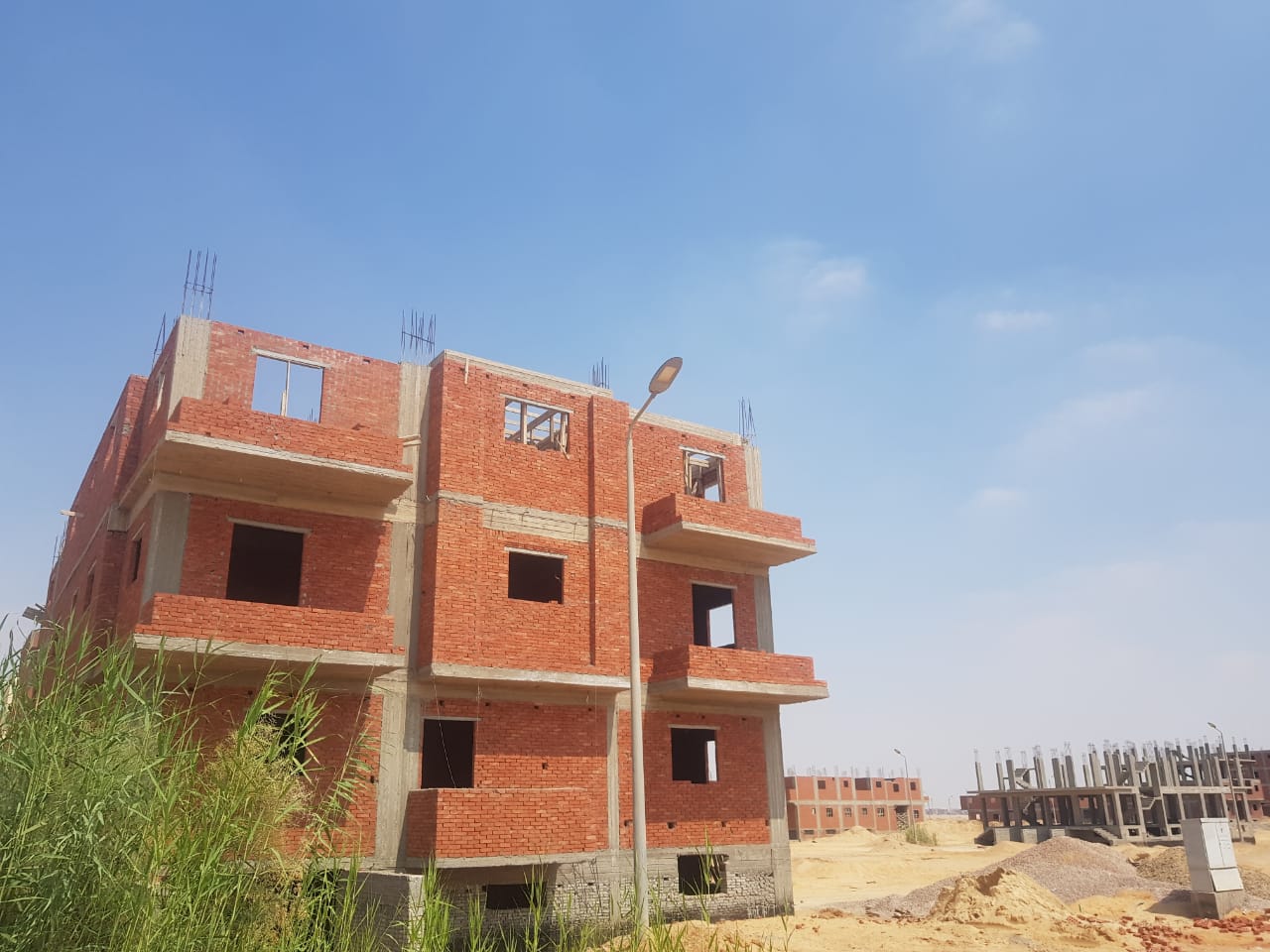

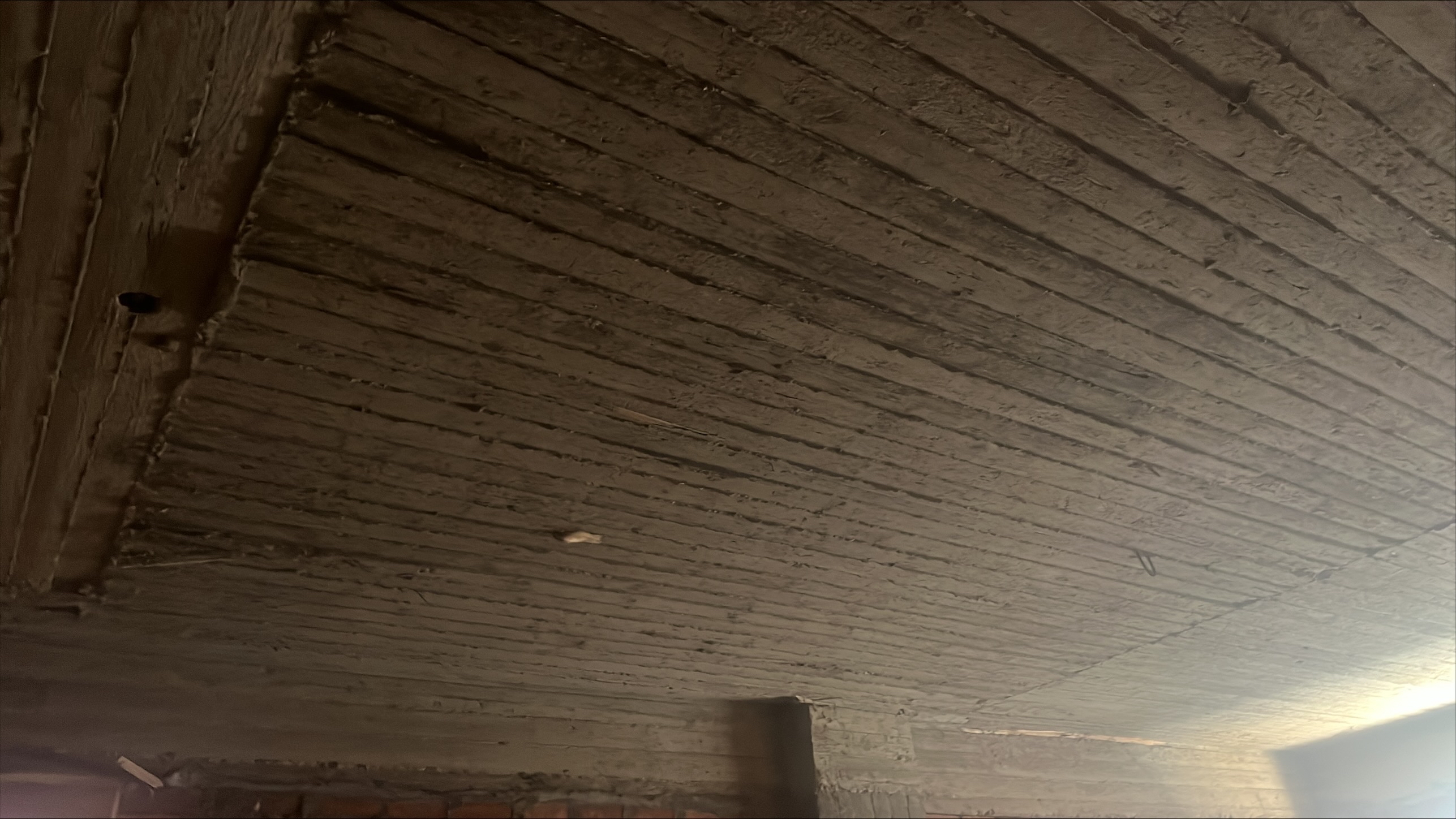

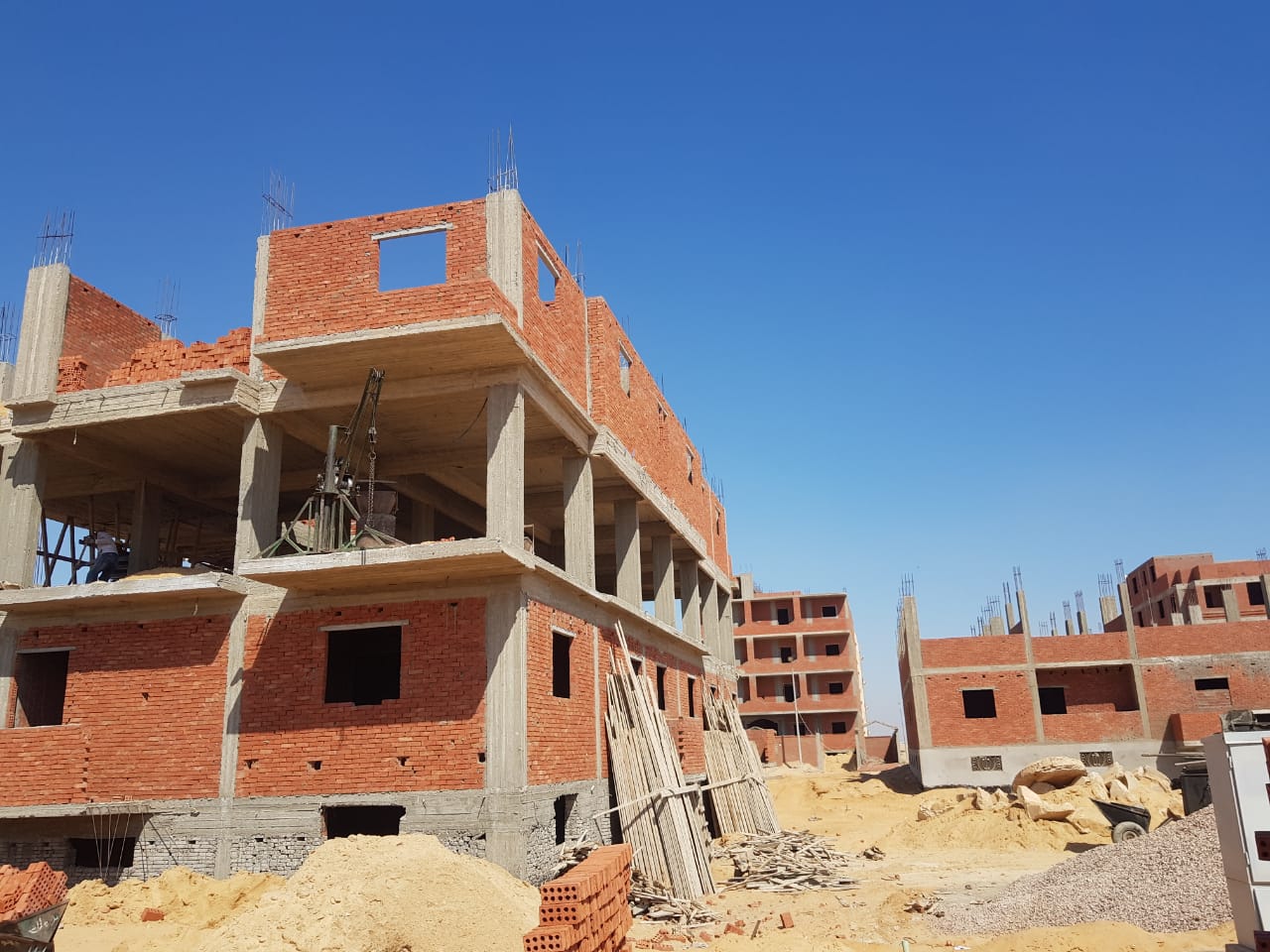

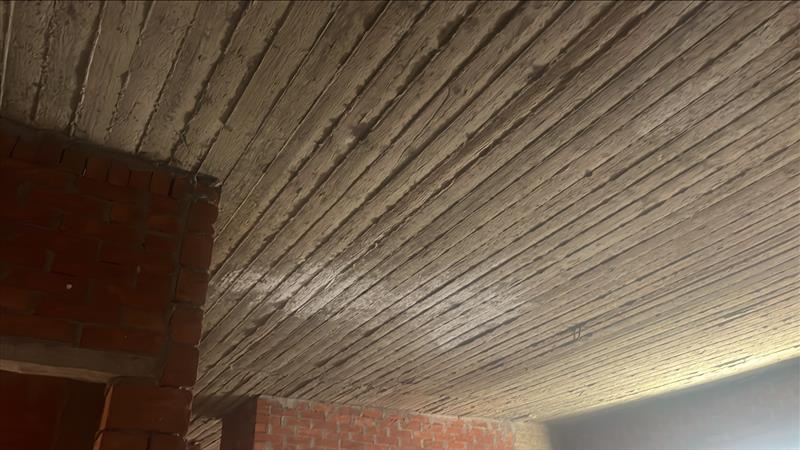

Second floor slab
June 24, 2024

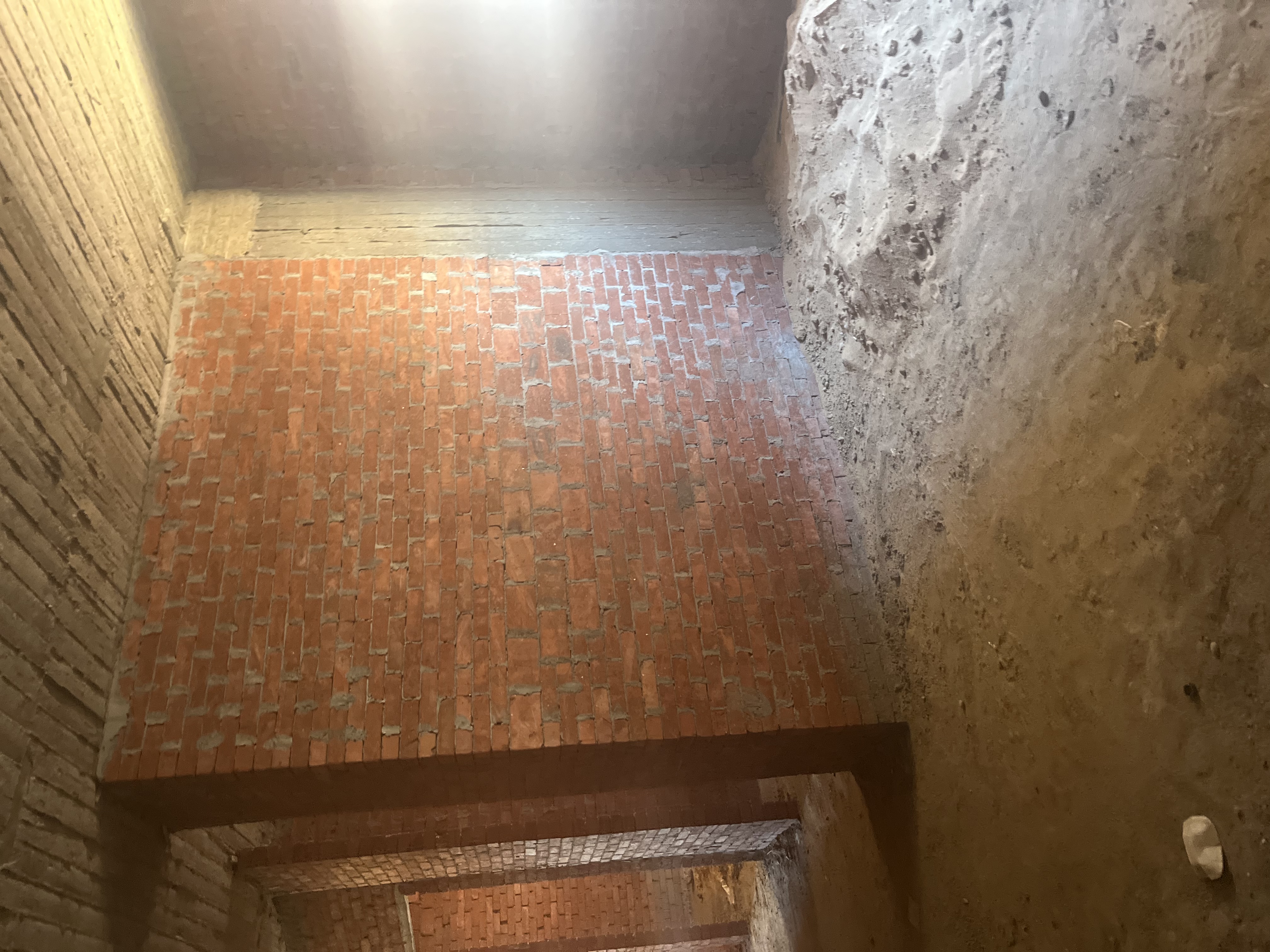

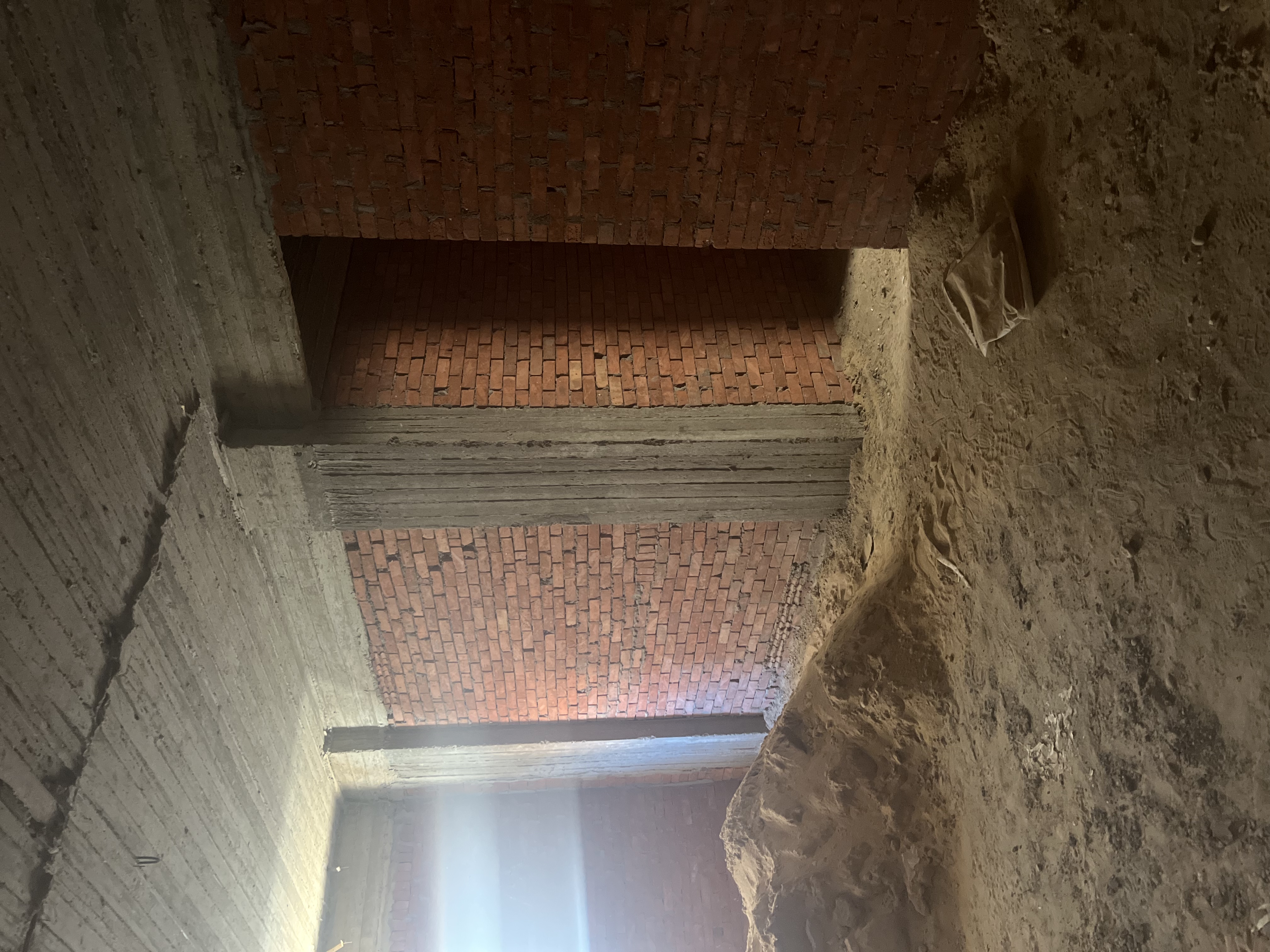

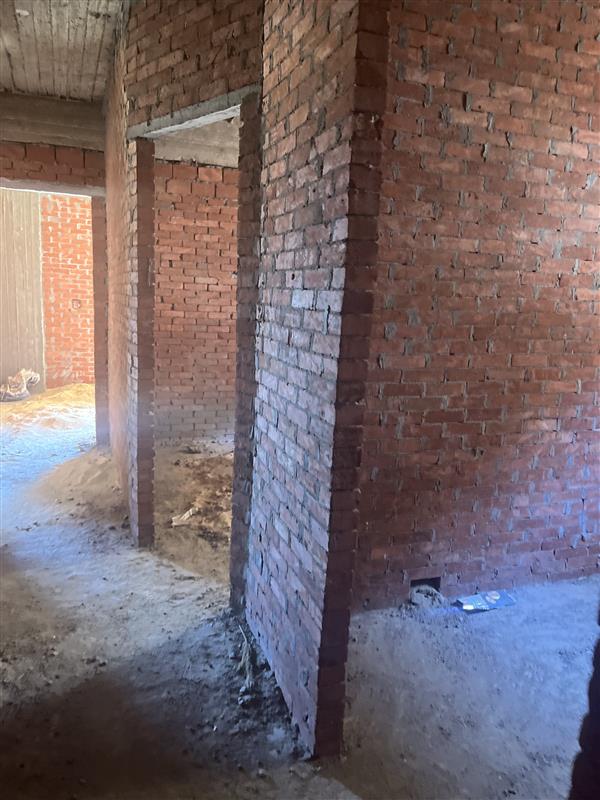

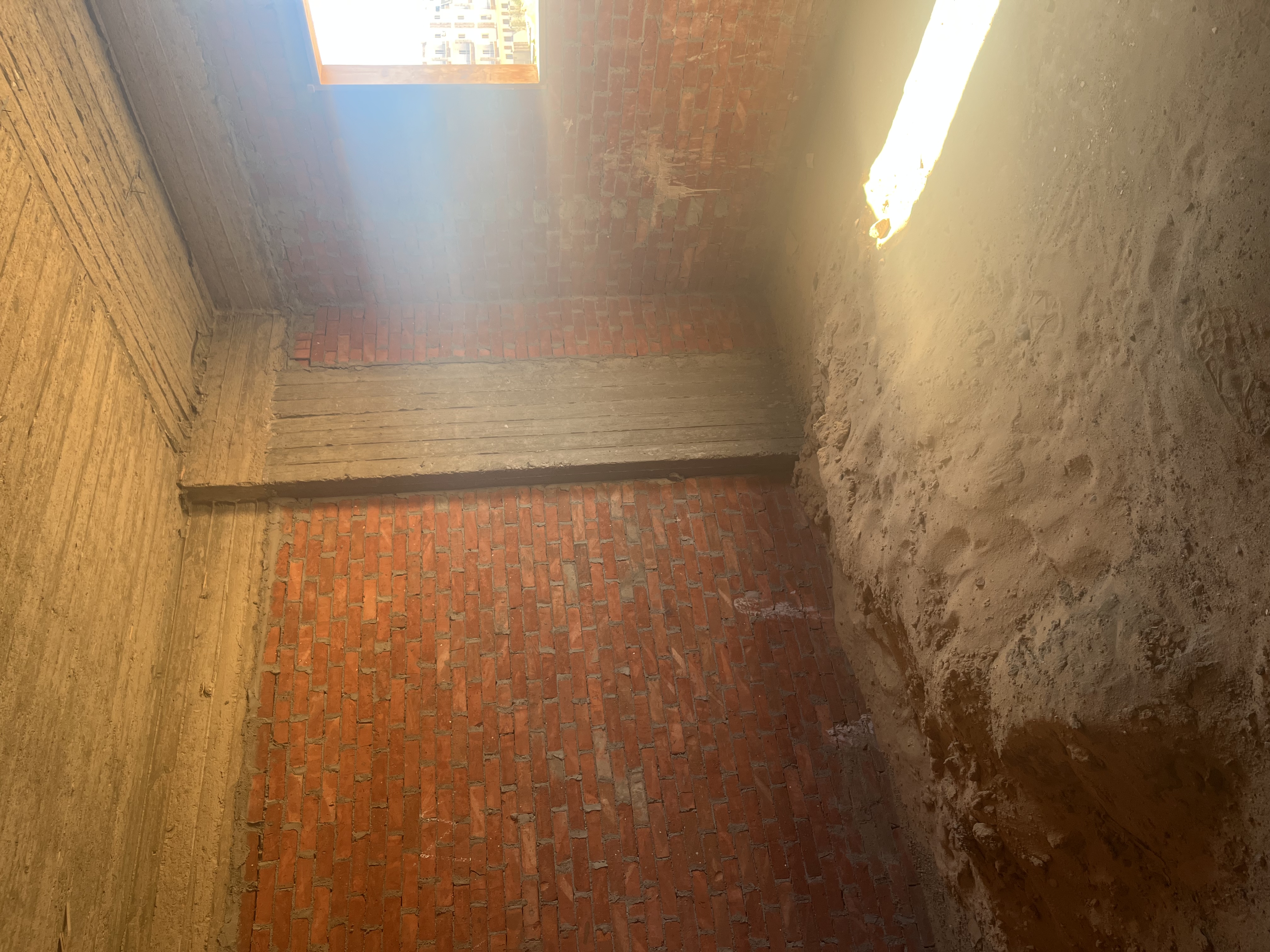

Second floor walls
July 1, 2024

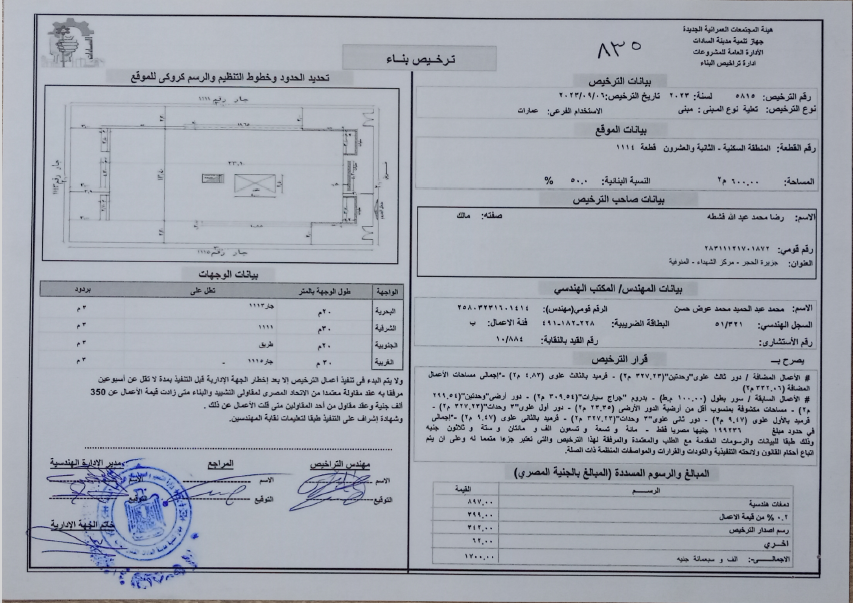

Third-floor addition permit
August 1, 2024

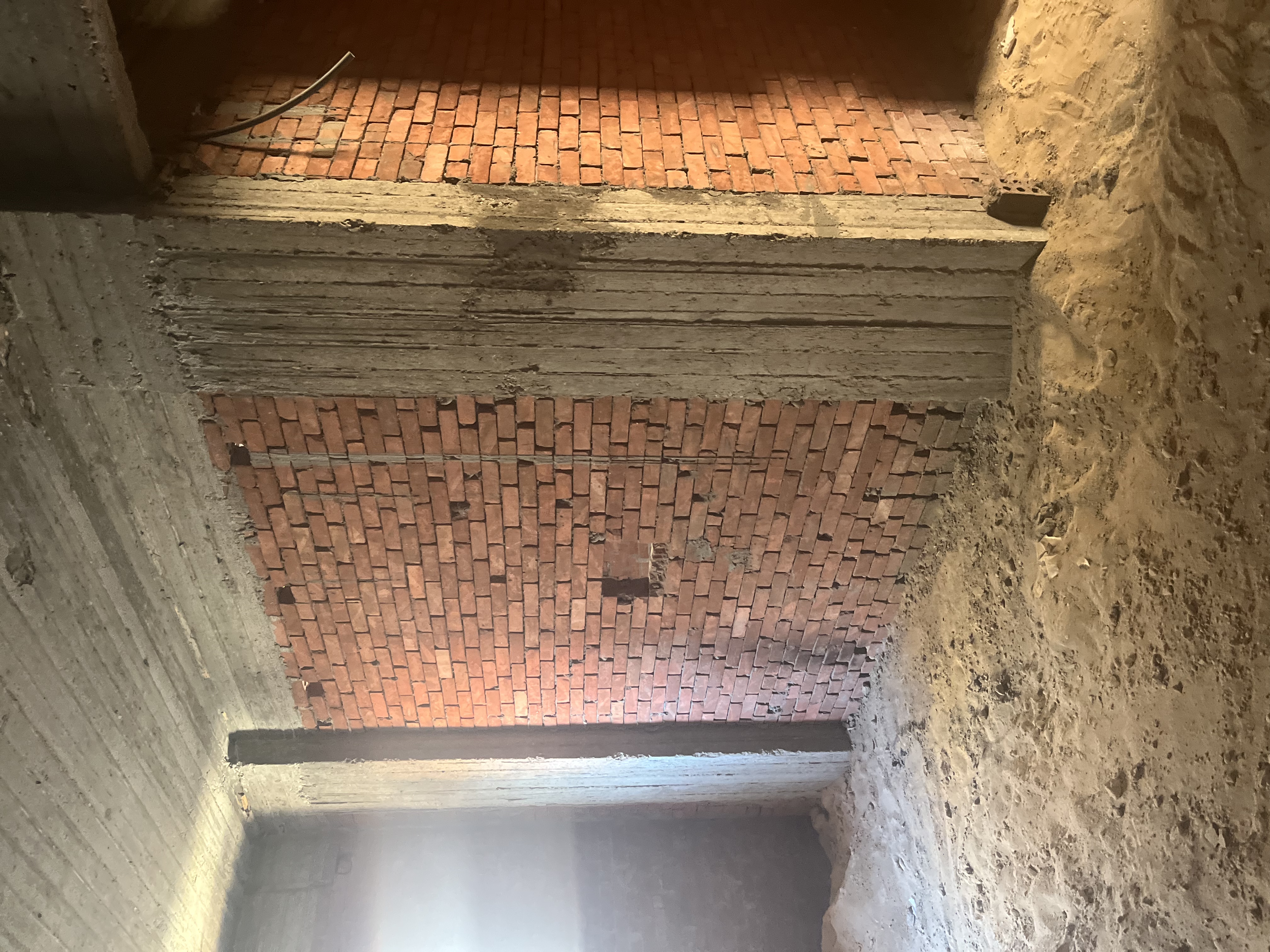

Third floor columns
August 15, 2024

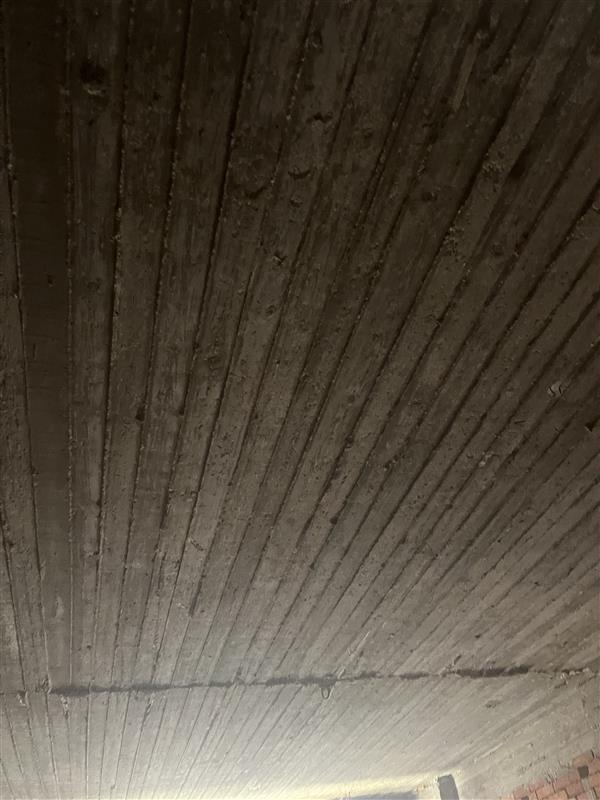

Third floor slab
August 25, 2024

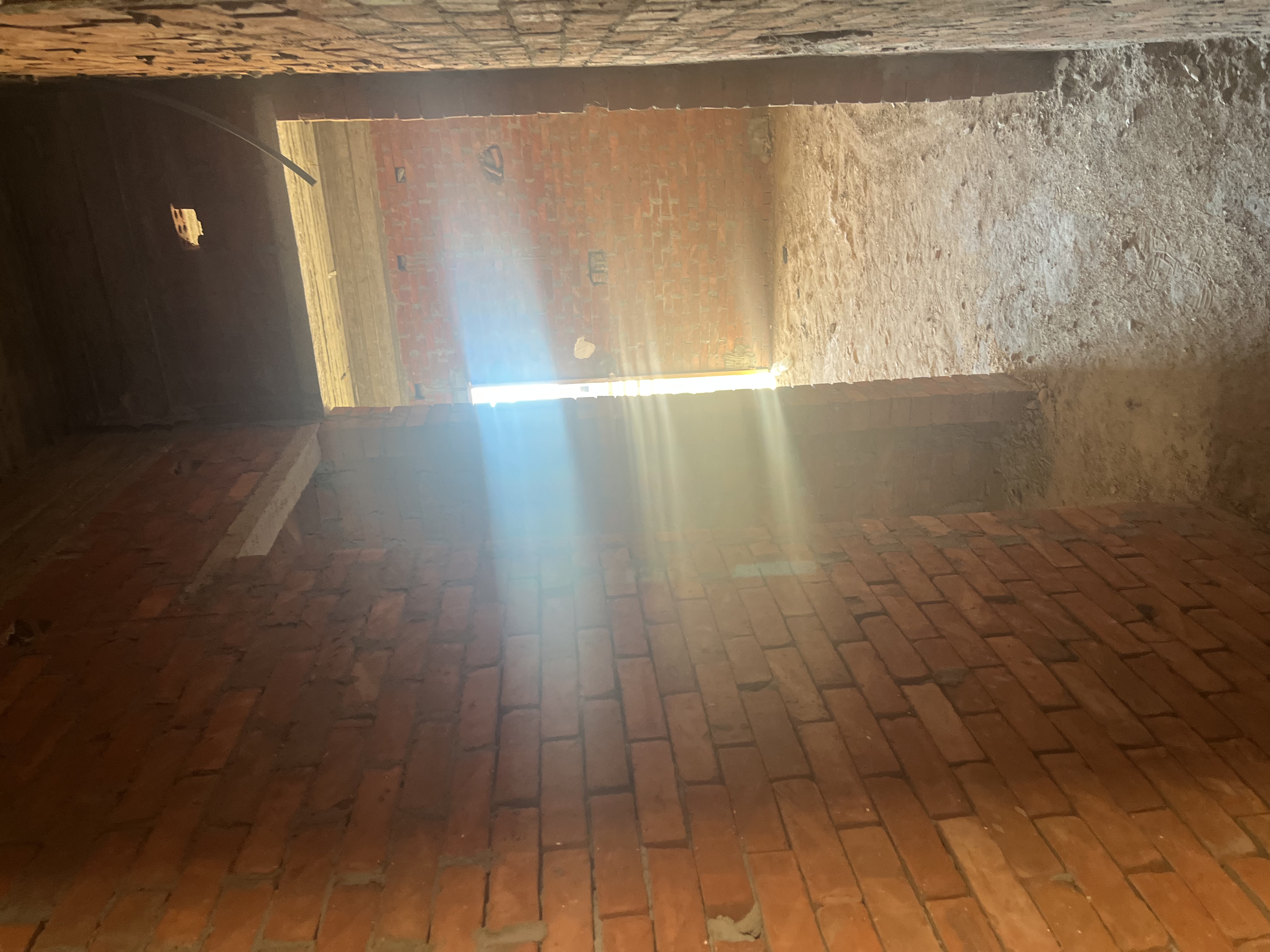

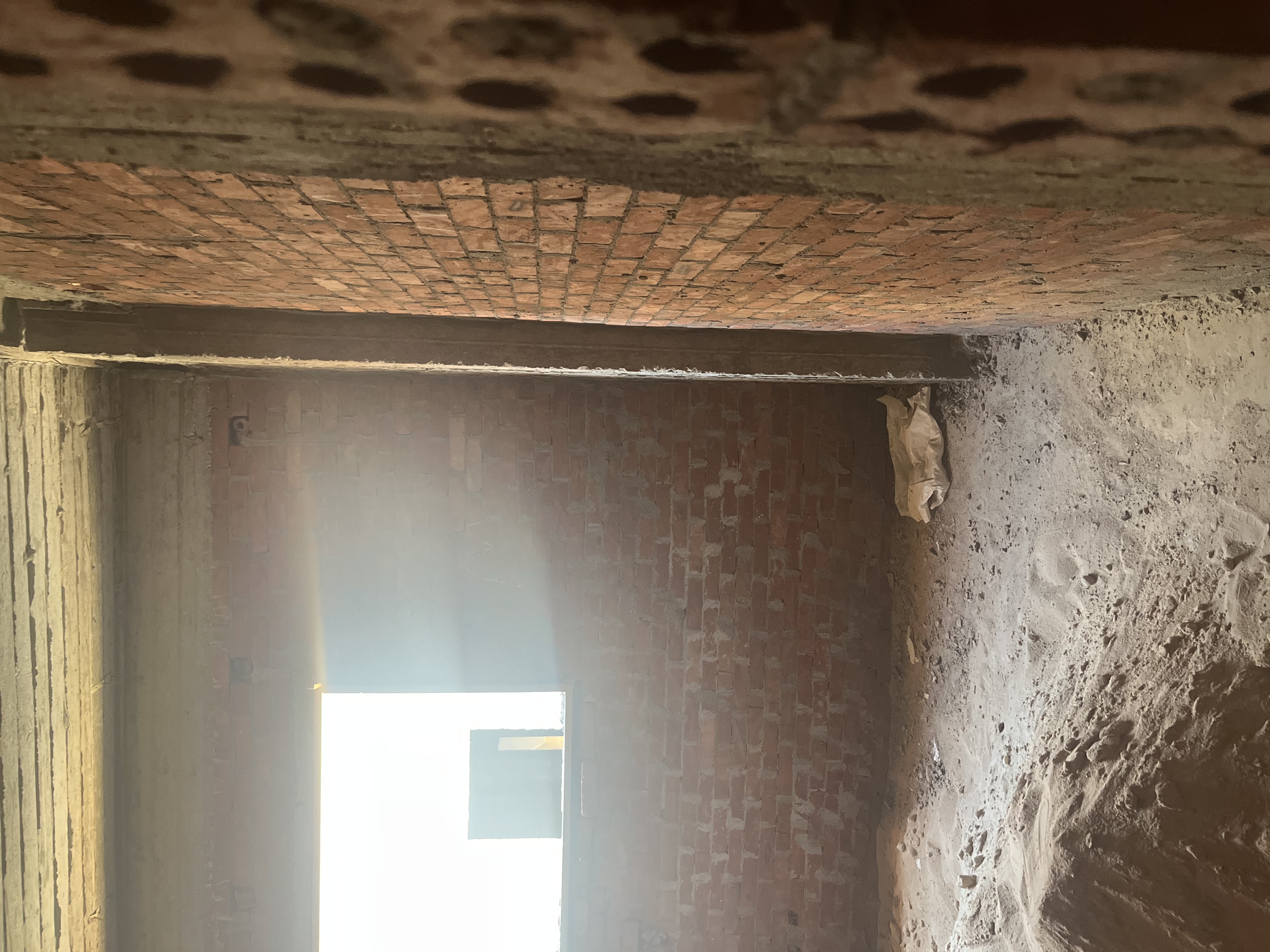

Third floor walls
September 3, 2024

Roof extension license
December 1, 2024
Roof concrete works
December 15, 2024

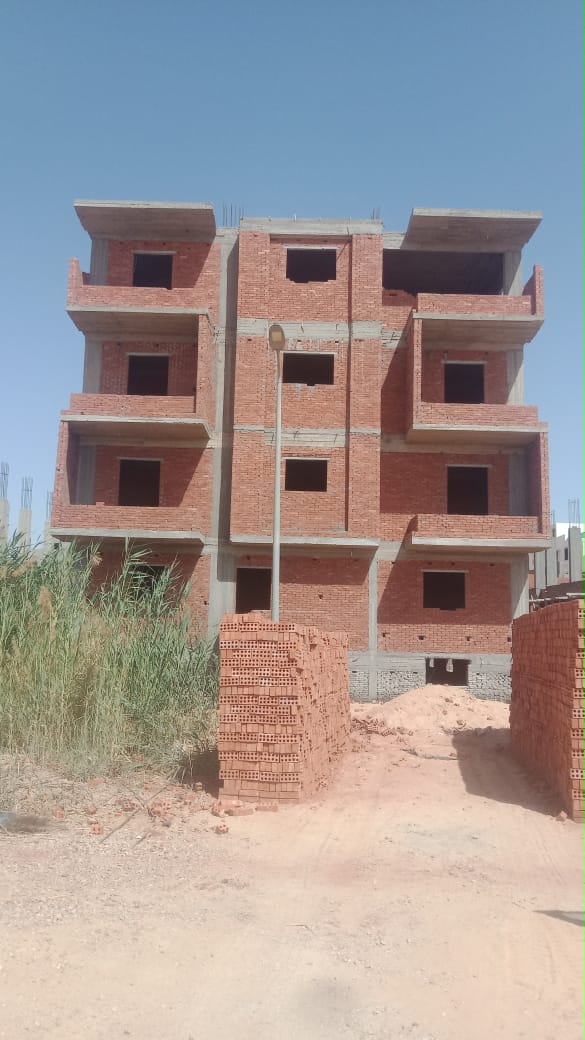

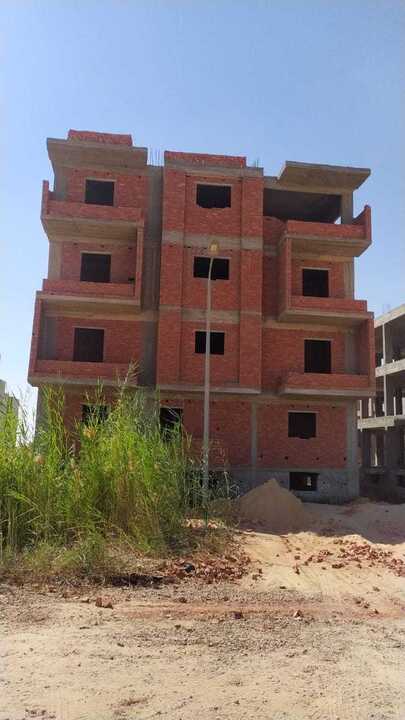

Roof walls
January 1, 2025

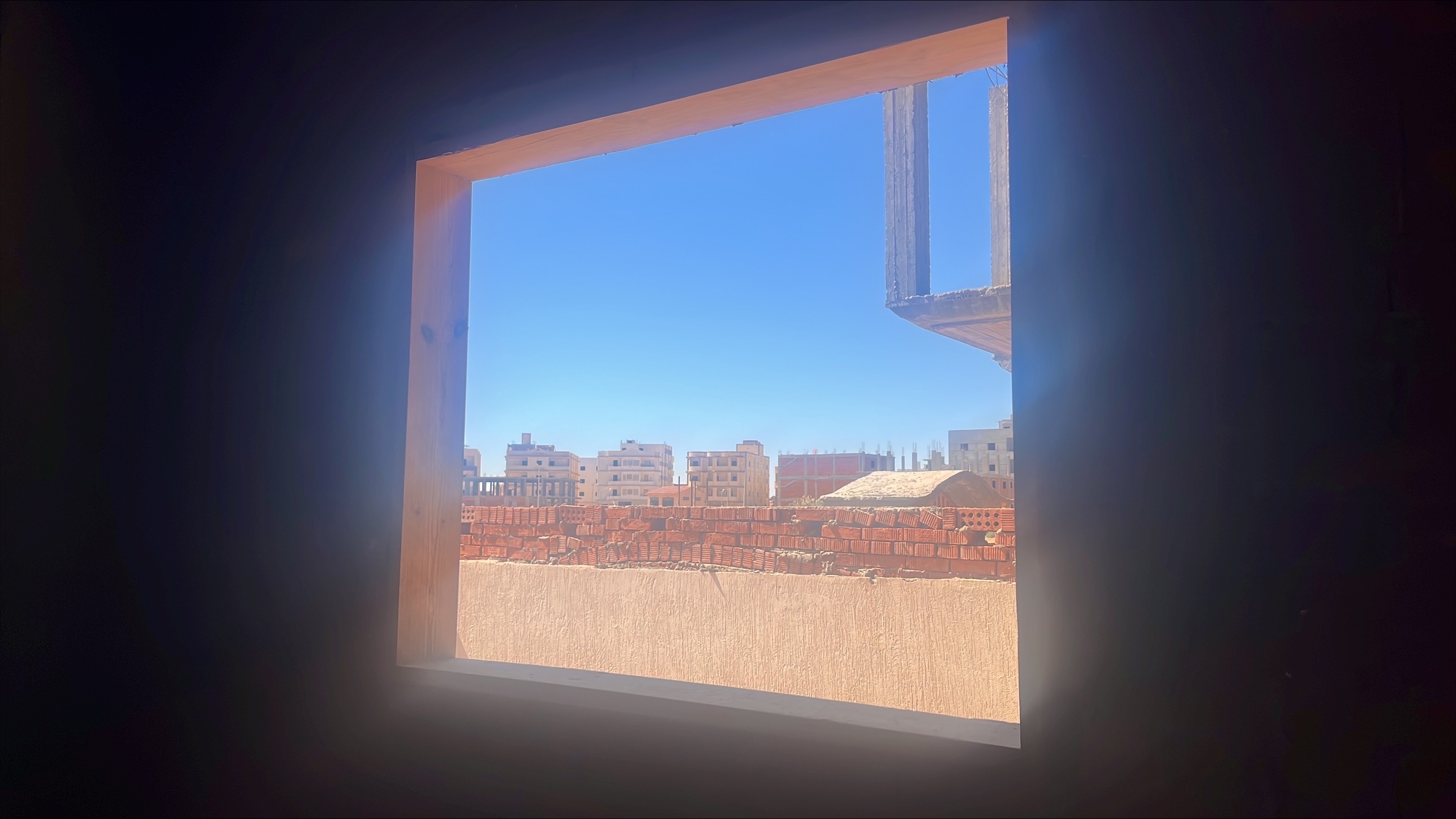

Wooden door frames
March 24, 2025

Electrical works
March 25, 2025

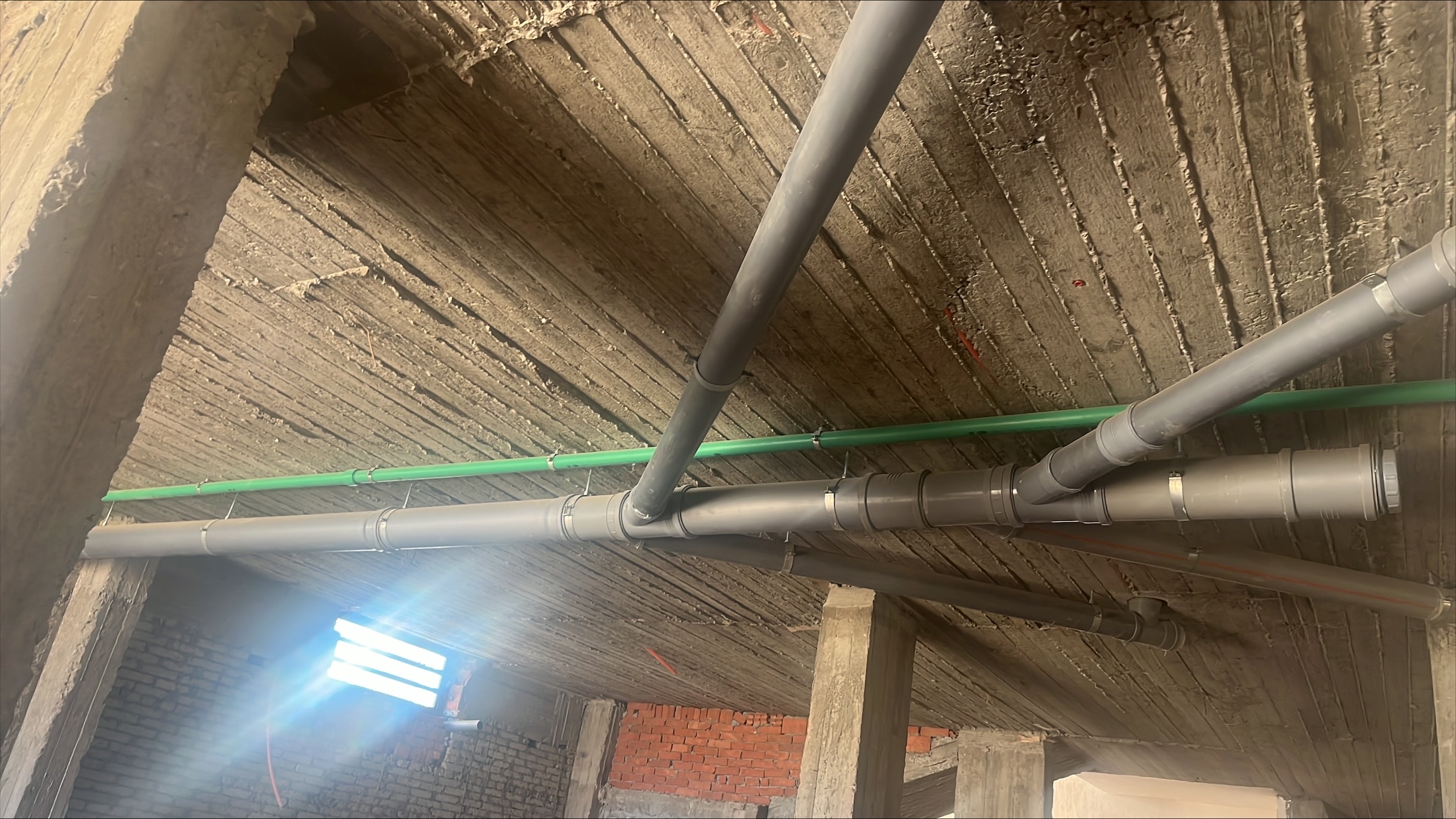

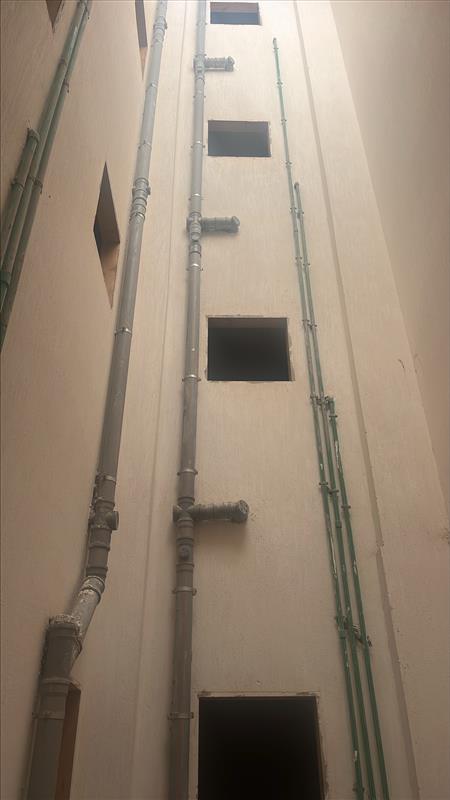

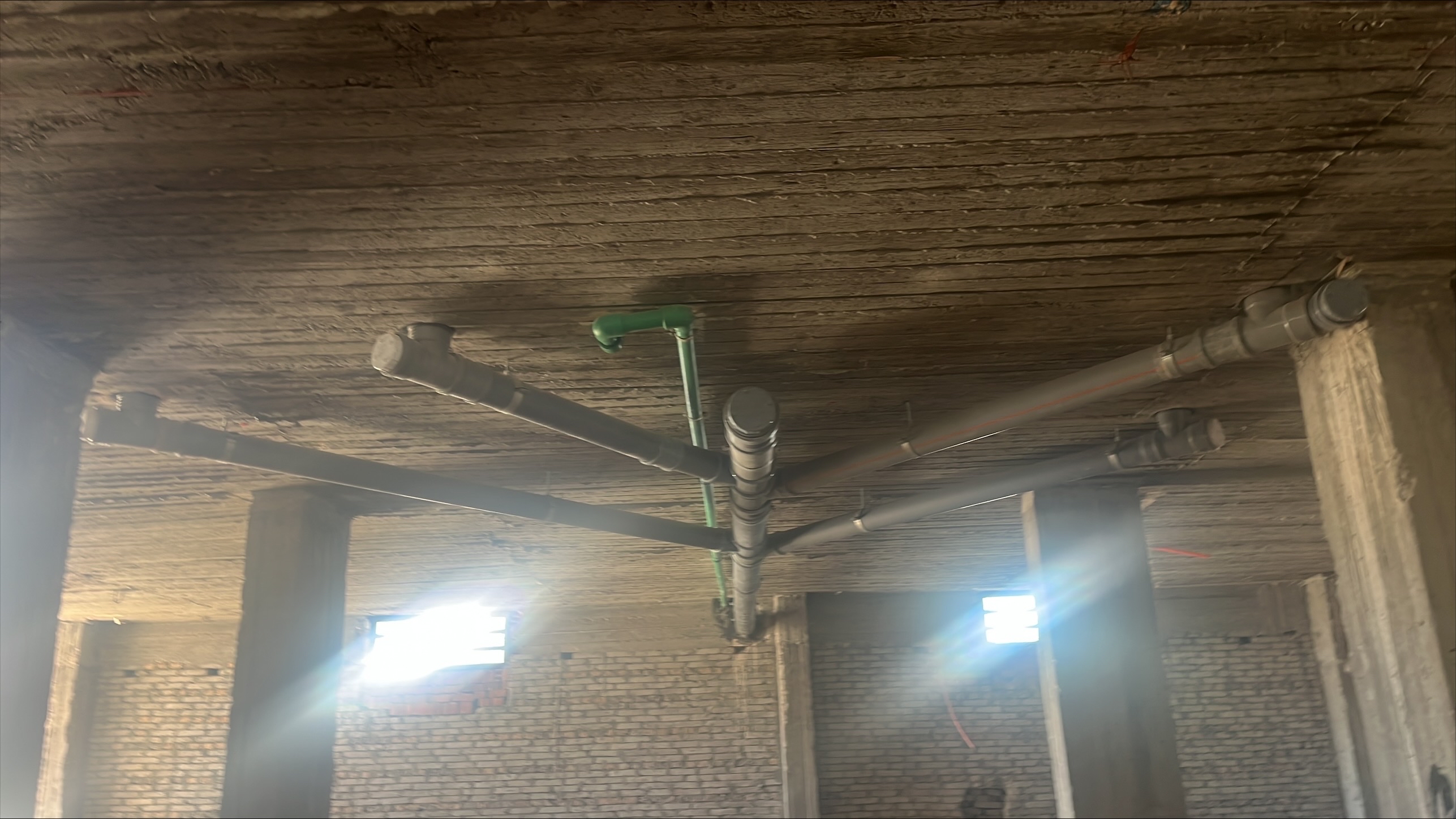

Plumbing works
March 26, 2025

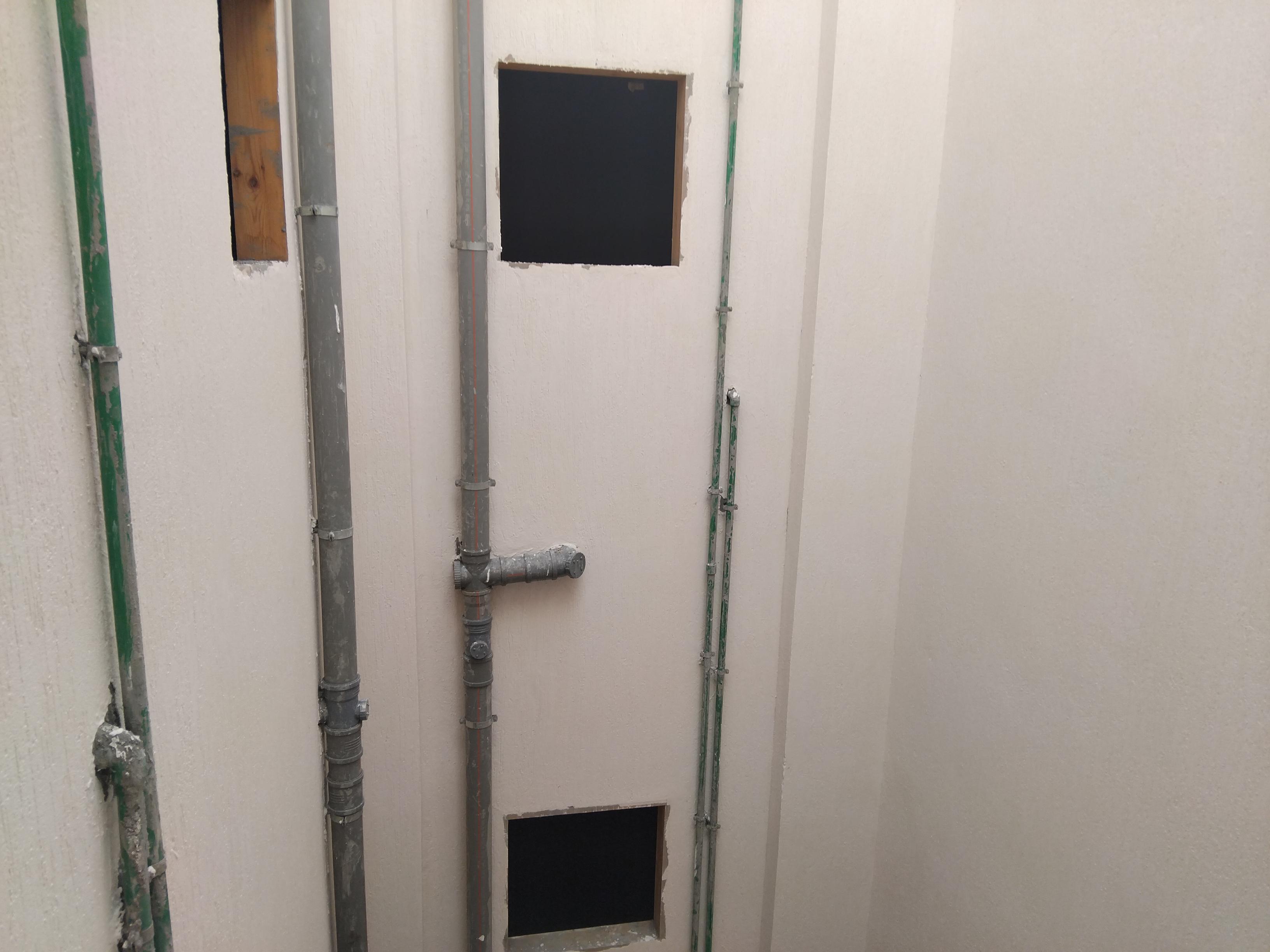

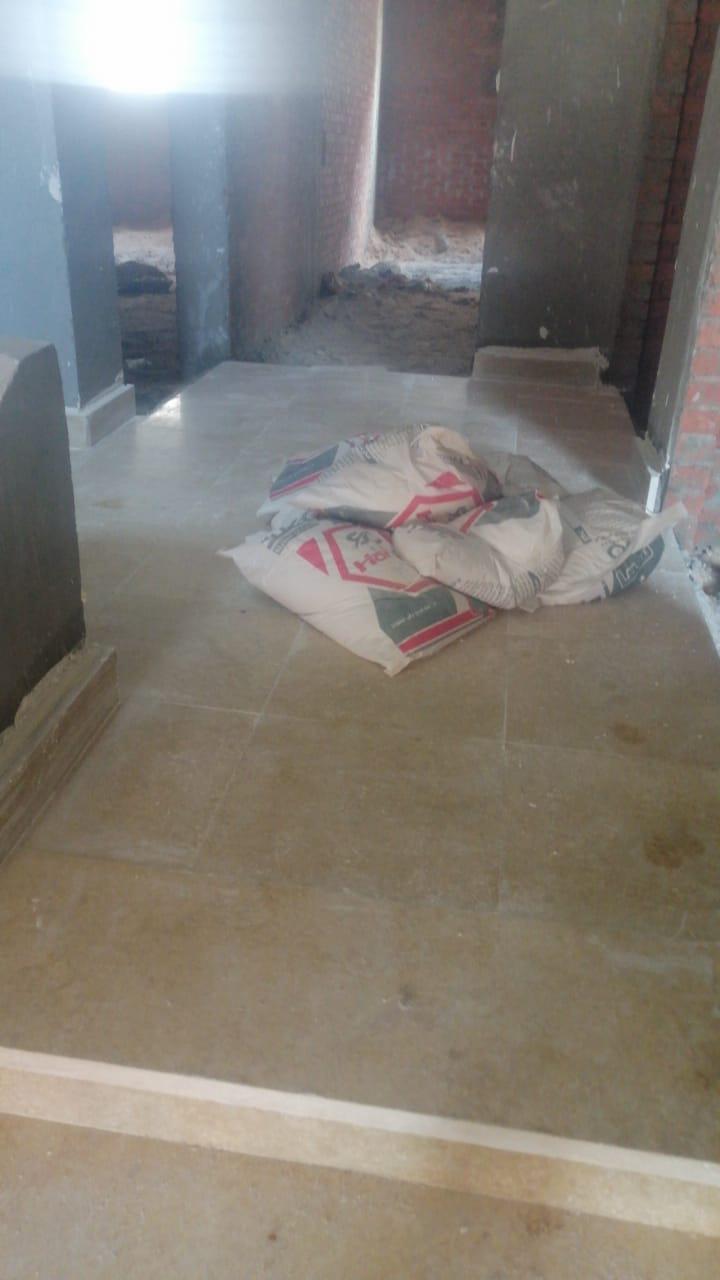

Plaster and putty
April 17, 2025

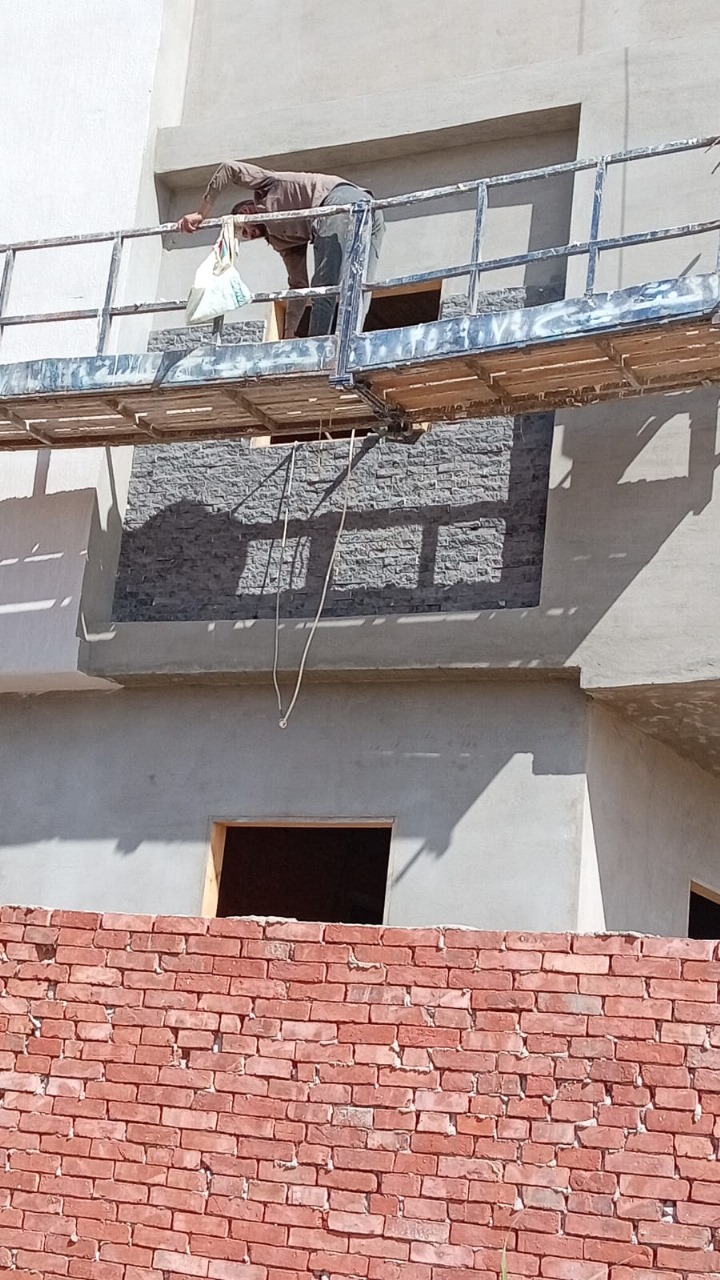

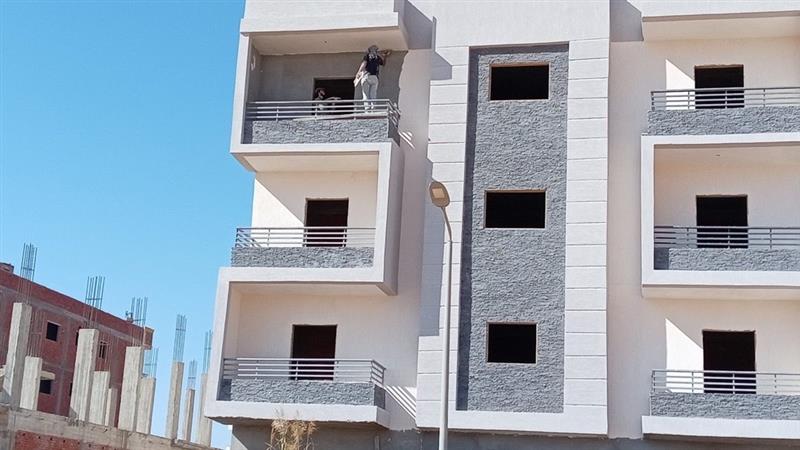

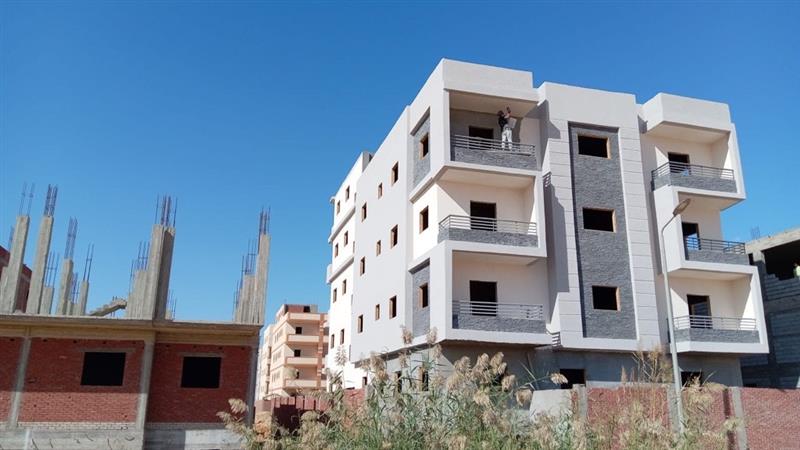

Façade finishing completed
April 18, 2025

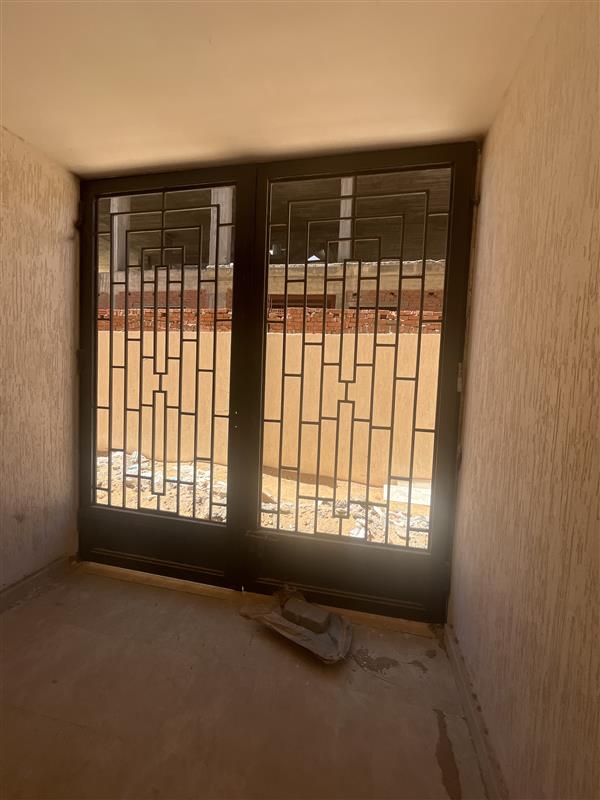

Aluminum & glass works (Krital)
May 15, 2025
Elevator
May 15, 2025

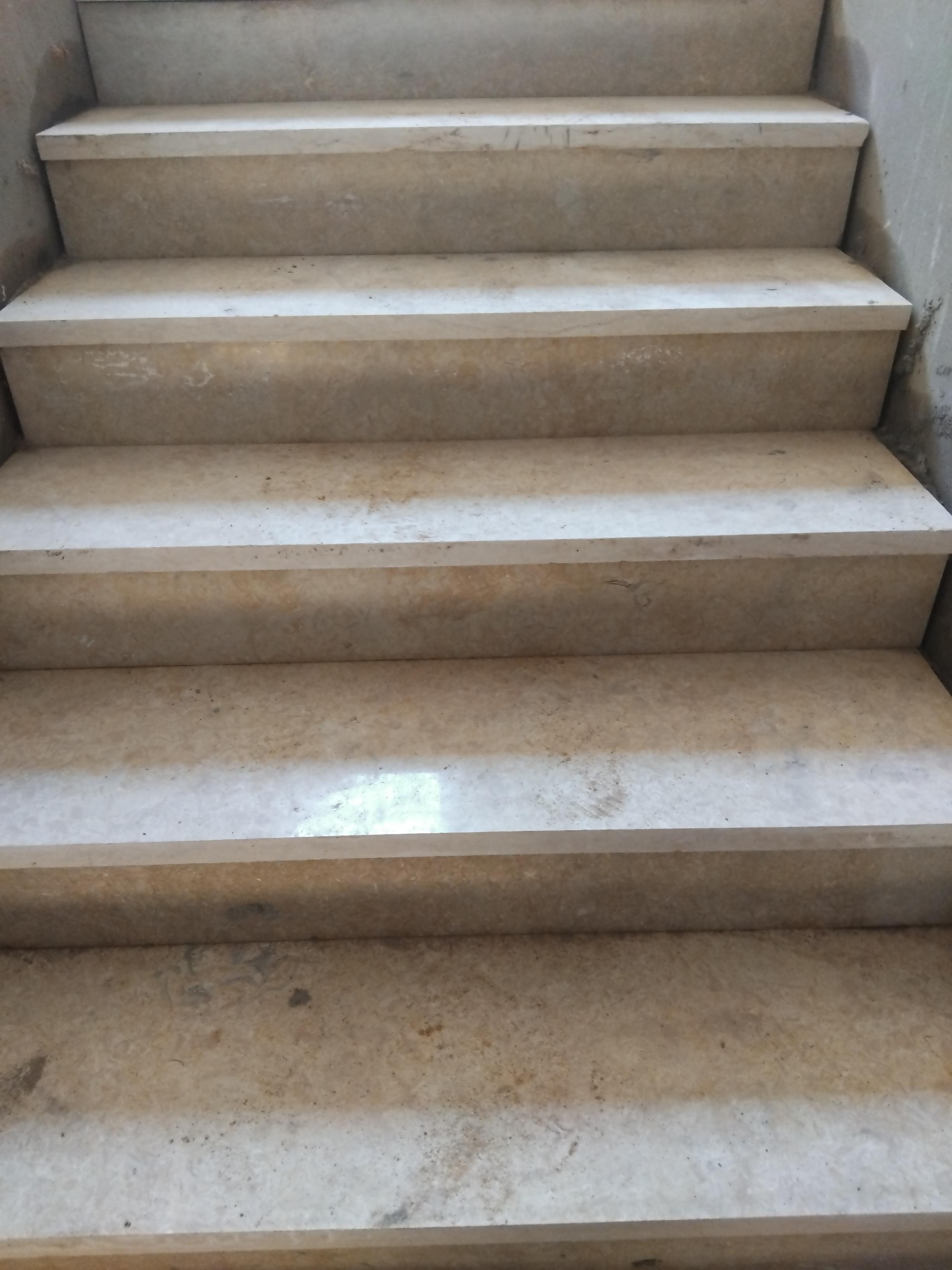

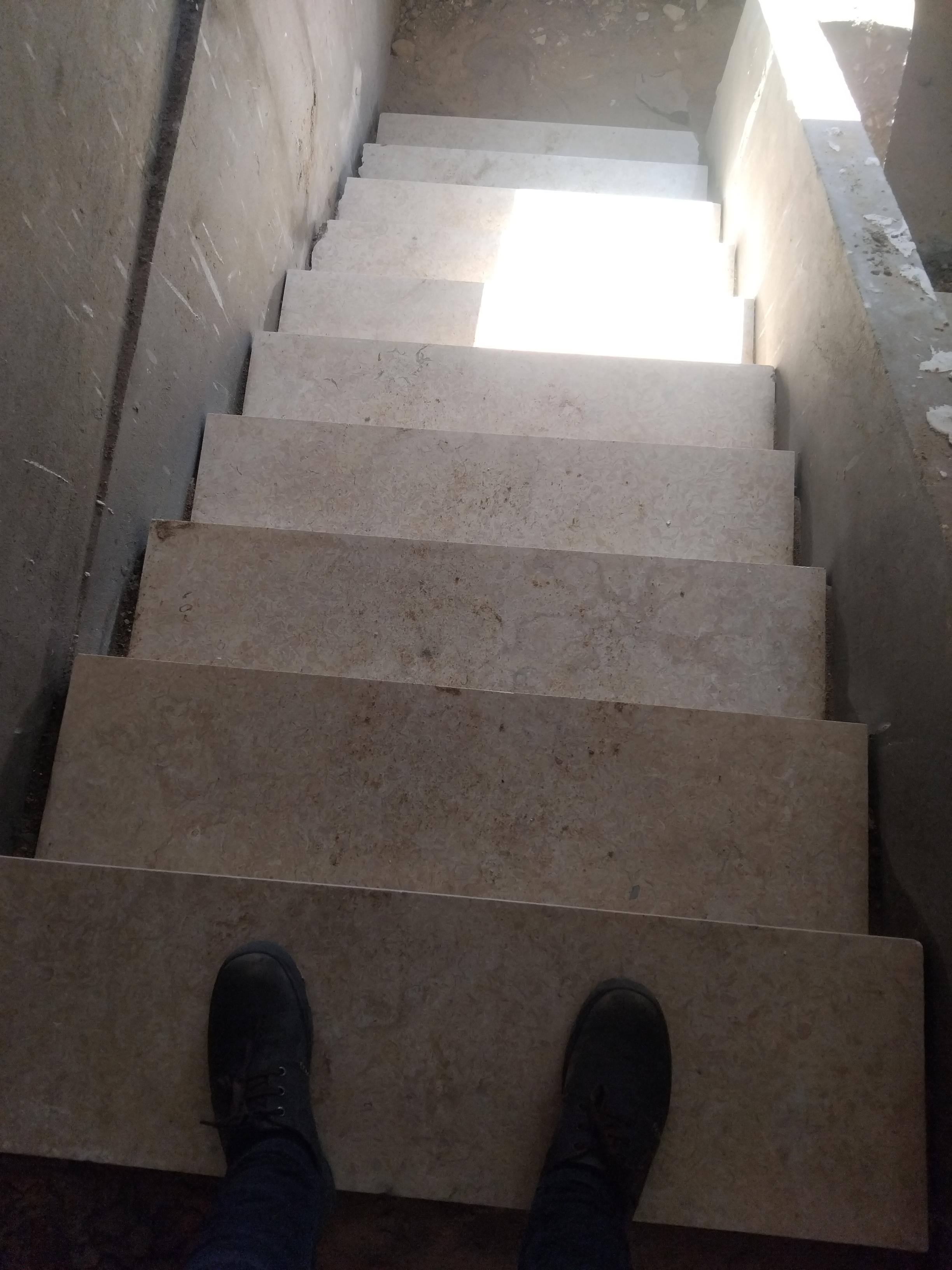

Marble works
May 15, 2025
Project handover to the authority
June 30, 2025
Utilities meter installation
July 1, 2025
