Project Details
Land Number
1528
Region
The Area 29, El Sadat City
HOMEi Price
8,100.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 15% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
195 m²
Delivery
Unit Delivery Date
August 2027
Average Unit Price
1,120,500 EGP
Project Location
Map View
The Area 29, El Sadat City
HOMEi Timeline

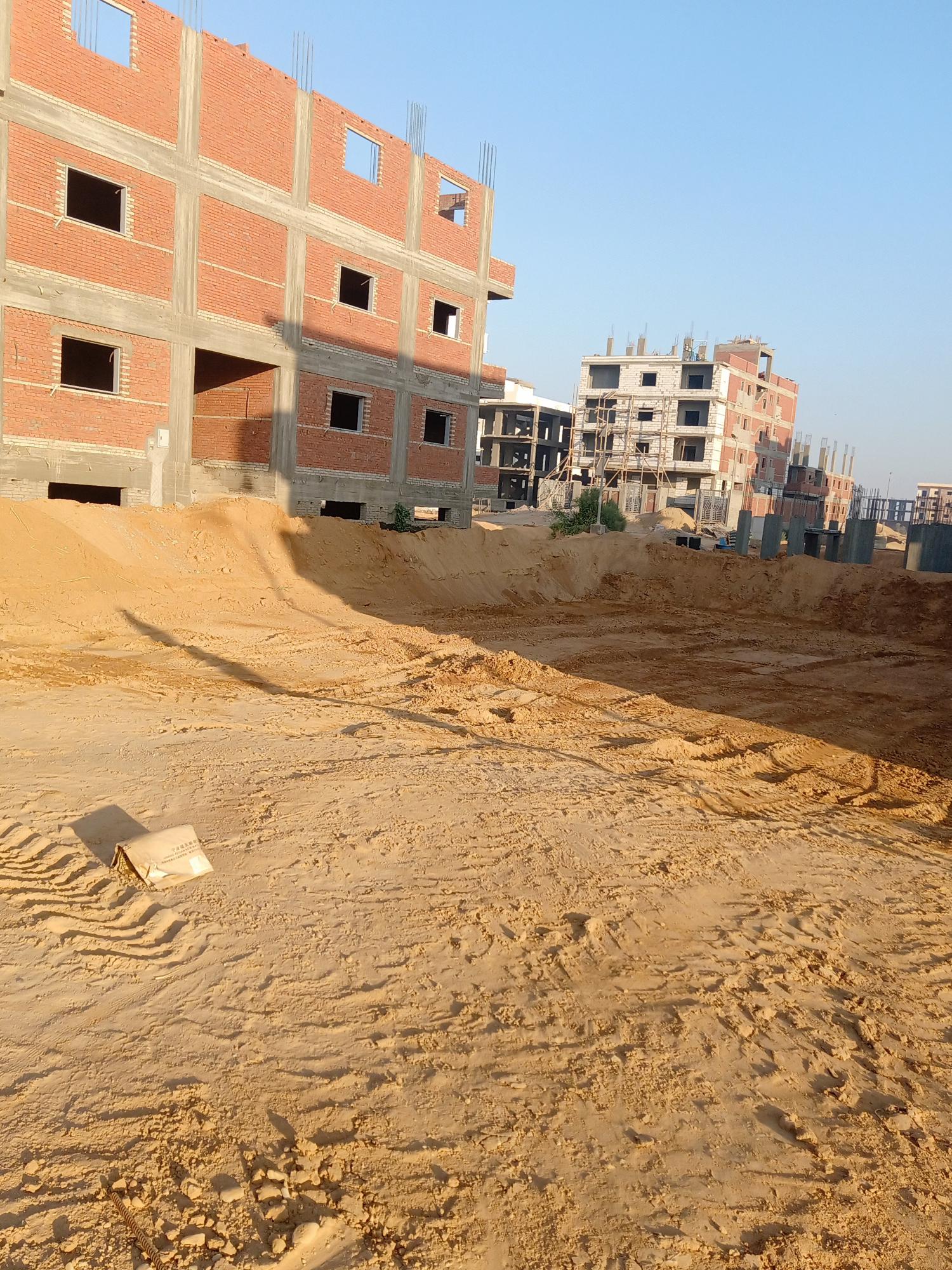

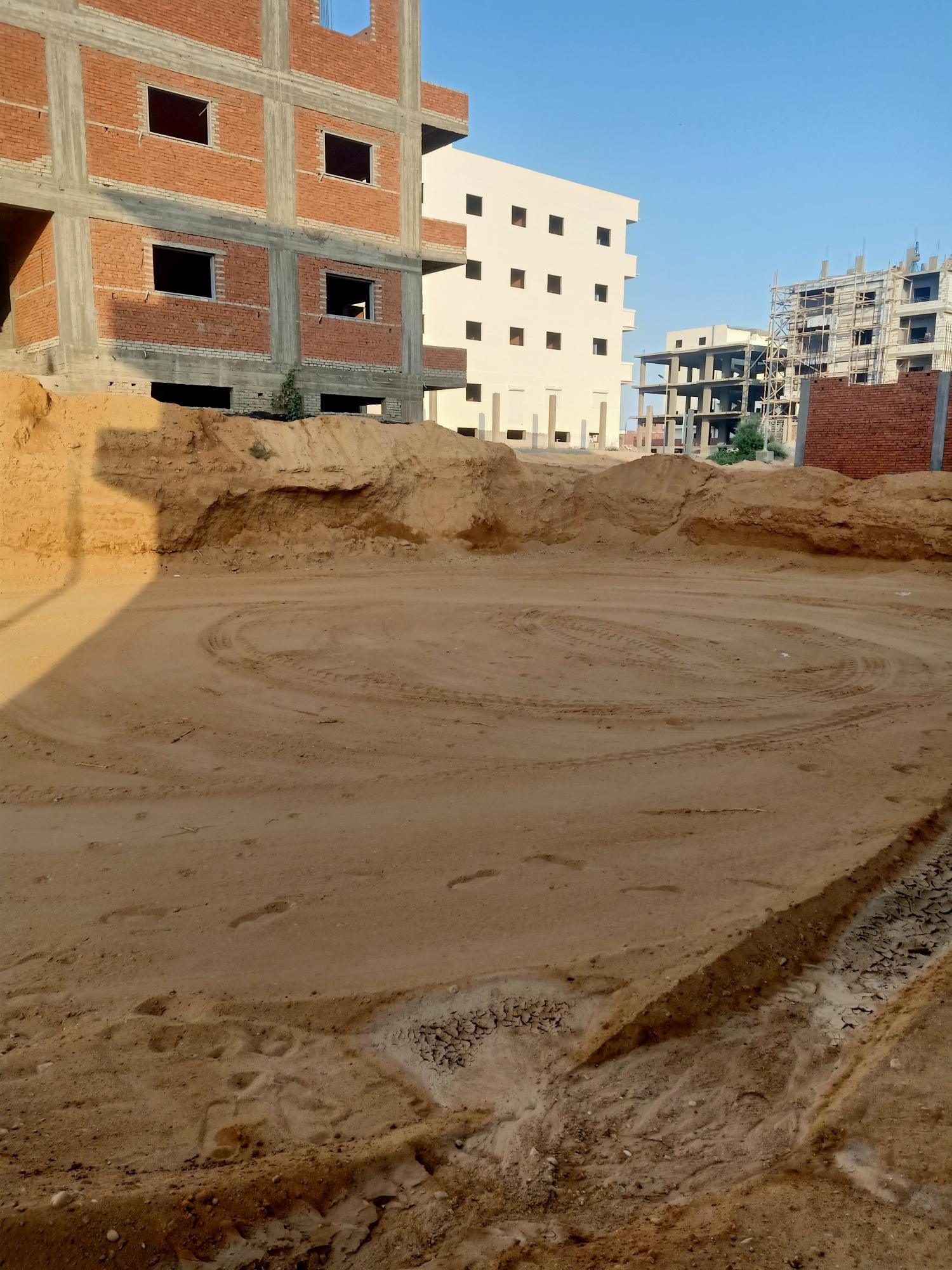

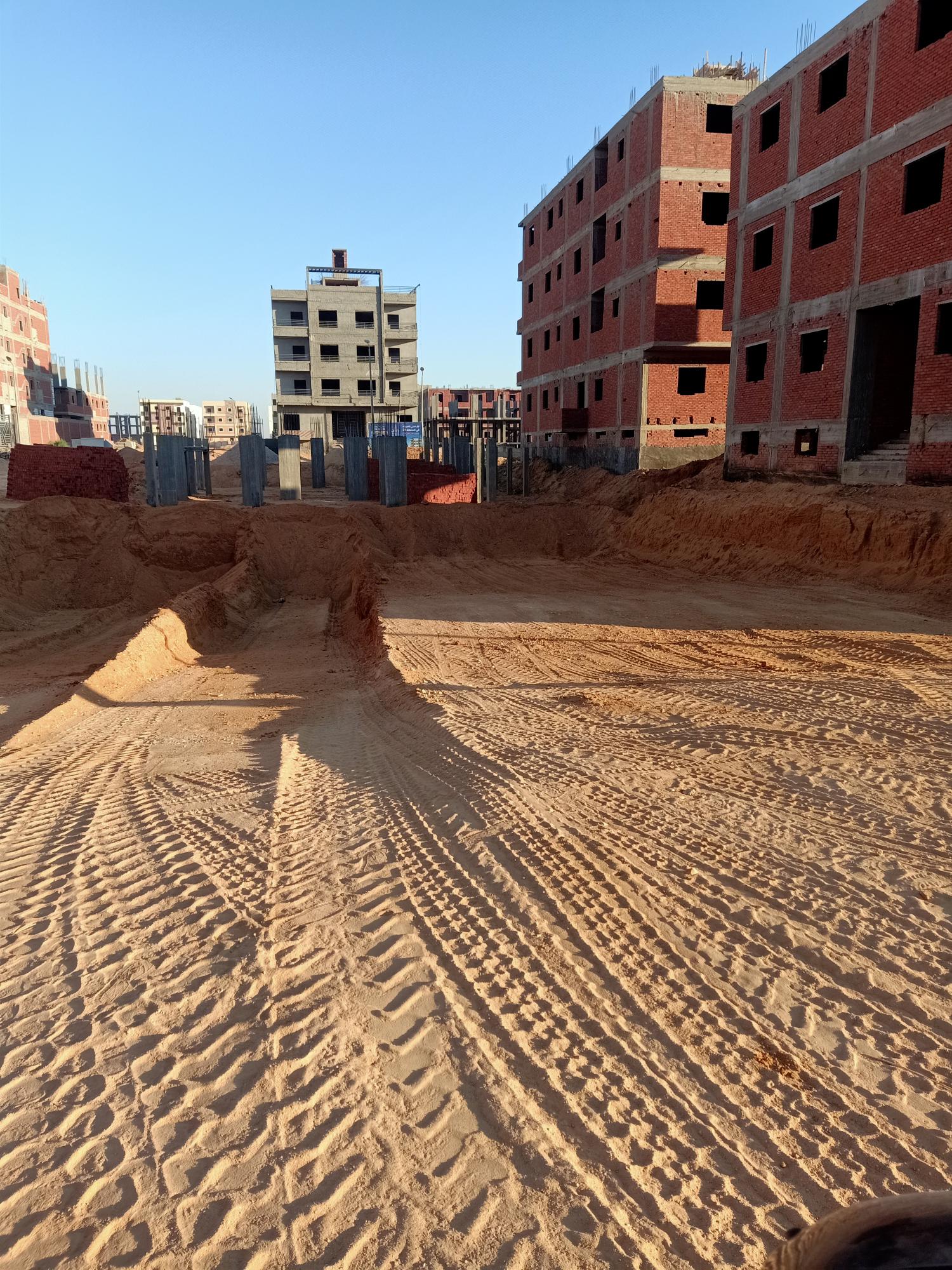

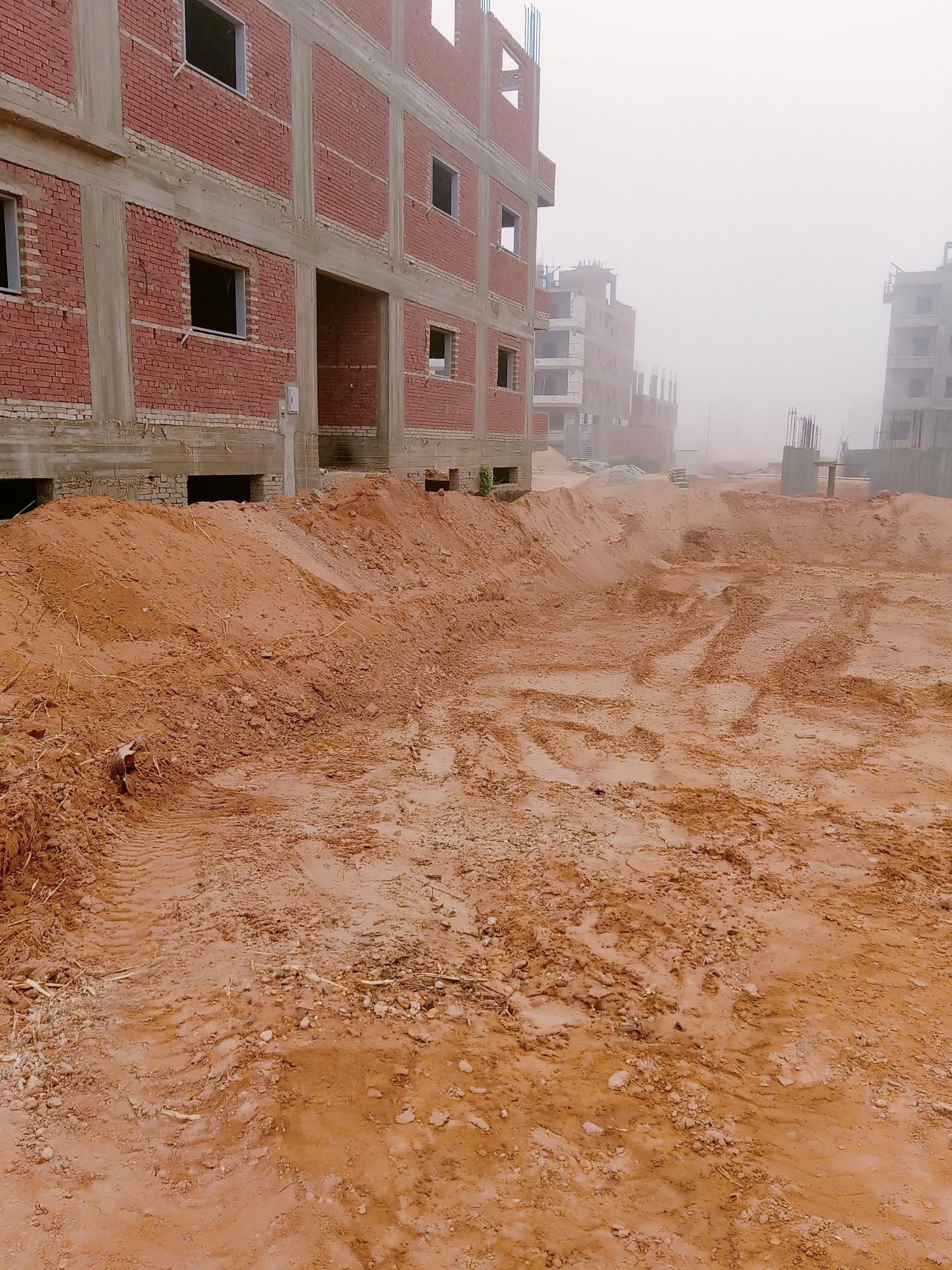

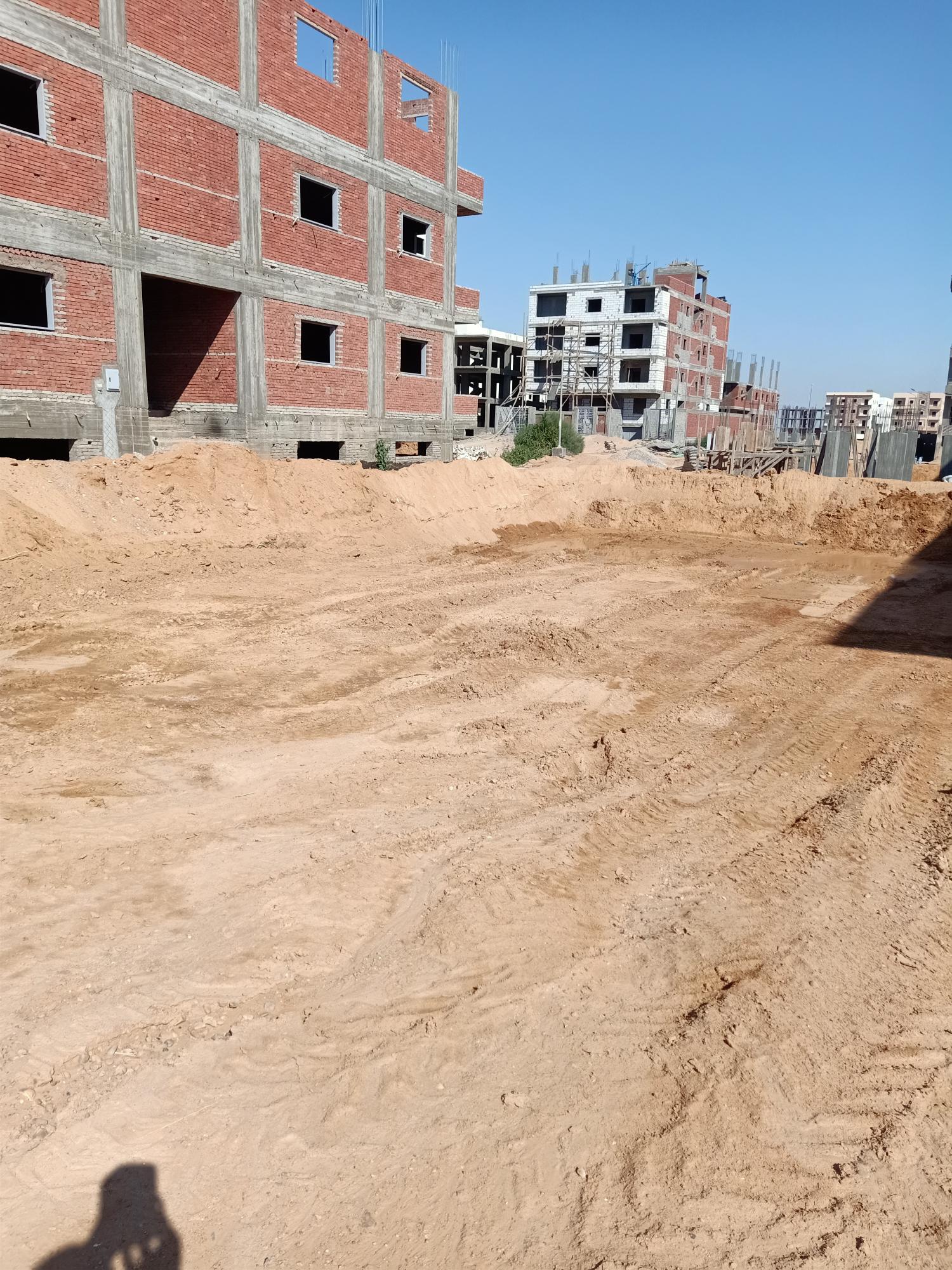

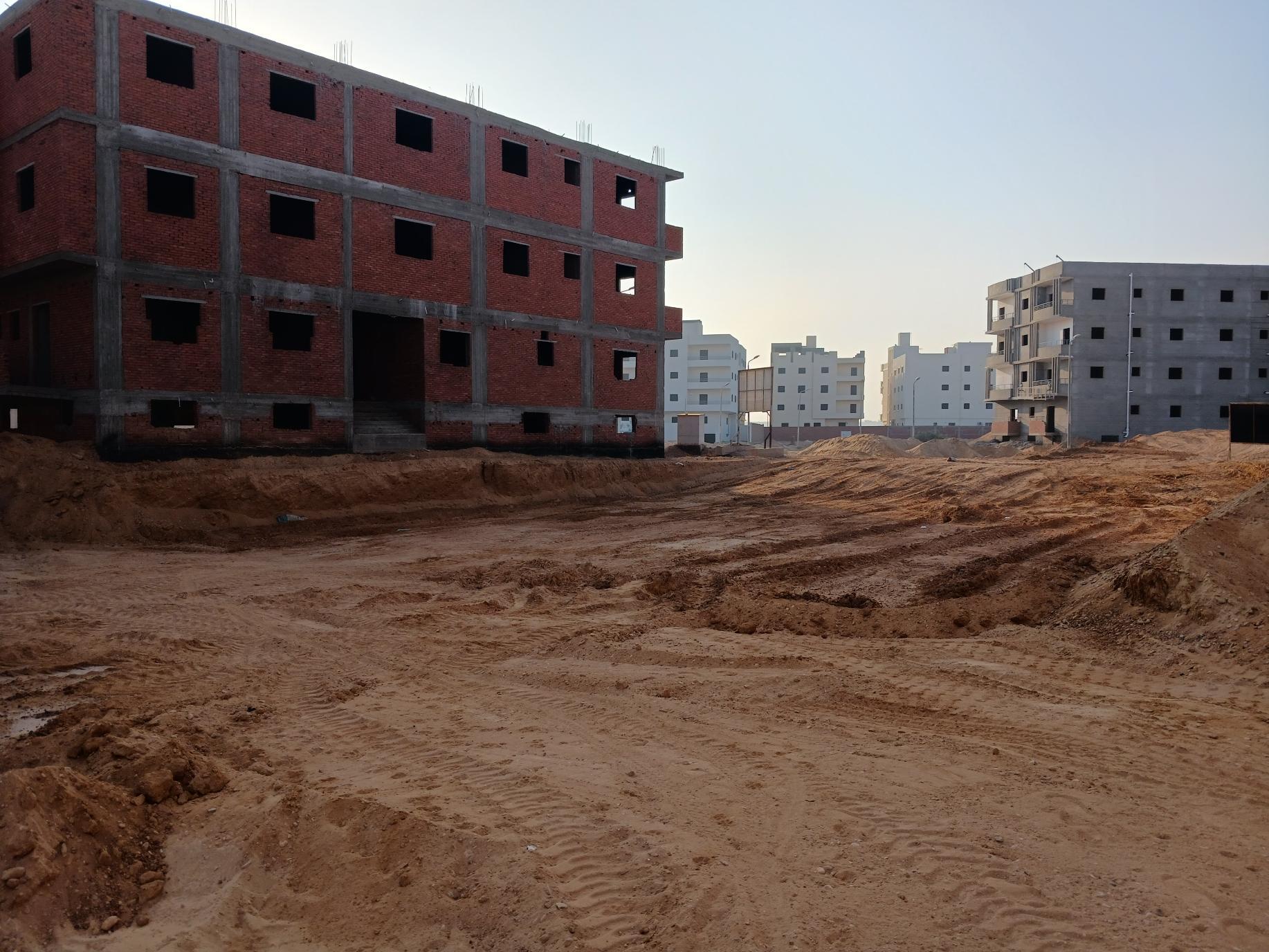

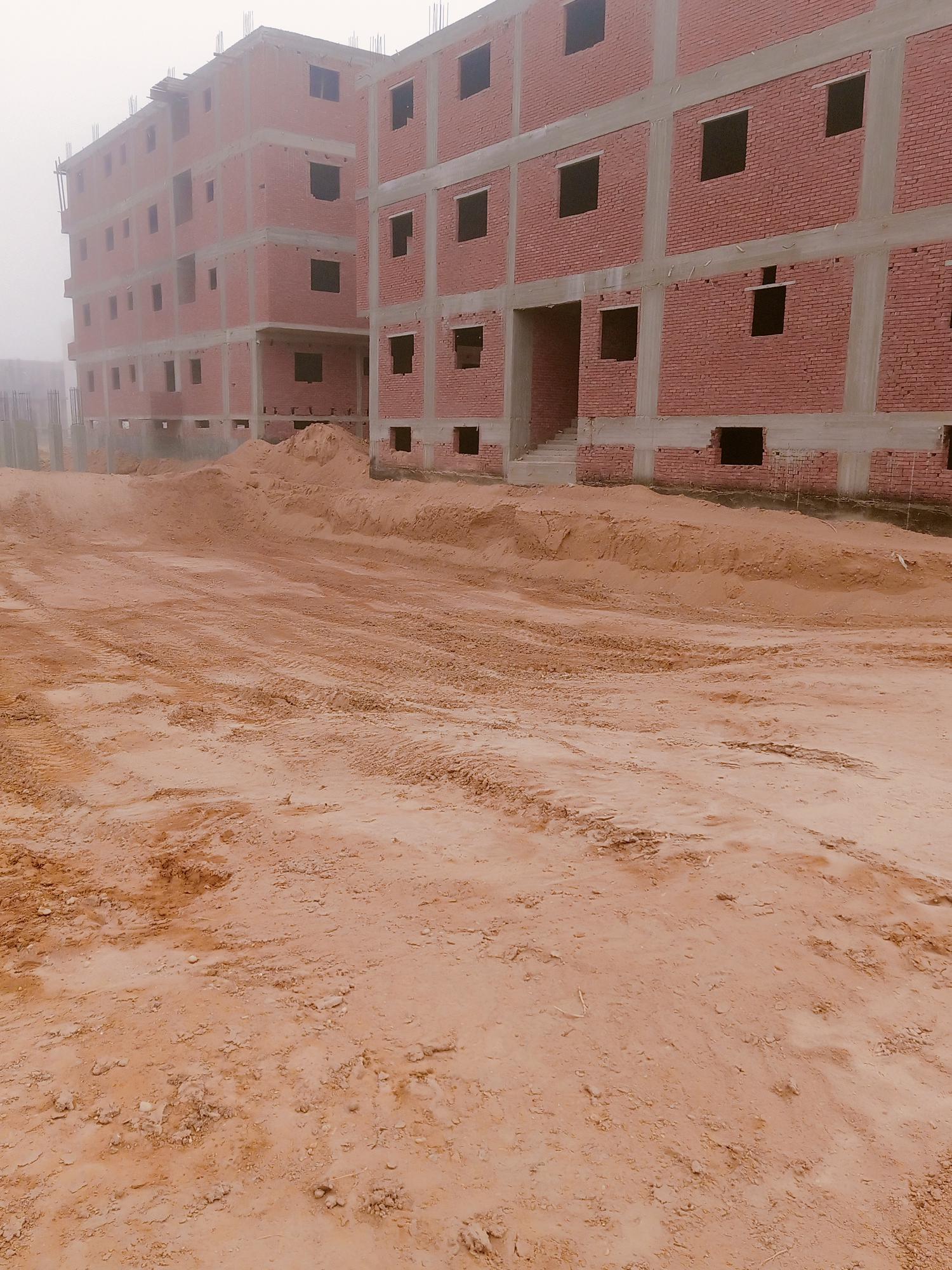

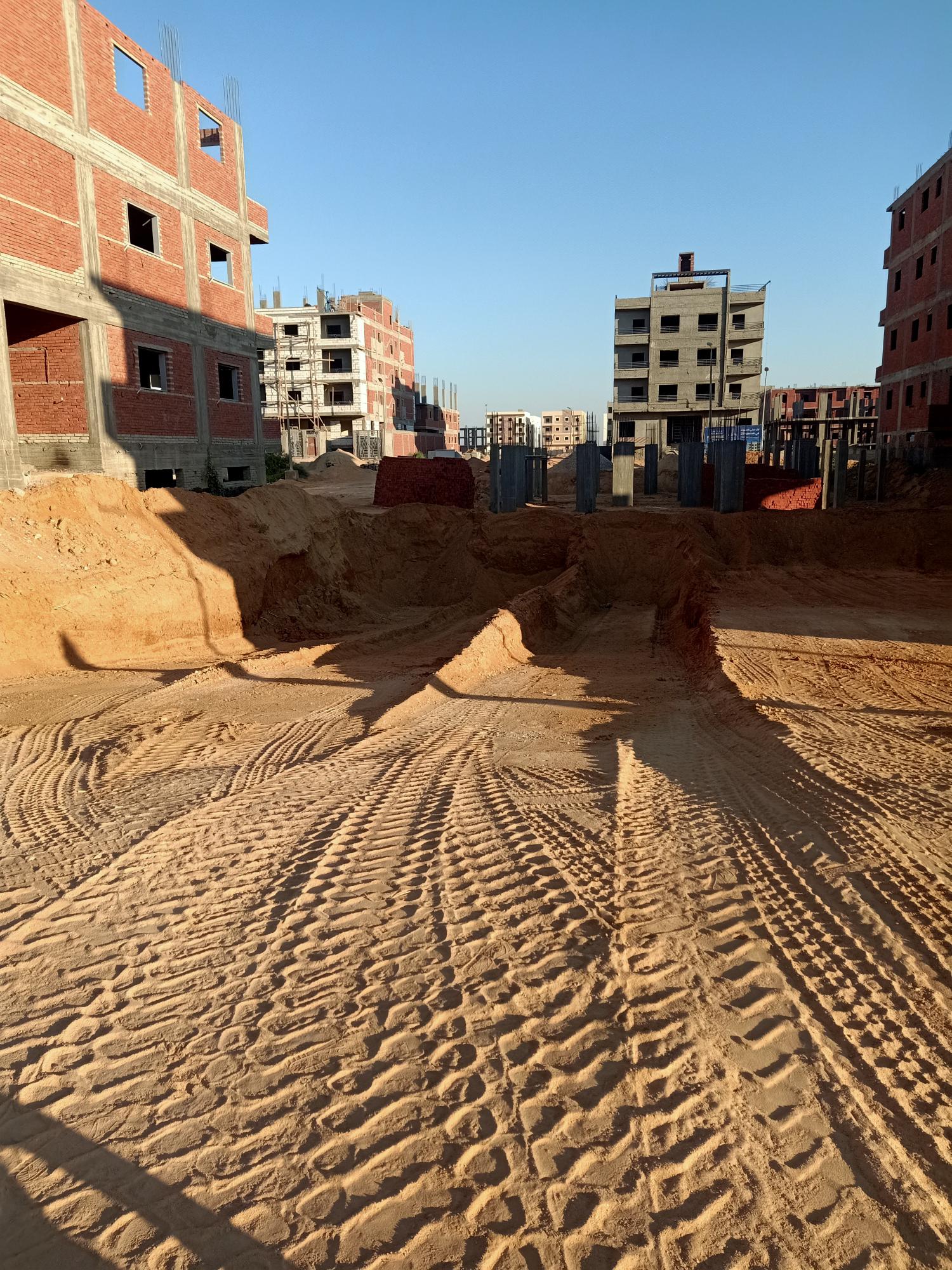

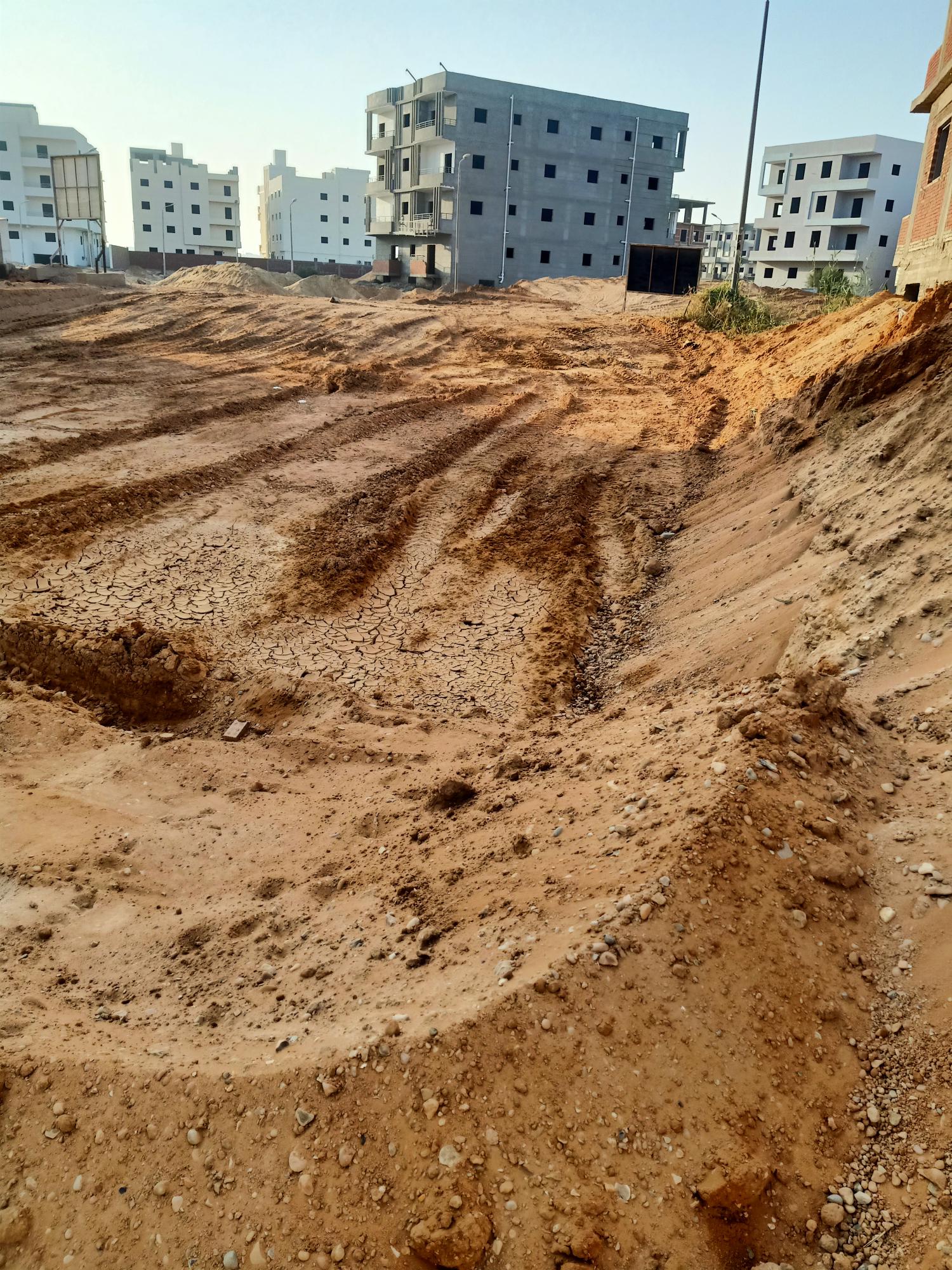

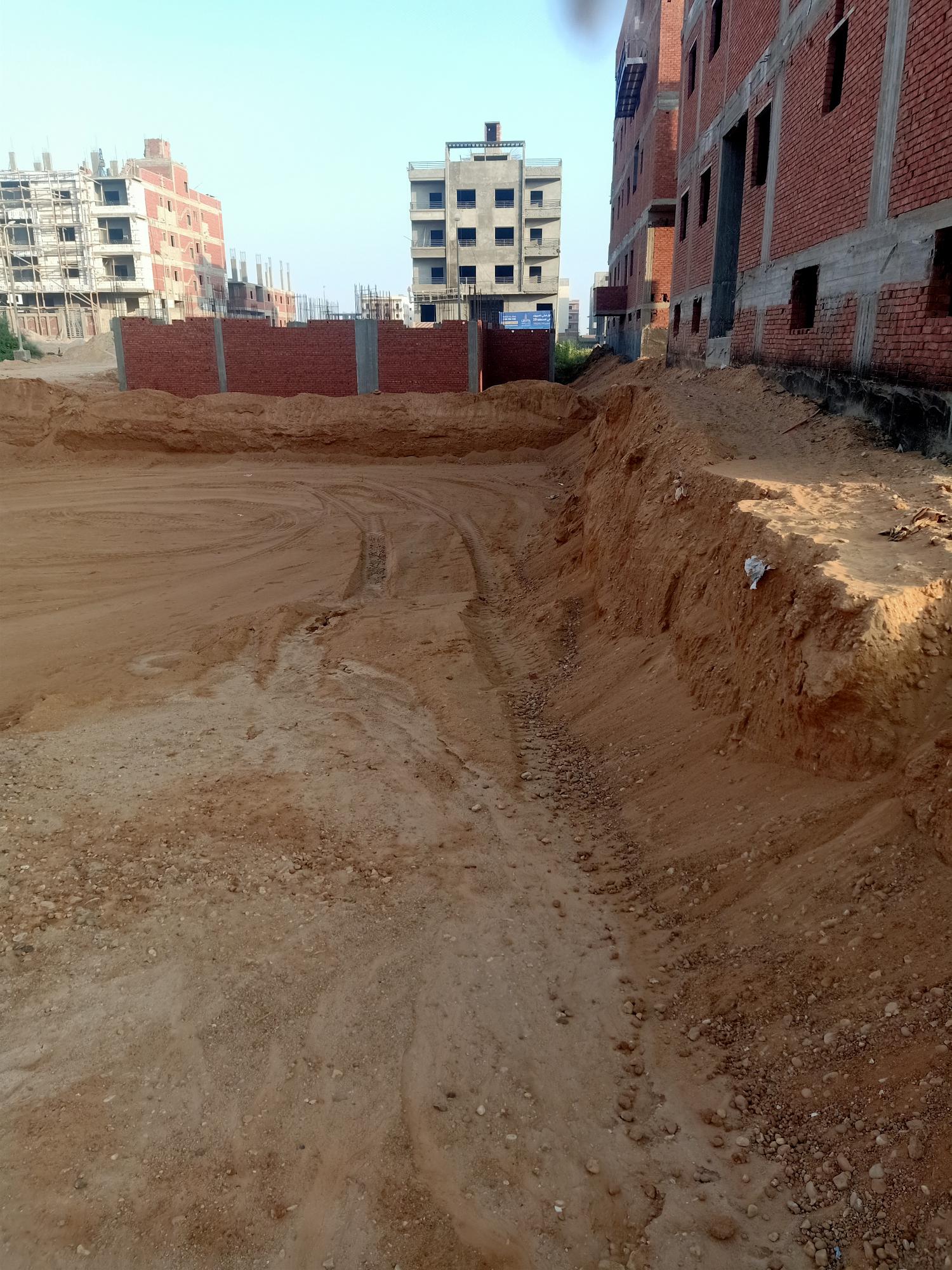

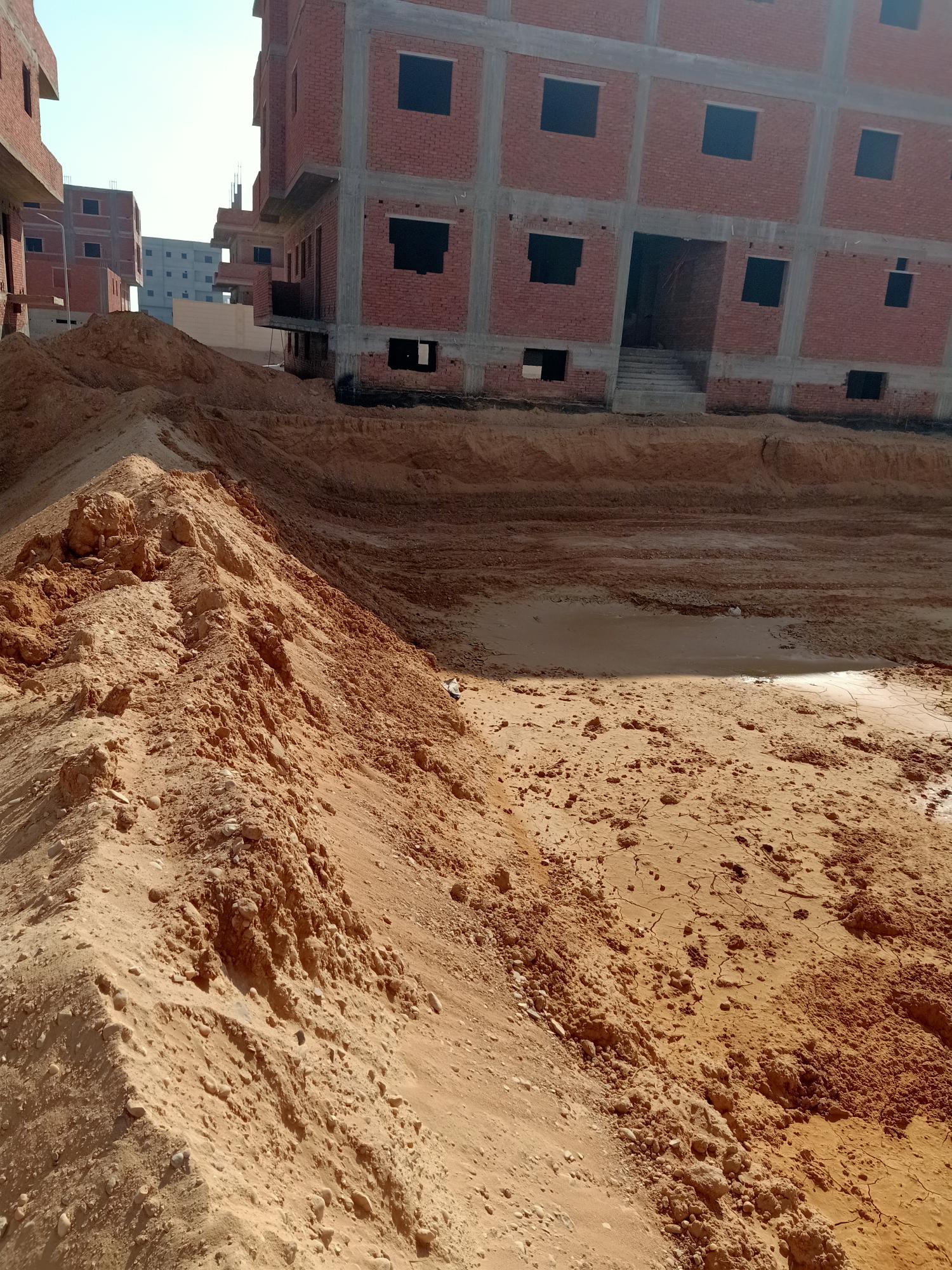

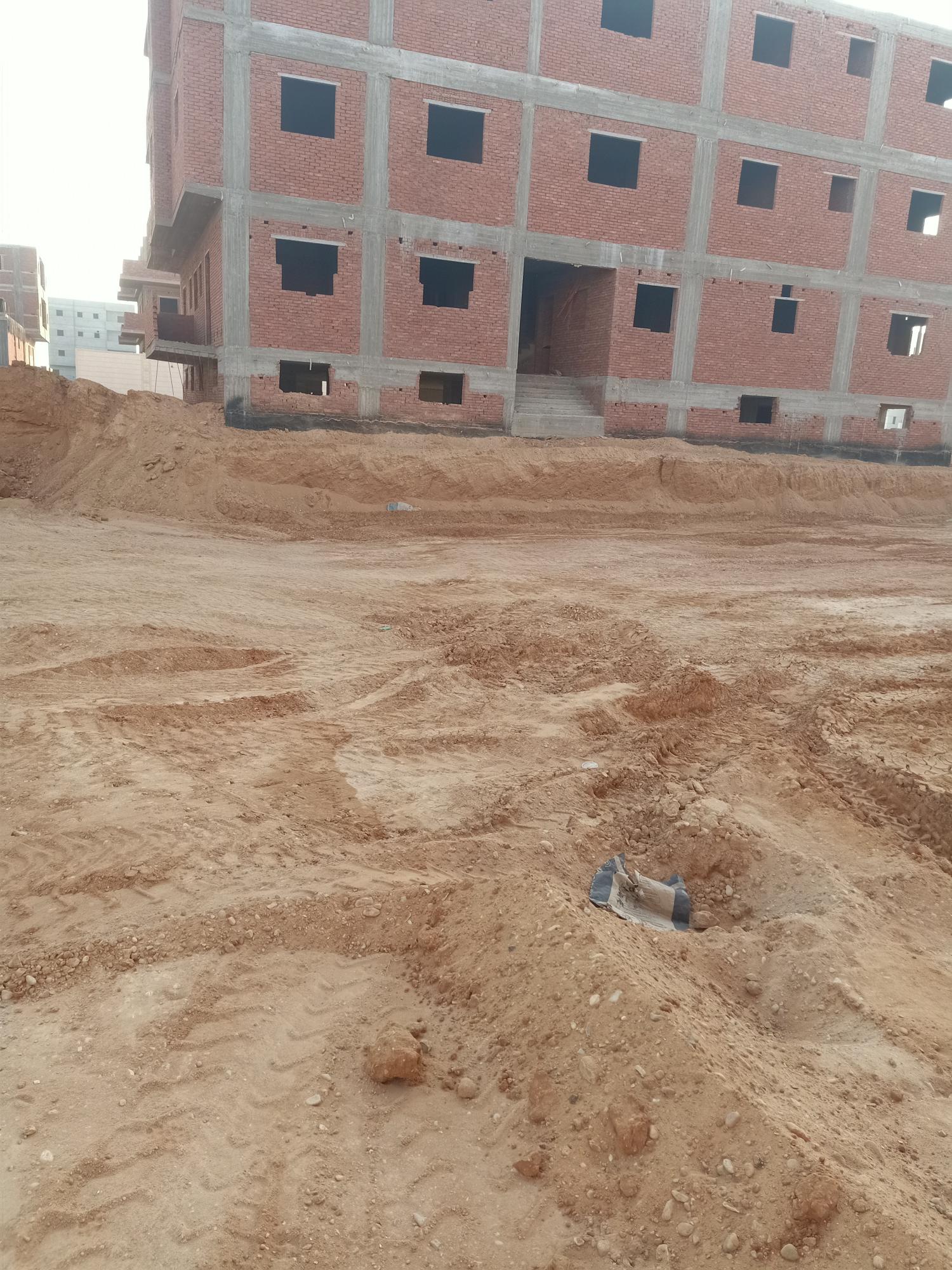

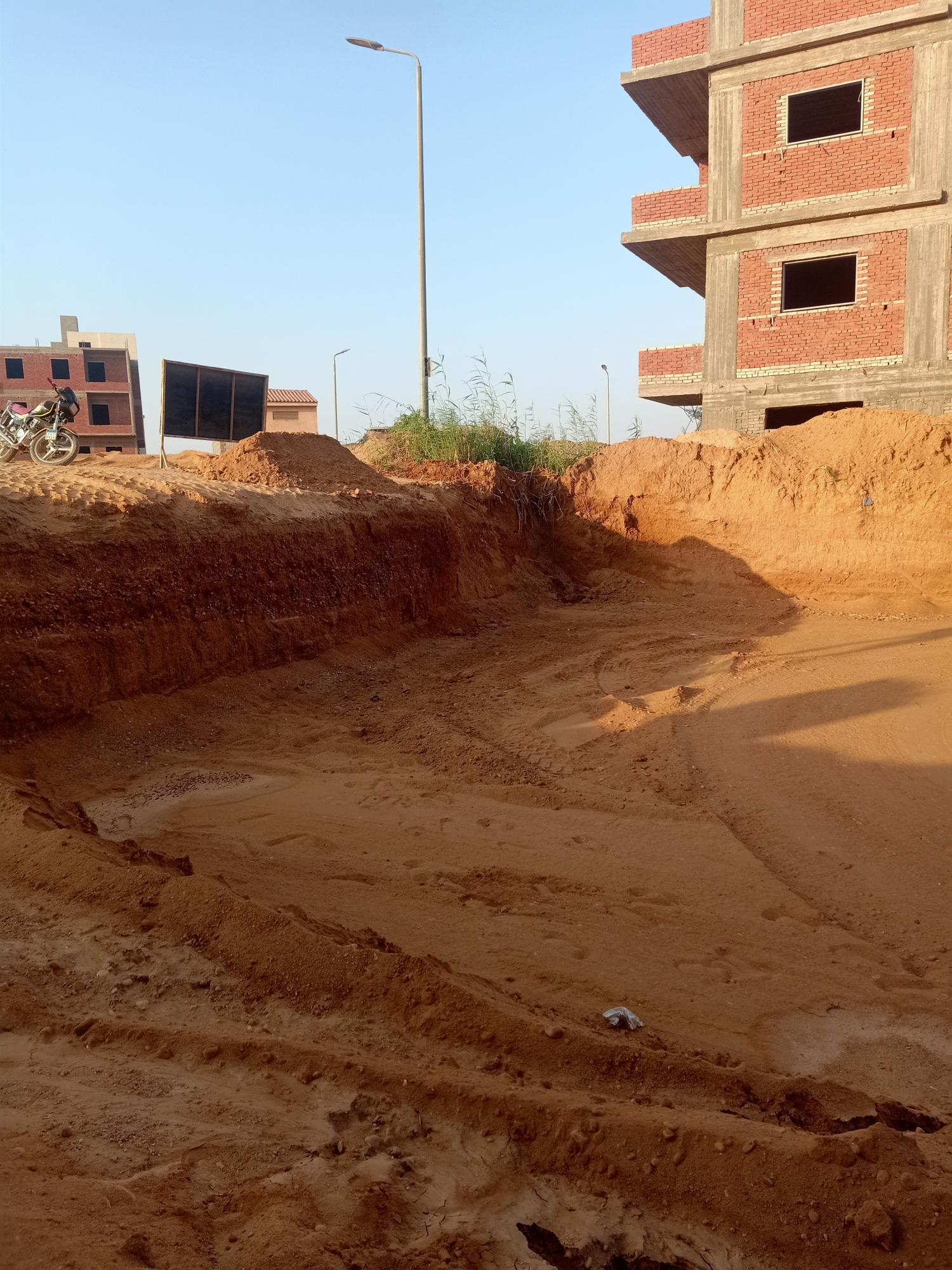

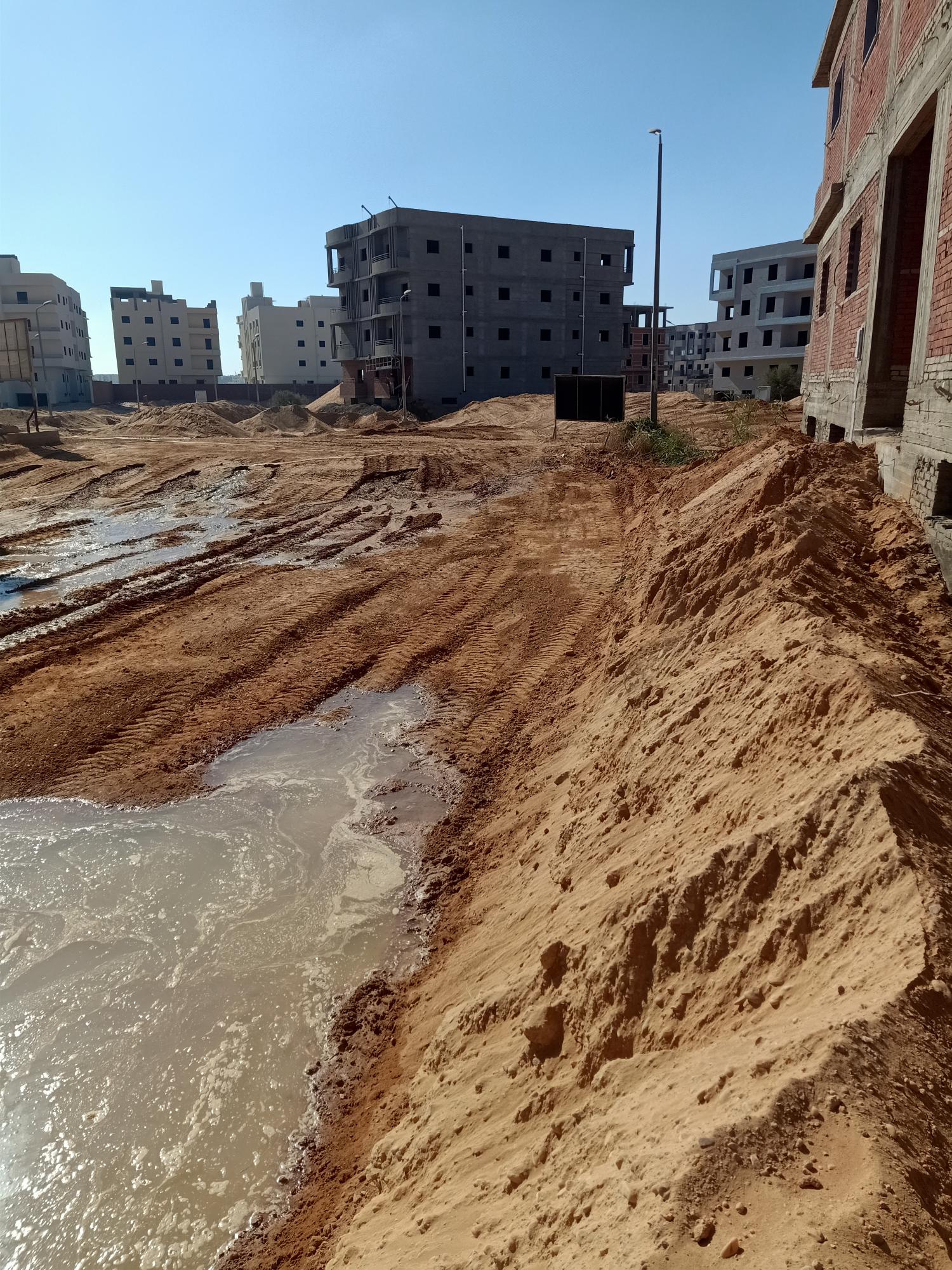

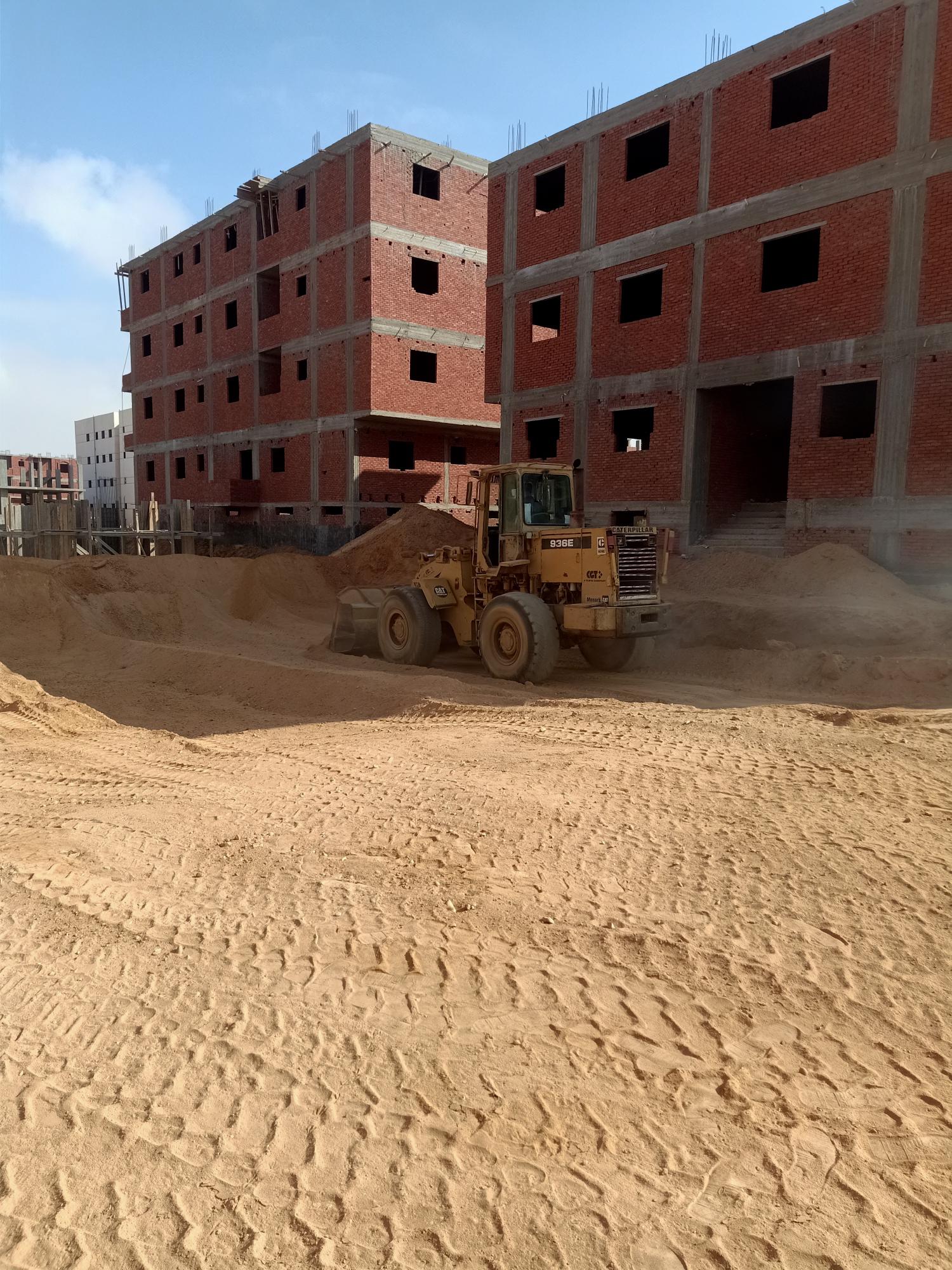

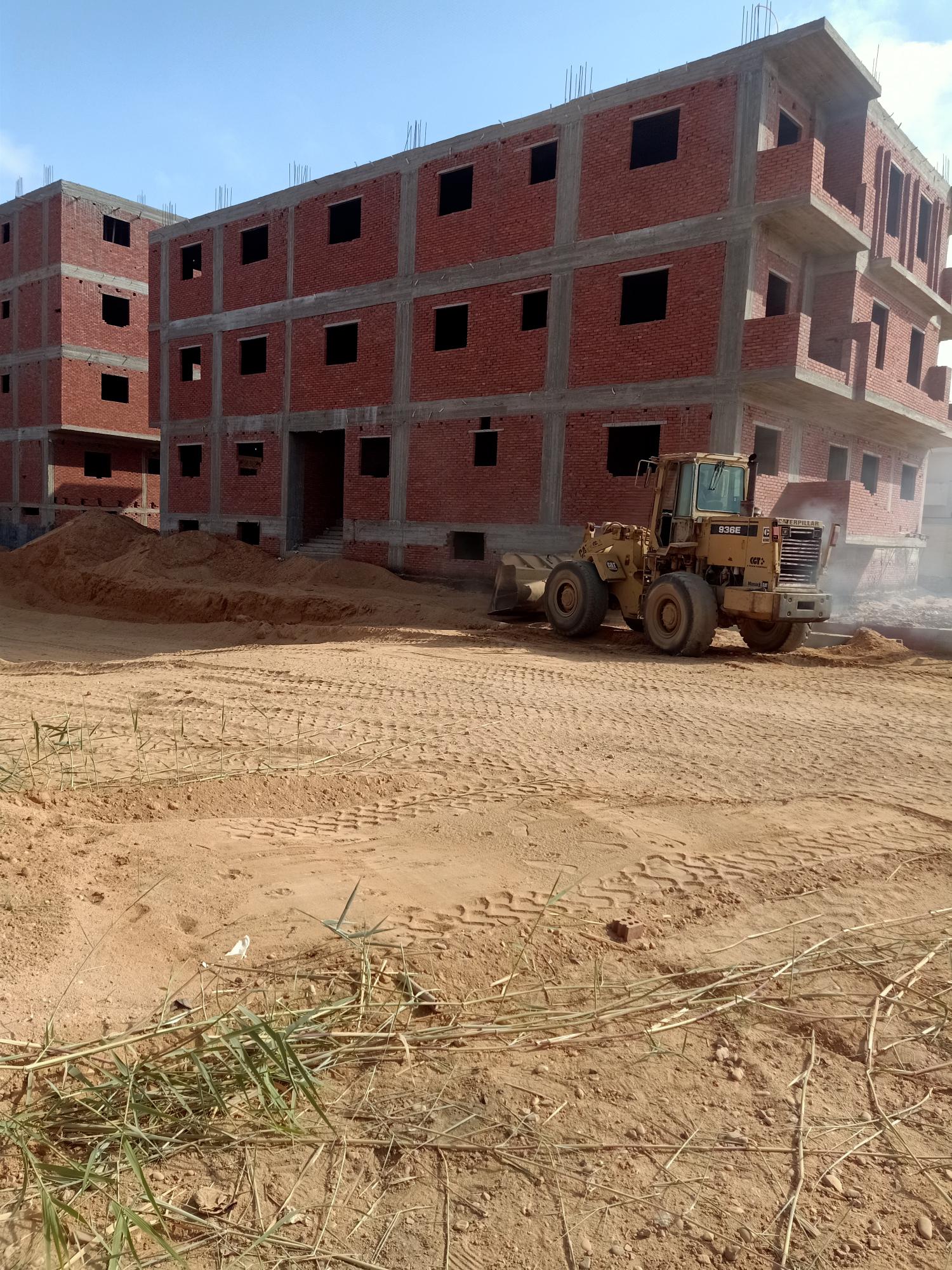

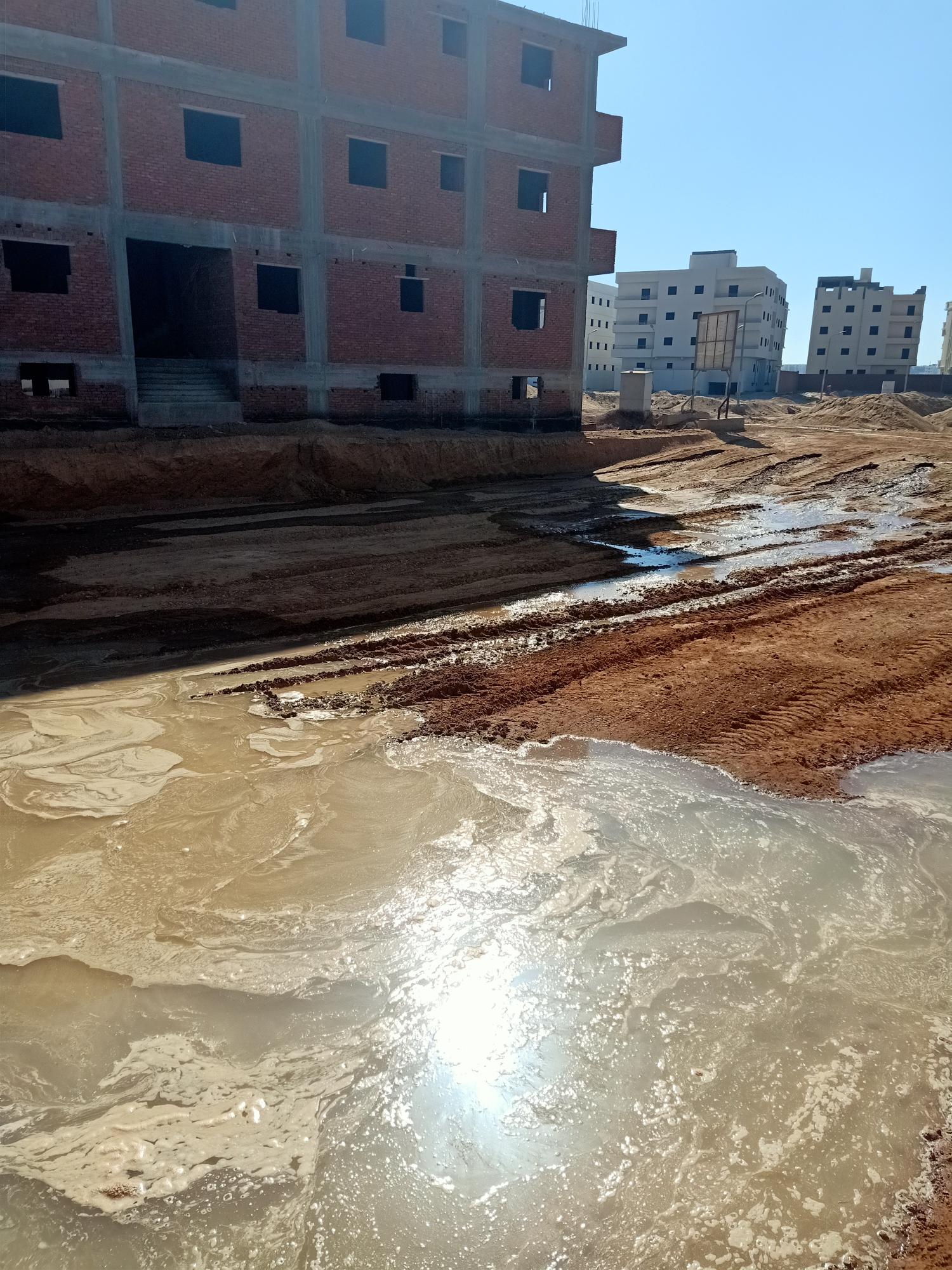

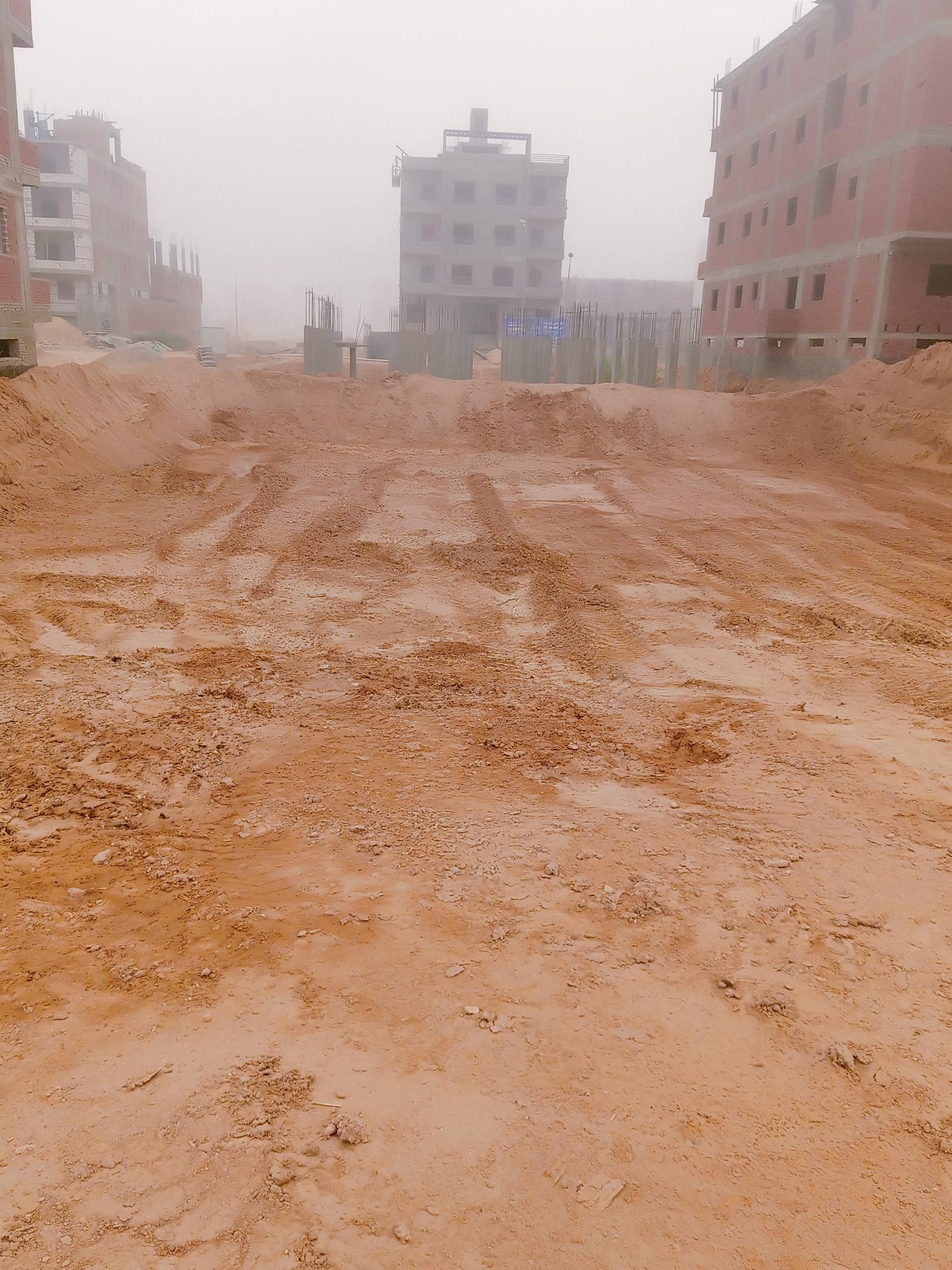

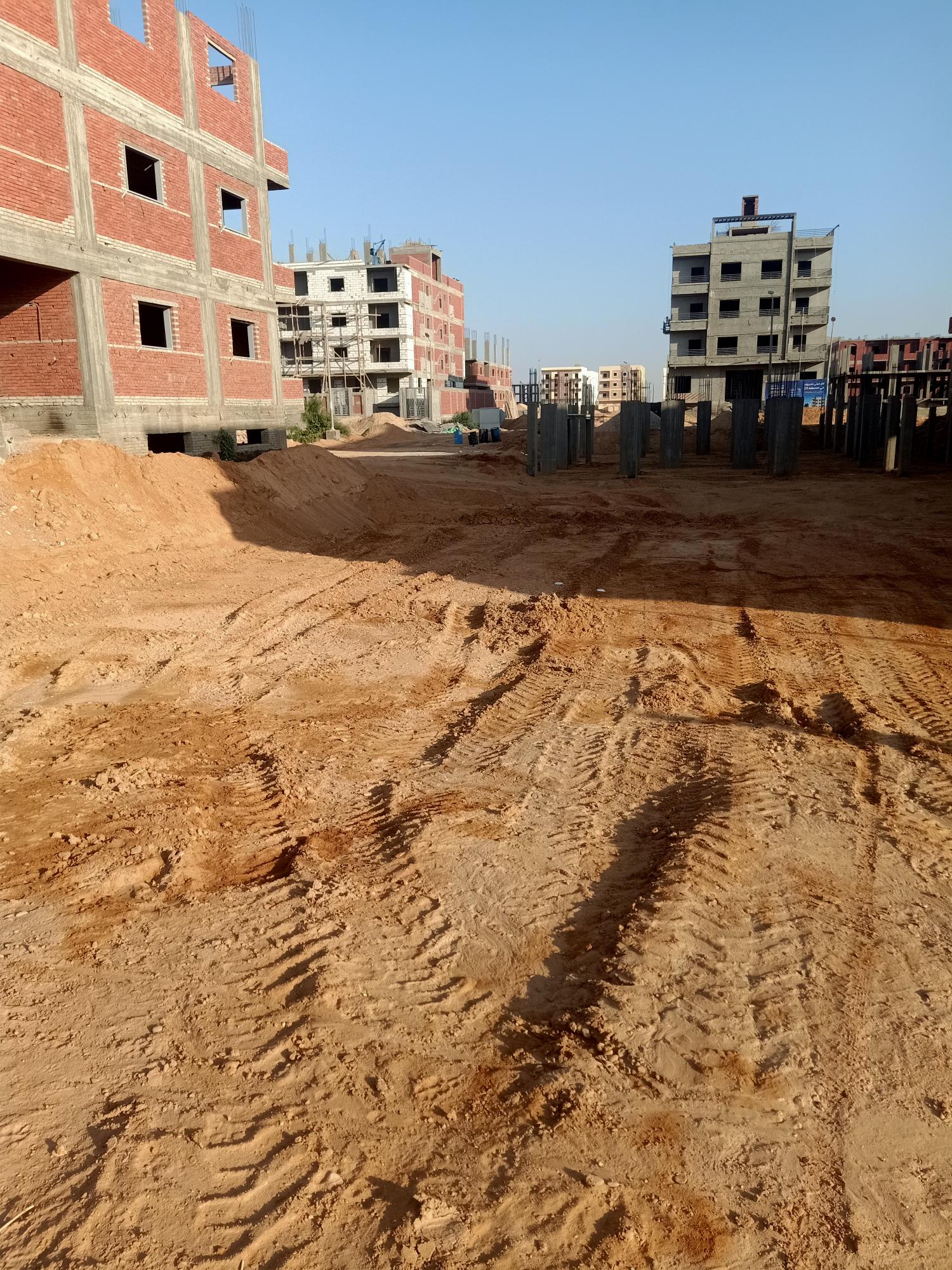

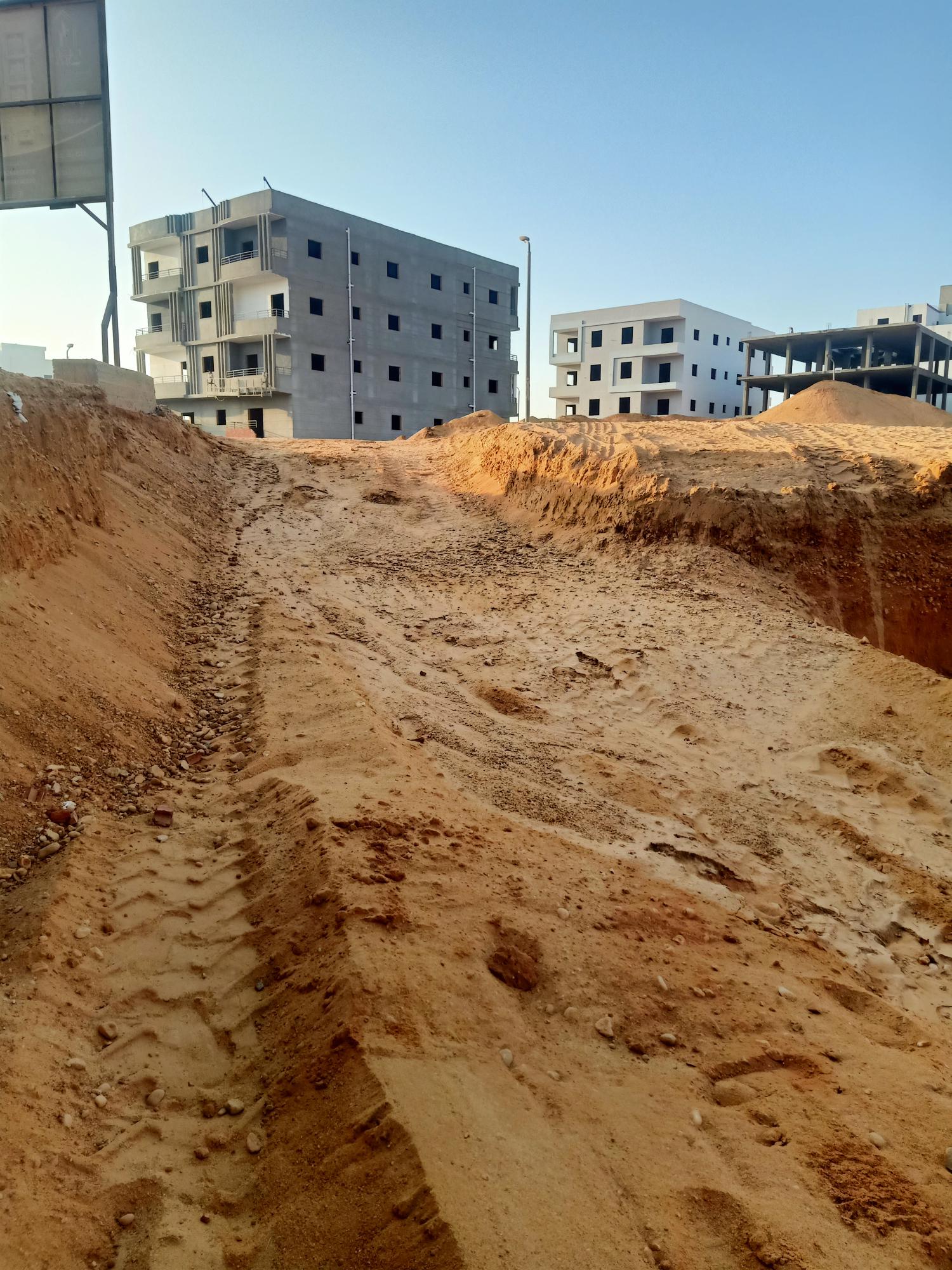

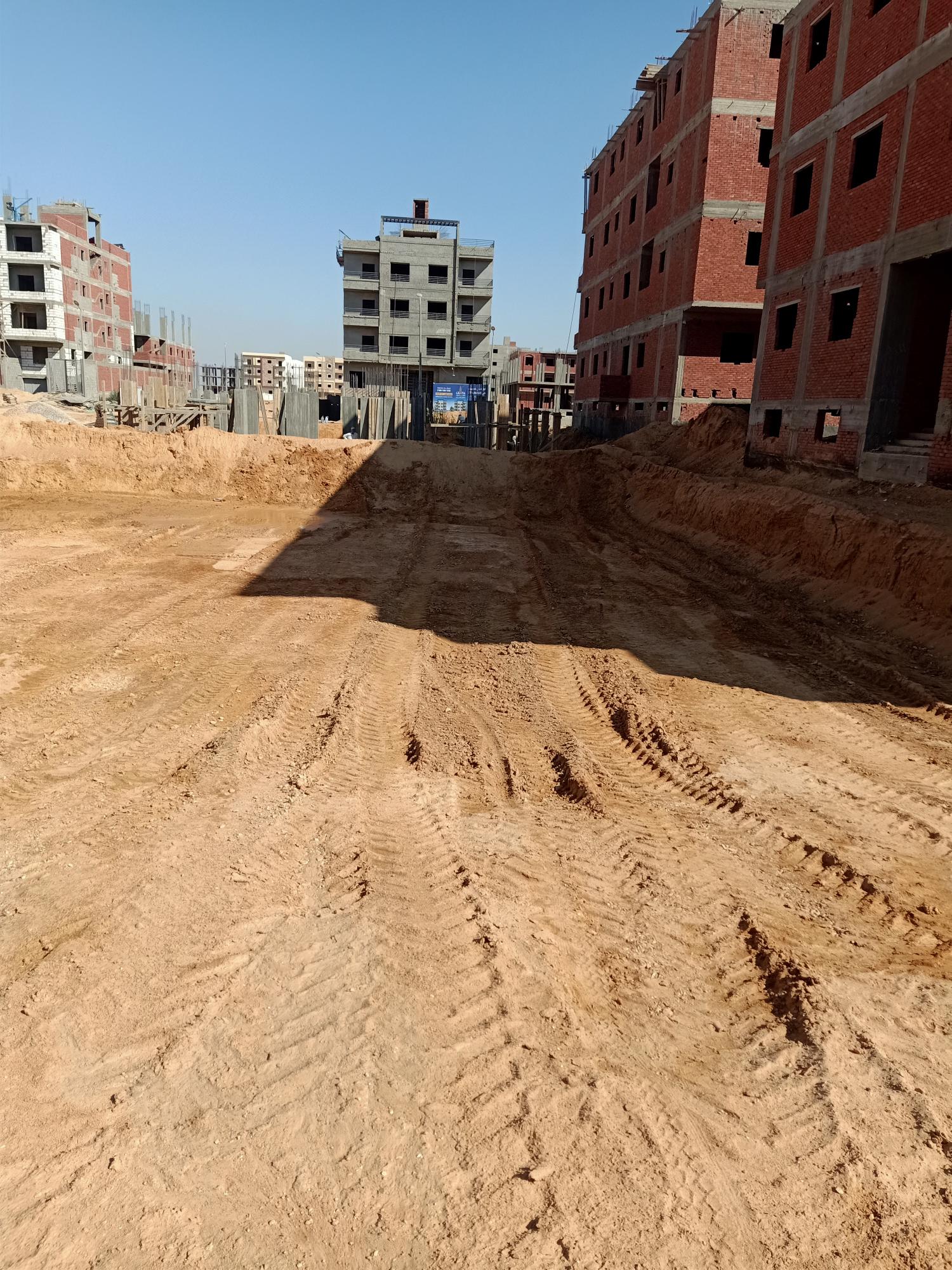

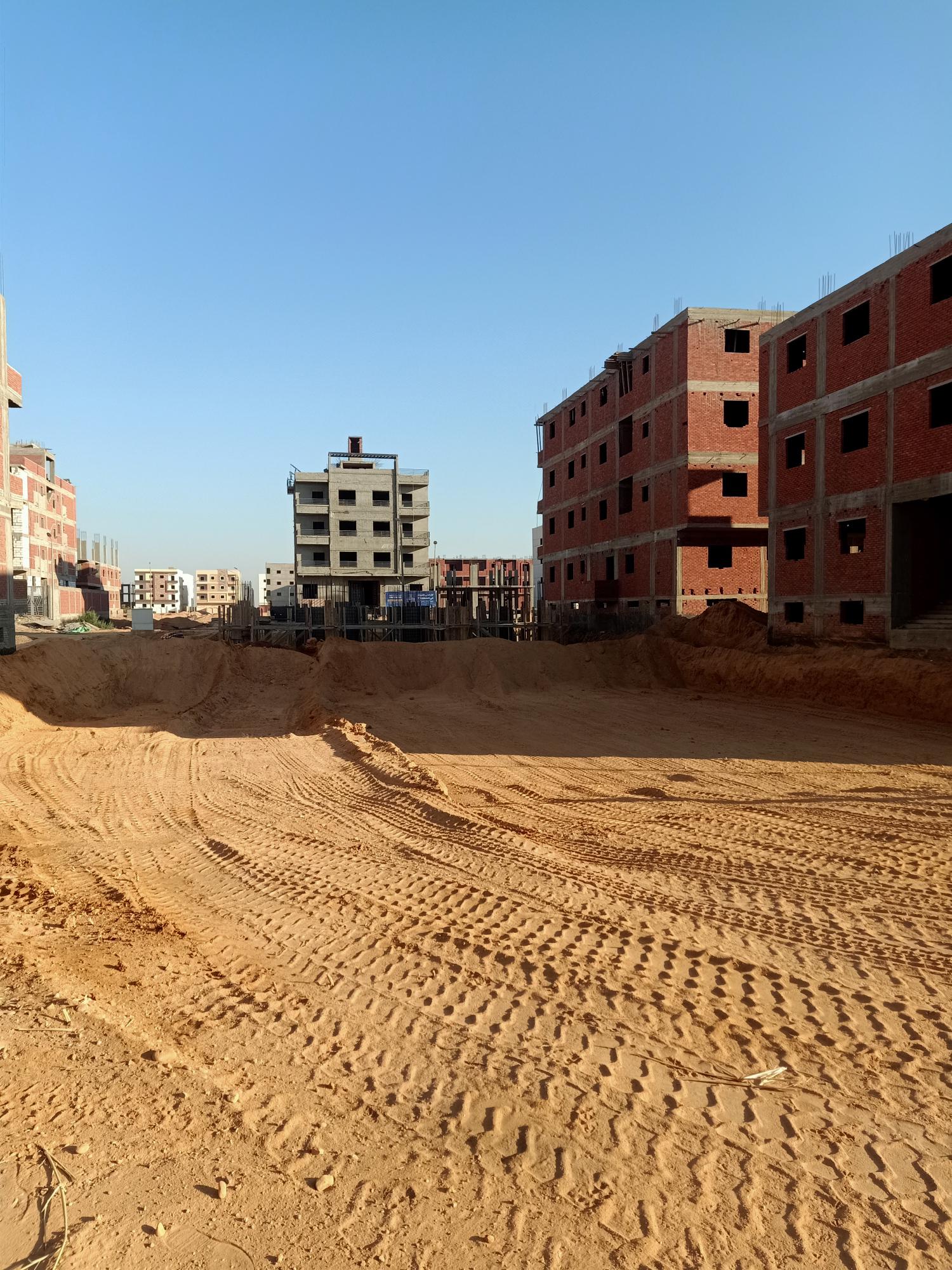

Excavation
January 6, 2026
Plain foundations
July 4, 2025
Reinforced foundations
July 9, 2025
License office contract
July 22, 2025
Basement columns
July 24, 2025
Basement slab
August 3, 2025
Ground floor columns
August 24, 2025
Ground floor slab
September 3, 2025
Backfilling around foundations
September 24, 2025
Footings insulation
September 24, 2025
First floor columns
September 27, 2025
First floor slab
October 7, 2025

Submitting the license
November 10, 2025
Second floor columns
October 28, 2025
Second floor slab
November 7, 2025
Receiving the license
April 1, 2026

Excavation permit
June 8, 2026
Construction contract in progress
November 17, 2025
Construction contract signed
November 18, 2025
December 27, 2025
Third floor columns
February 20, 2026
Third floor slab
February 27, 2026
Fence columns
February 27, 2026
February 28, 2026
Submitting third-floor extension license
March 30, 2026
Roof concrete works
June 18, 2026
Basement walls
July 19, 2026
Roof extension license
July 20, 2026
Ground floor walls
July 29, 2026
First floor walls
August 8, 2026
Second floor walls
August 9, 2026
Wooden door frames
September 8, 2026
Plumbing main works
September 13, 2026
Electrical final finishes
September 23, 2026
Plaster and putty
October 3, 2026
November 22, 2026
November 22, 2026
Aluminum & glass works (Krital)
November 22, 2026
Elevator
November 22, 2026
Plumbing finishing
November 22, 2026
Electrical finishing
December 7, 2026
Marble finishing
April 17, 2027
Project handover to the authority
May 5, 2027
Utilities meter installation
May 8, 2027
Third floor walls
August 19, 2027
Roof walls
August 29, 2027
