Project Details
Land Number
1158
Region
The Area 22, El Sadat City
HOMEi Price
7,500.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 15% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
| 5 | During Construction | 5% |
| 6 | During Construction | 5% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
195 m²
Delivery
Unit Delivery Date
December 2026
Average Unit Price
1,090,125 EGP
Project Location
Map View
The Area 22, El Sadat City
HOMEi Timeline
License office contract
March 25, 2025
Submitting the license
April 1, 2025

Receiving the license
May 1, 2025

Excavation permit
June 1, 2025
Mining permit
June 3, 2025
Construction contract in progress
June 15, 2025
Construction contract signed
June 20, 2025

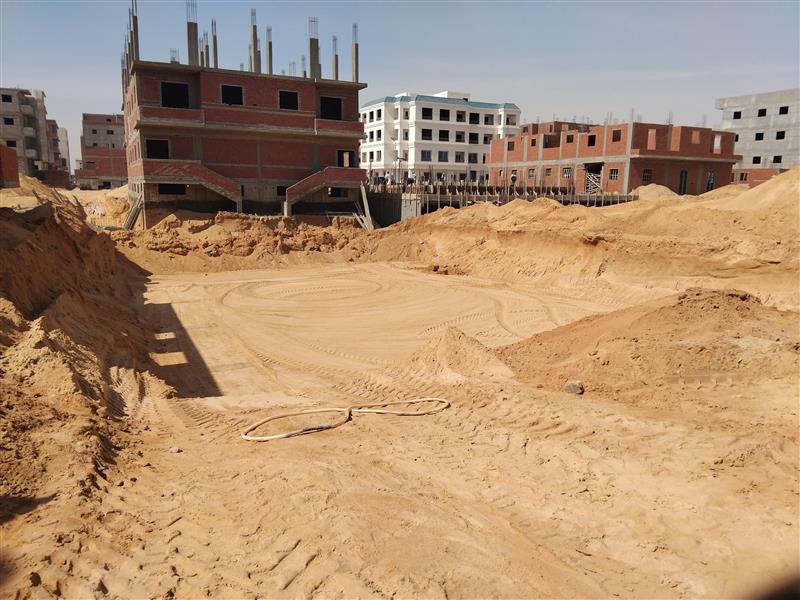

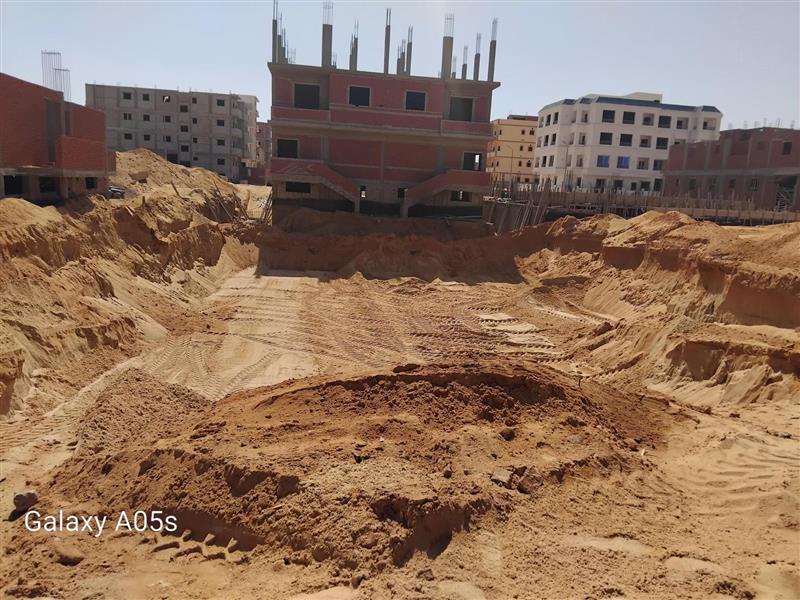

Excavation

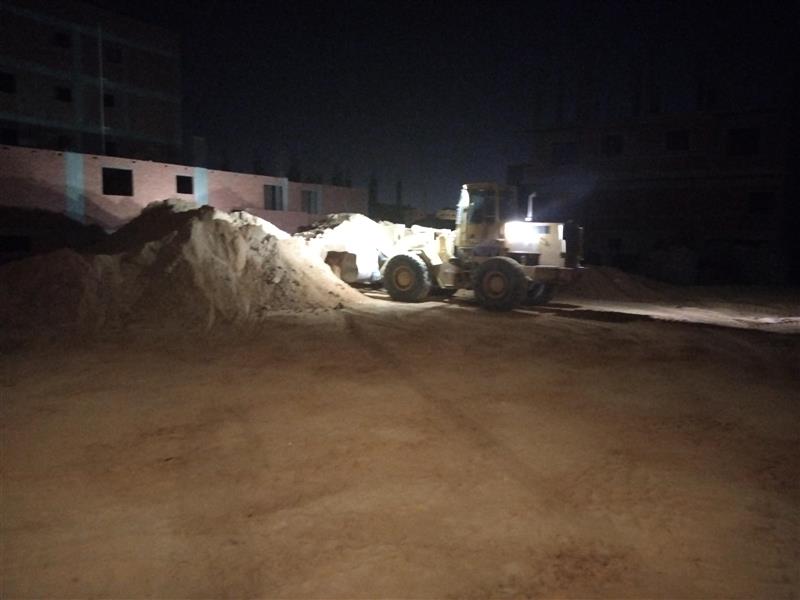

July 4, 2025

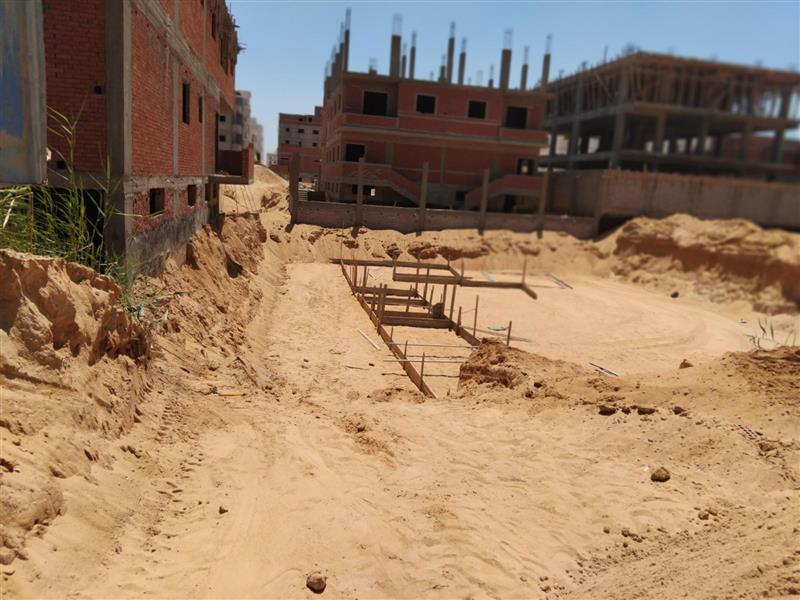

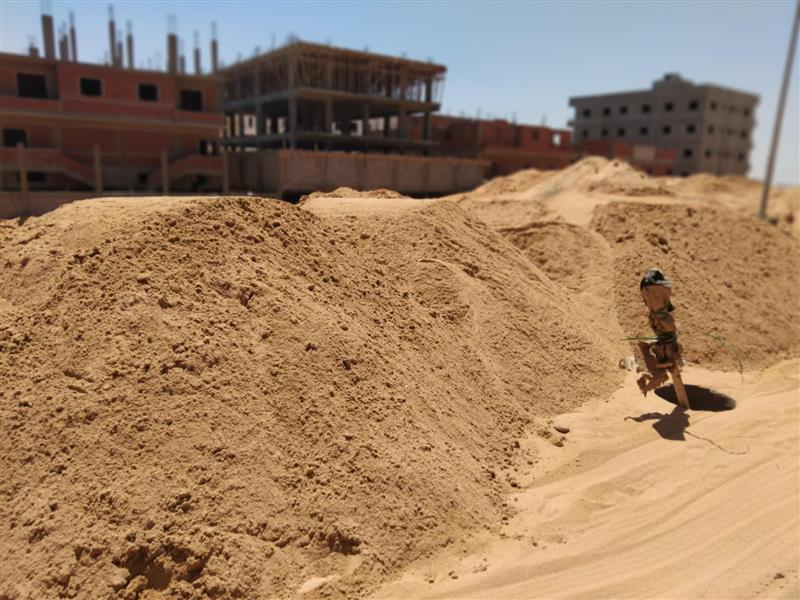

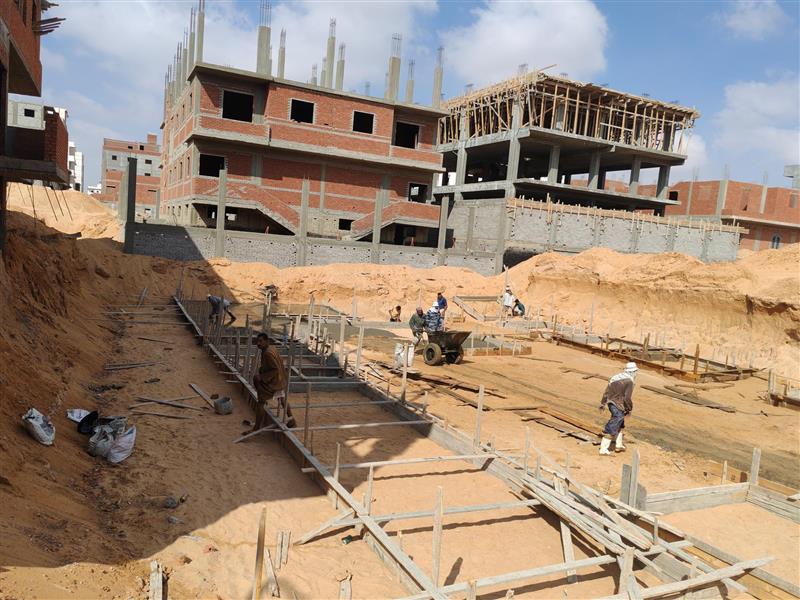

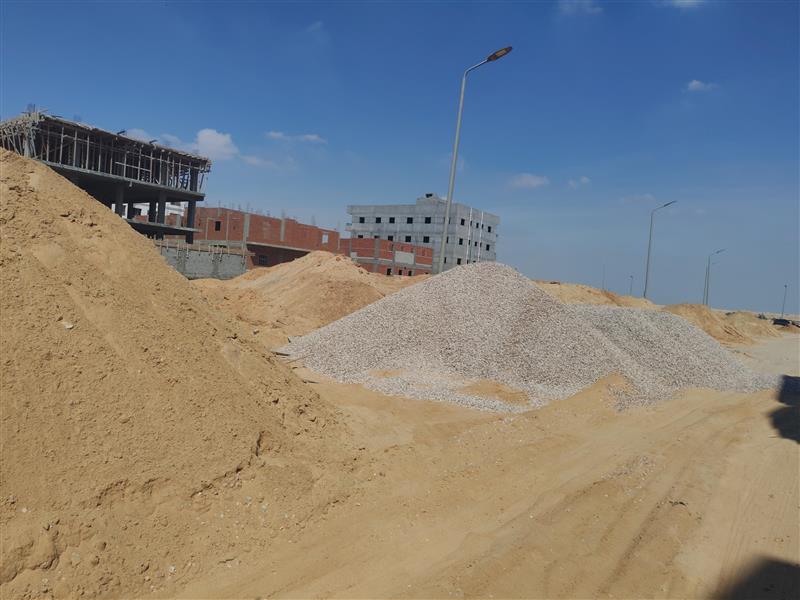

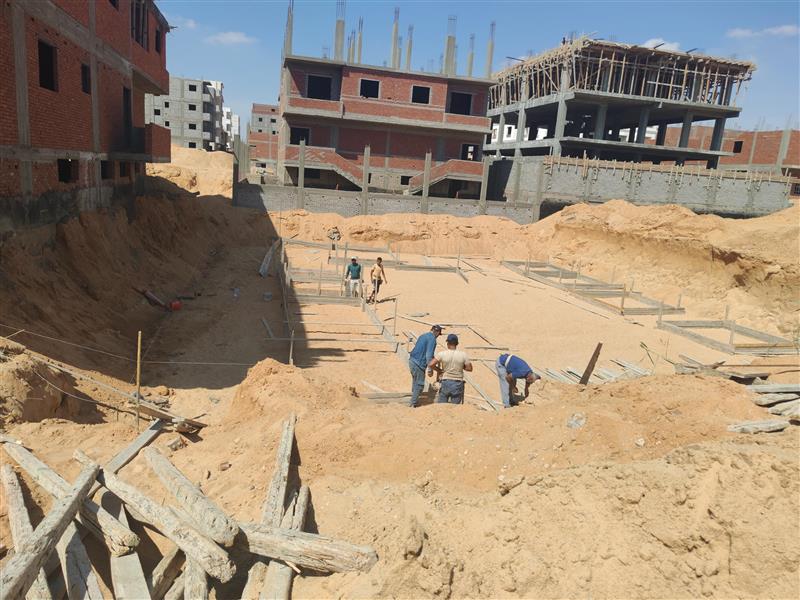

Plain foundations
July 10, 2025

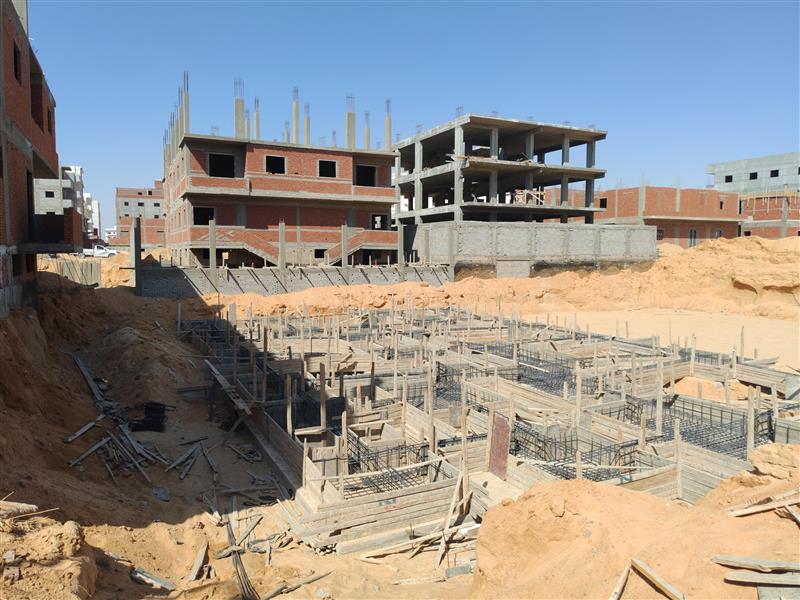

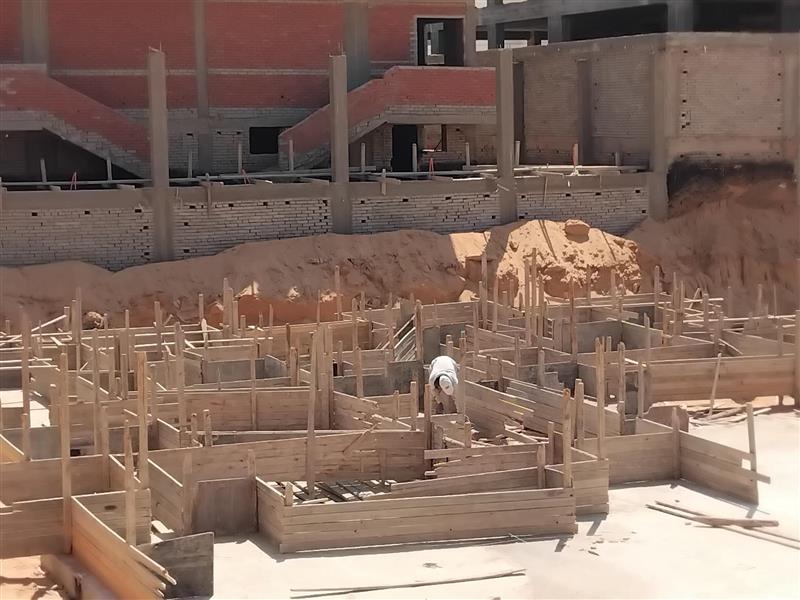

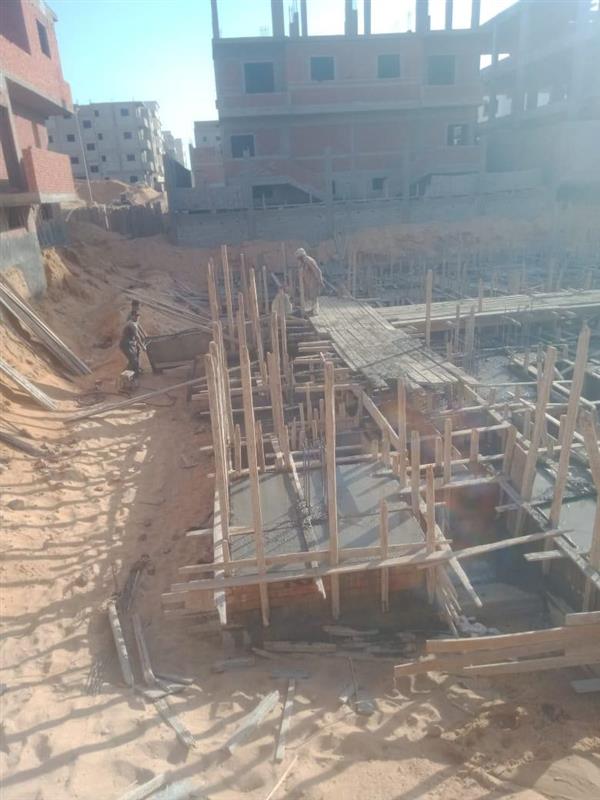

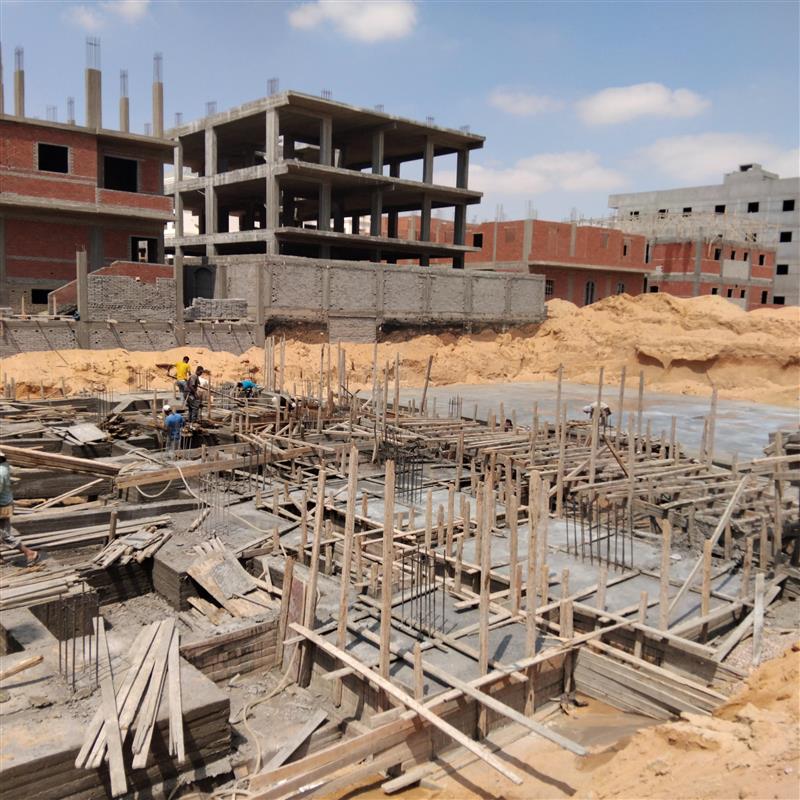

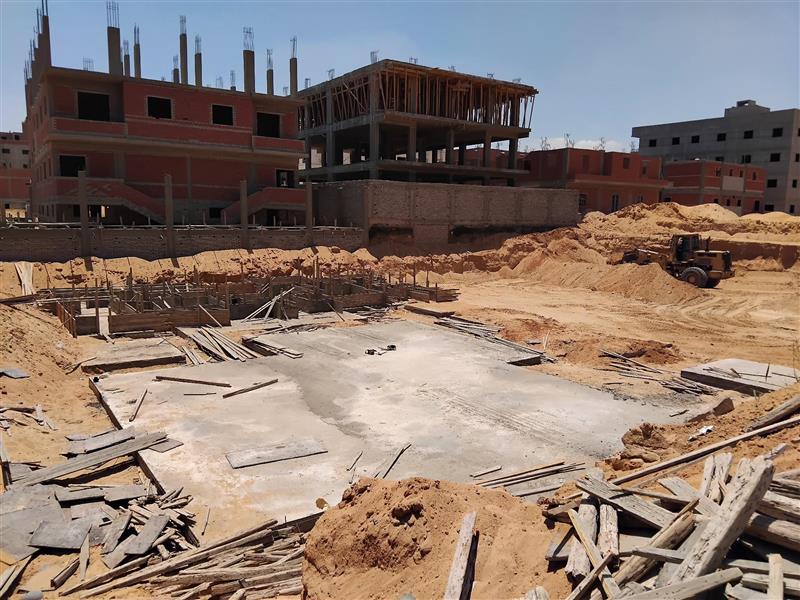

Reinforced foundations
July 19, 2025

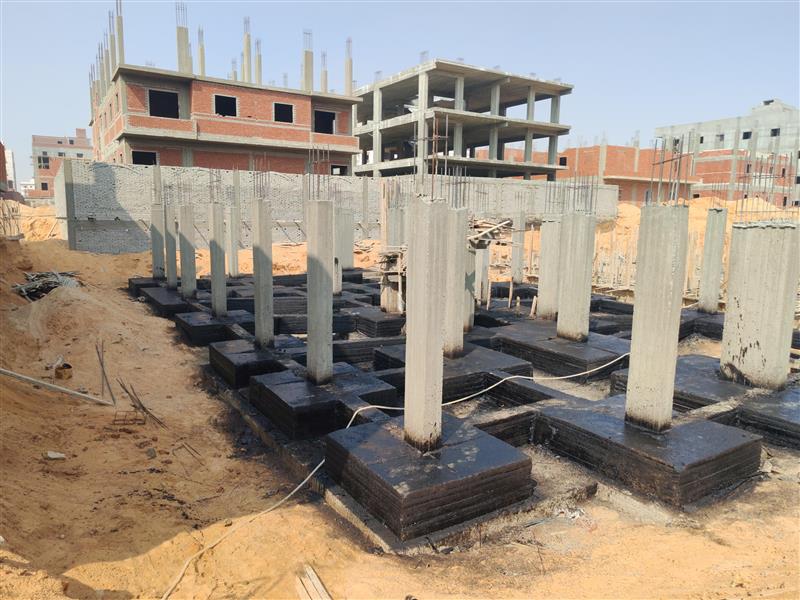

Footings insulation
July 31, 2025

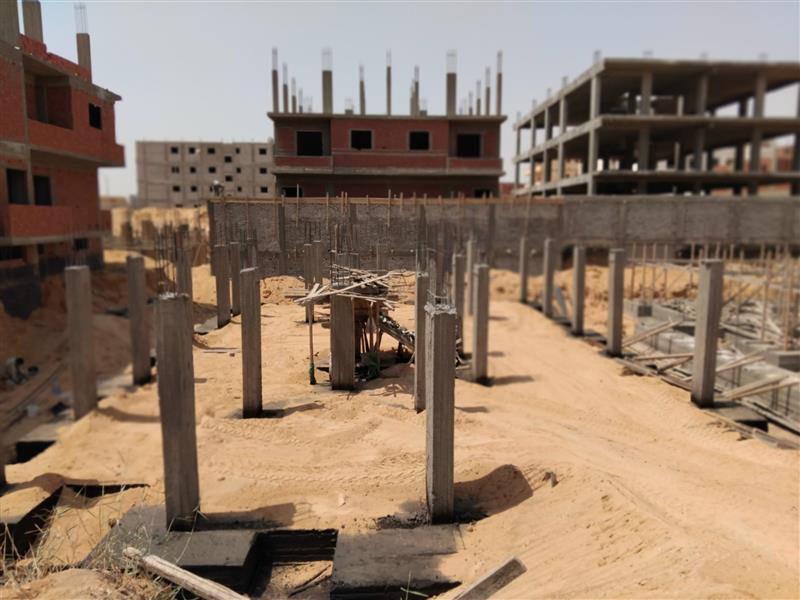

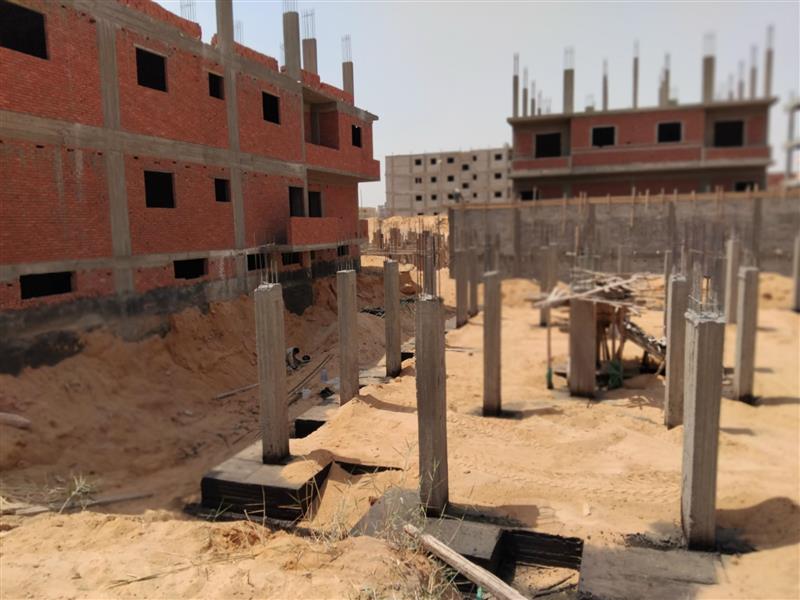

Backfilling around foundations
August 2, 2025

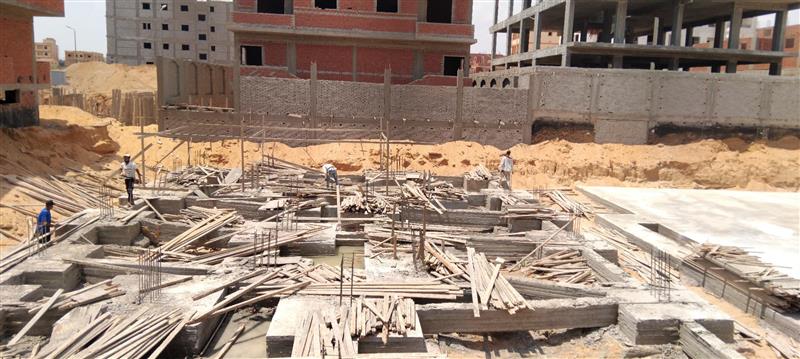

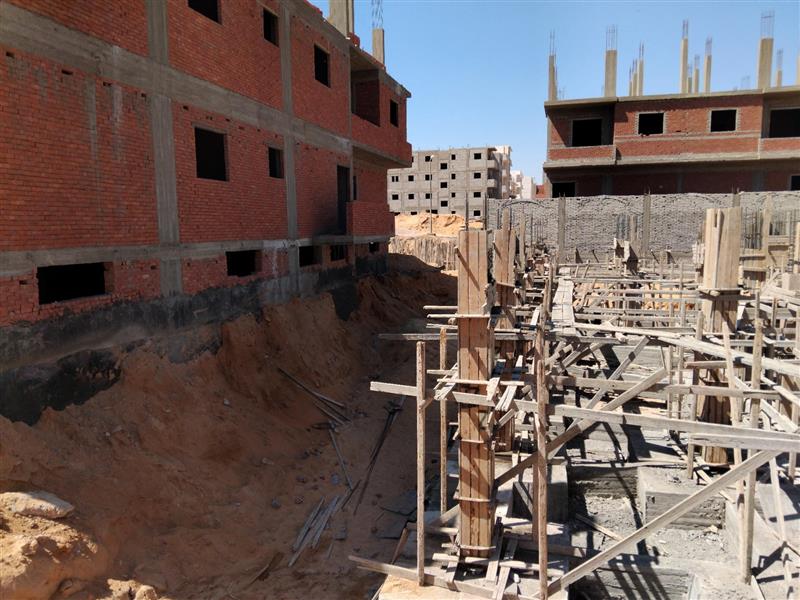

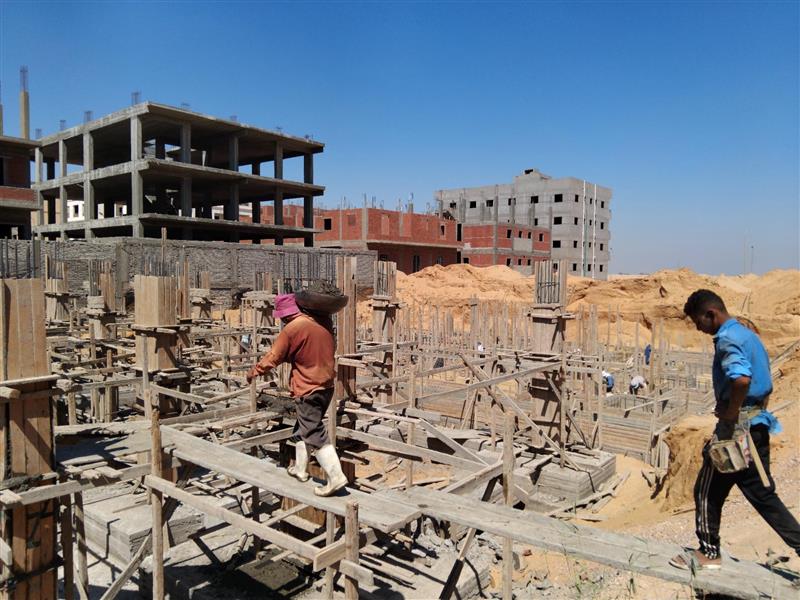

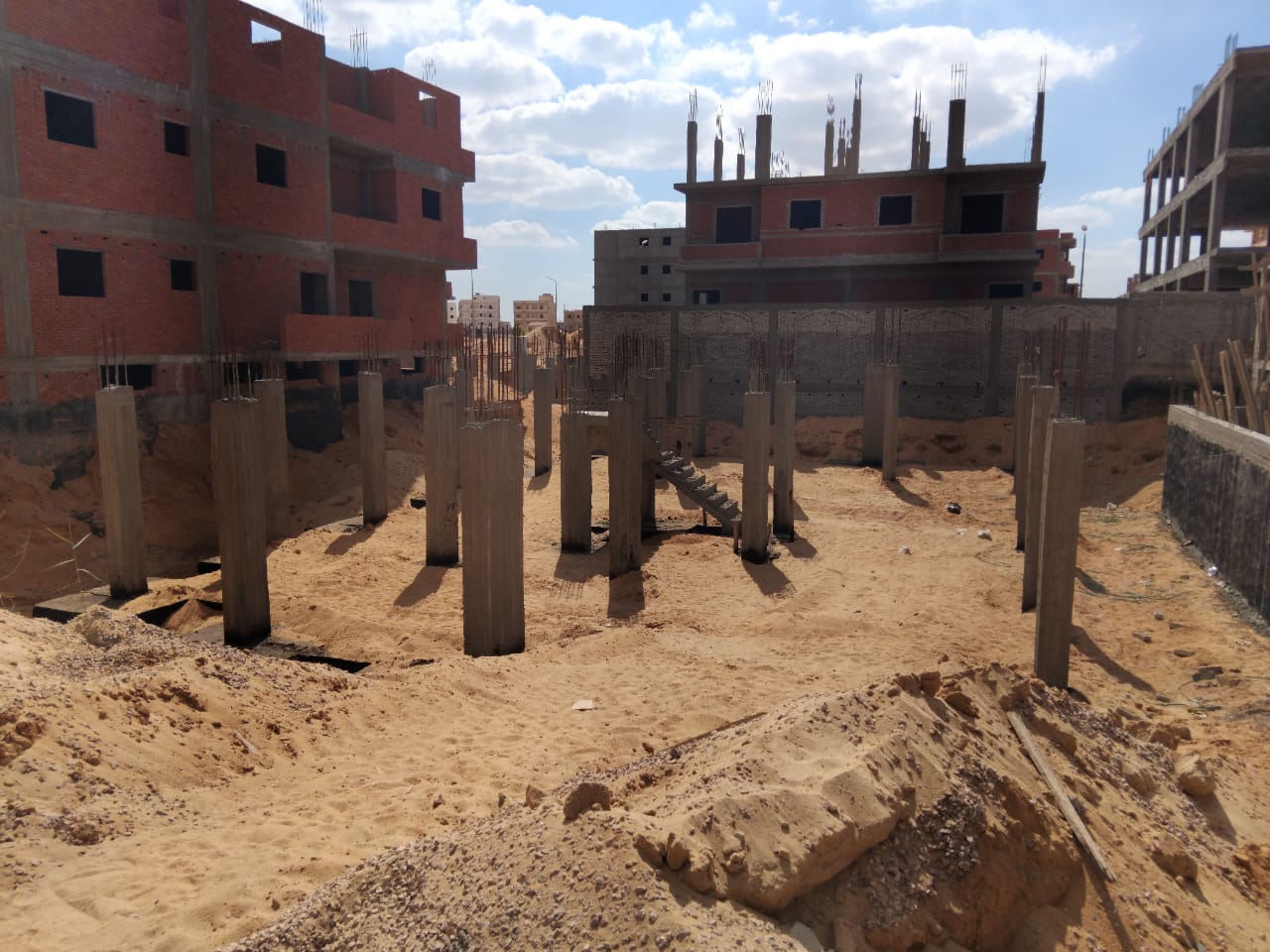

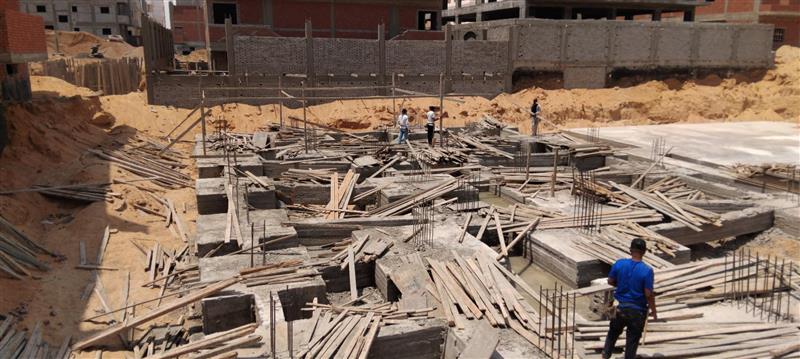

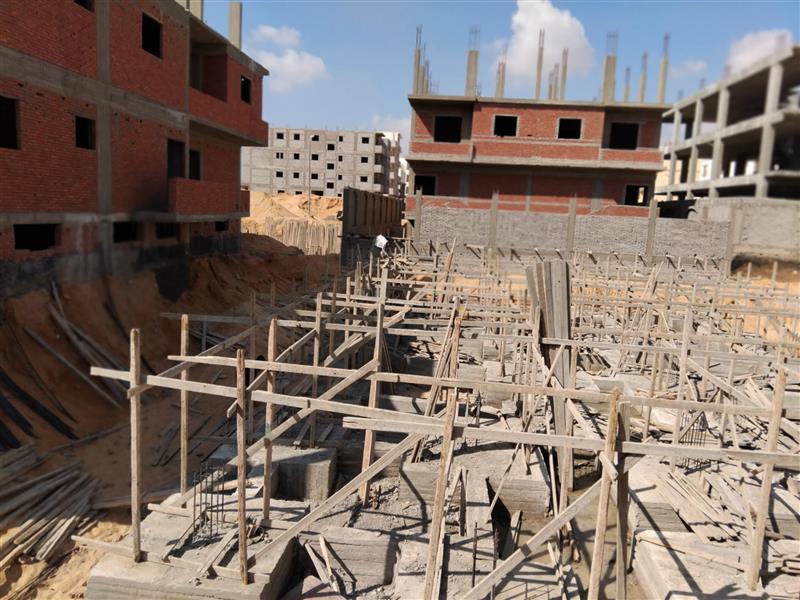

Basement columns

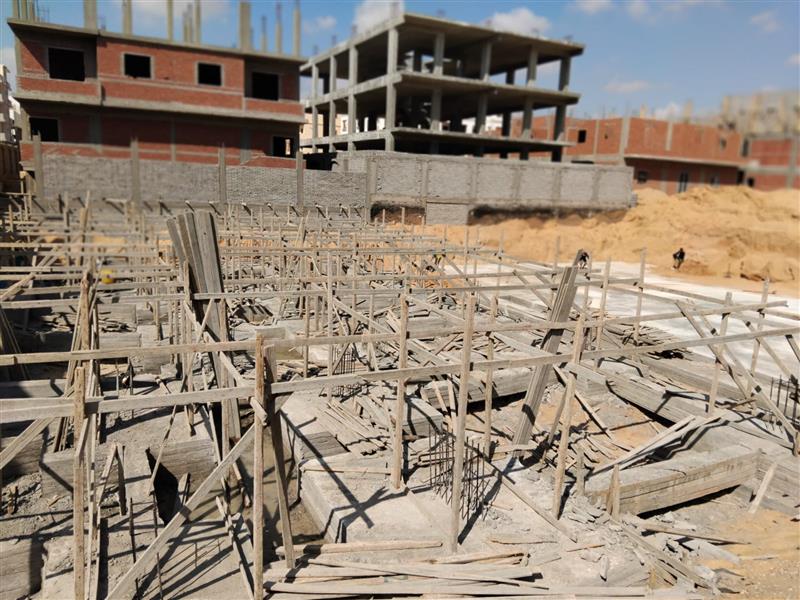

August 3, 2025

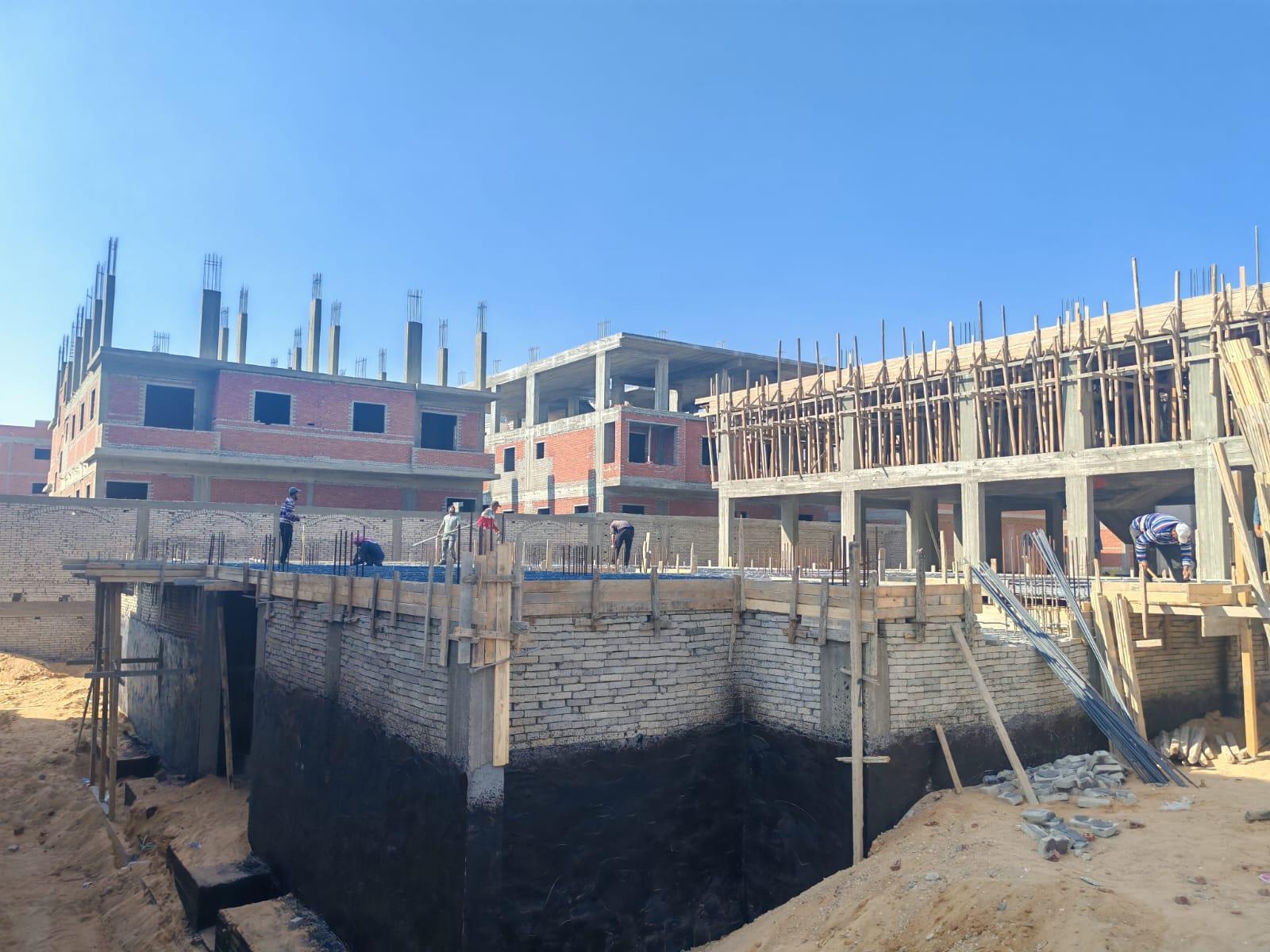

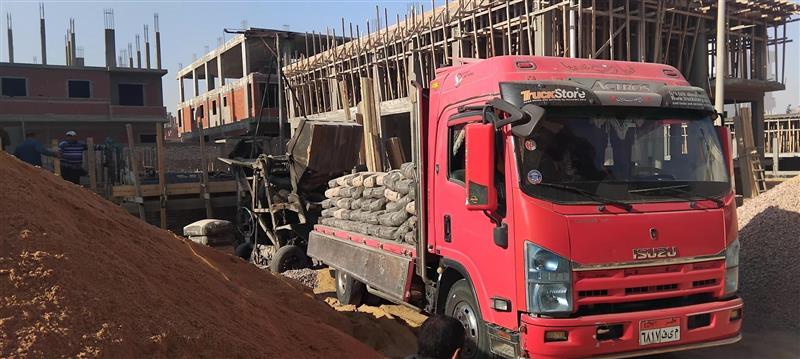

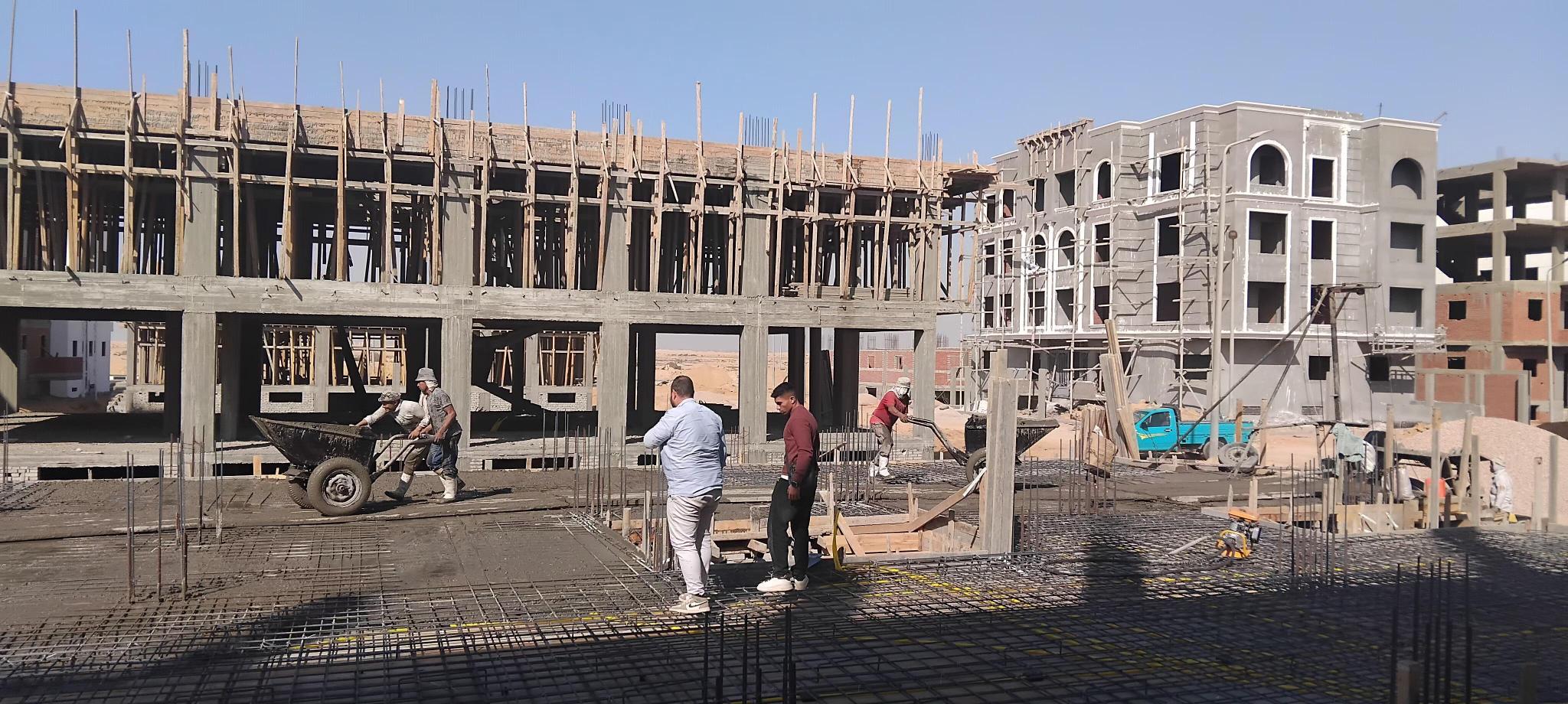

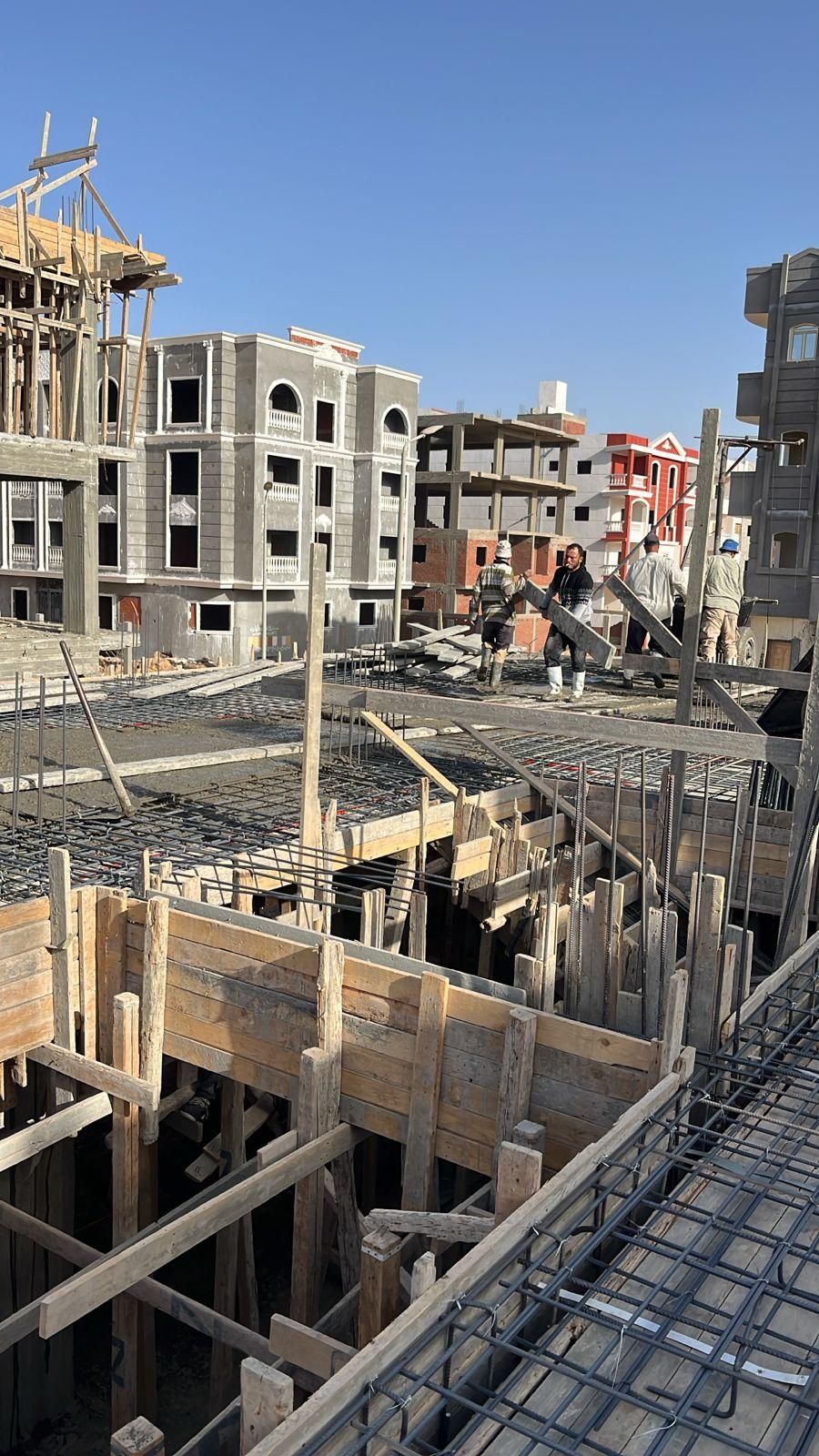

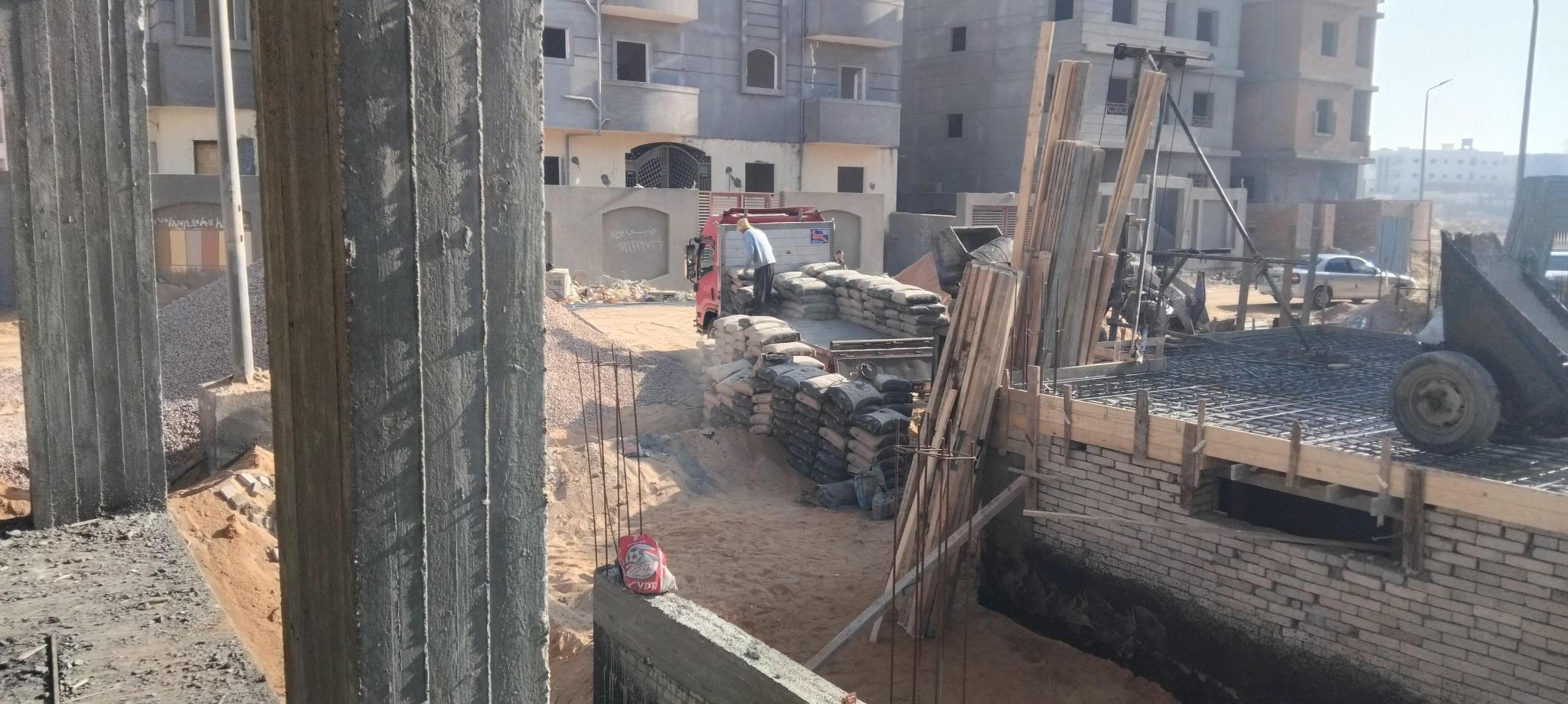

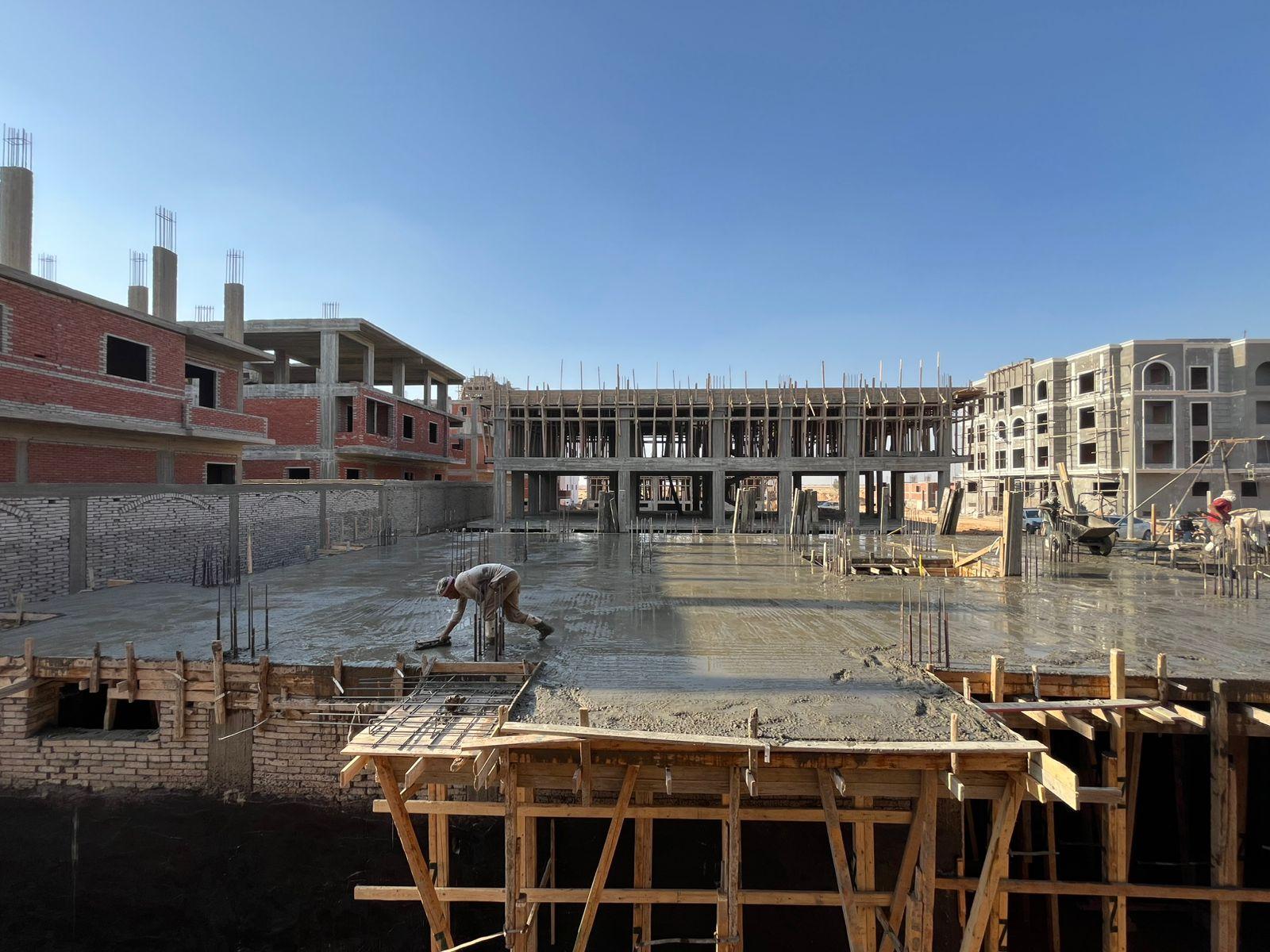

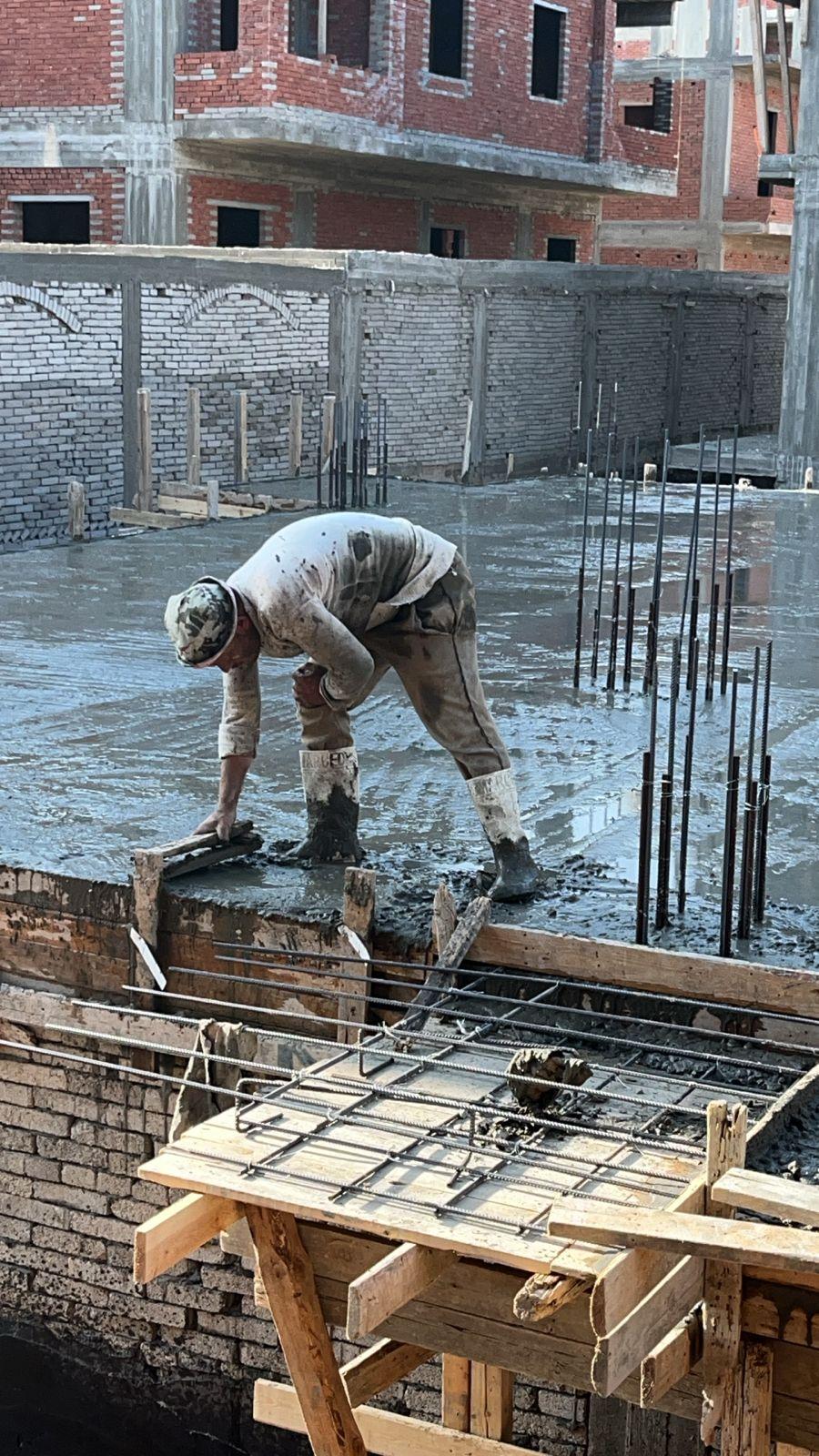

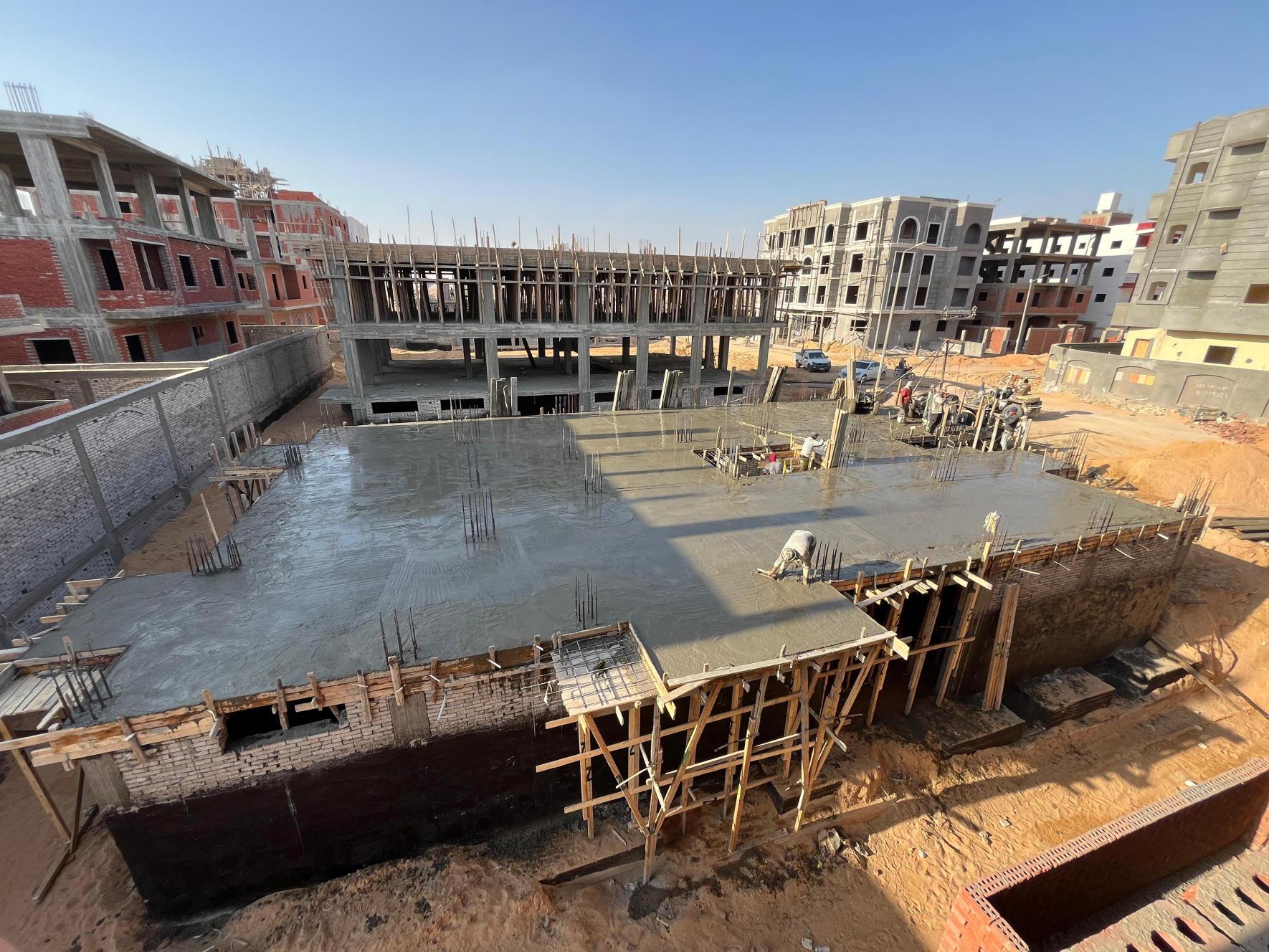

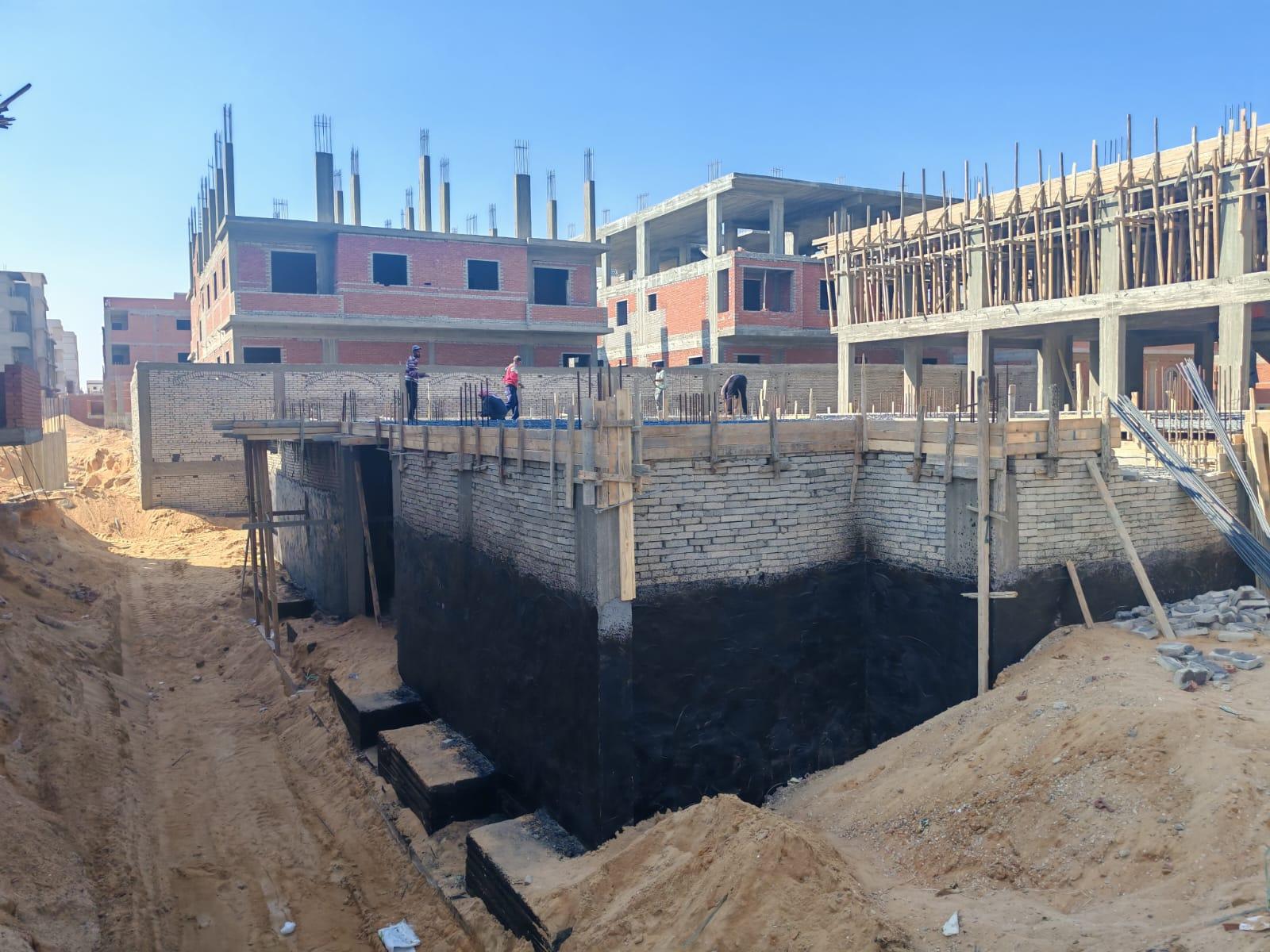

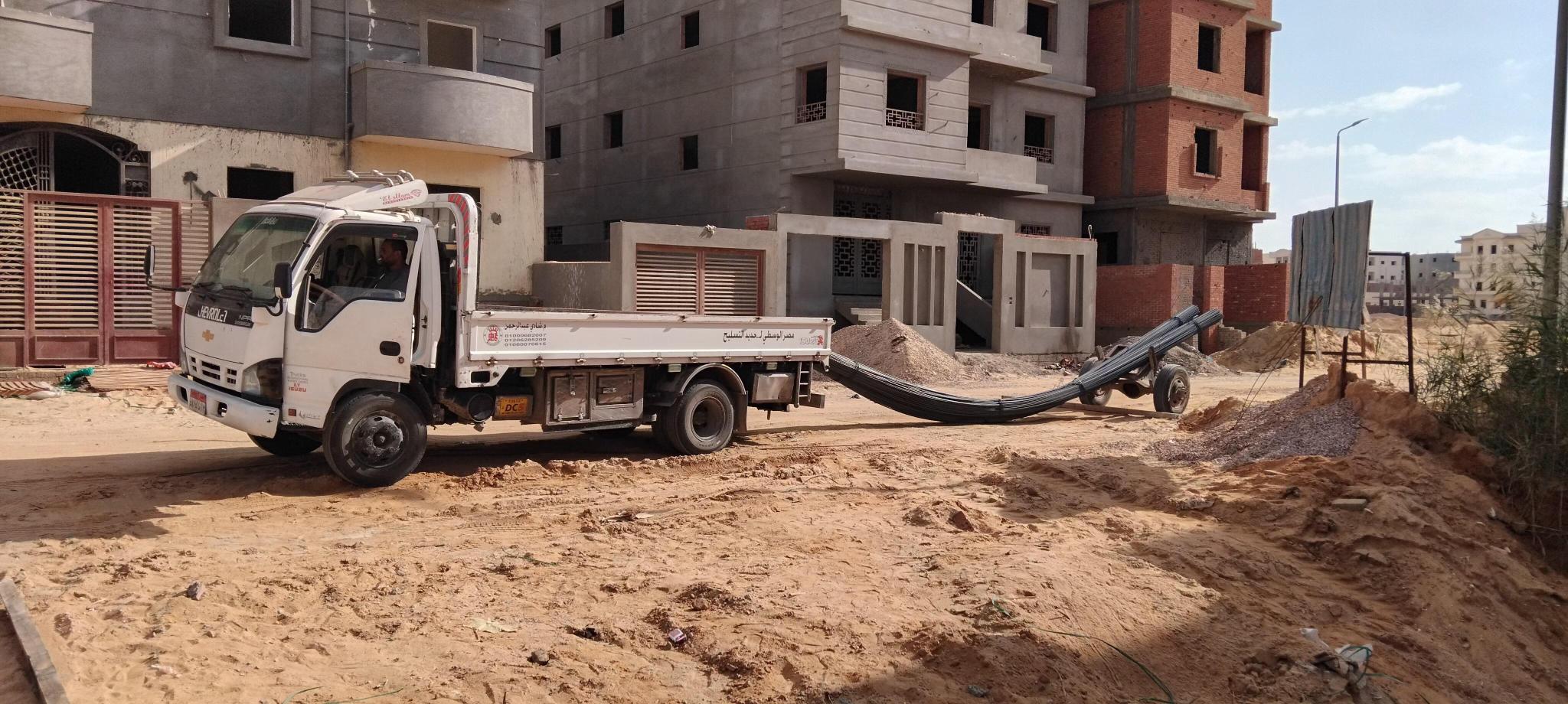

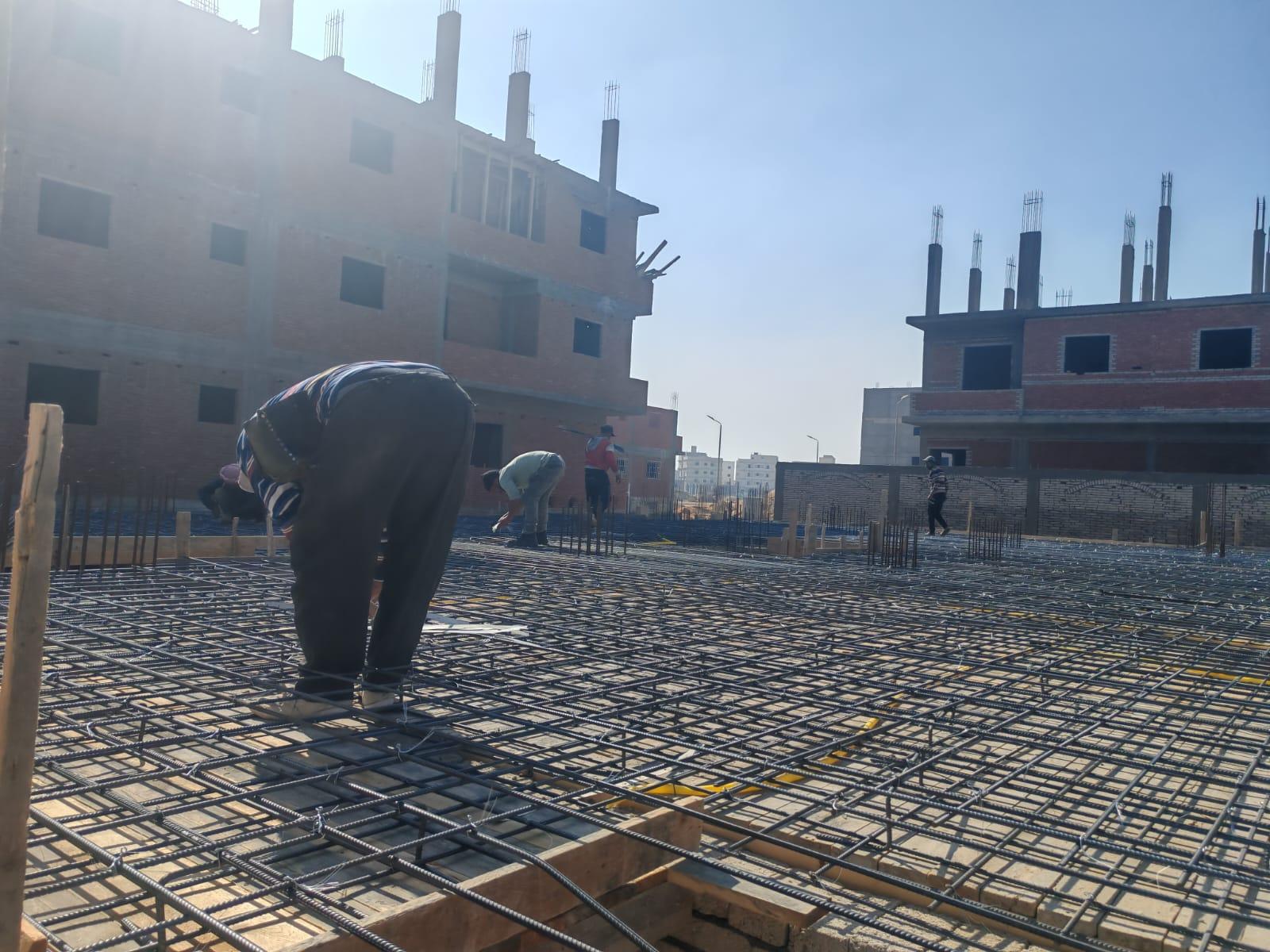

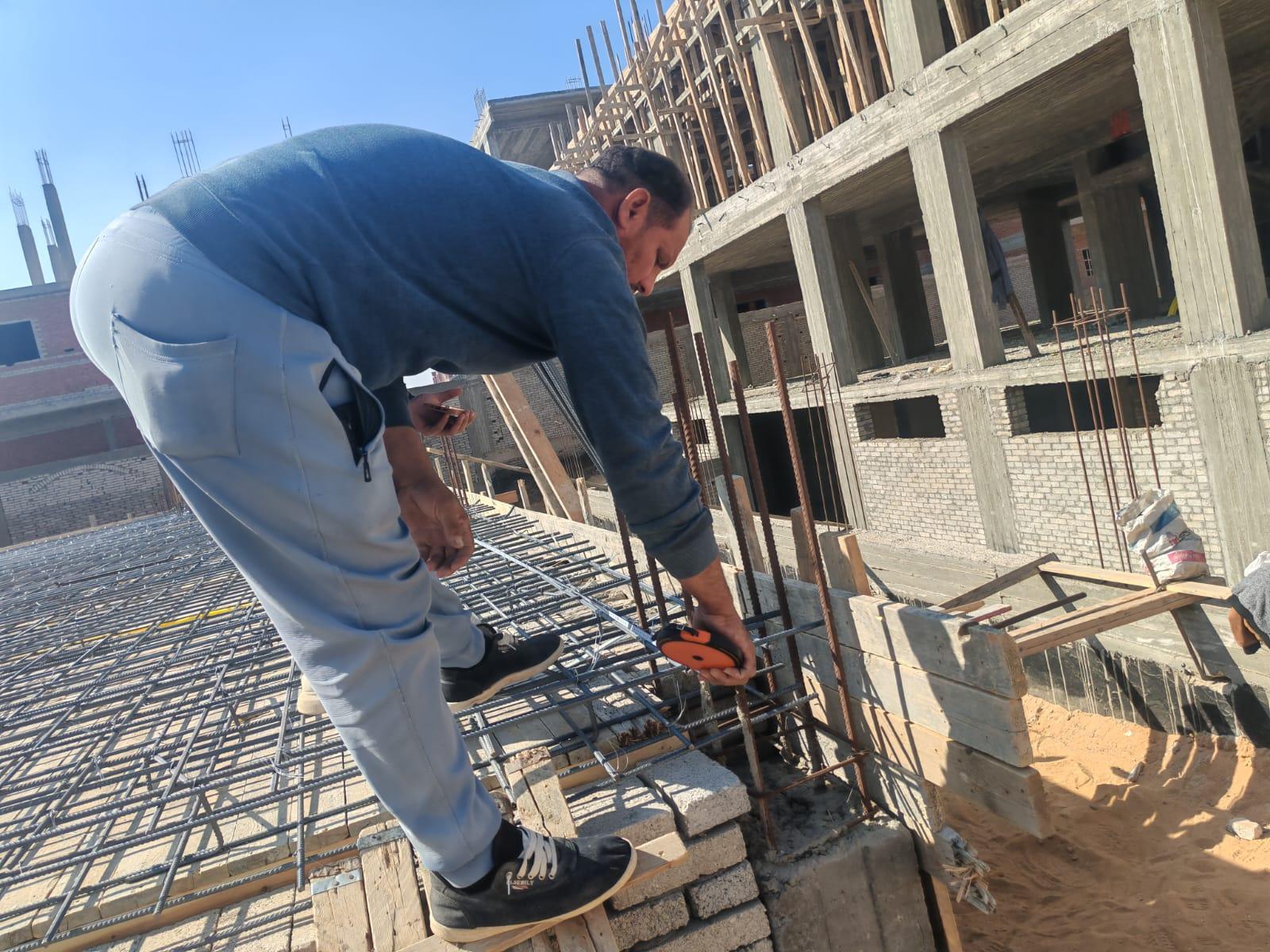

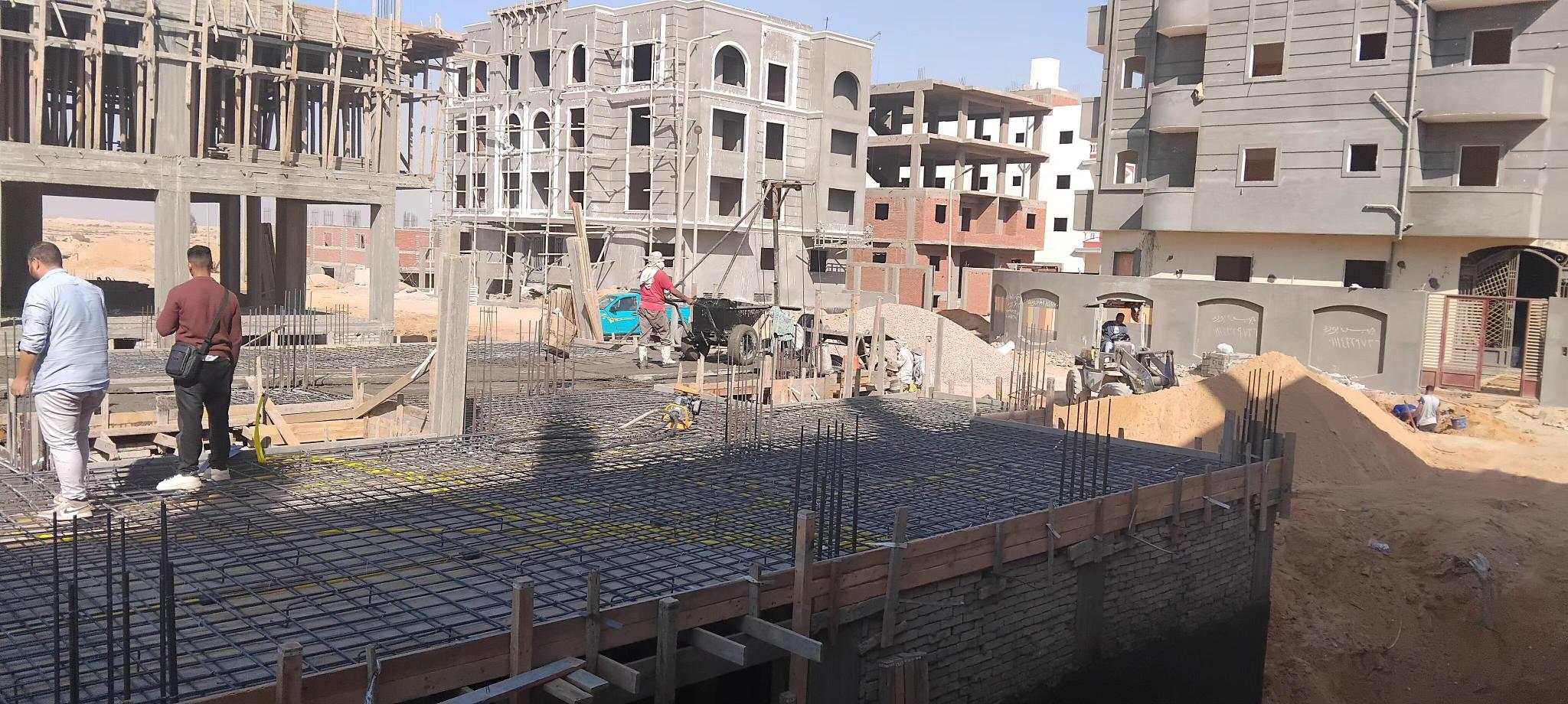

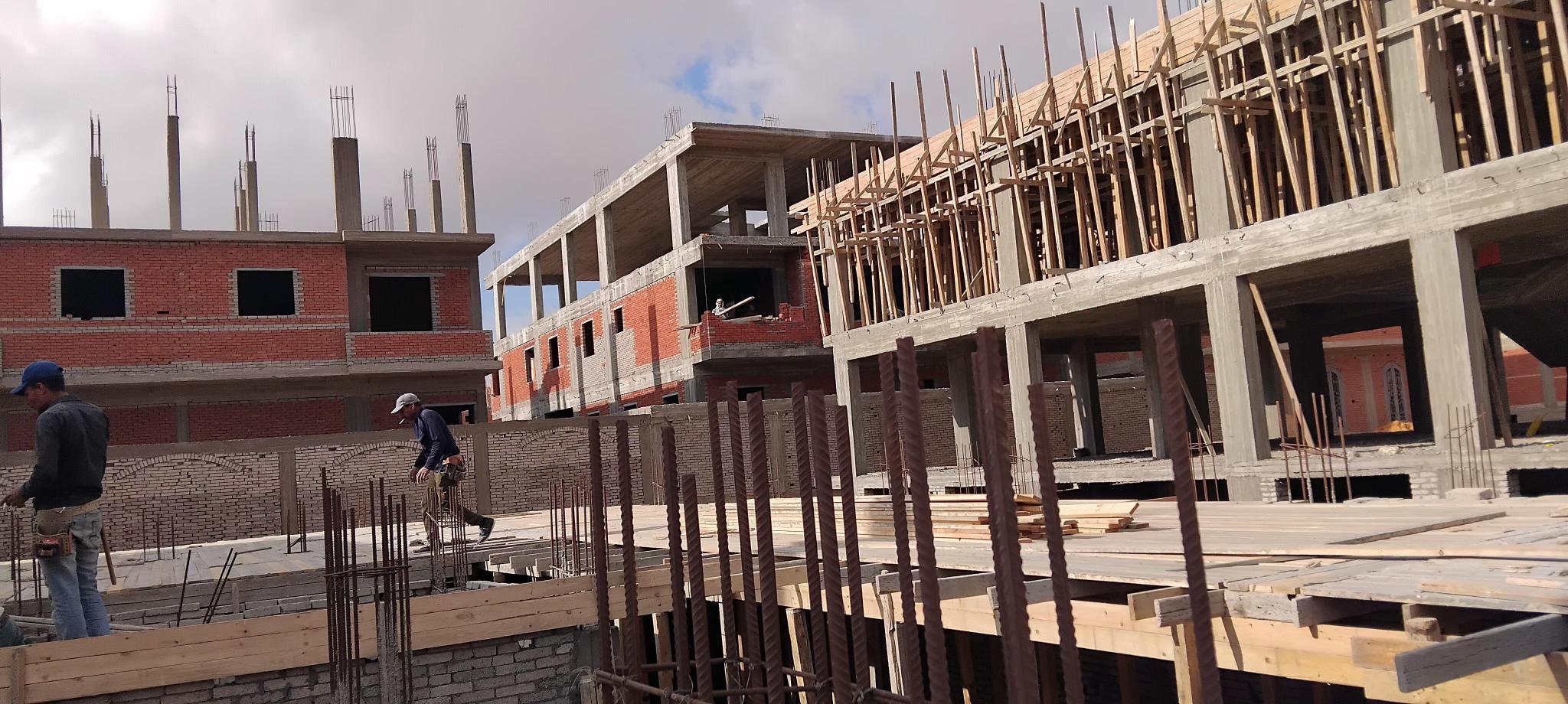

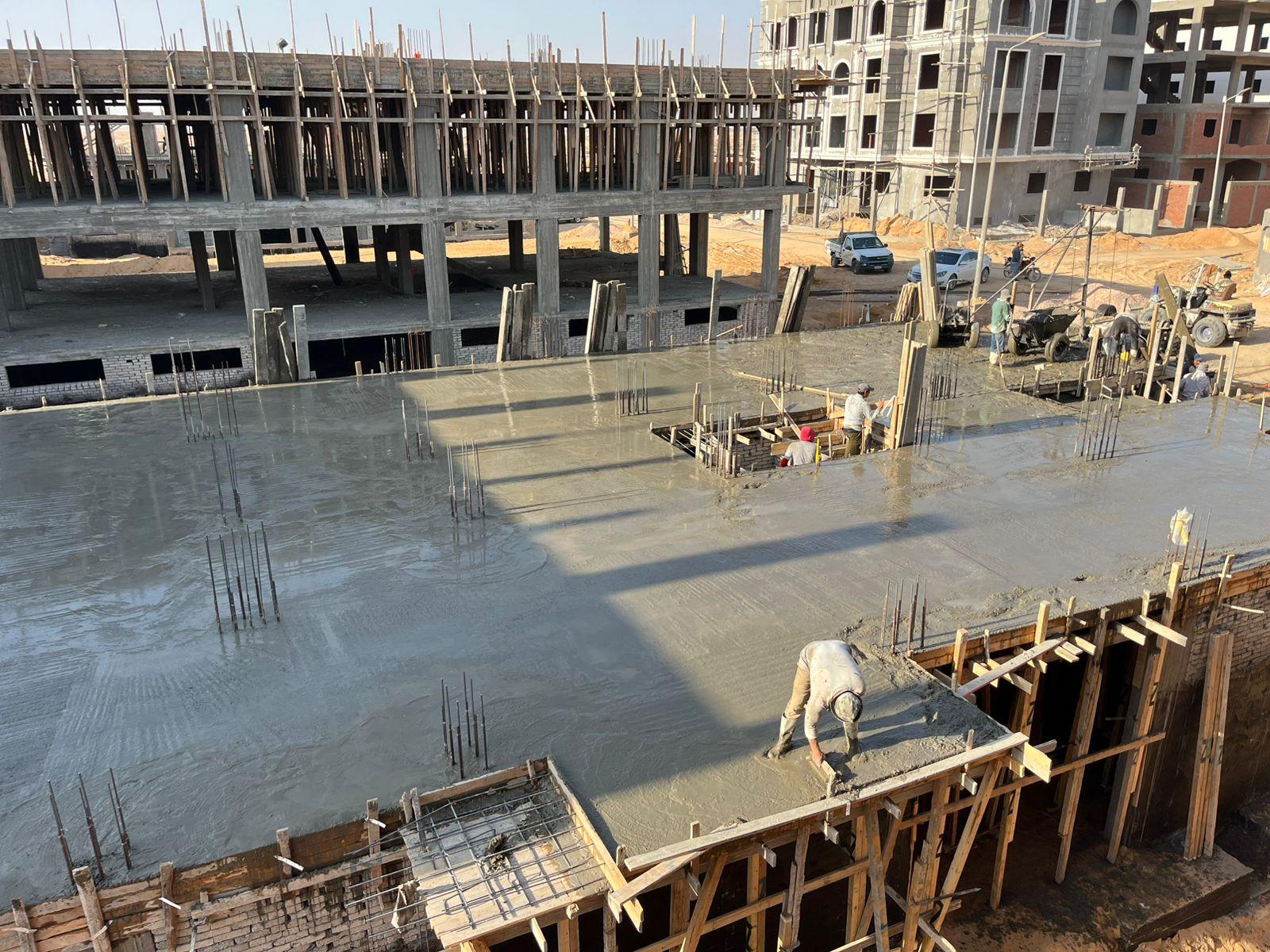

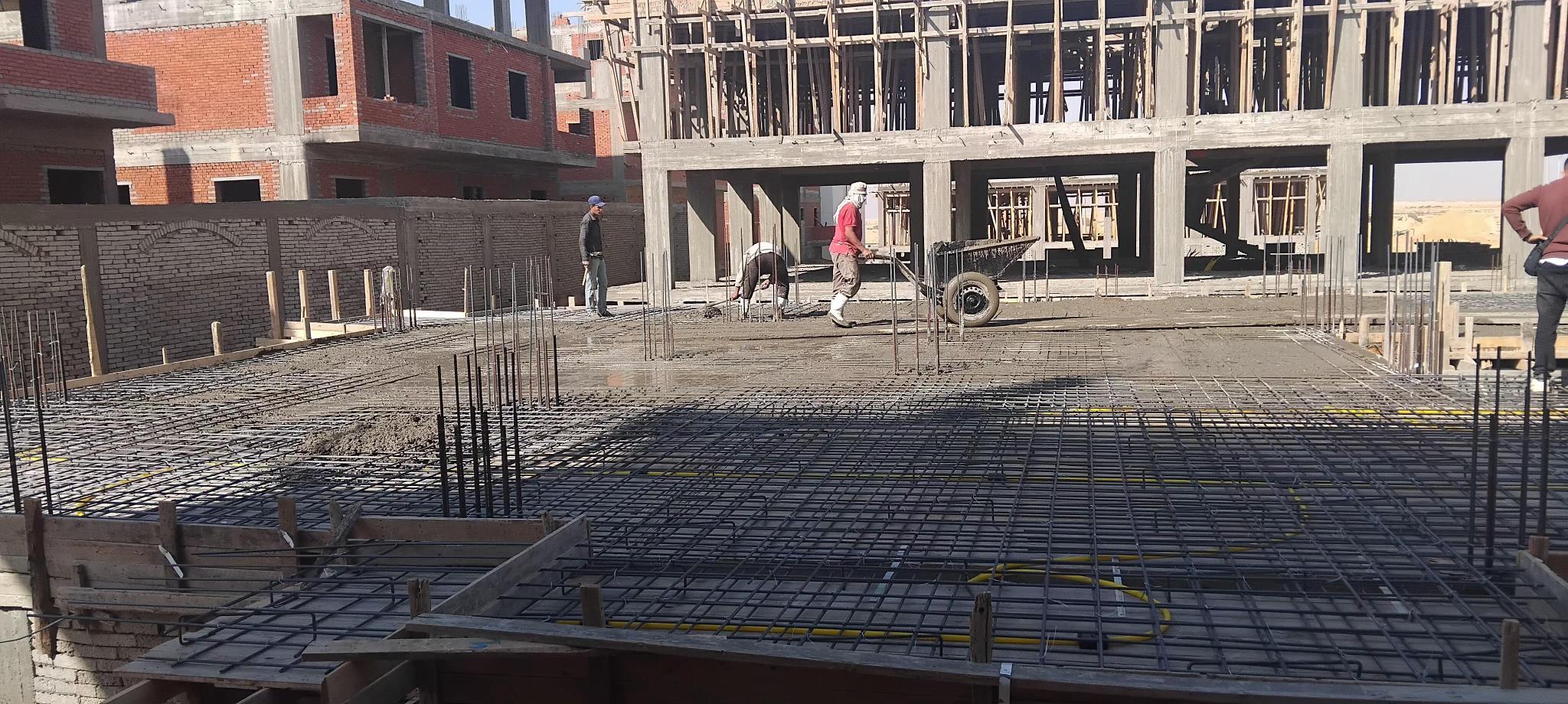

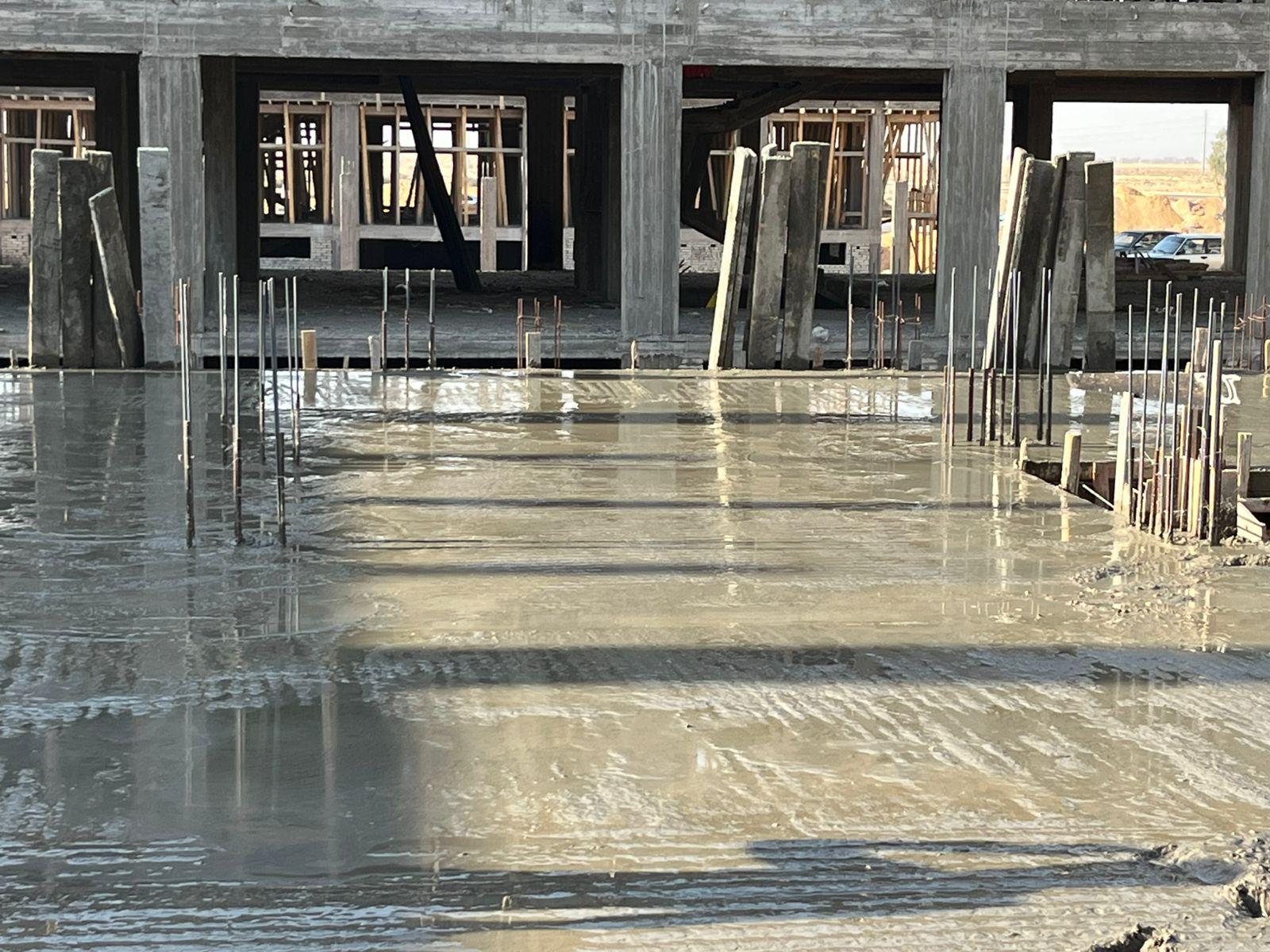

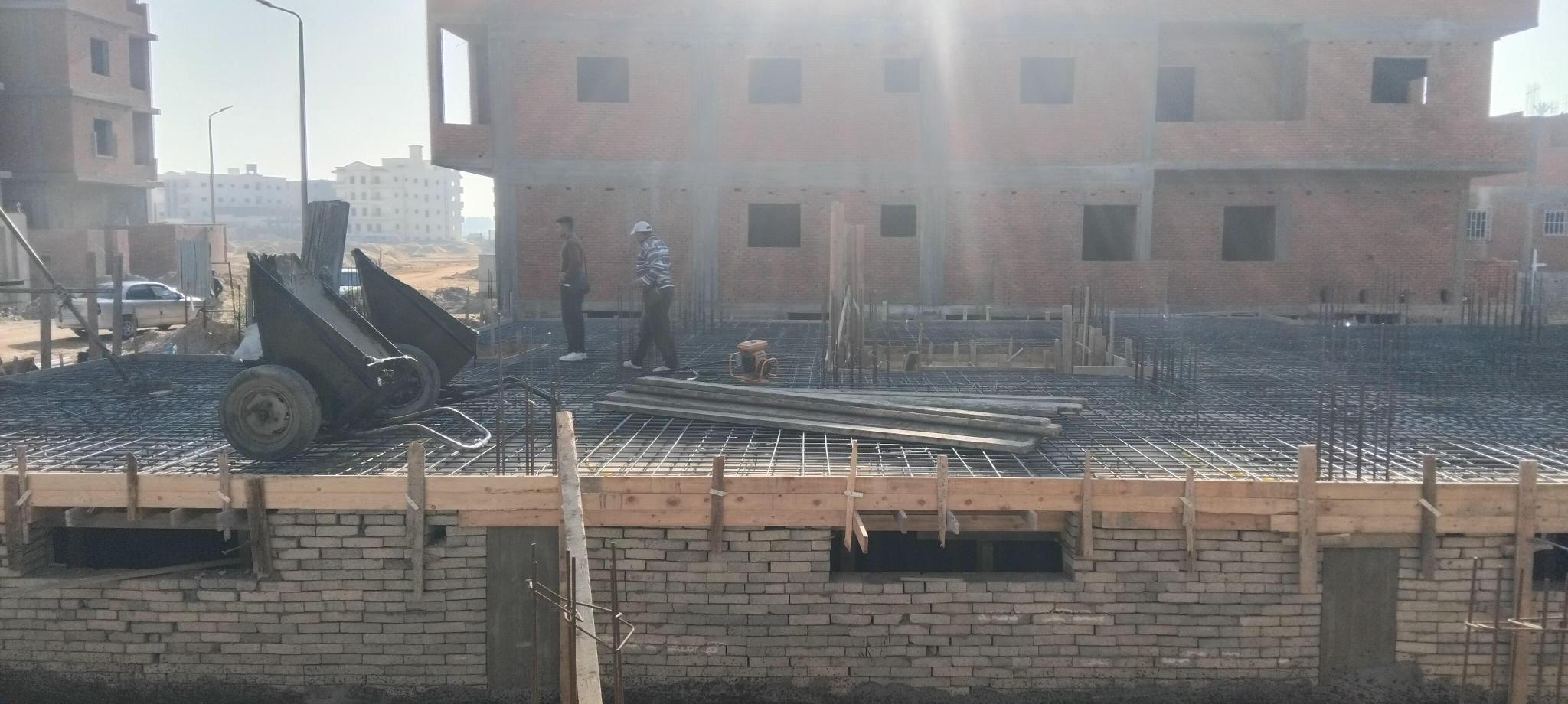

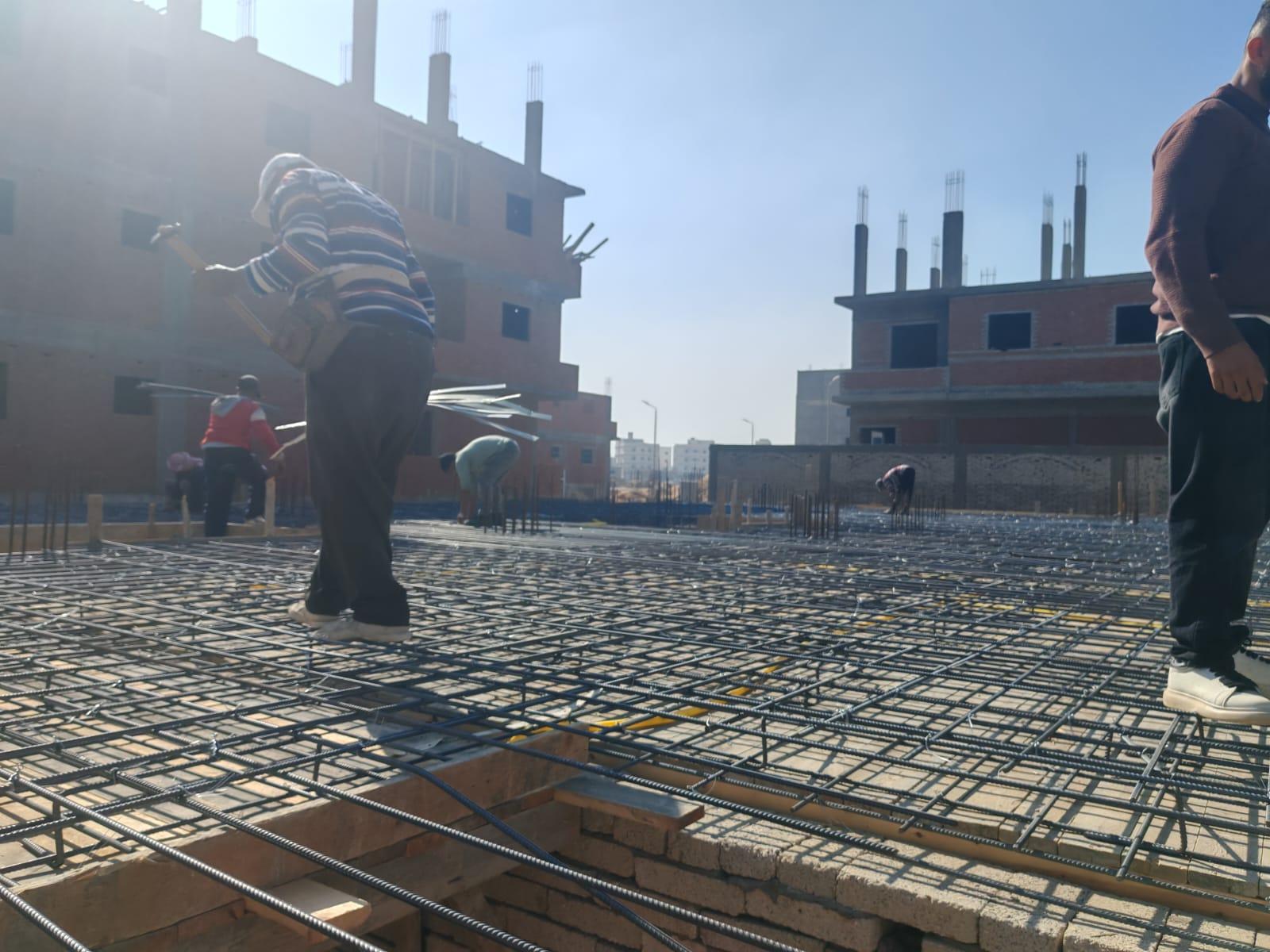

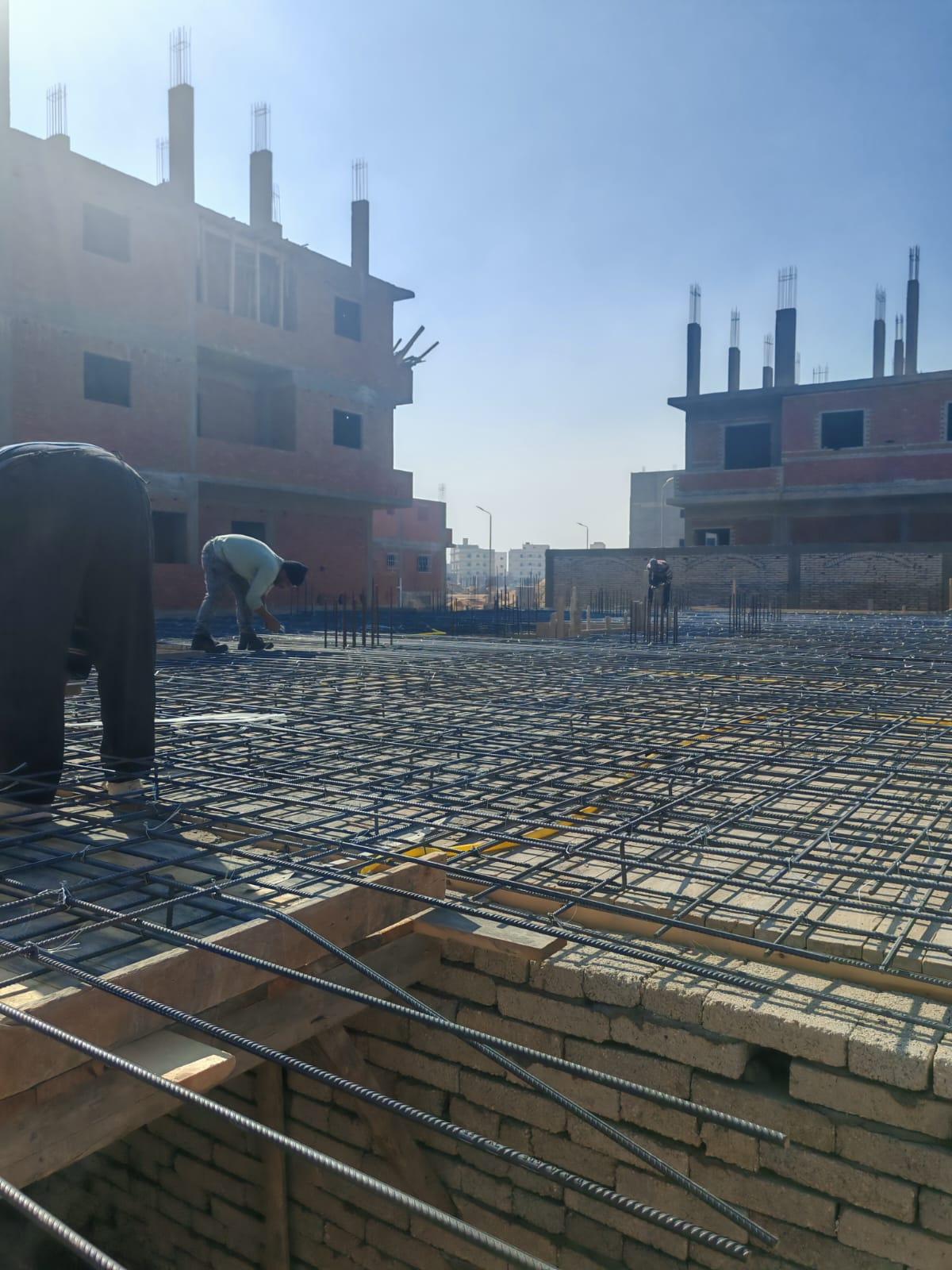

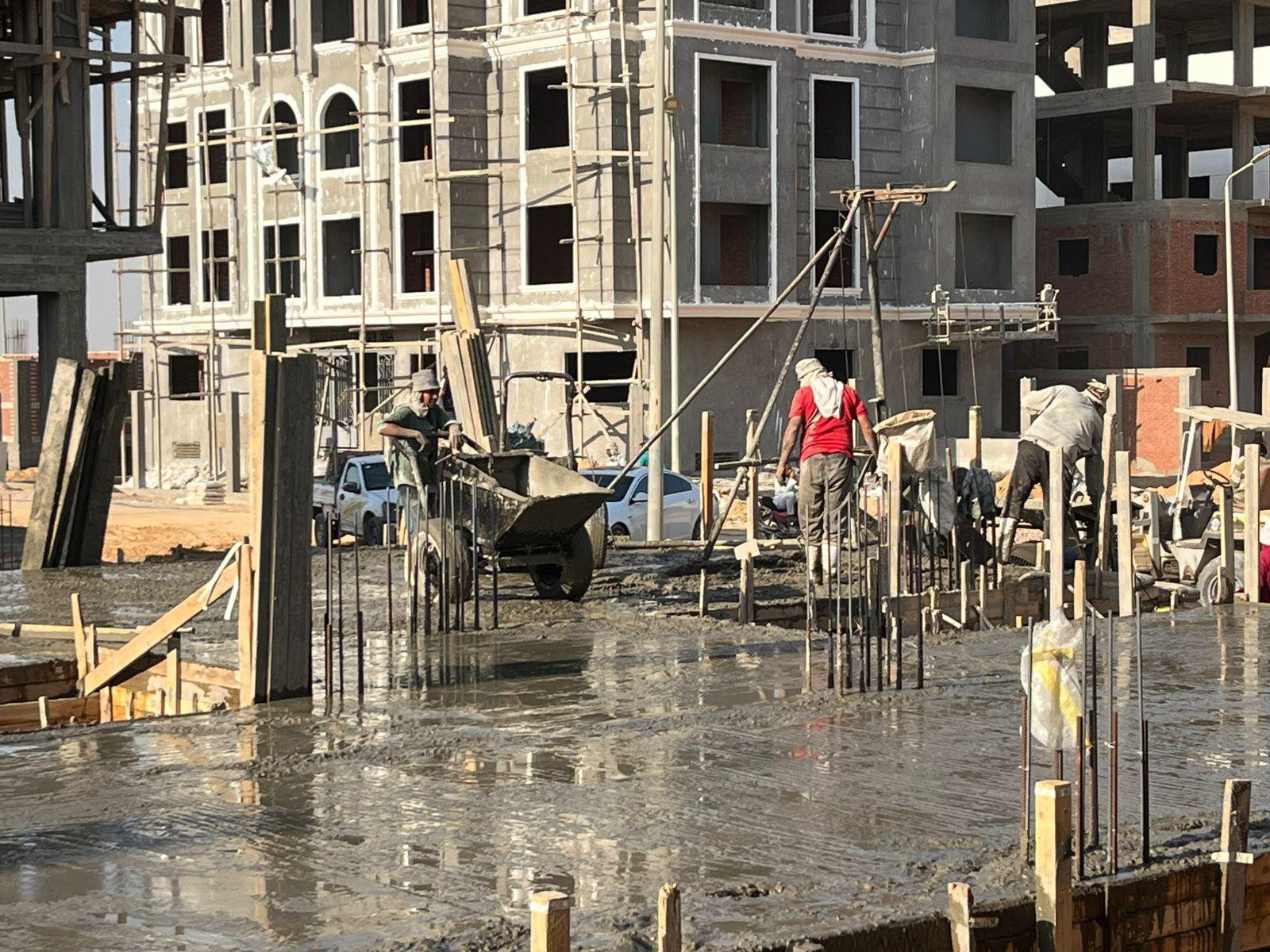

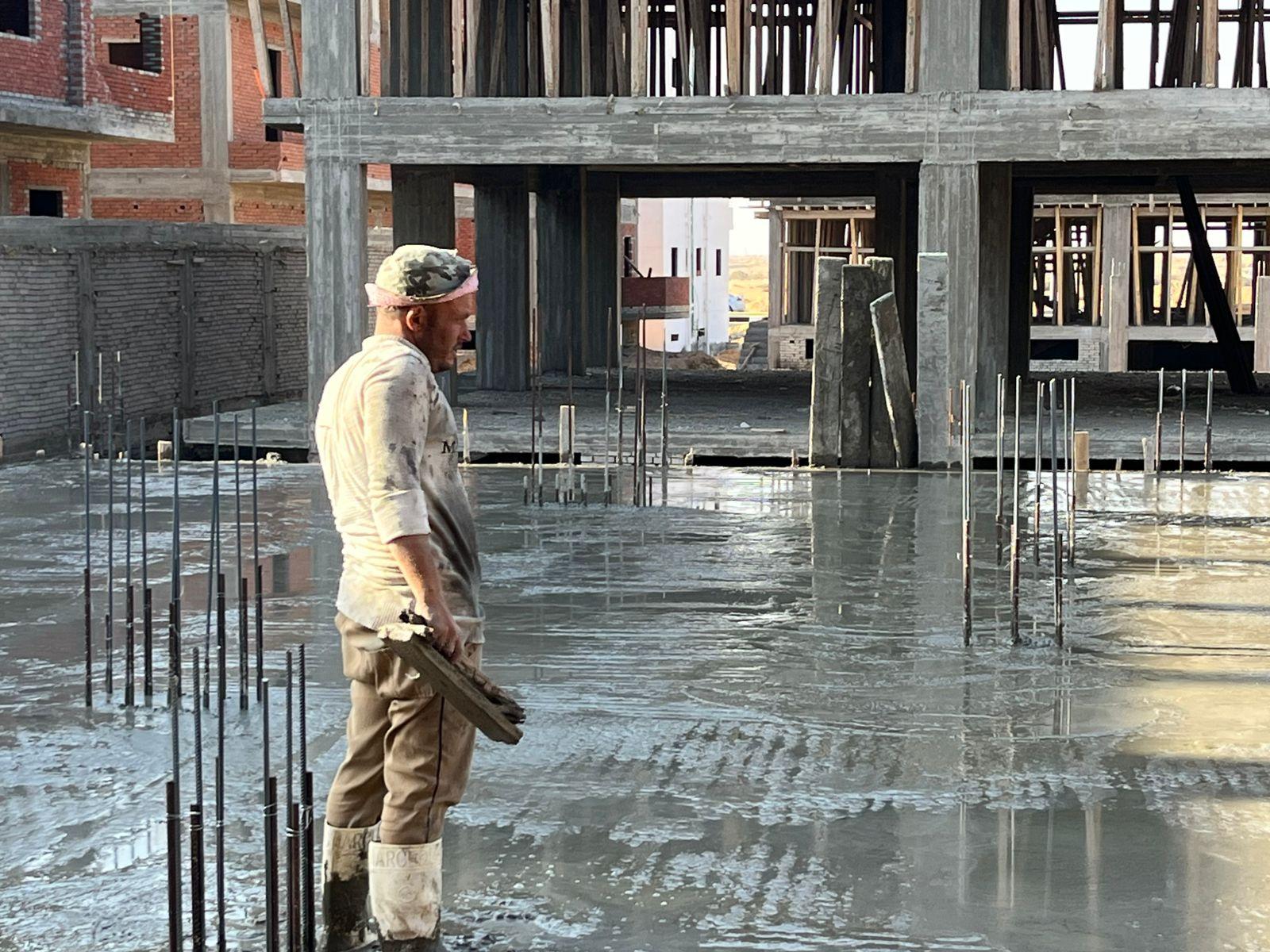

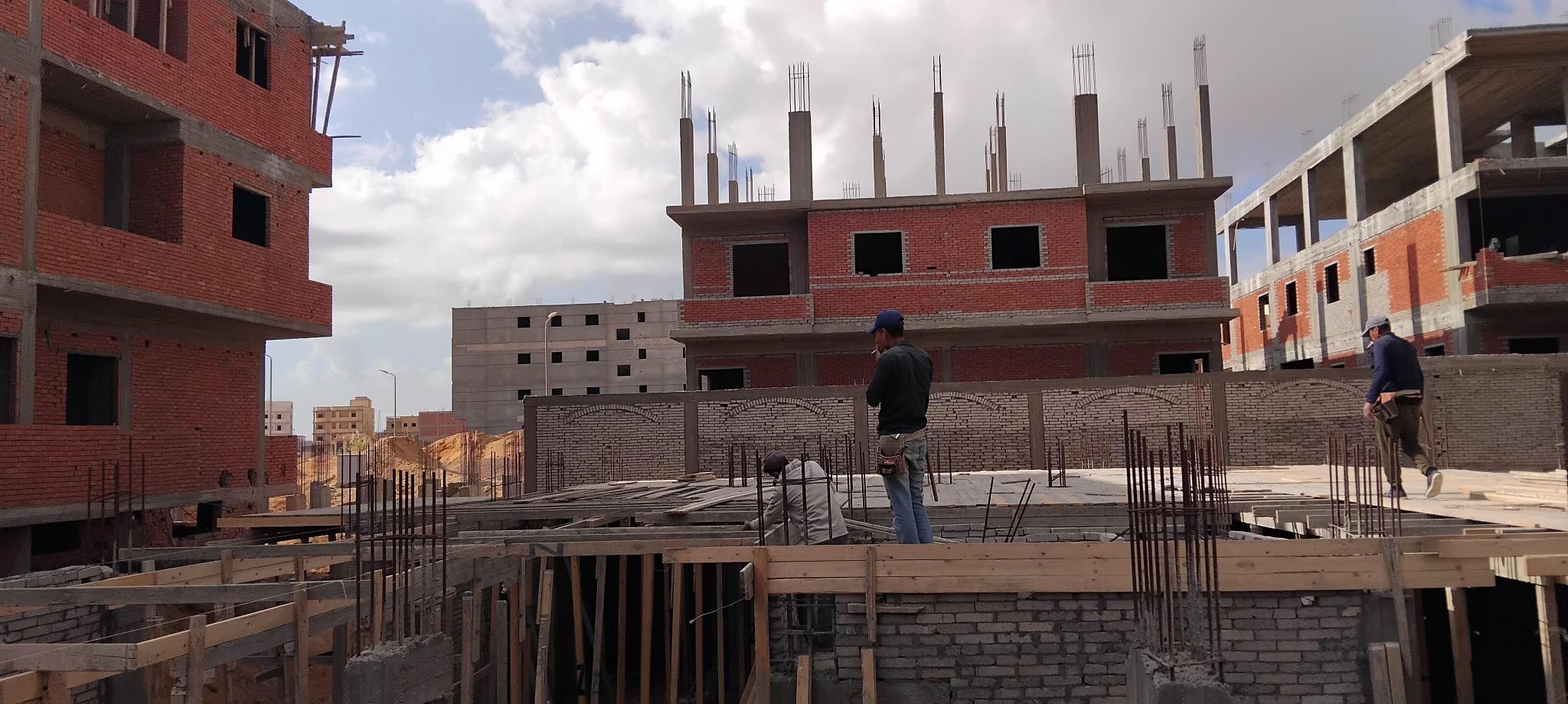

Basement slab

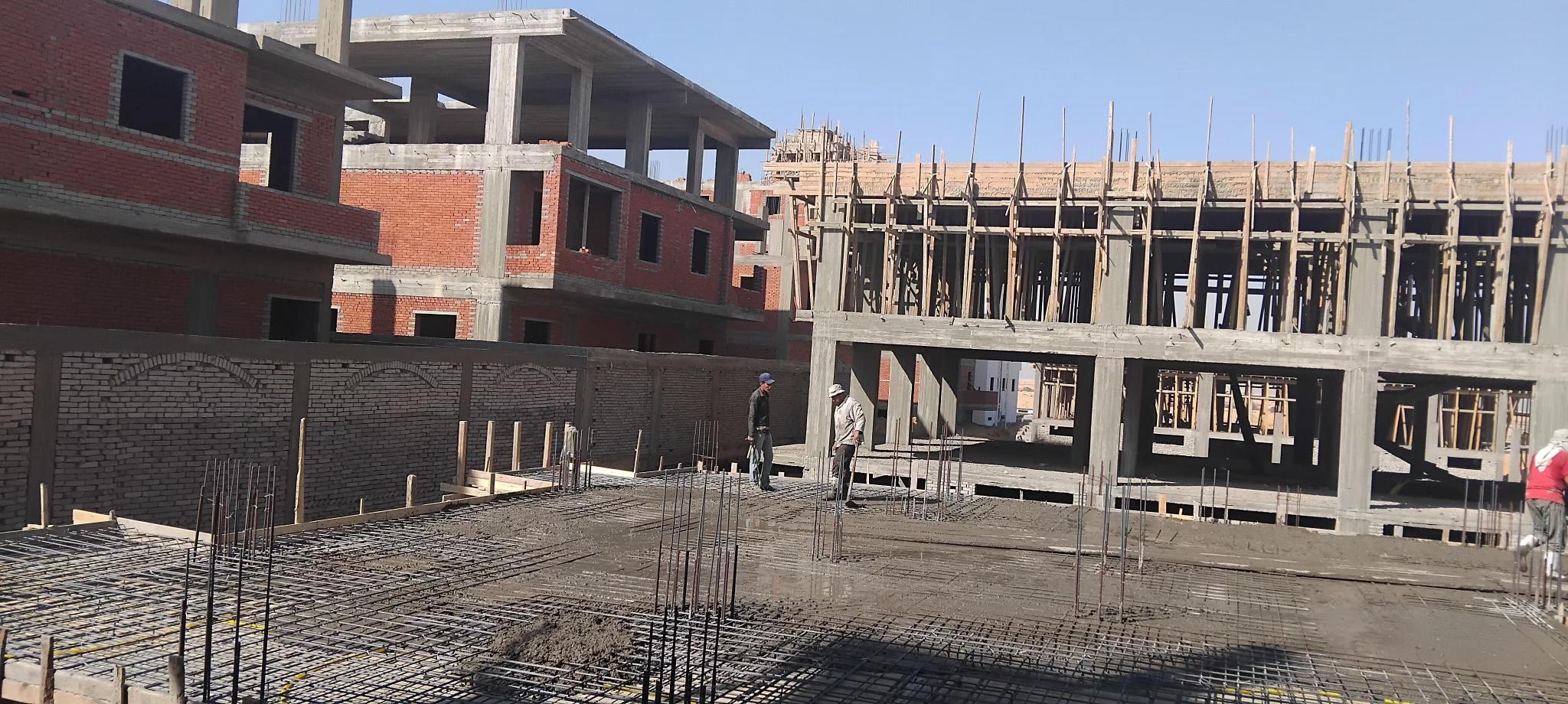

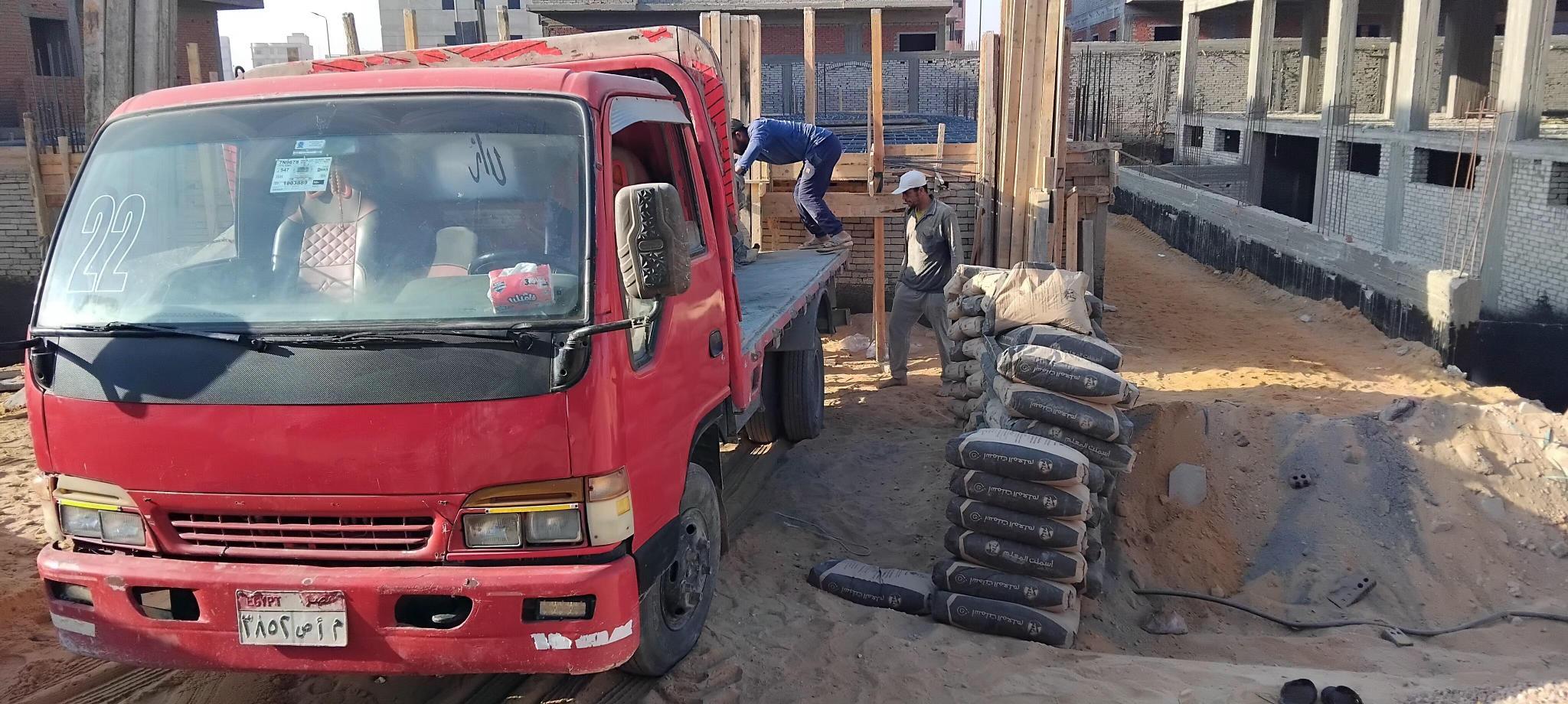

November 16, 2025

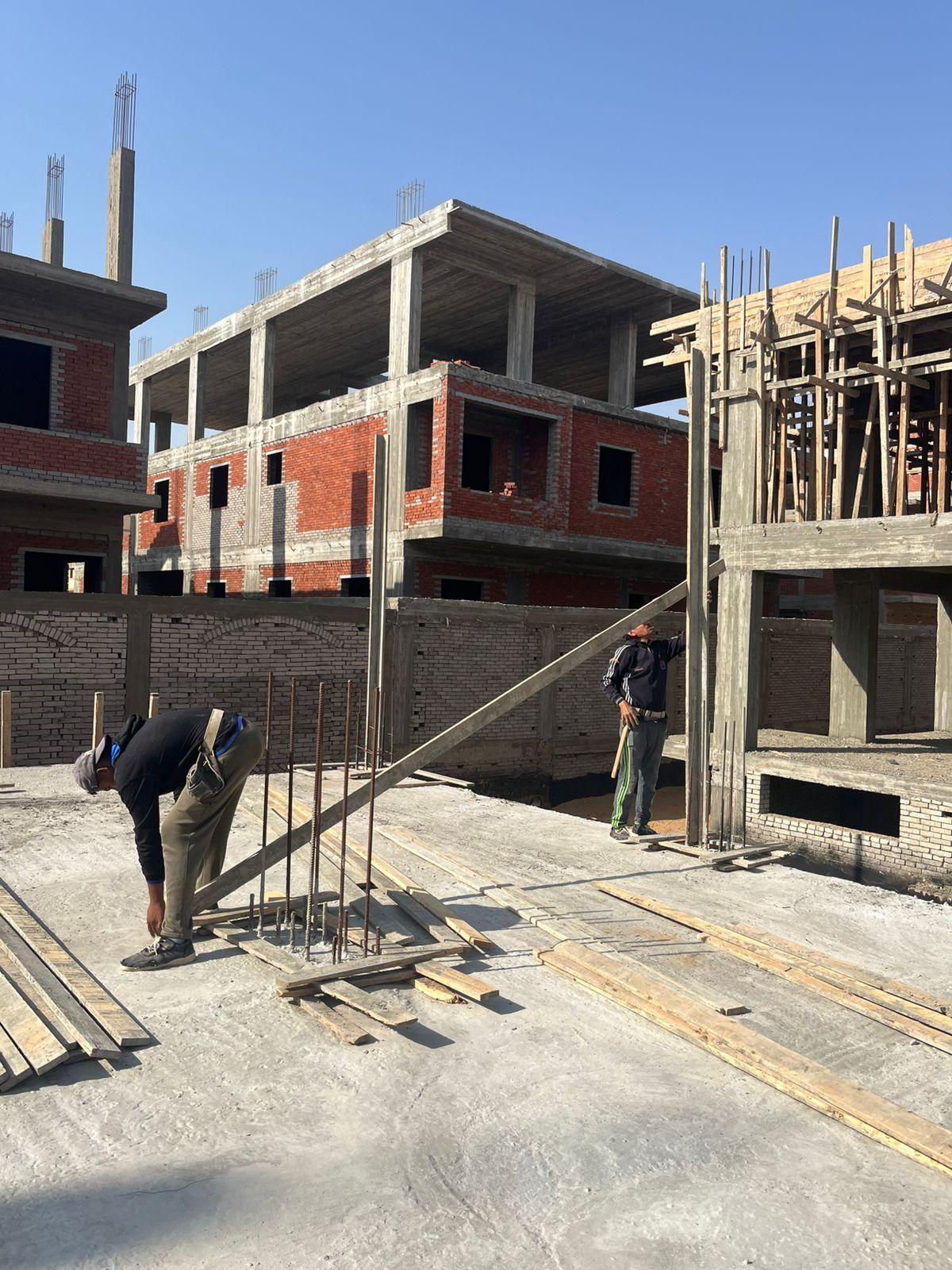

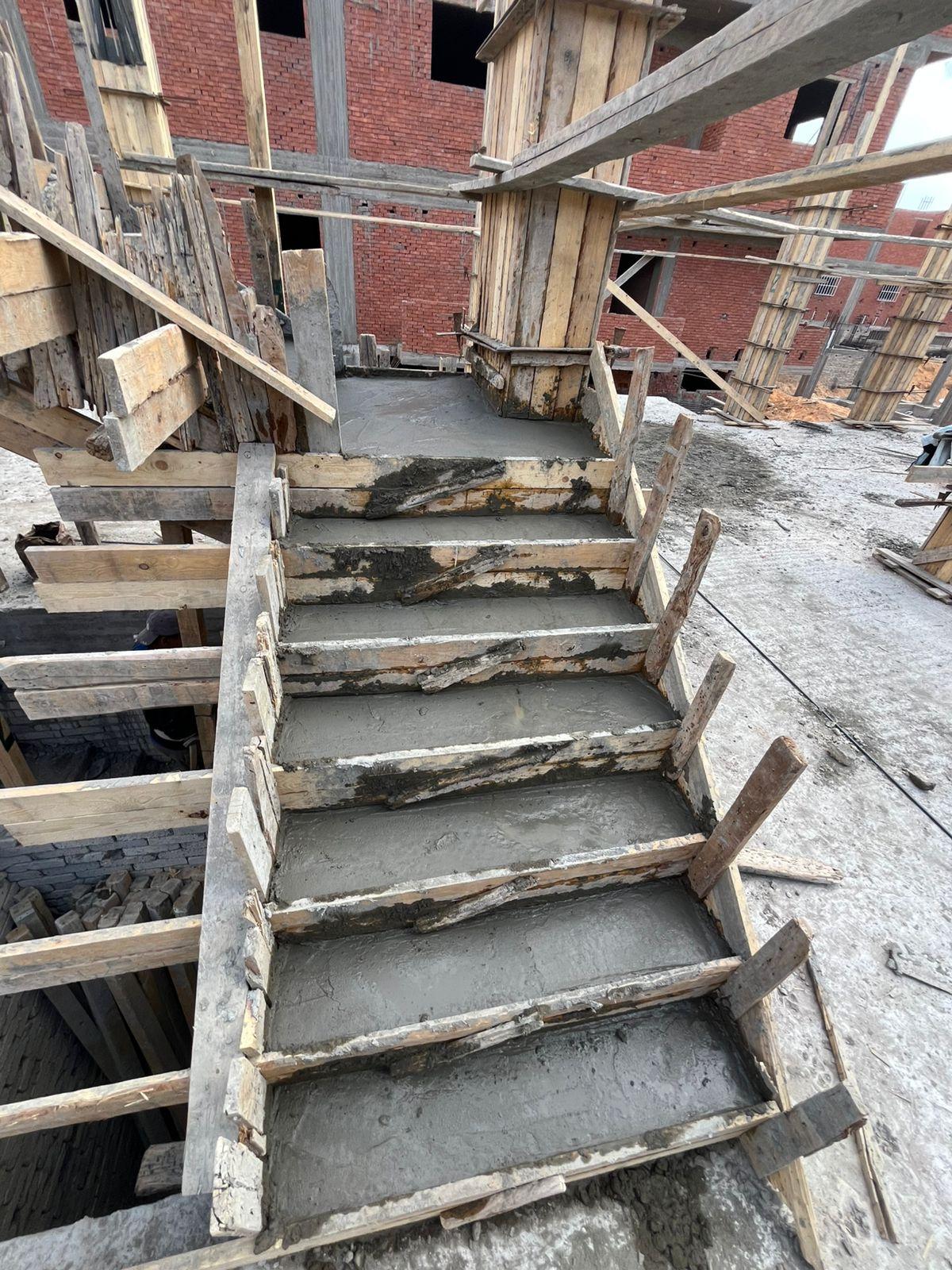

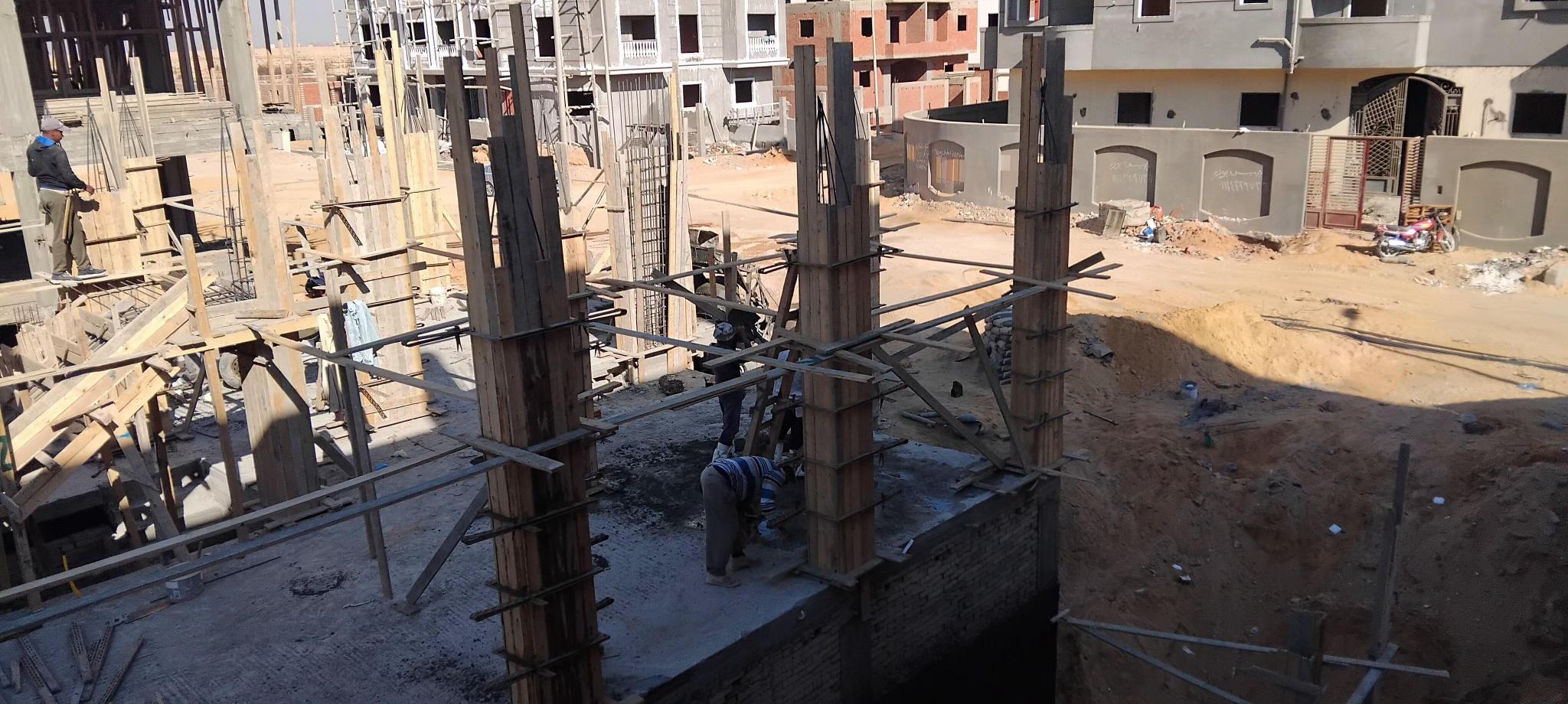

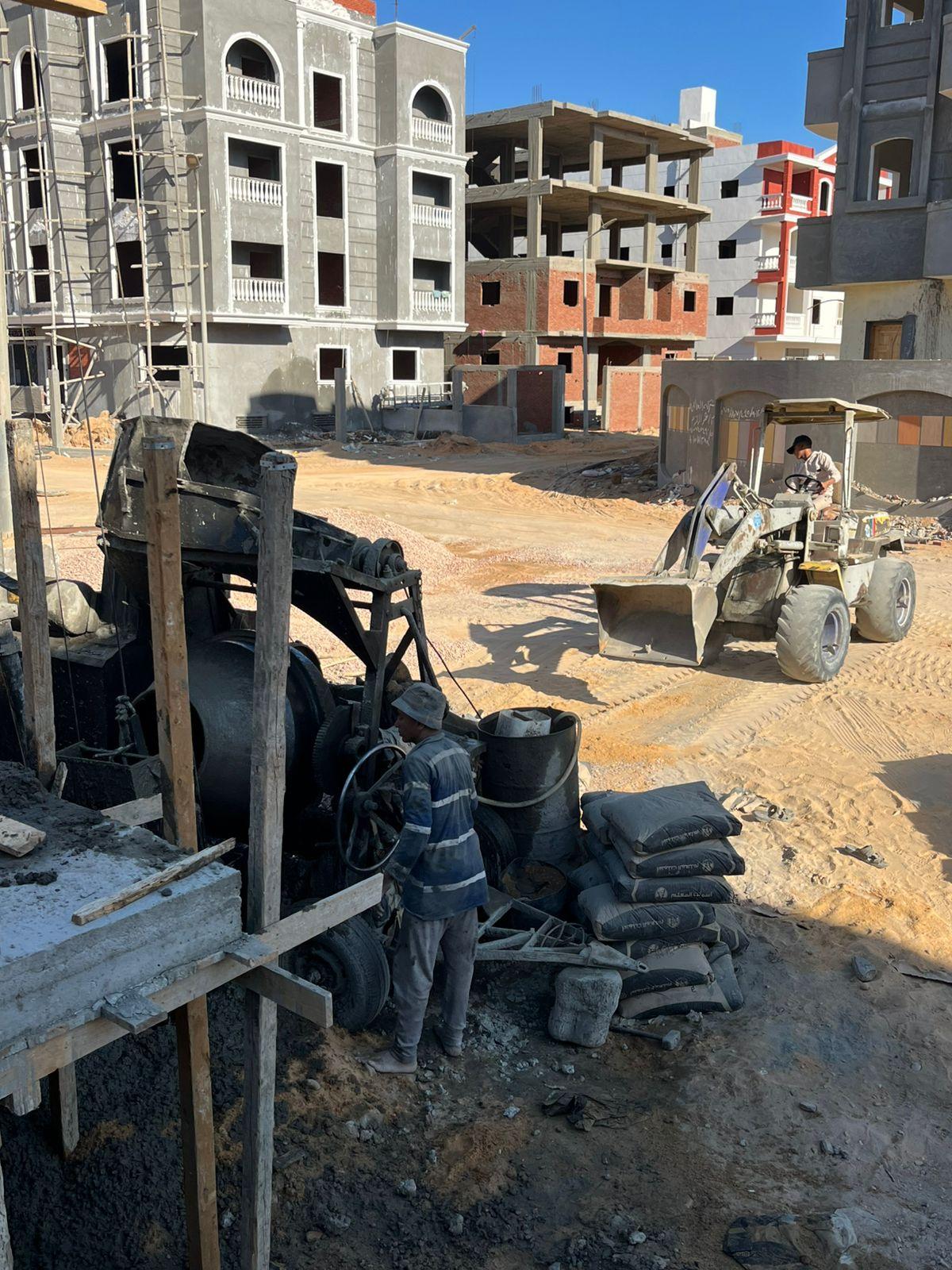

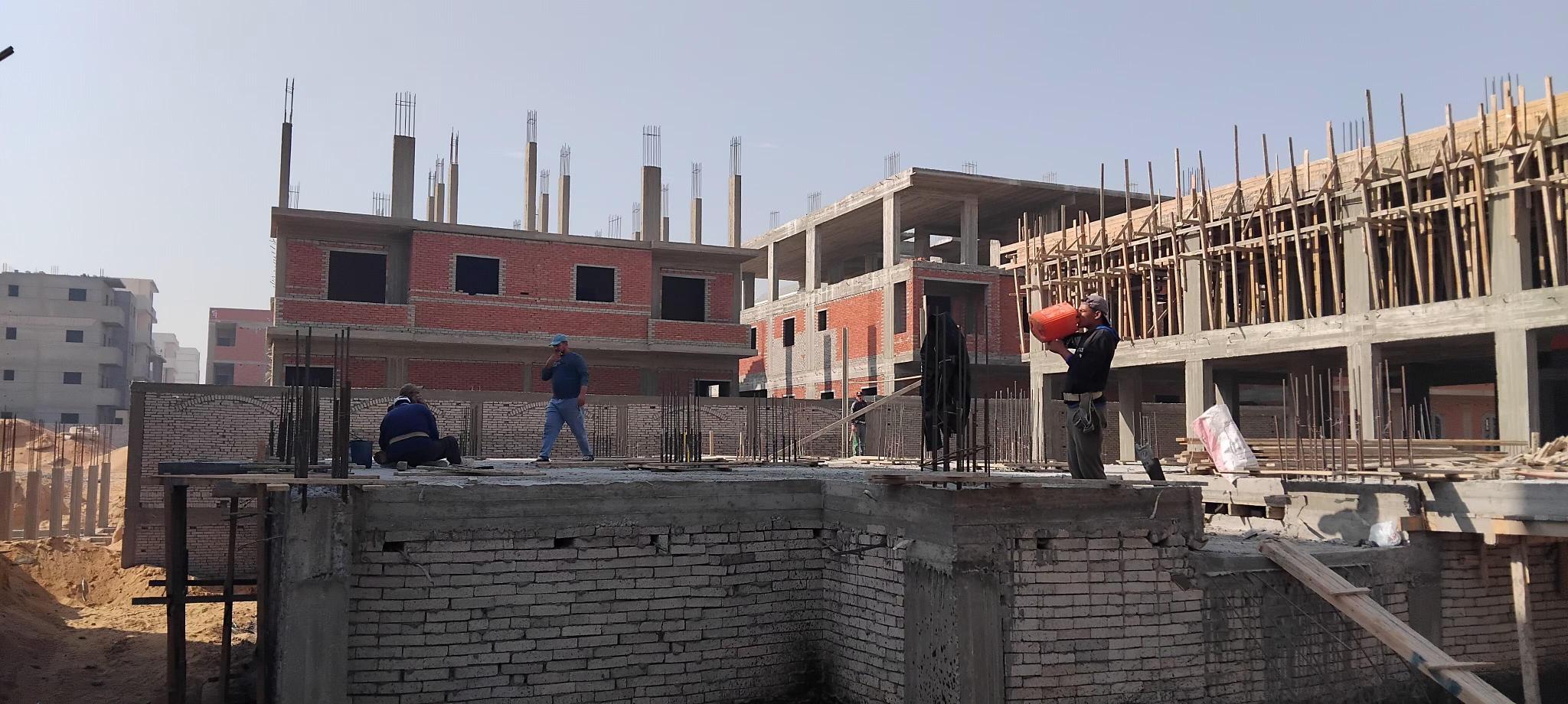

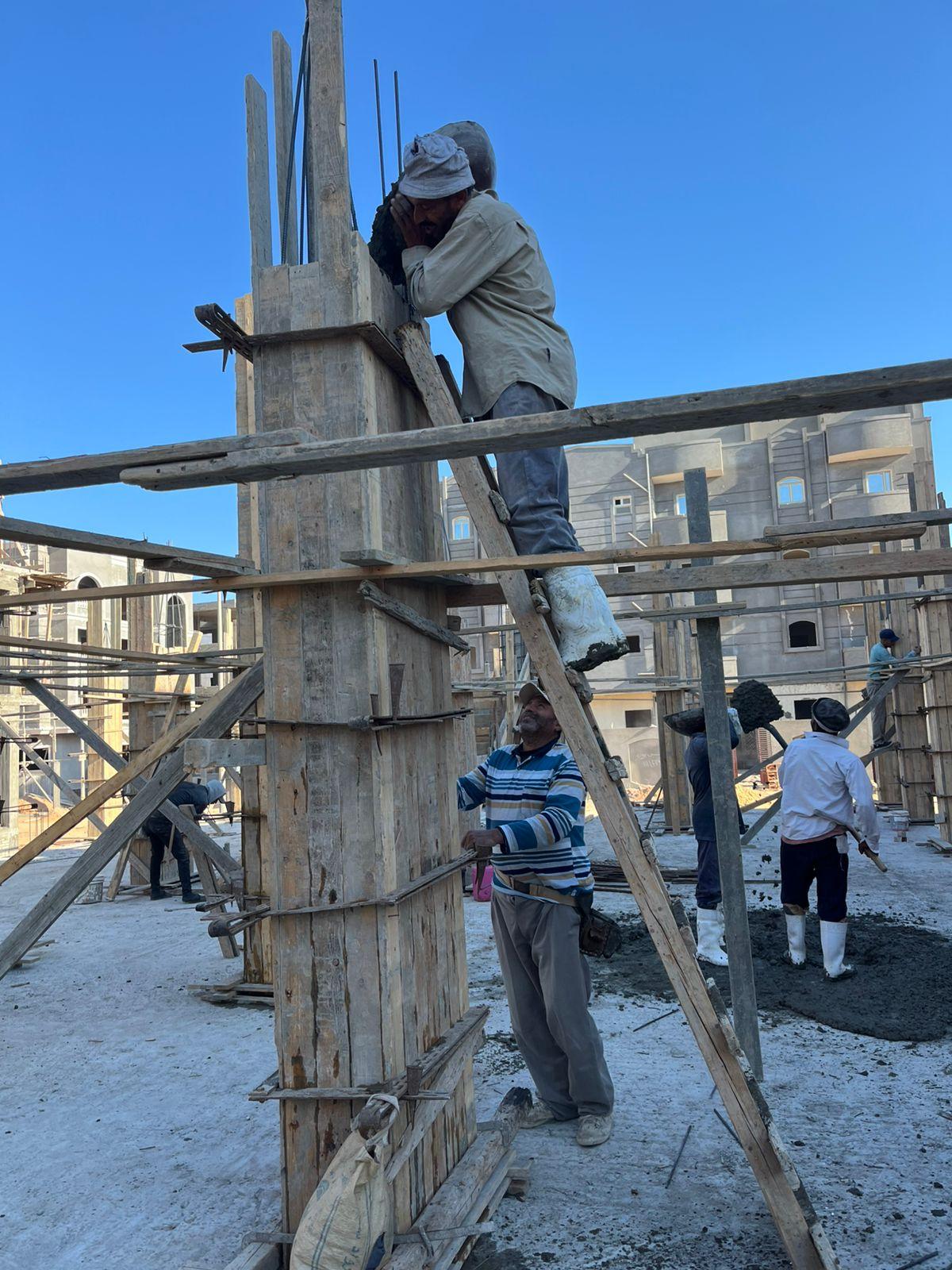

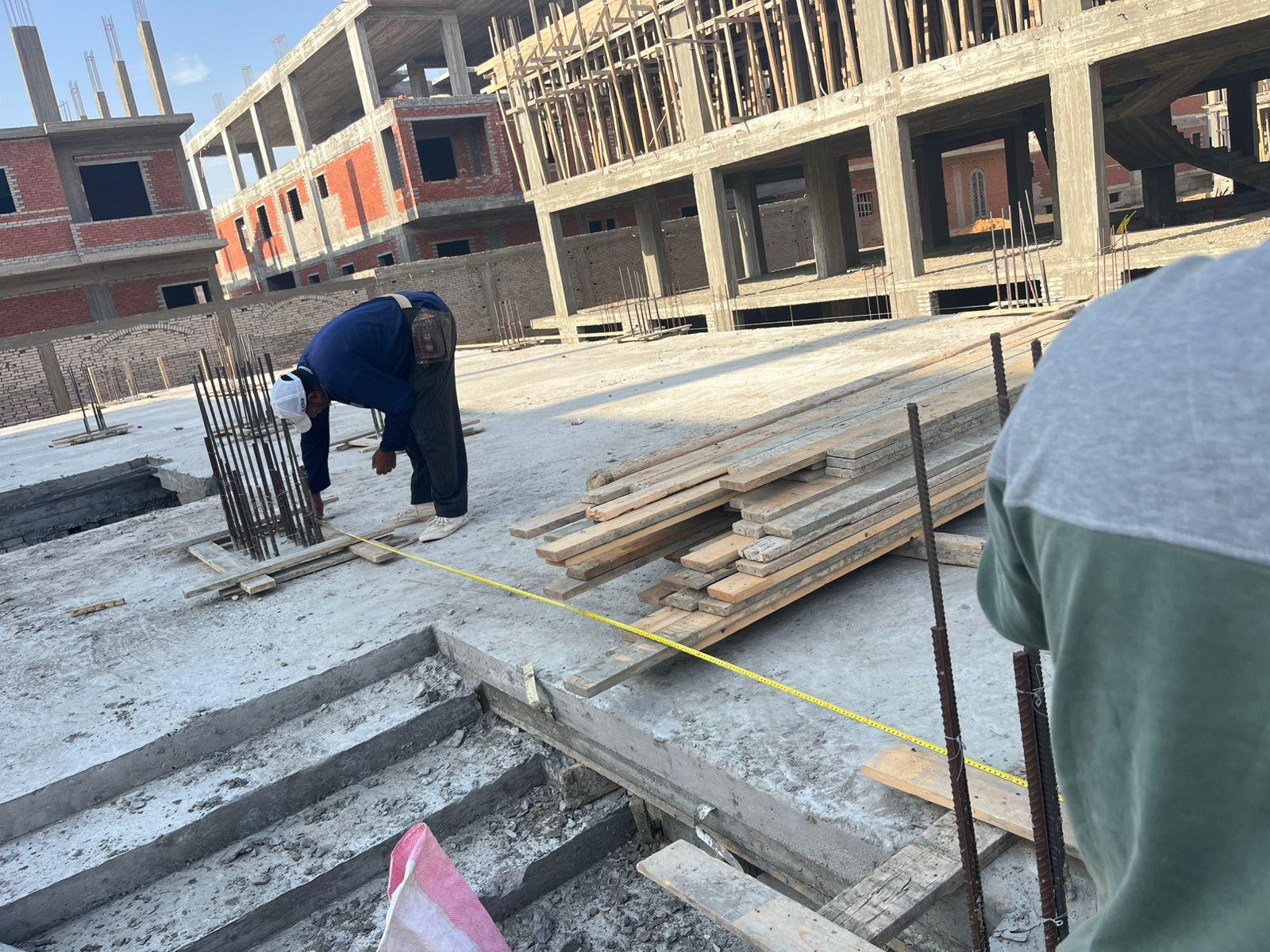

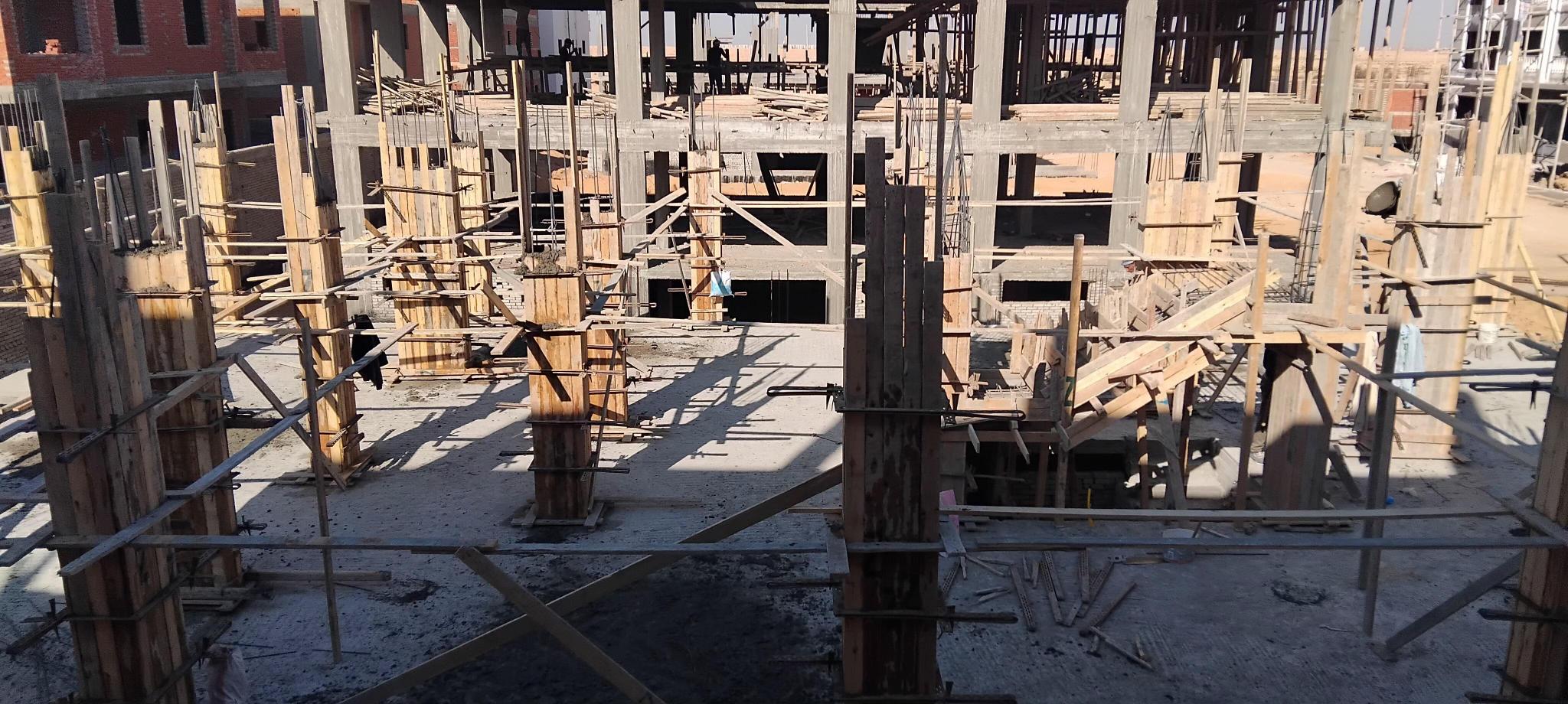

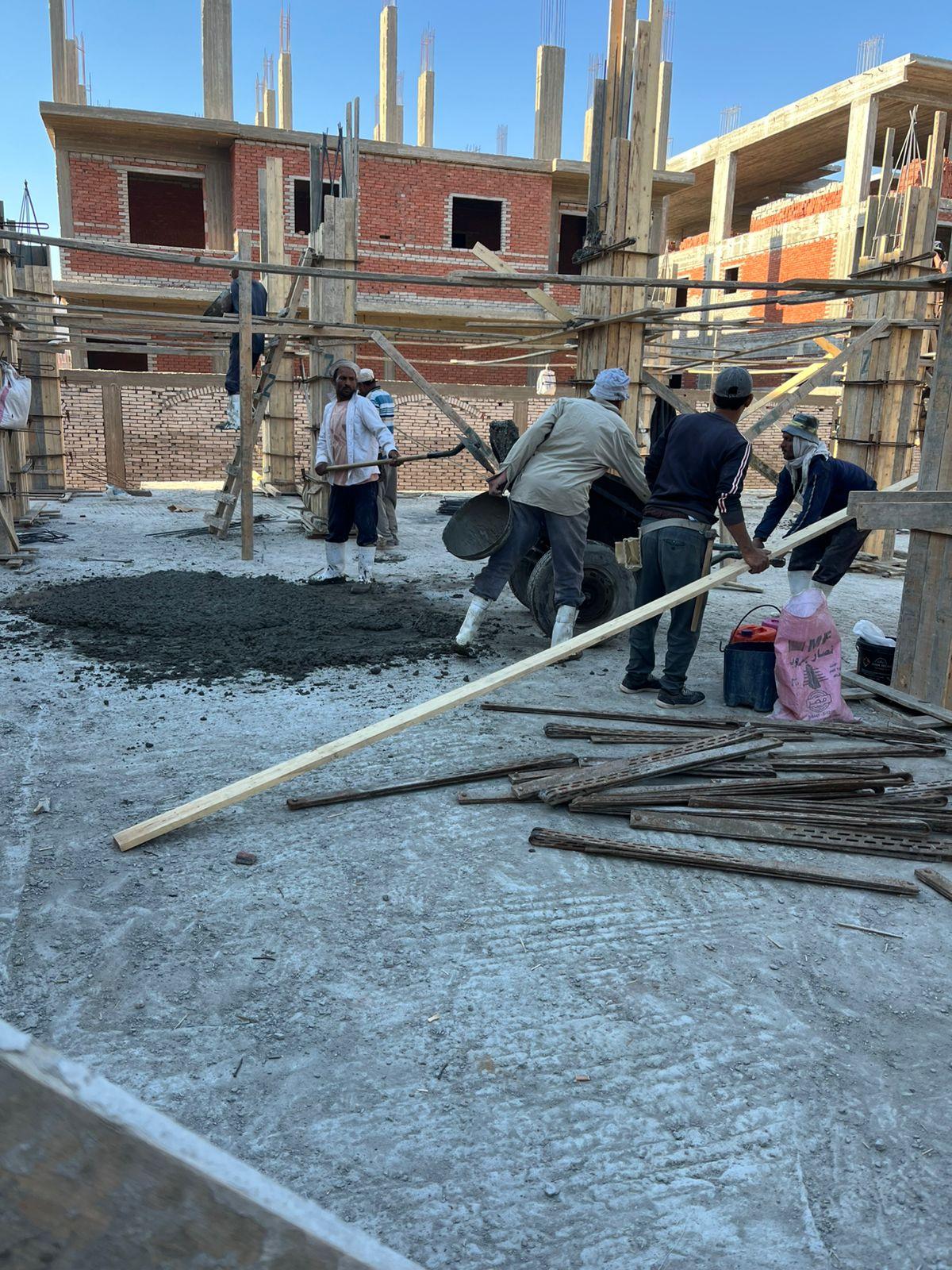

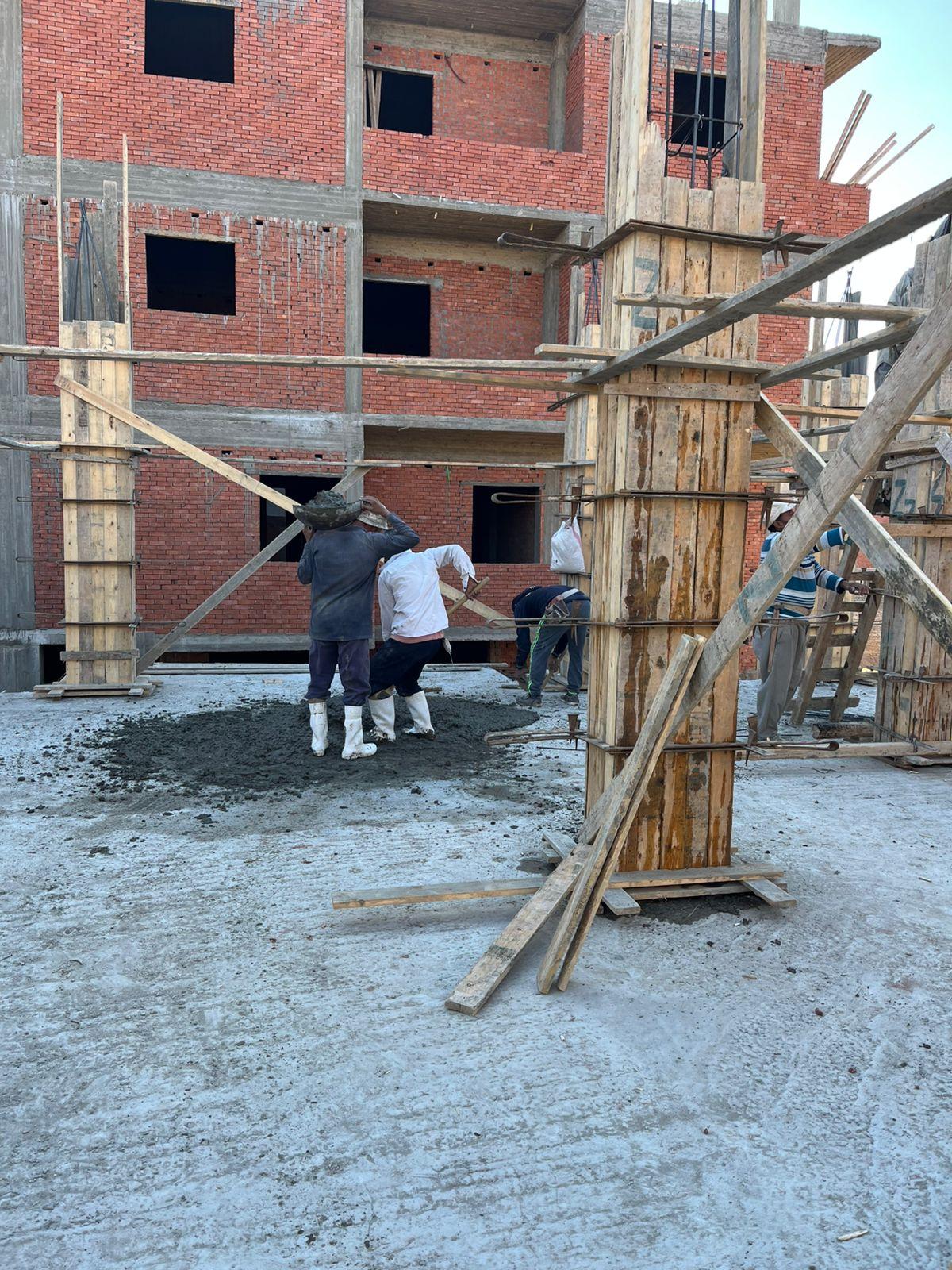

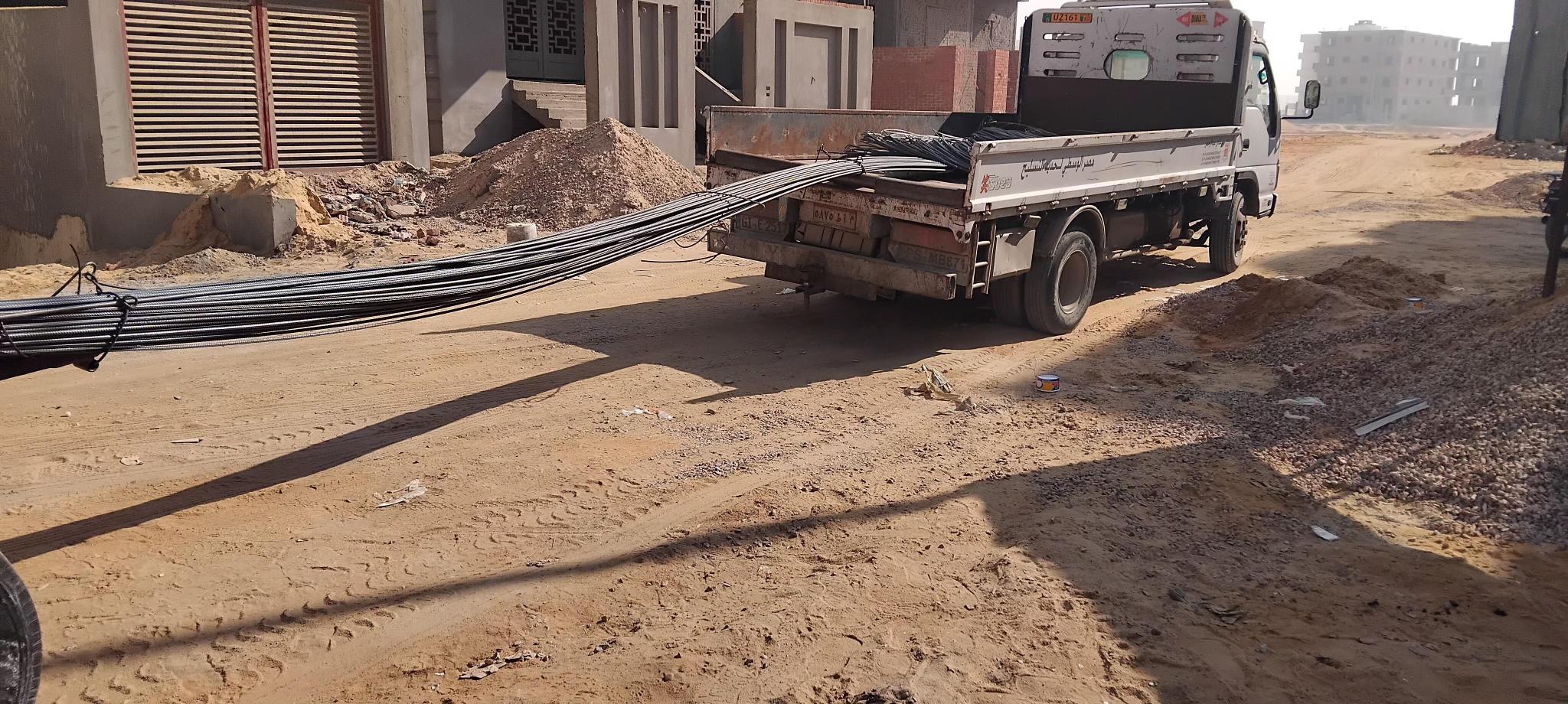

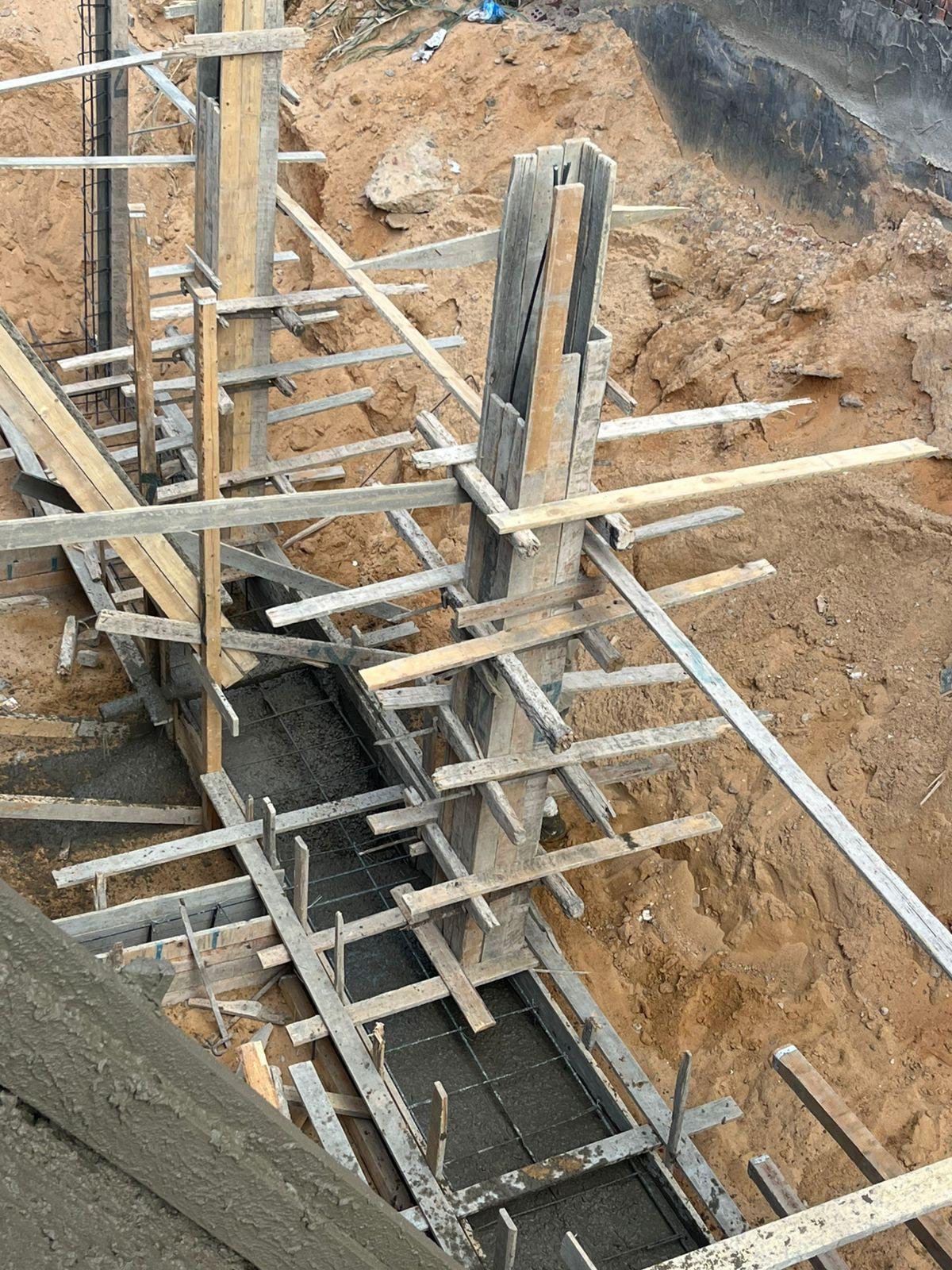

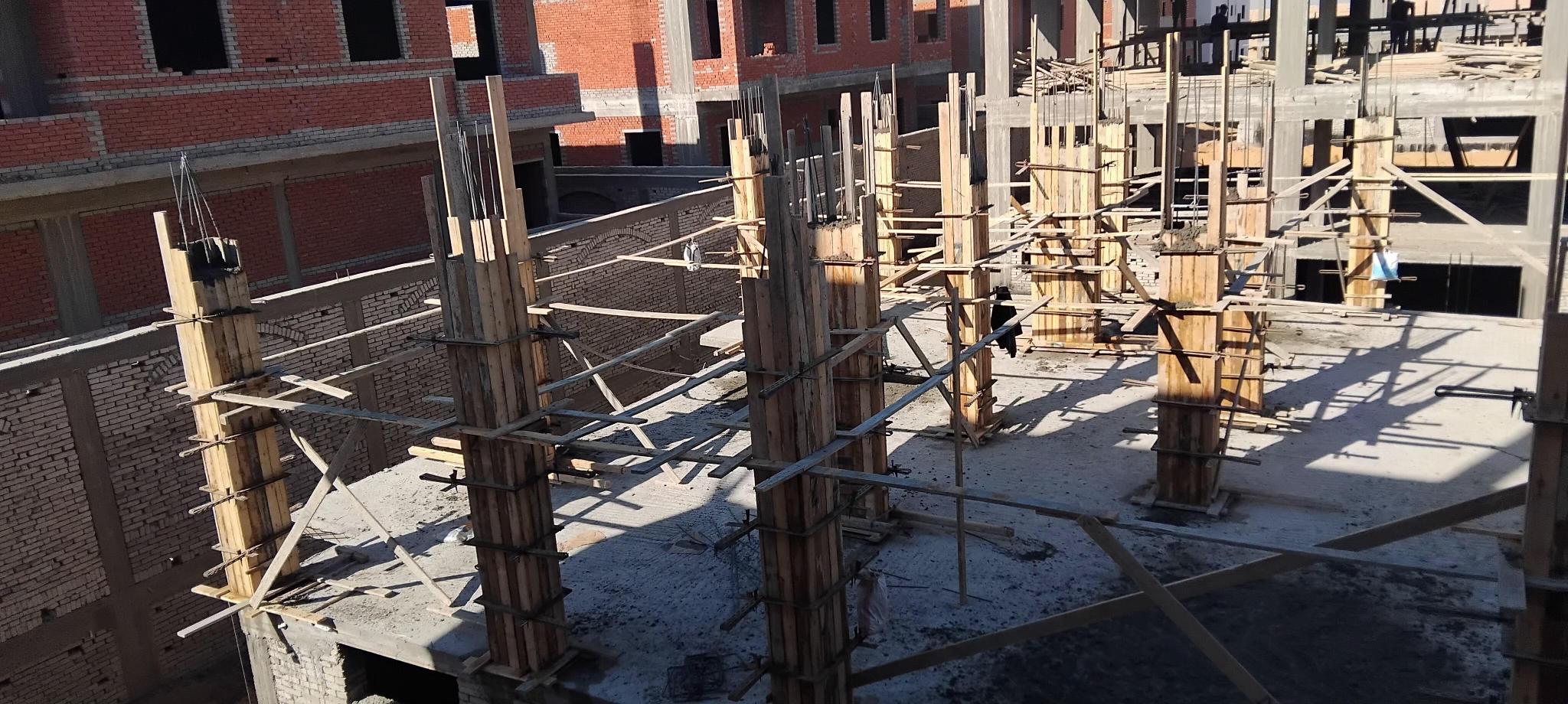

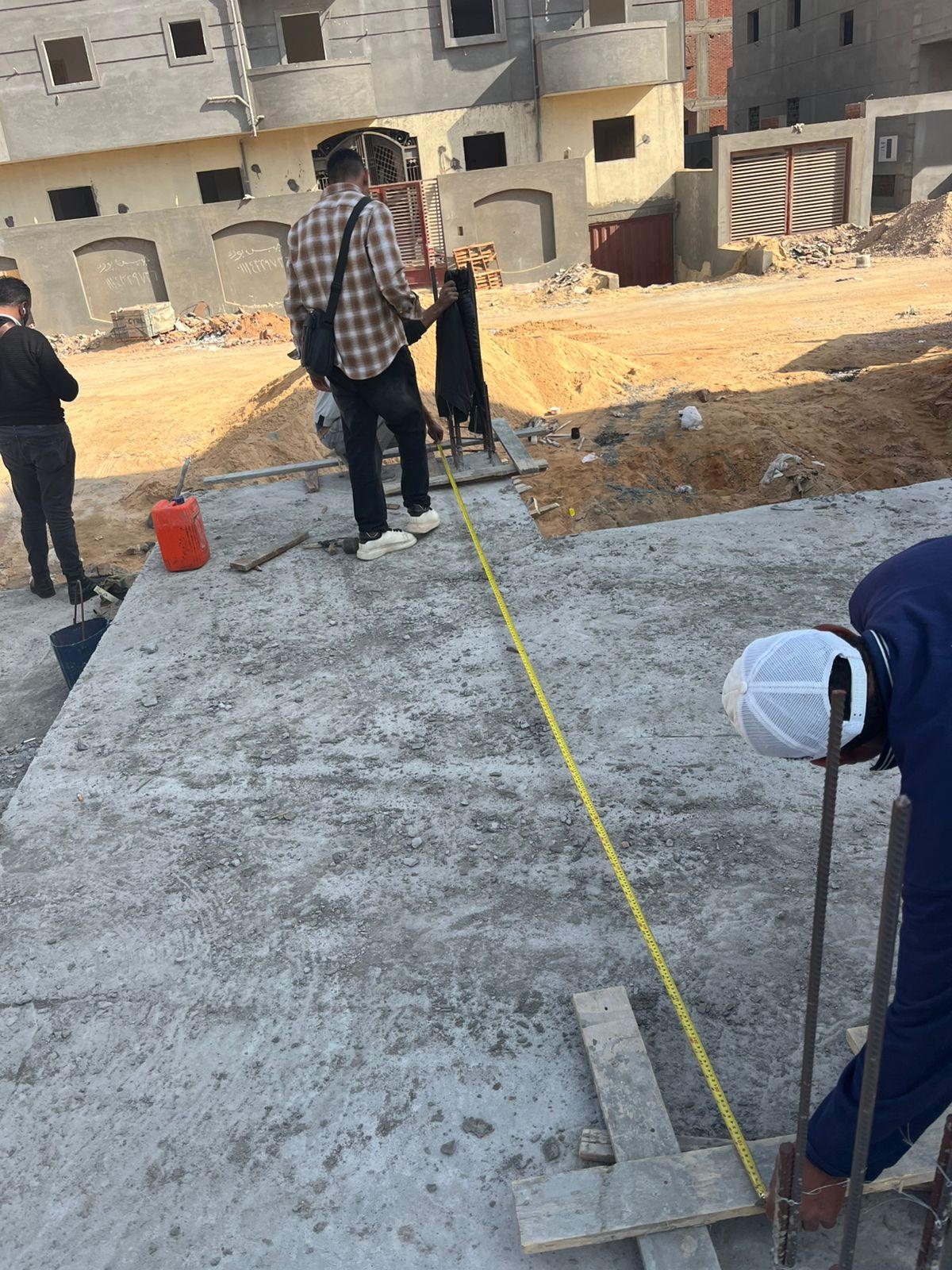

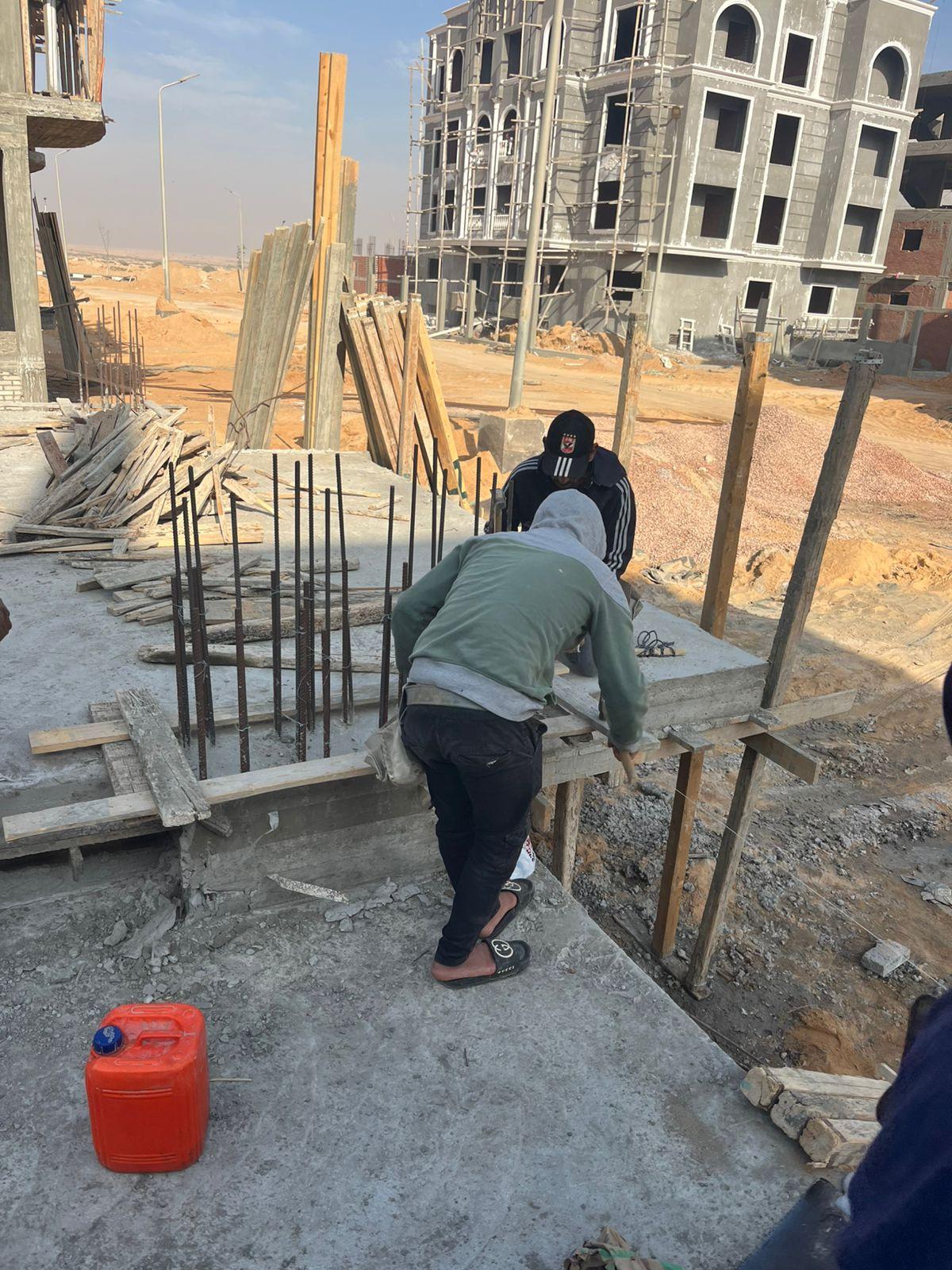

Ground floor columns
November 23, 2025

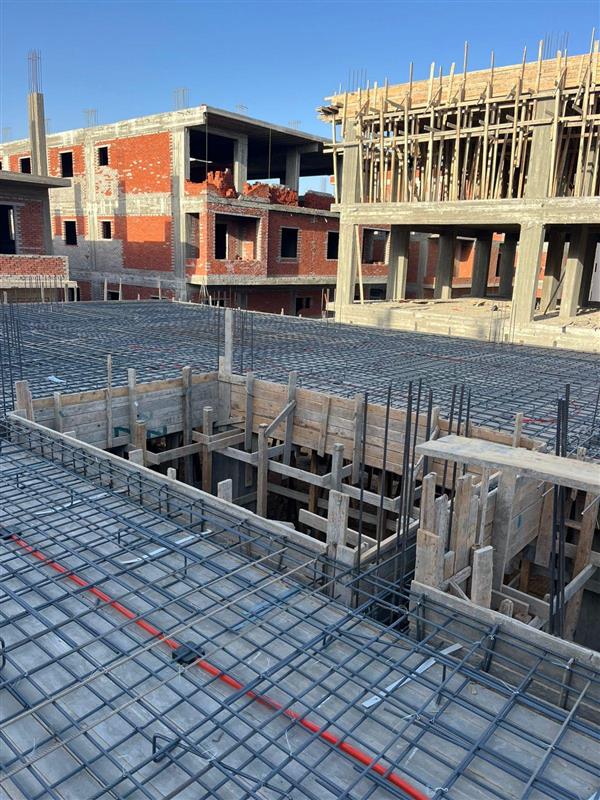

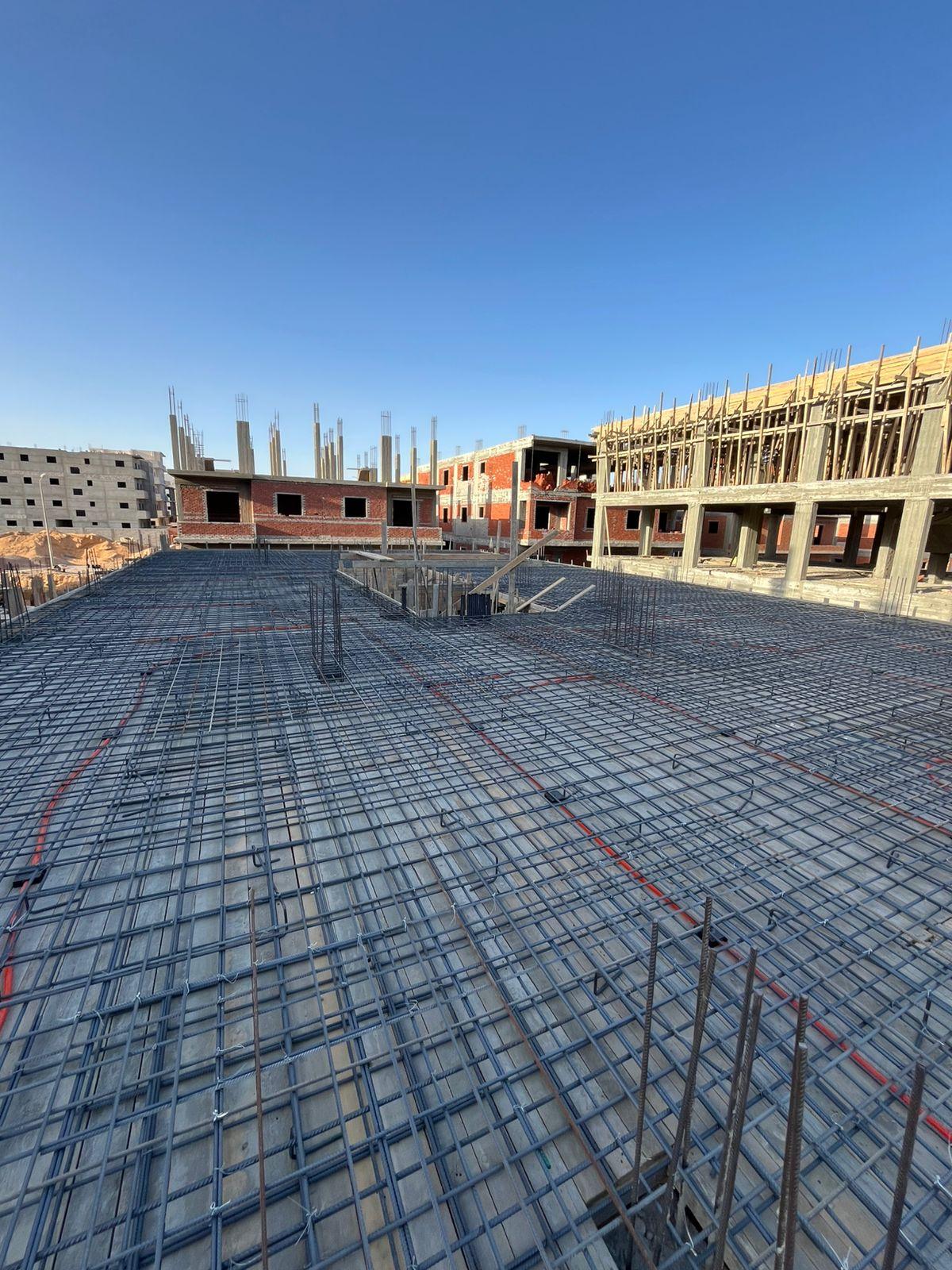

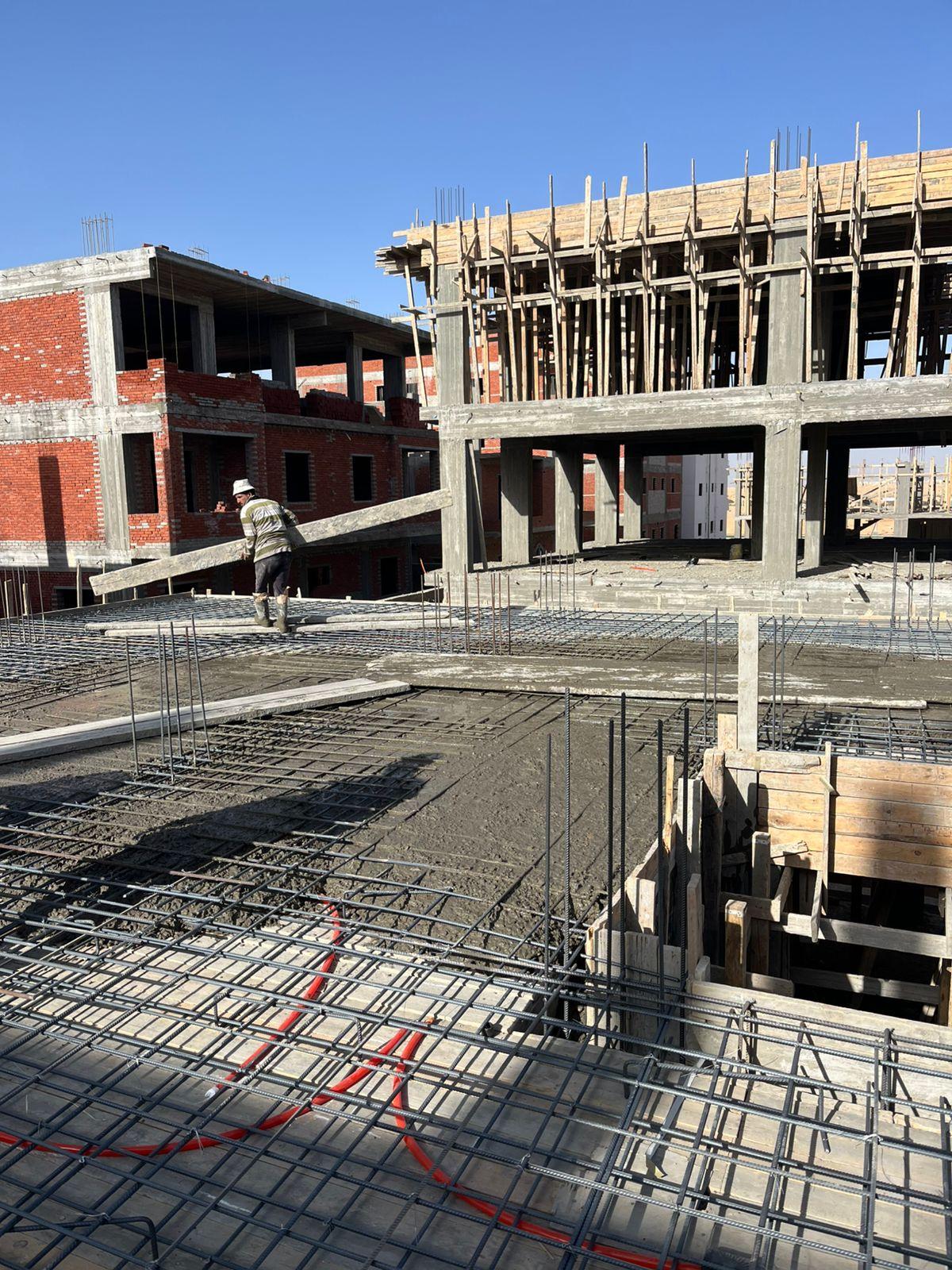

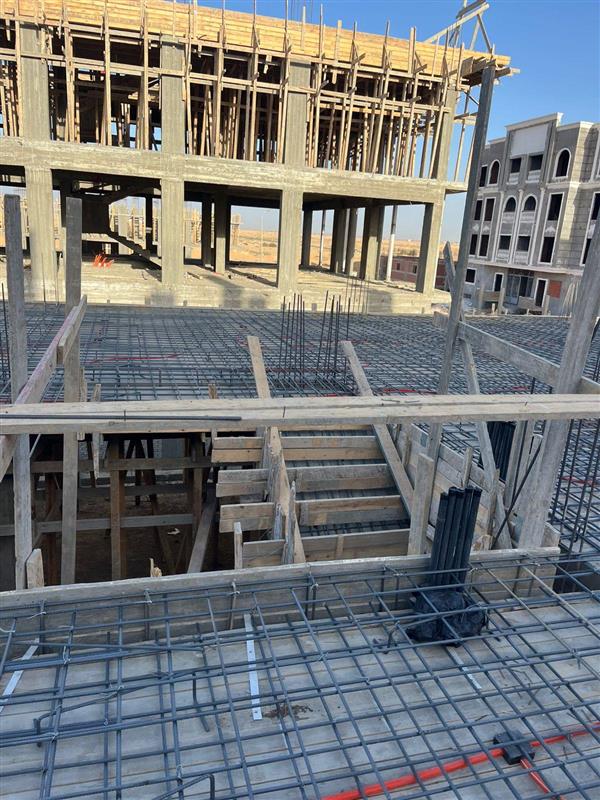

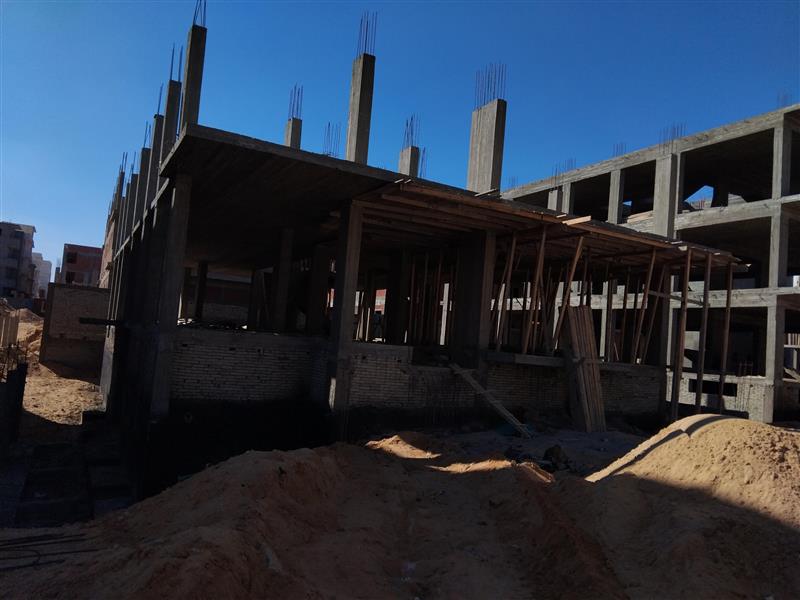

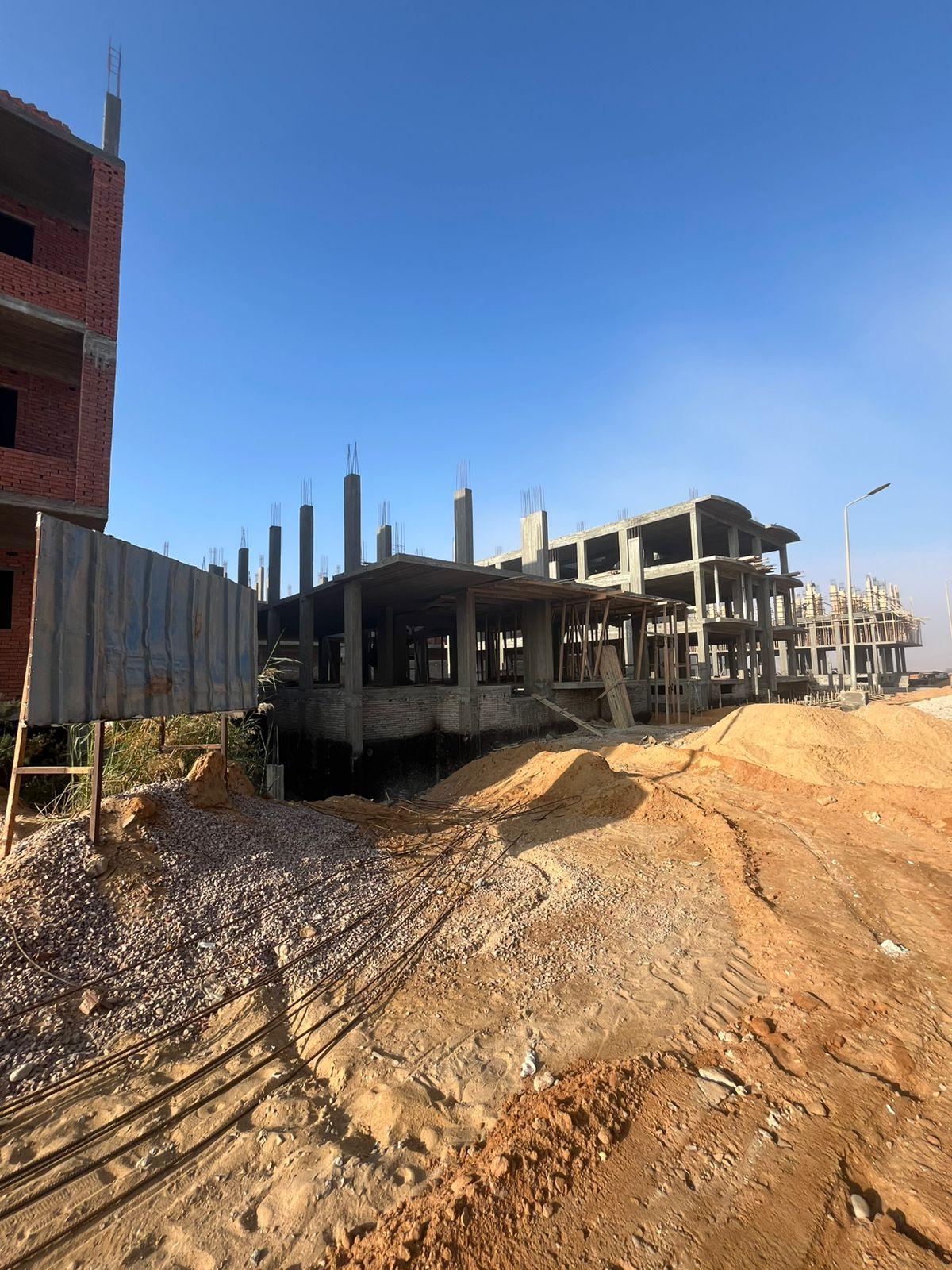

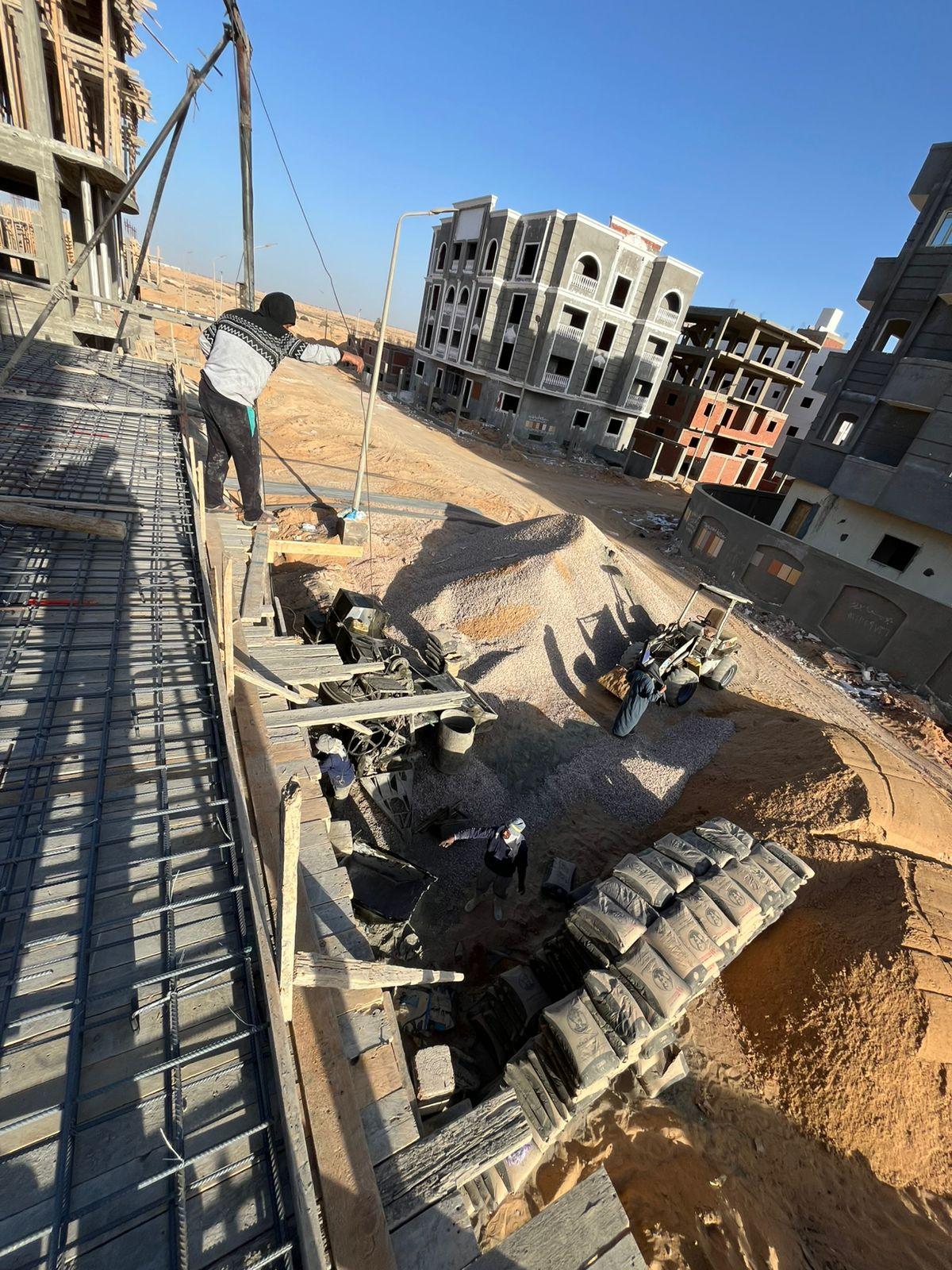

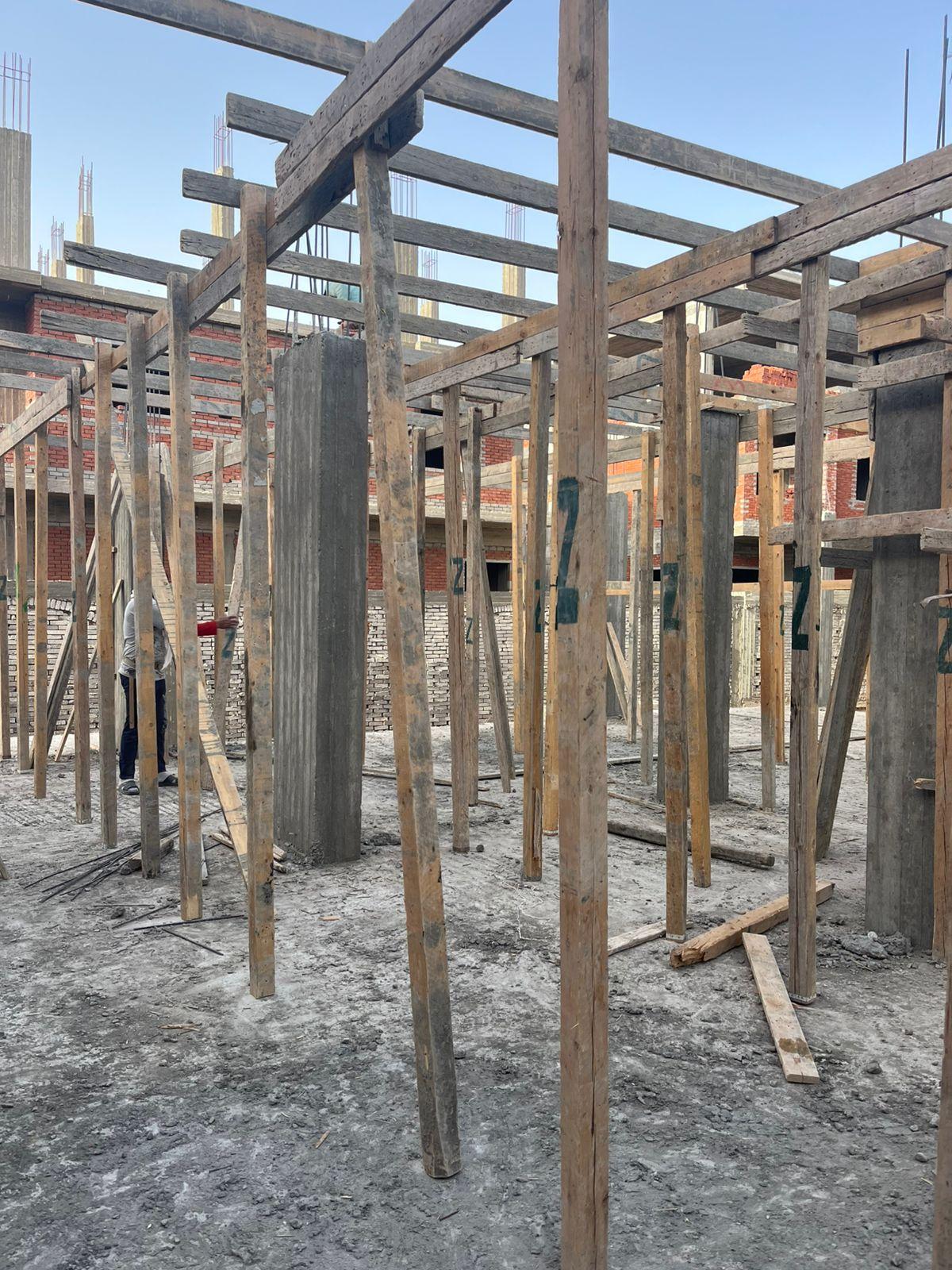

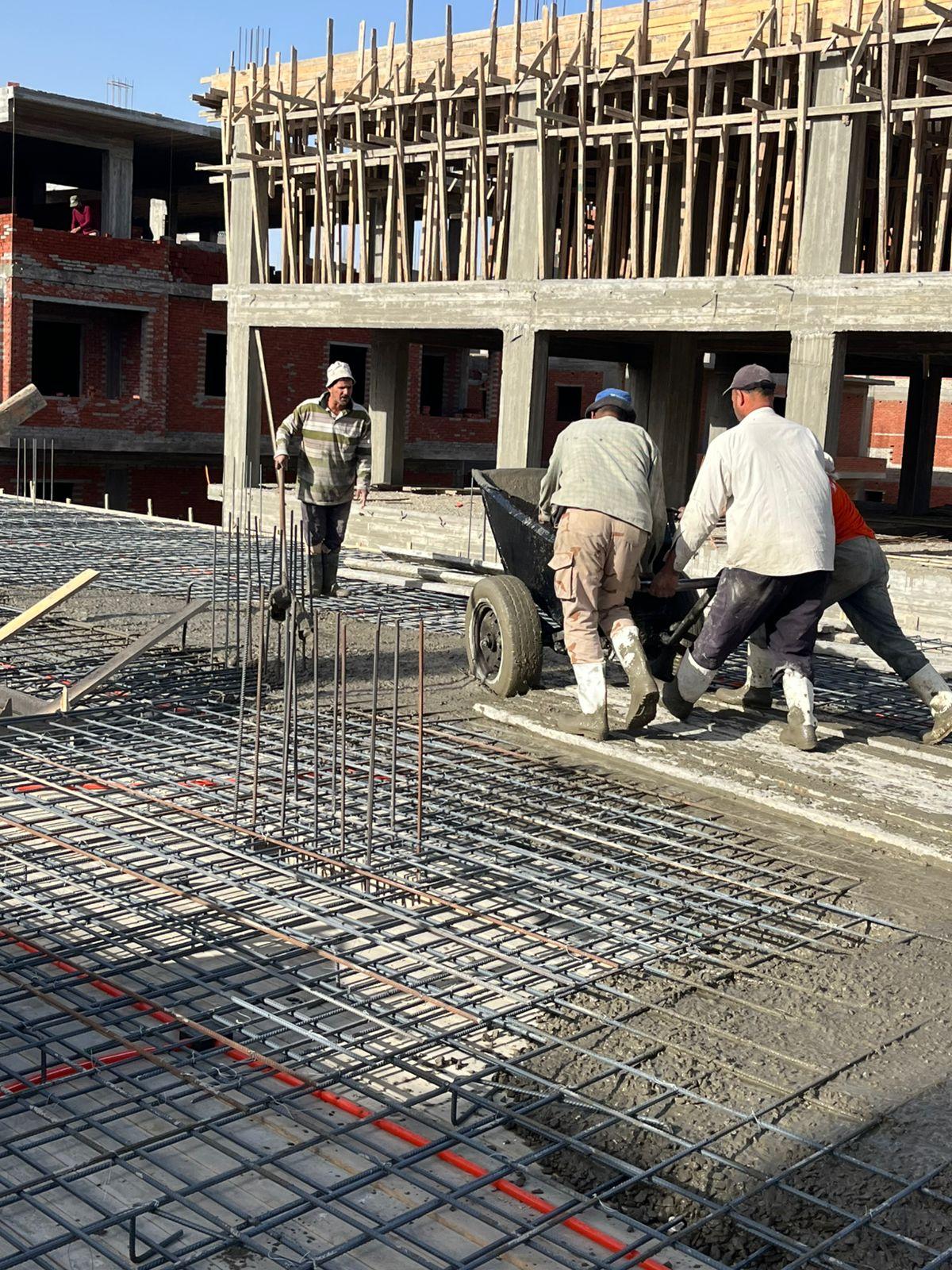

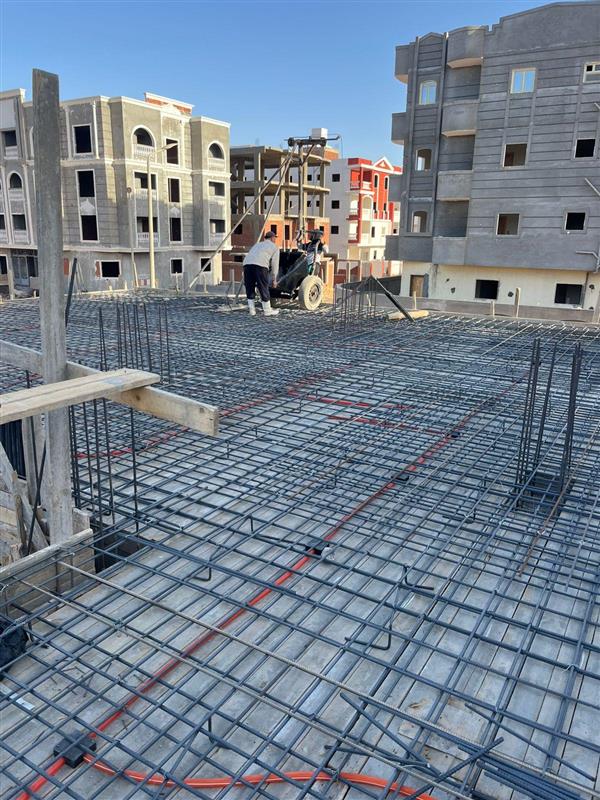

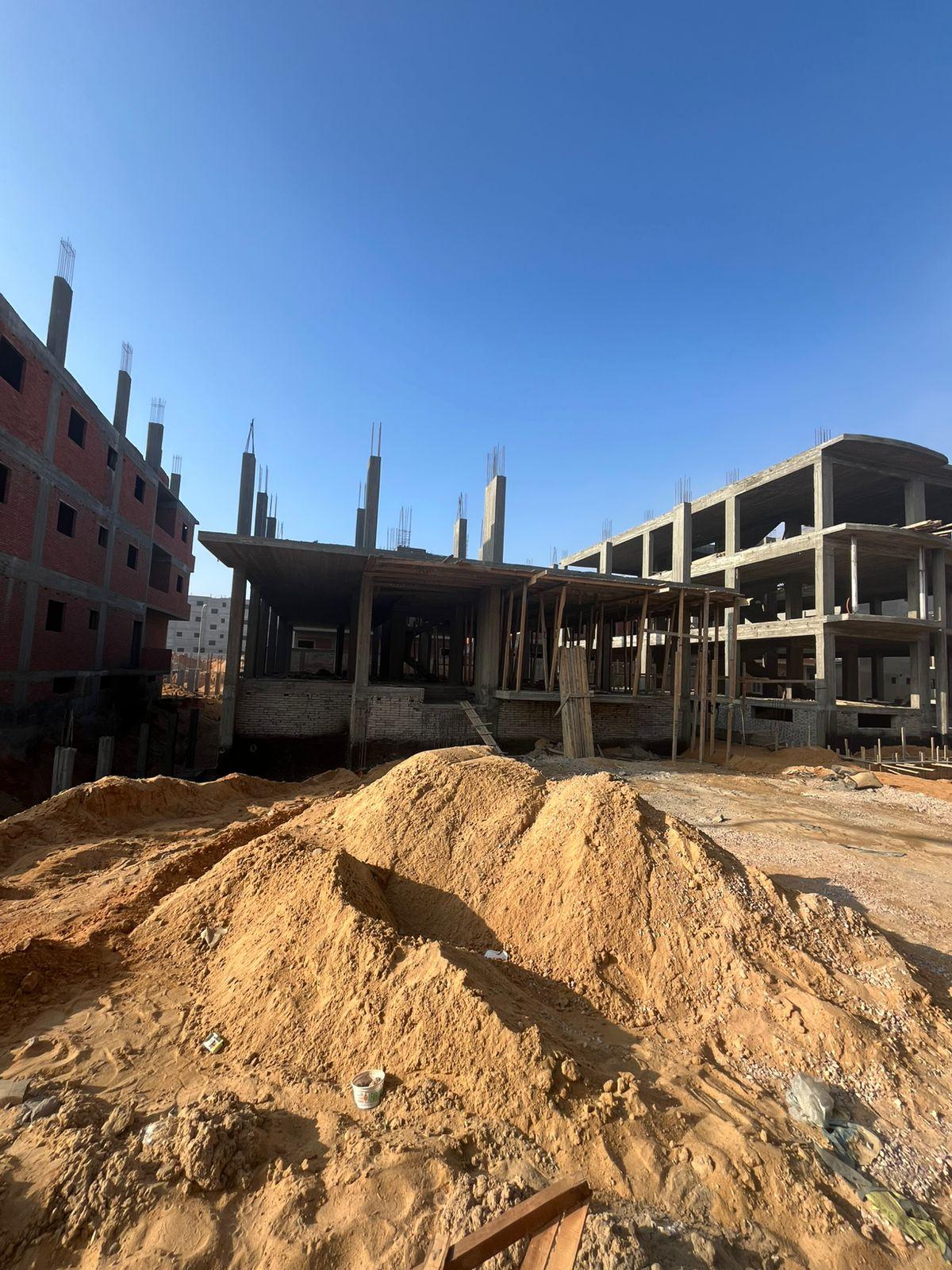

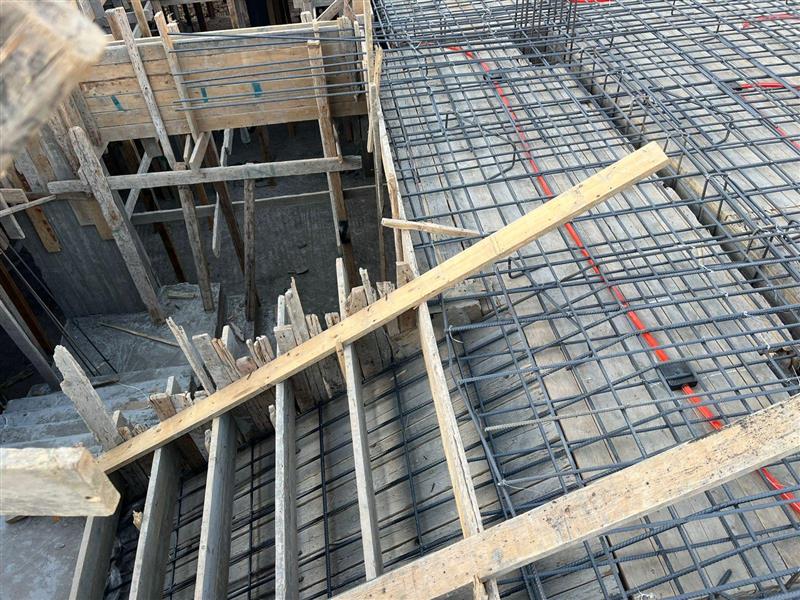

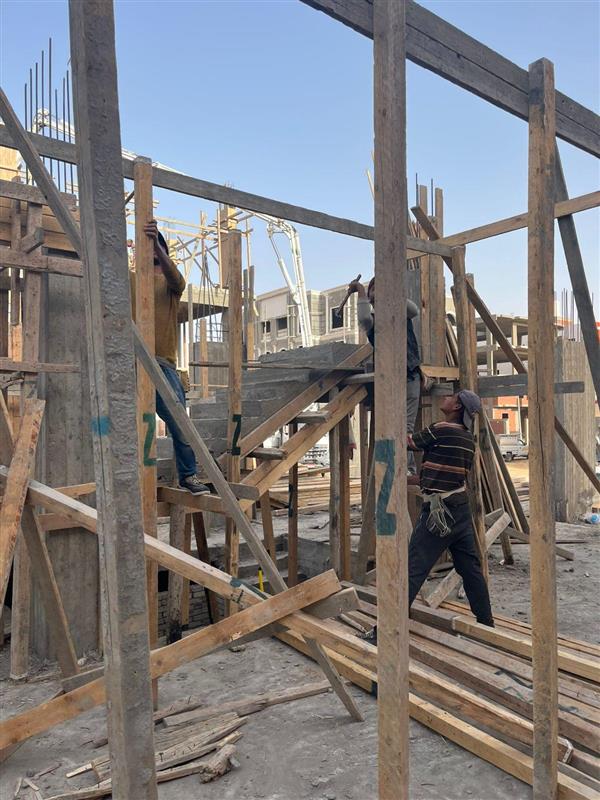

Ground floor slab

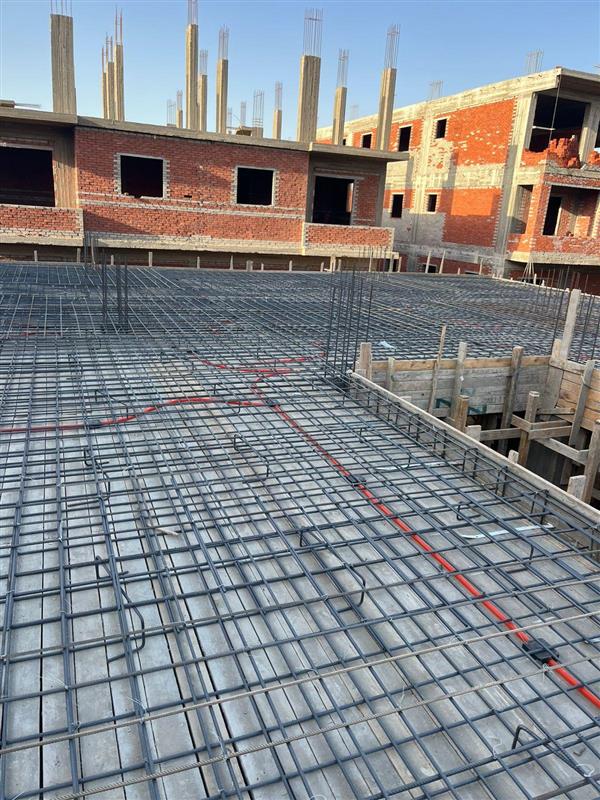

November 30, 2025

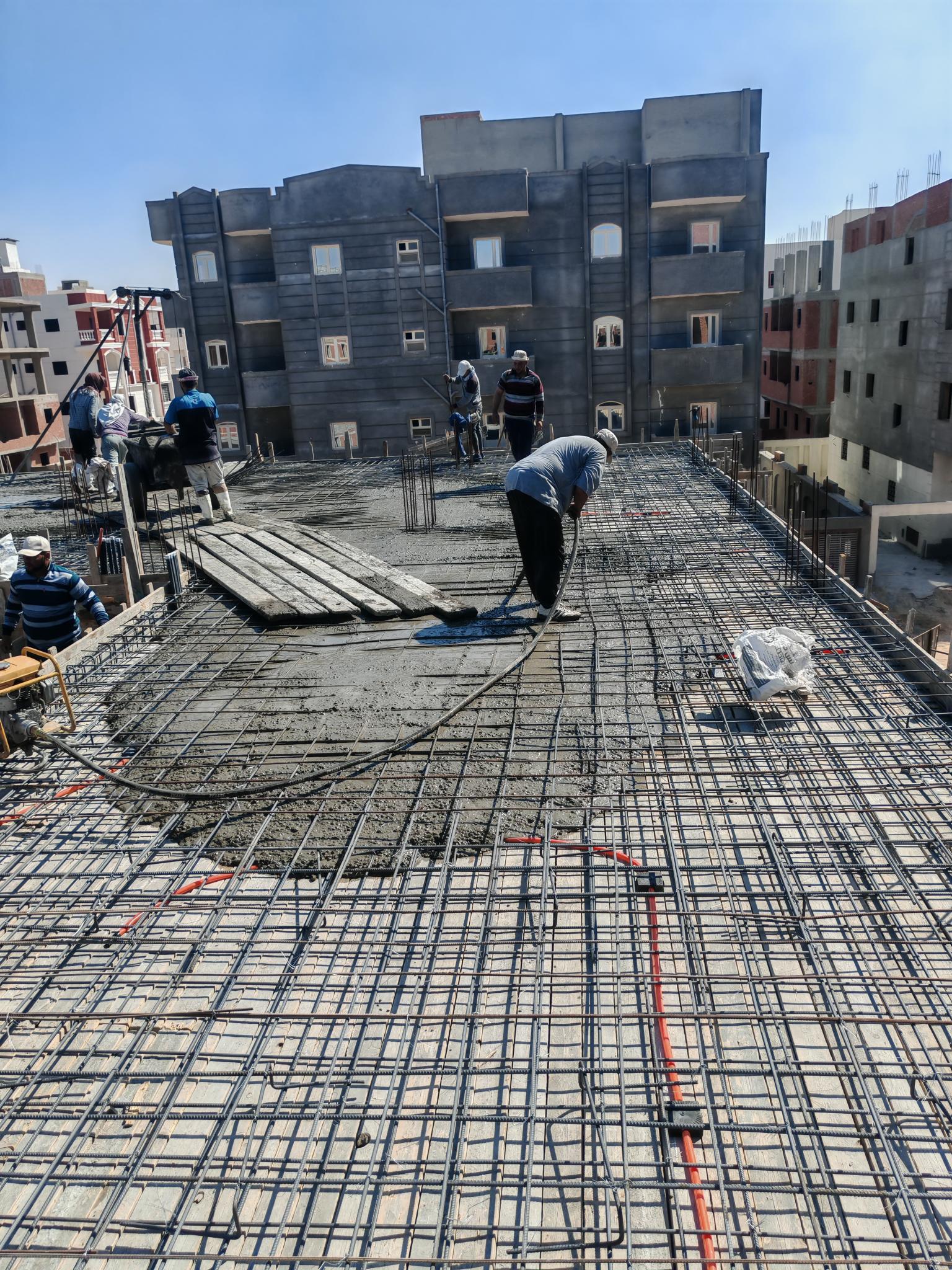

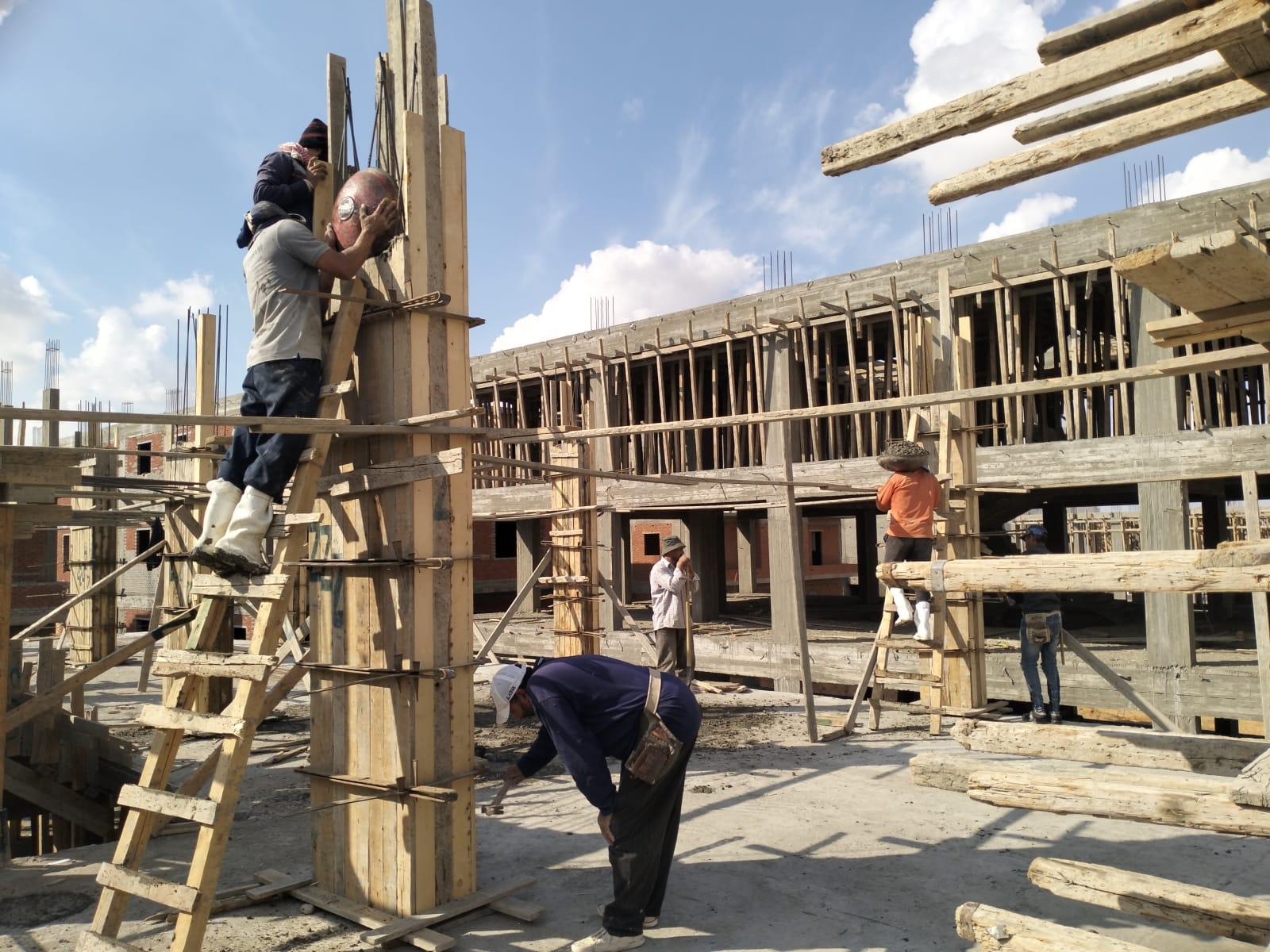

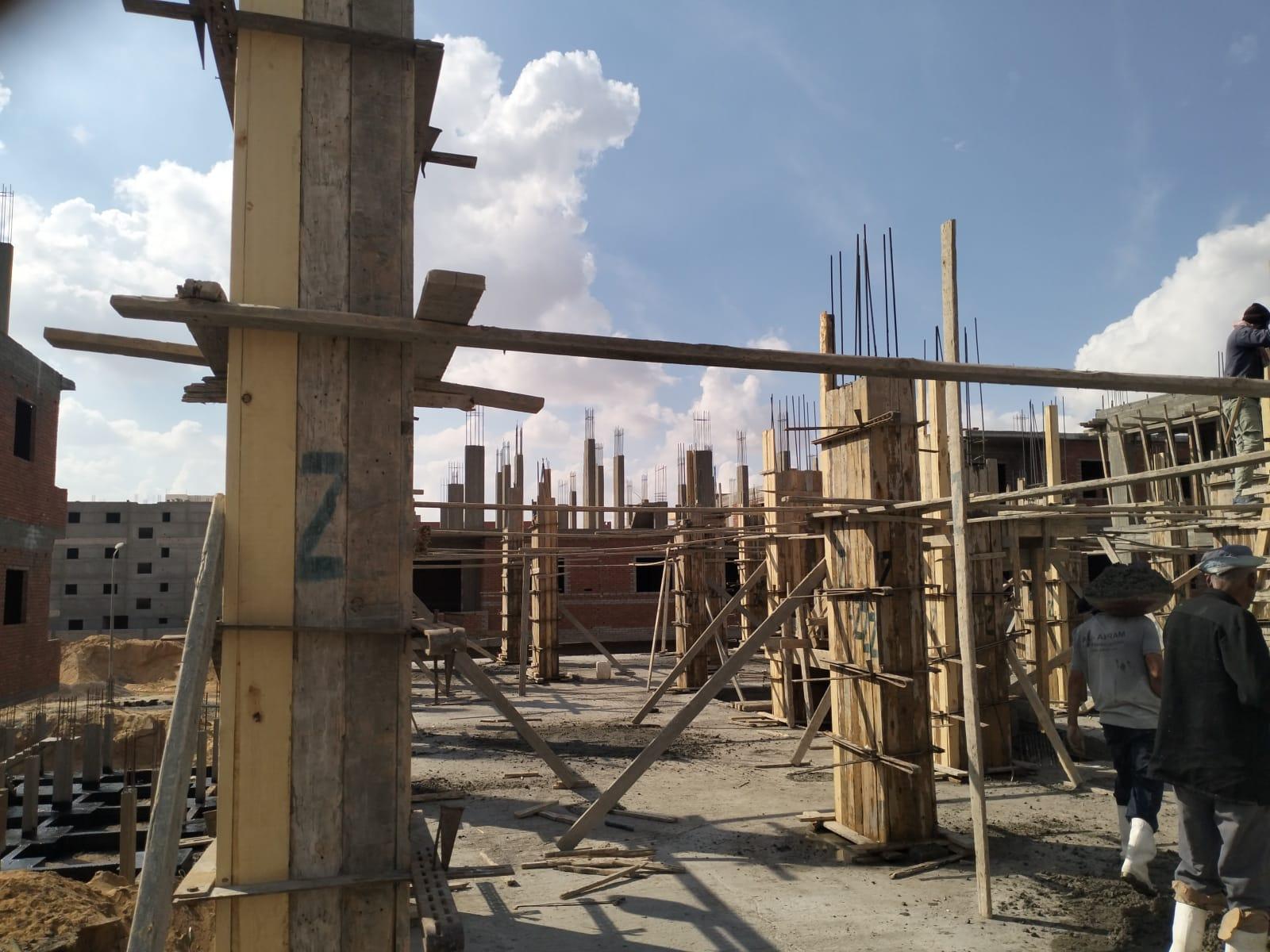

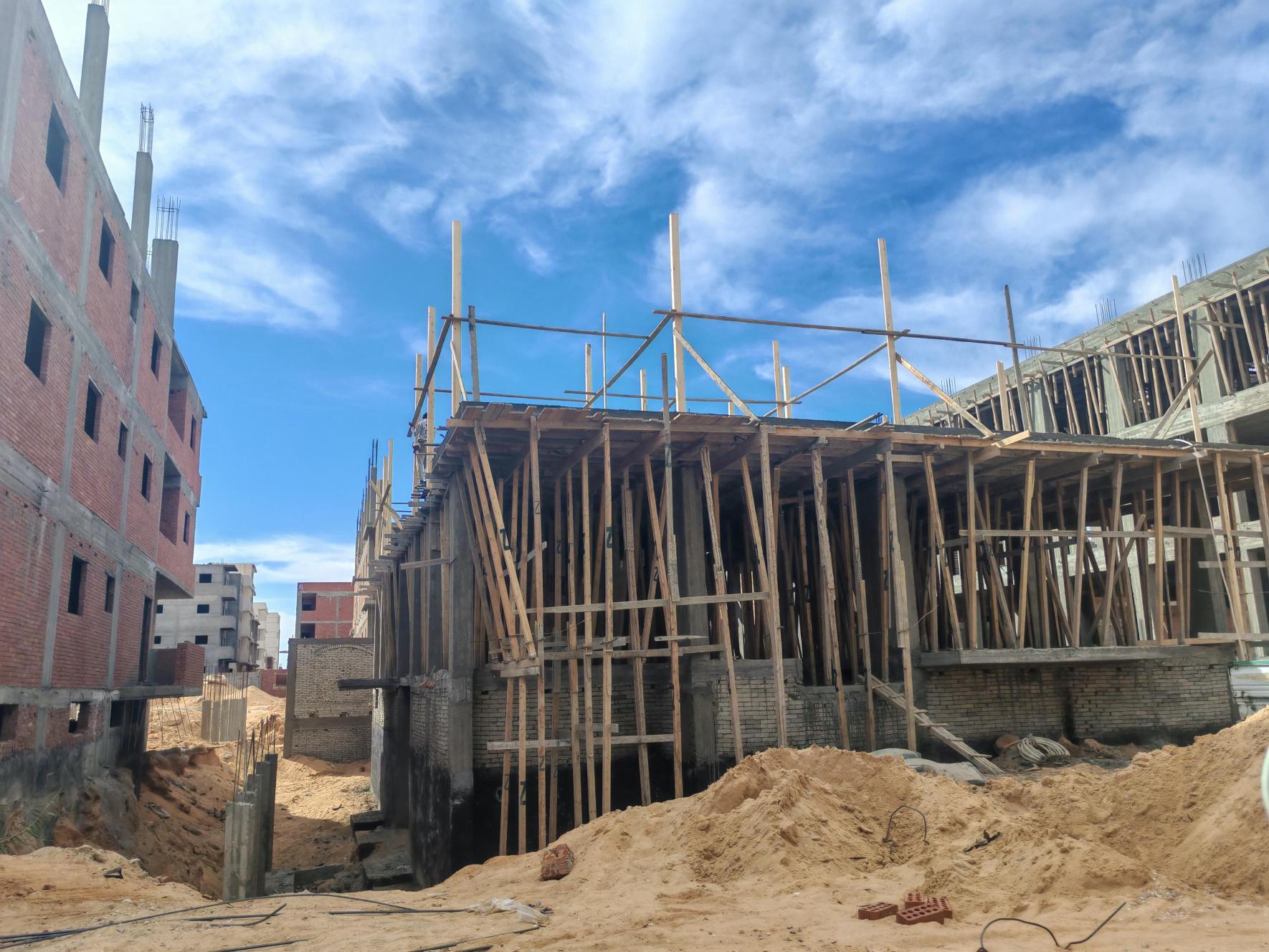

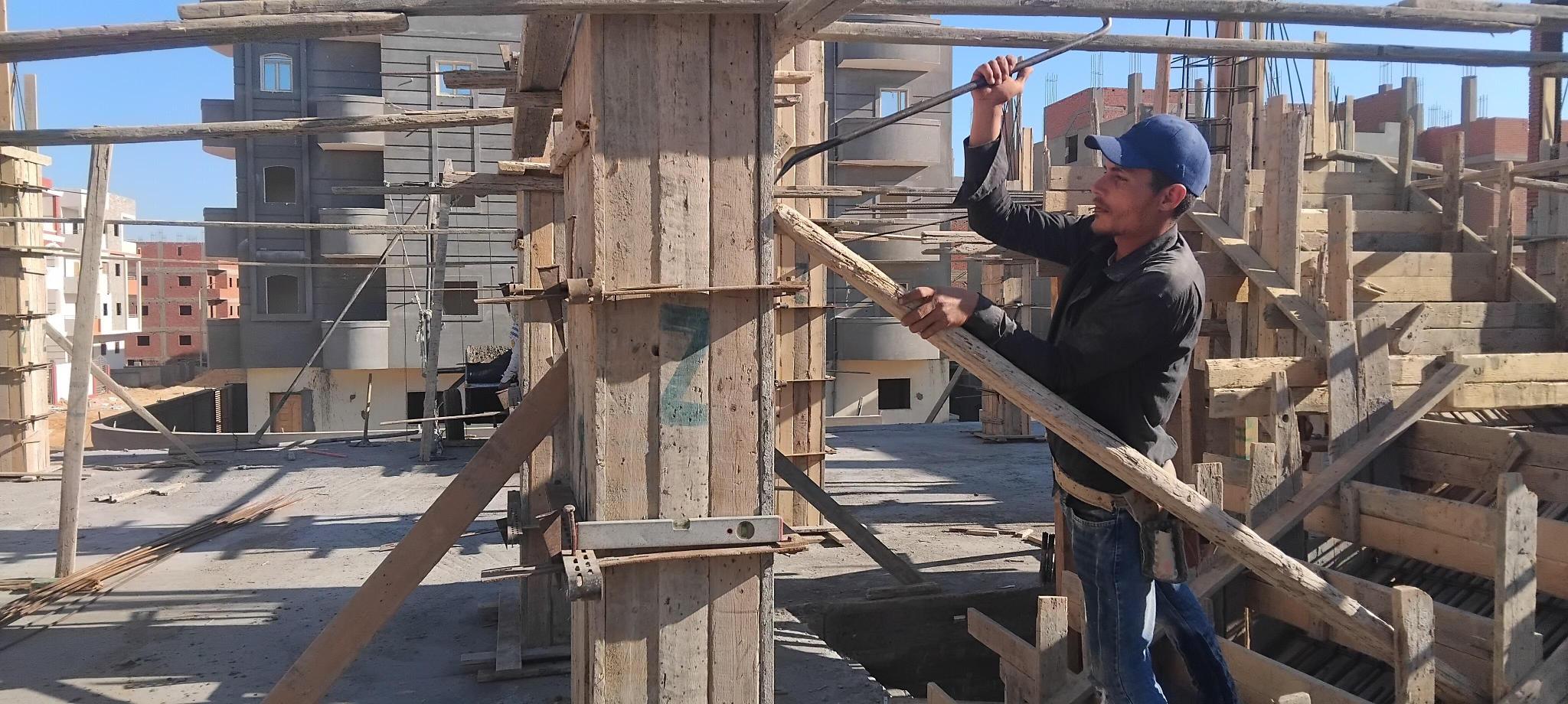

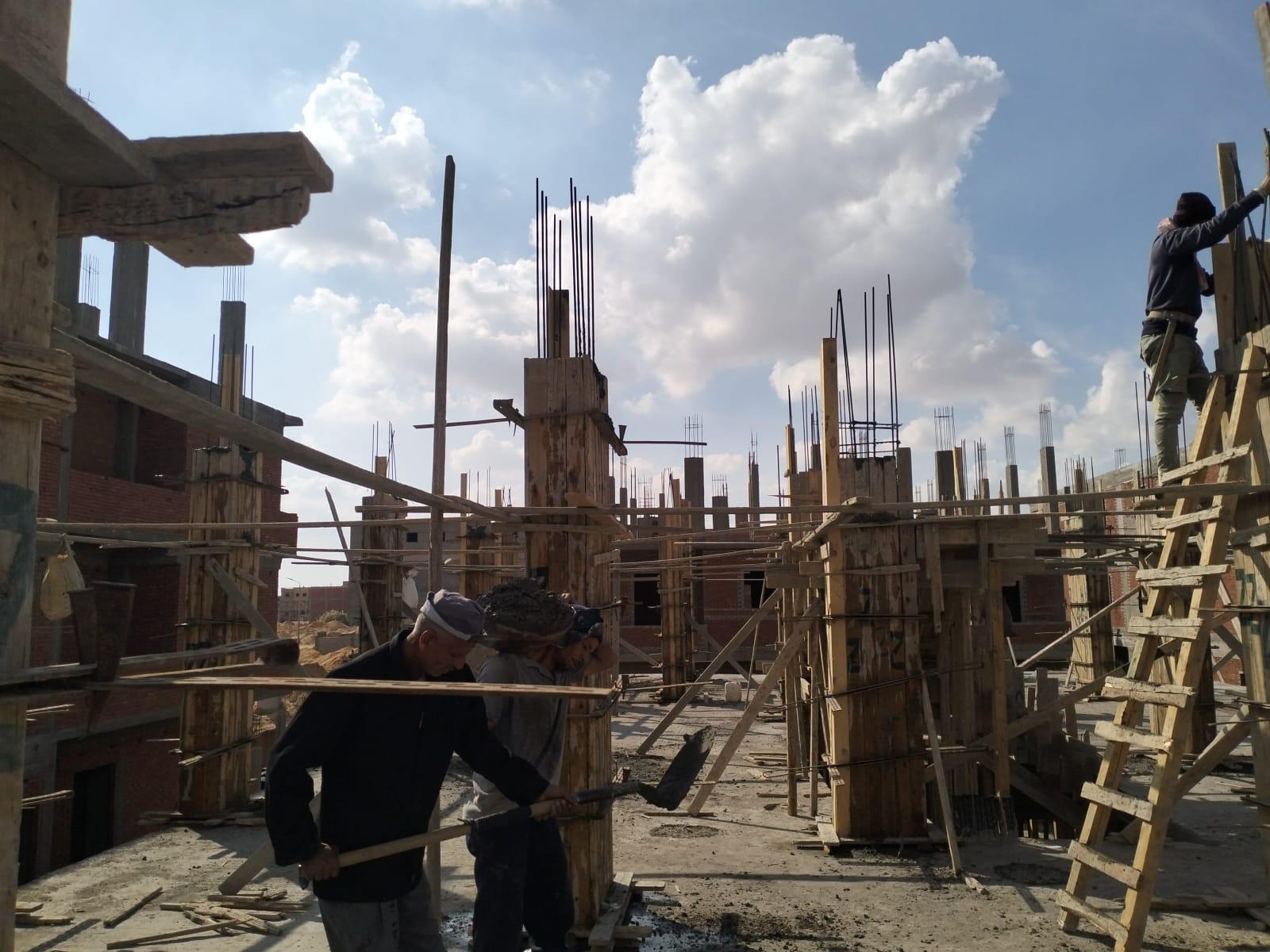

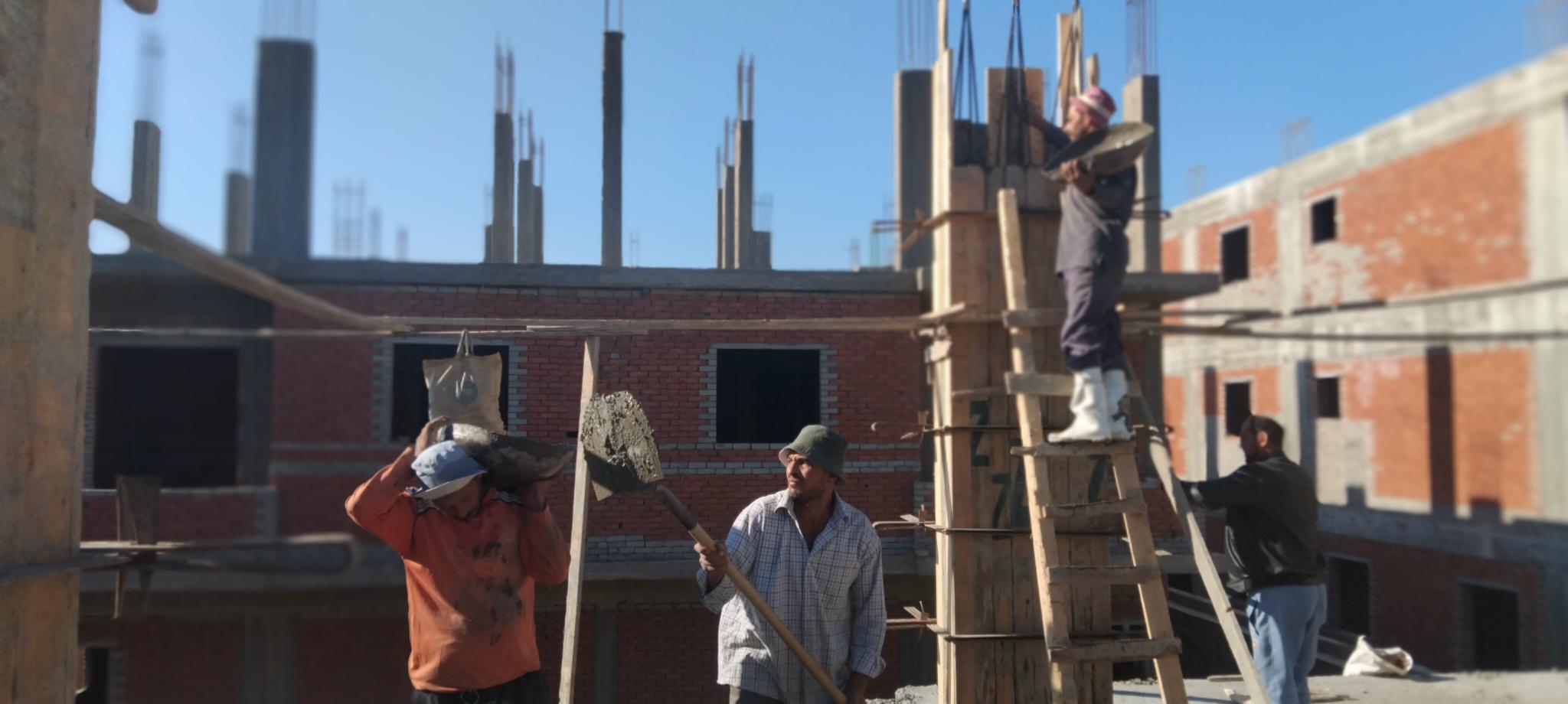

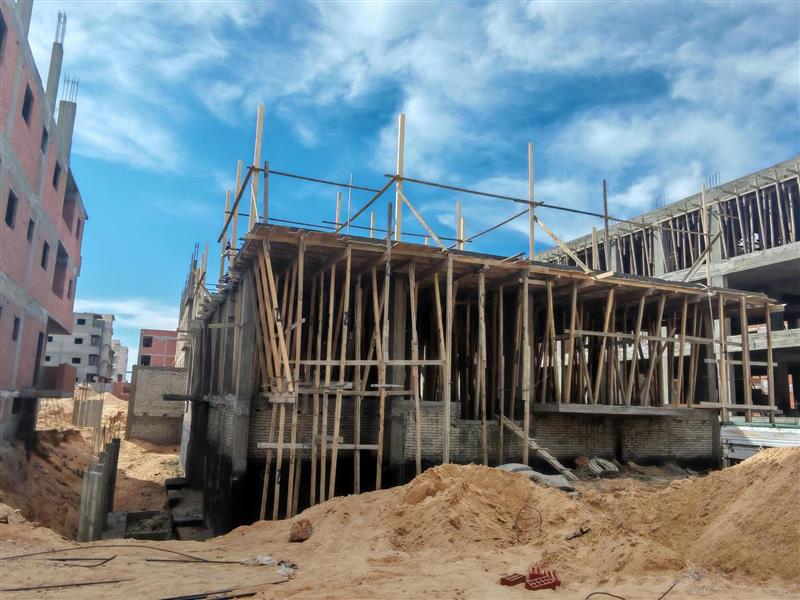

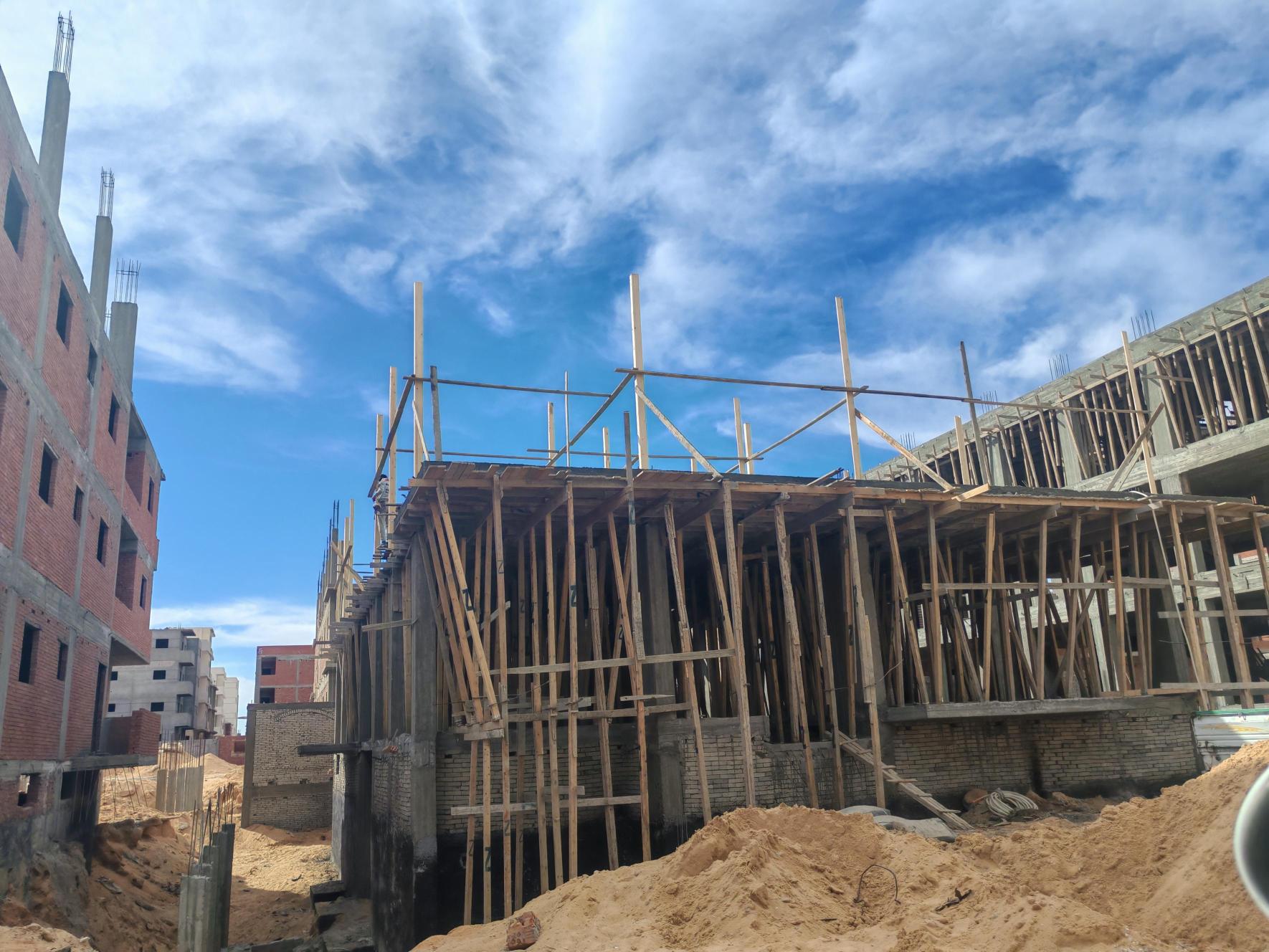

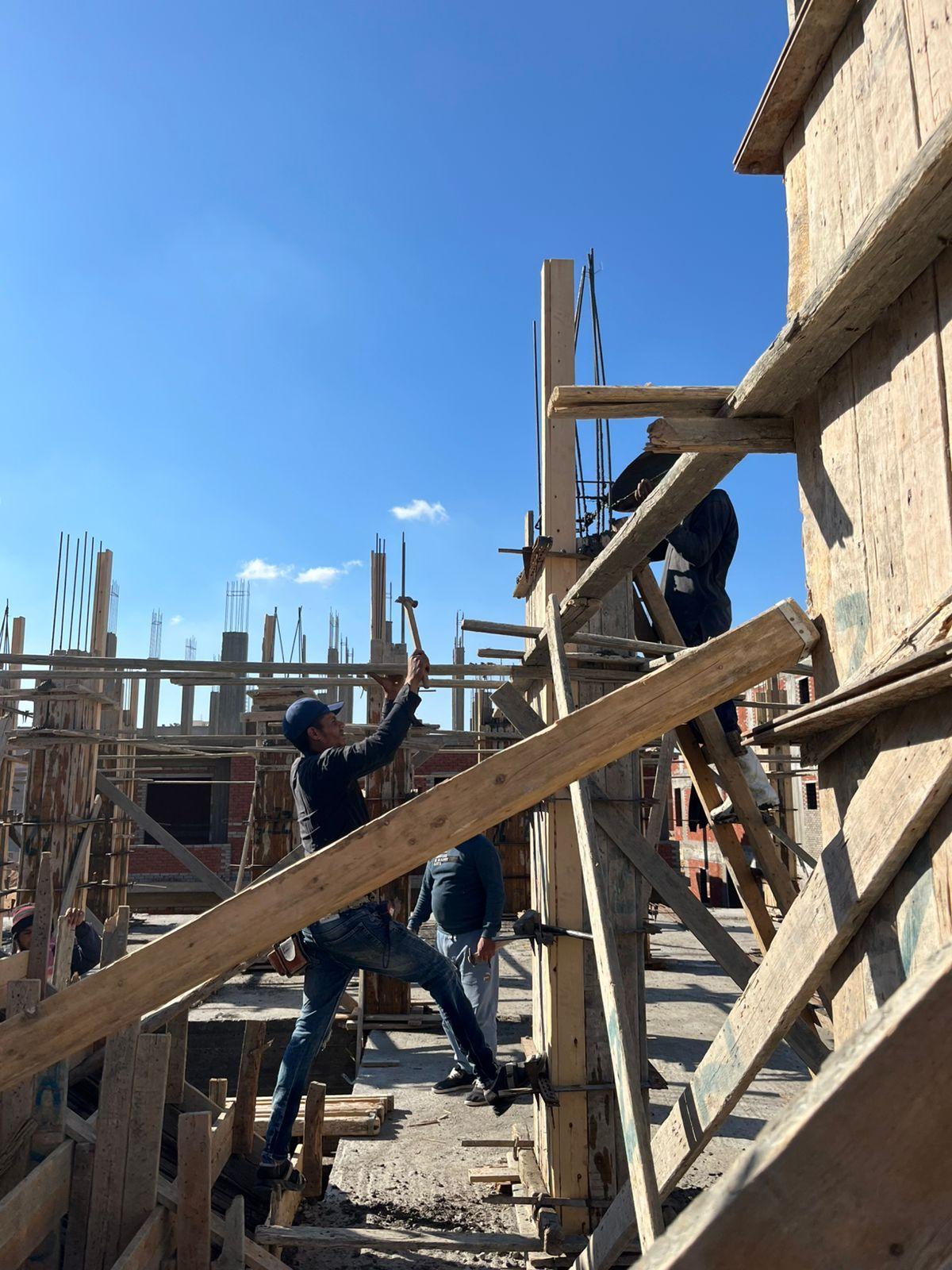

First floor columns

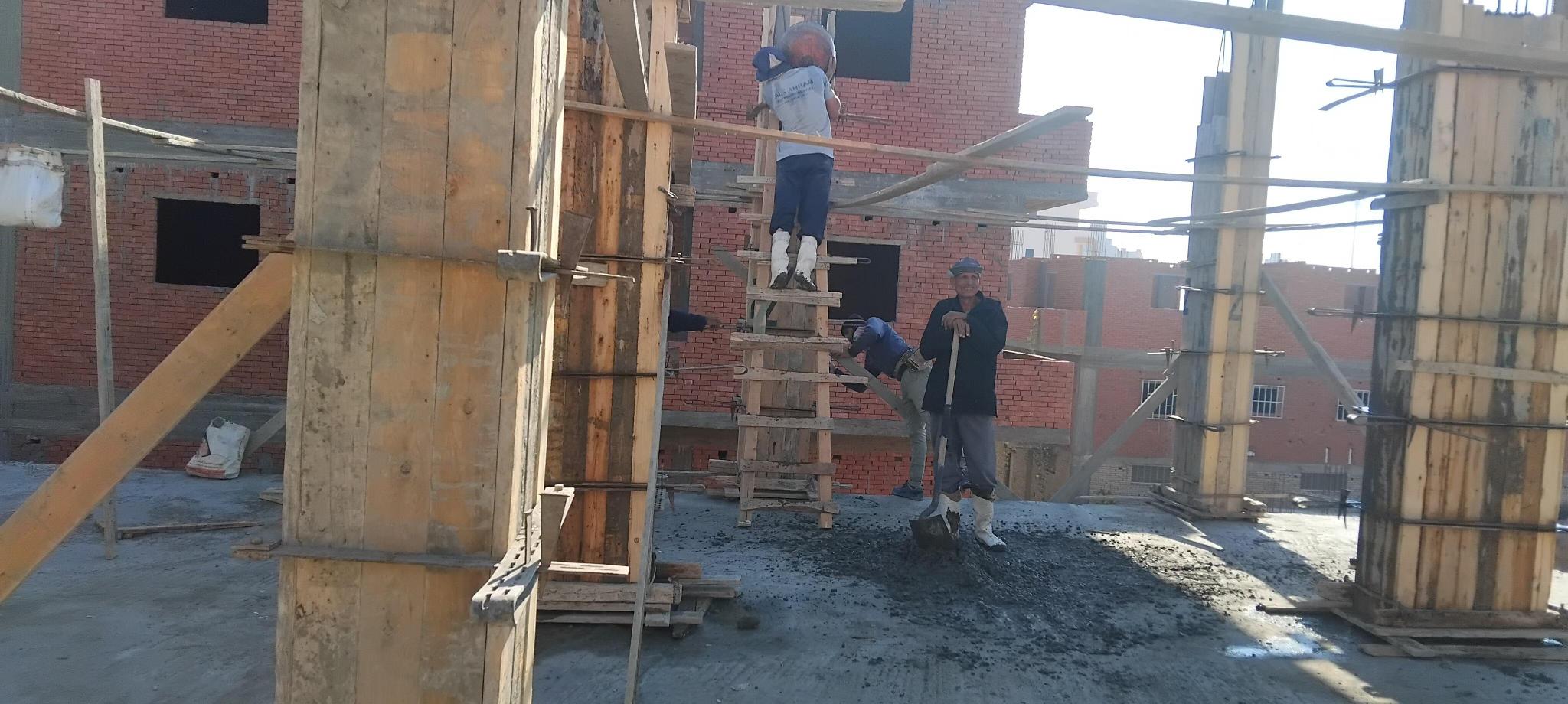

December 9, 2025

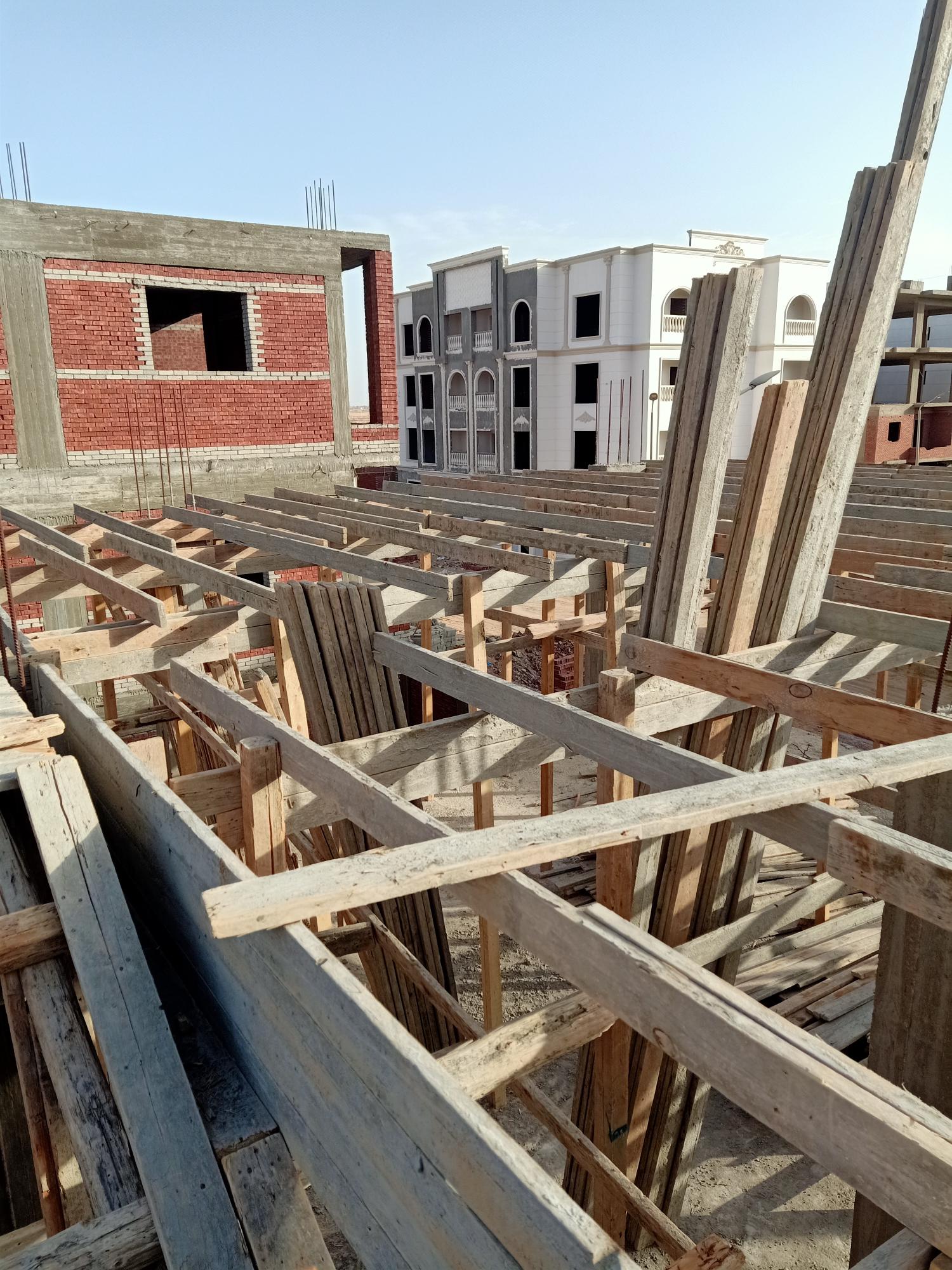

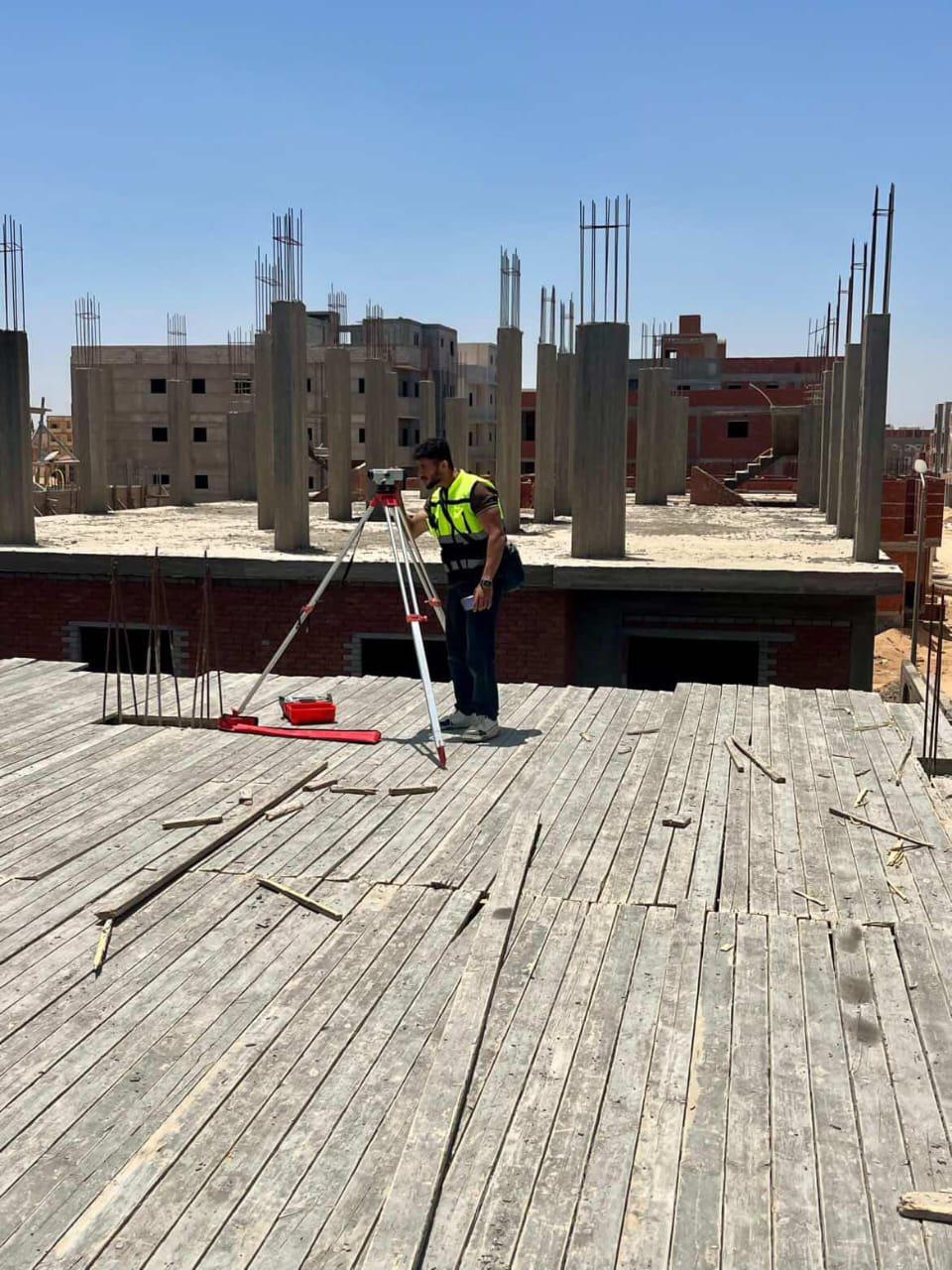

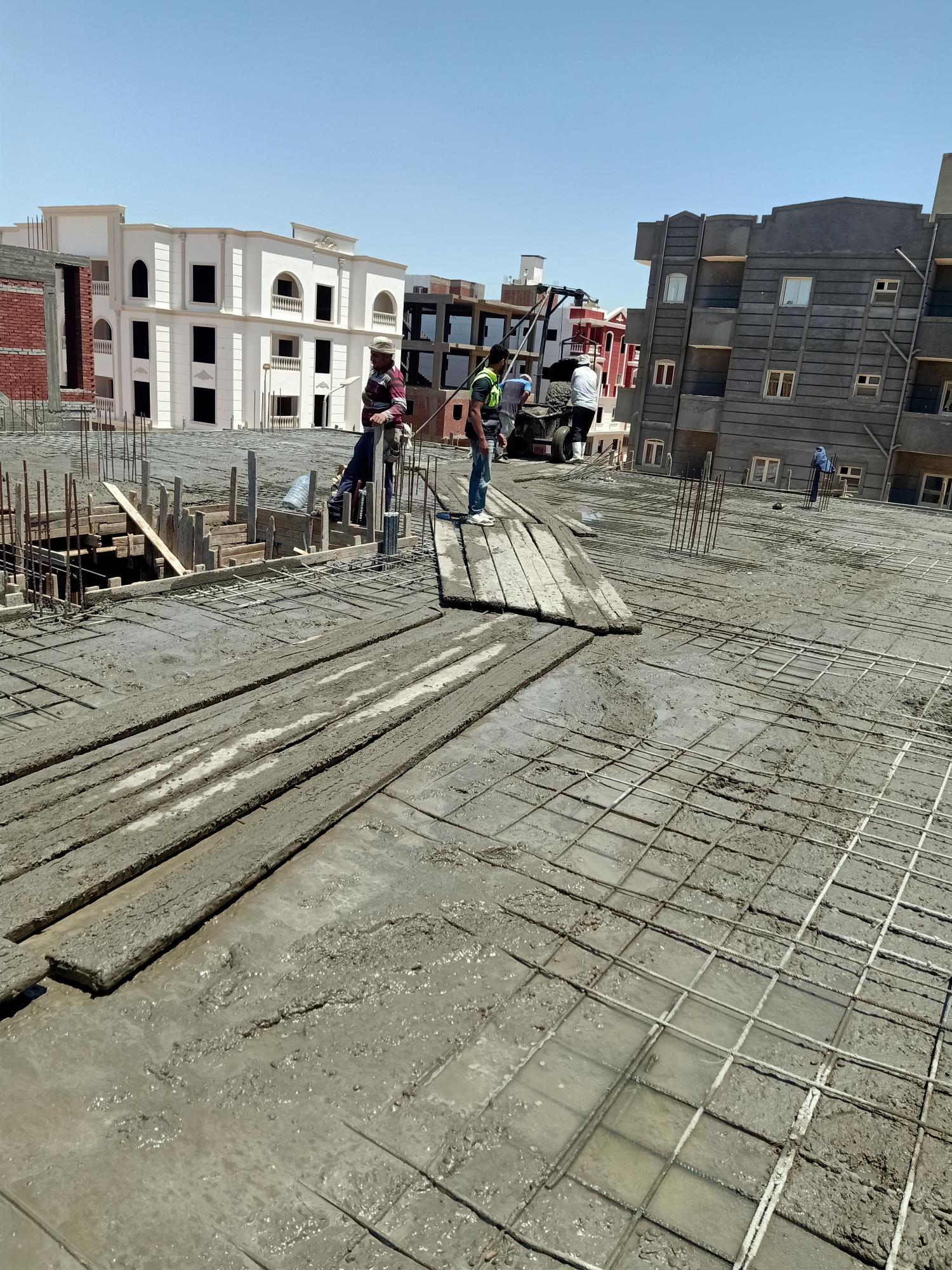

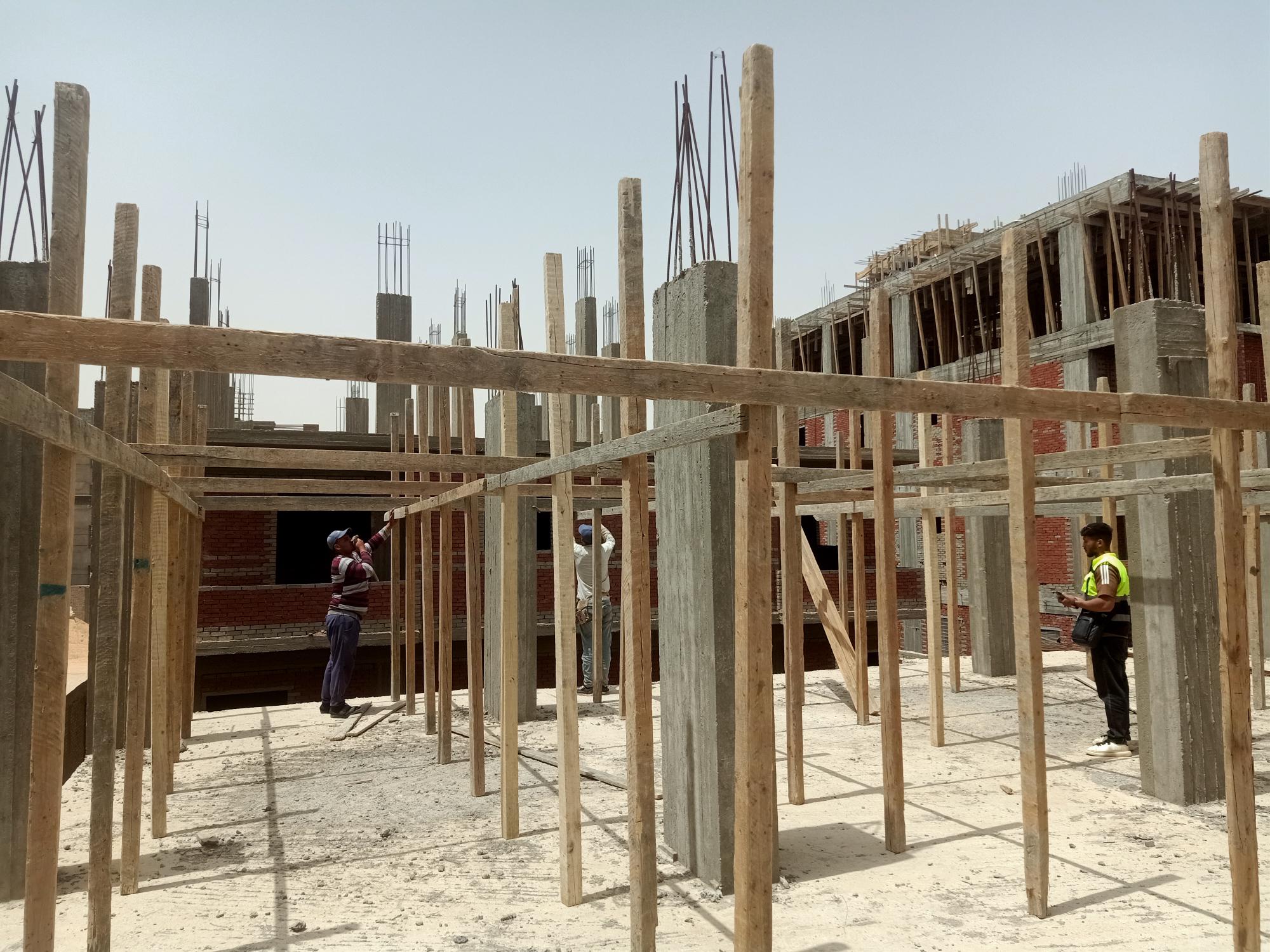

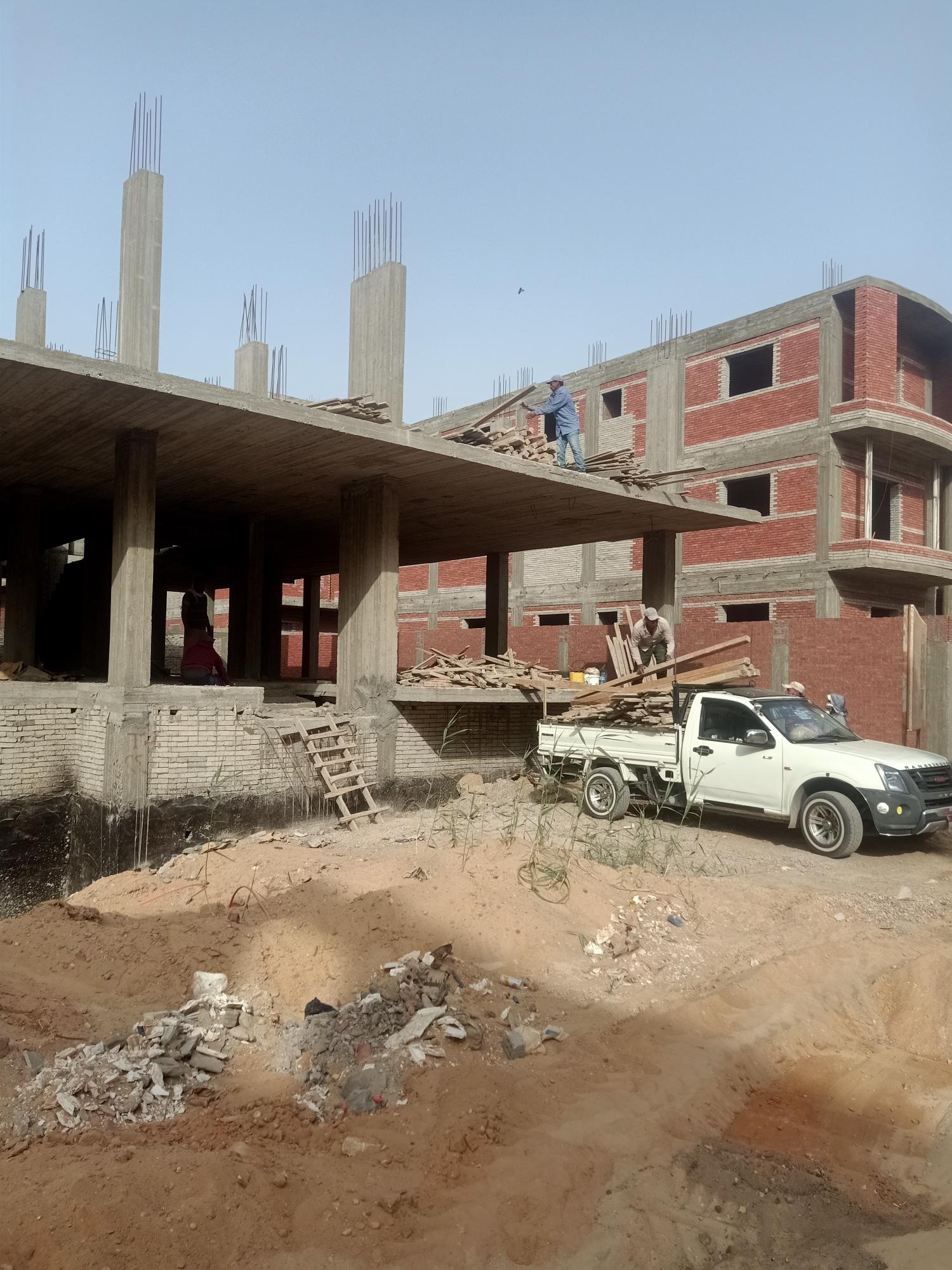

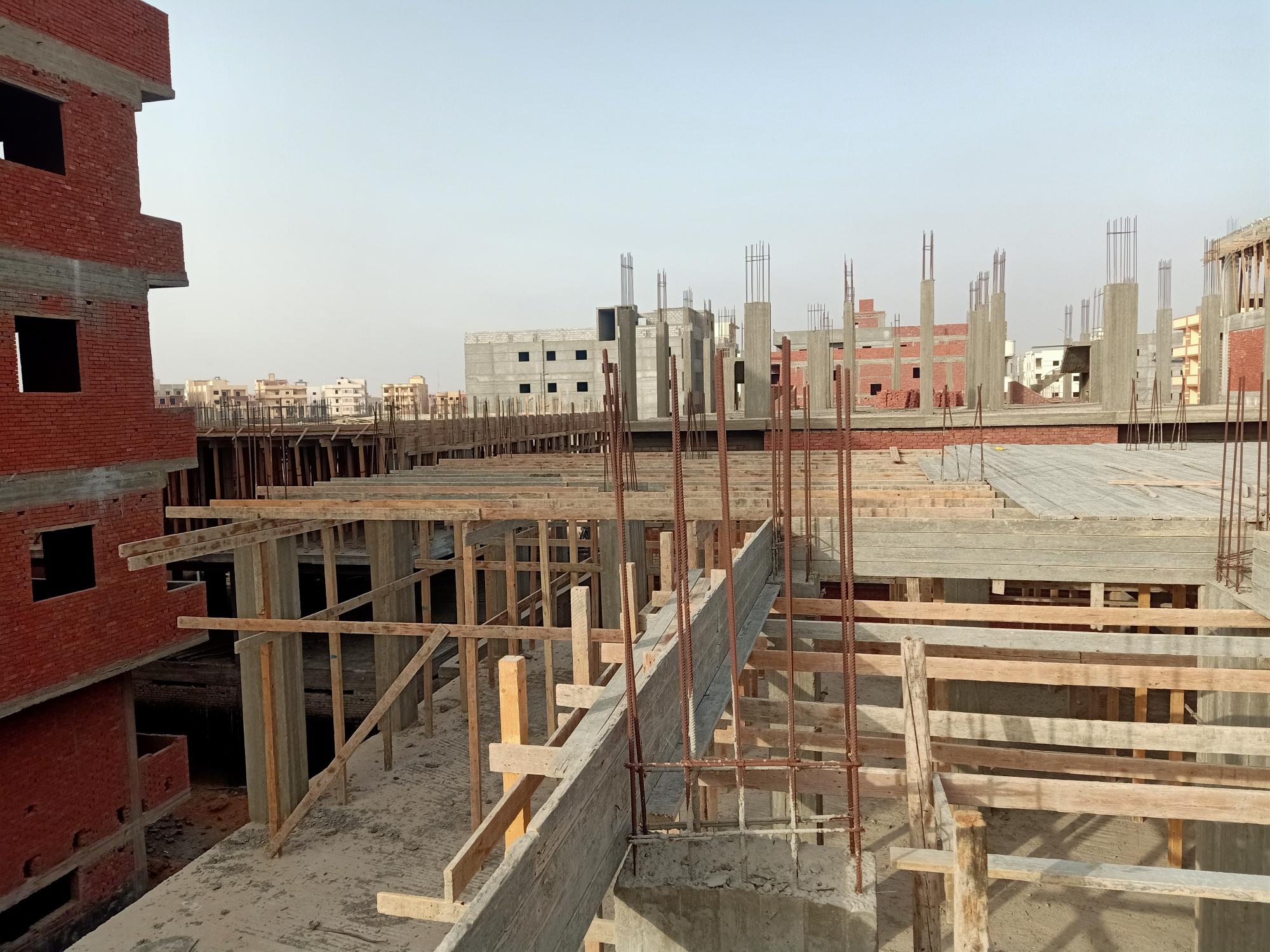

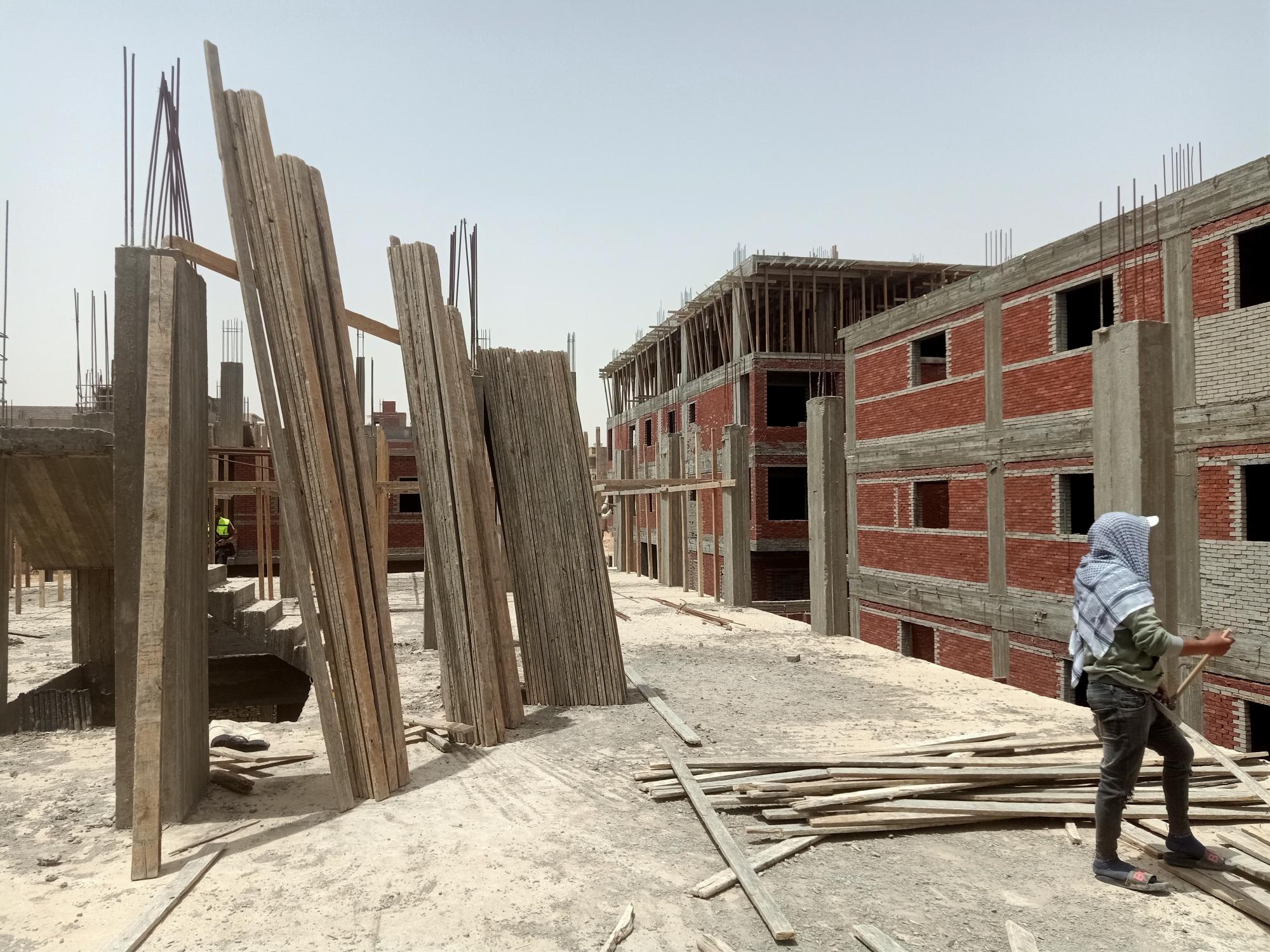

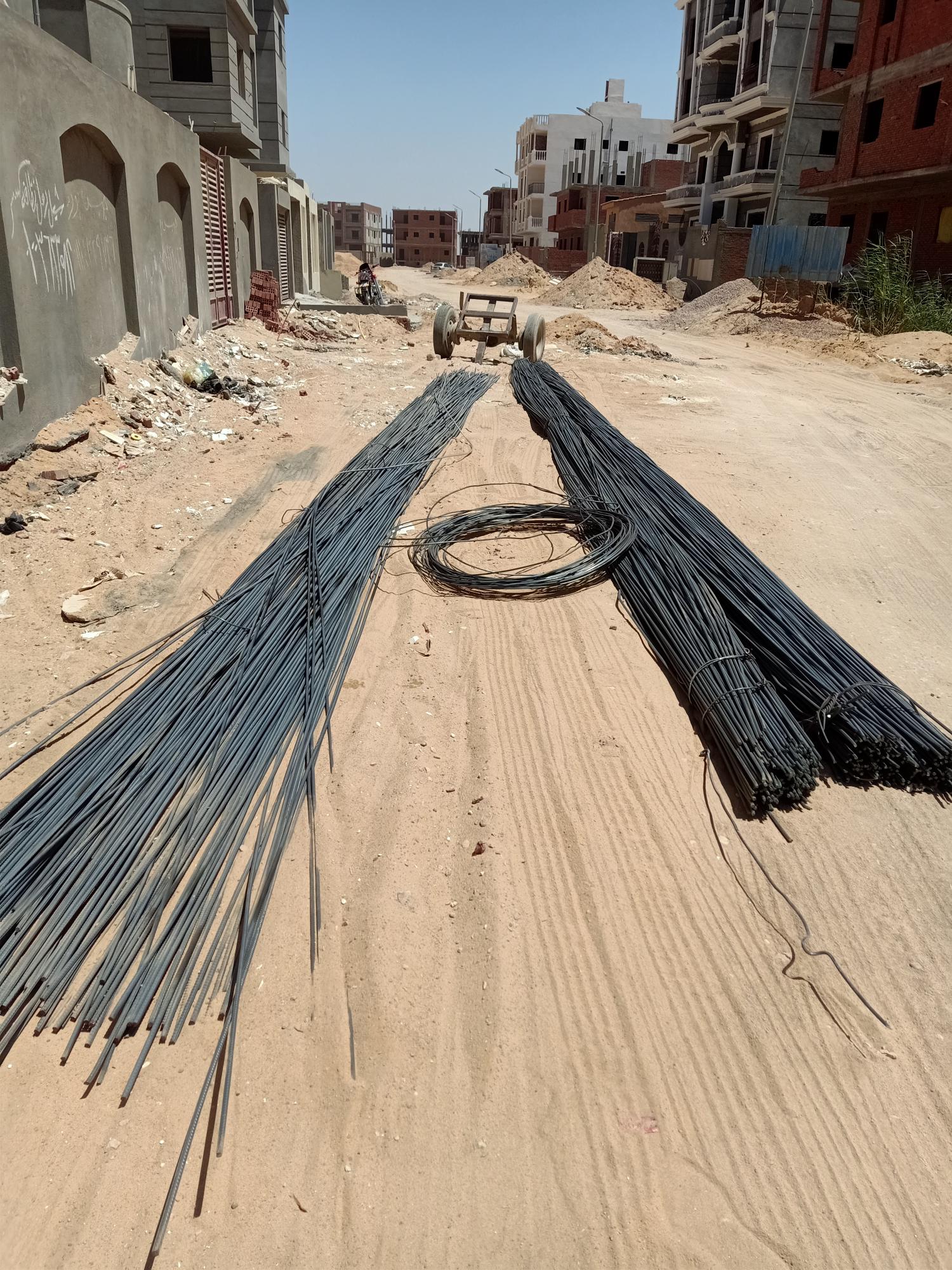

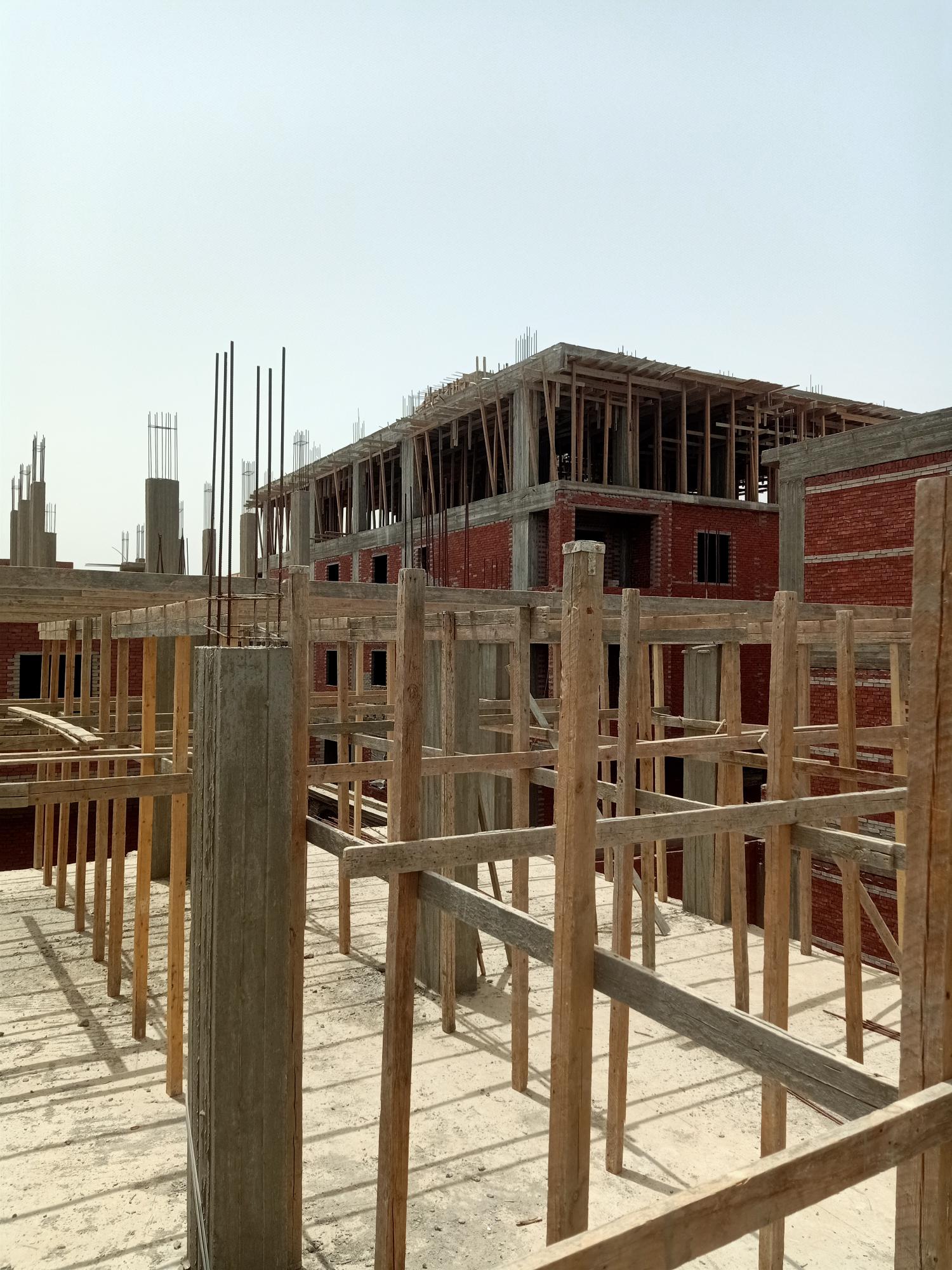

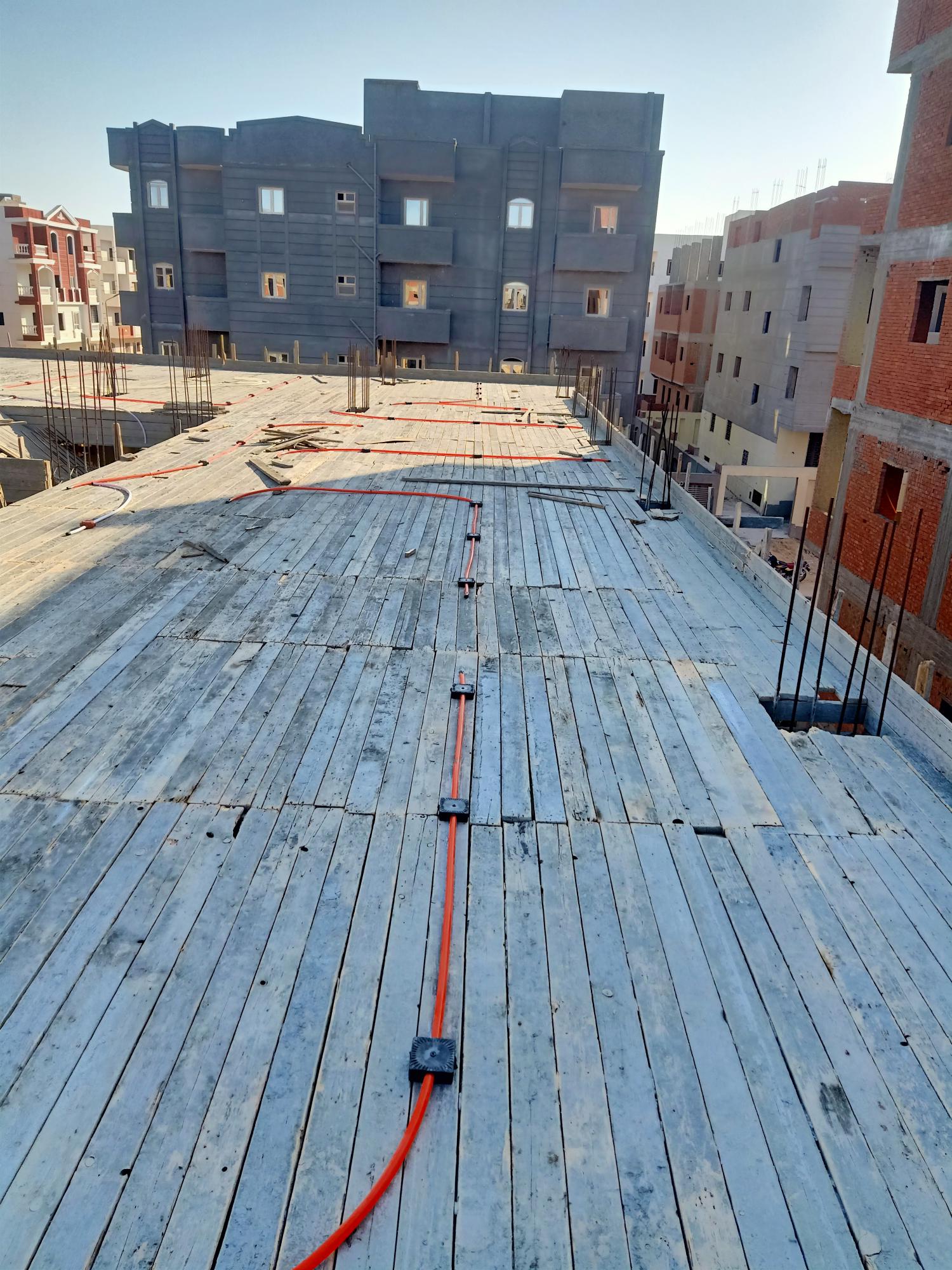

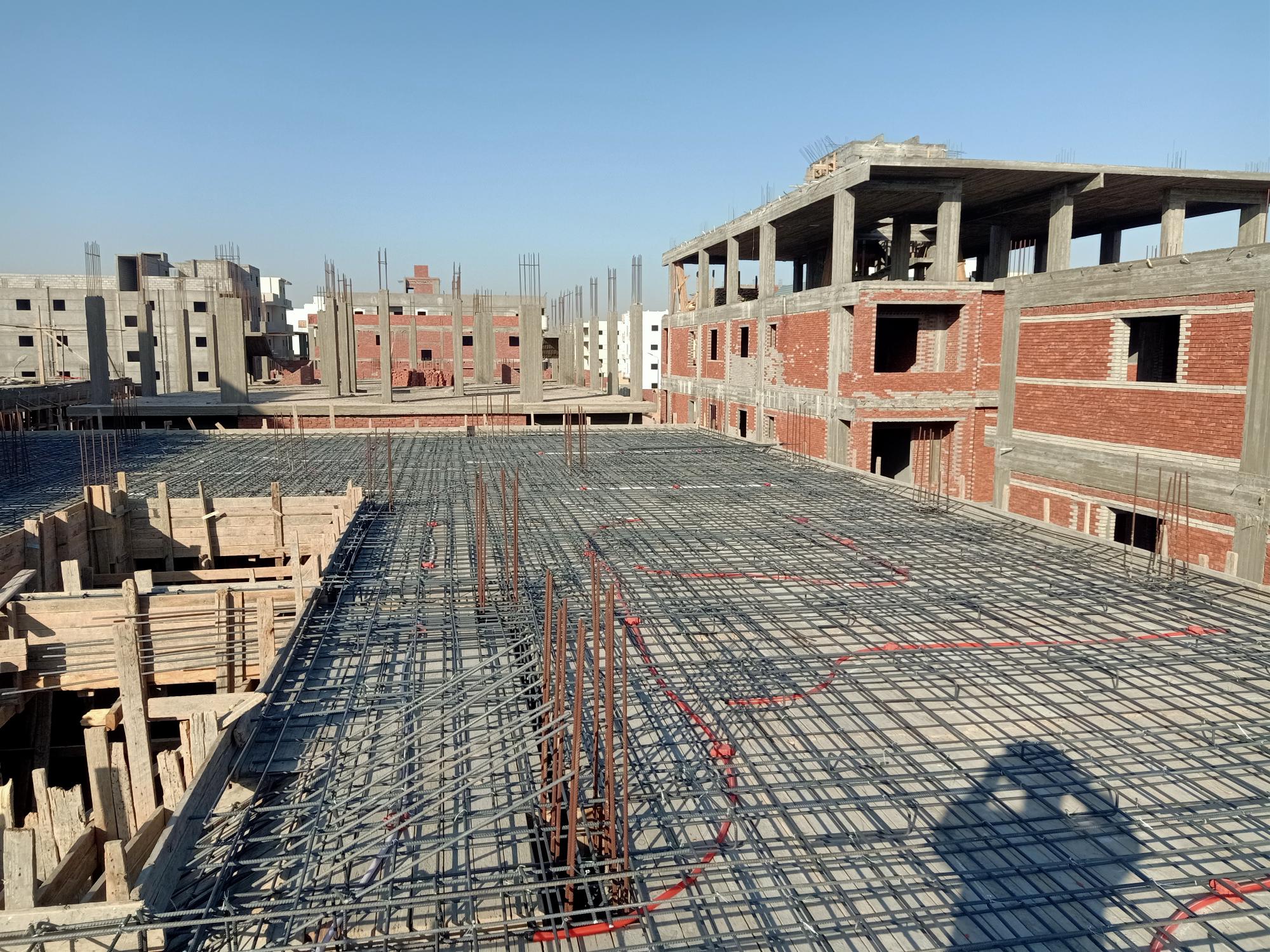

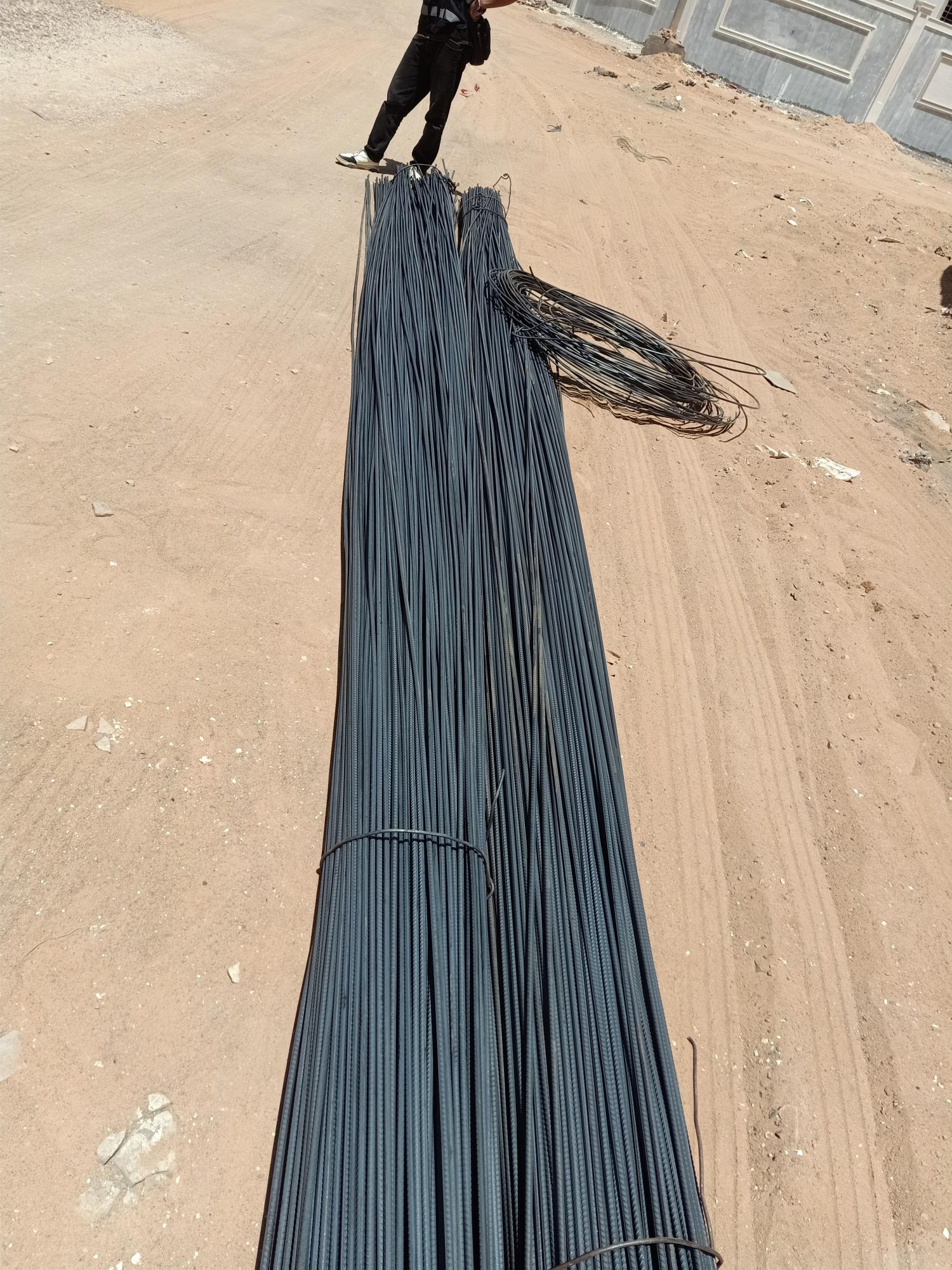

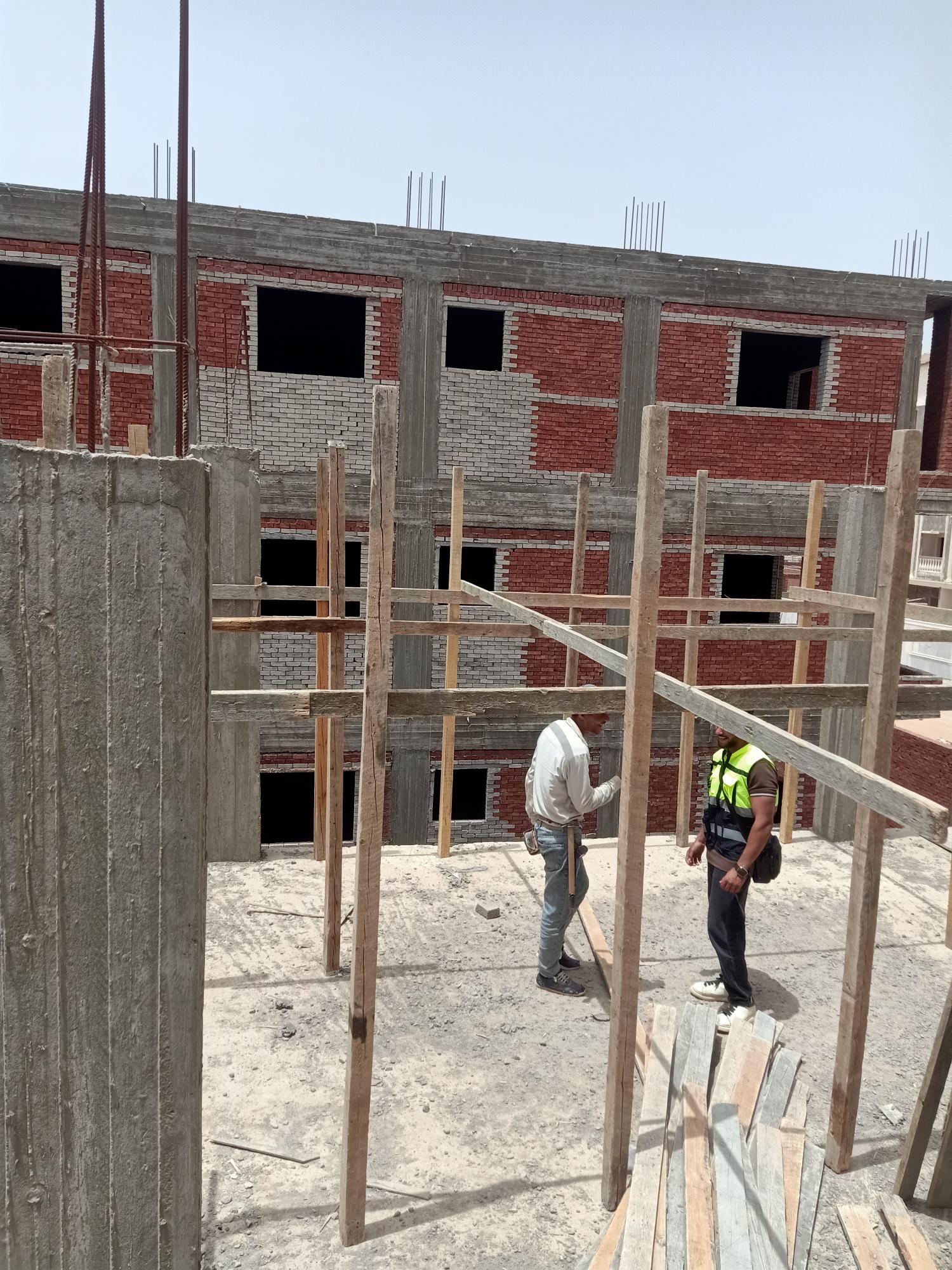

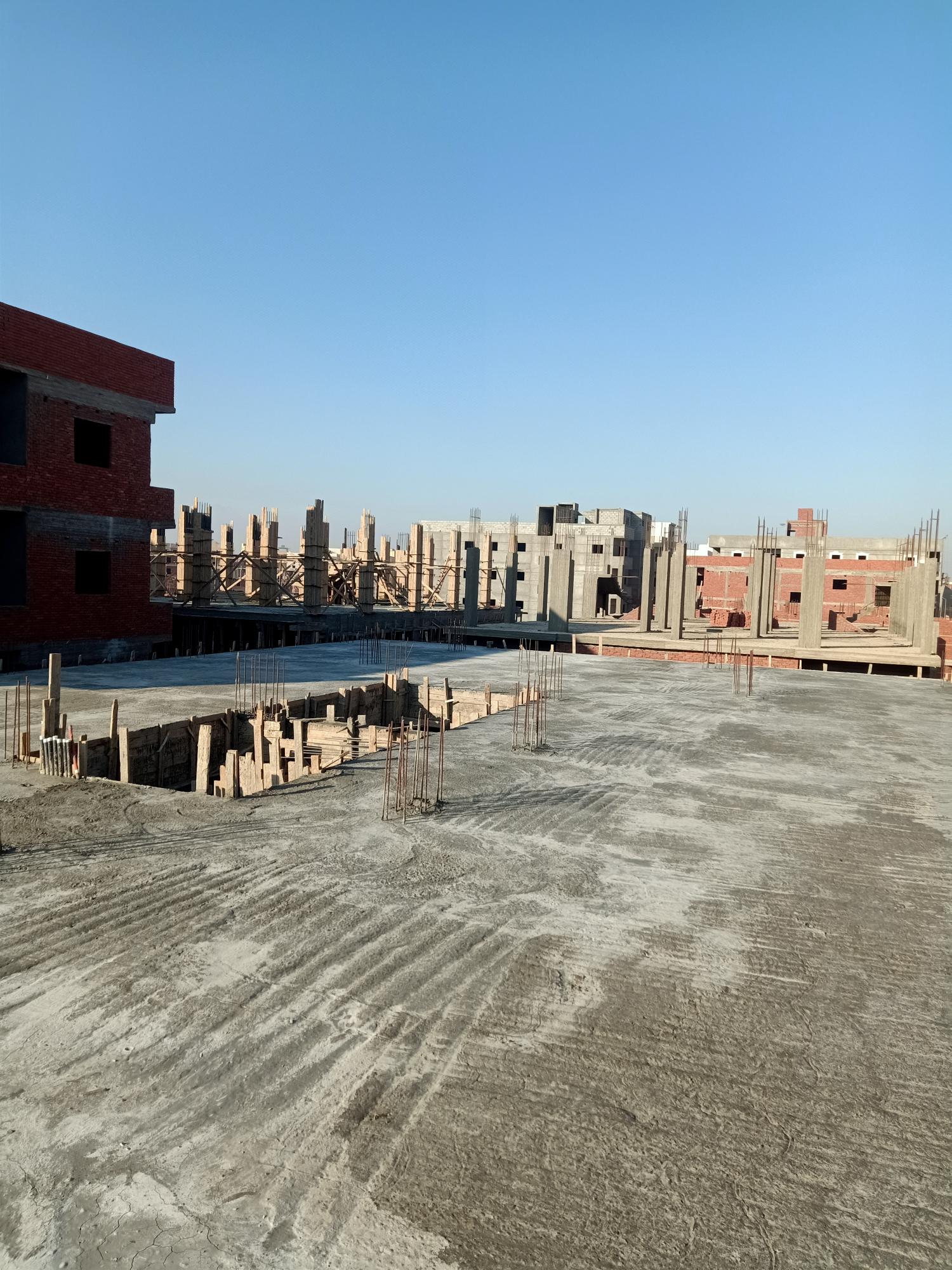

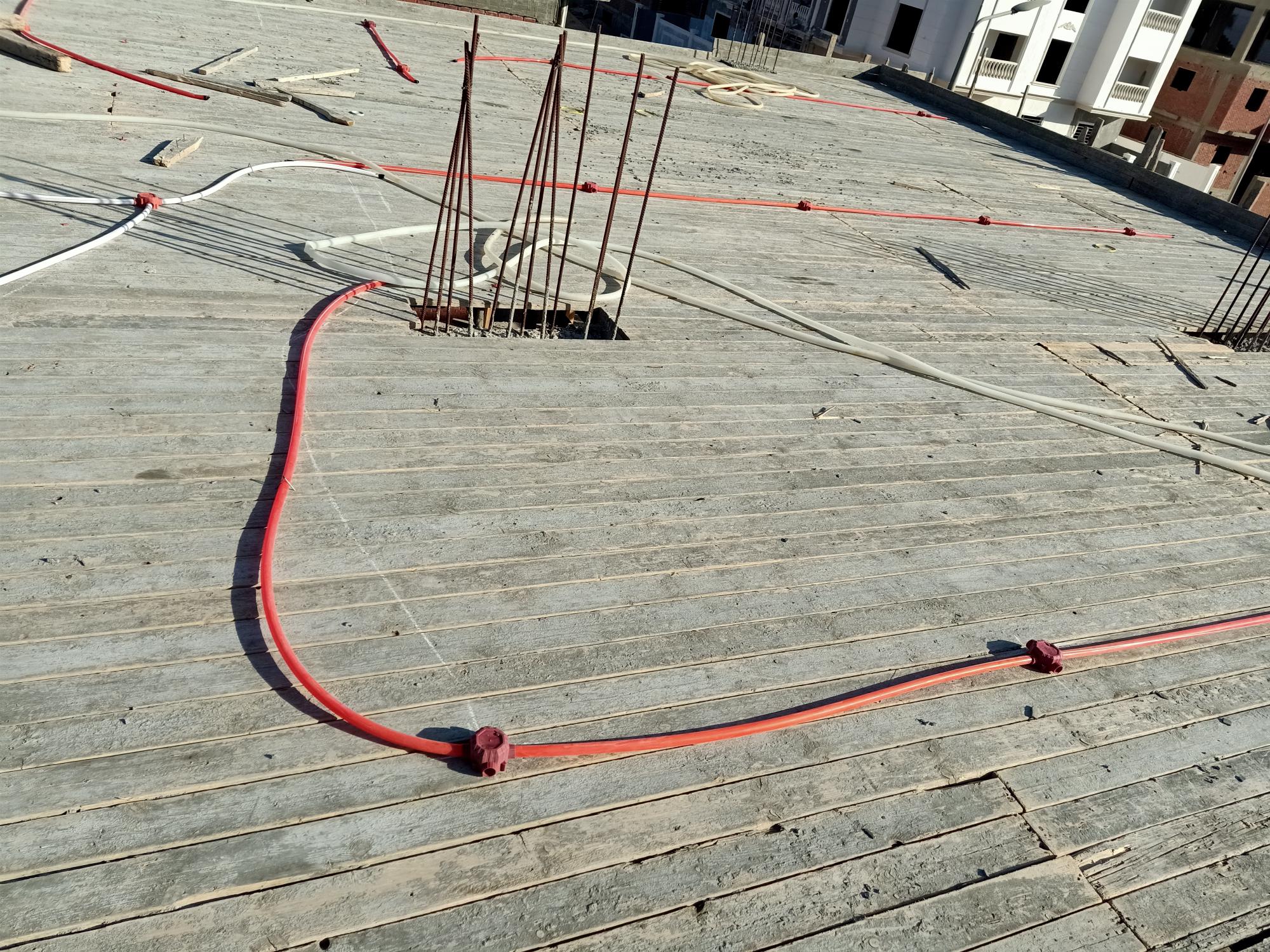

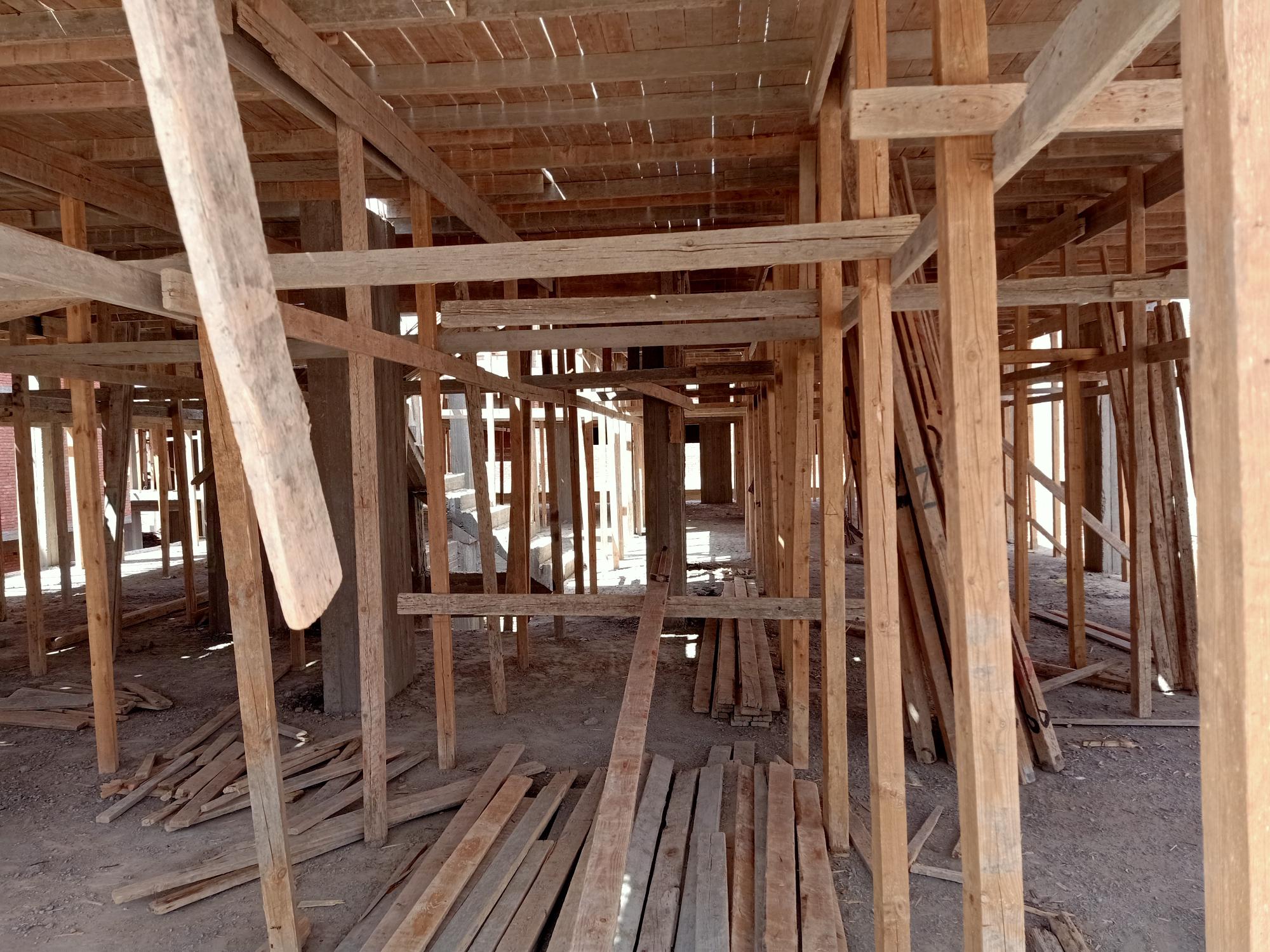

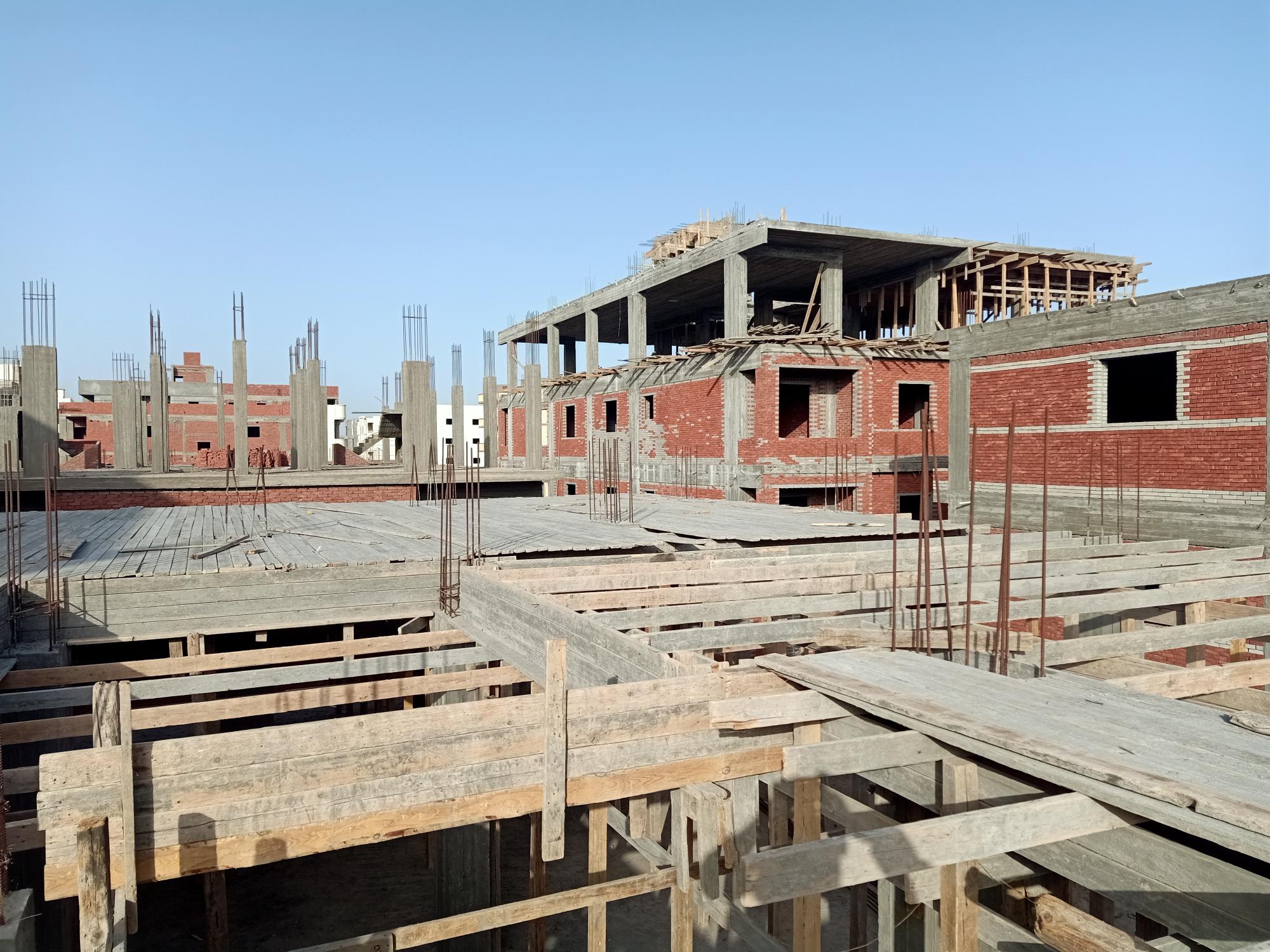

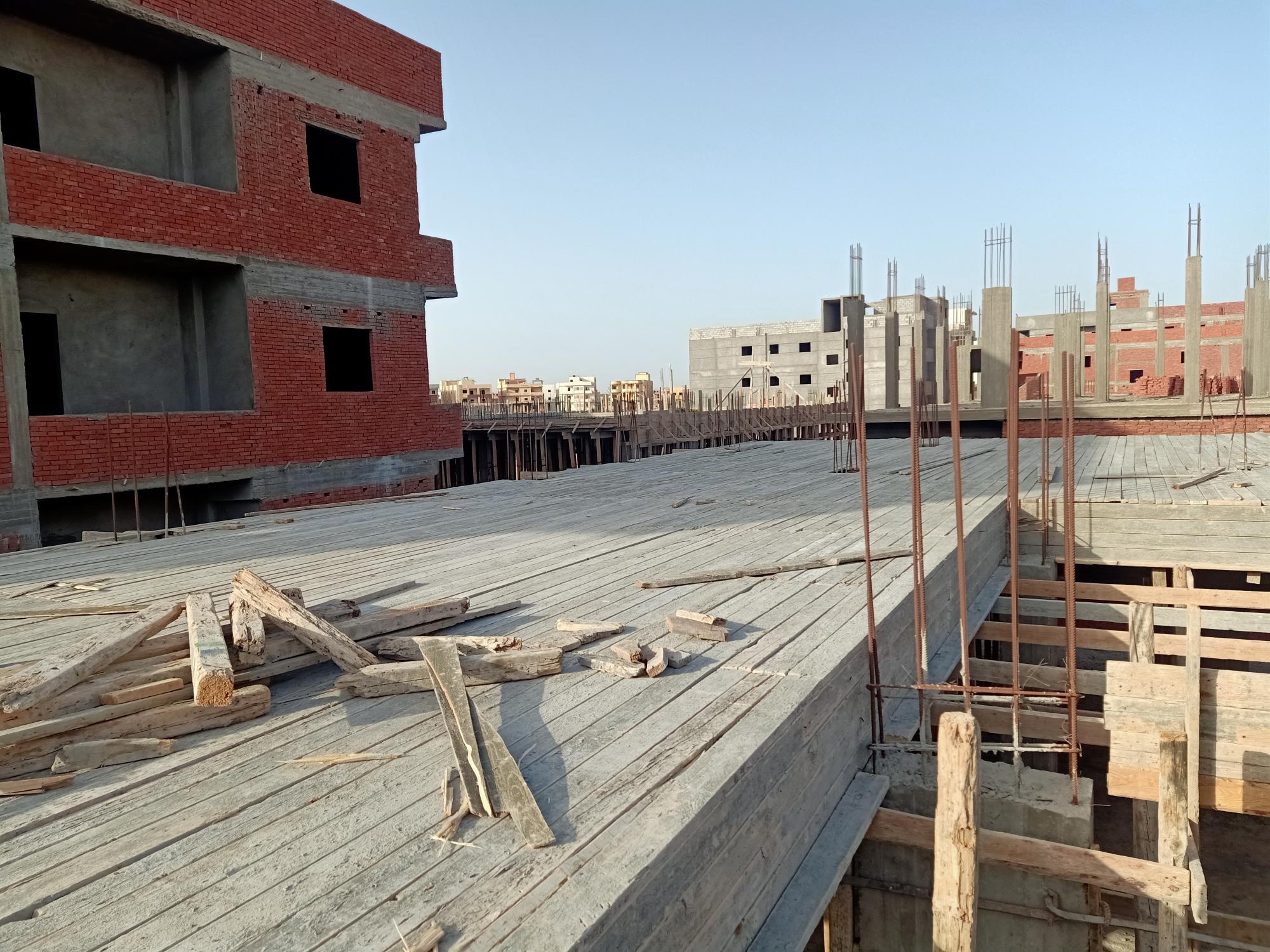

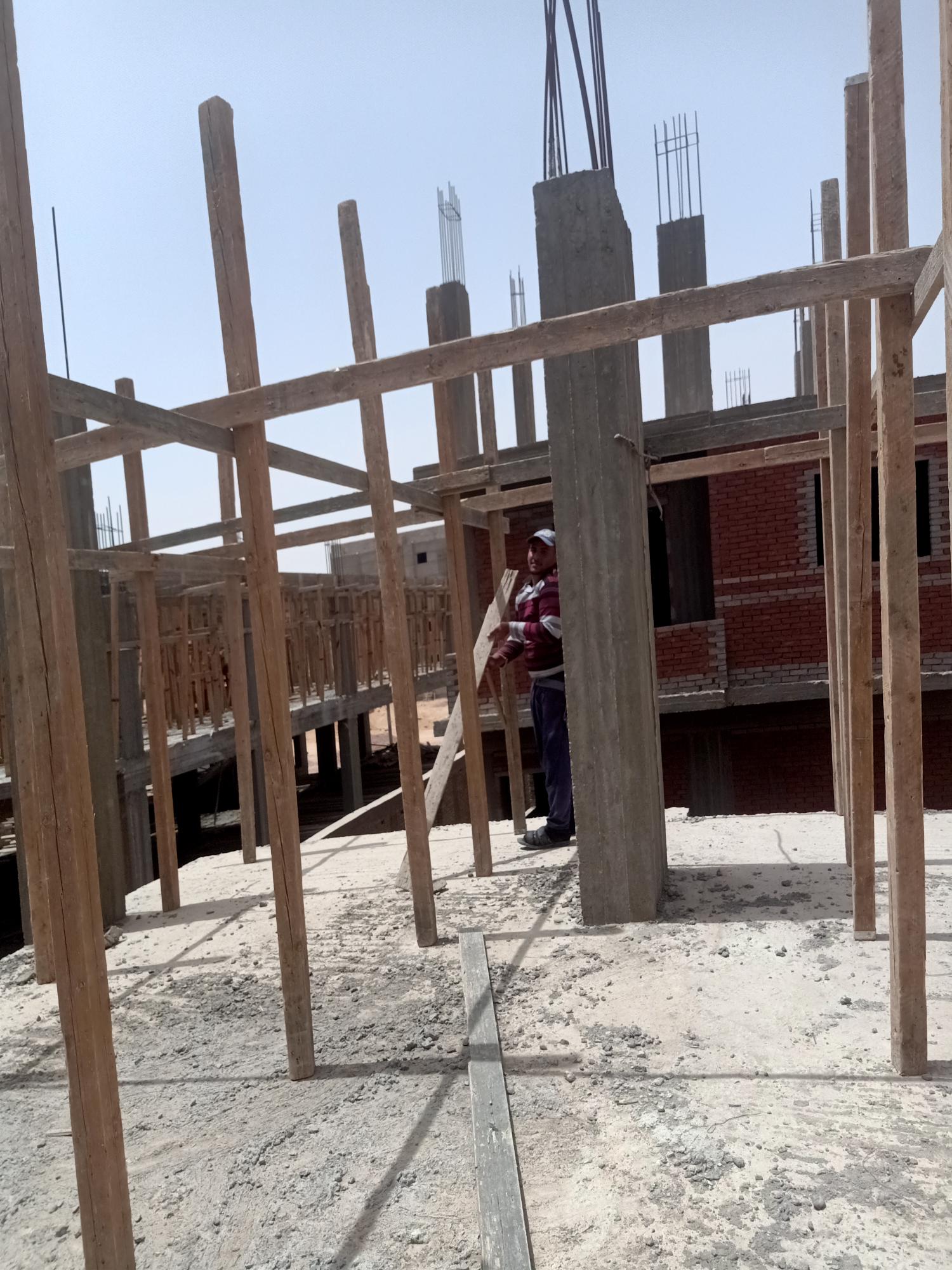

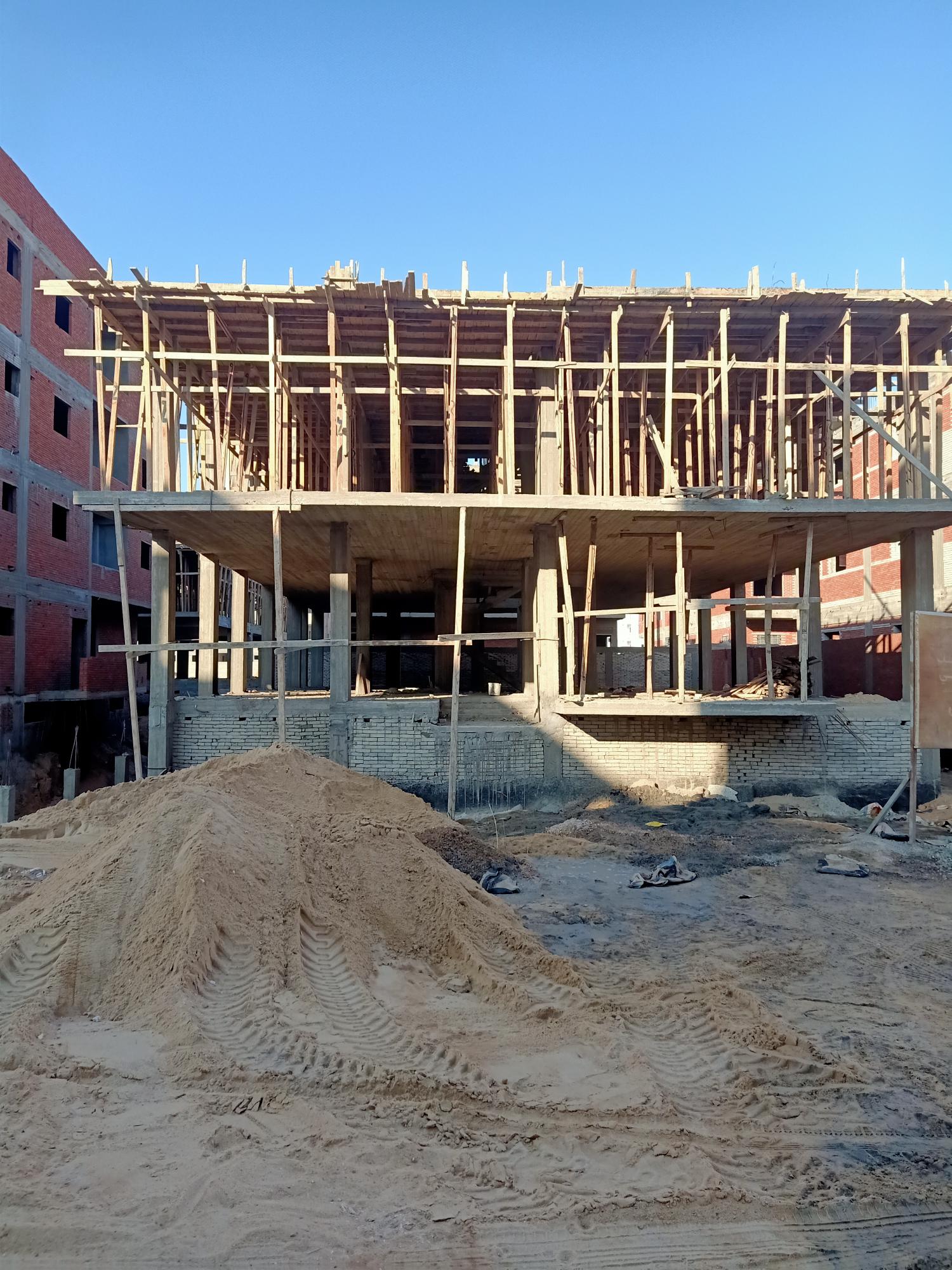

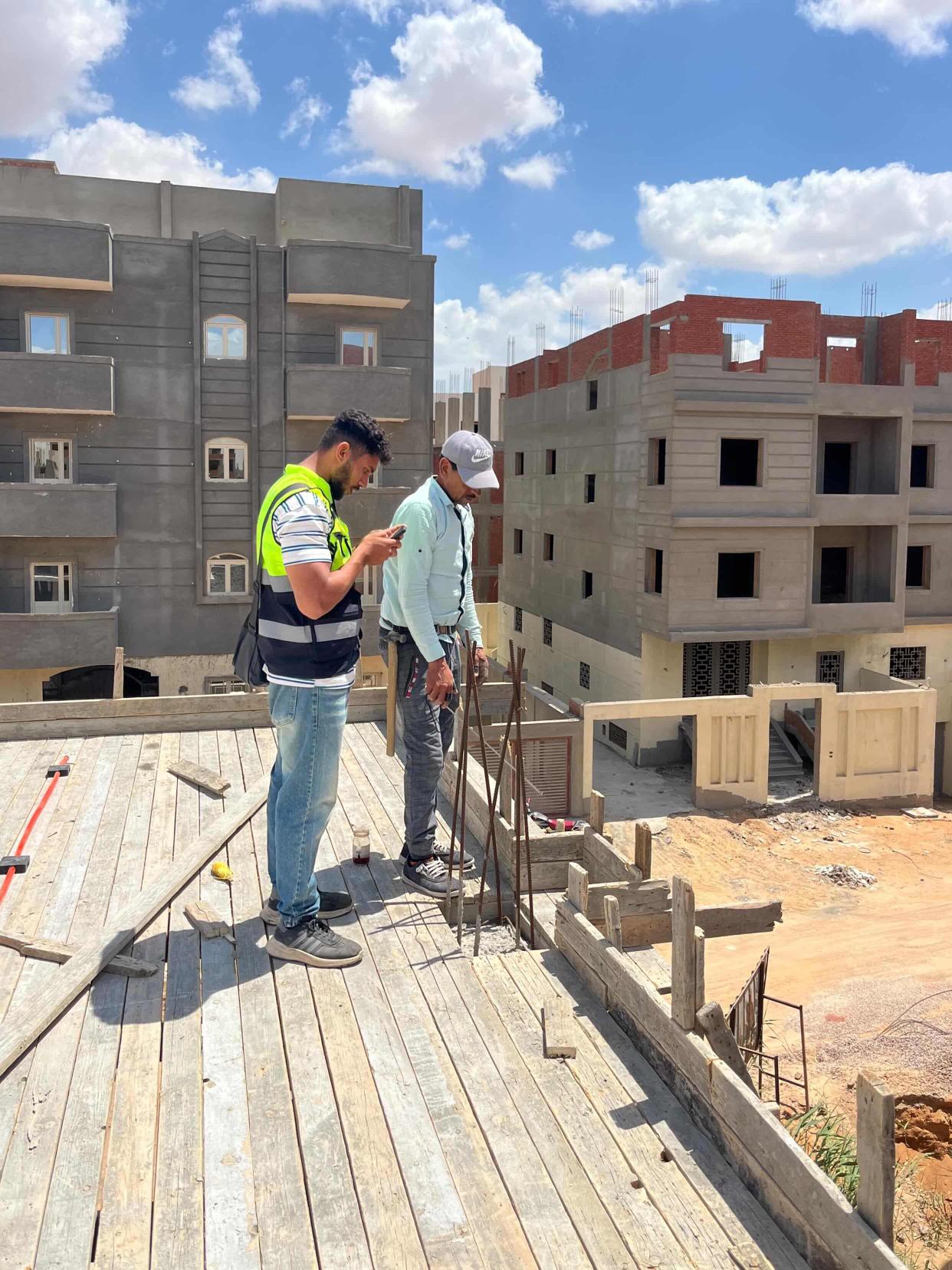

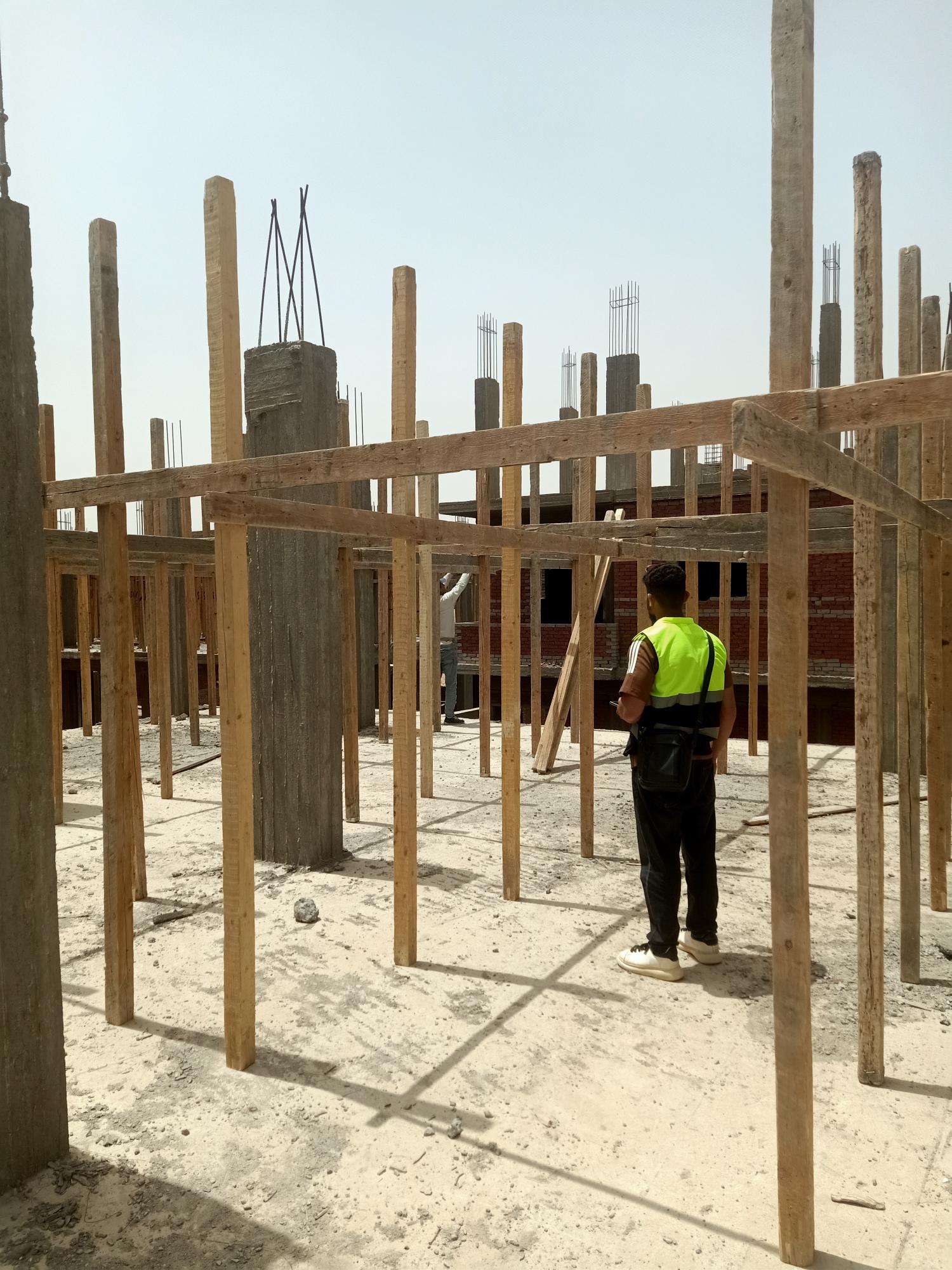

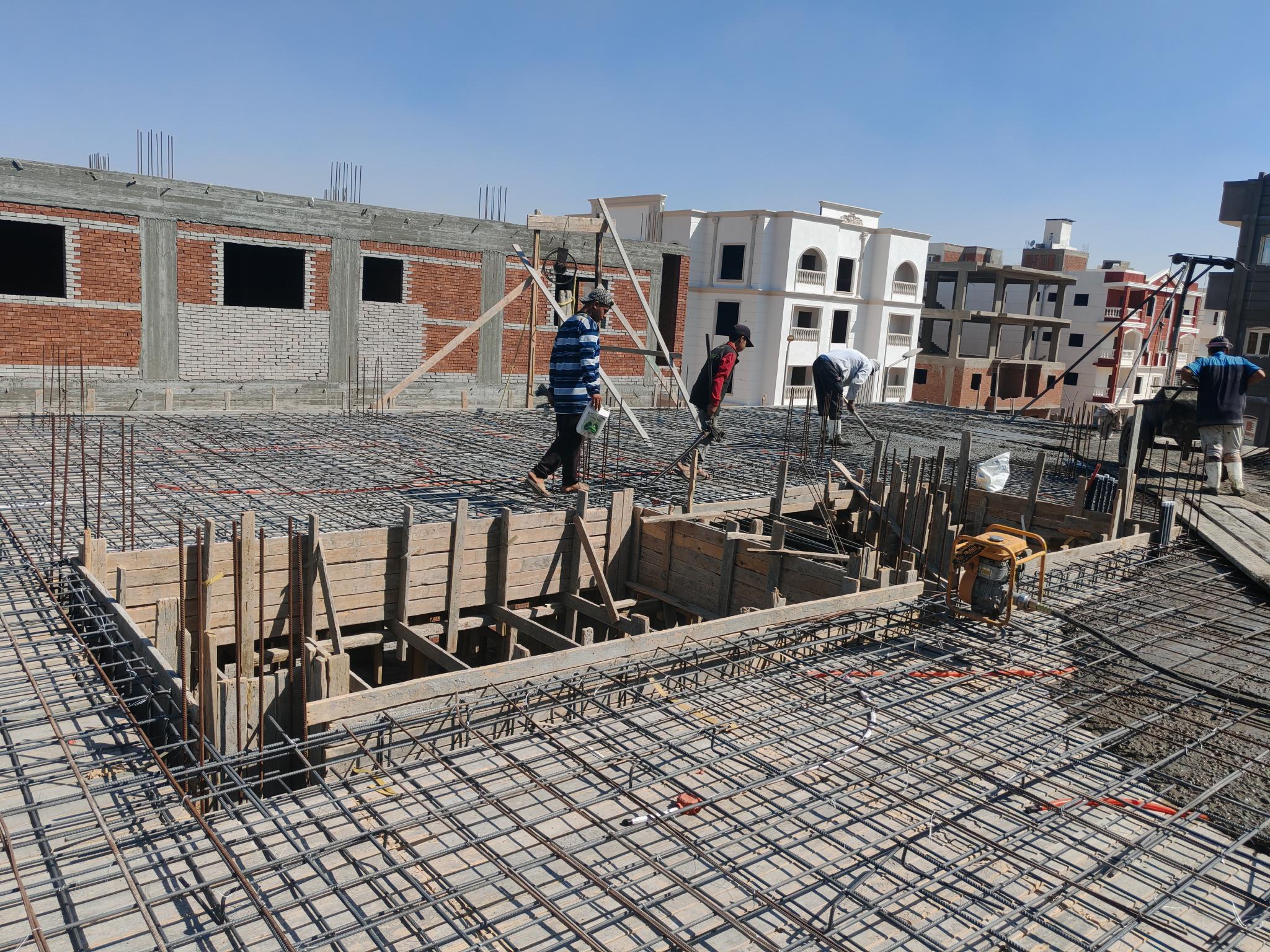

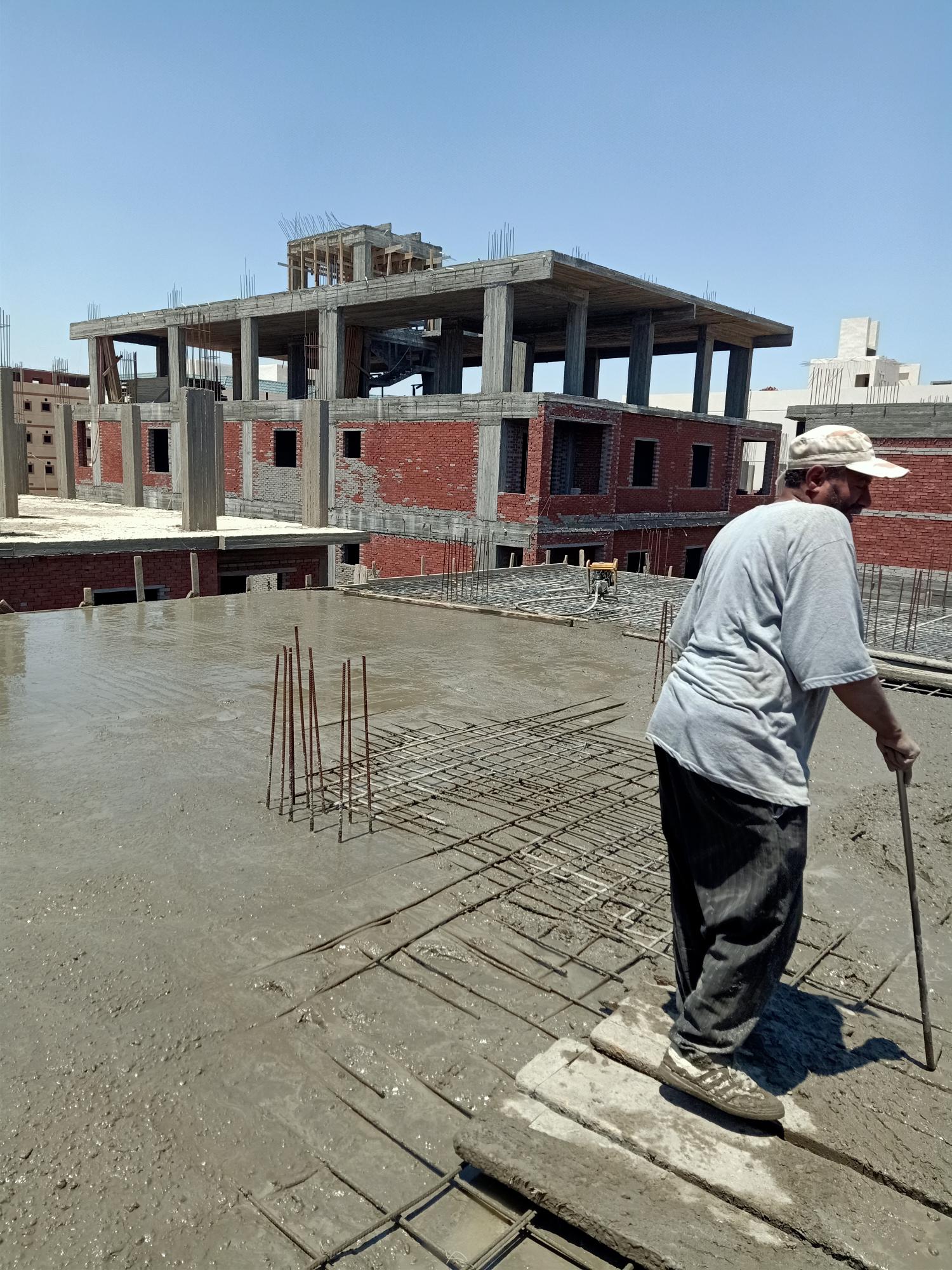

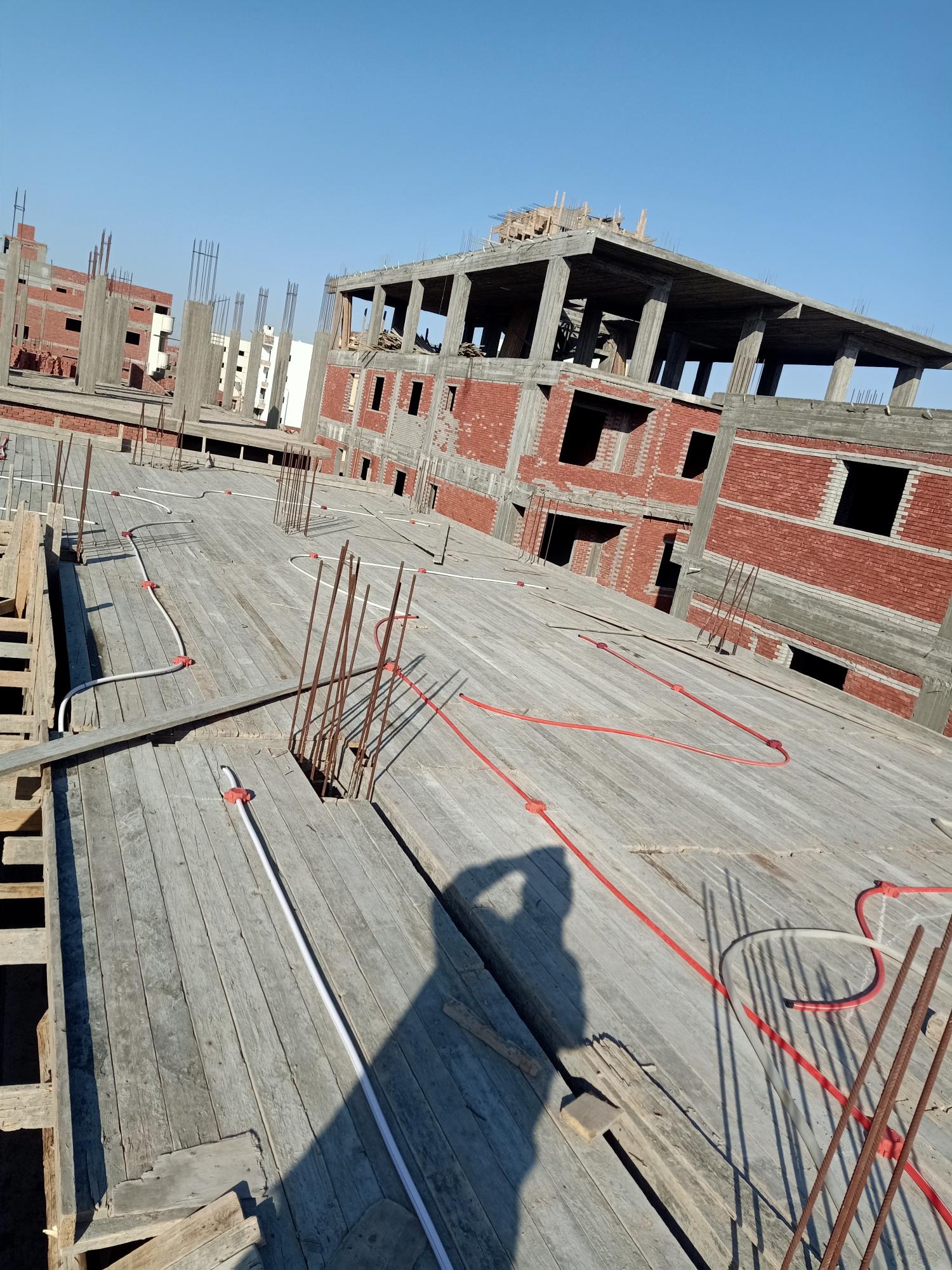

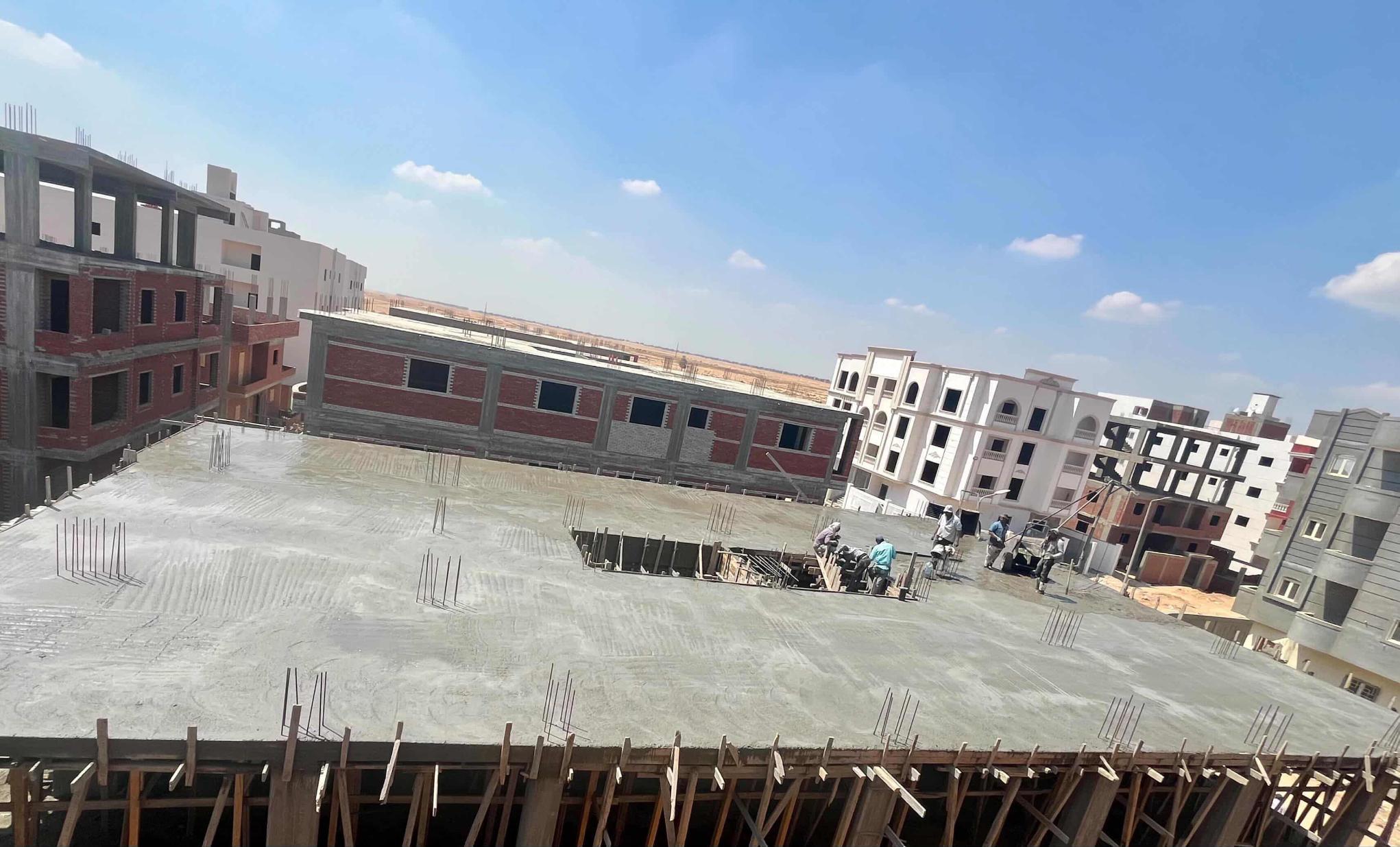

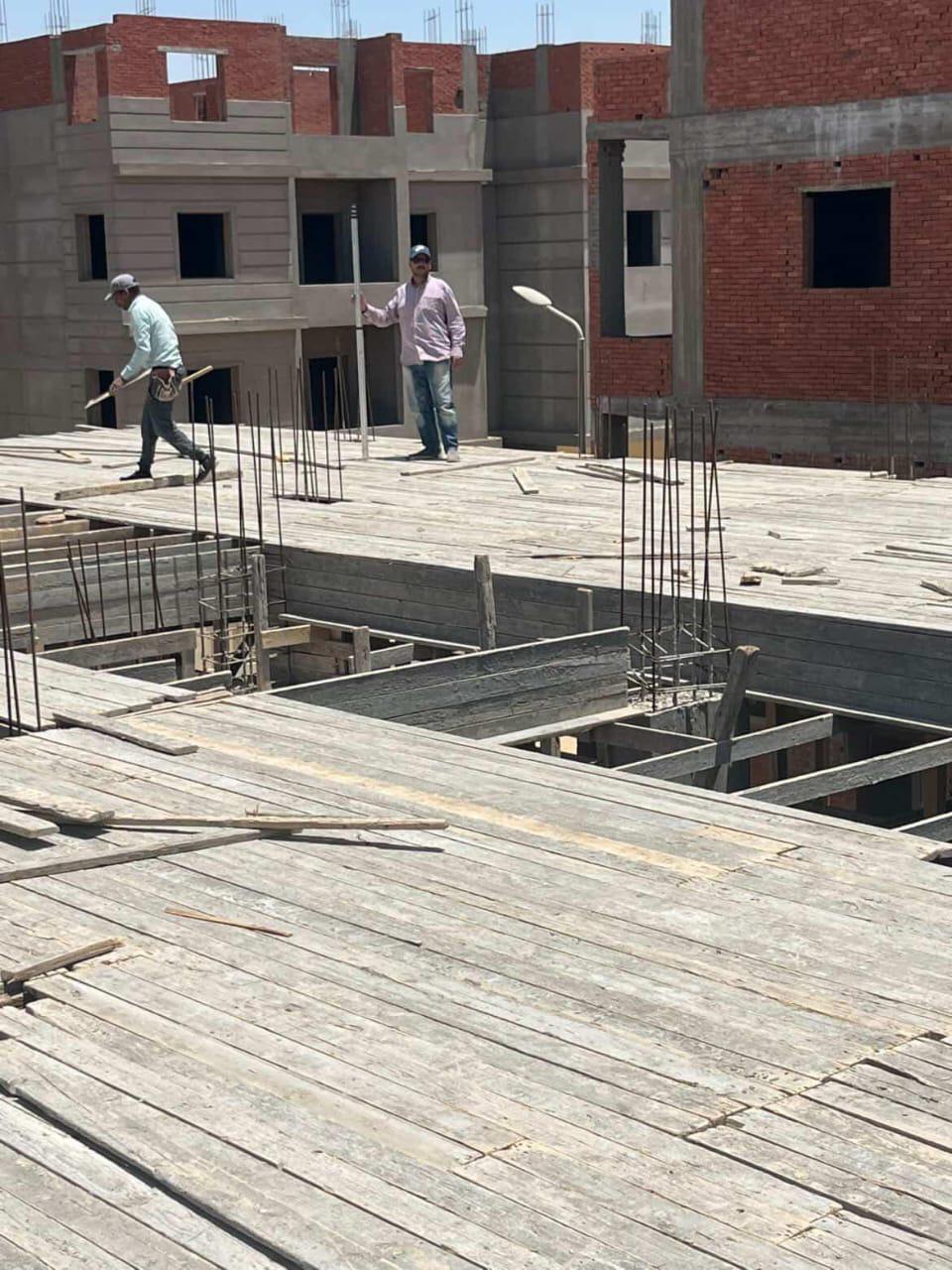

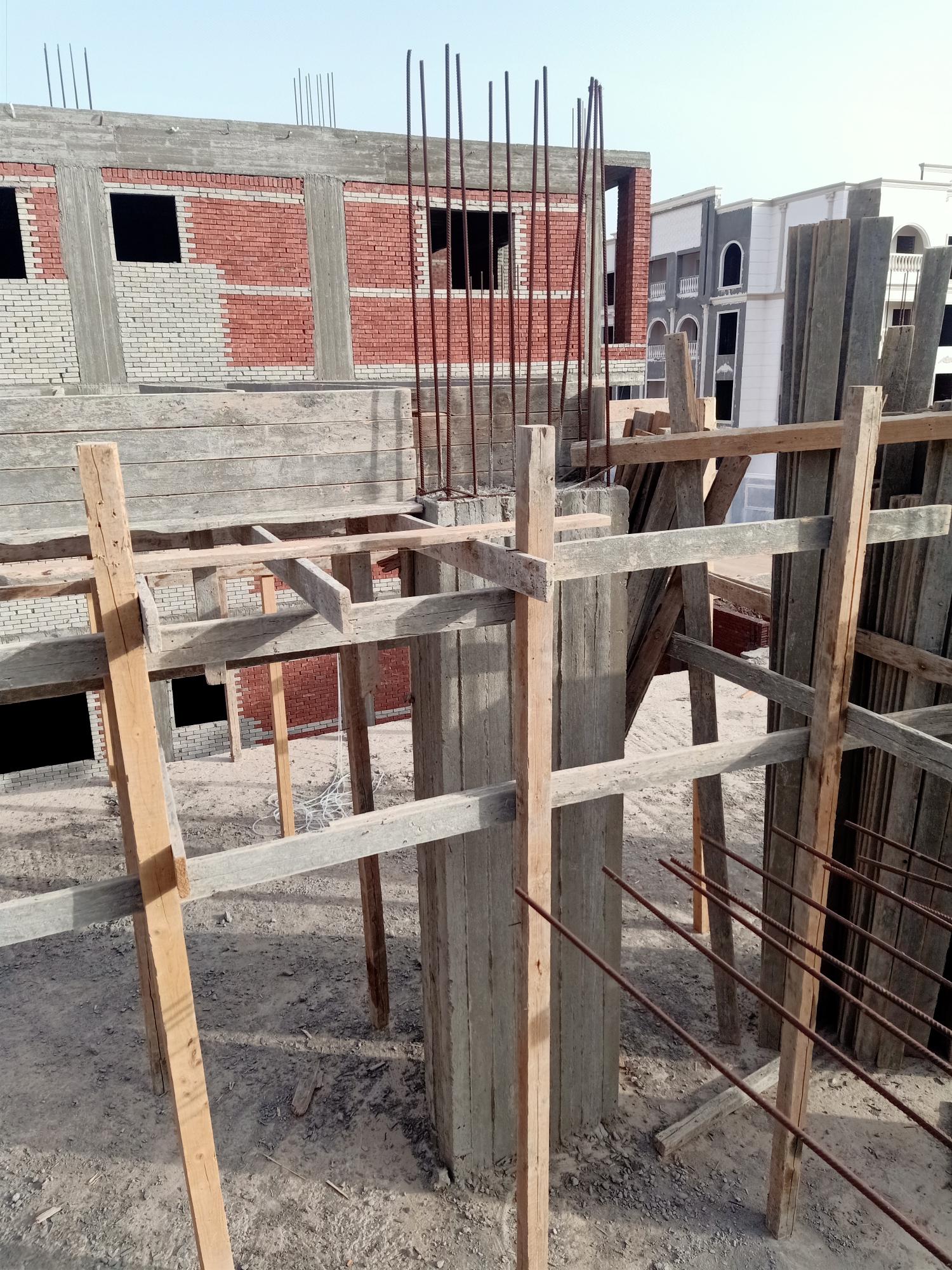

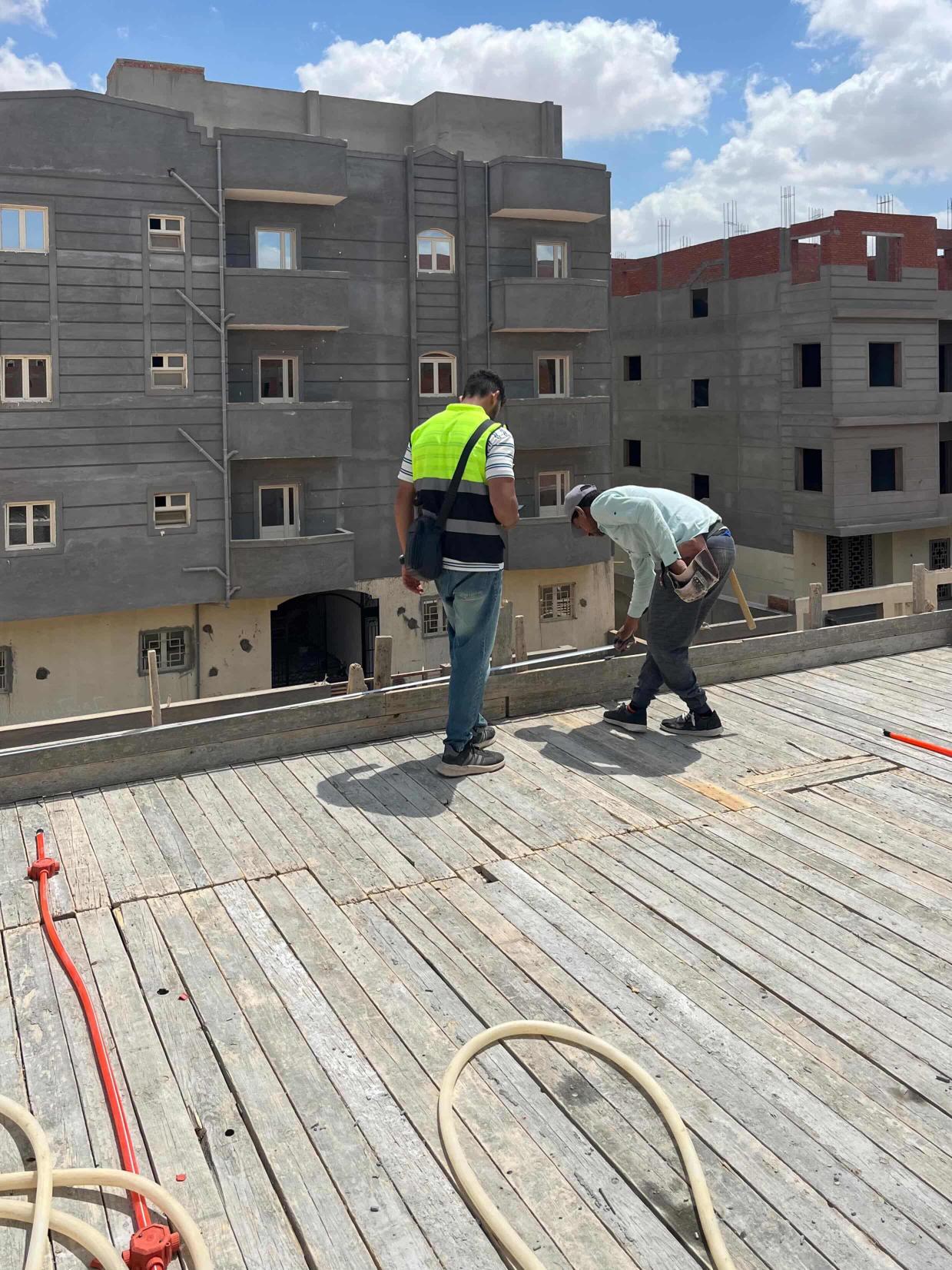

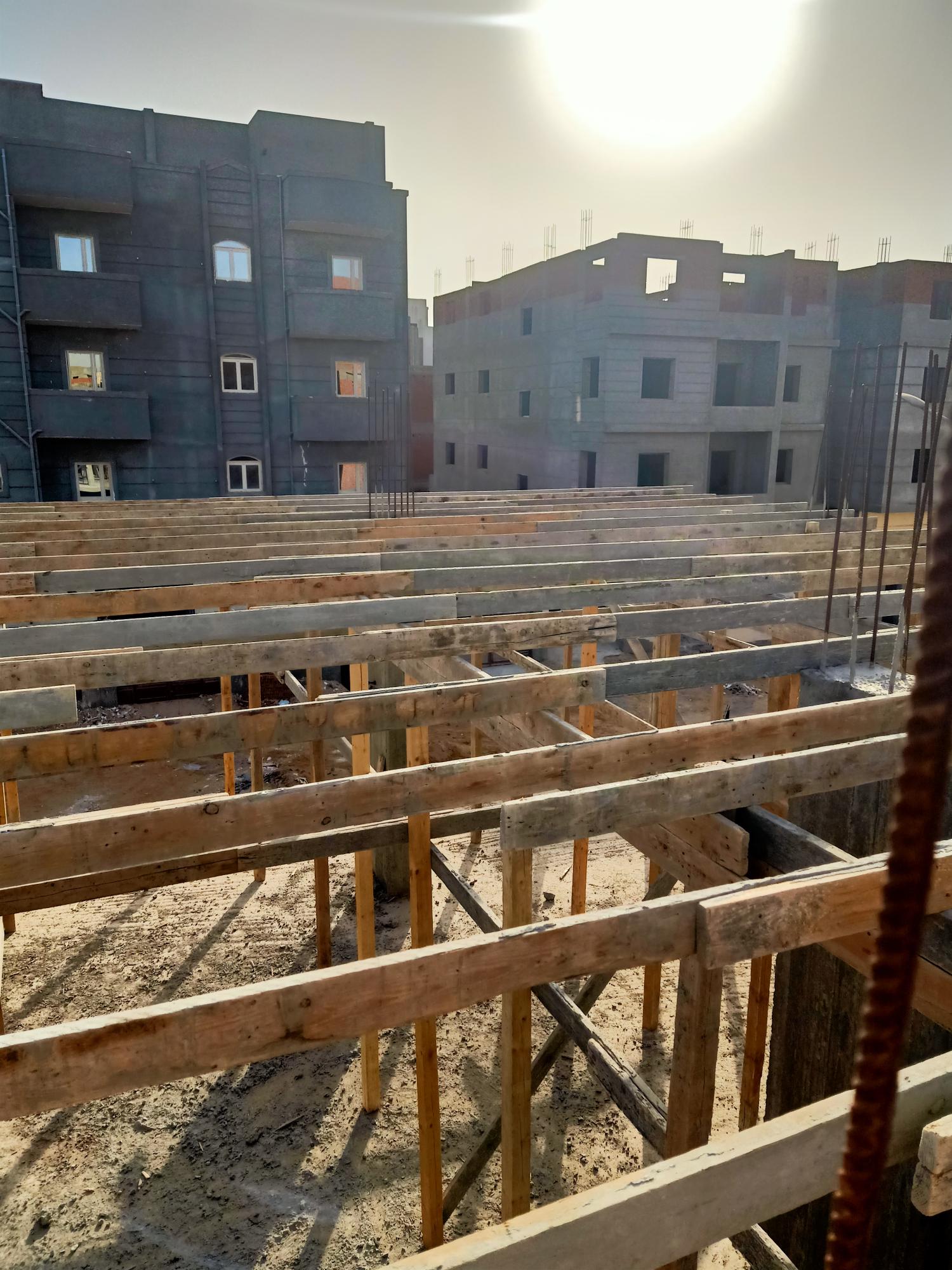

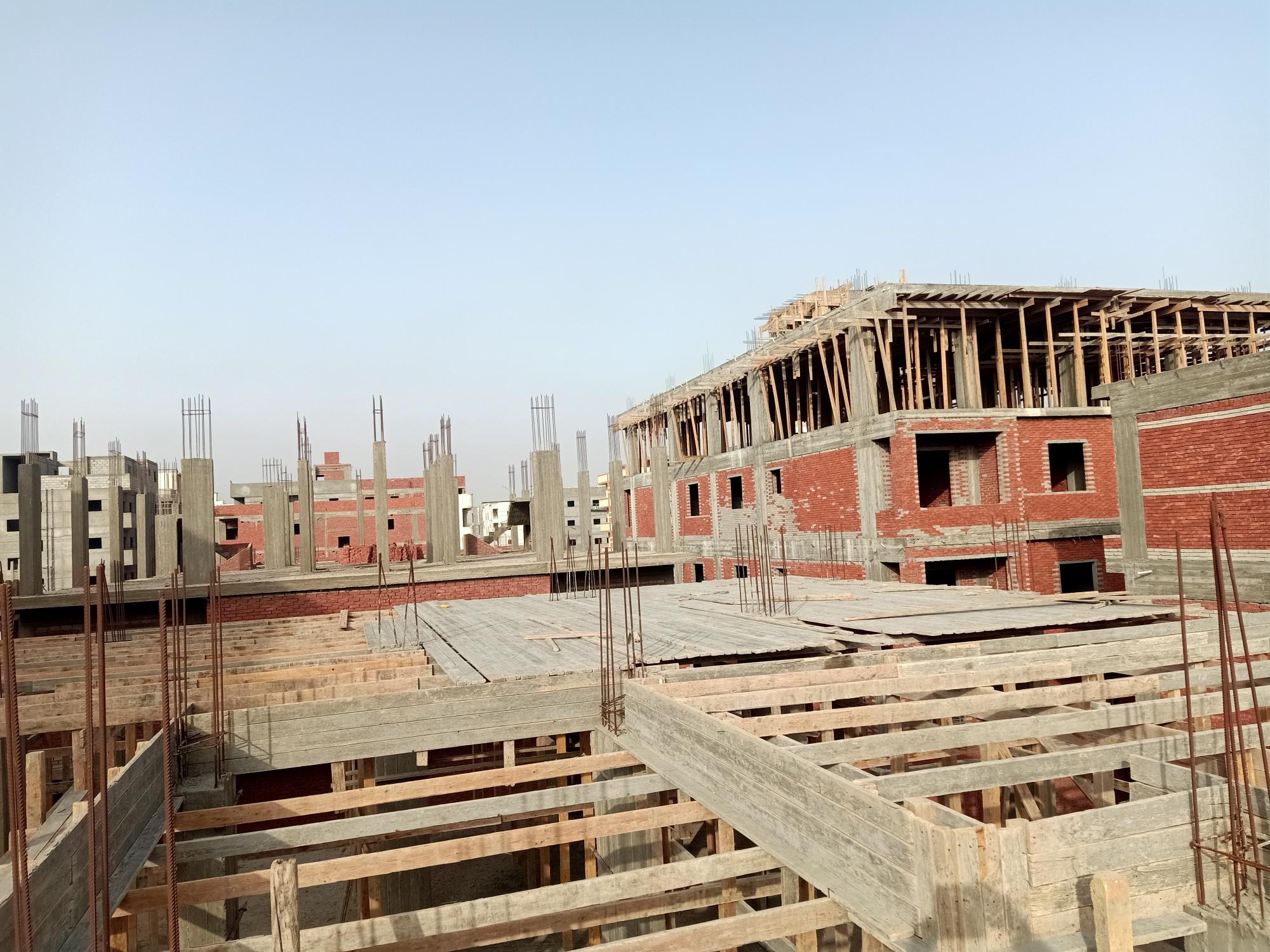

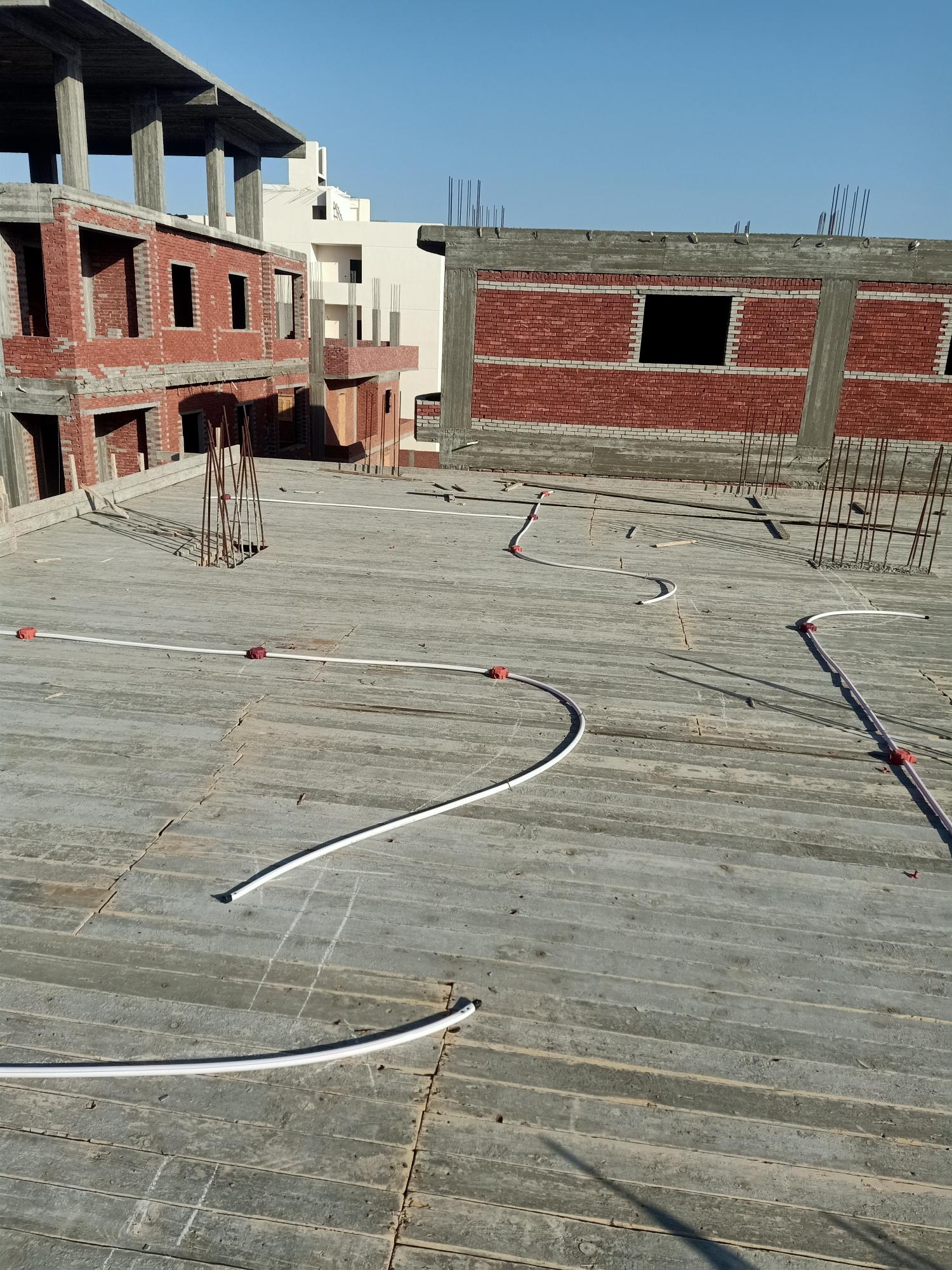

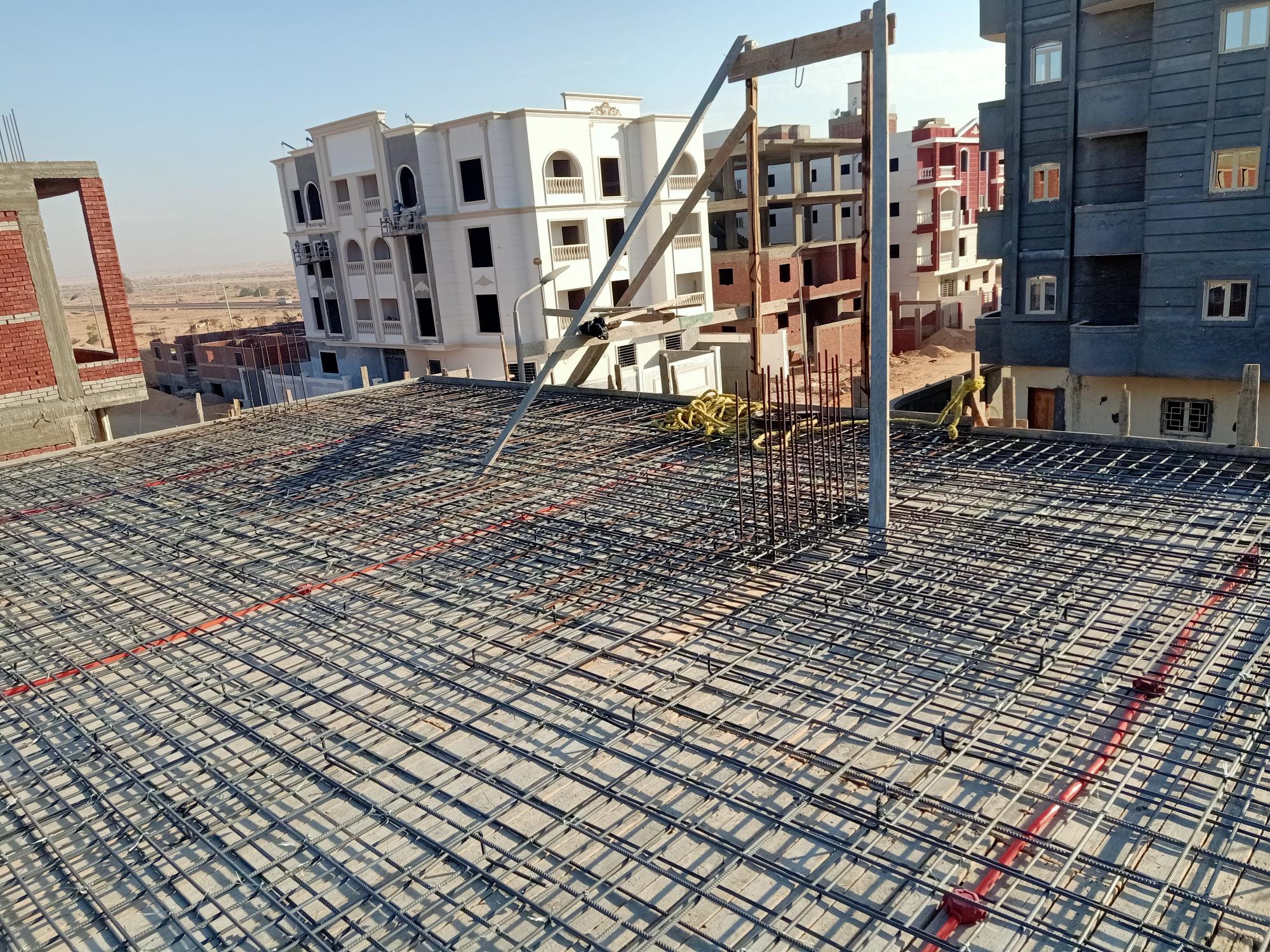

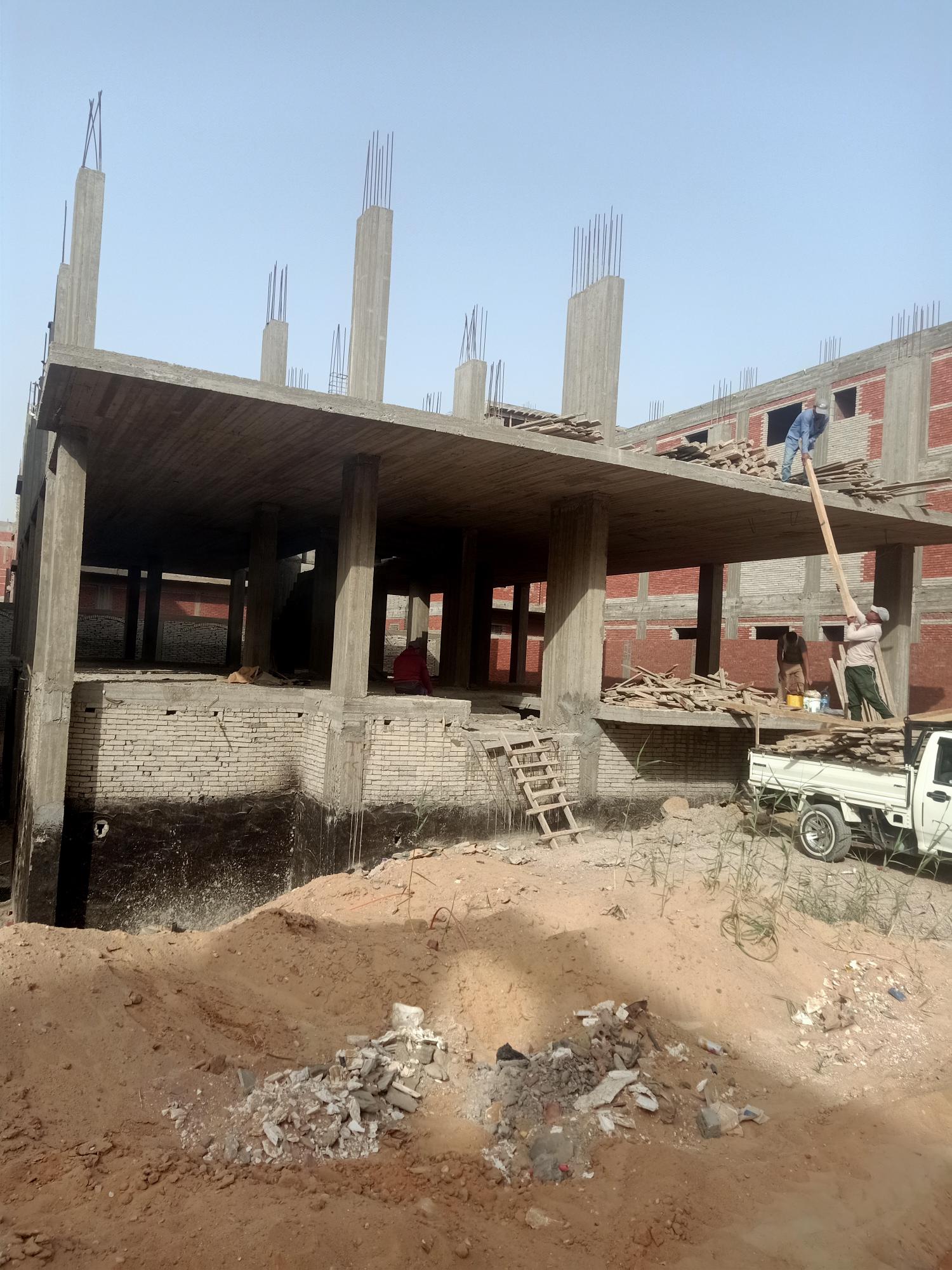

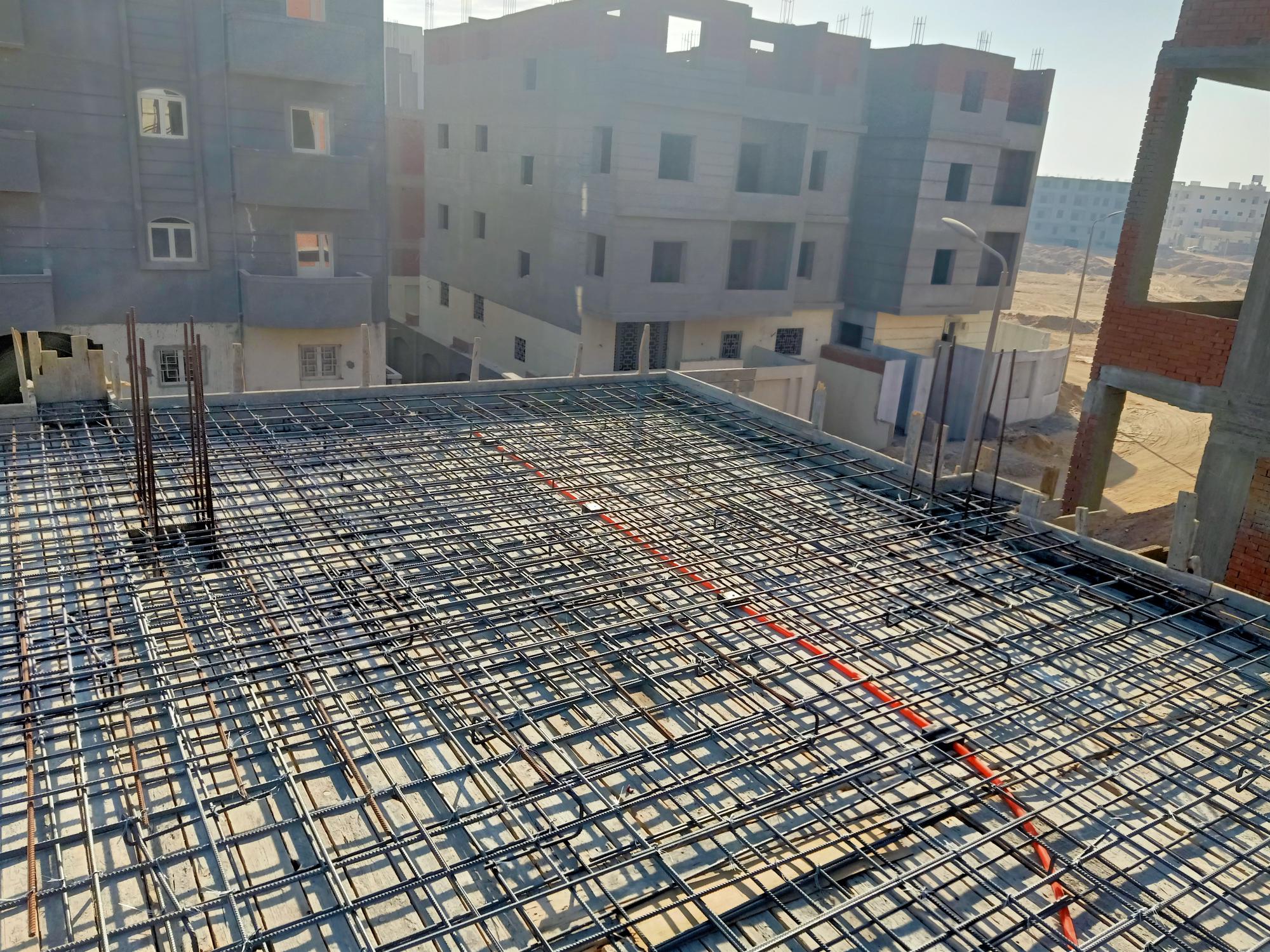

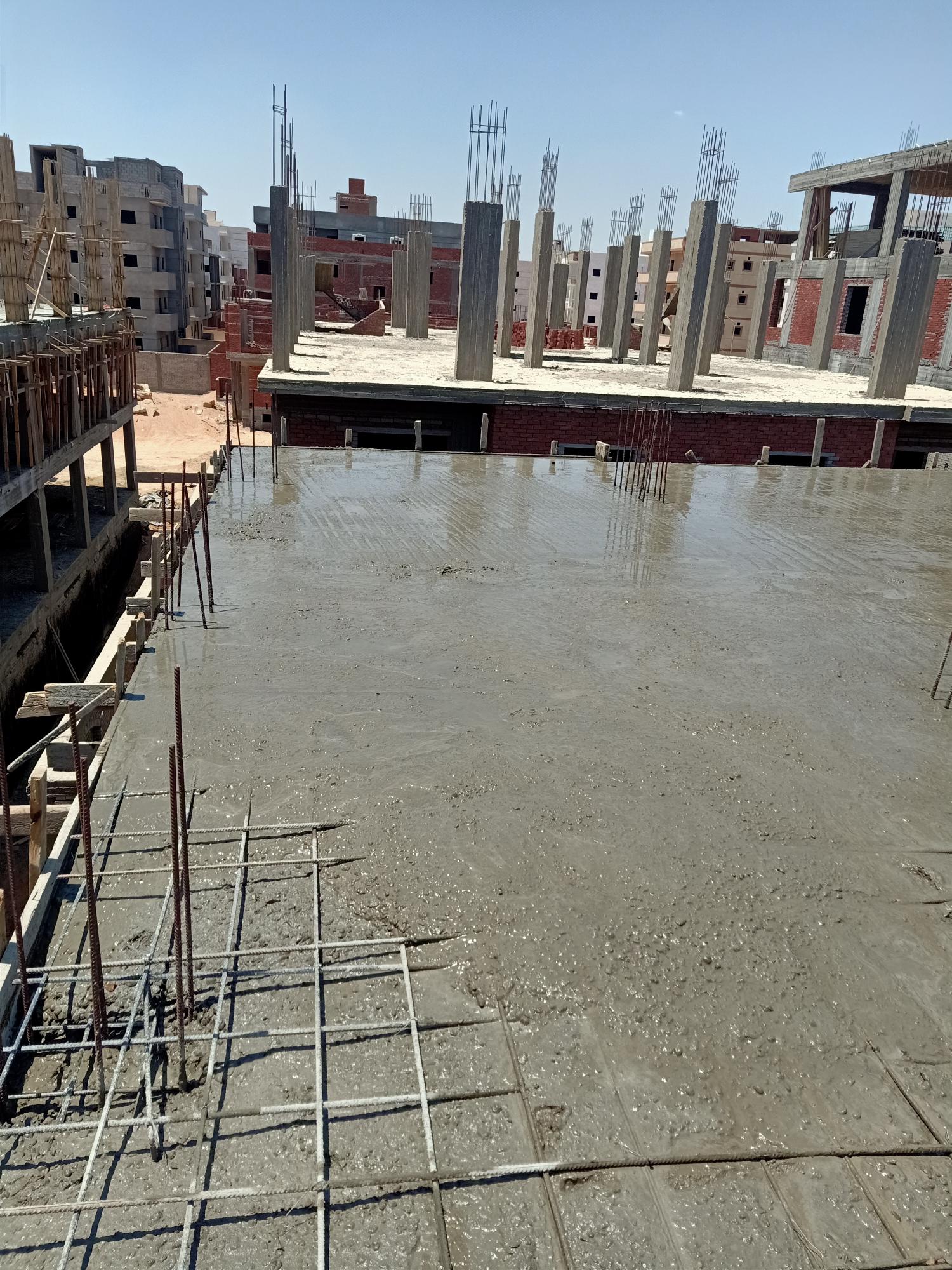

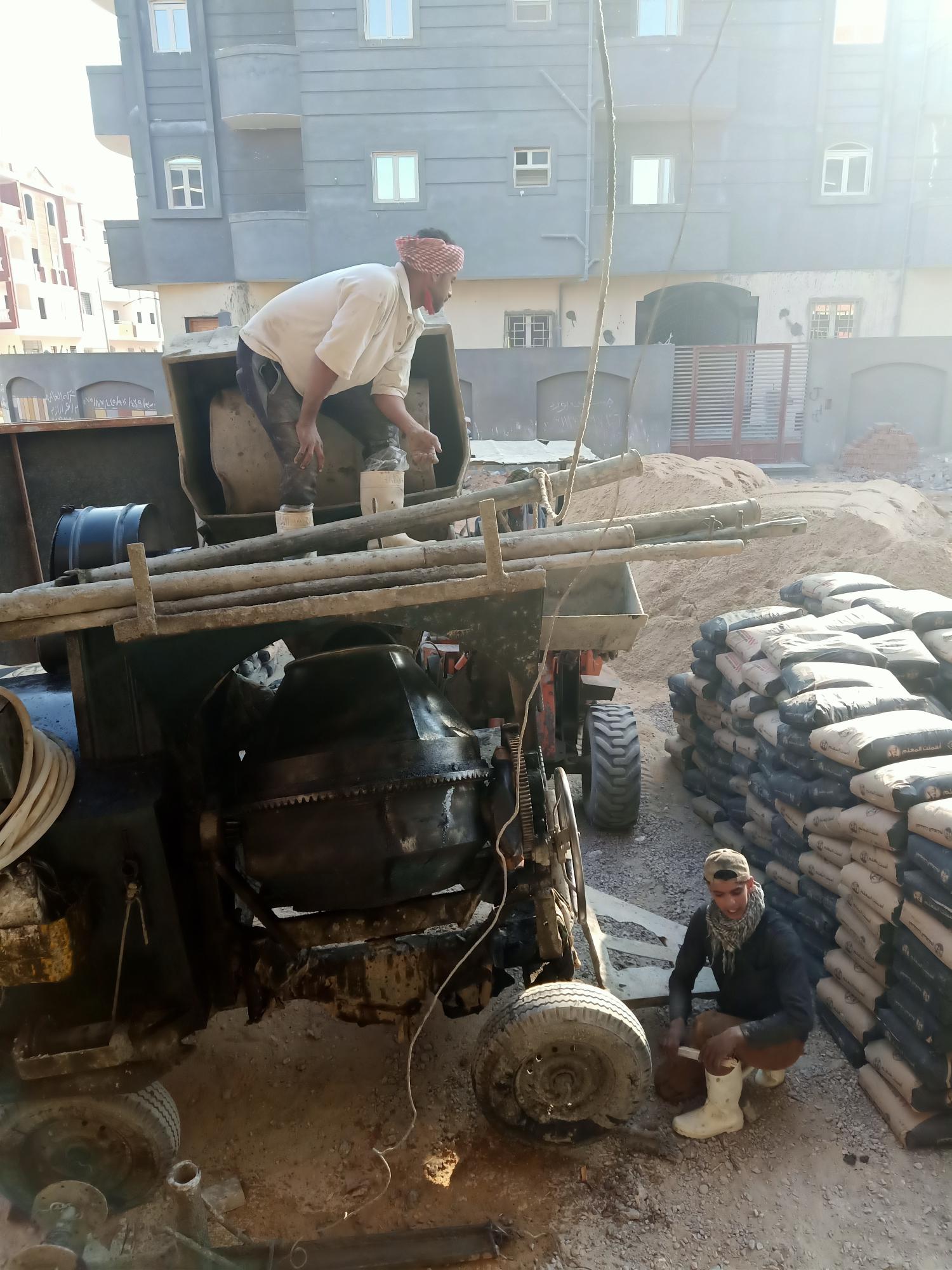

First floor slab

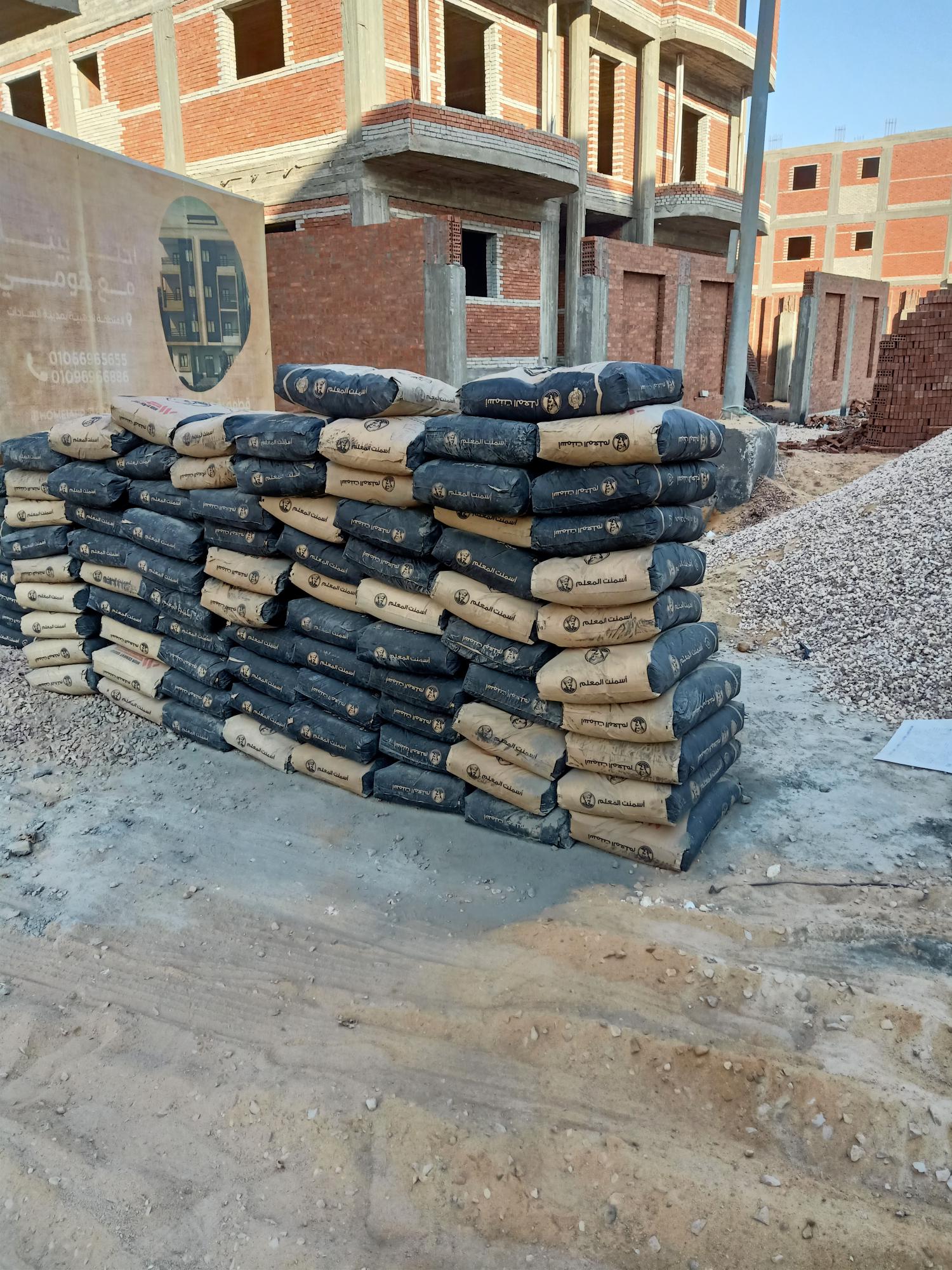

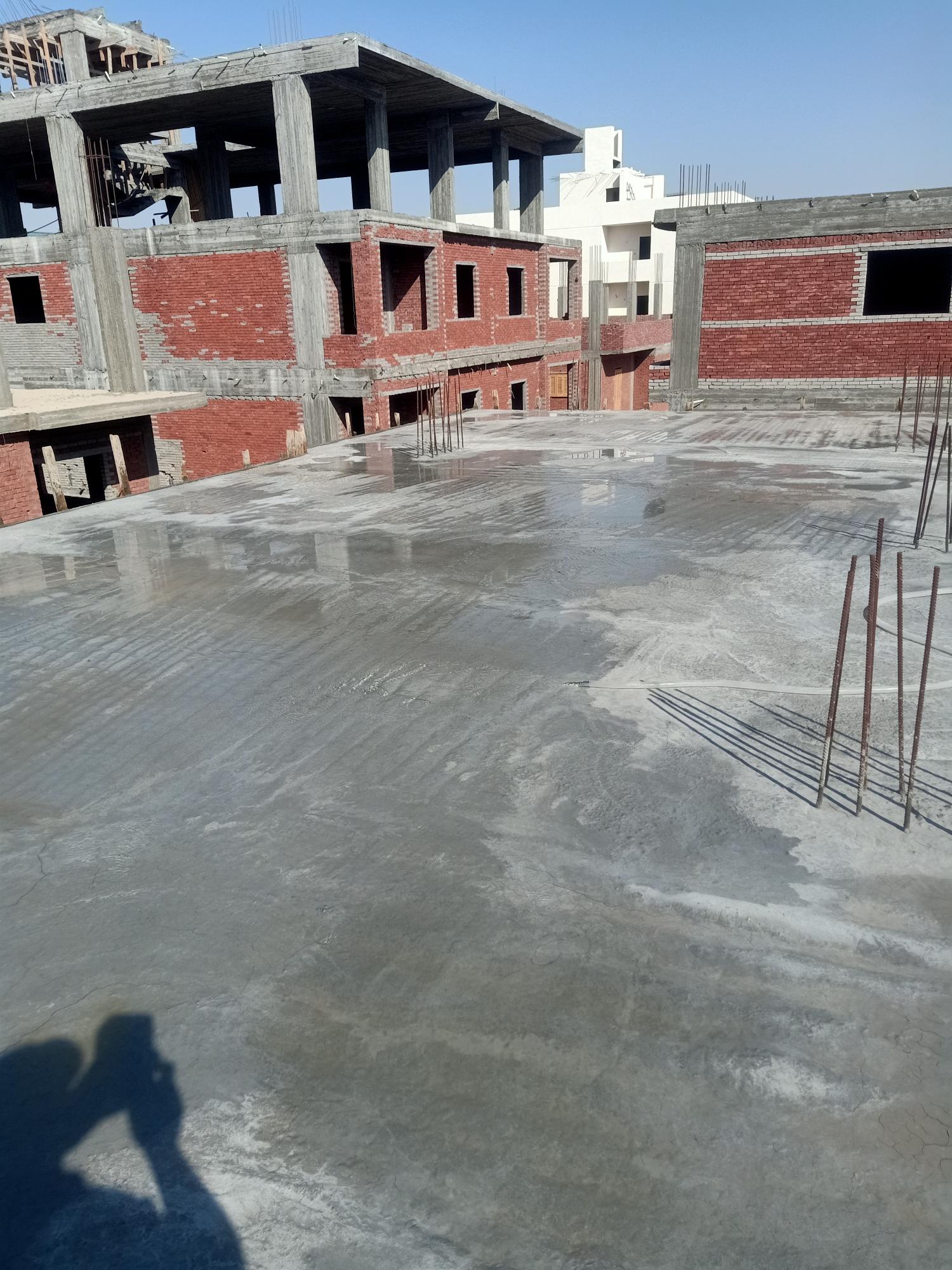

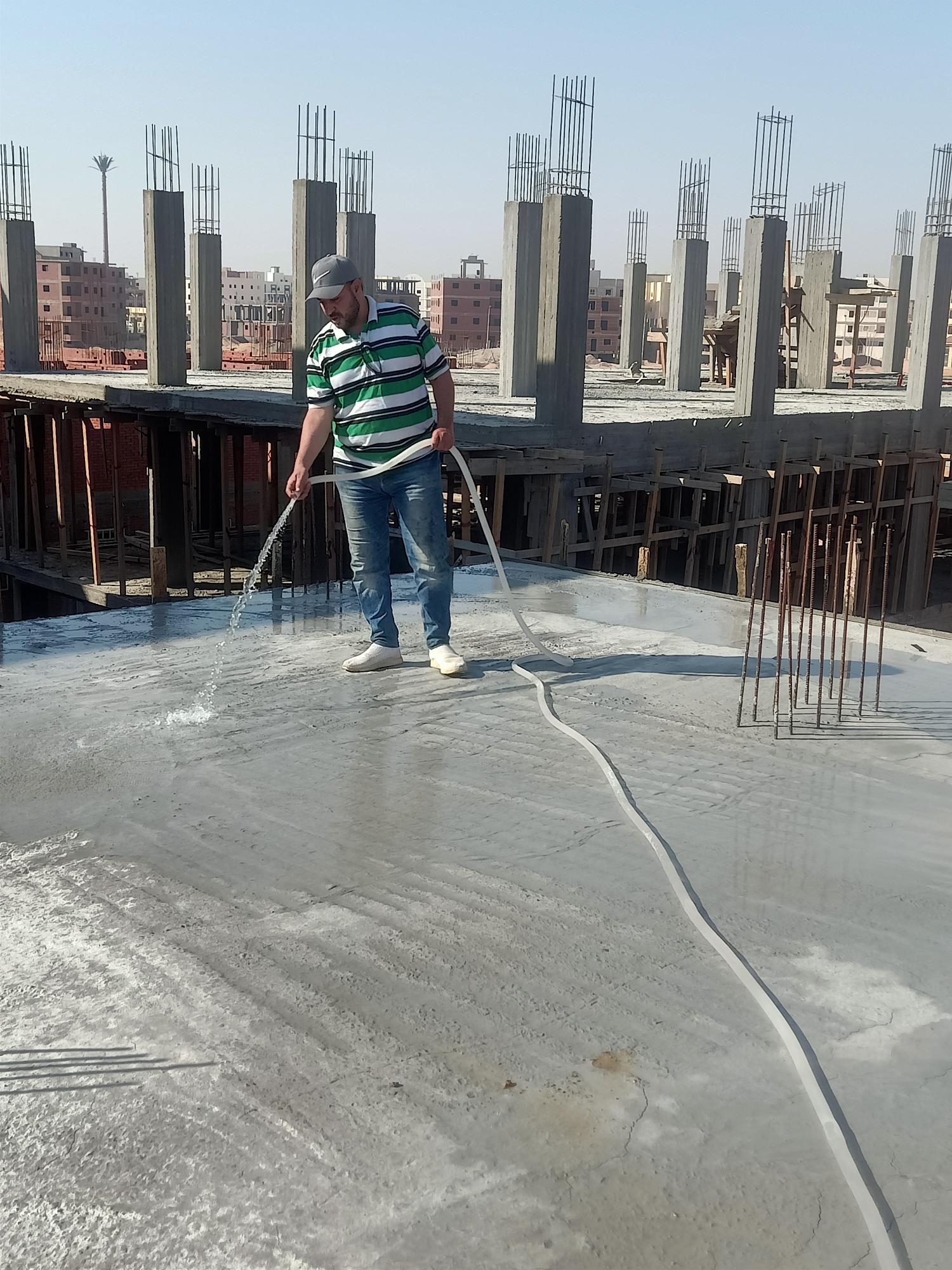

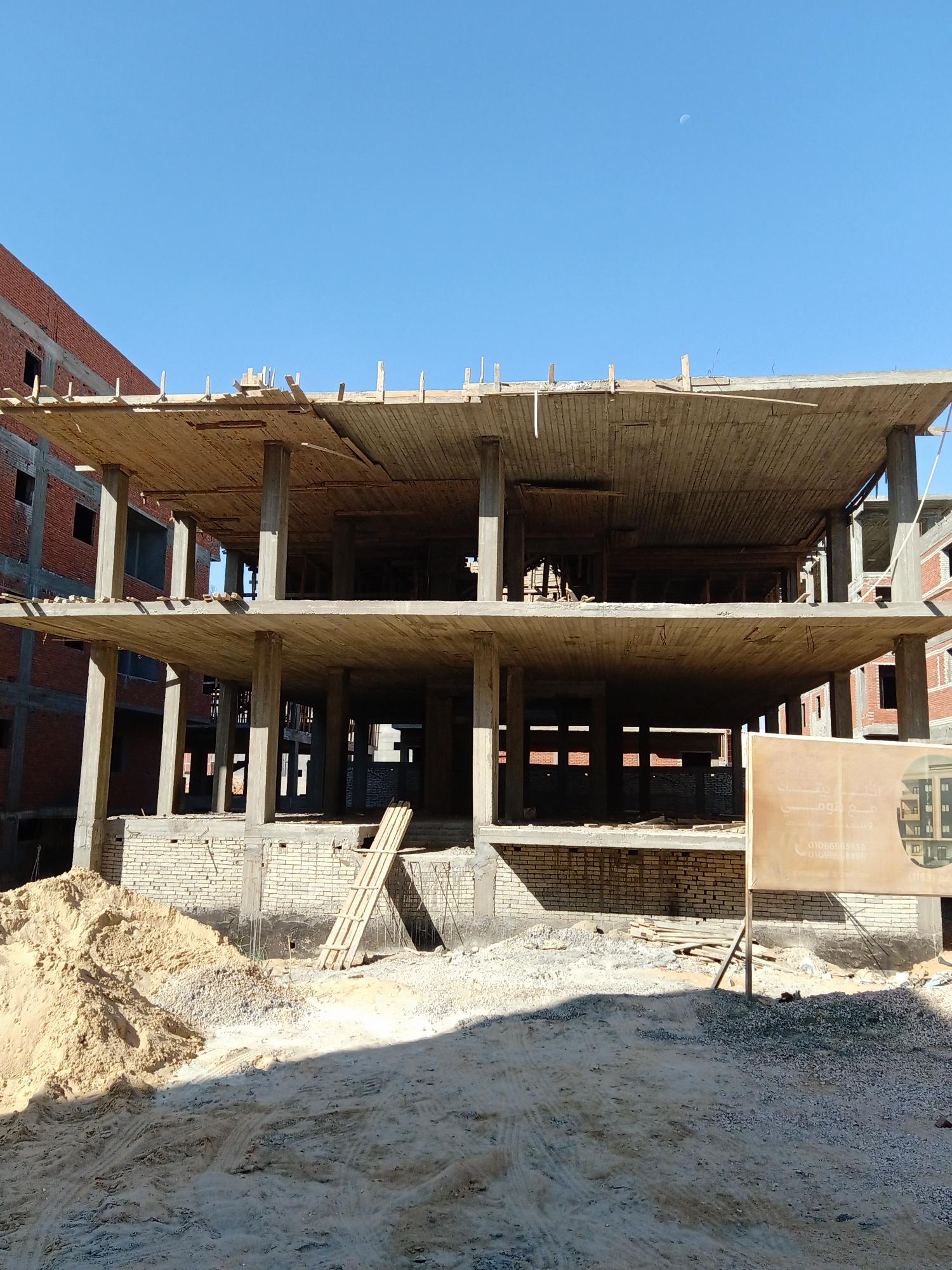

October 28, 2025
Second floor columns
November 7, 2025
Second floor slab
November 22, 2025
Submitting third-floor extension license
November 23, 2025
Receiving third-floor extension license
February 20, 2026
Third floor columns
February 27, 2026
Fence columns
March 14, 2026
Wall Building works
March 15, 2026
Third floor slab
March 20, 2026
Roof extension license
June 18, 2026
Roof room columns
June 28, 2026
Roof room slab
July 19, 2026

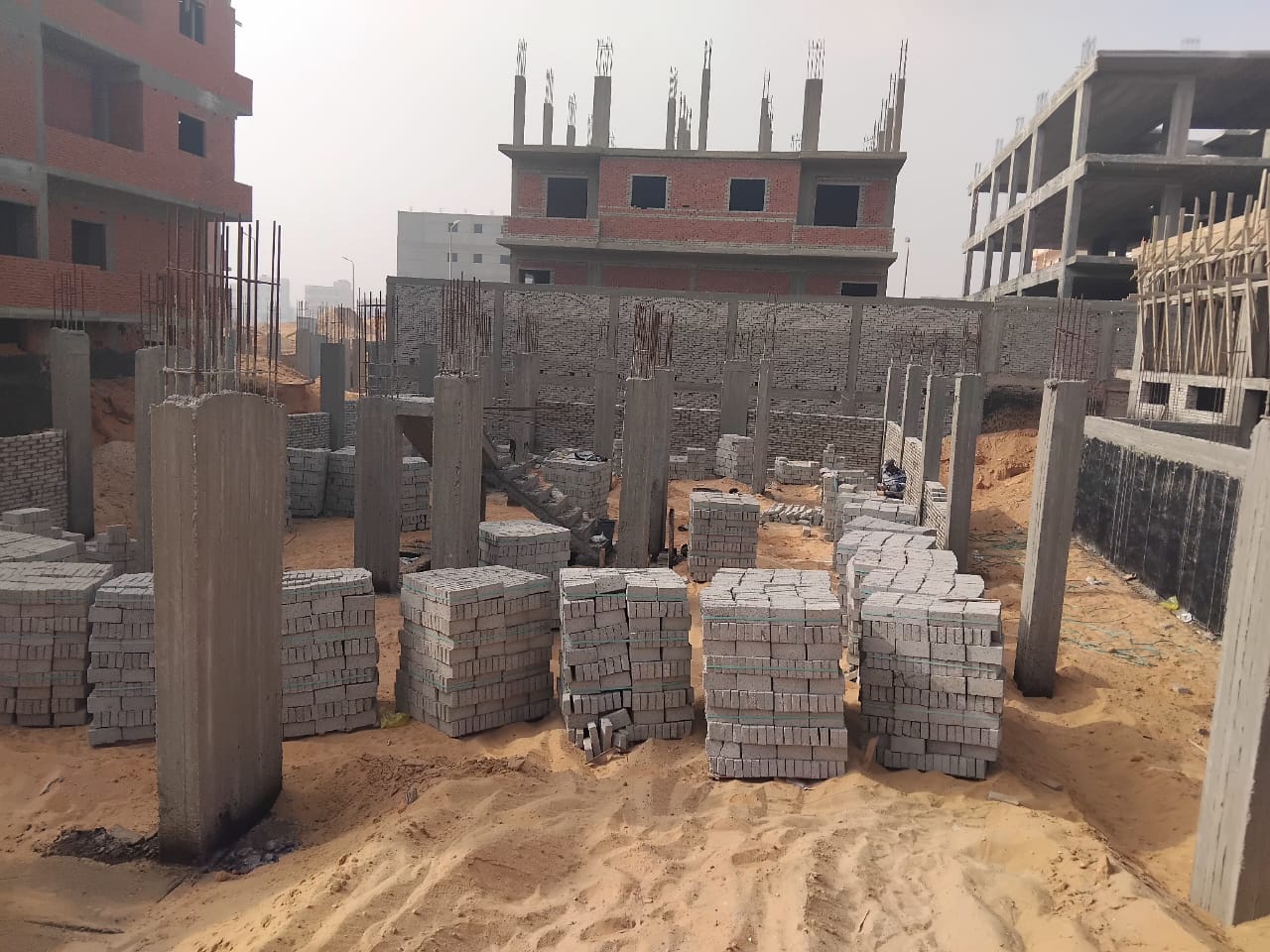

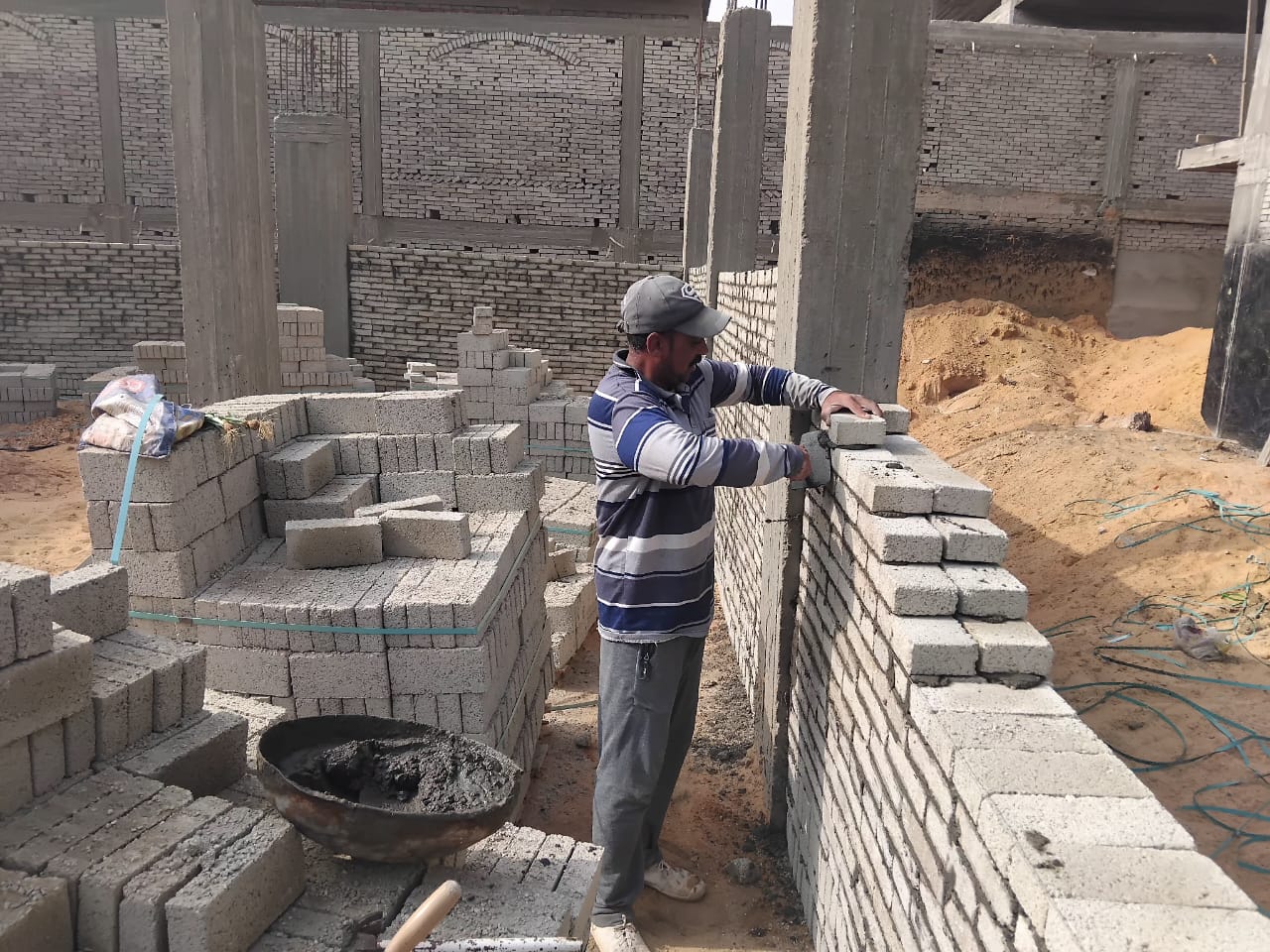

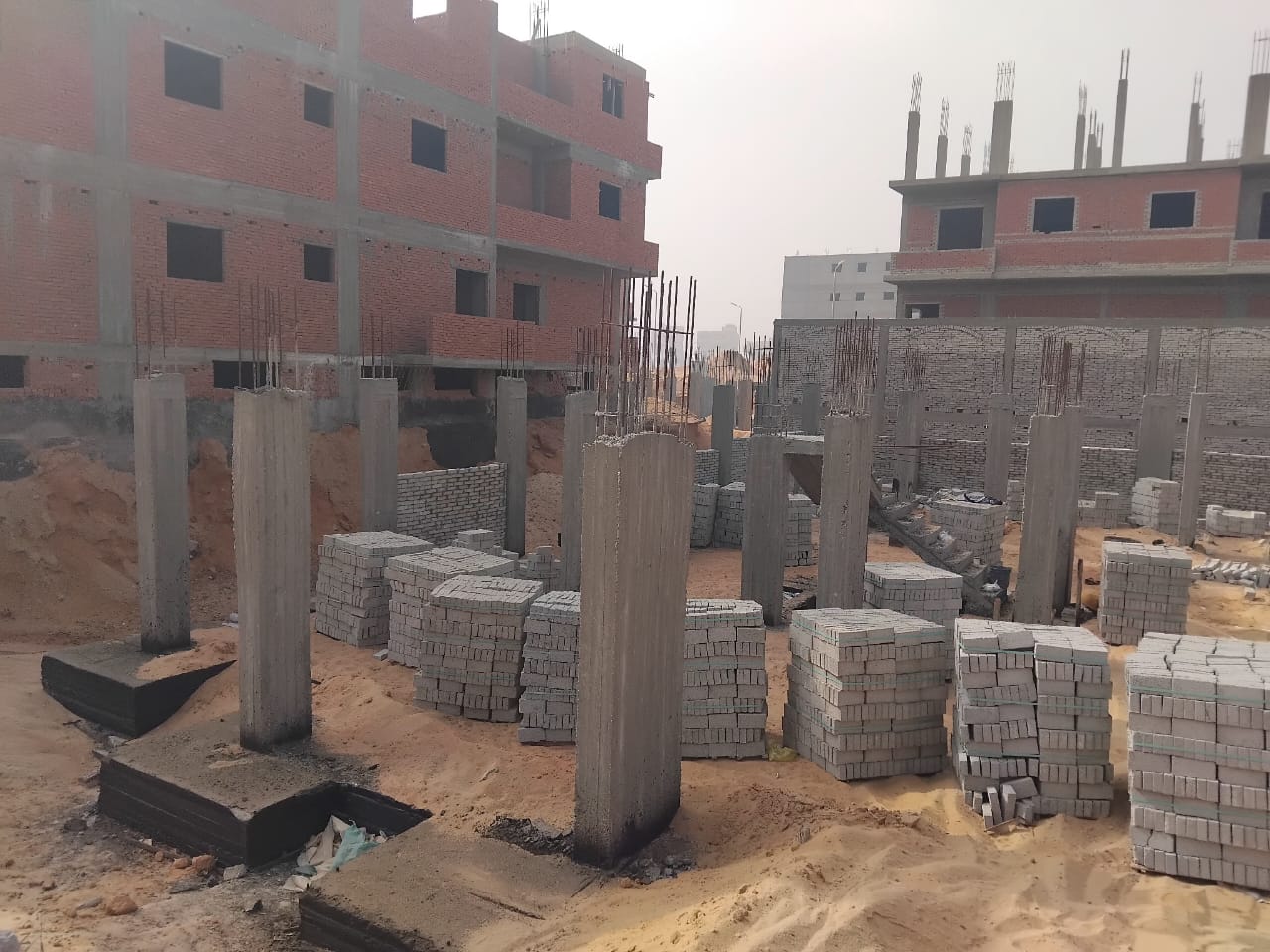

Basement walls
July 29, 2026
Ground floor walls
August 8, 2026
First floor walls
August 9, 2026
Second floor walls
August 19, 2026
Third floor walls
August 29, 2026
Roof walls
September 8, 2026
Wooden door frames
September 22, 2026
Plumbing main works
September 23, 2026
Electrical final finishes
October 3, 2026
Electrical finishing
November 20, 2026
Plumbing finishing
November 21, 2026
Plaster and putty
November 22, 2026
Marble works
December 1, 2026
Aluminum & glass works (Krital)
December 2, 2026
Elevator
December 27, 2026
