Project Details
Land Number
1327
Region
The Area 29, El Sadat City
HOMEi Price
4,500.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
| 2 |
|
- | Finished |
| 3 |
|
- | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 25% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
175 m²
Delivery
Unit Delivery Date
September 2025
Average Unit Price
634,500 EGP
Project Location
Map View
The Area 29, El Sadat City
HOMEi Timeline
License office contract
November 10, 2023

Building permit

November 15, 2023

Excavation permit
November 25, 2023
Mining permit
November 26, 2023
Extracting a Building water meter
November 29, 2023
Obtaining a construction insurance certificate
November 29, 2023
Construction contract in progress
December 1, 2023
Construction contract signed
December 1, 2023

Excavation
December 5, 2023

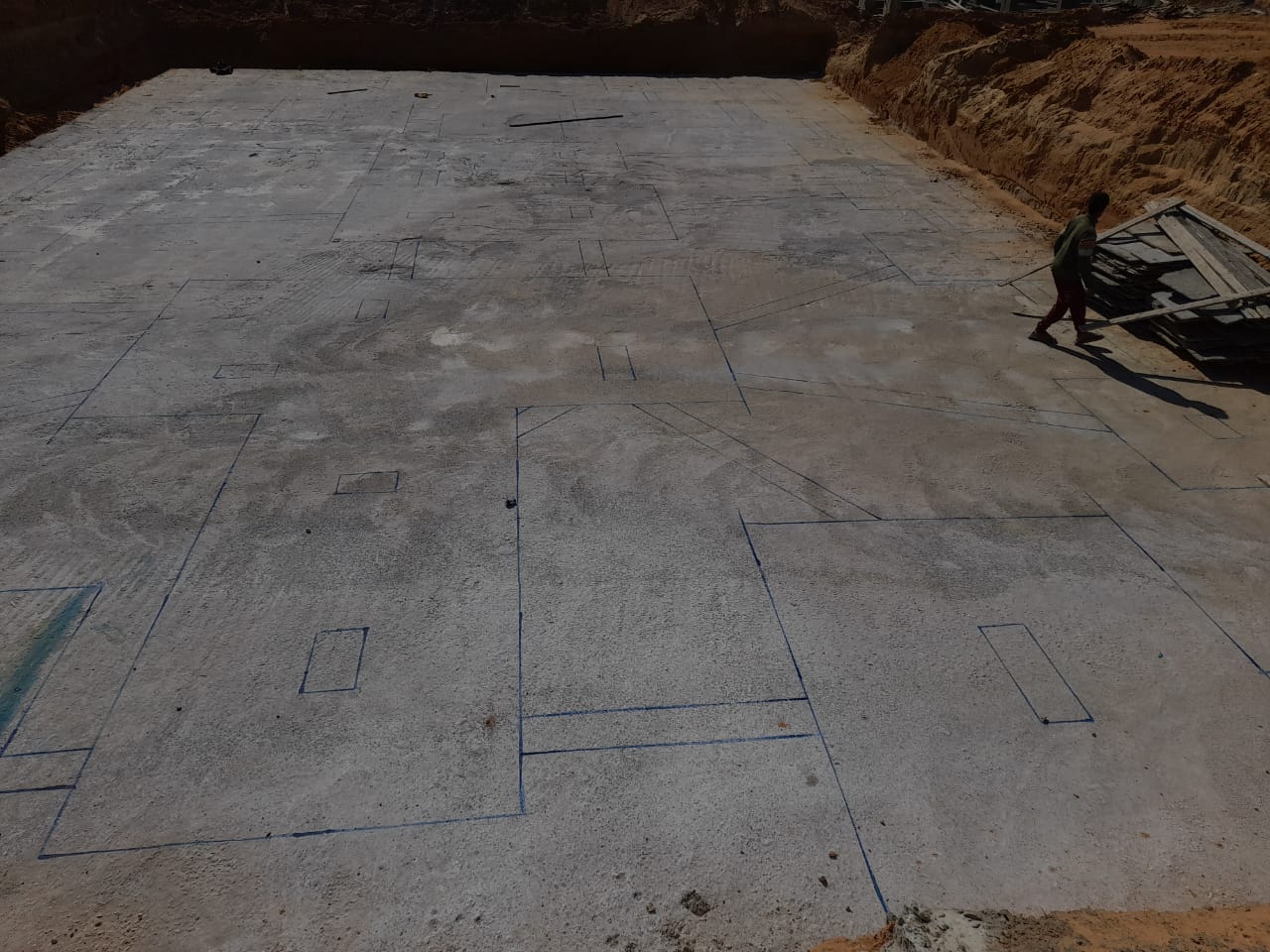

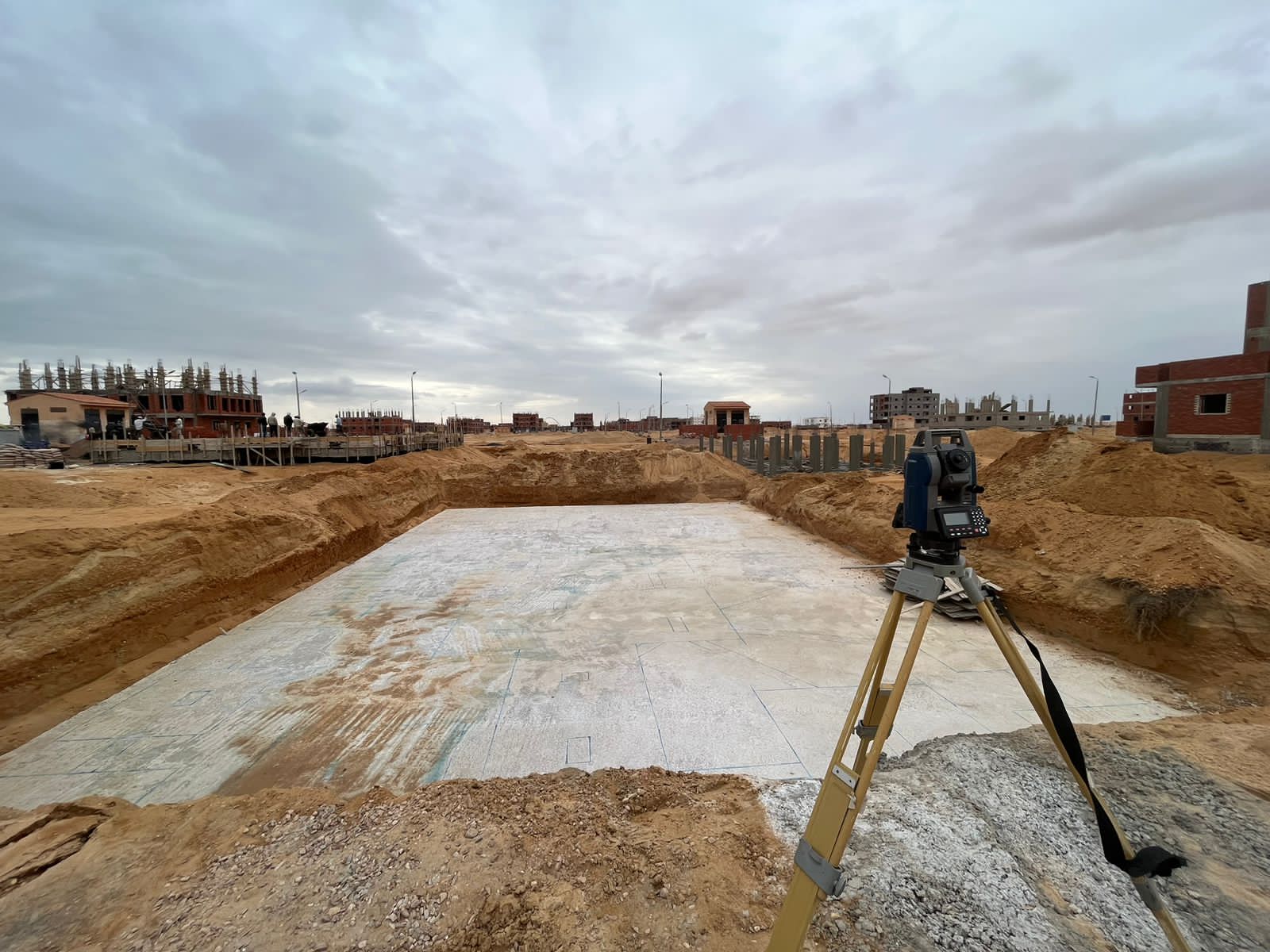

Plain concrete
December 7, 2023

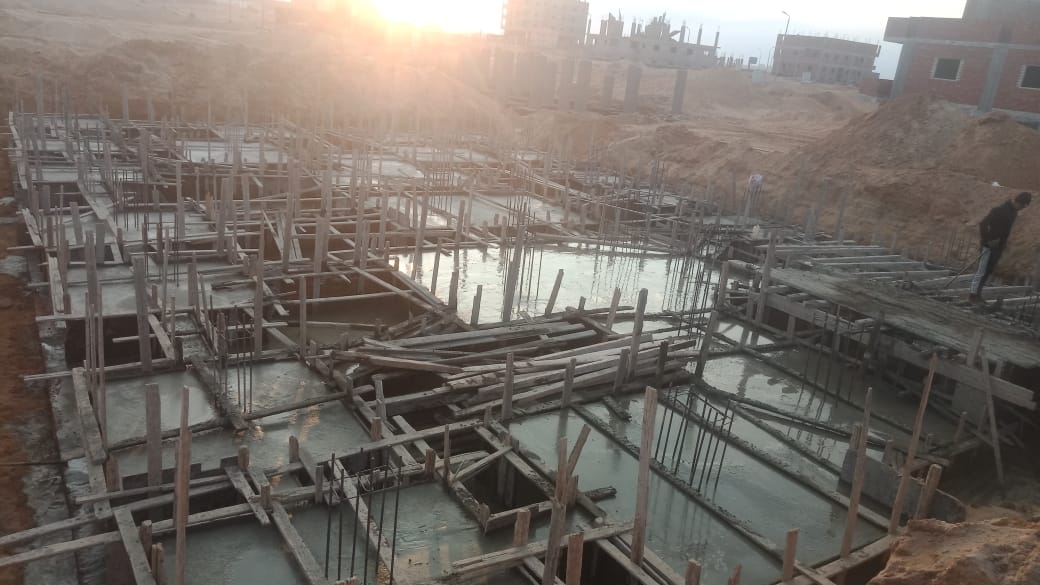

Reinforced concrete
December 7, 2023

Footings insulation
December 11, 2023

Backfilling around foundations
December 11, 2023

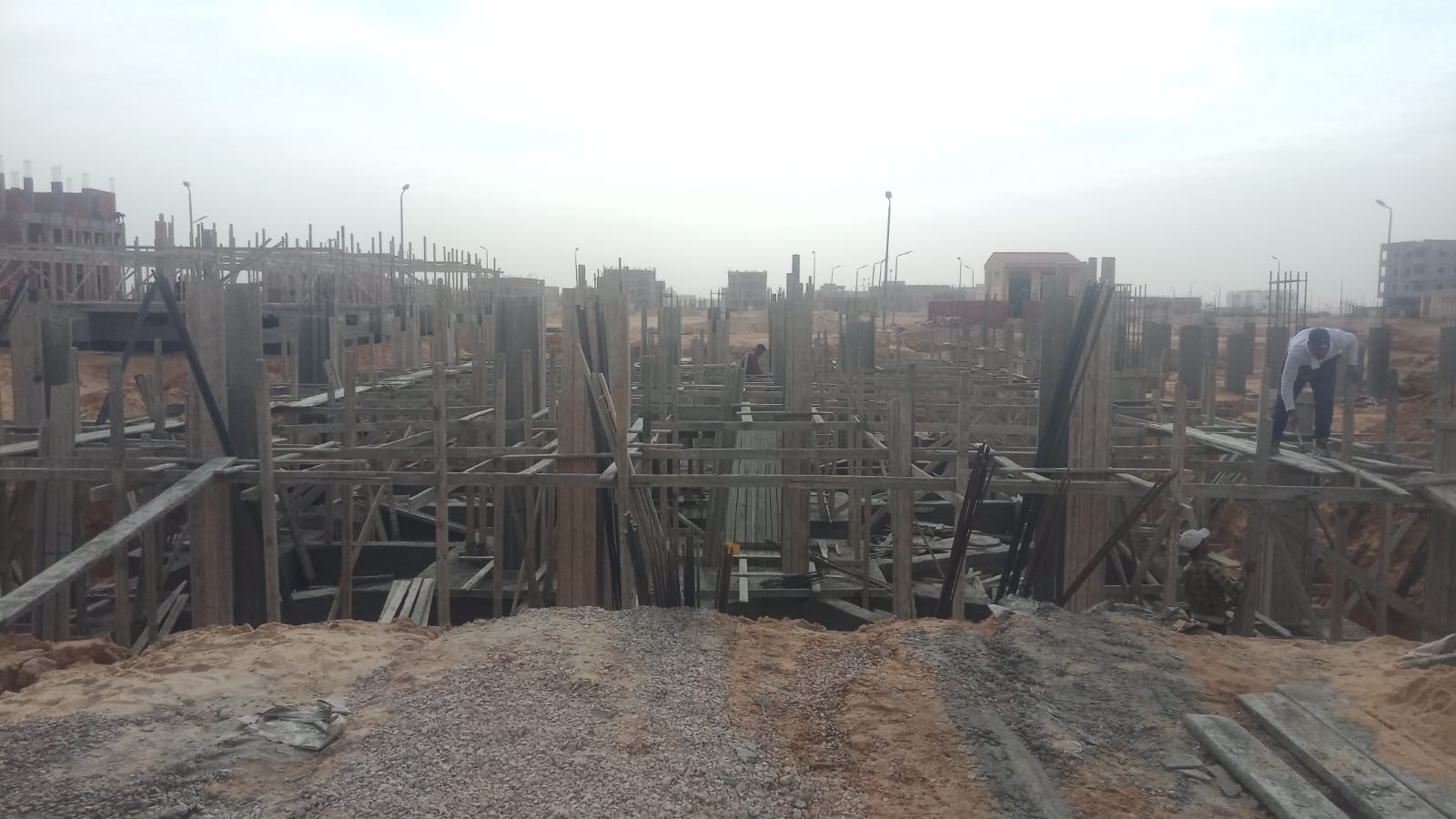

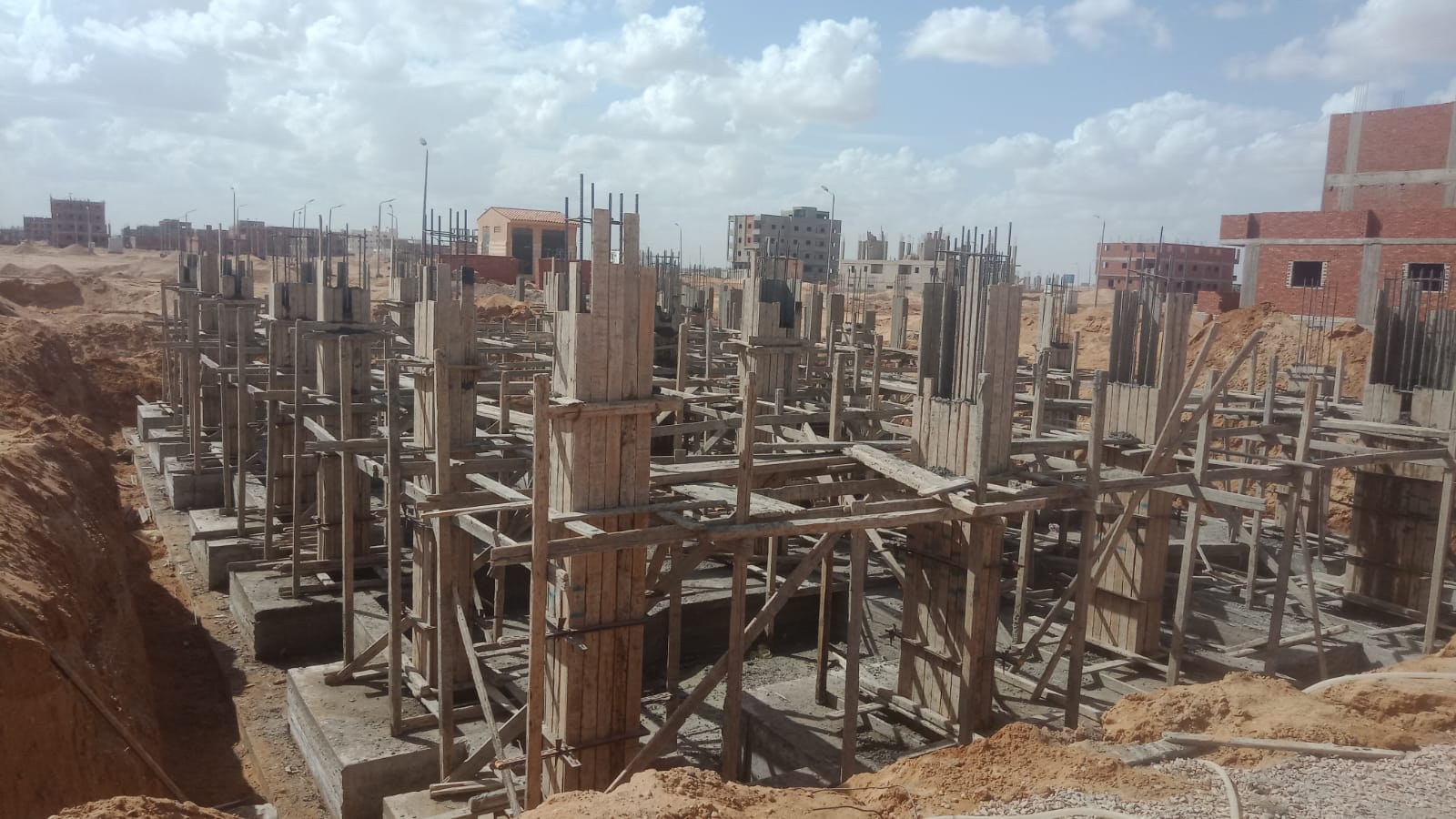

Basement columns
December 20, 2023

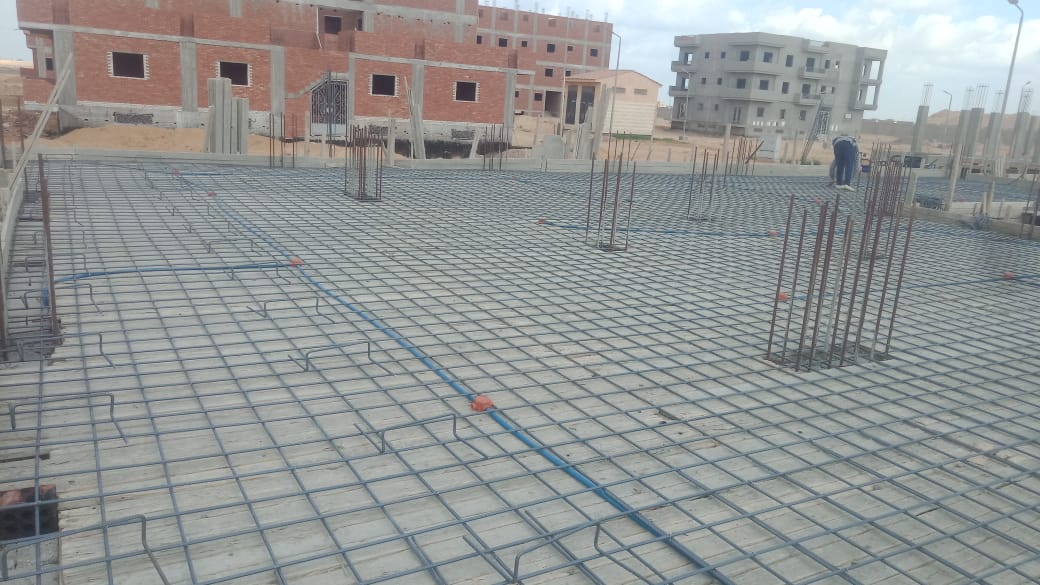

Basement slab
December 30, 2023

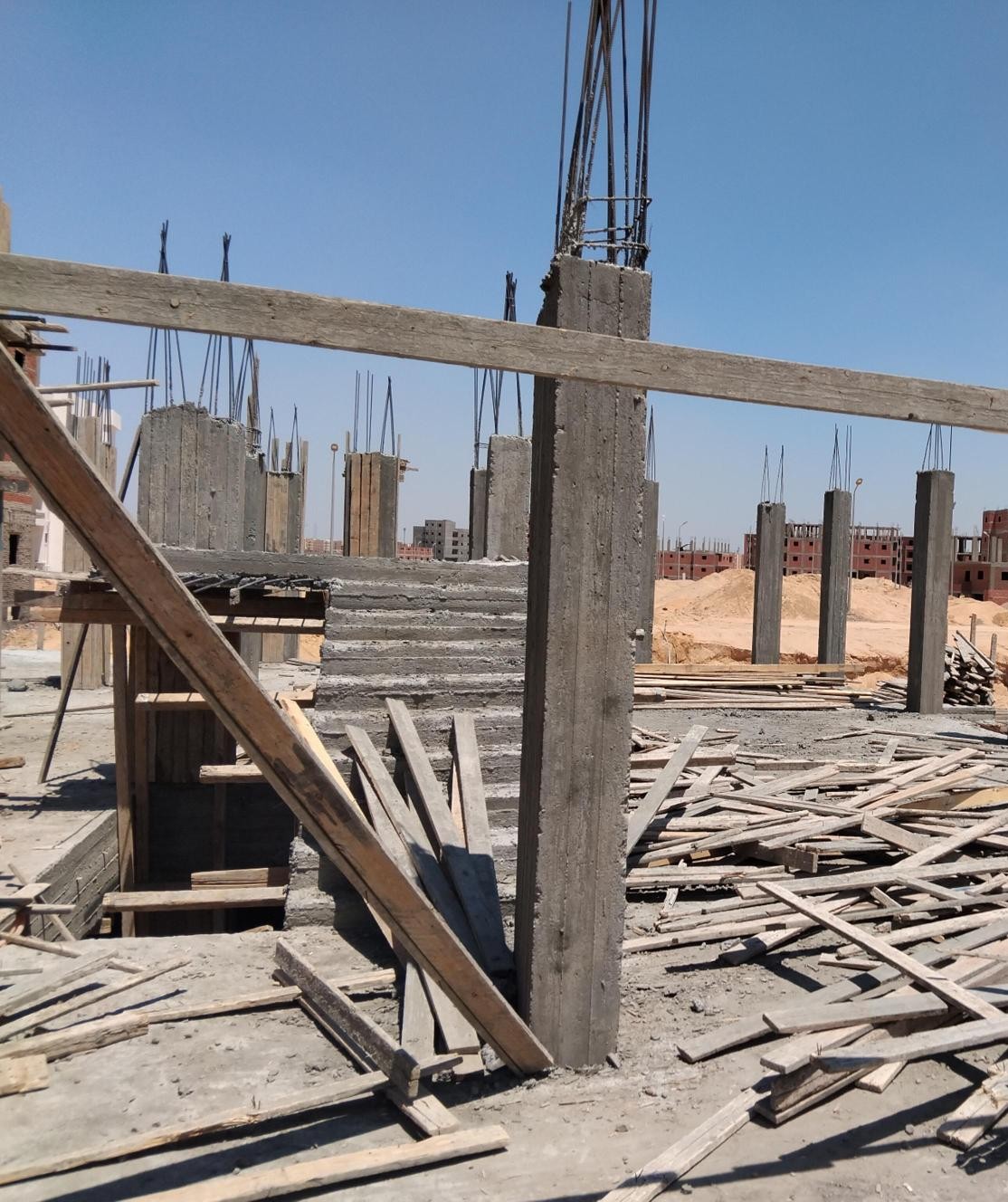

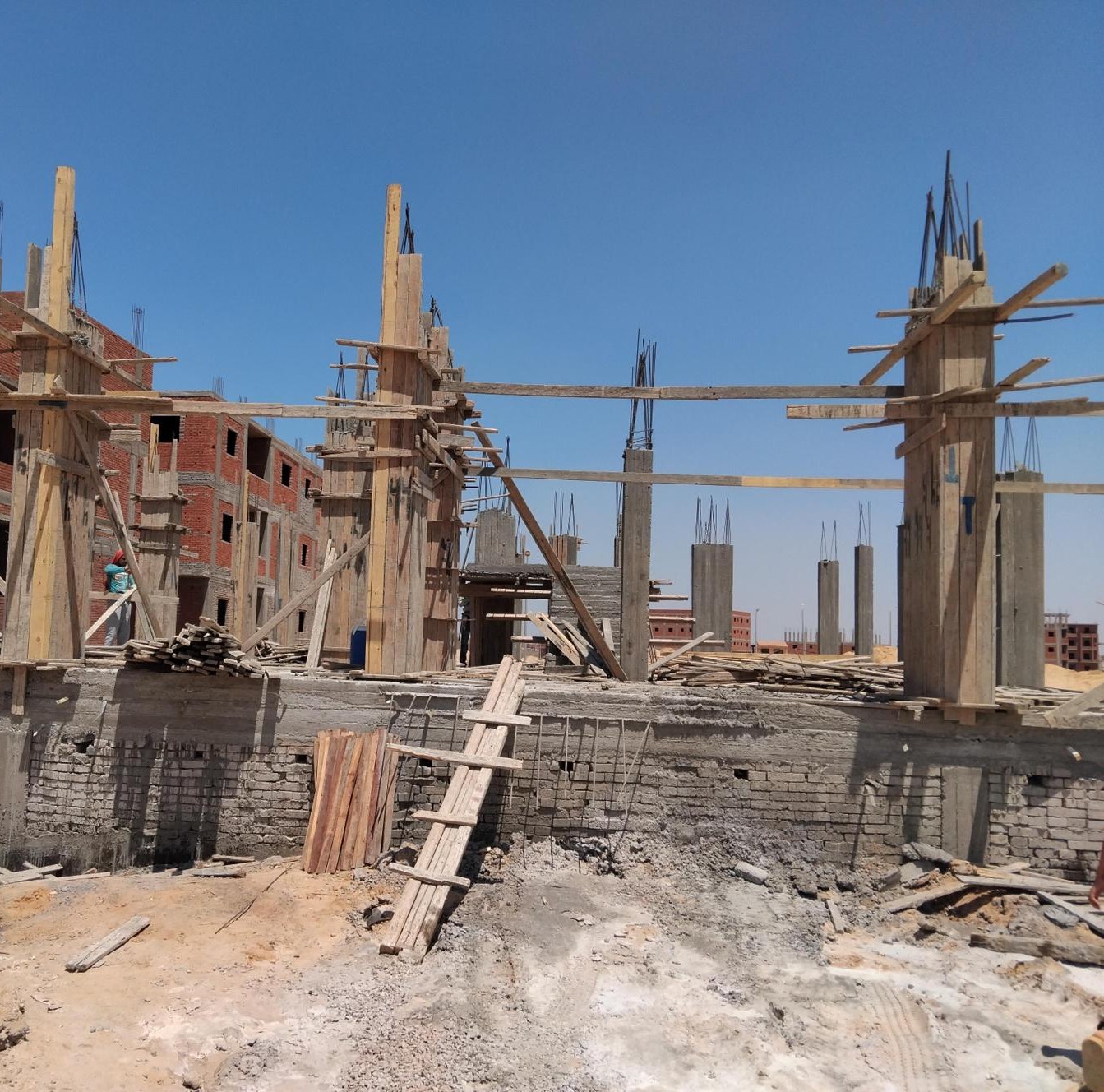

Ground floor columns
January 1, 2024

Ground floor slab
January 22, 2024

Basement walls
January 26, 2024

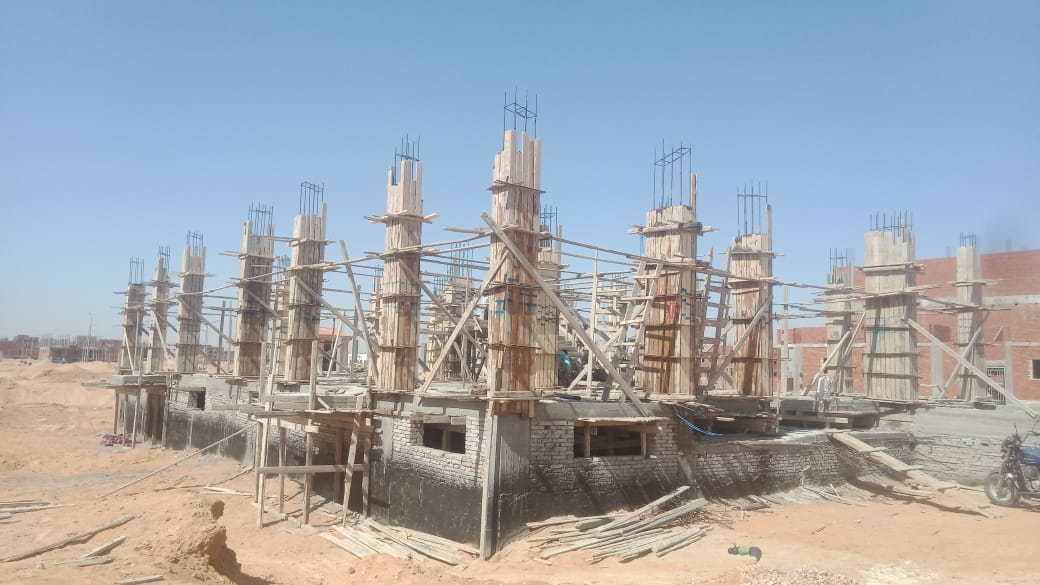

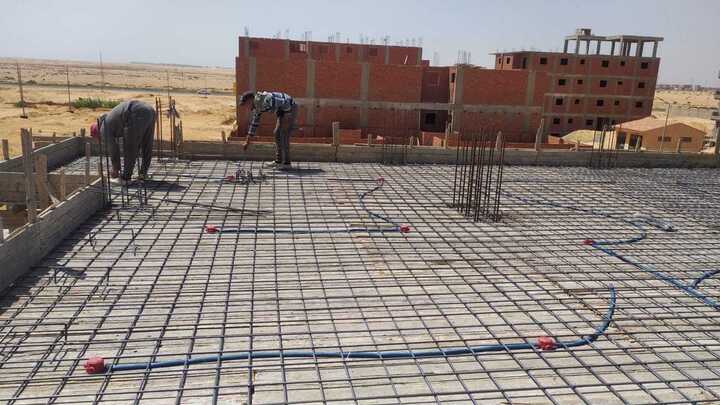

First floor columns
February 8, 2024

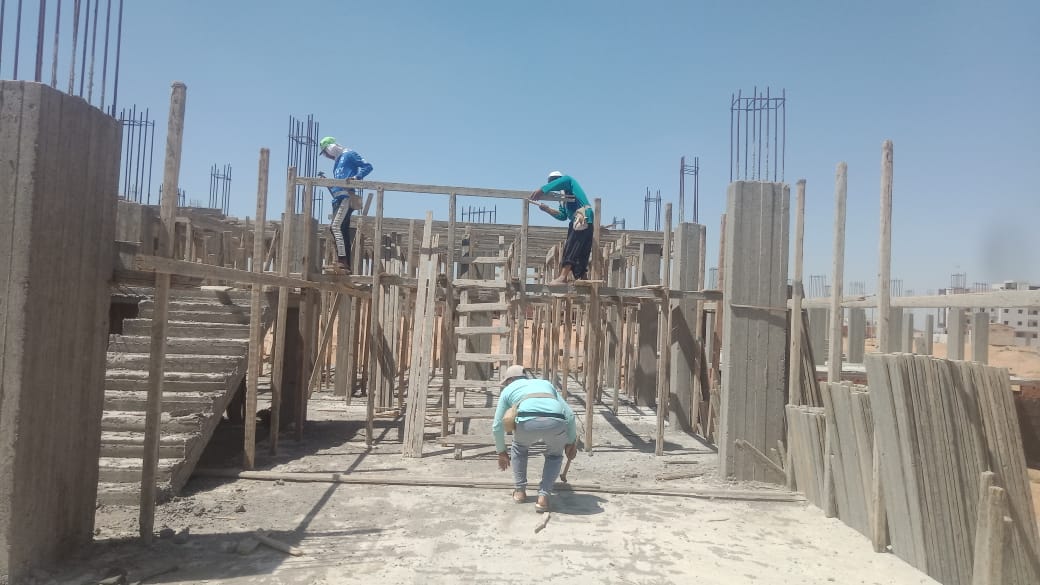

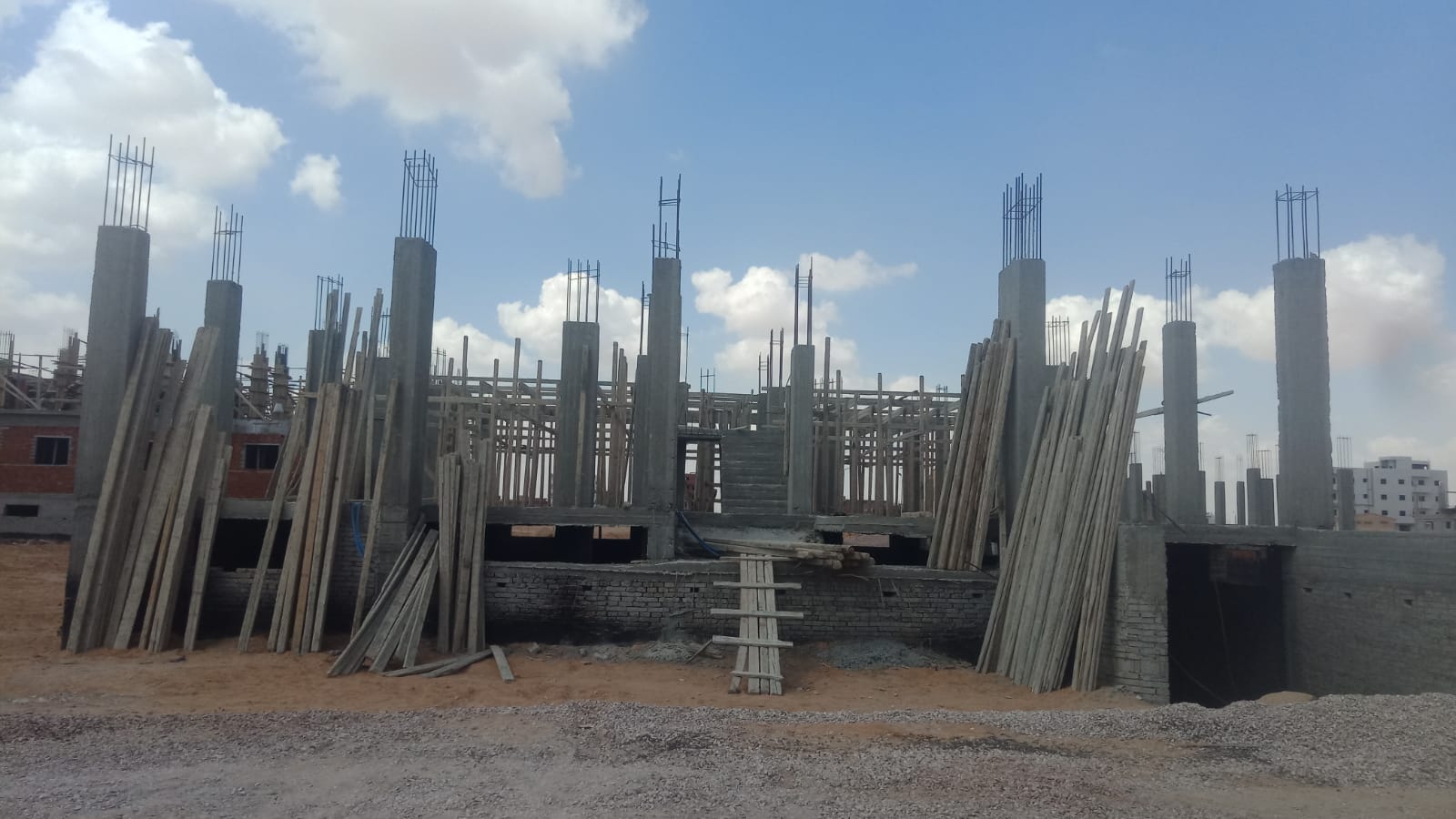

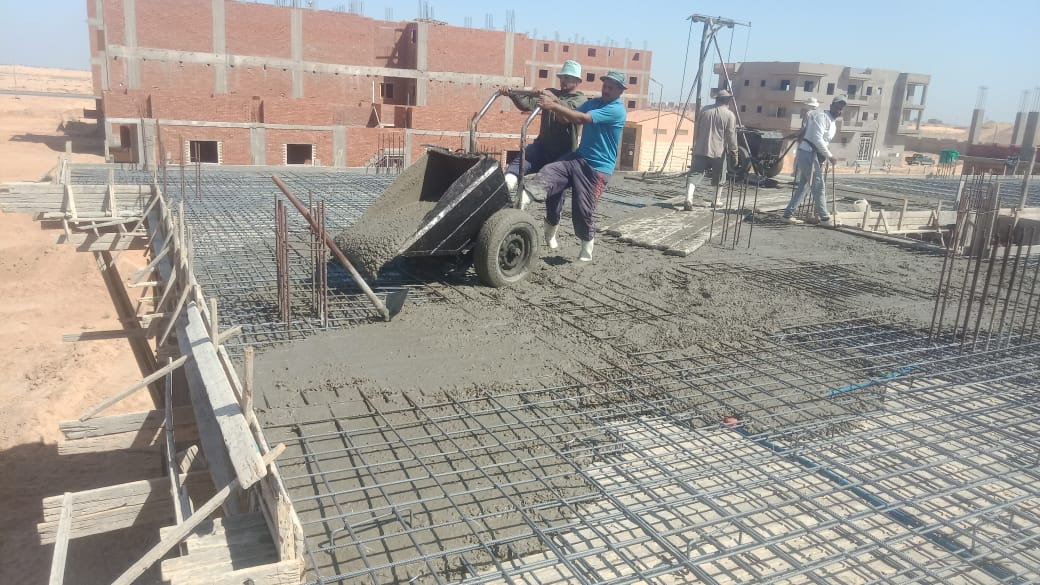

First floor slab
February 28, 2024

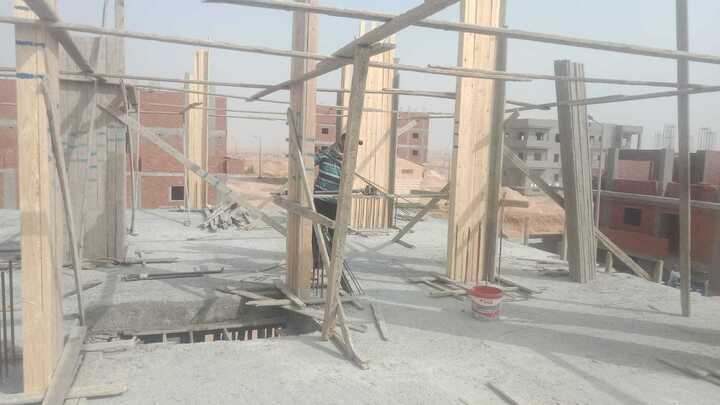

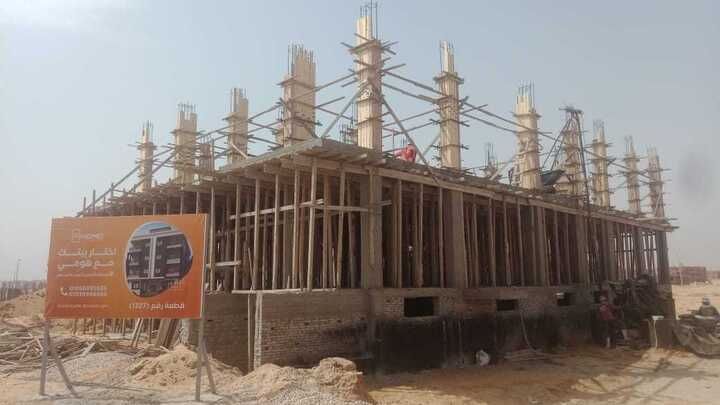

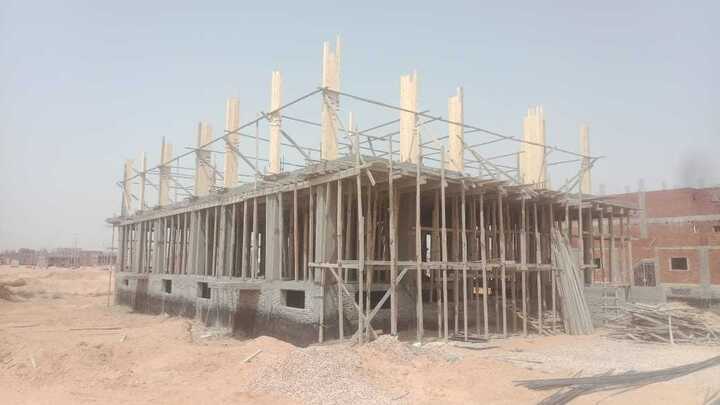

Second floor columns
March 9, 2024

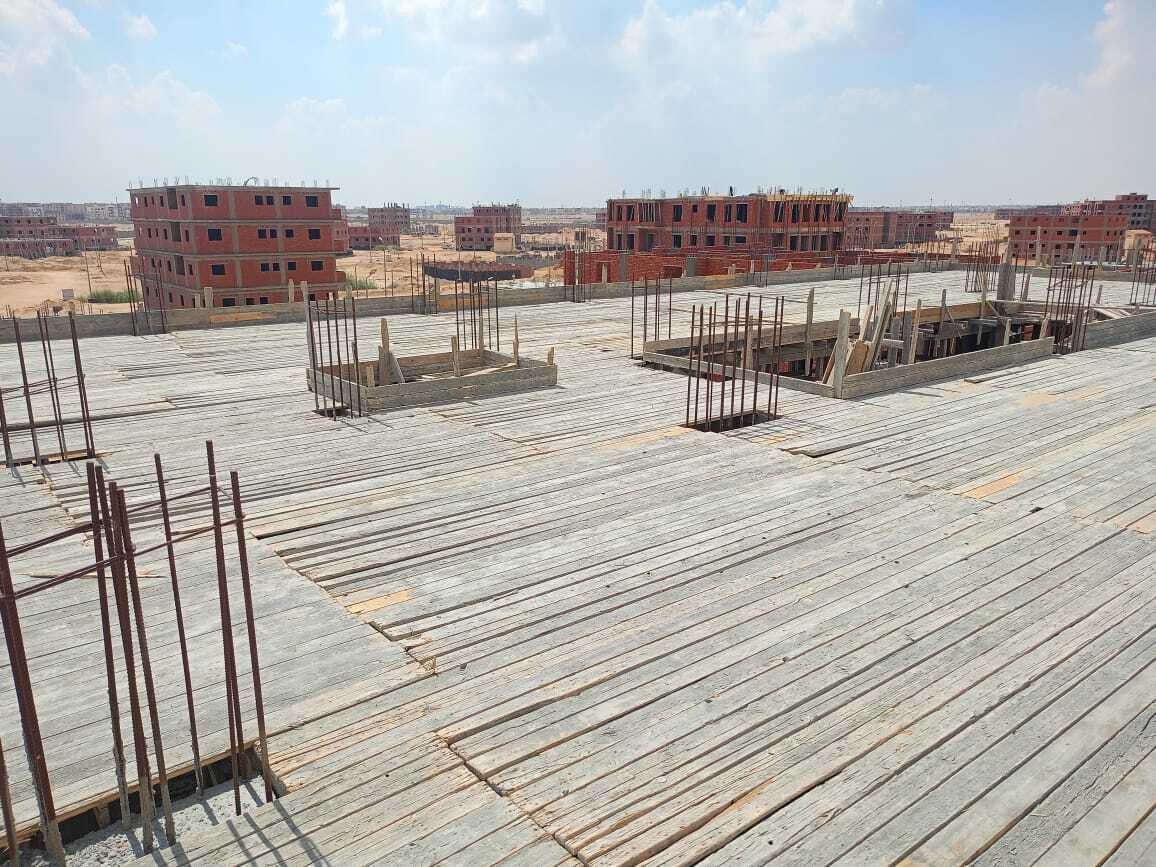

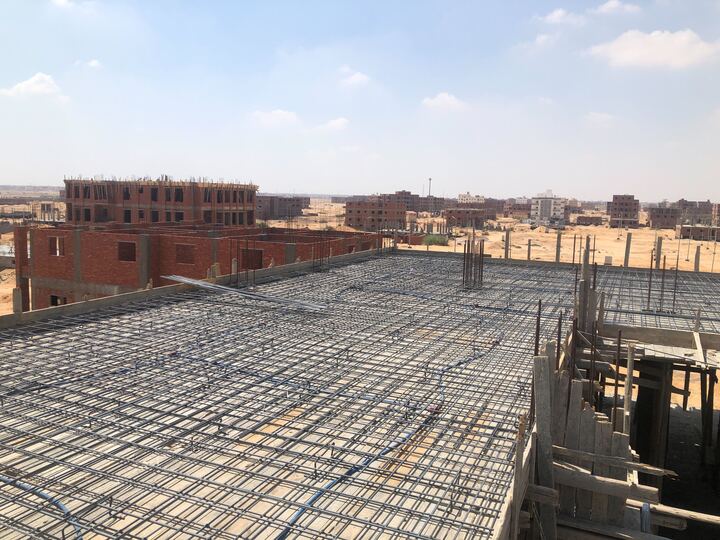

Second floor slab
August 24, 2024

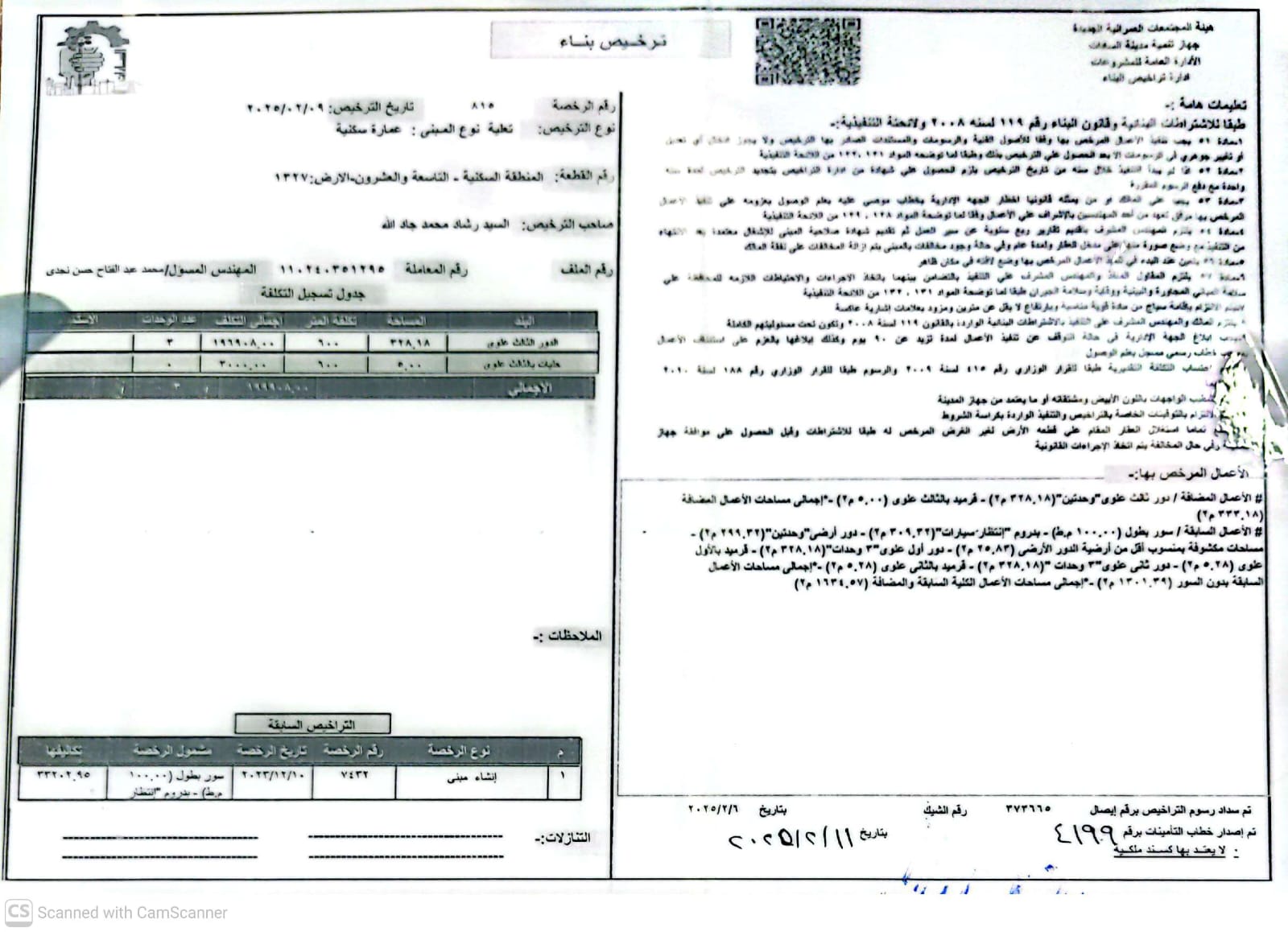

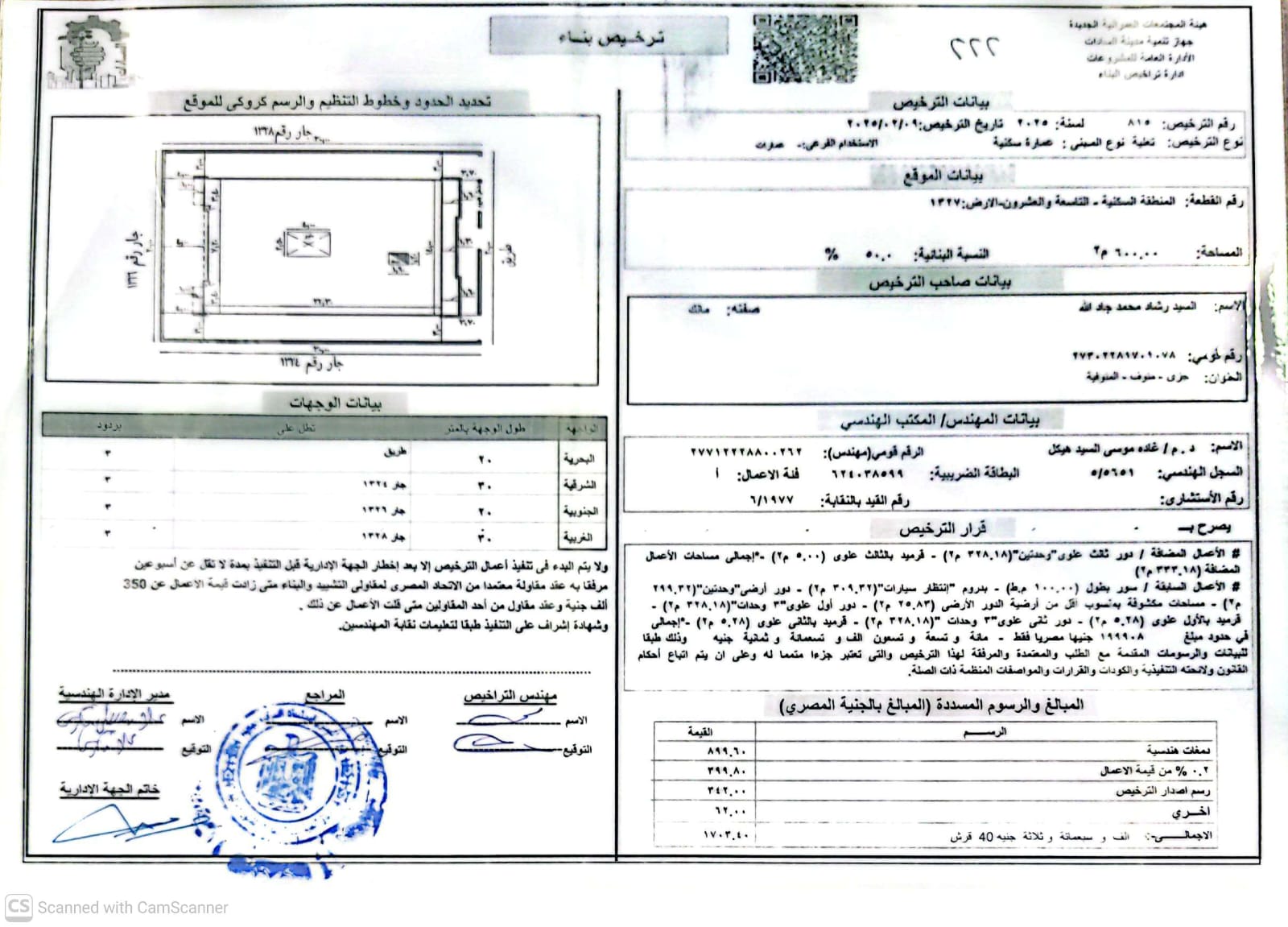

Third-floor addition permit
September 14, 2024
Obtaining an insurance certificate for a third-floor extension
November 15, 2024

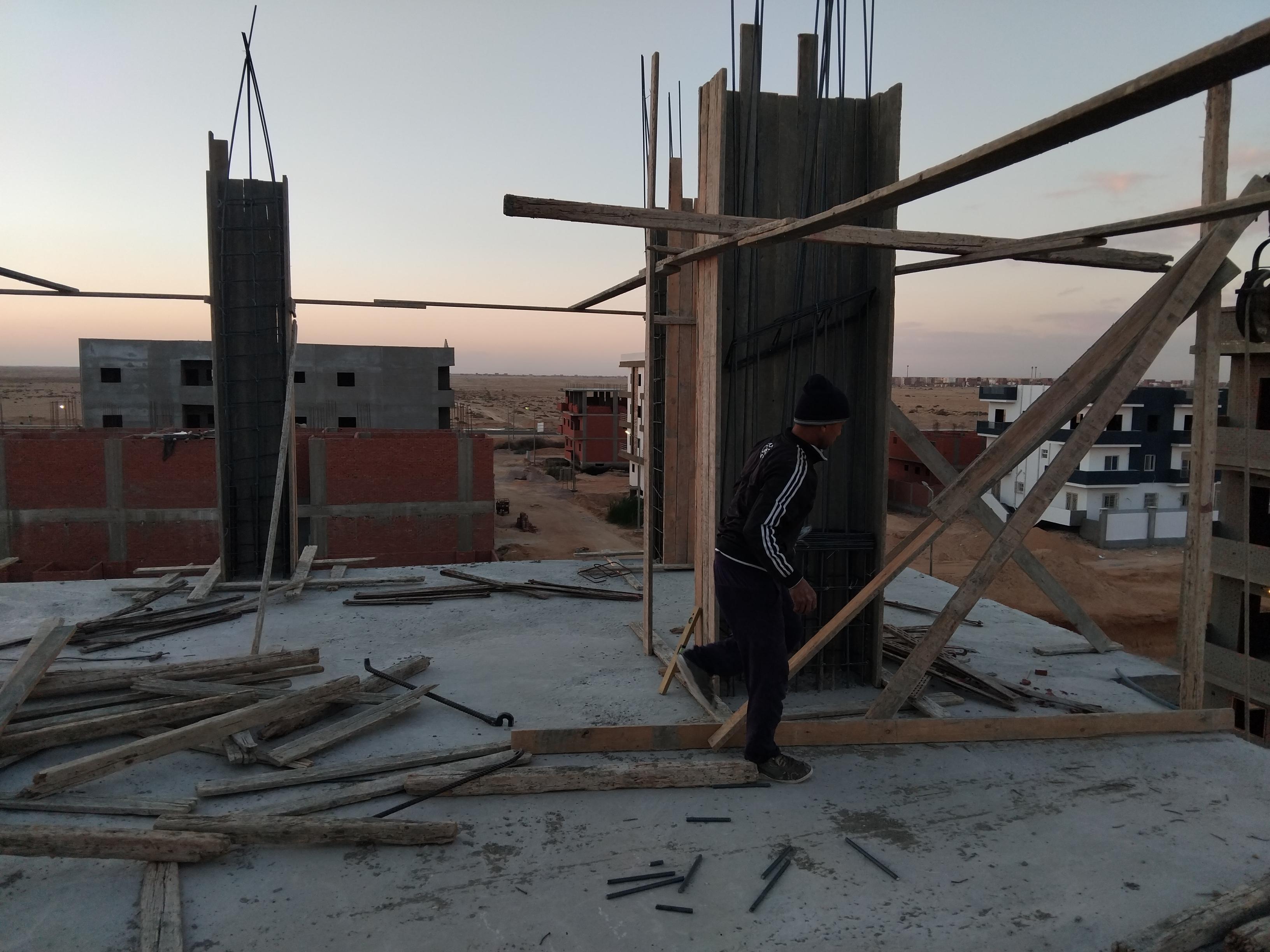

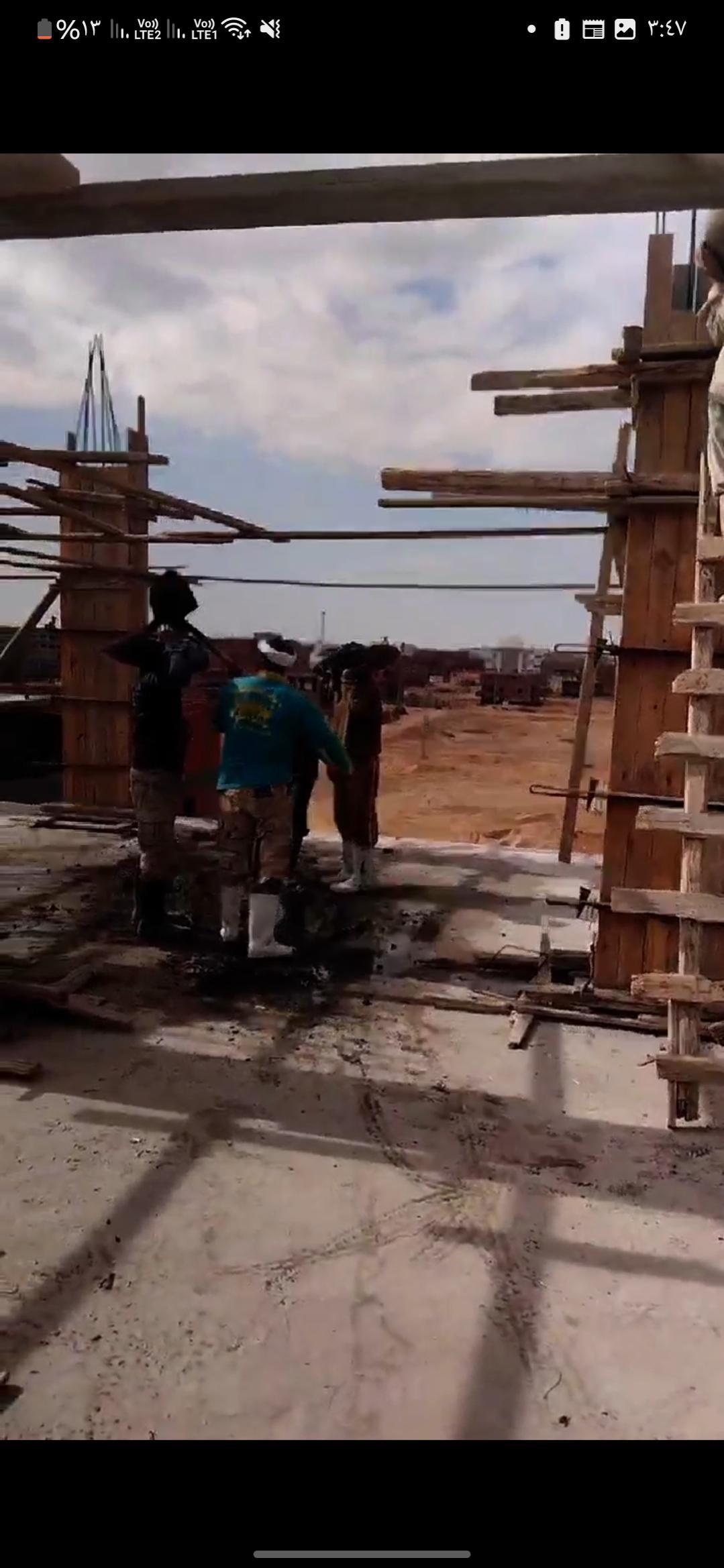

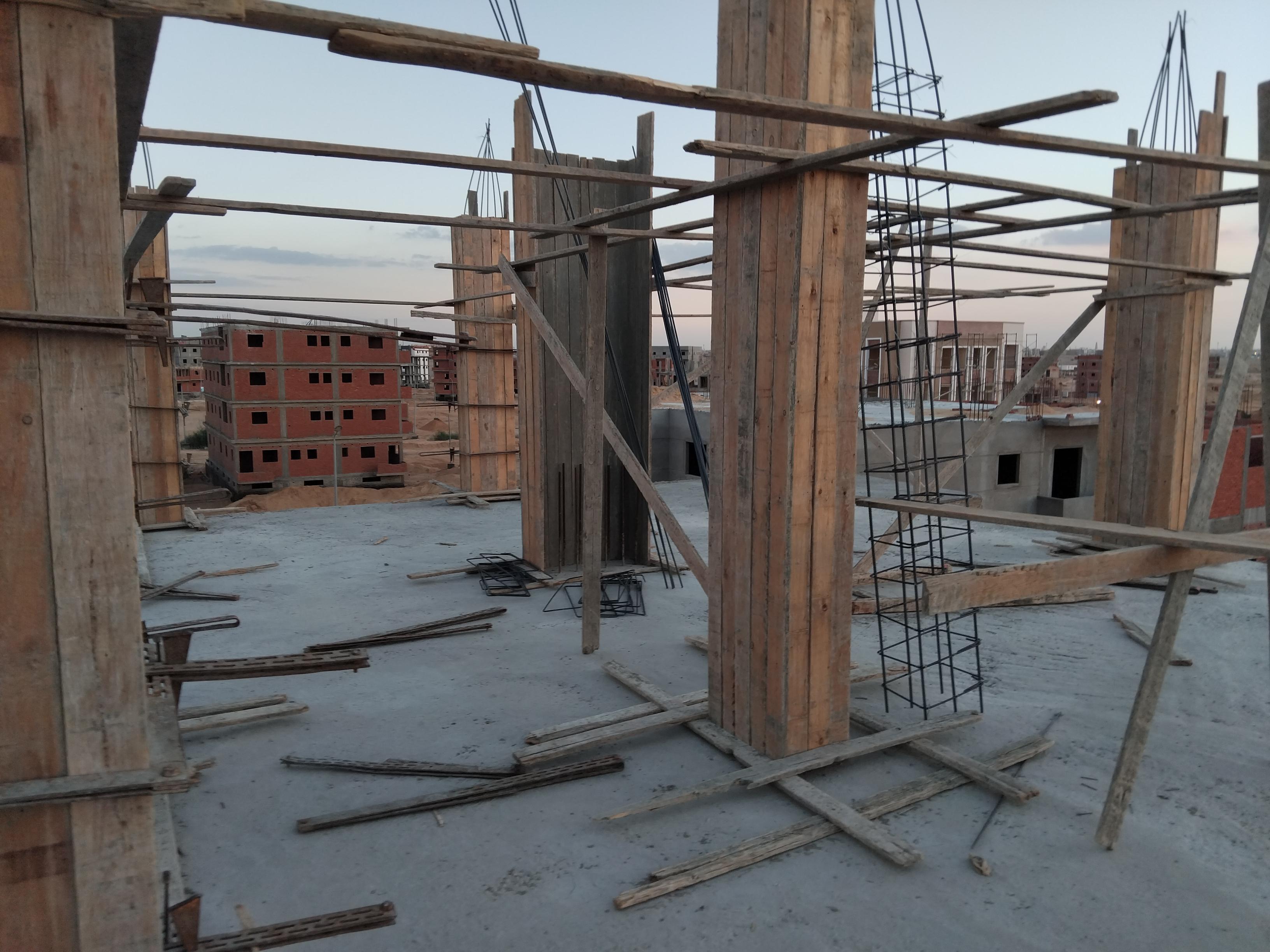

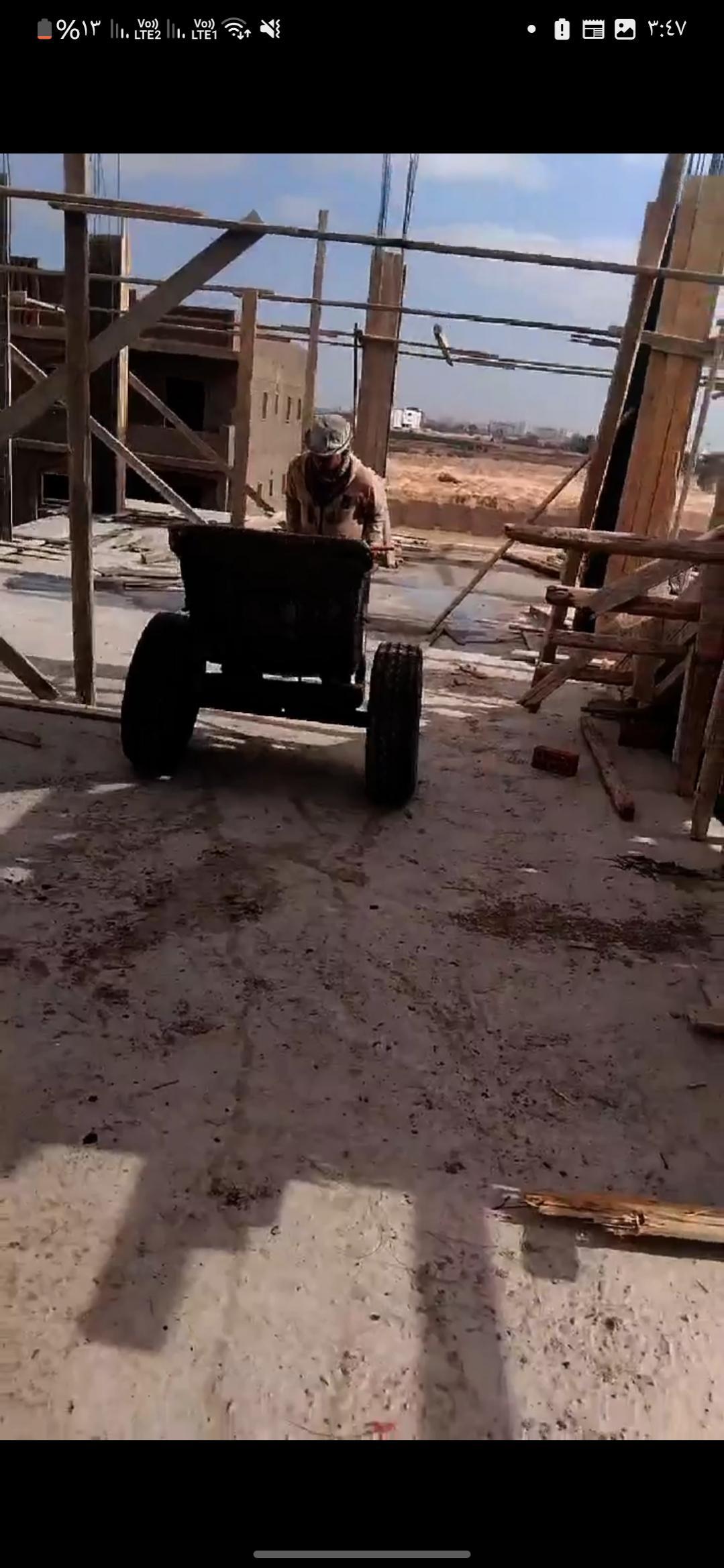

Third floor columns
December 14, 2024

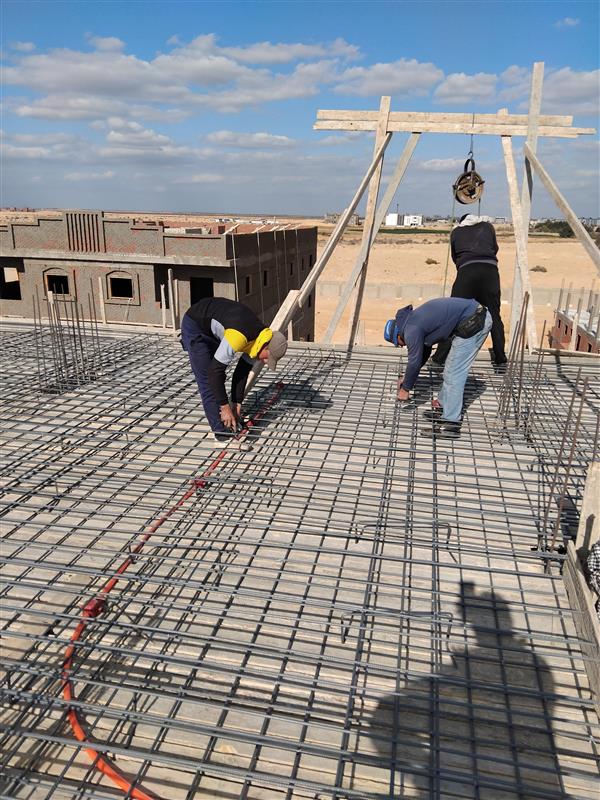

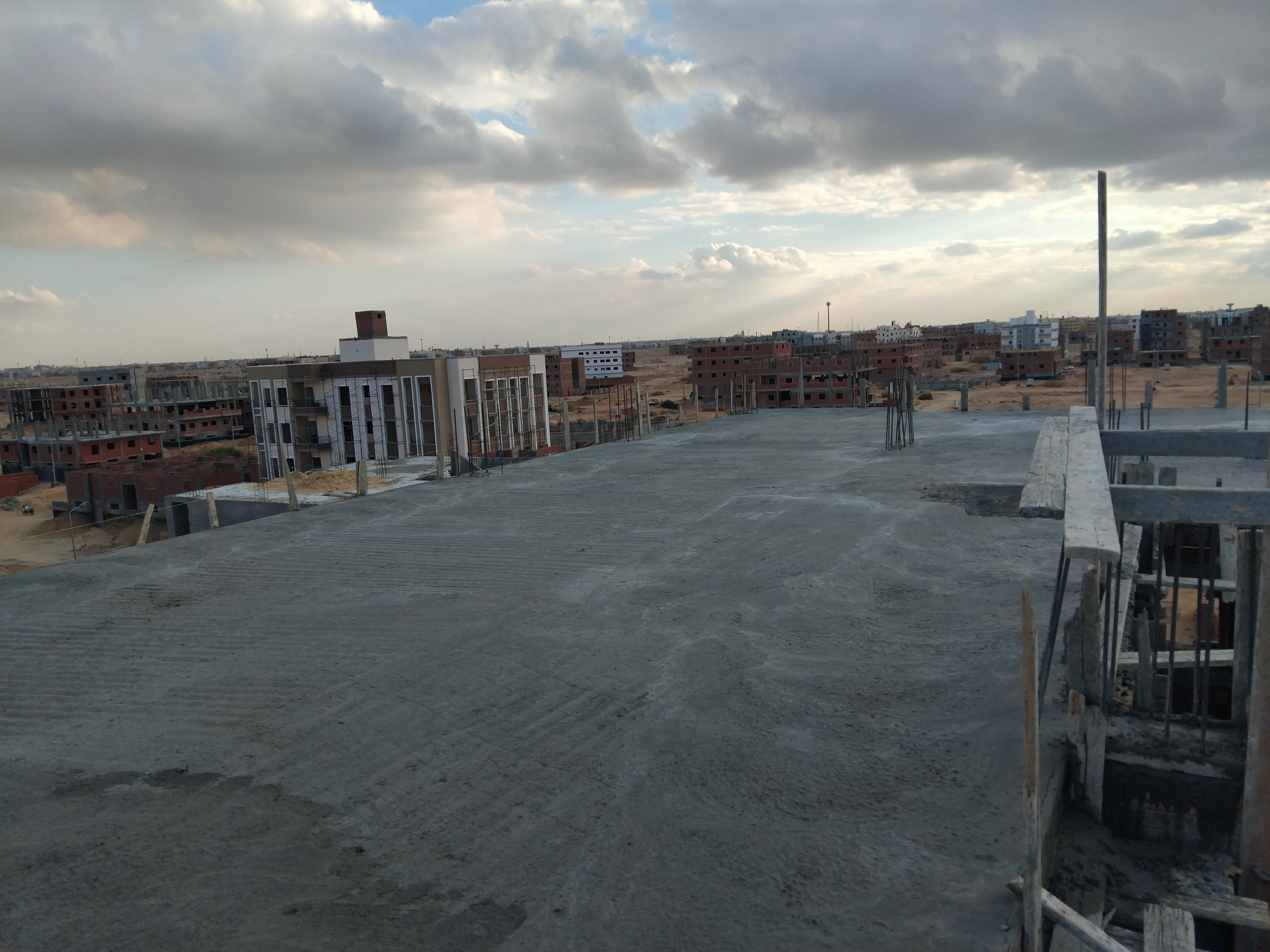

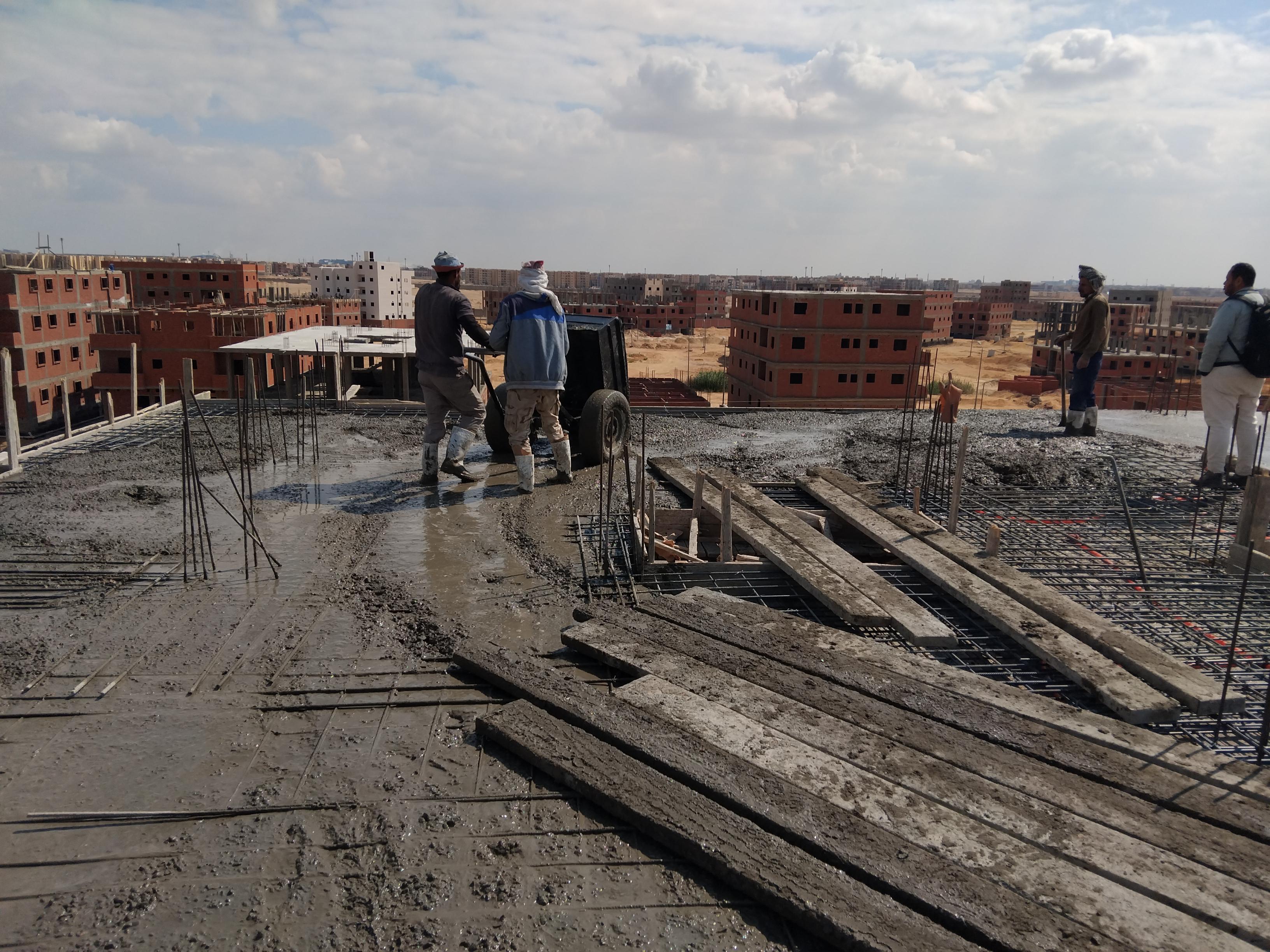

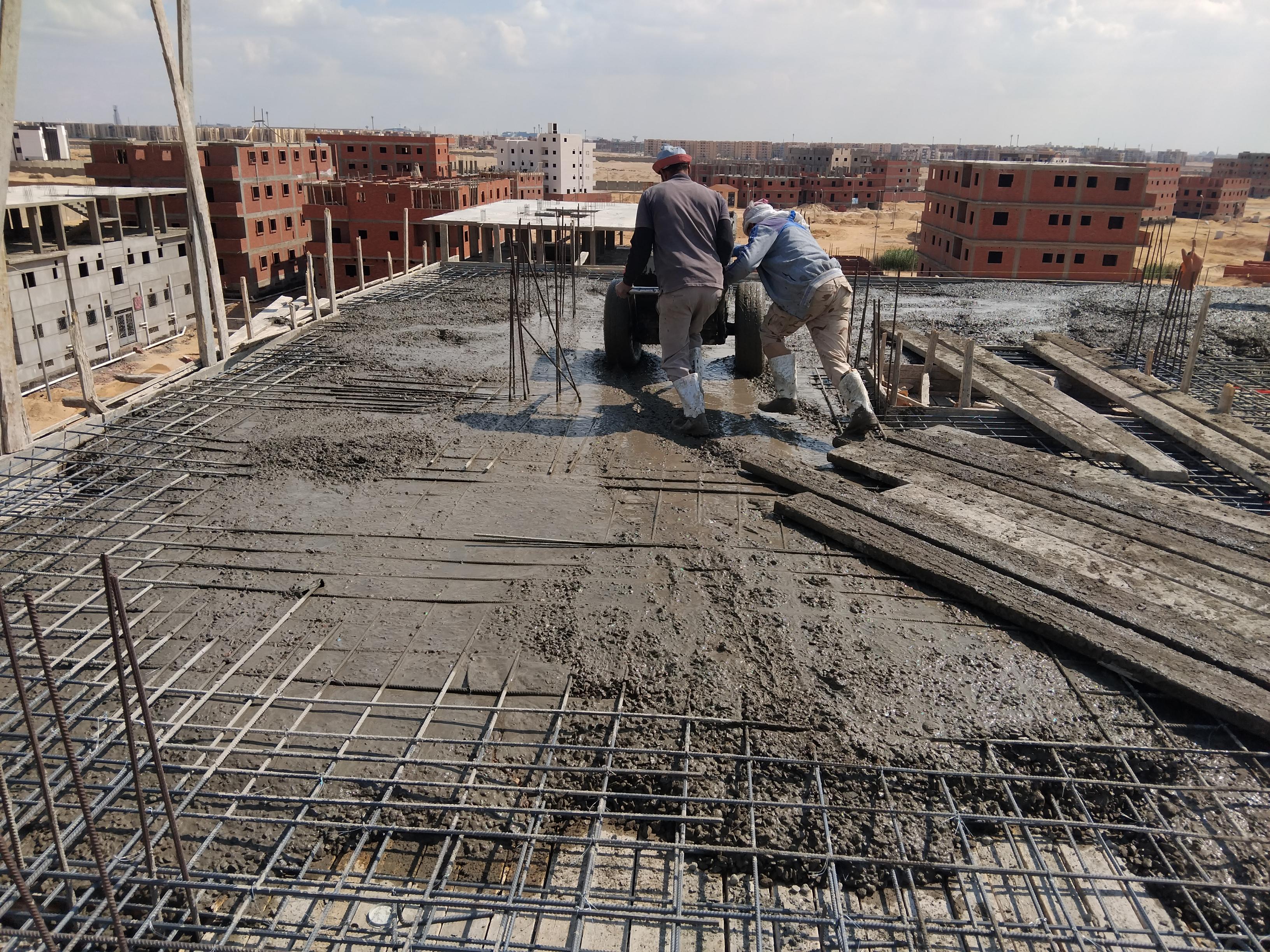

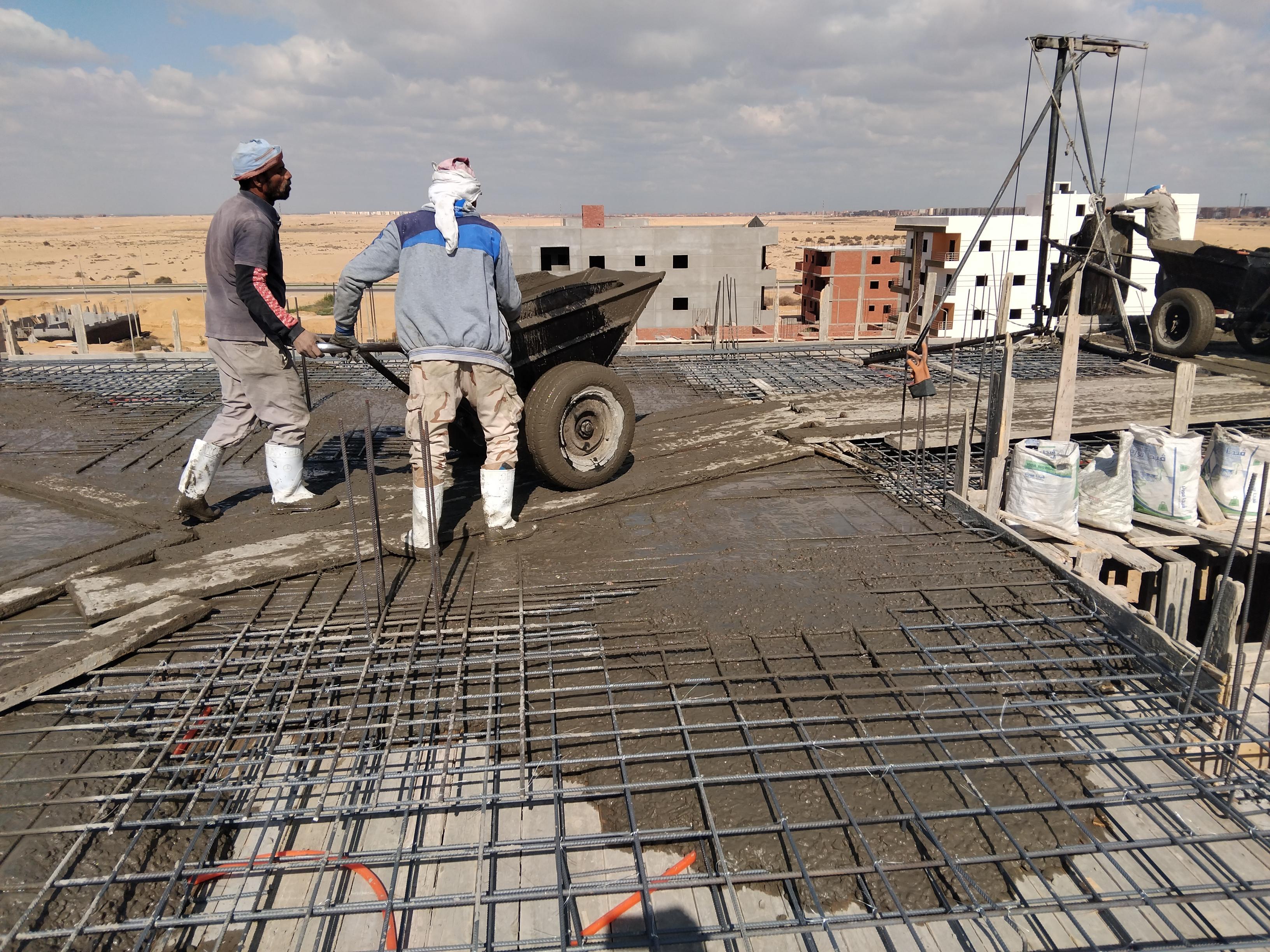

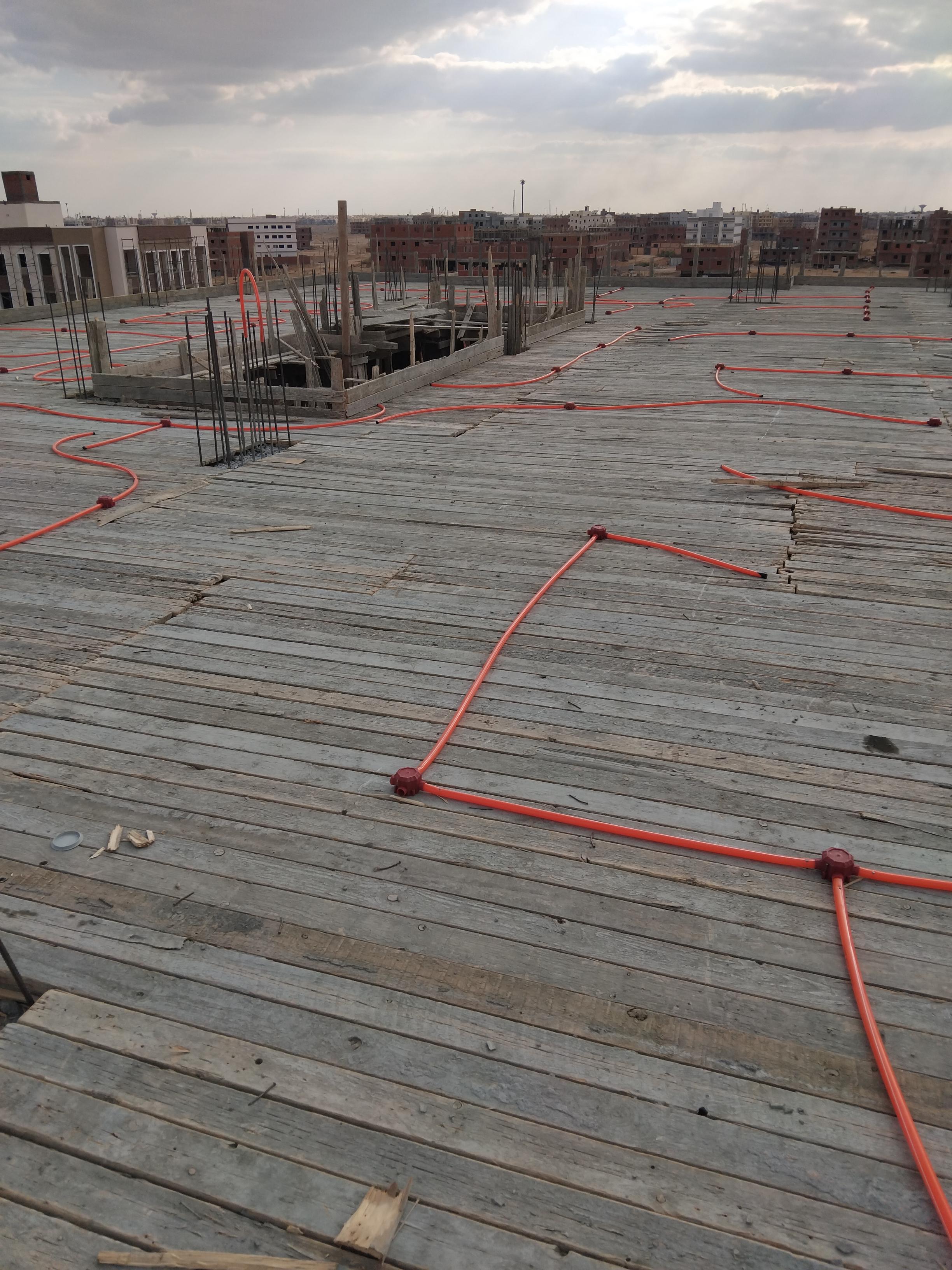

Third floor slab
December 24, 2024
Roof extension license
January 14, 2025
Obtaining a roof insurance certificate
January 14, 2025
Roof concrete works
April 4, 2025

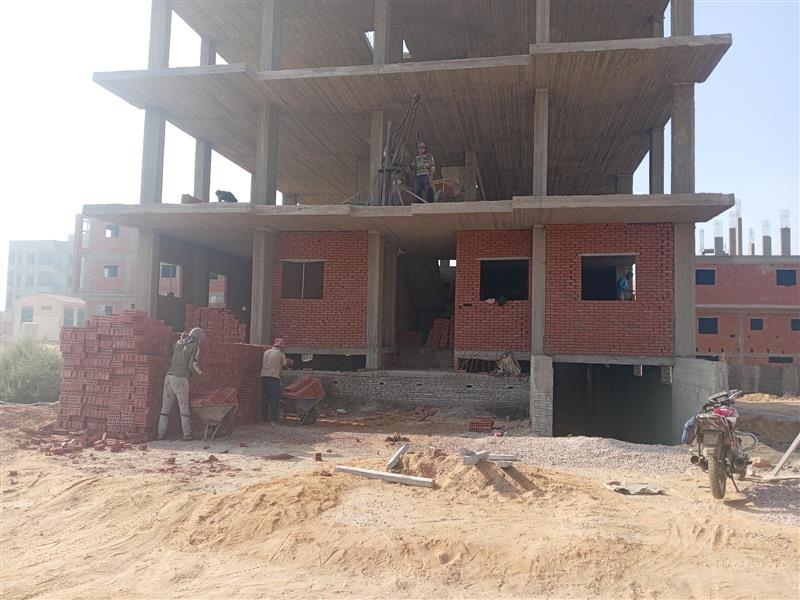

Ground floor walls

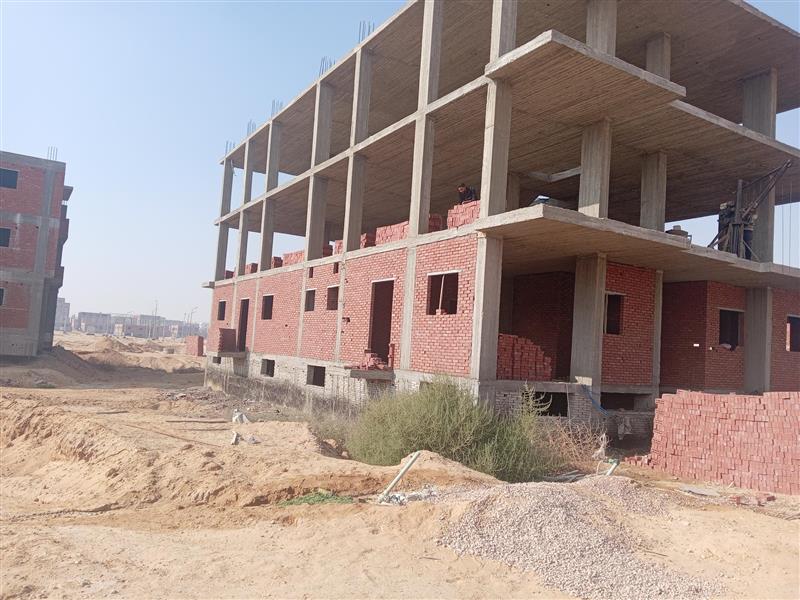

April 28, 2025

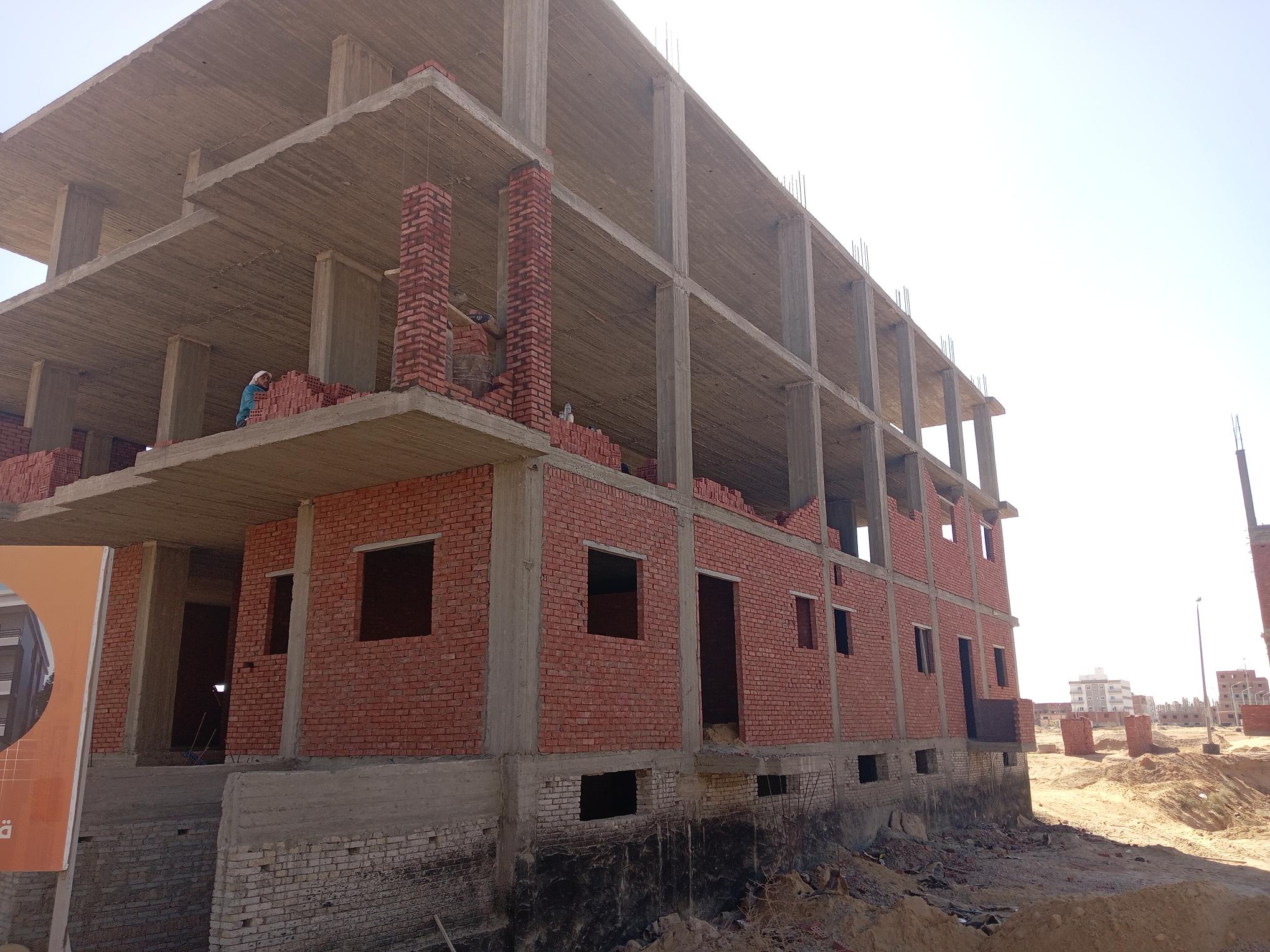

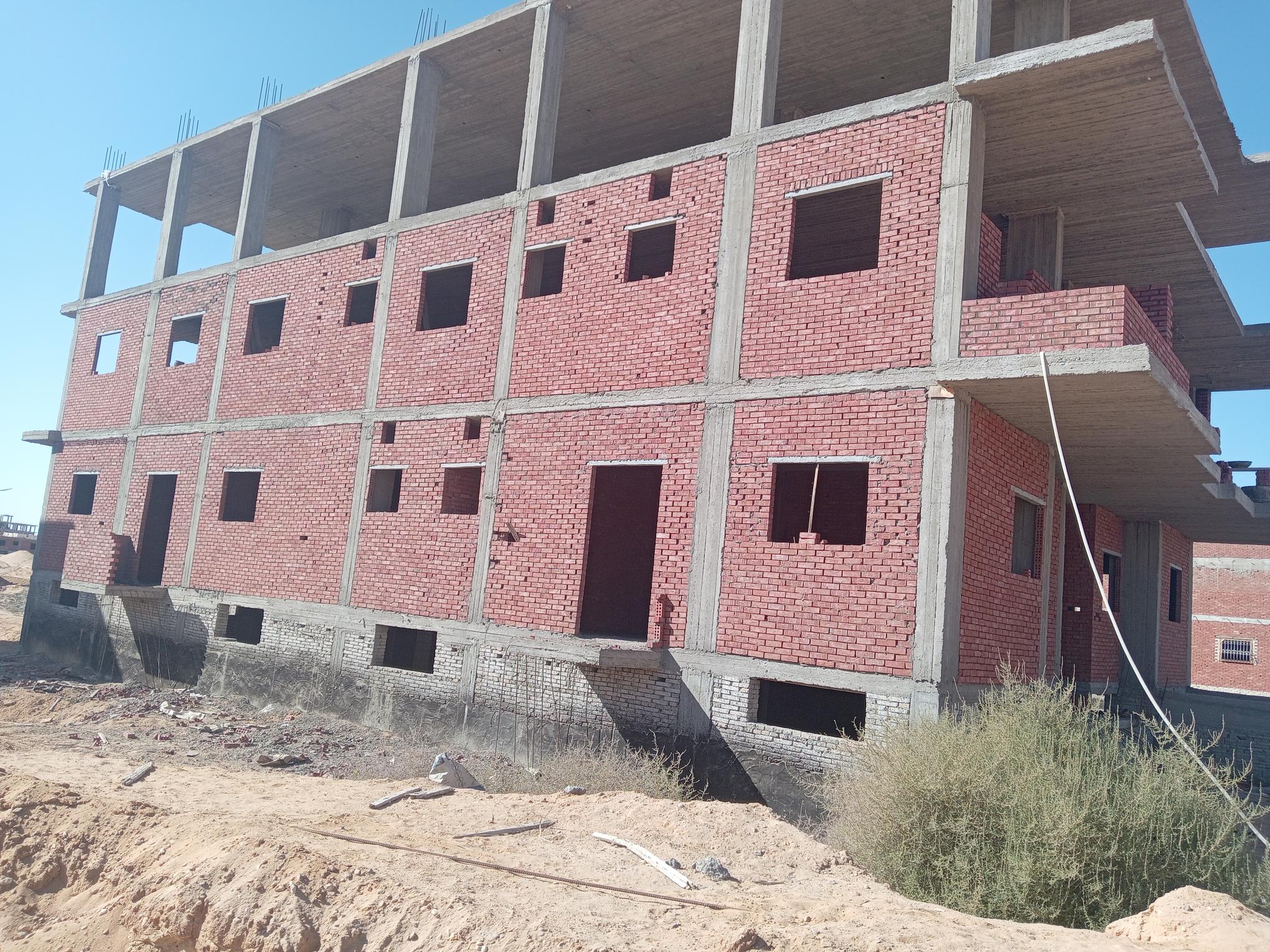

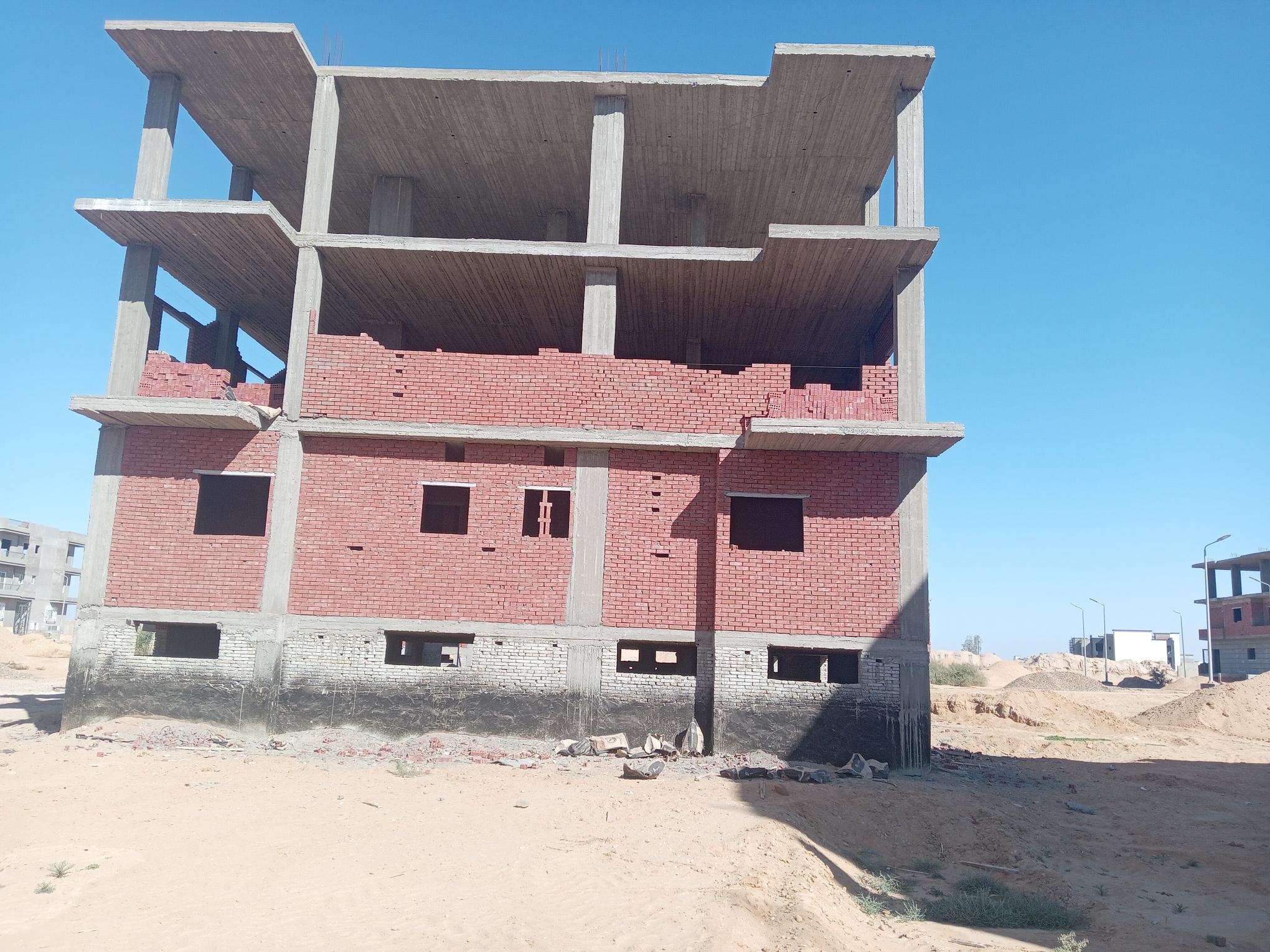

First floor walls
May 8, 2025

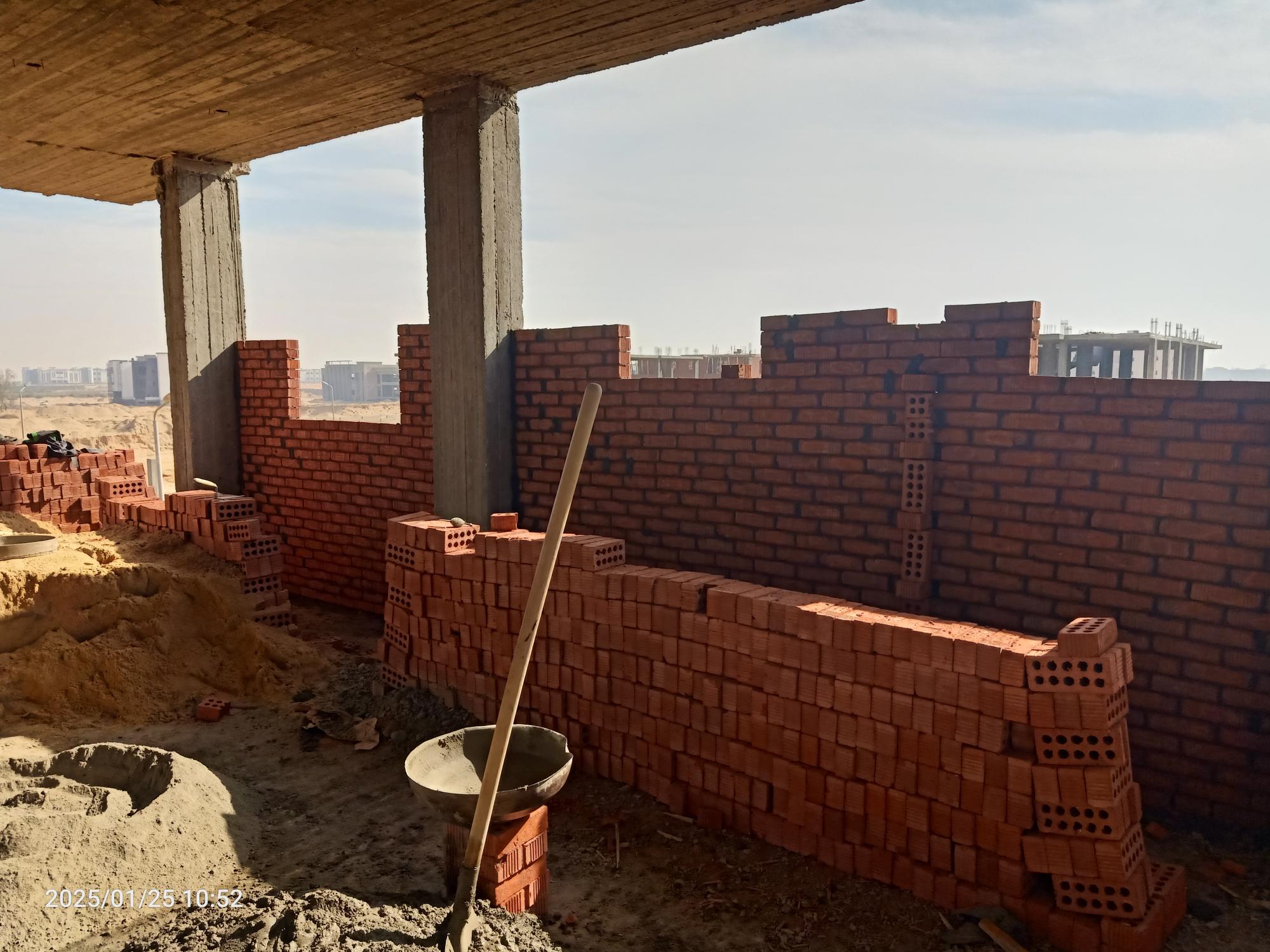

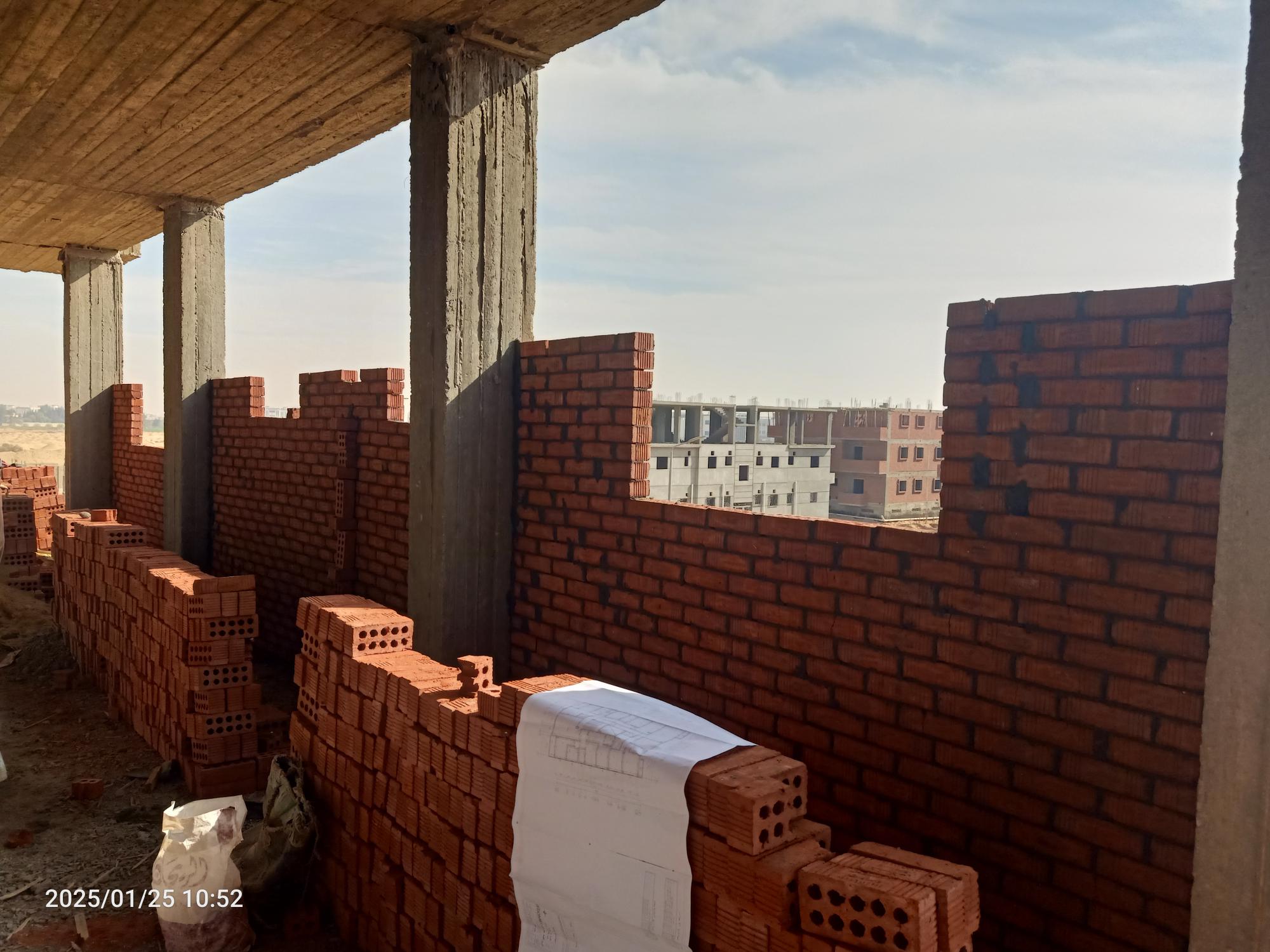

Second floor walls

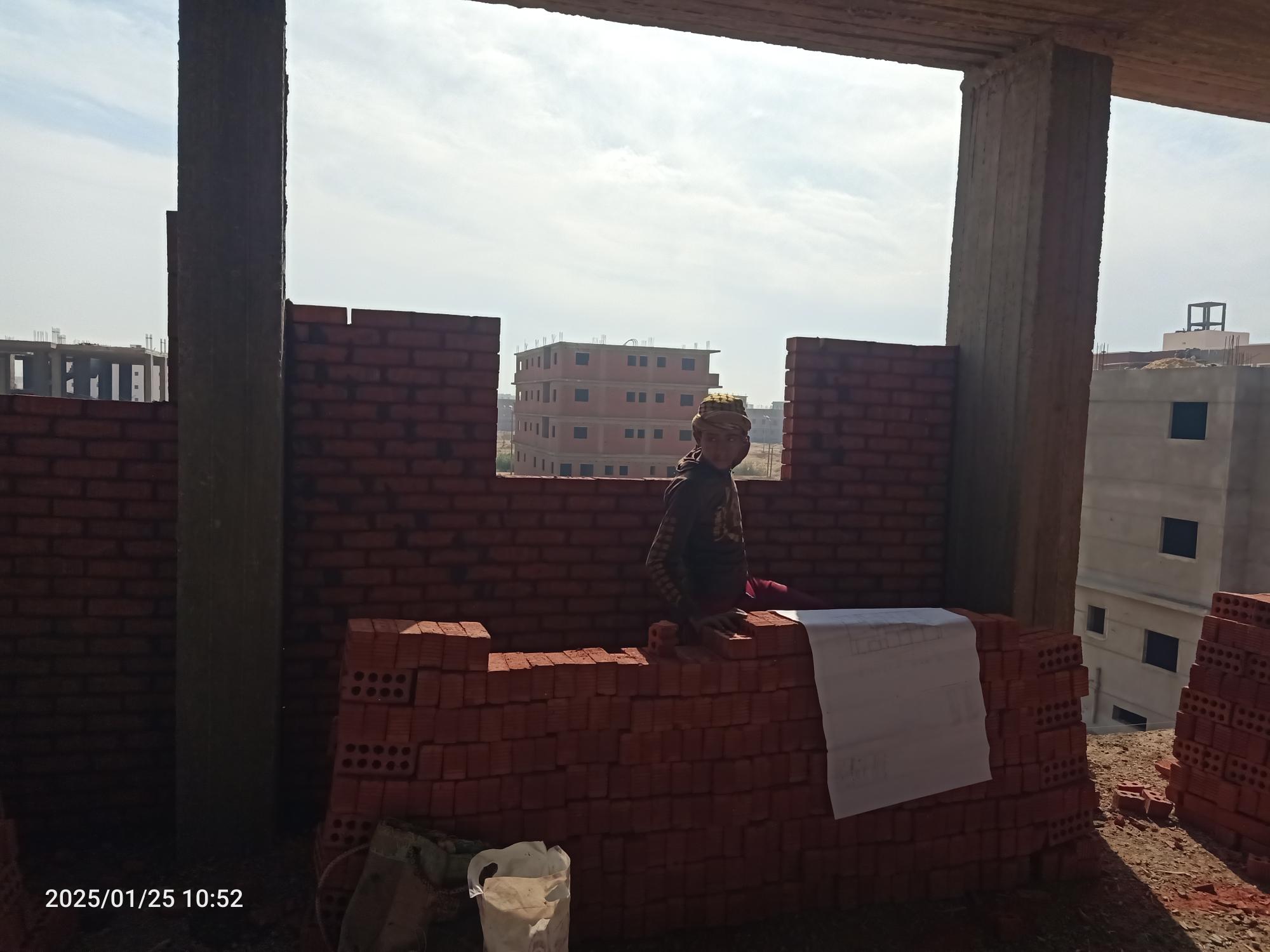

May 18, 2025

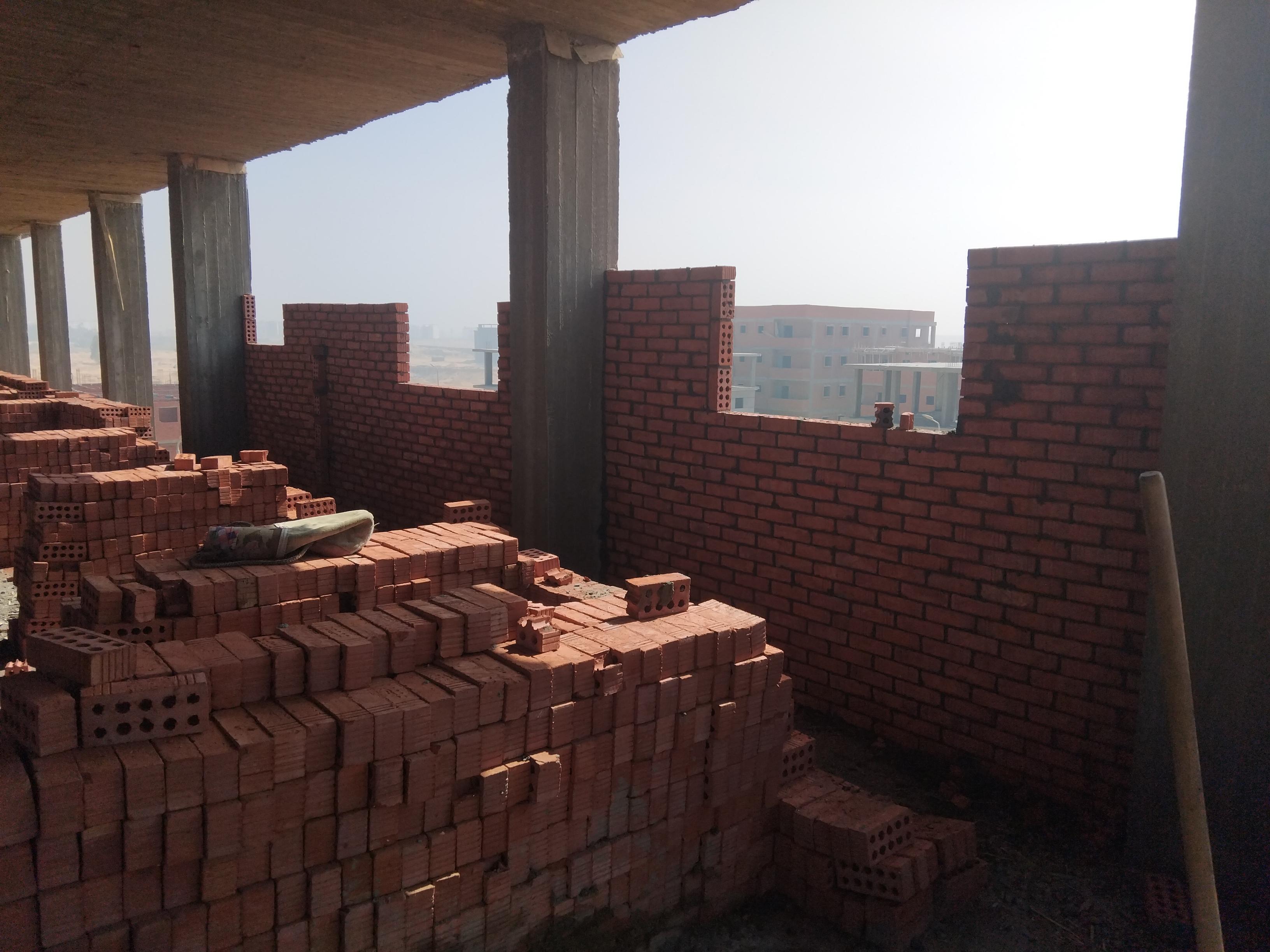

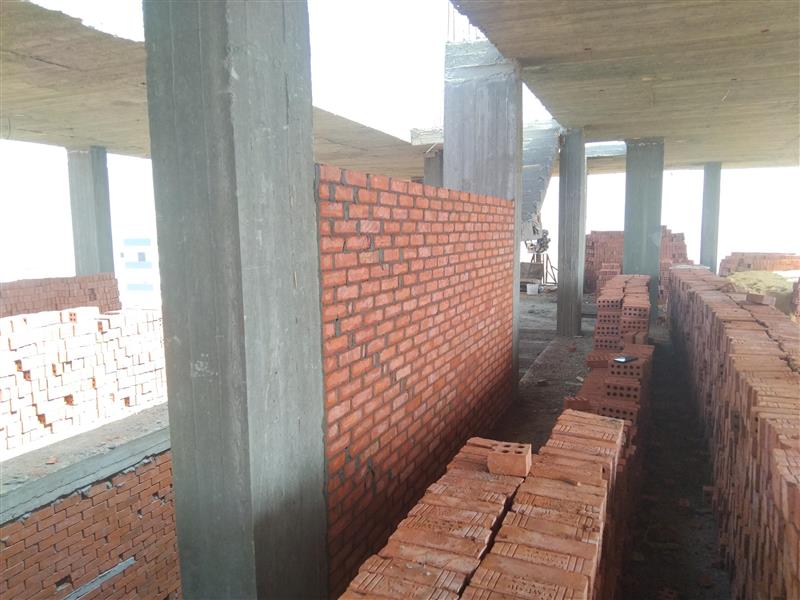

Third floor walls
May 28, 2025
Roof walls
June 8, 2025

Concrete works for the external wall
June 15, 2025

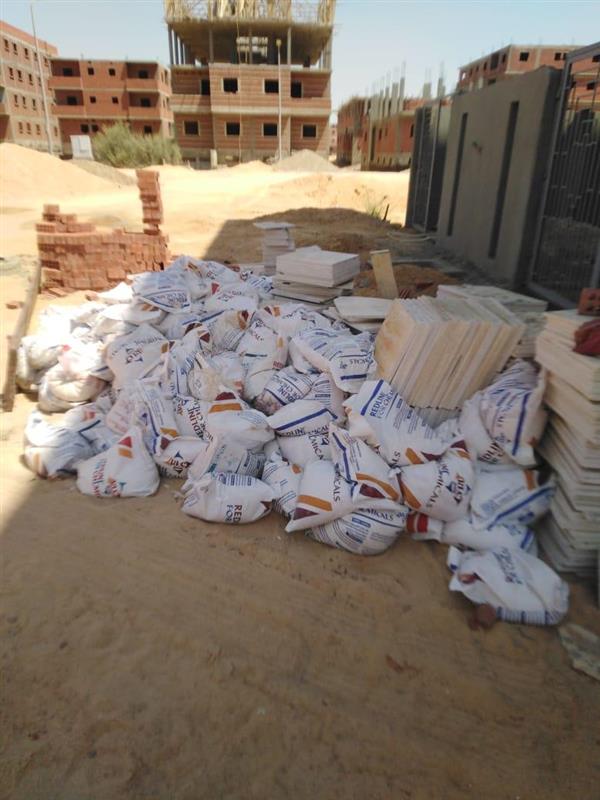

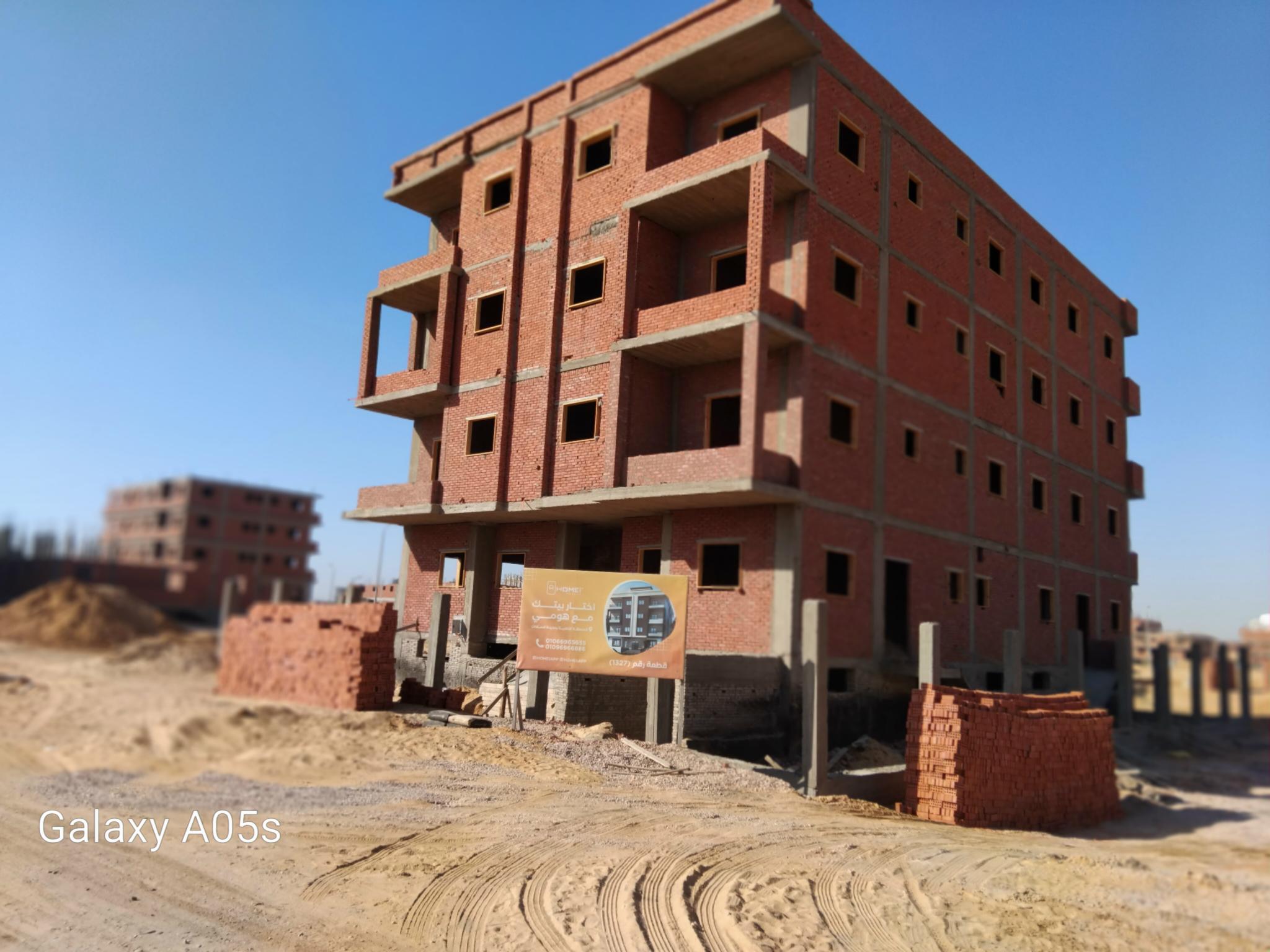

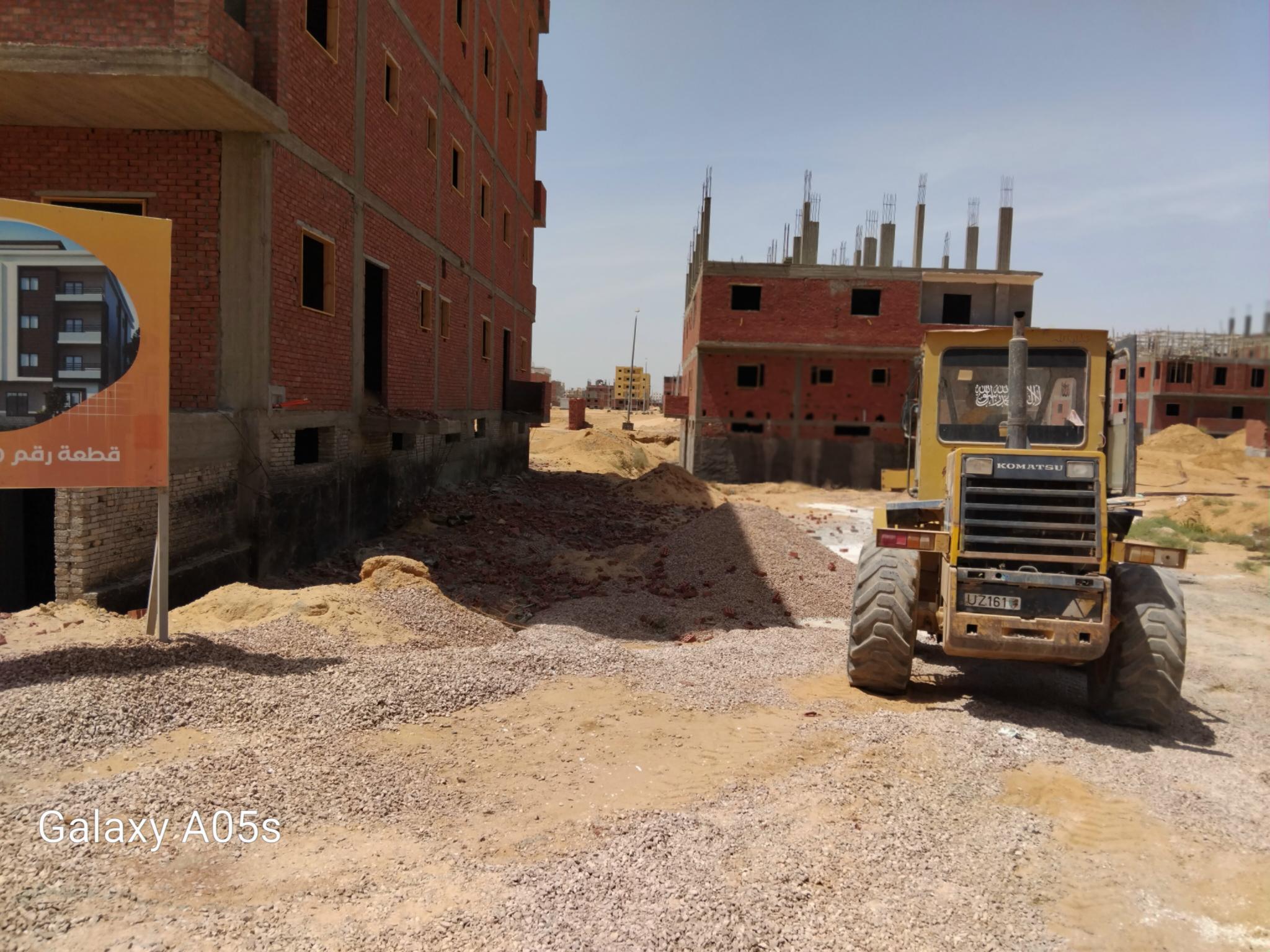

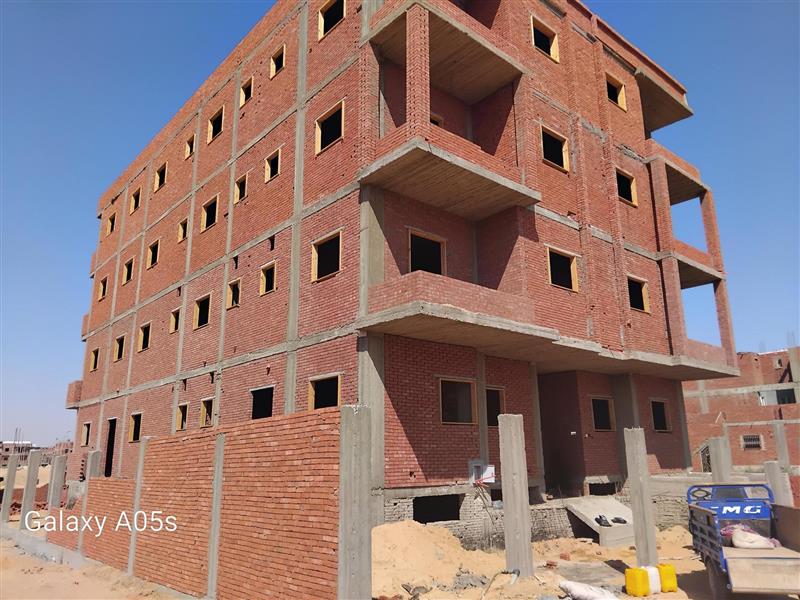

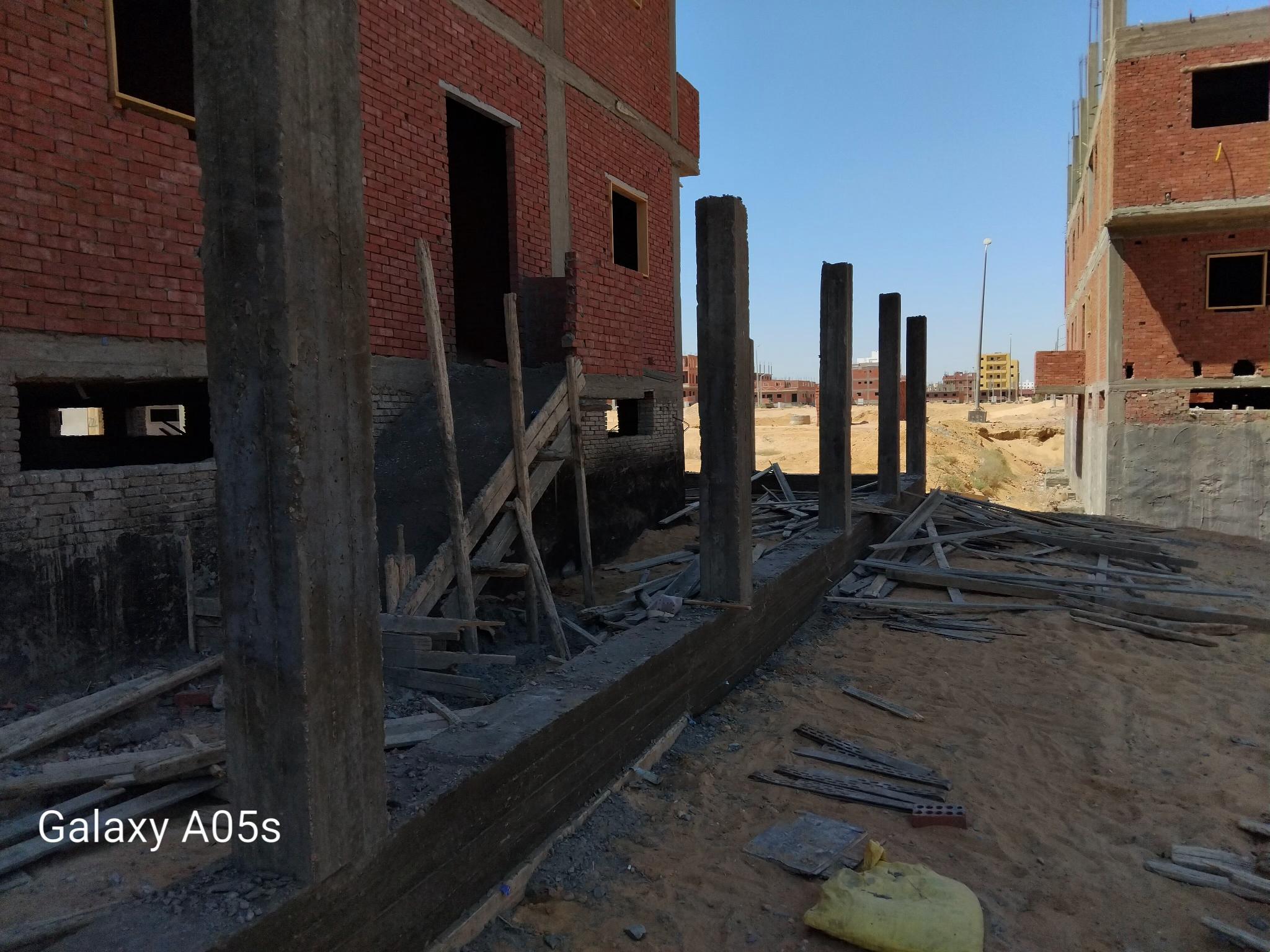

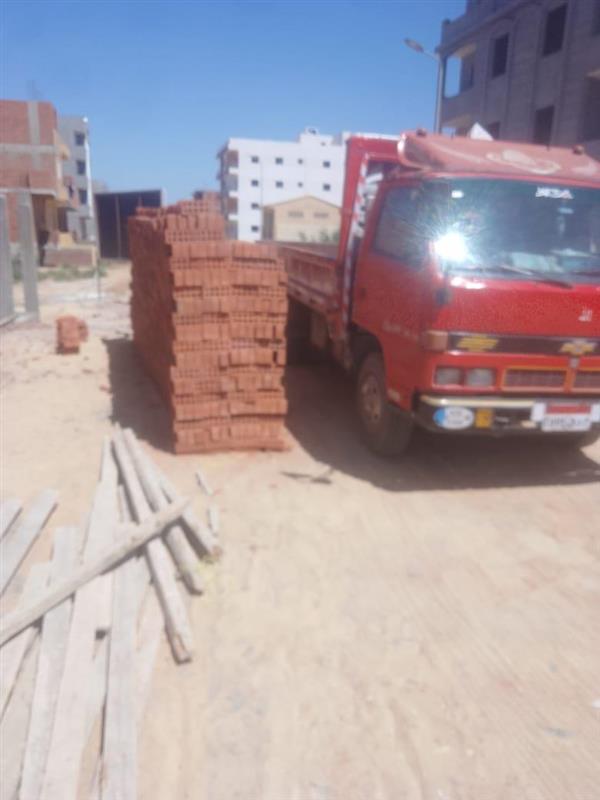

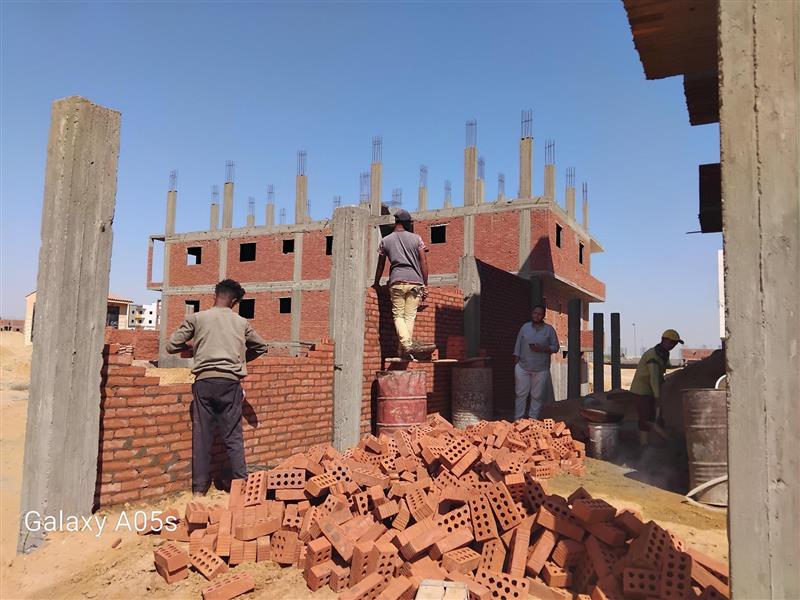

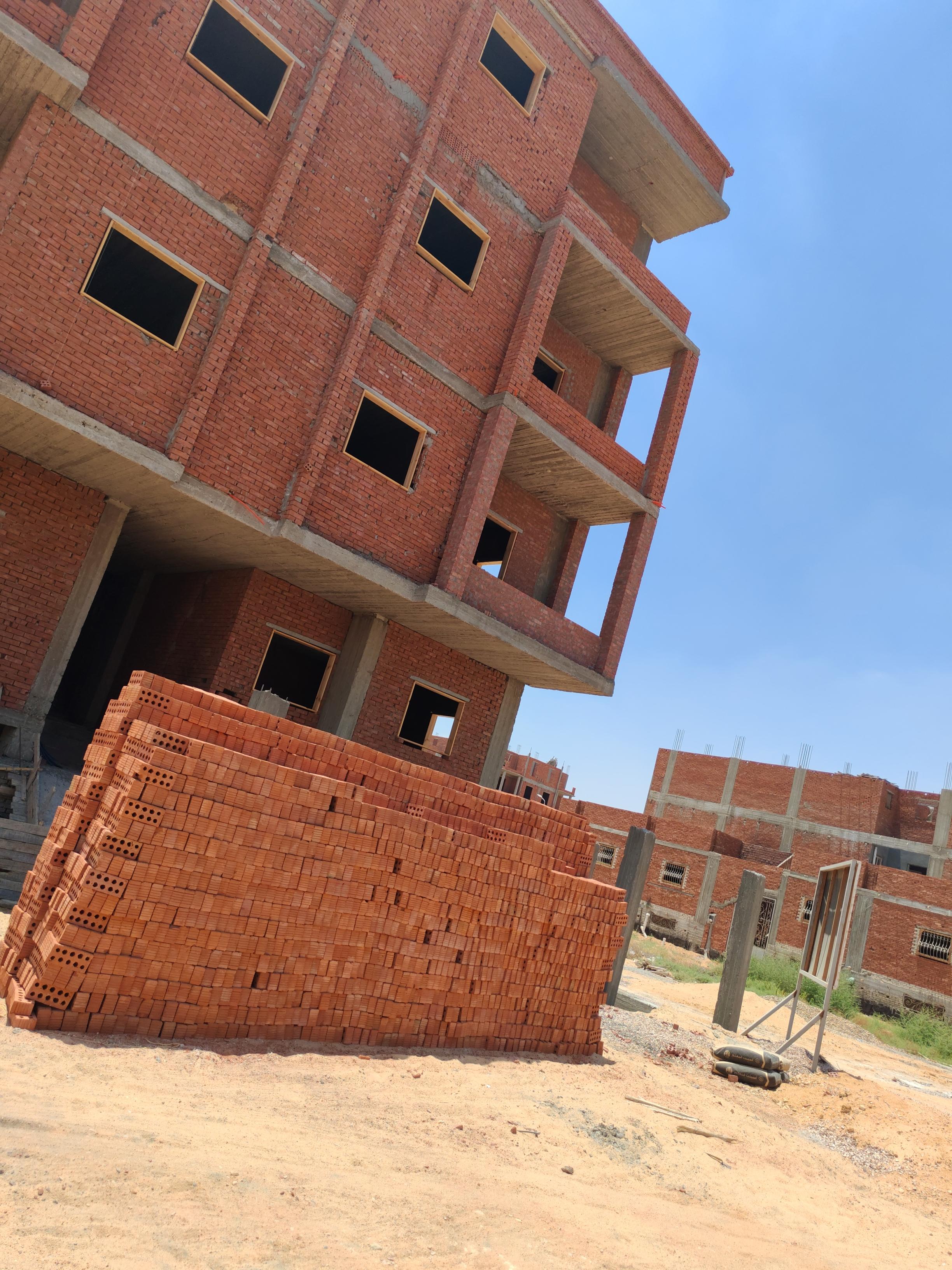

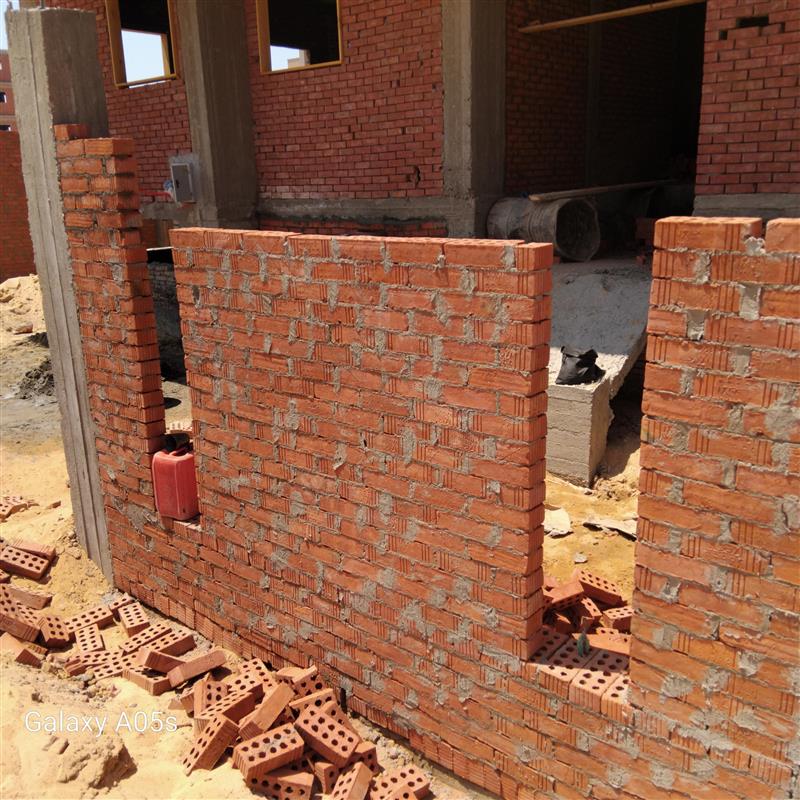

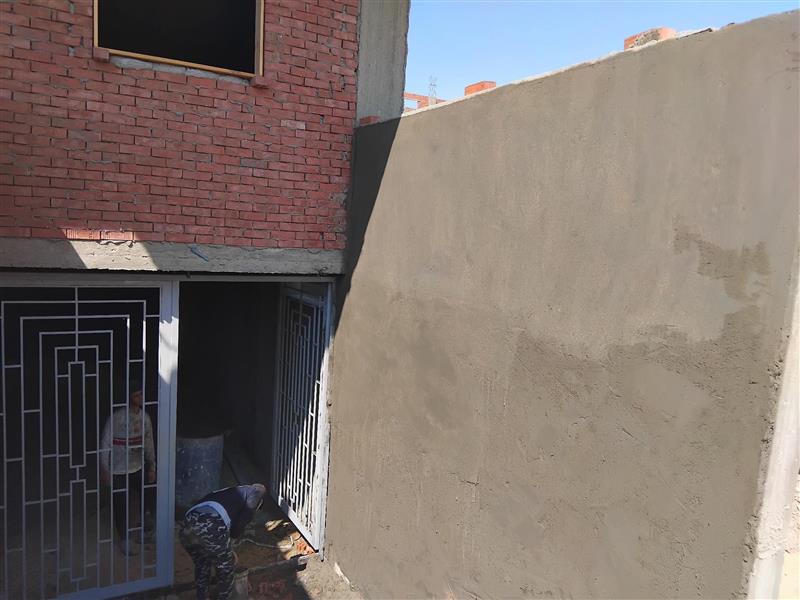

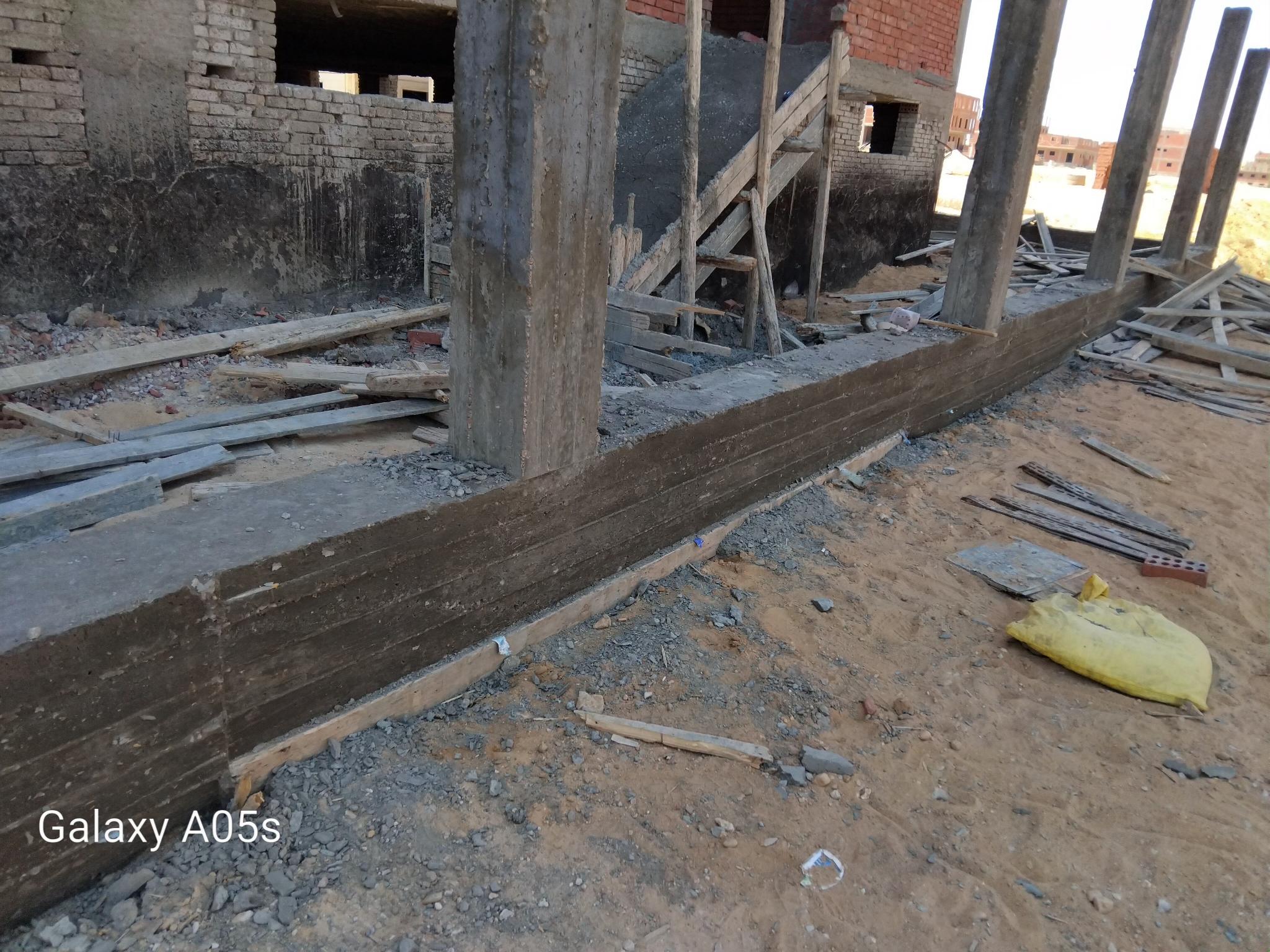

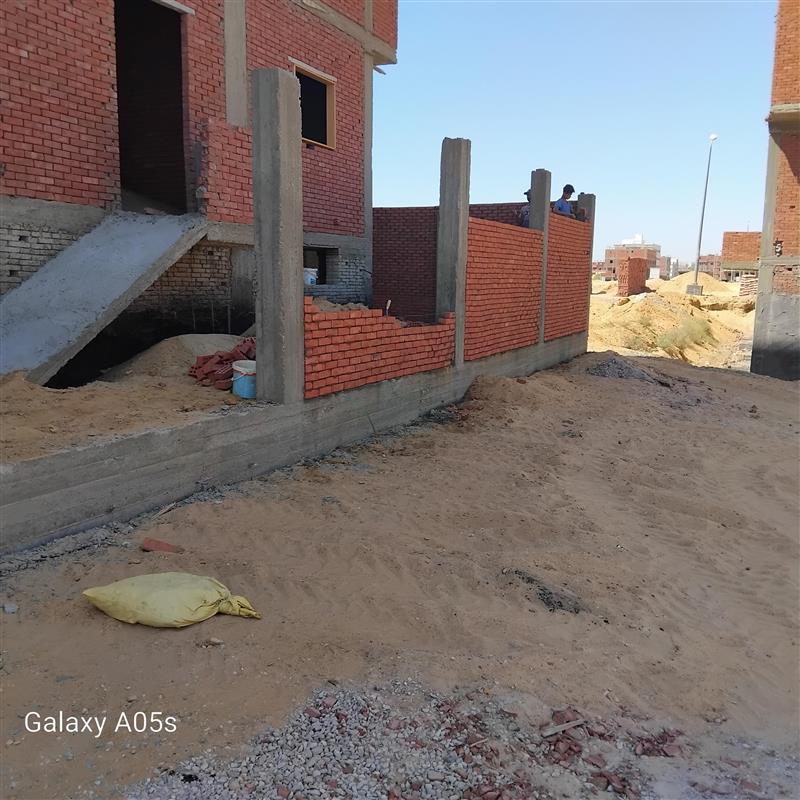

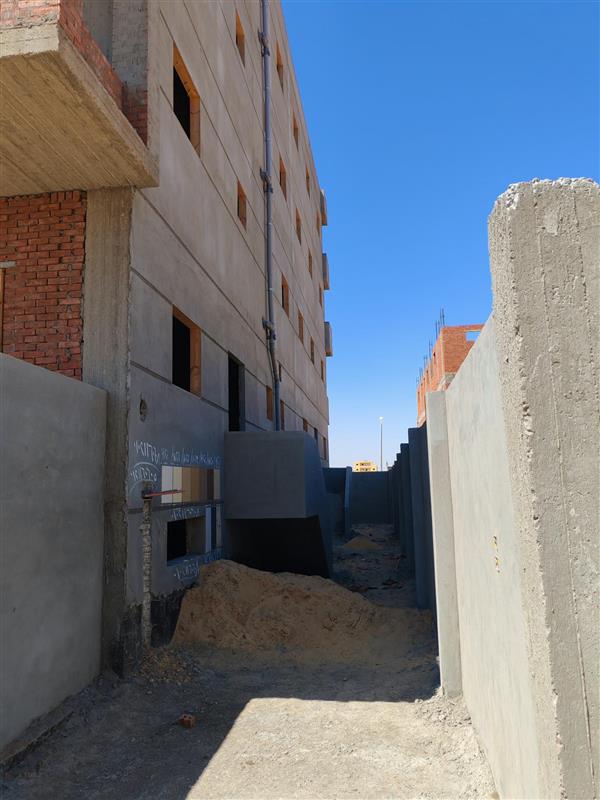

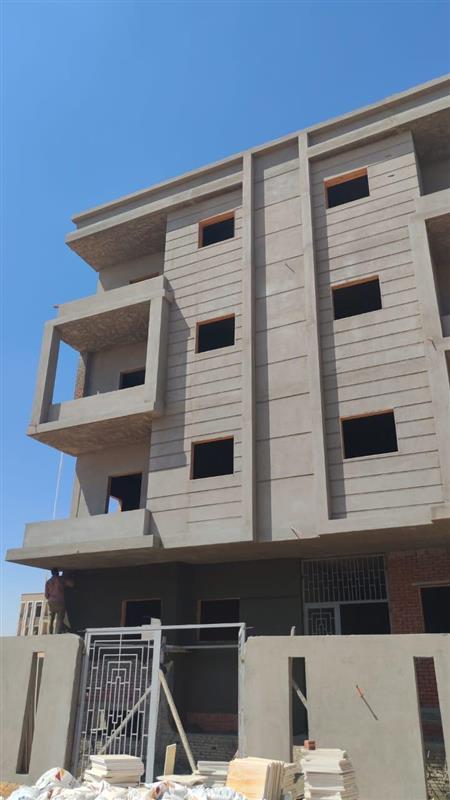

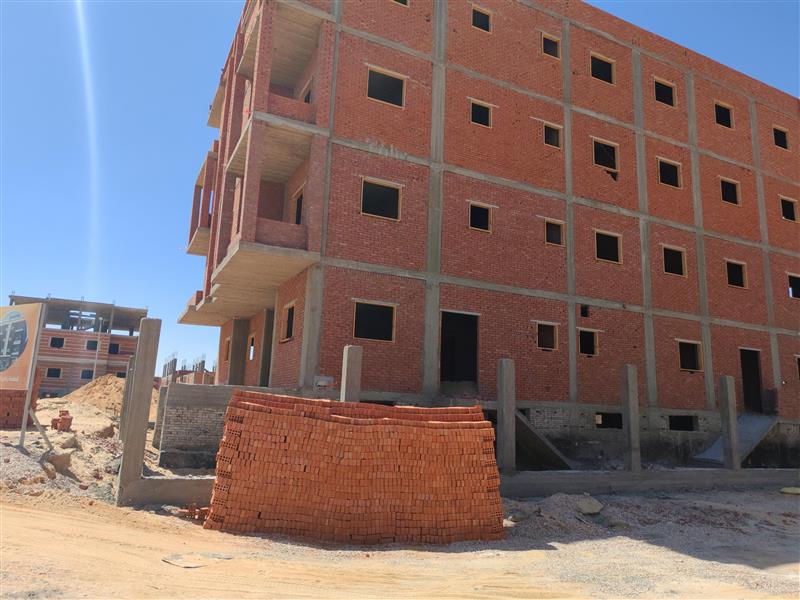

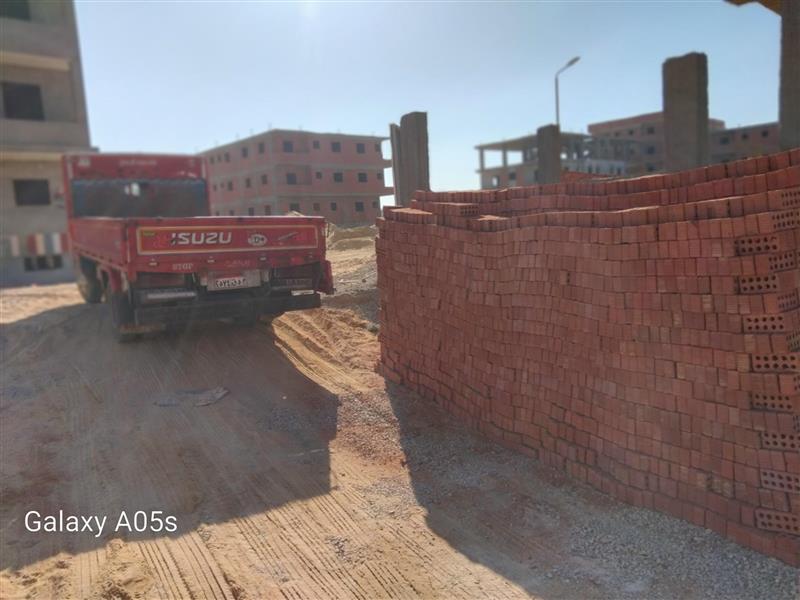

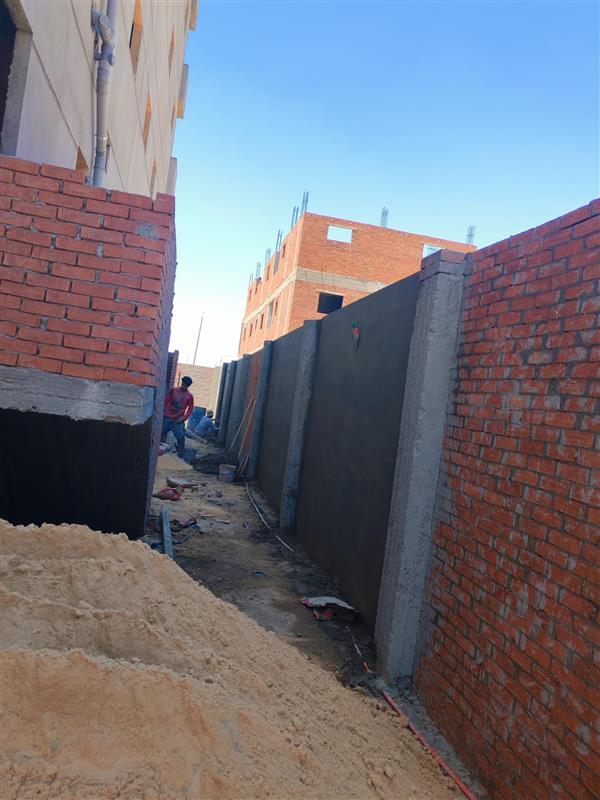

Wall Building works

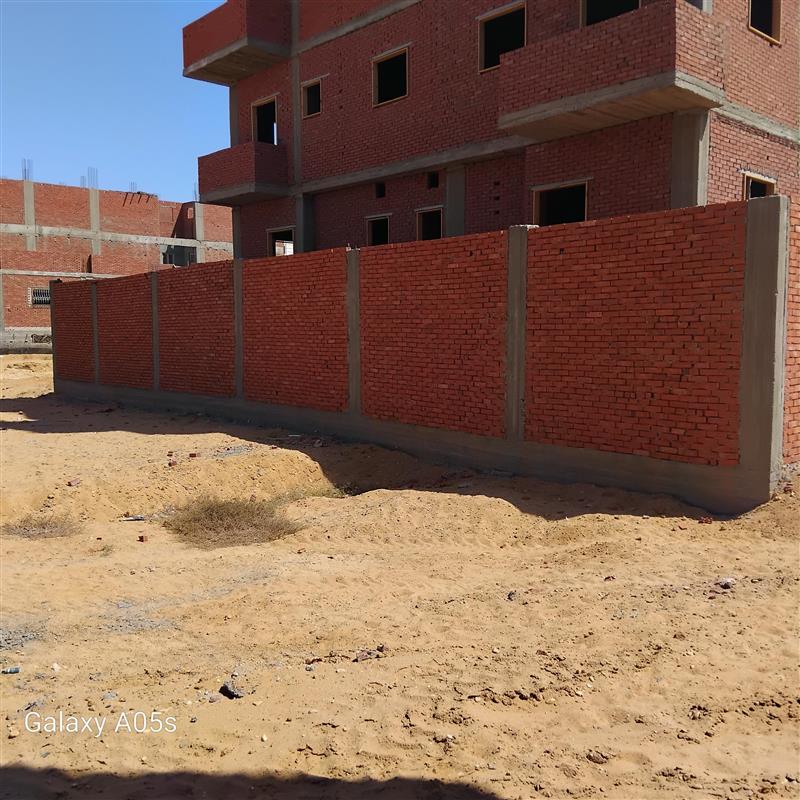

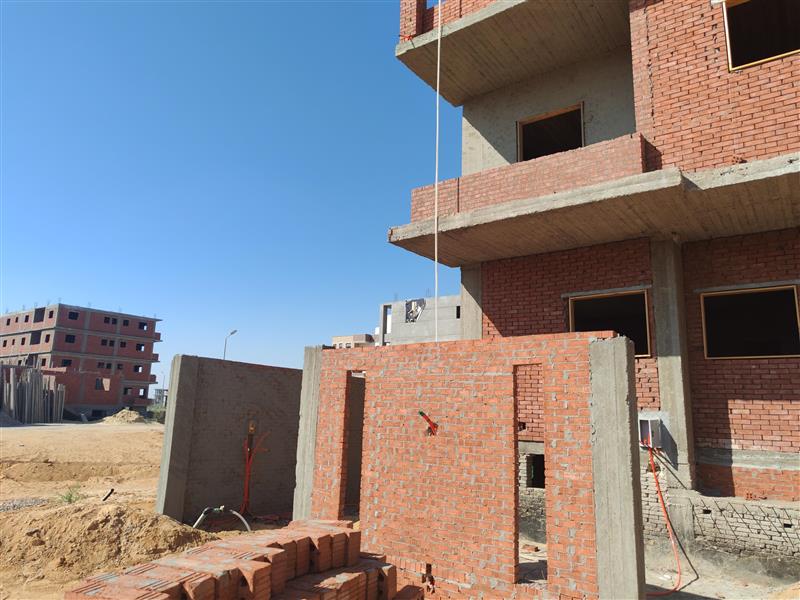

July 6, 2025

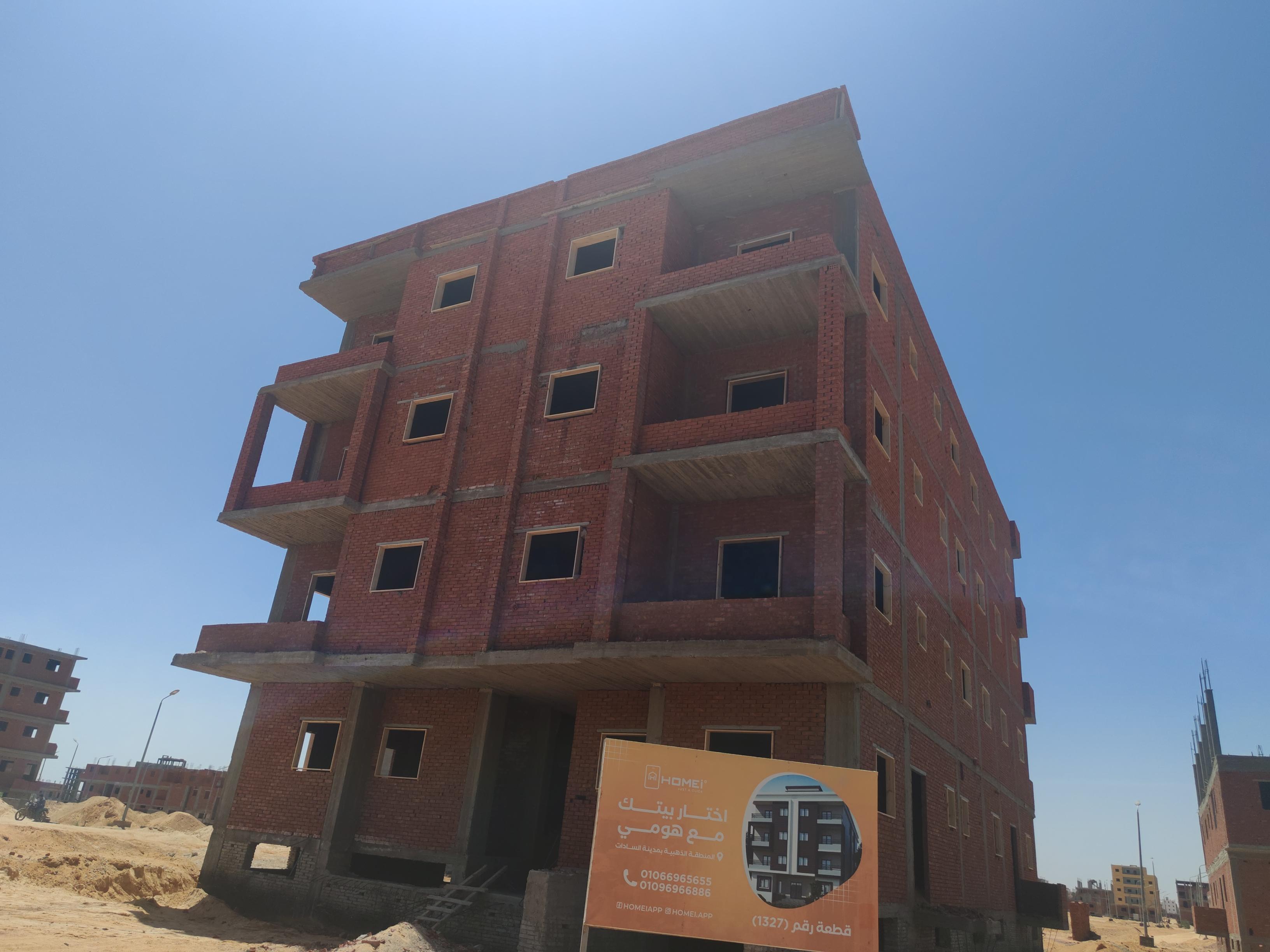

Wooden door frames

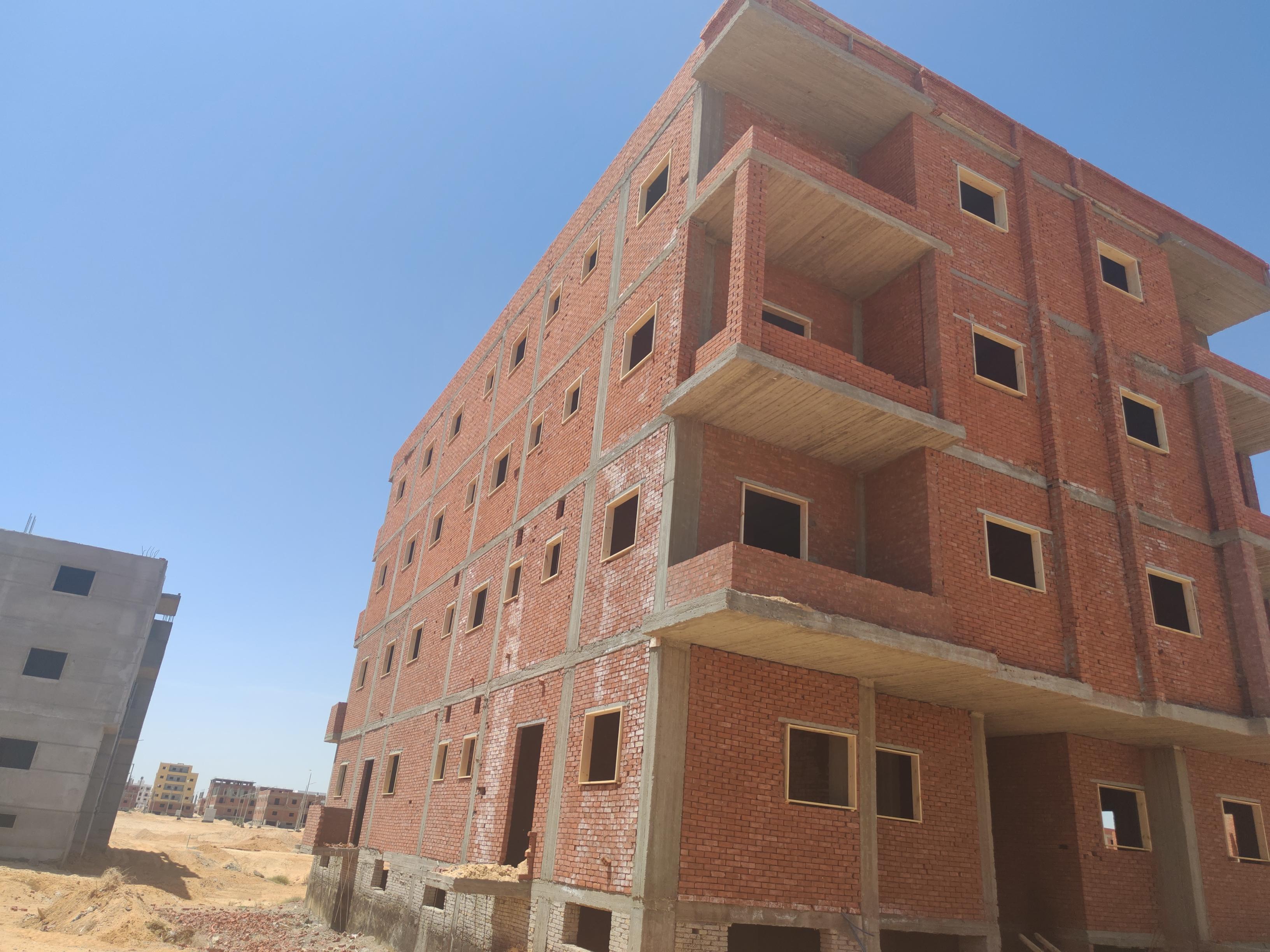

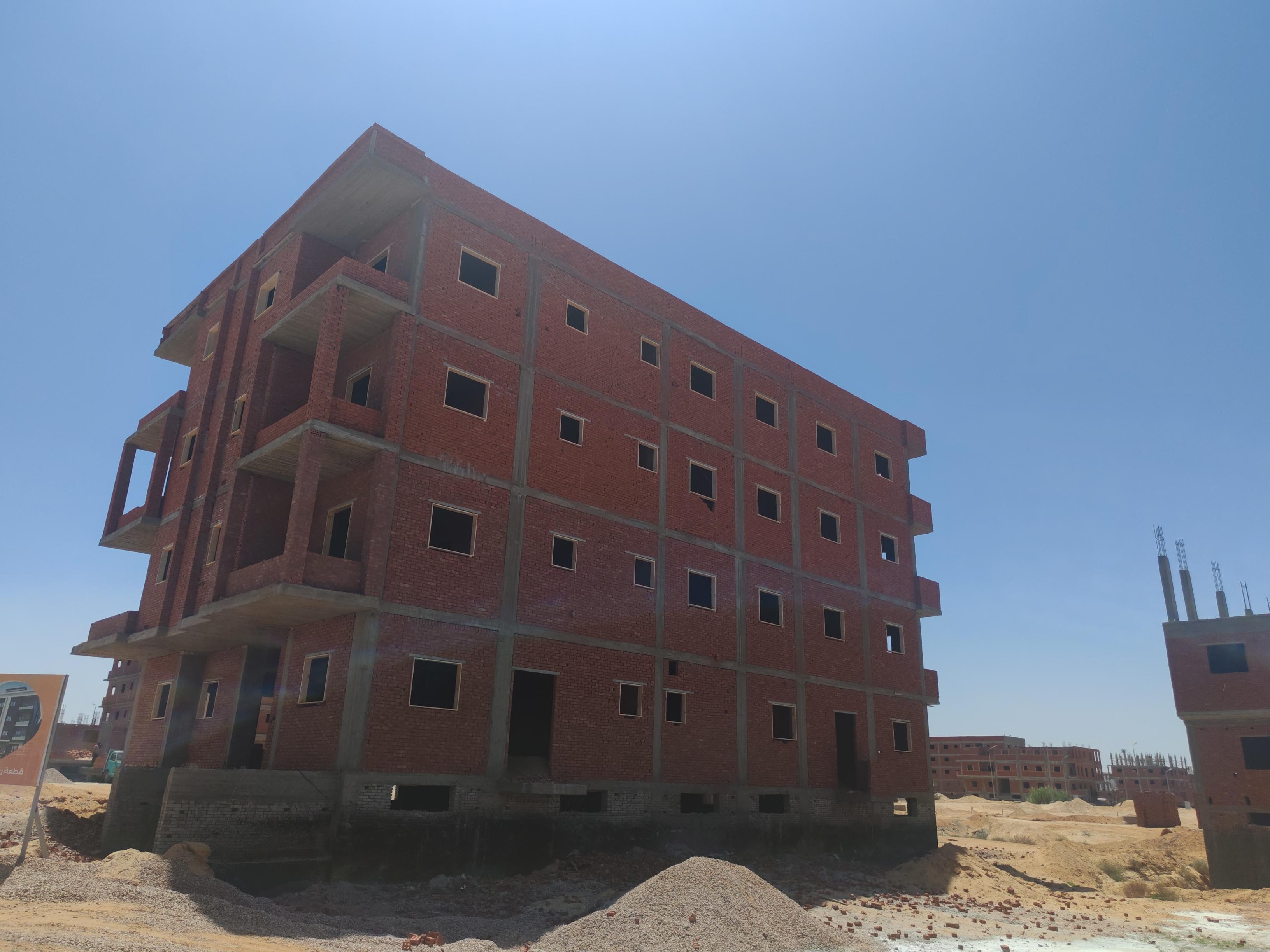

July 6, 2025

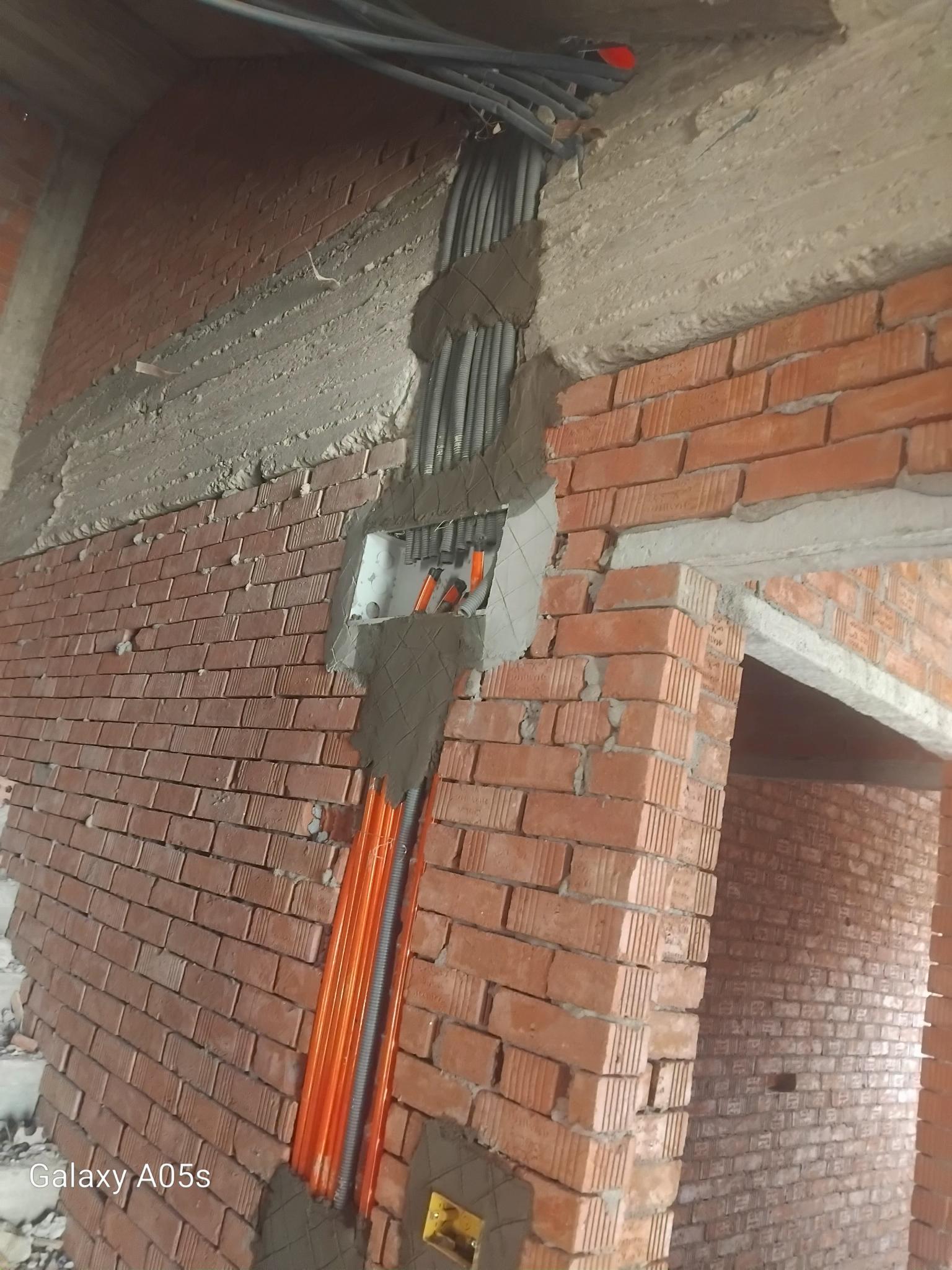

Electrical works
July 7, 2025

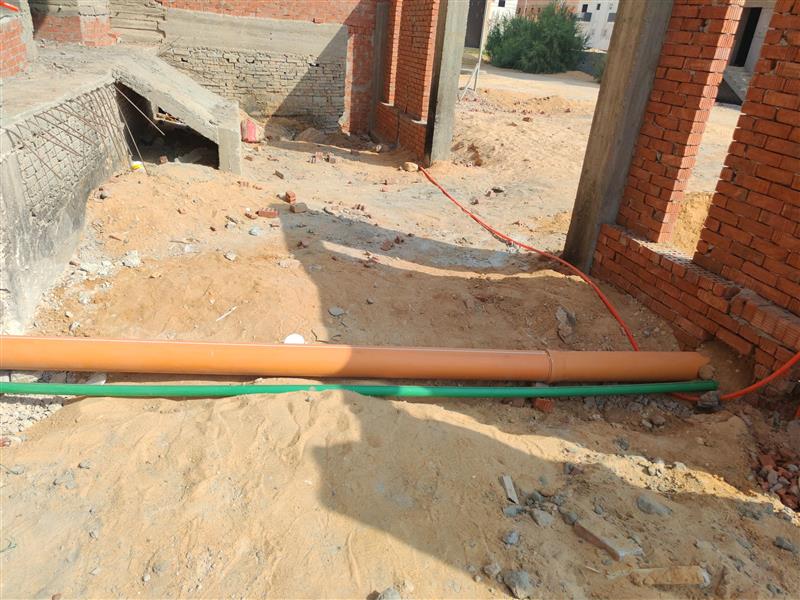

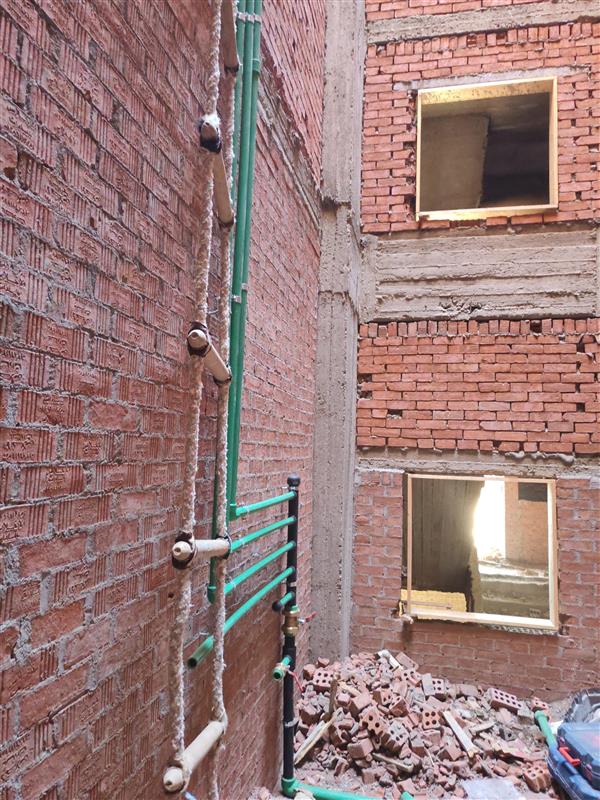

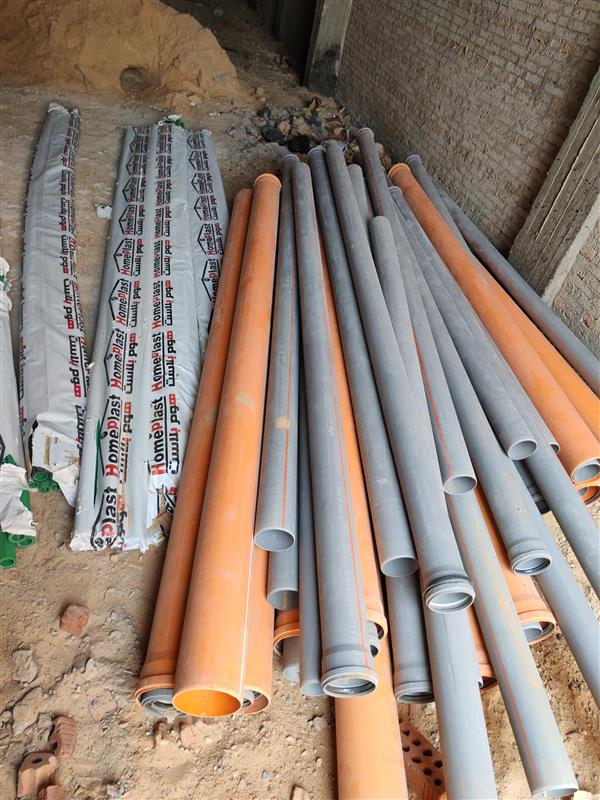

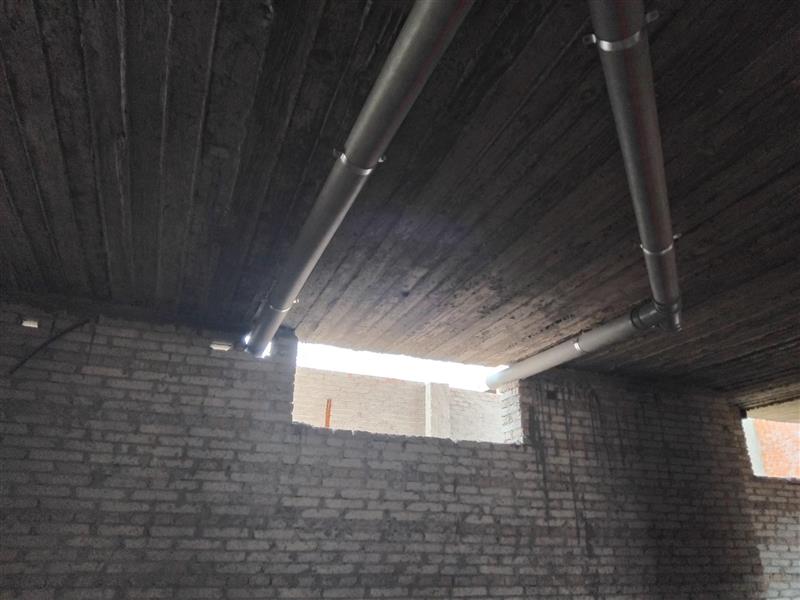

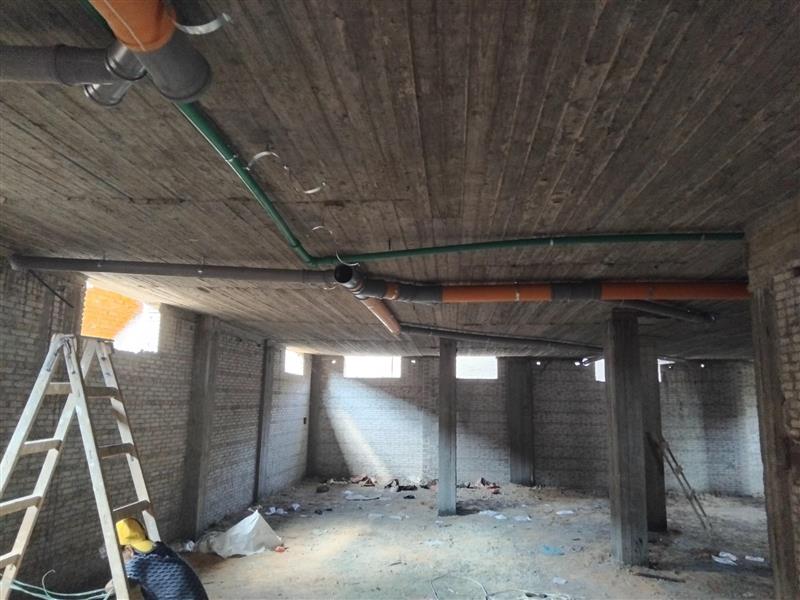

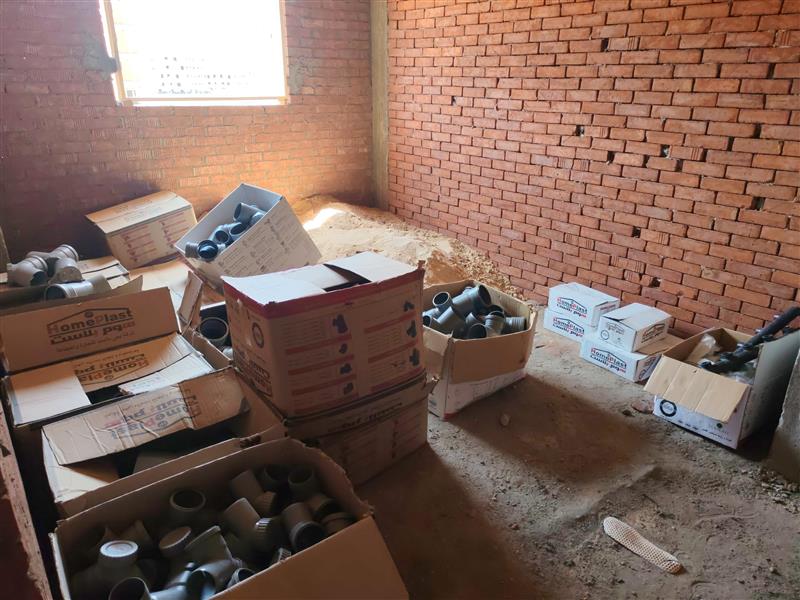

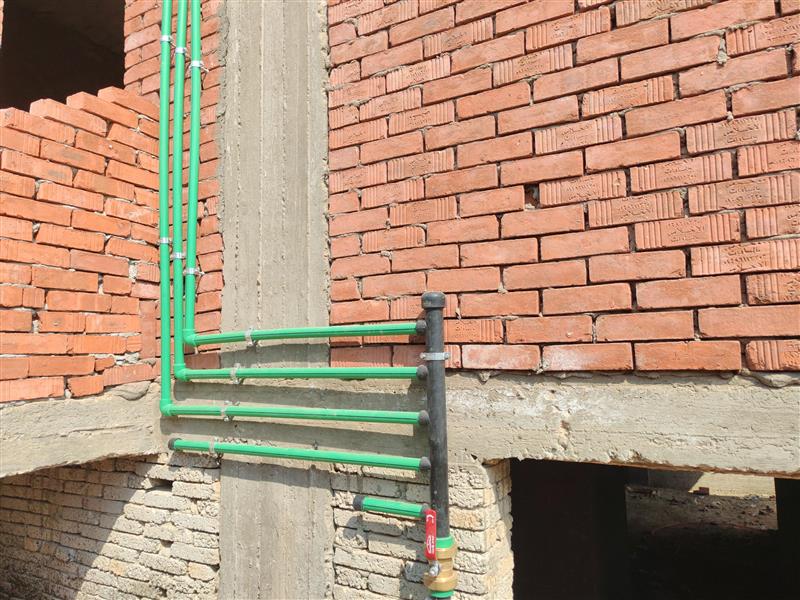

Plumbing works

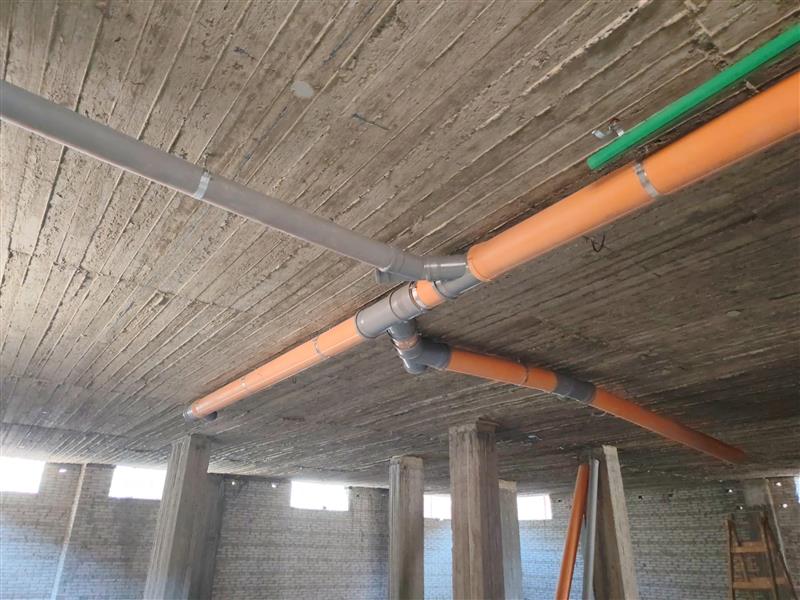

July 8, 2025

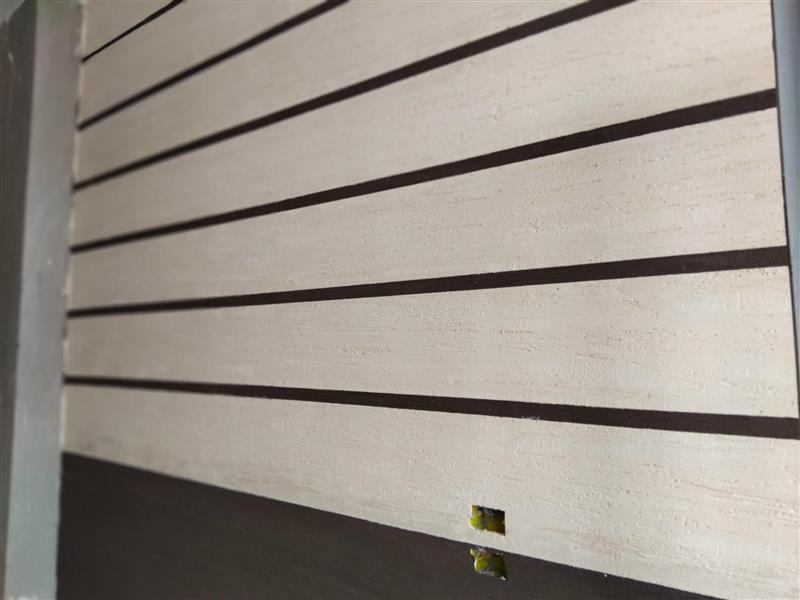

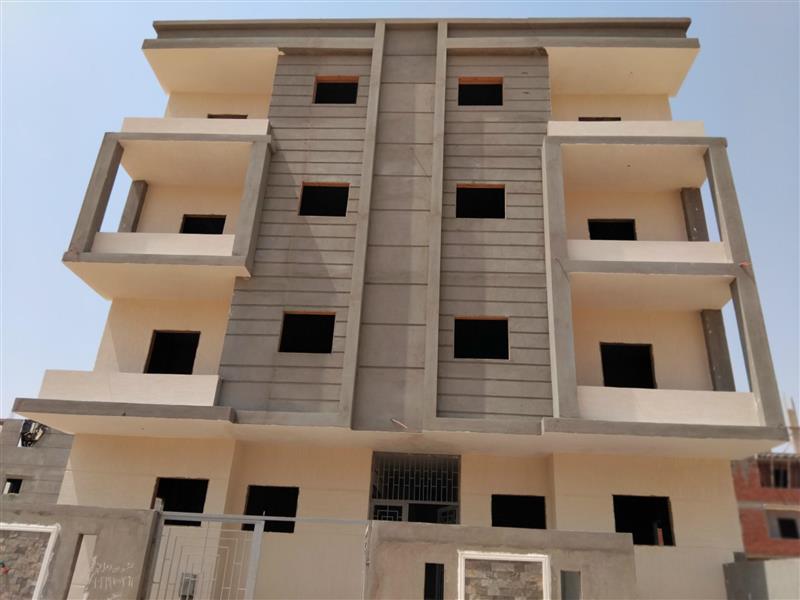

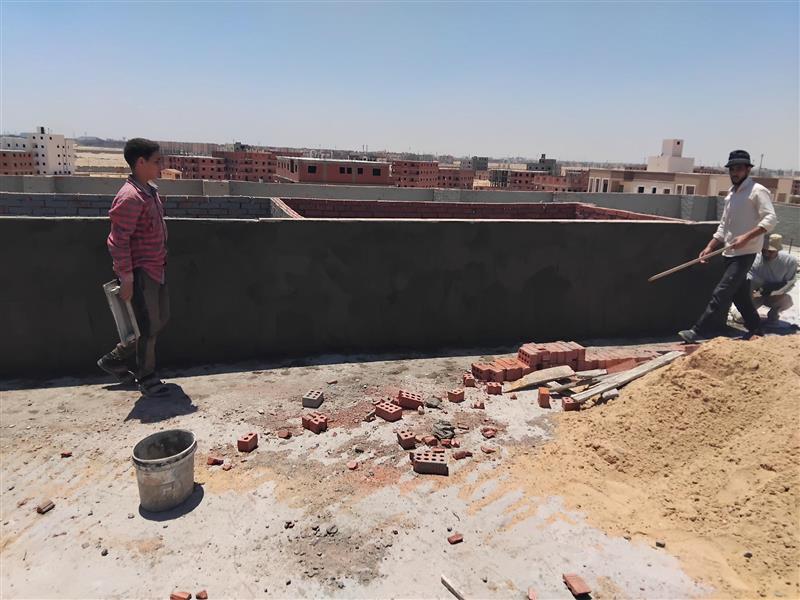

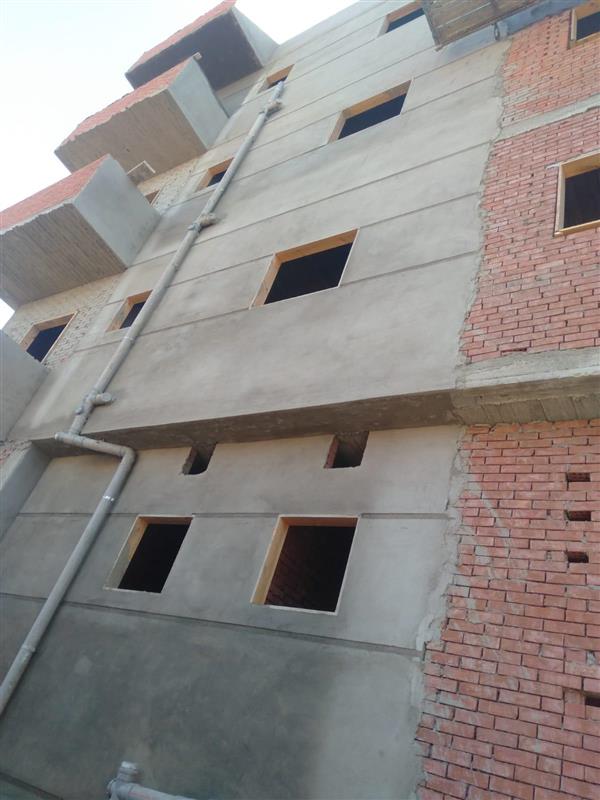

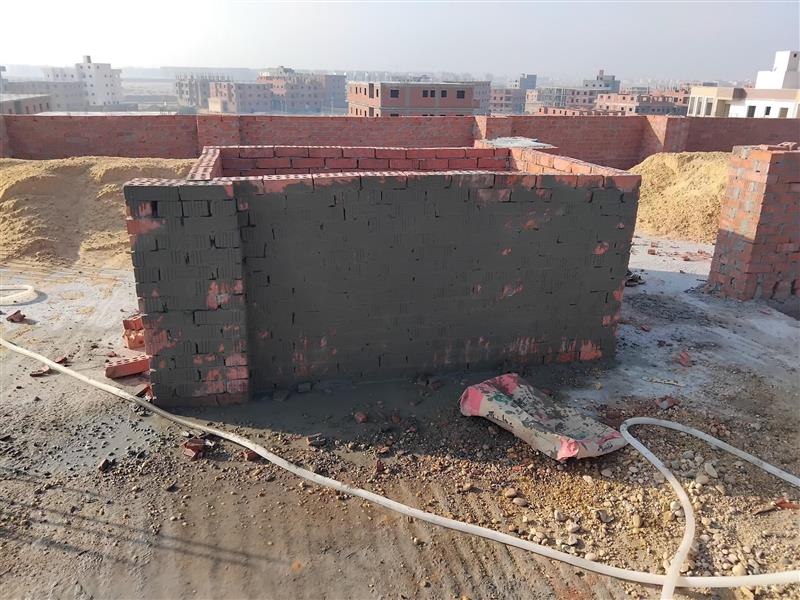

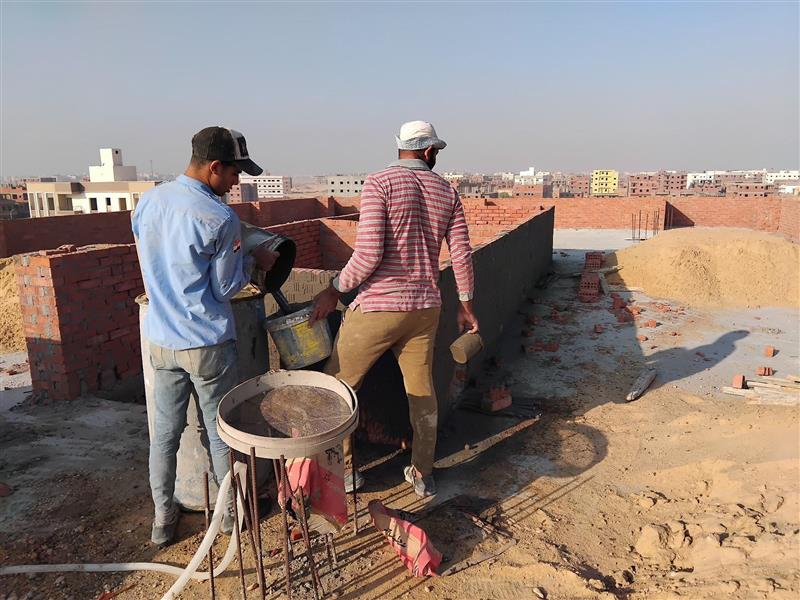

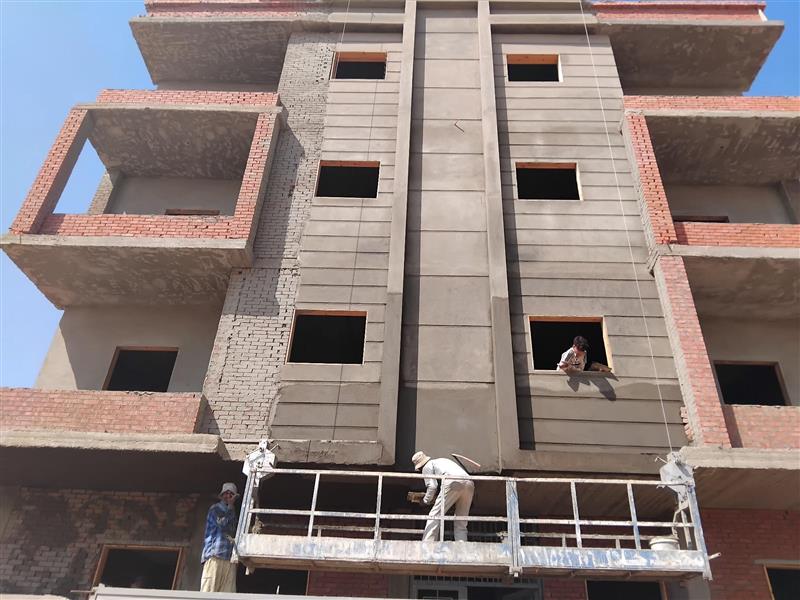

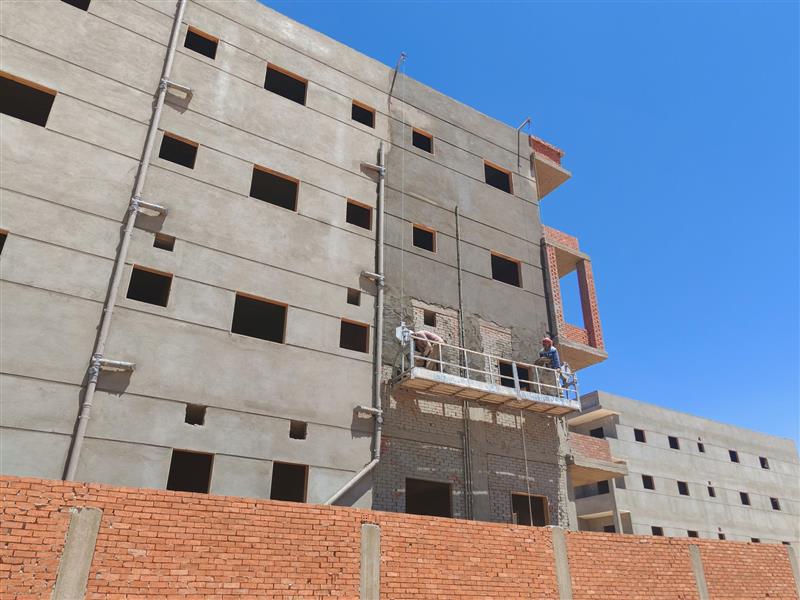

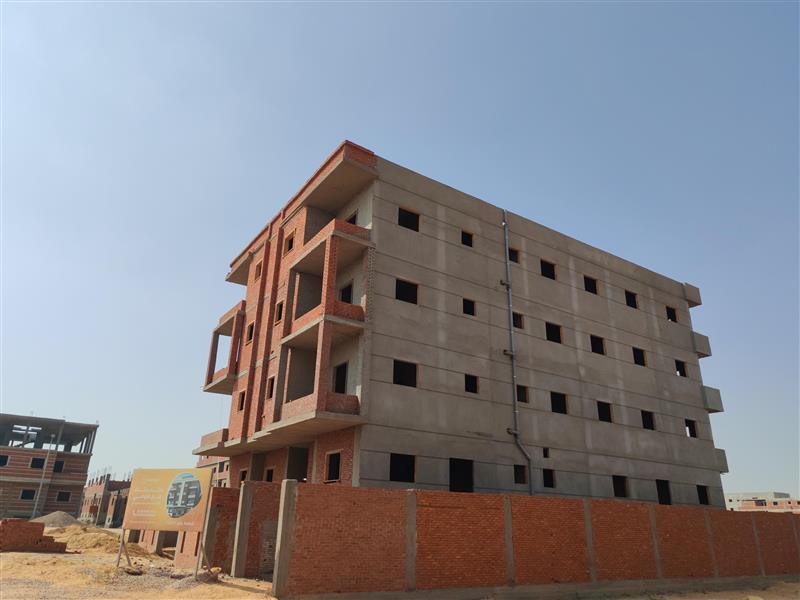

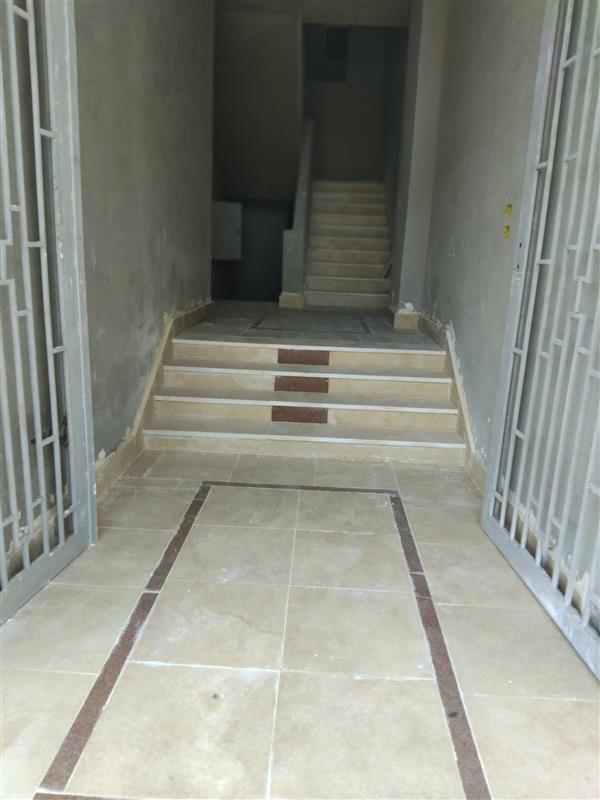

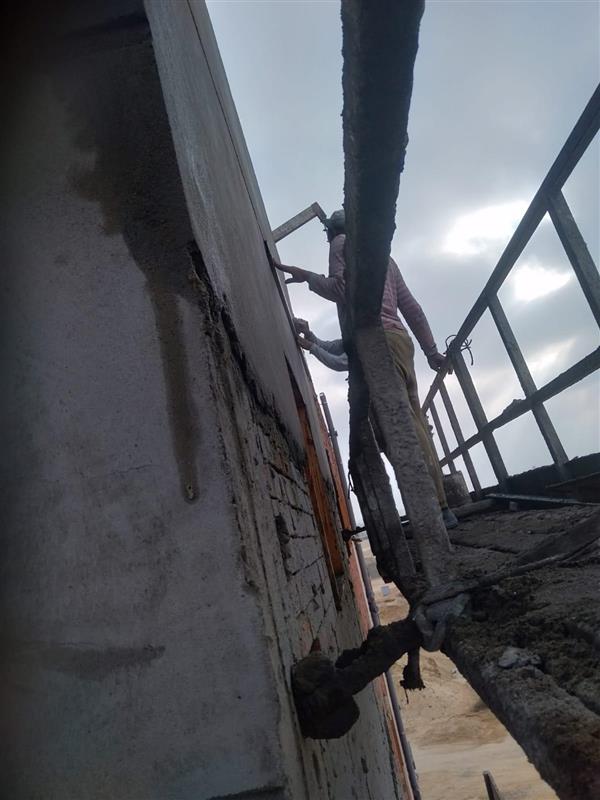

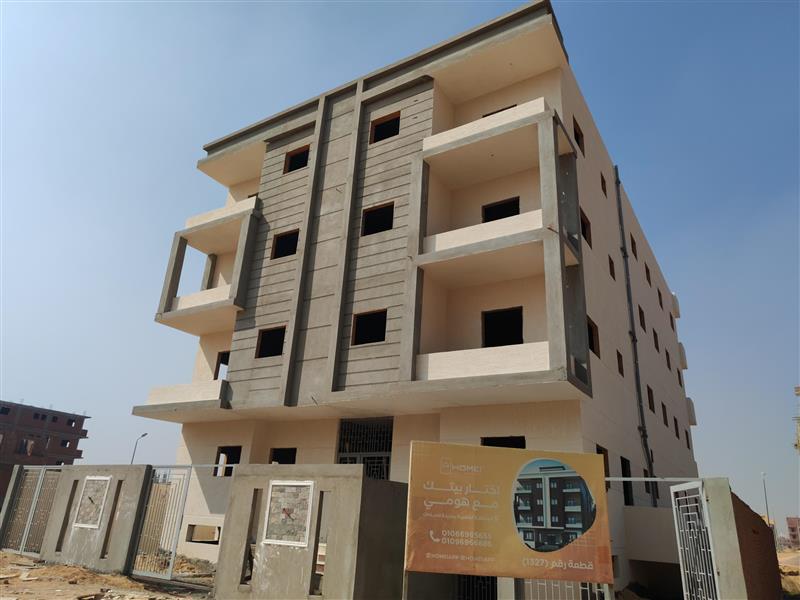

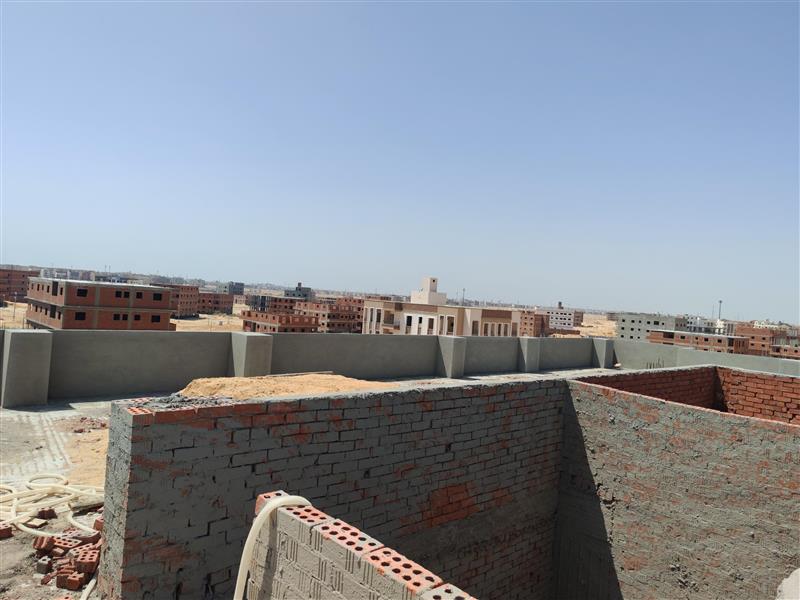

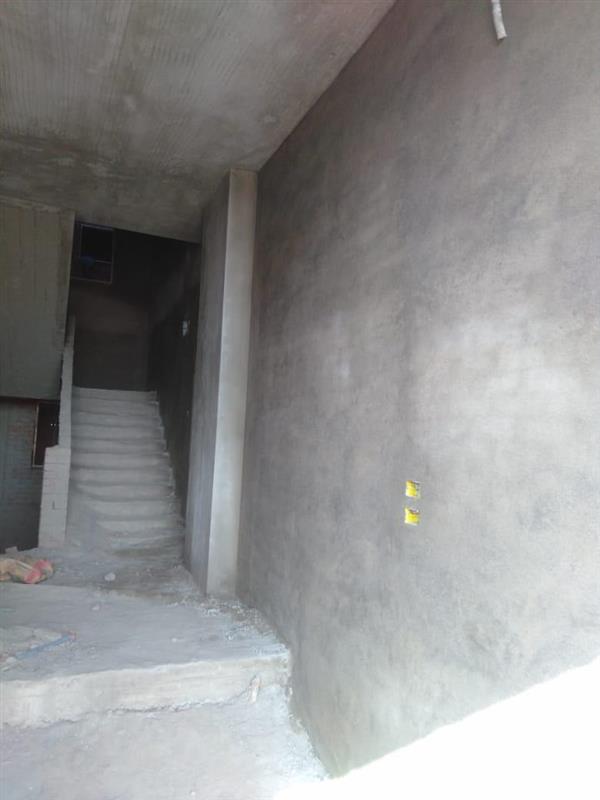

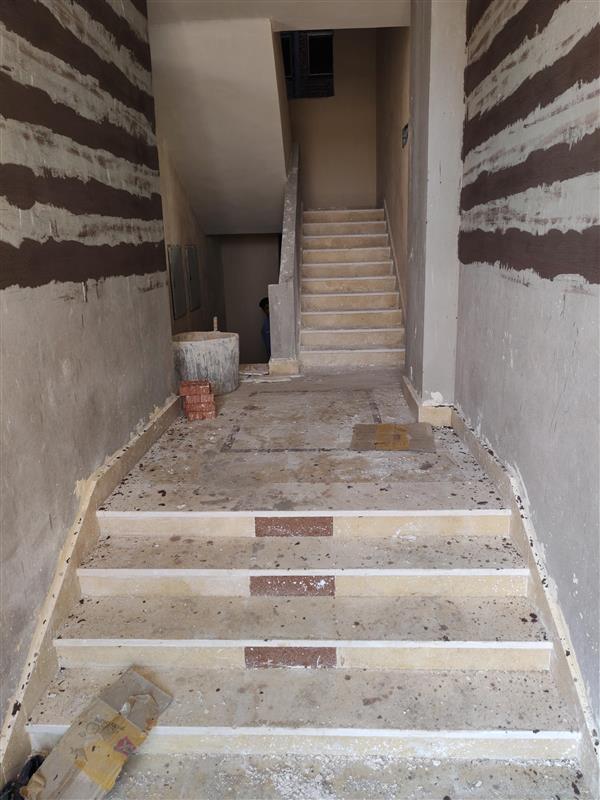

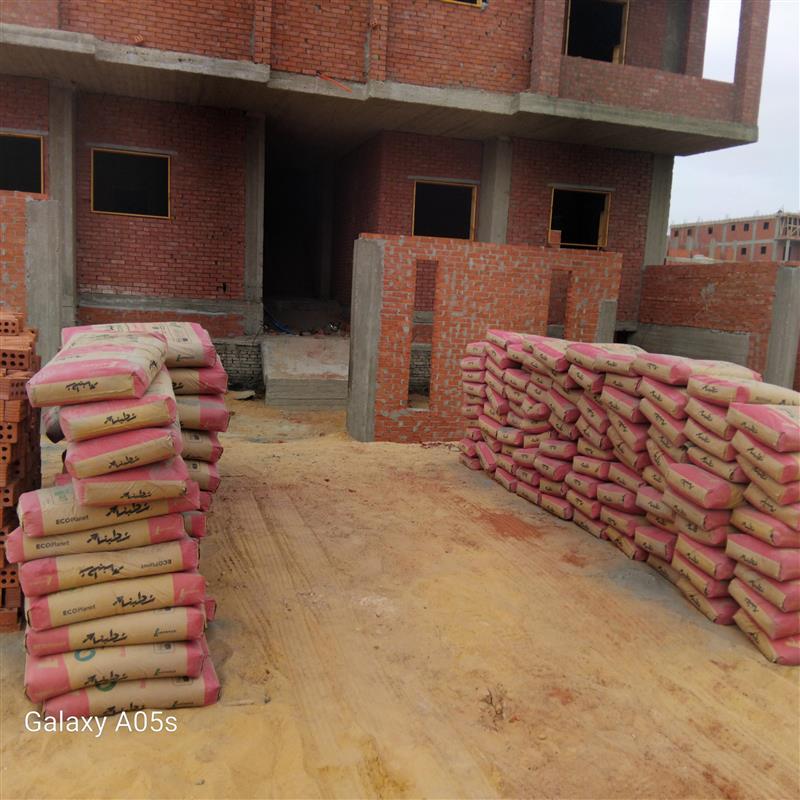

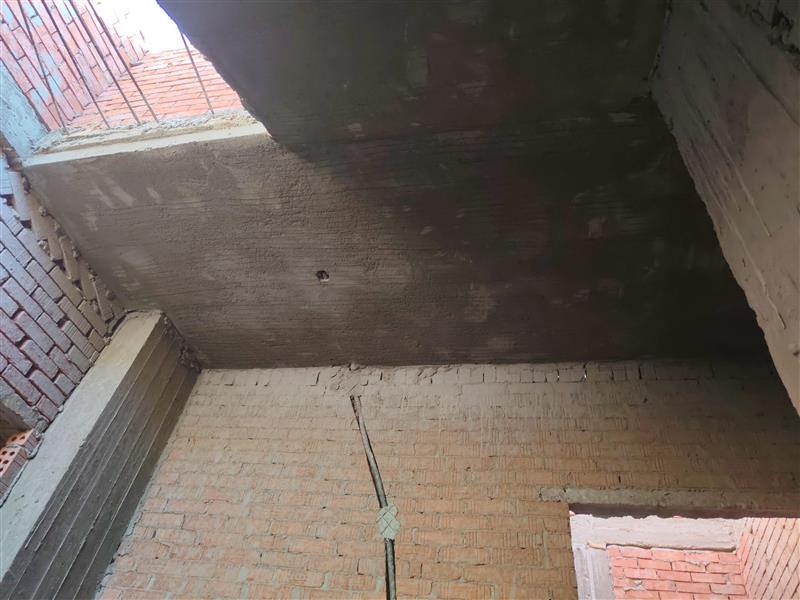

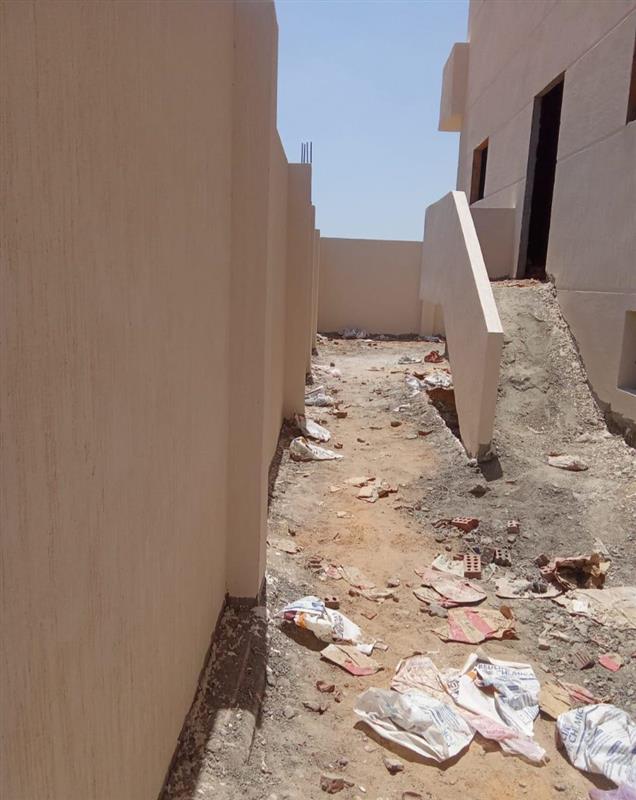

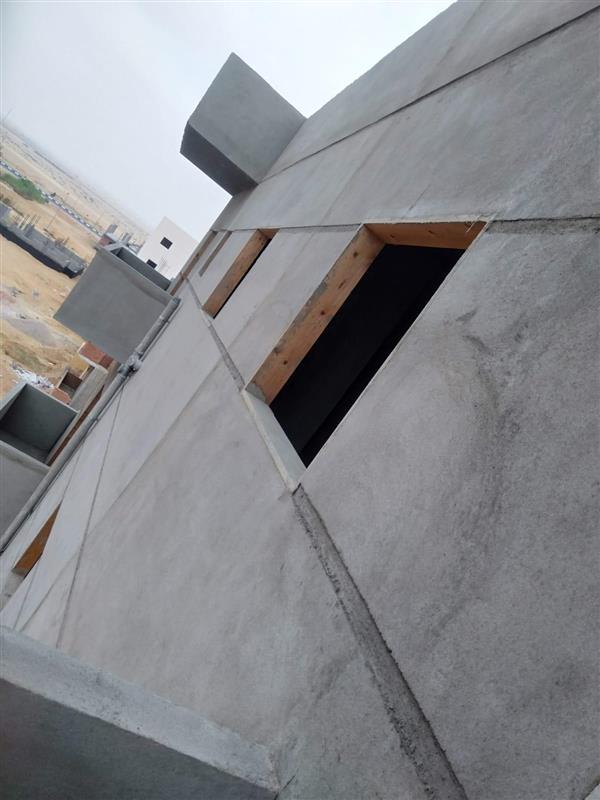

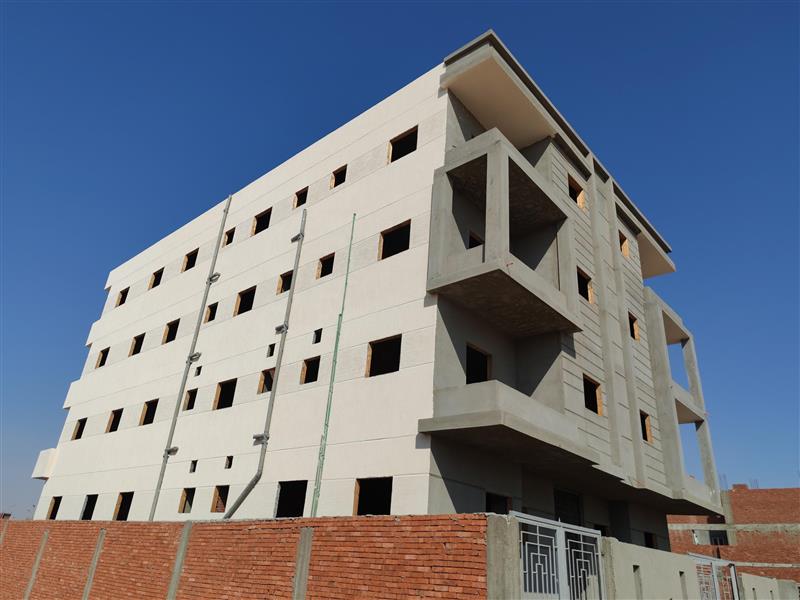

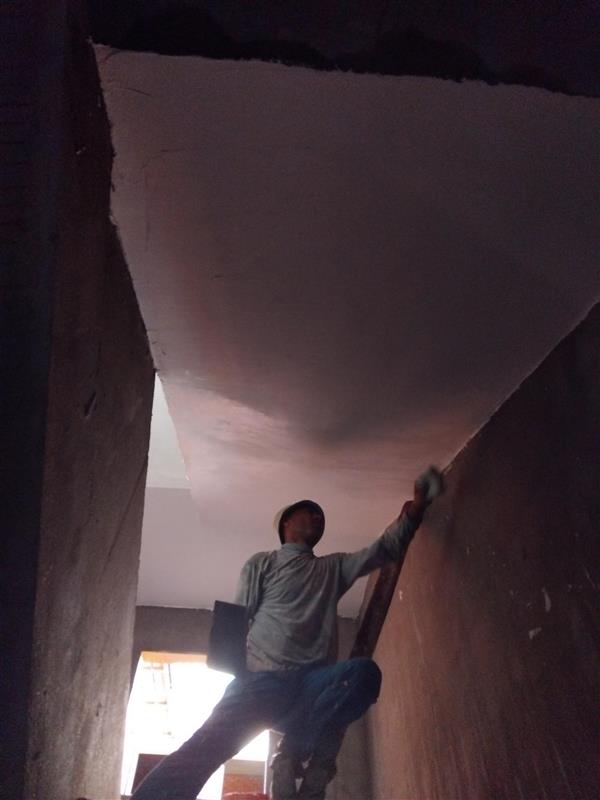

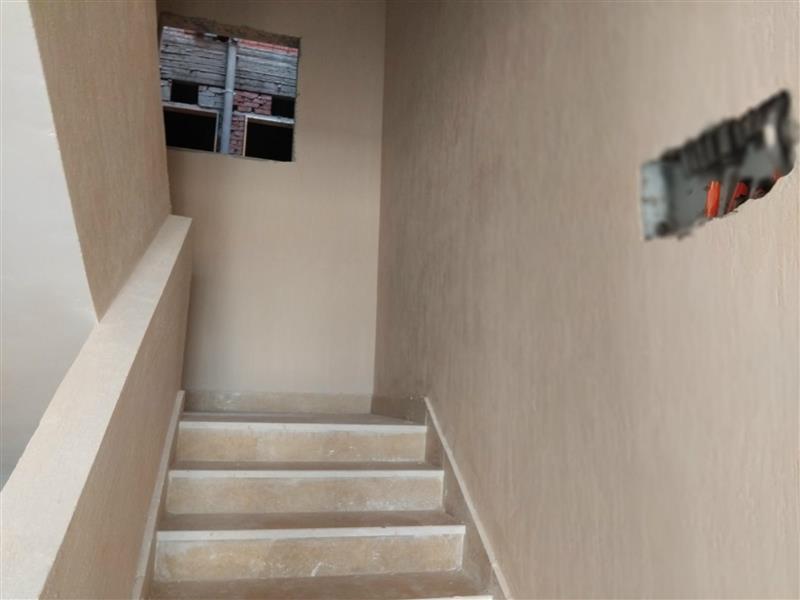

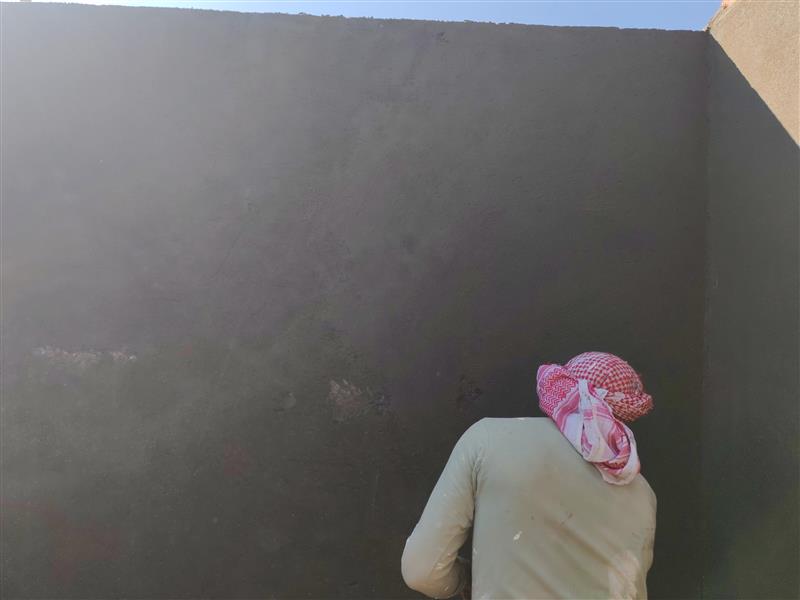

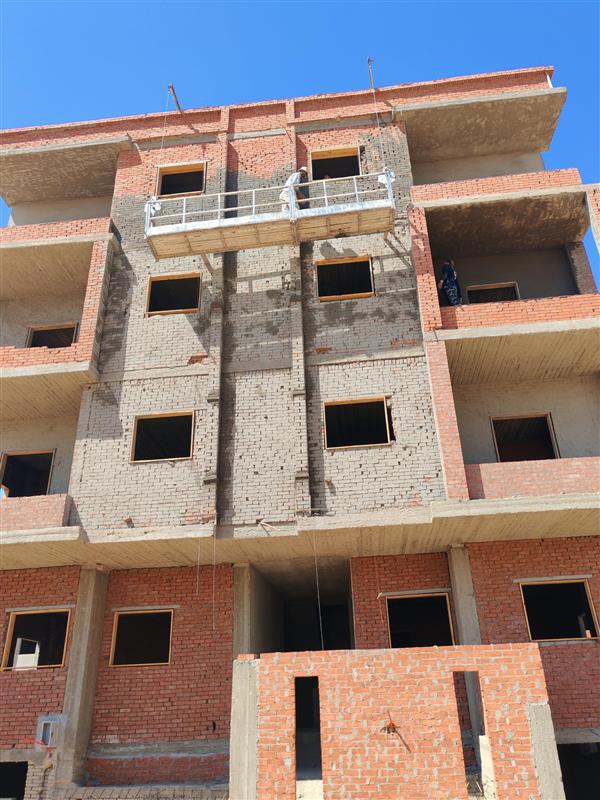

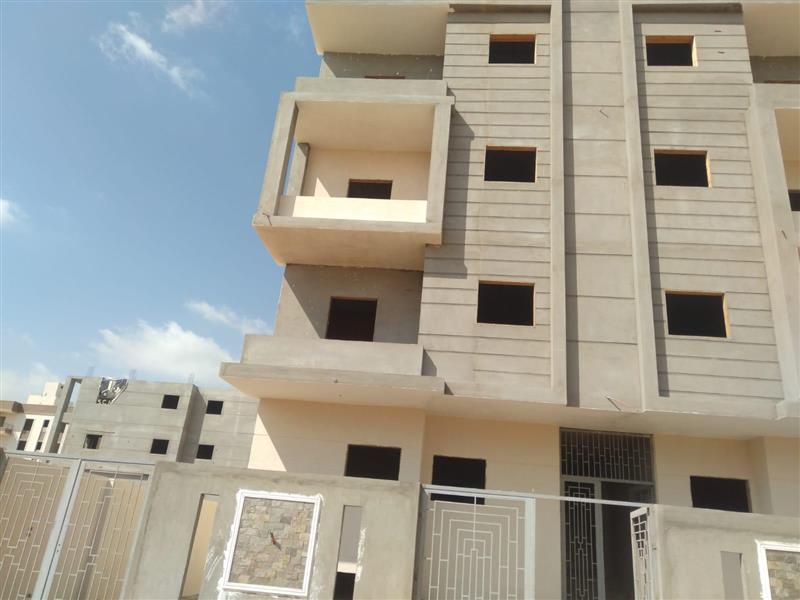

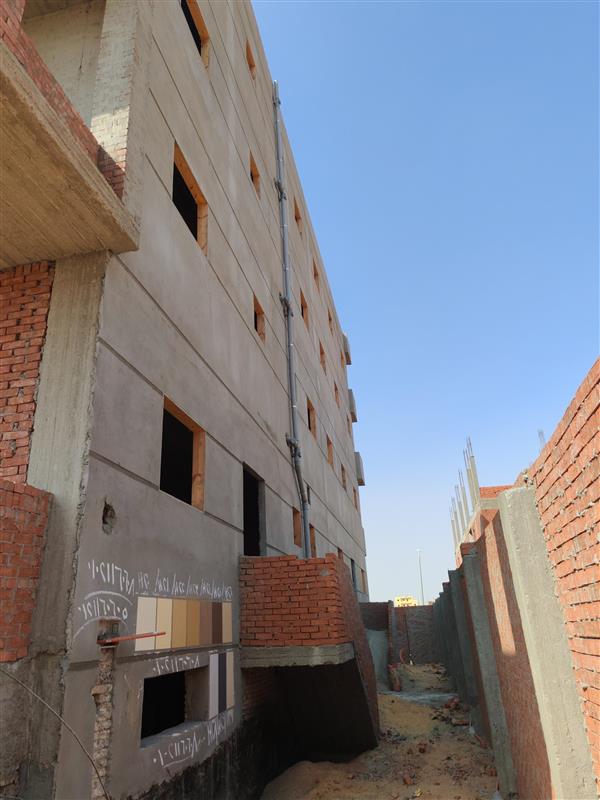

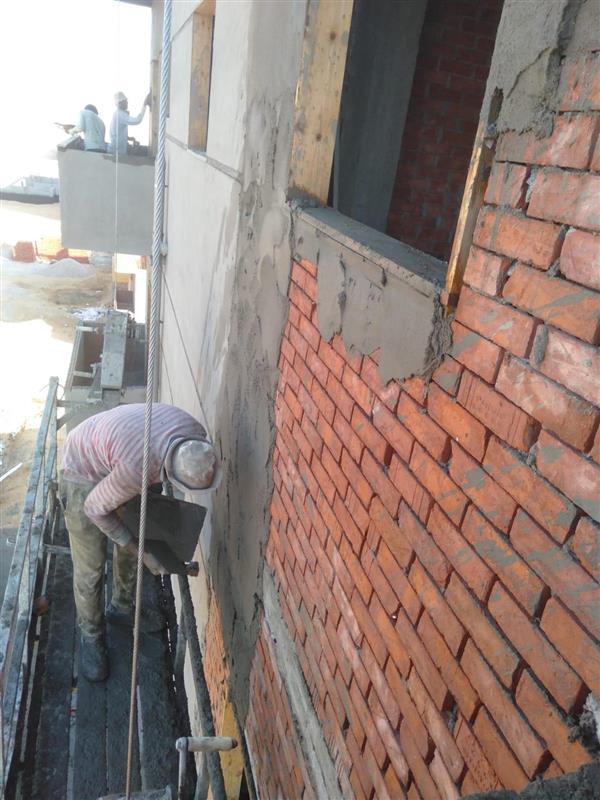

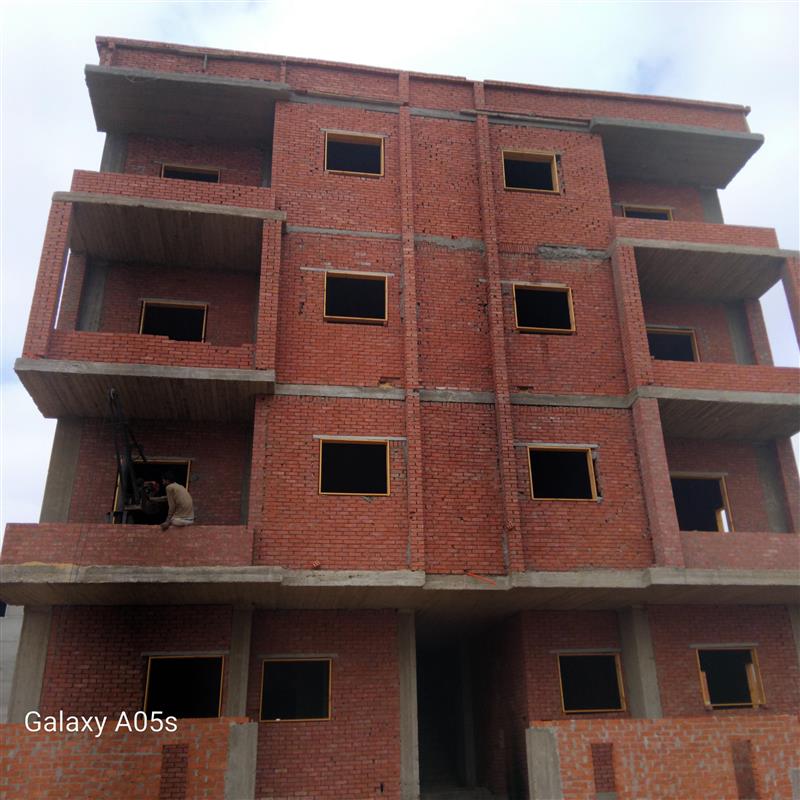

Plaster and putty

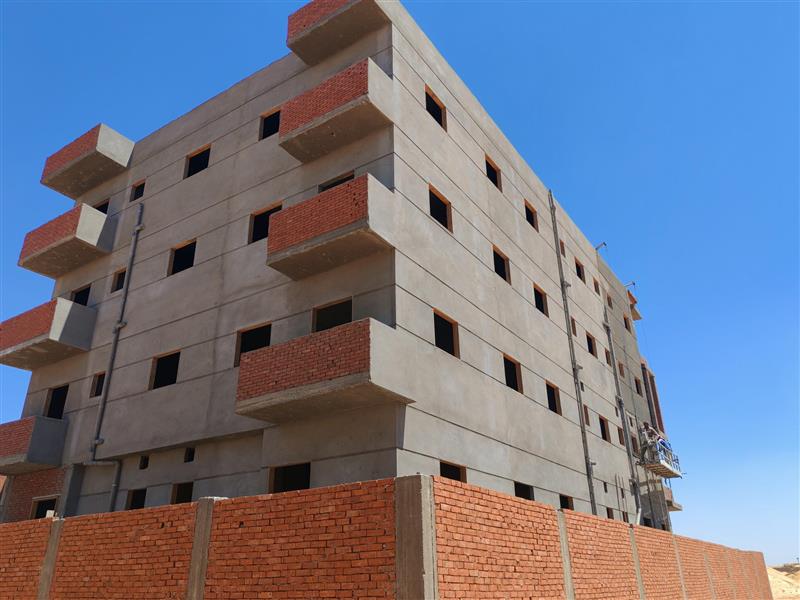

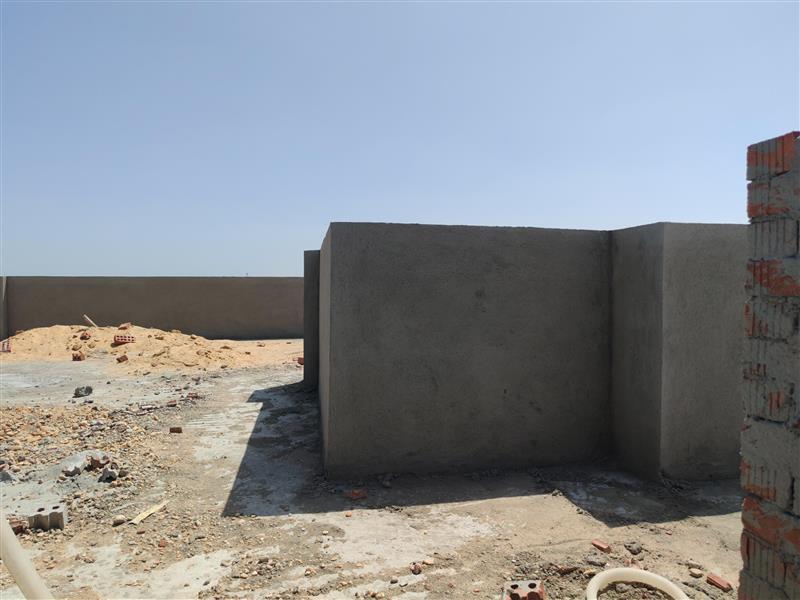

July 11, 2025

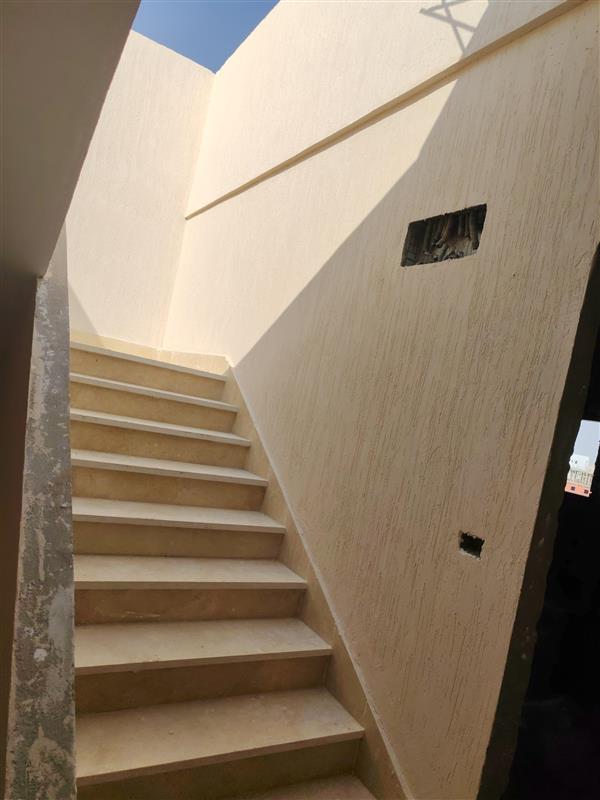

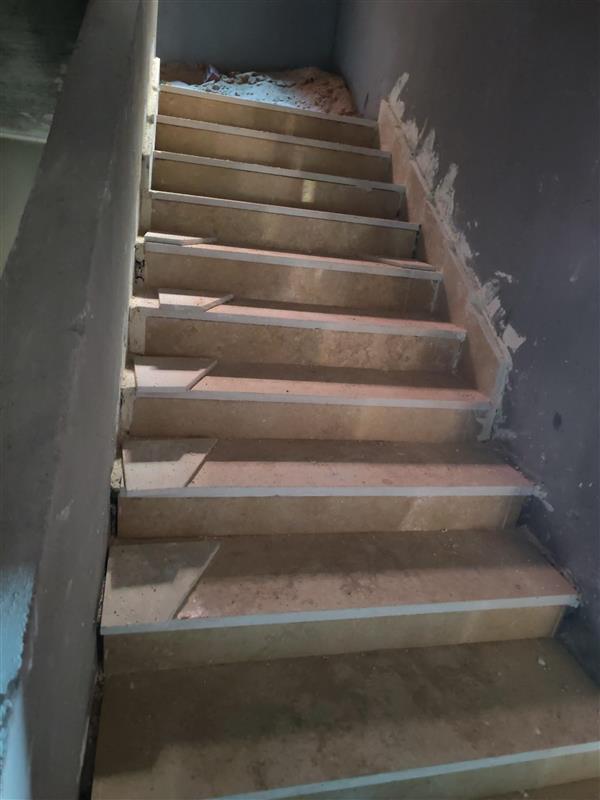

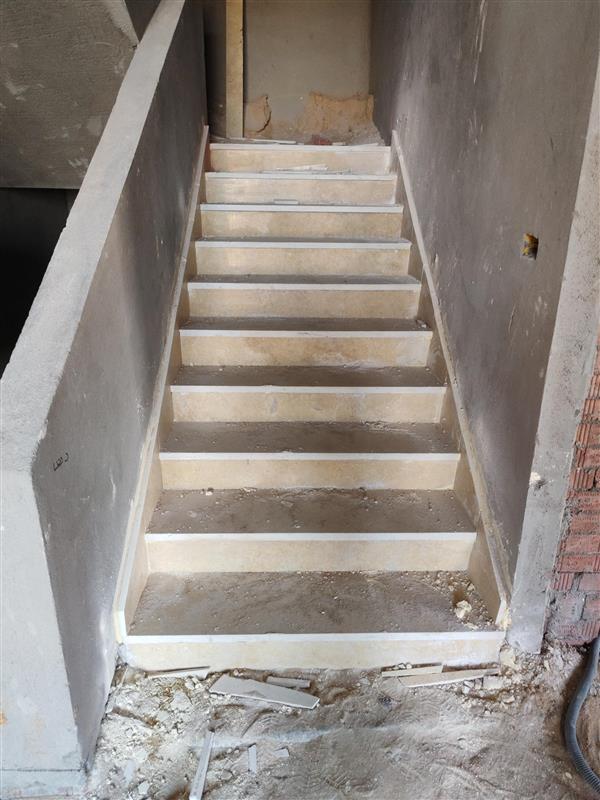

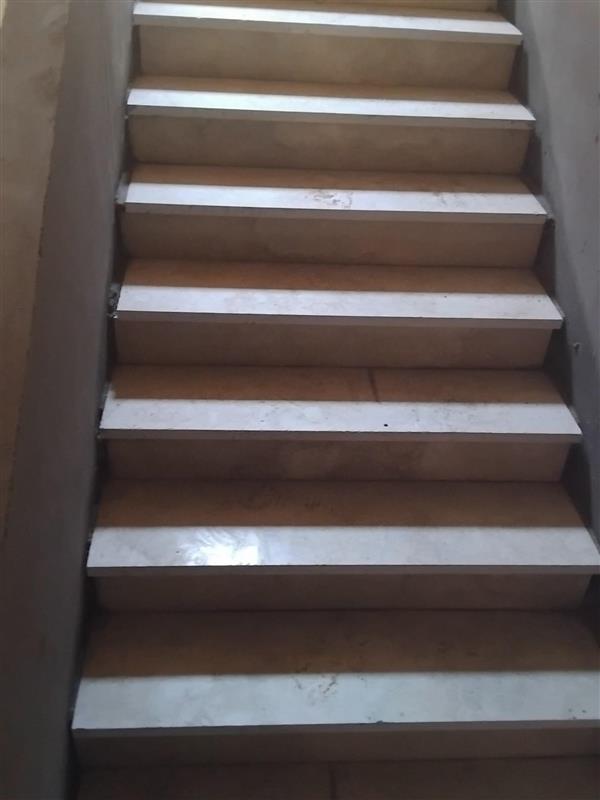

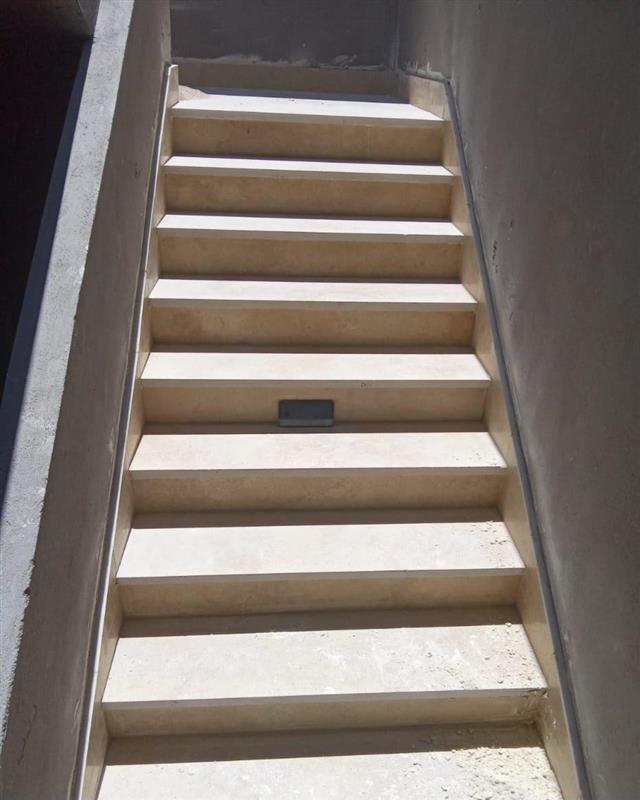

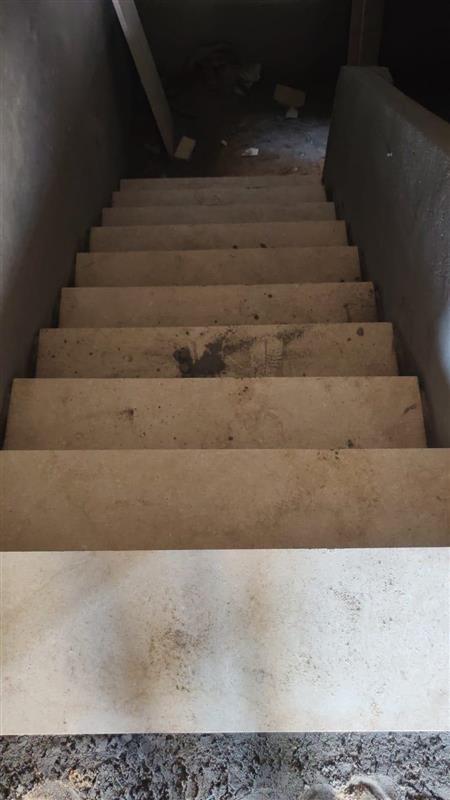

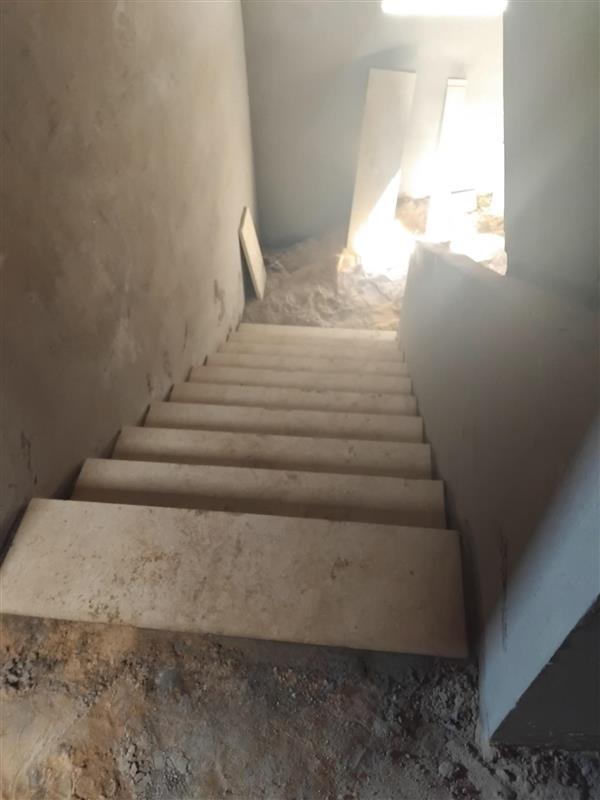

Marble works

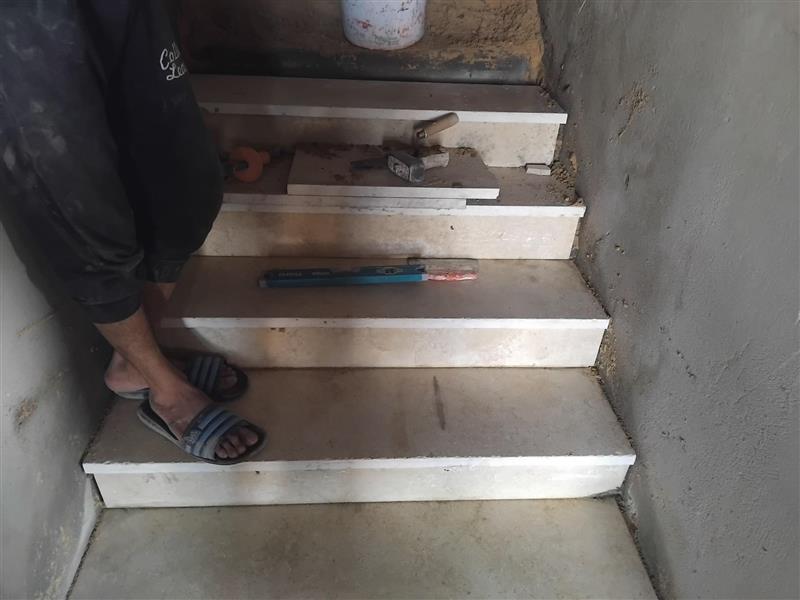

August 20, 2025

Aluminum & glass works (Krital)
August 20, 2025
Elevator
August 25, 2025
Project handover to the authority
August 30, 2025
Utilities meter installation
September 1, 2025
