Project Details
Land Number
621
Region
The Area 21, El Sadat City
HOMEi Price
4,800.00 EGP
Neighbour Price
10,000.00 EGP
Construction Companies
| # | Company | Title | Status |
|---|---|---|---|
| 1 |
|
Construction | Finished |
| 2 |
|
- | Finished |
| 3 |
|
- | Finished |
Payment Plan
| Instalment Number | Duration | Percentage Paid |
|---|---|---|
| 1 | On Booking | 50% |
| 2 | During Construction | 25% |
| 3 | During Construction | 15% |
| 4 | During Construction | 10% |
Unit Details
Bedrooms
3
Bathrooms
2
Area
175 m²
Delivery
Unit Delivery Date
August 2025
Average Unit Price
675,000 EGP
Project Location
Map View
The Area 21, El Sadat City
HOMEi Timeline
License office contract
September 5, 2023

Building permit

September 15, 2023
Extracting a Building water meter
September 17, 2023
Obtaining a construction insurance certificate
September 19, 2023

Excavation permit
September 19, 2023
Mining permit
September 21, 2023
Construction contract in progress
September 28, 2023
Construction contract signed
September 30, 2023

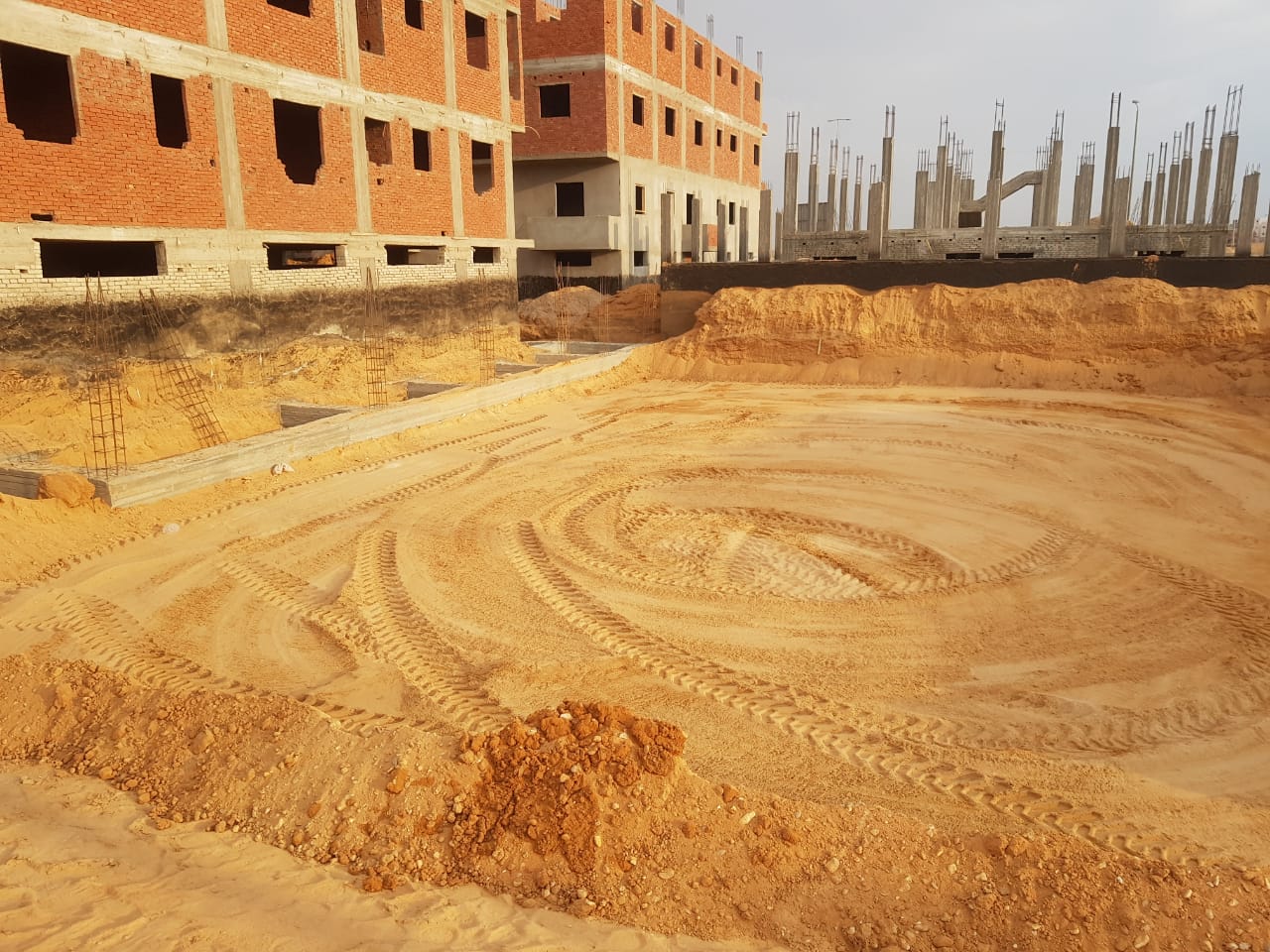

Excavation
October 1, 2023

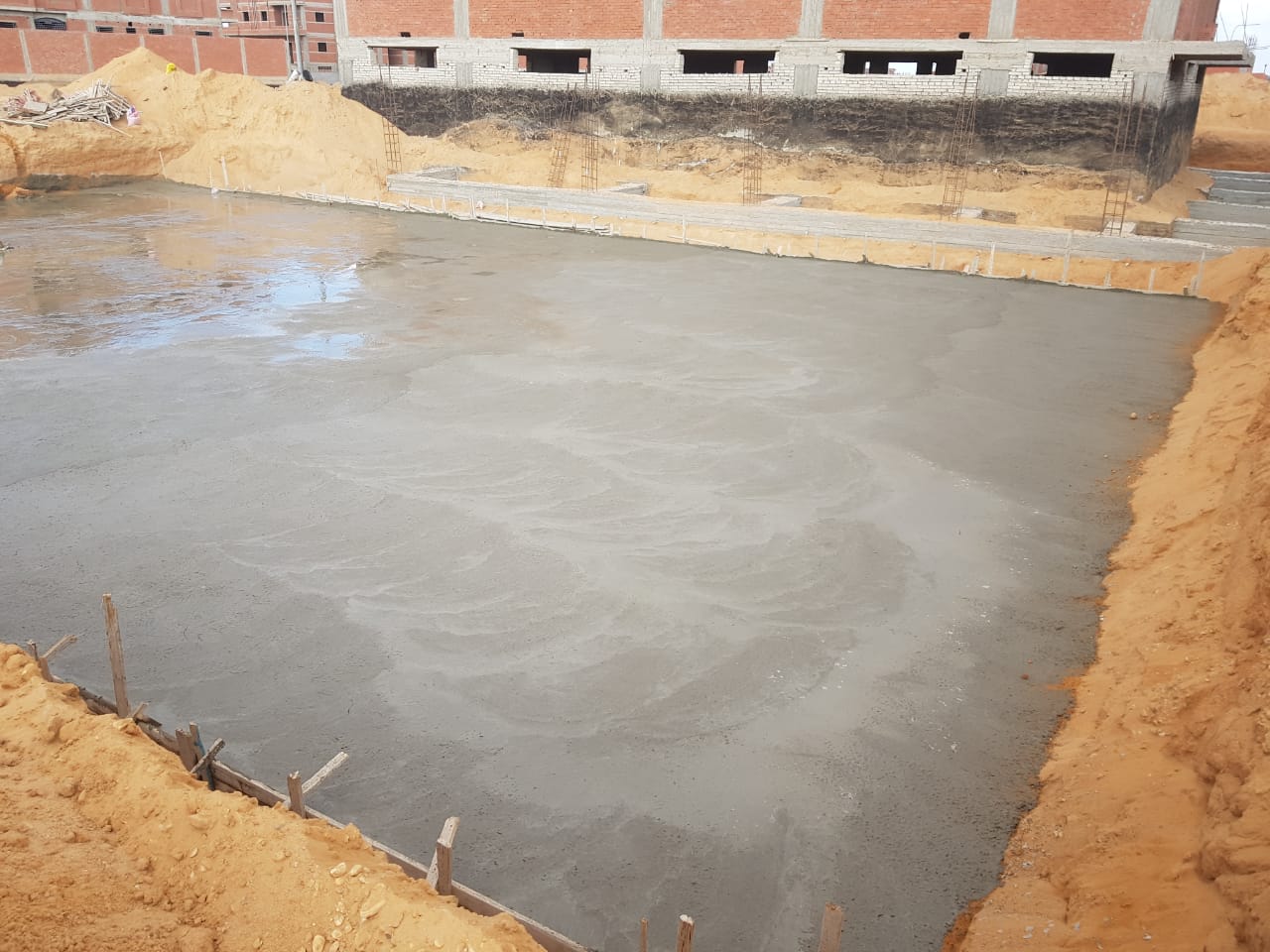

Plain concrete

October 5, 2023

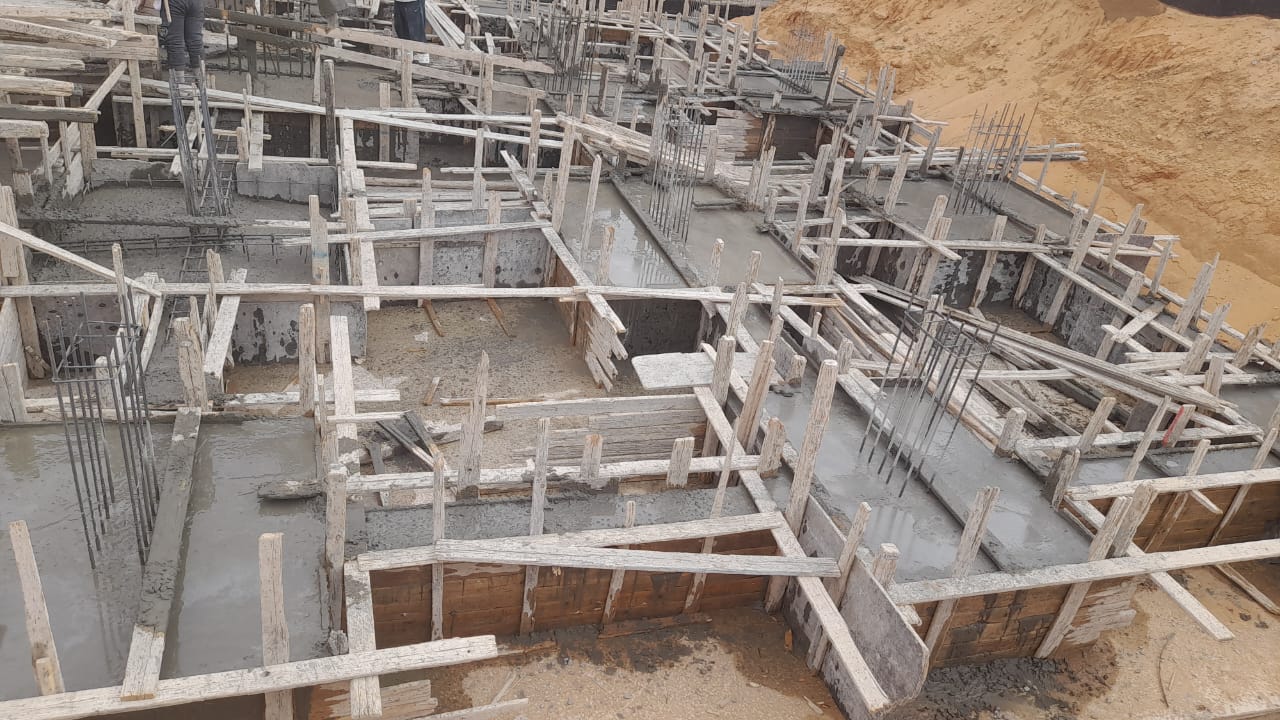

Reinforced concrete
October 7, 2023

Footings insulation
October 9, 2023

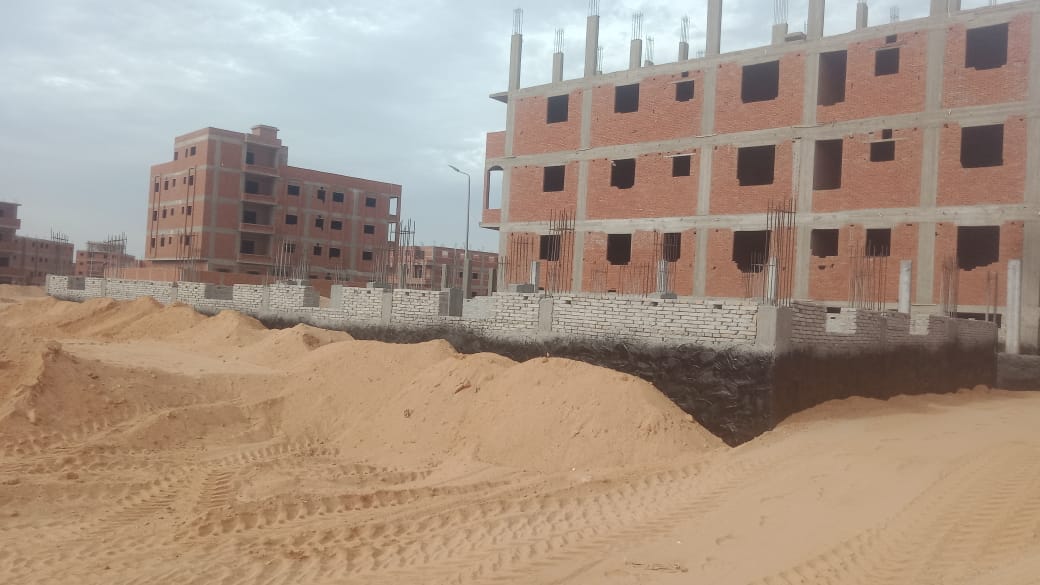

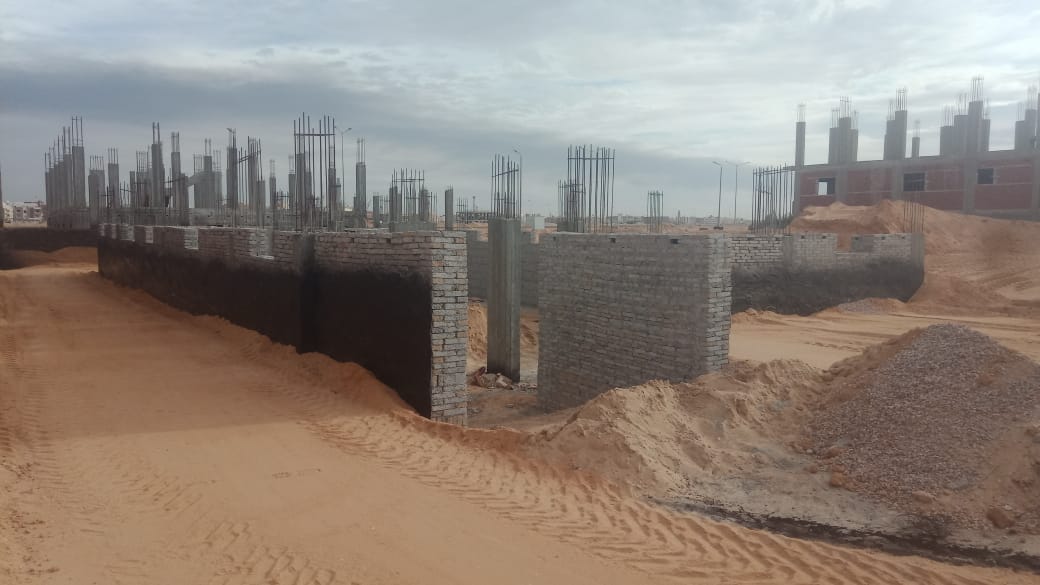

Backfilling around foundations
October 9, 2023

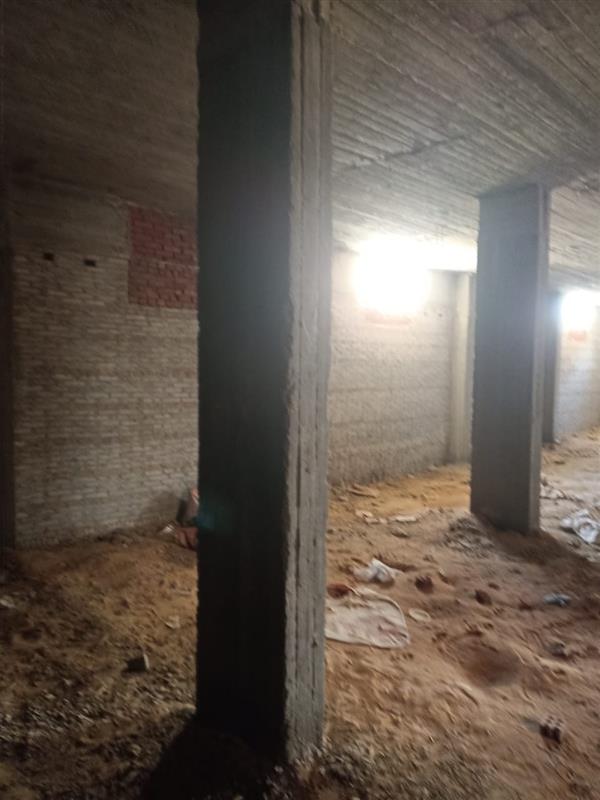

Basement columns
October 14, 2023

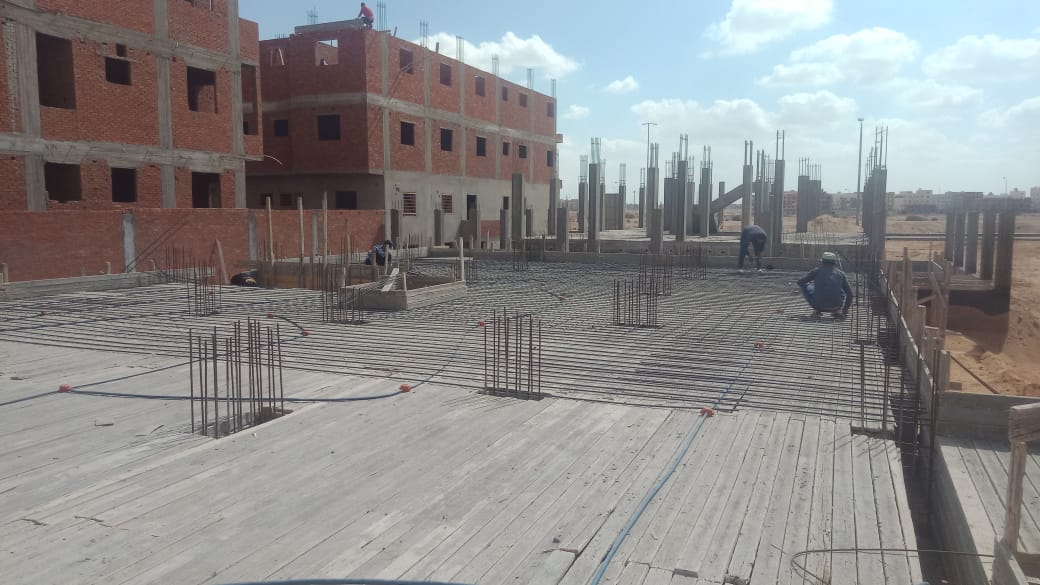

Basement slab
October 25, 2023

Ground floor columns
November 1, 2023

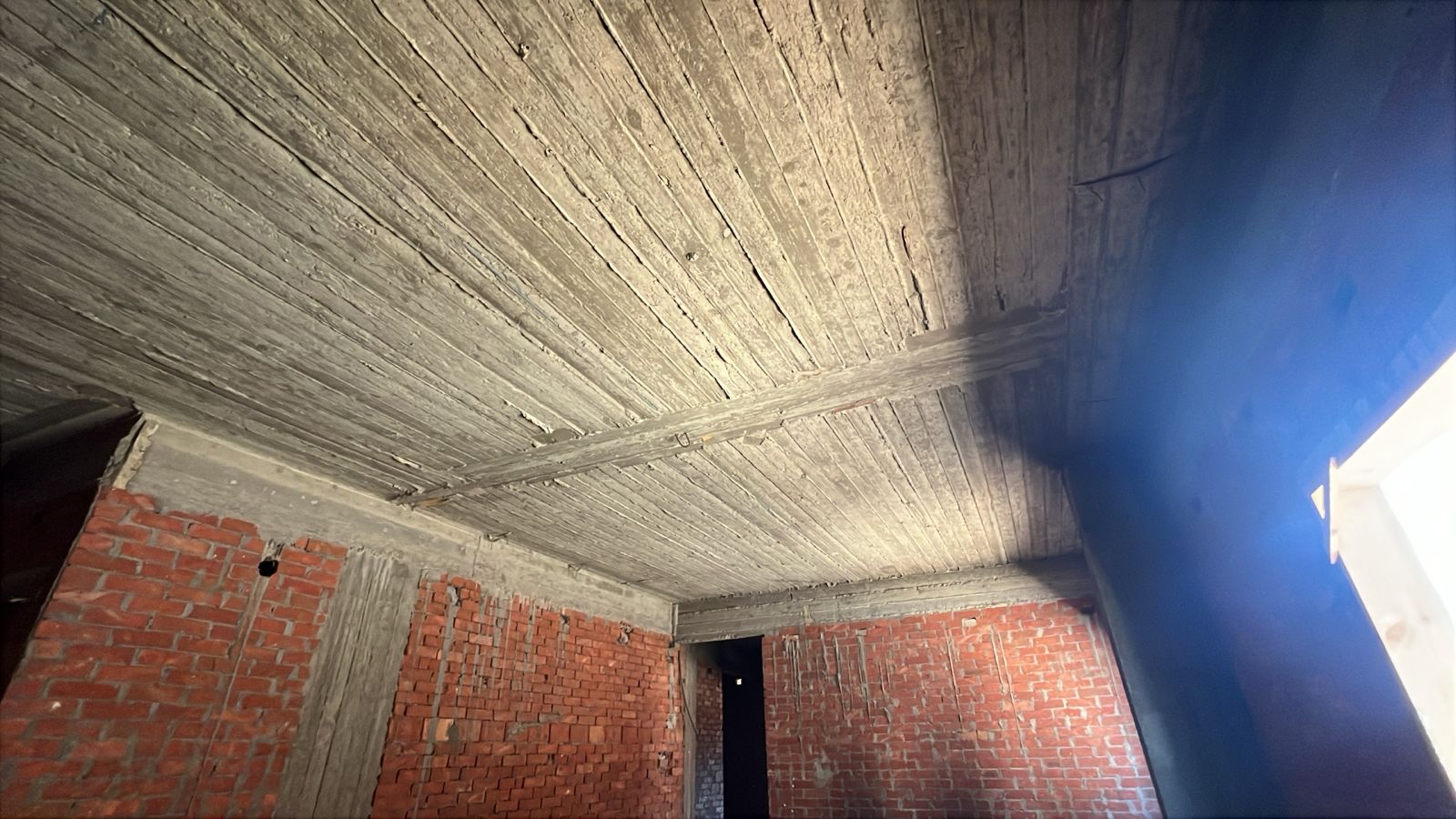

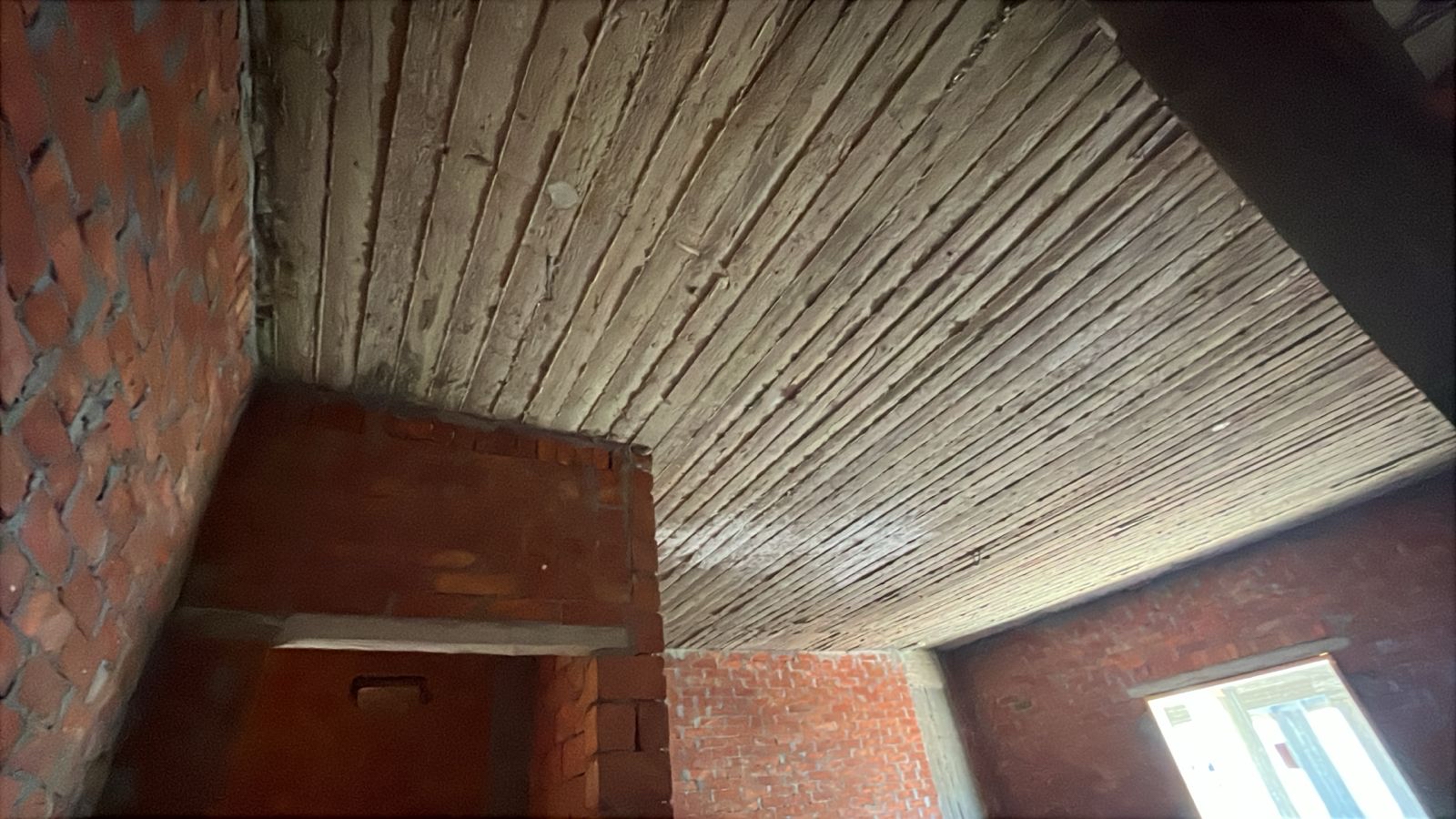

Ground floor slab
November 10, 2023

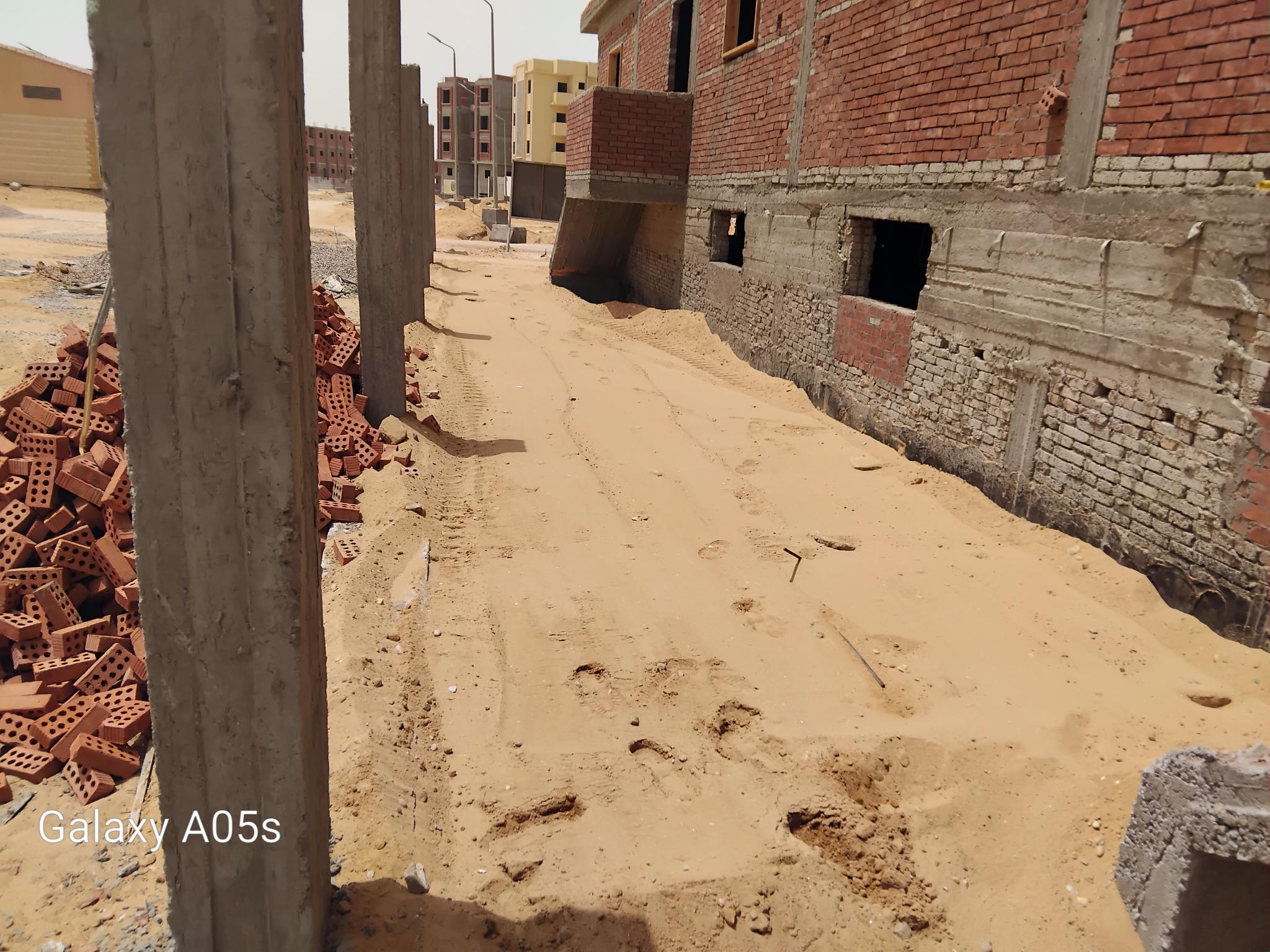

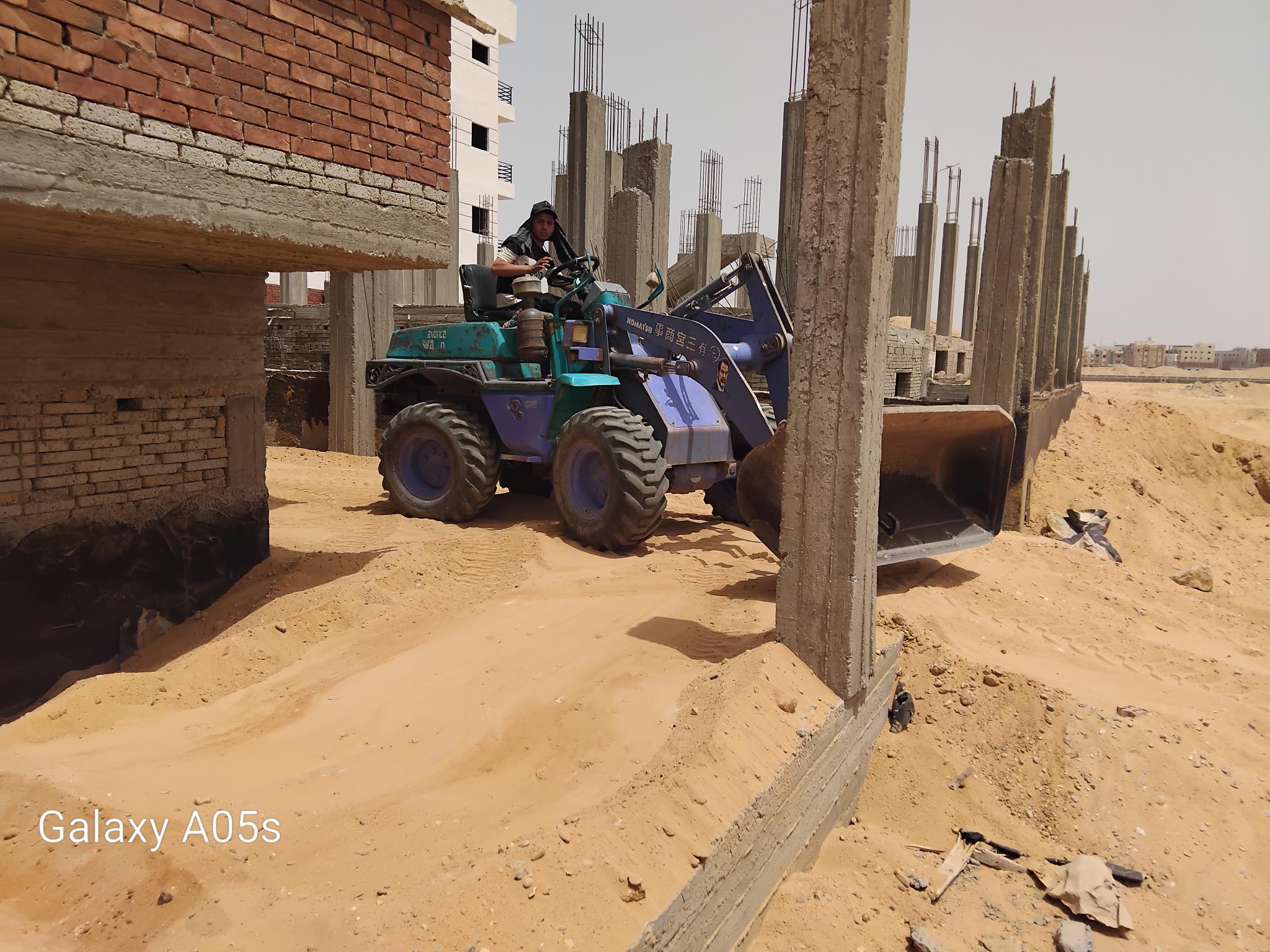

Concrete works for the external wall
November 18, 2023

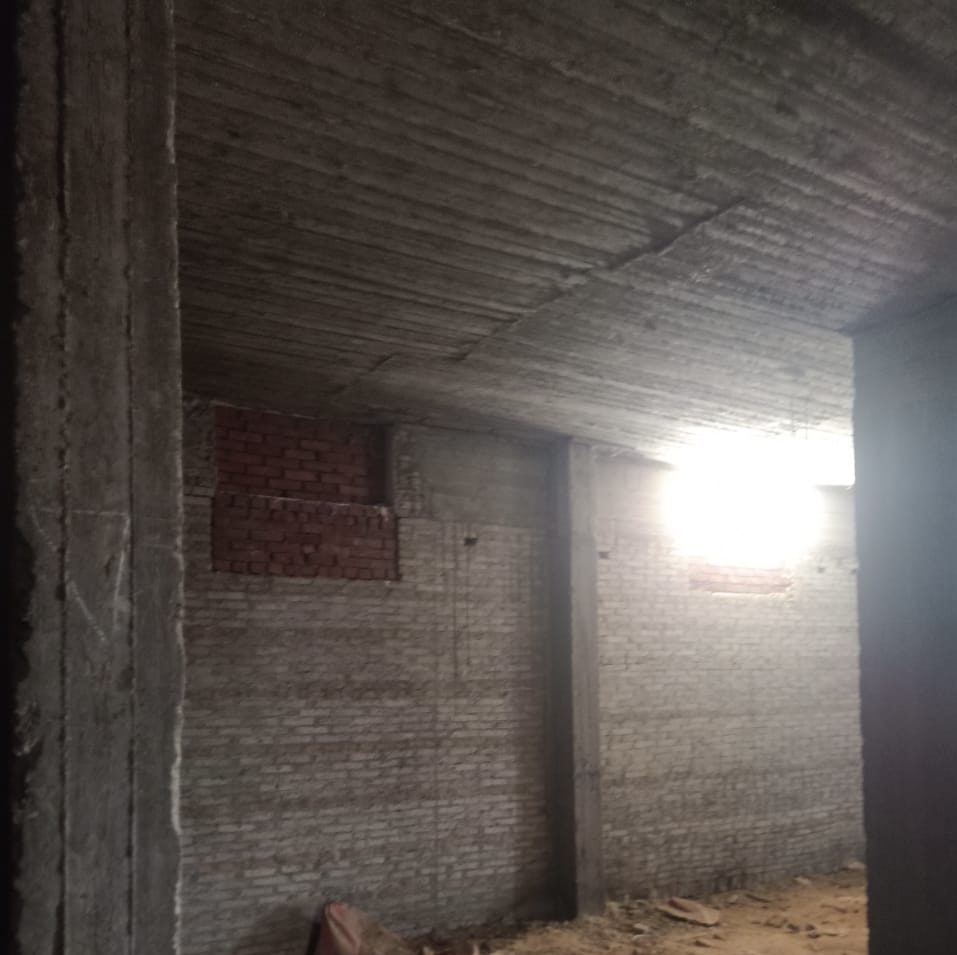

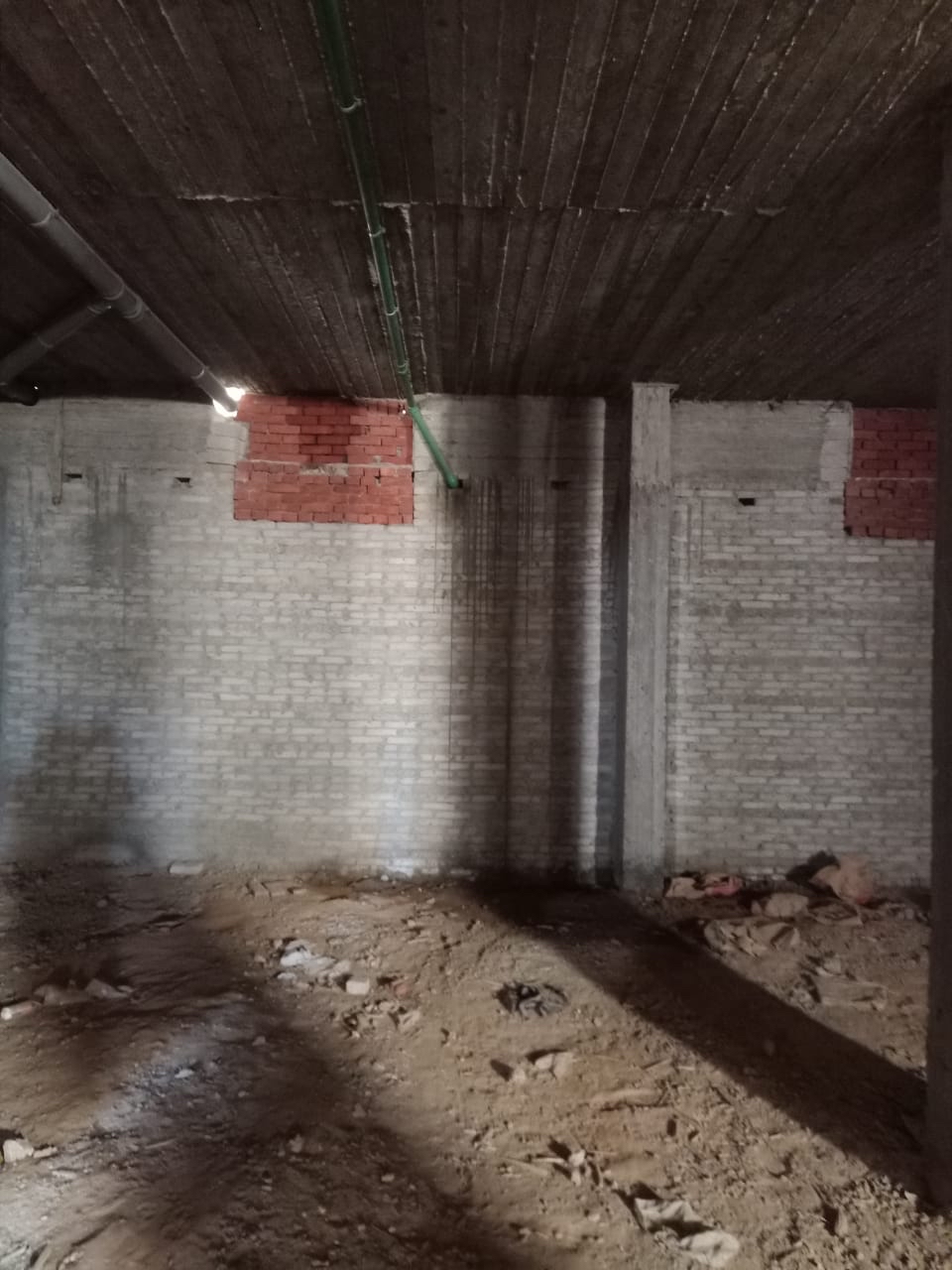

Basement walls
November 20, 2023

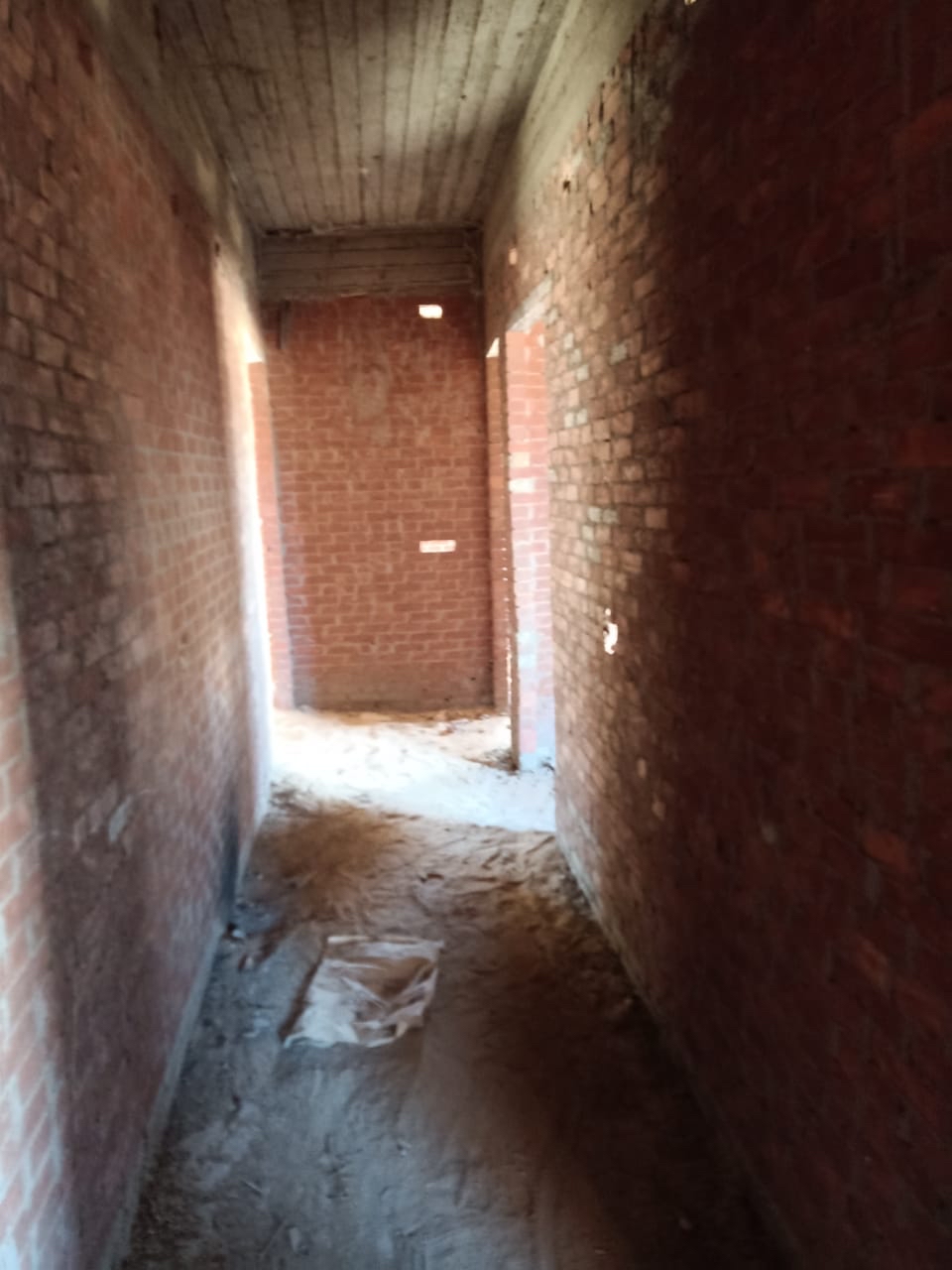

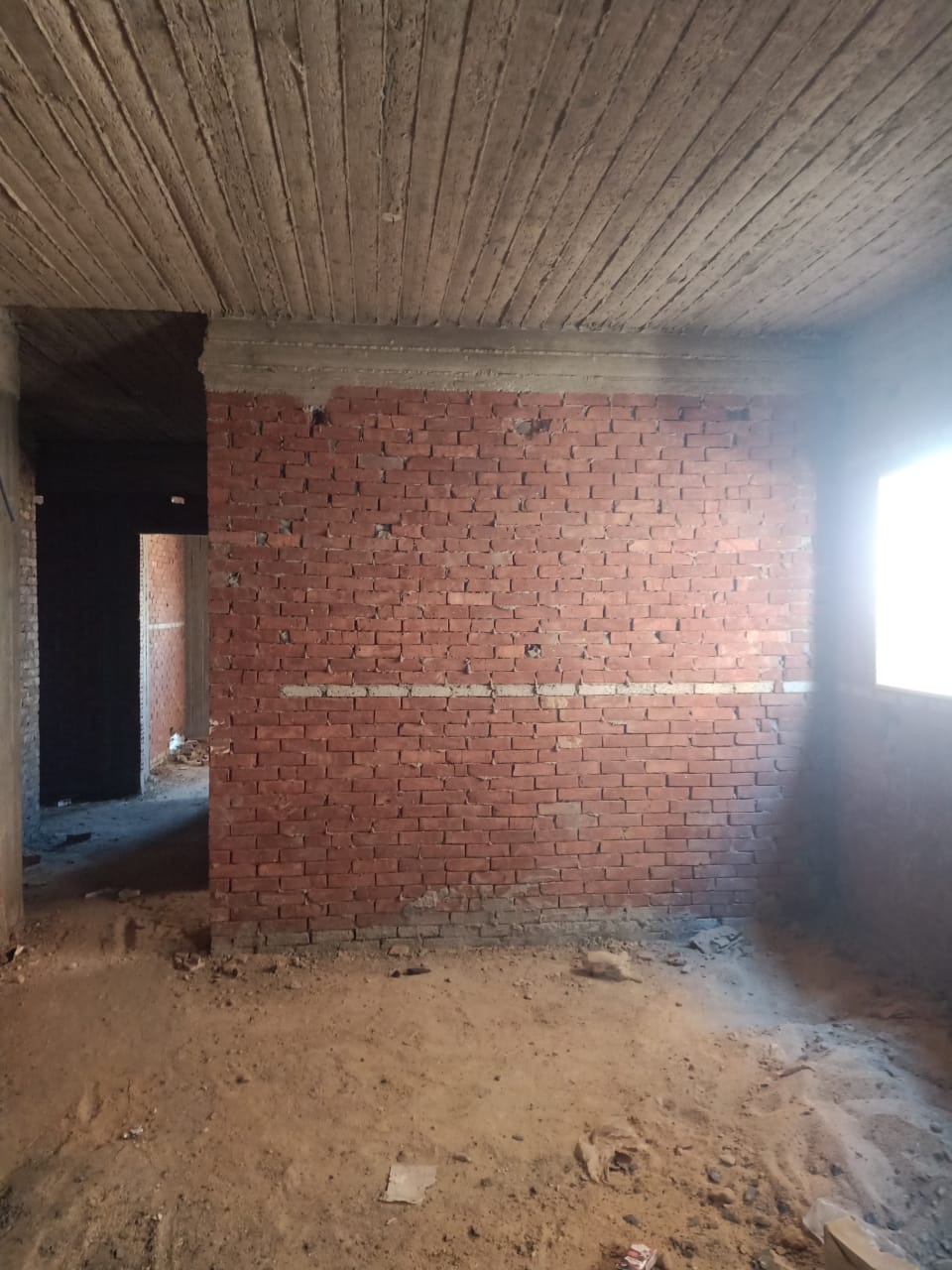

Ground floor walls
November 23, 2023

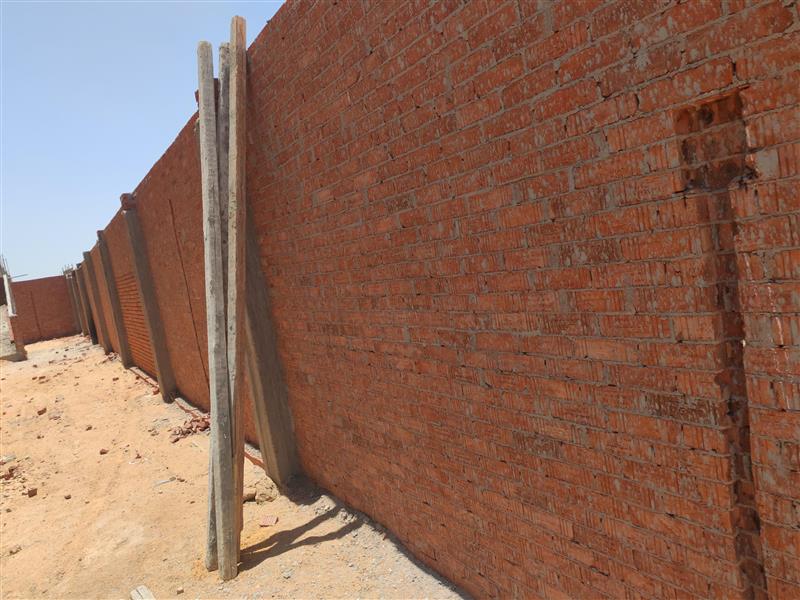

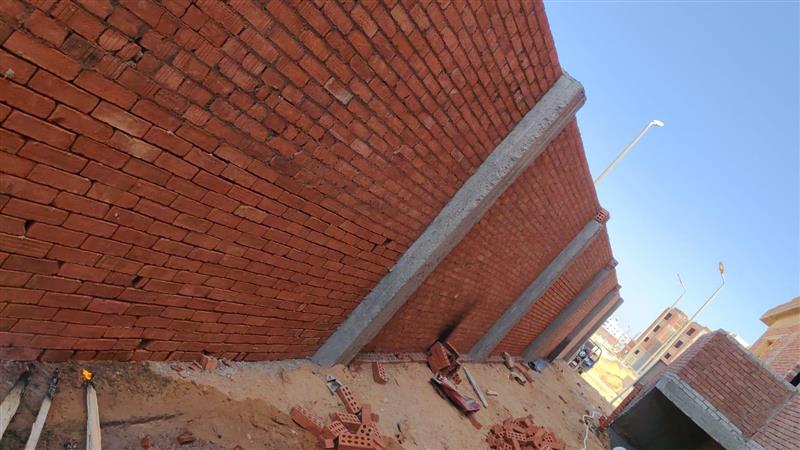

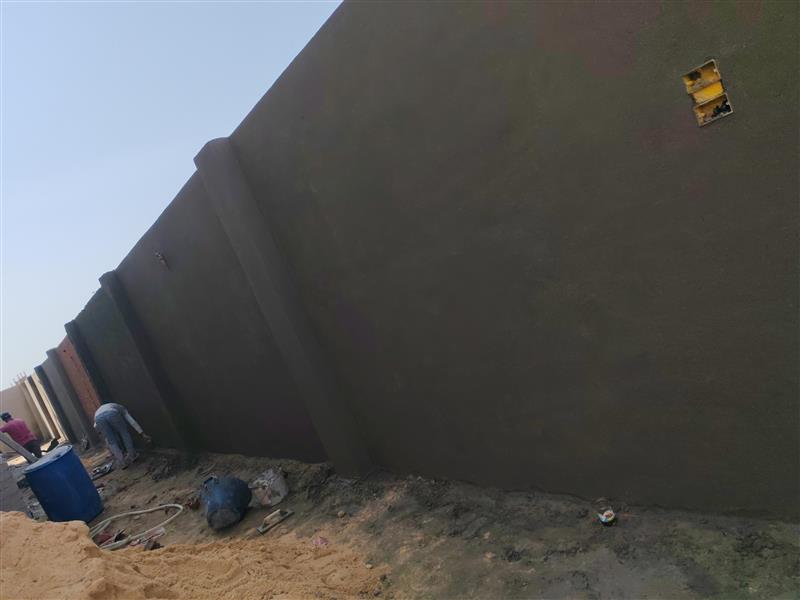

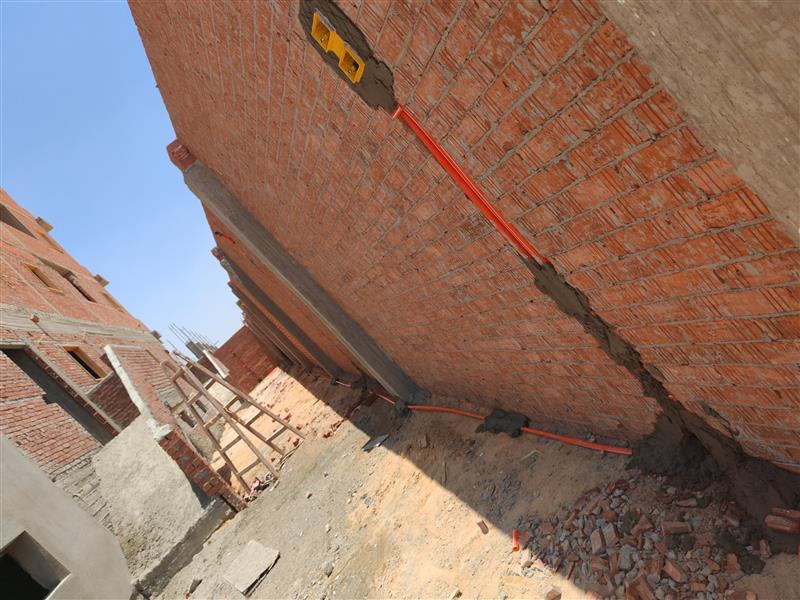

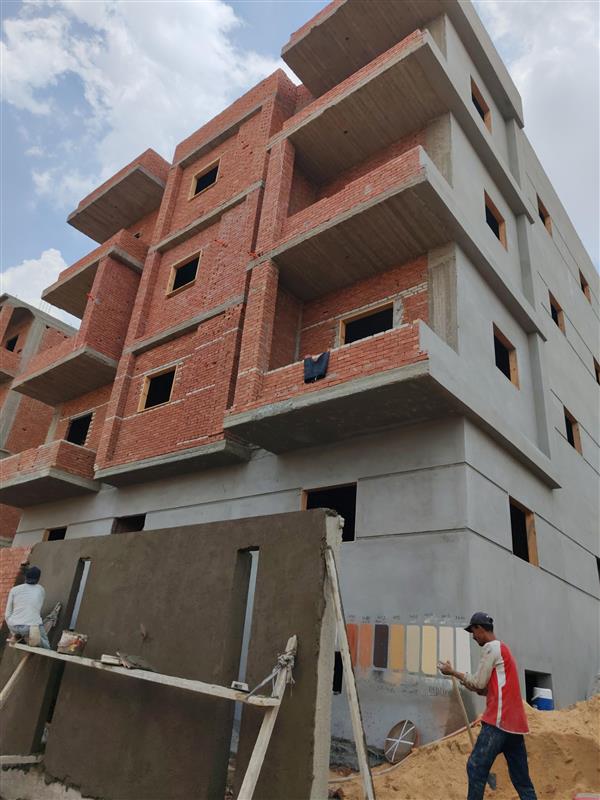

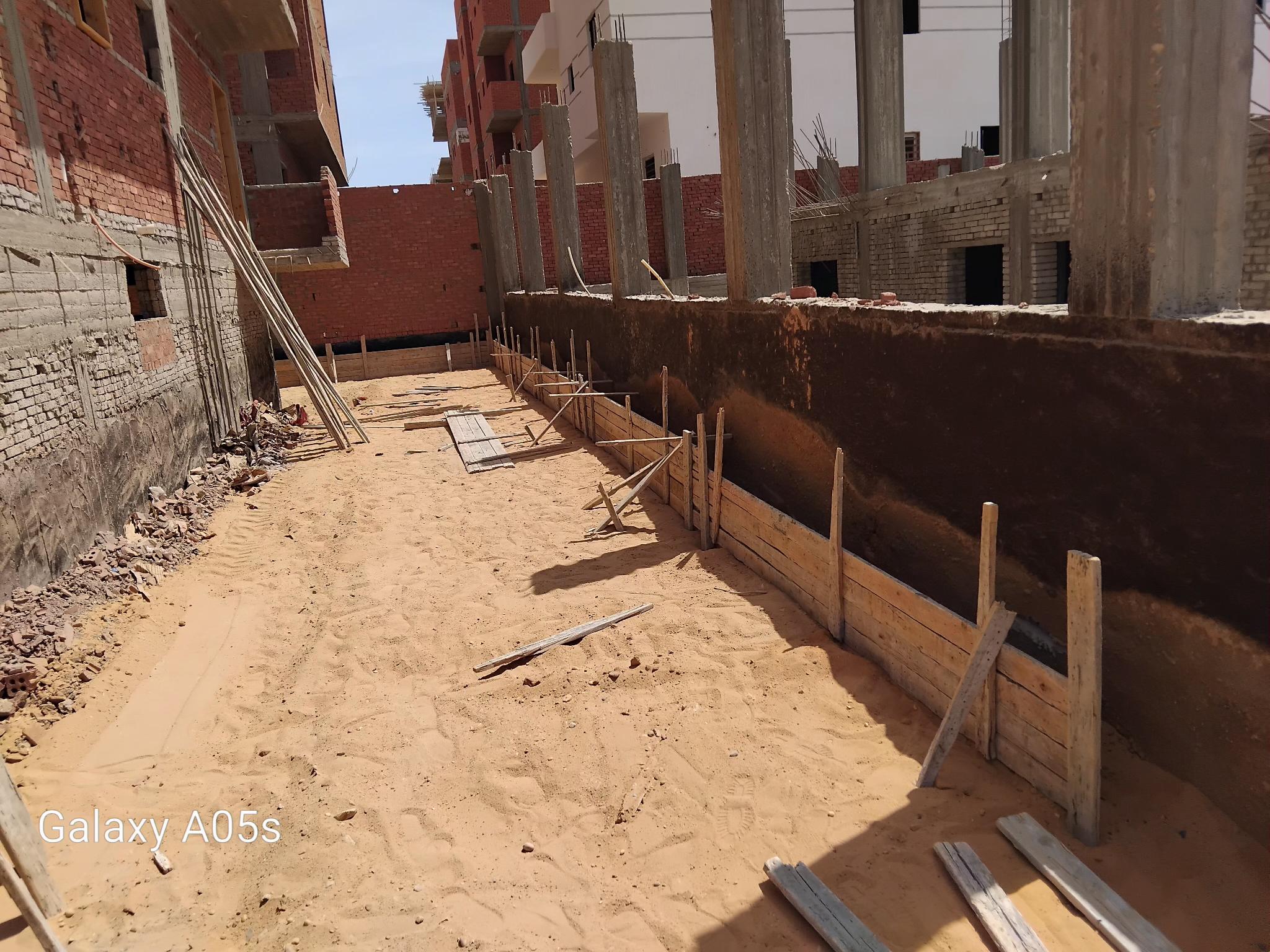

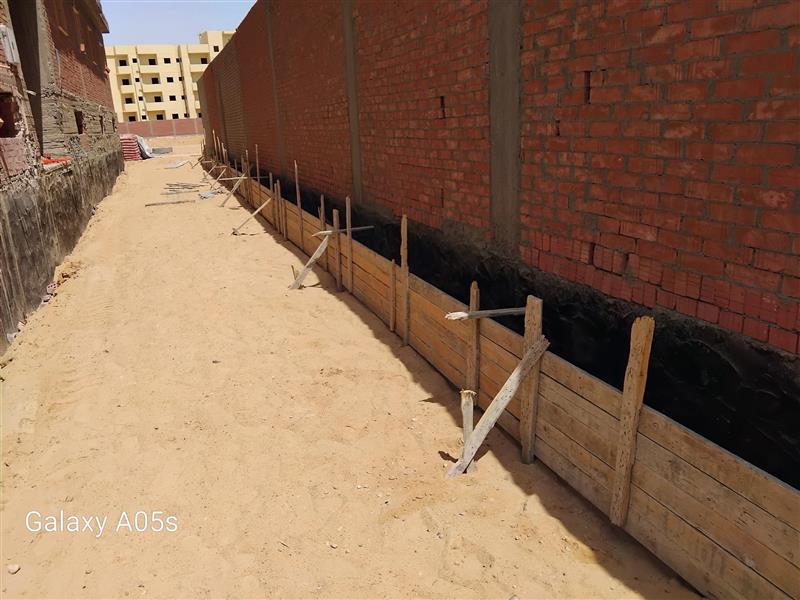

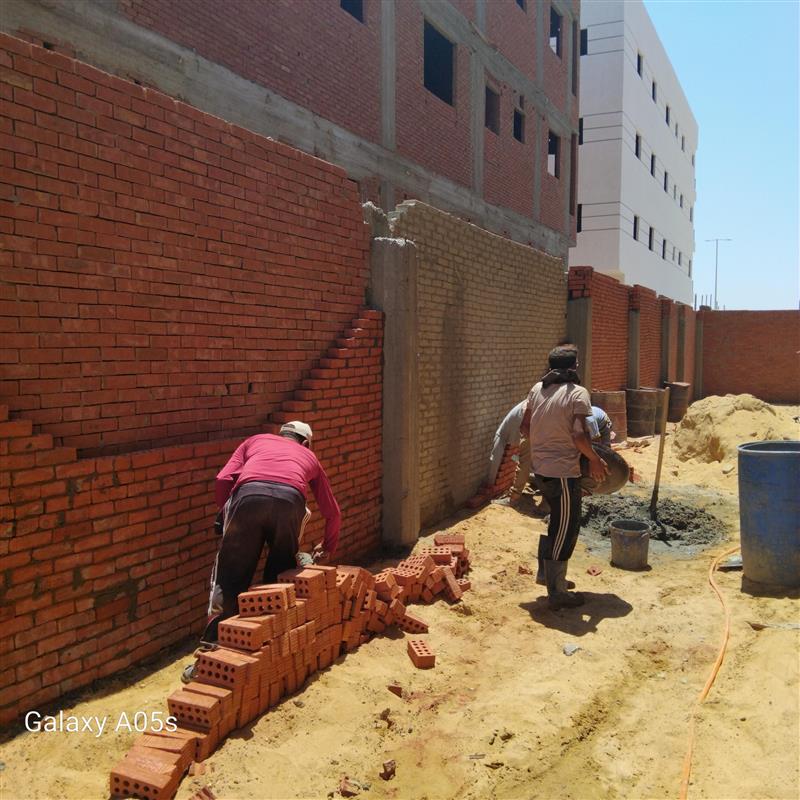

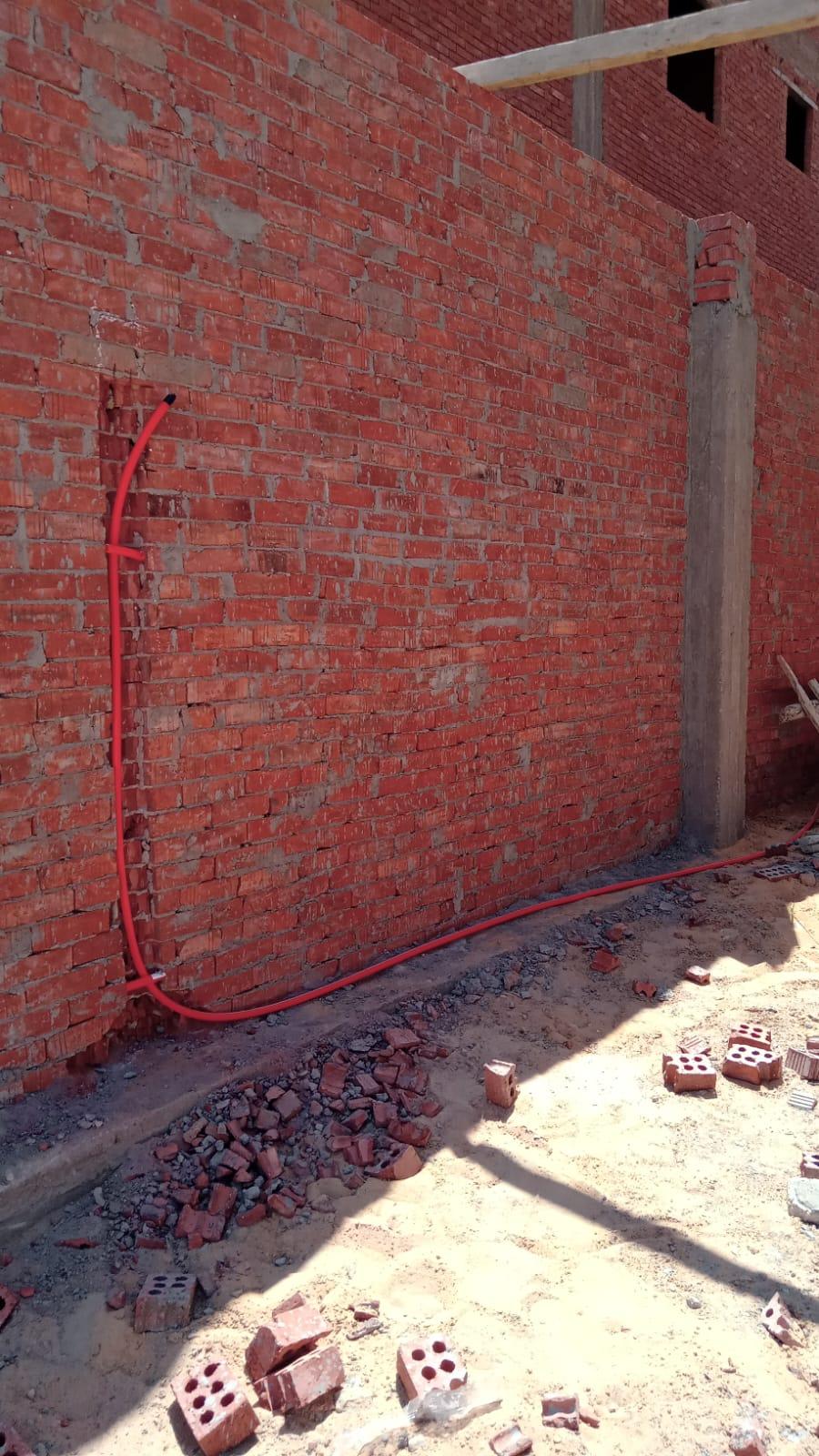

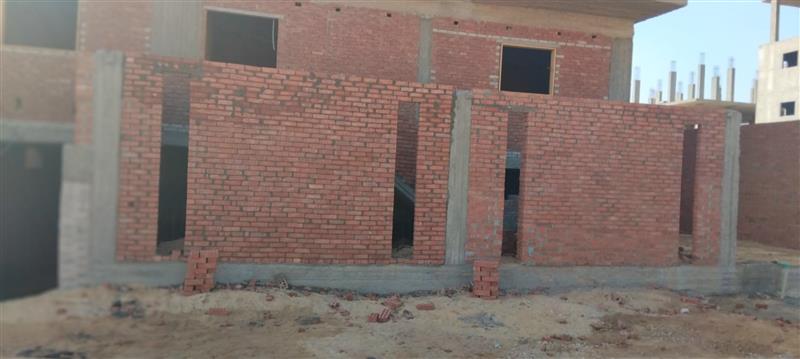

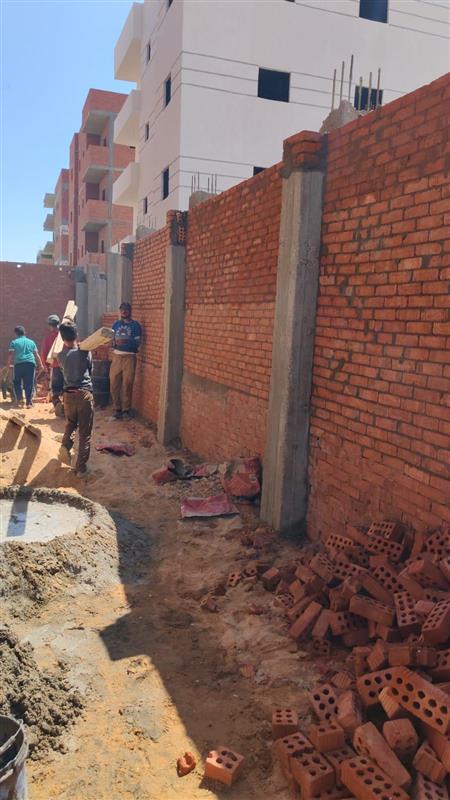

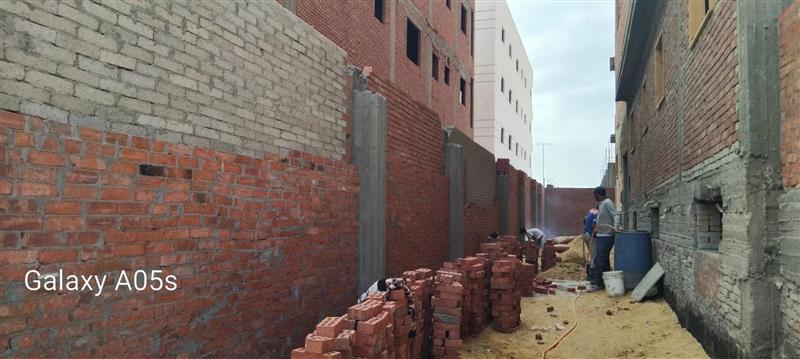

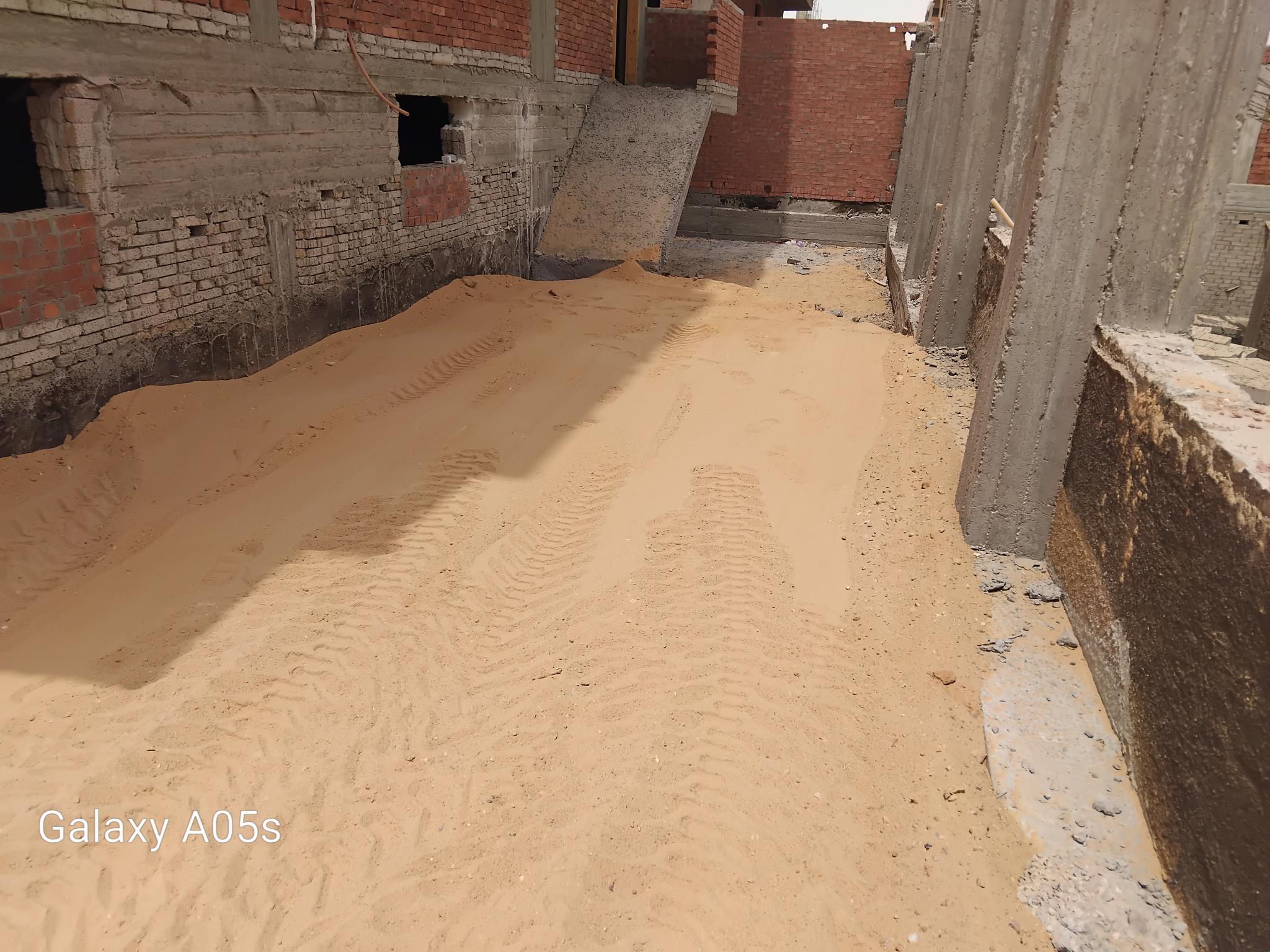

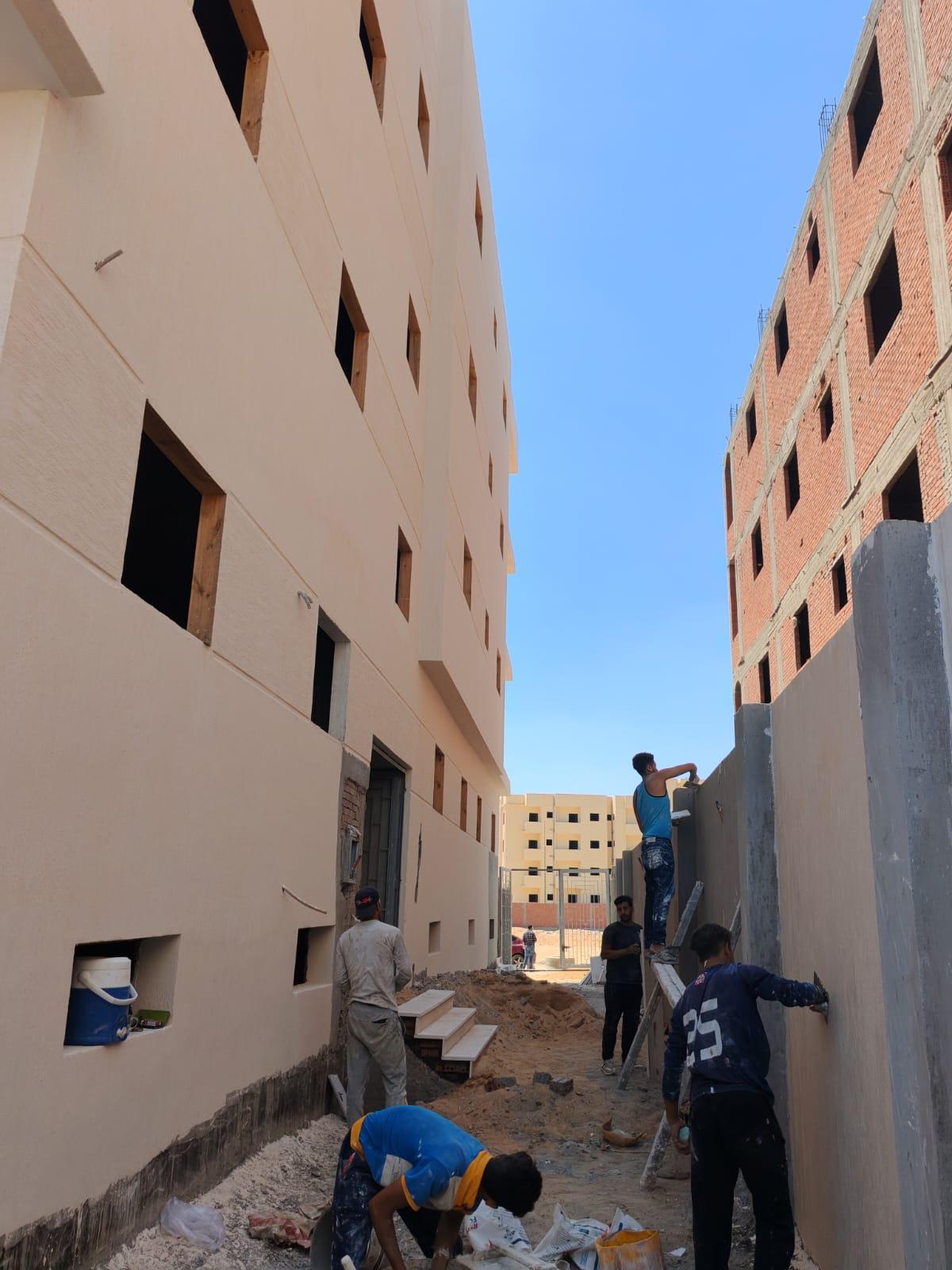

Wall Building works

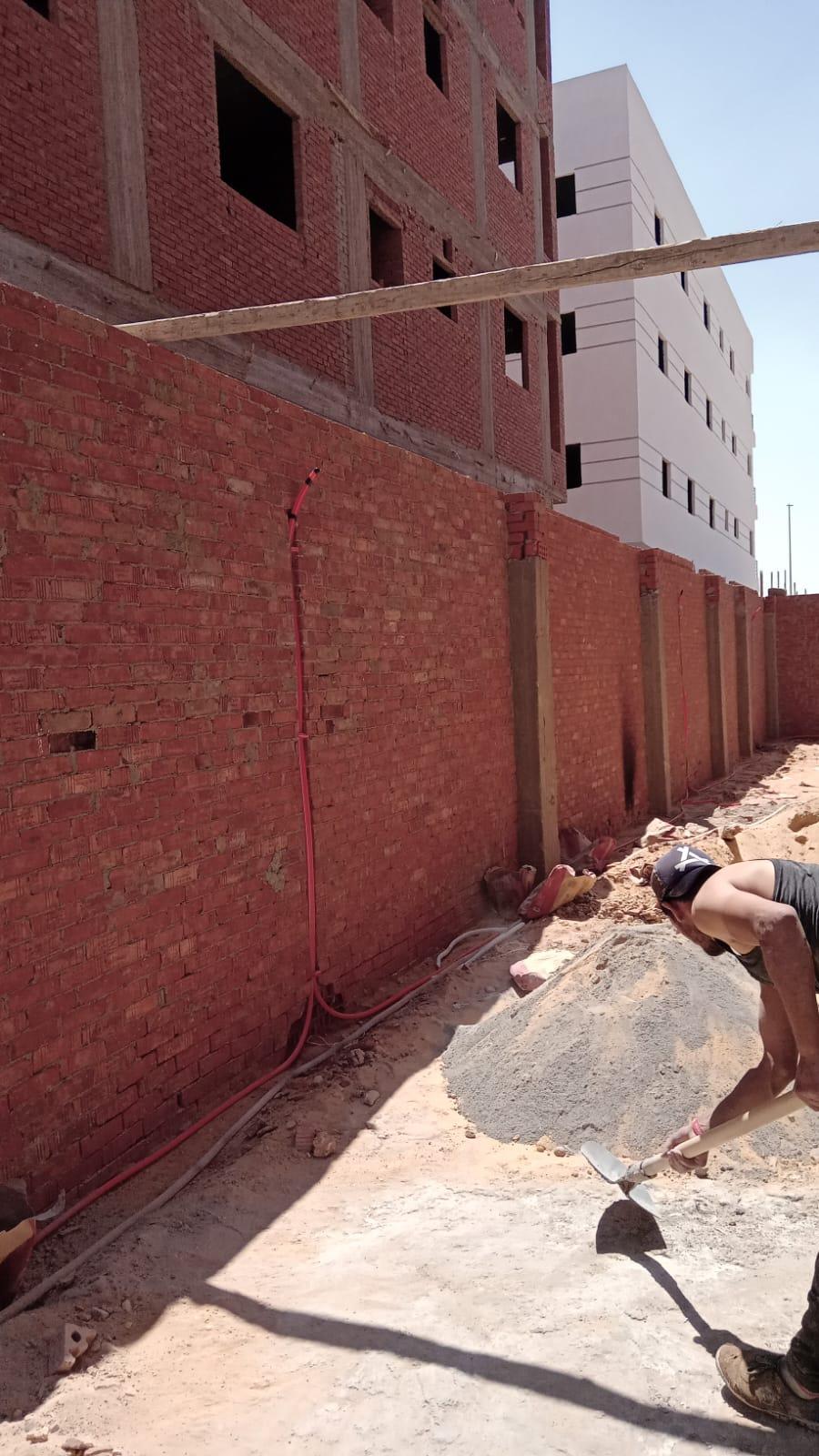

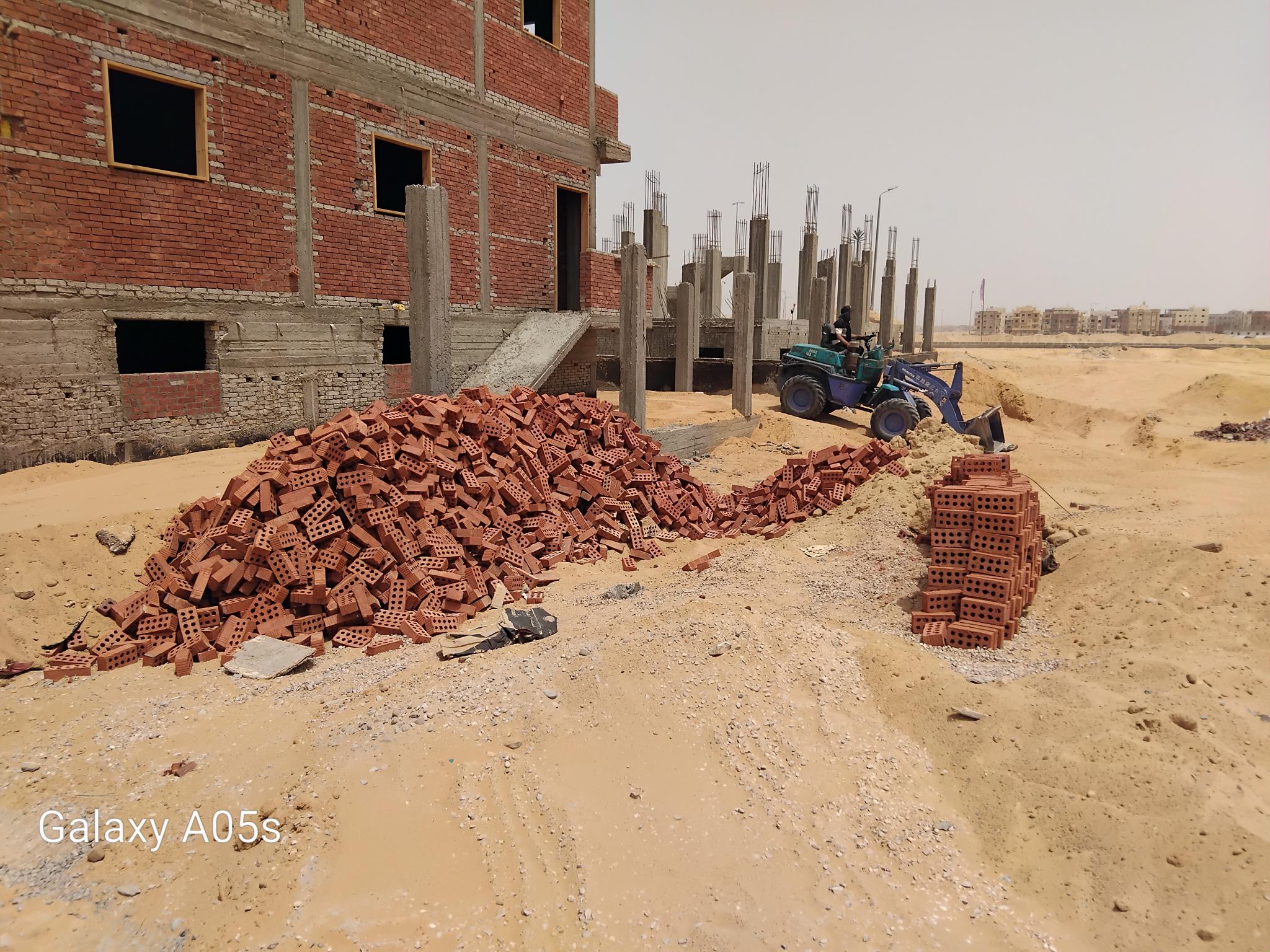

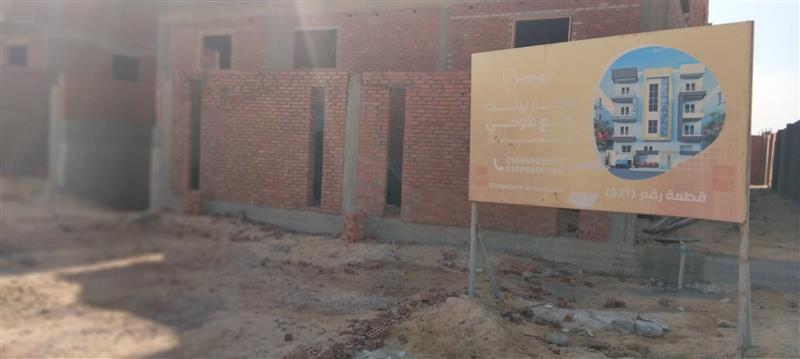

November 25, 2023

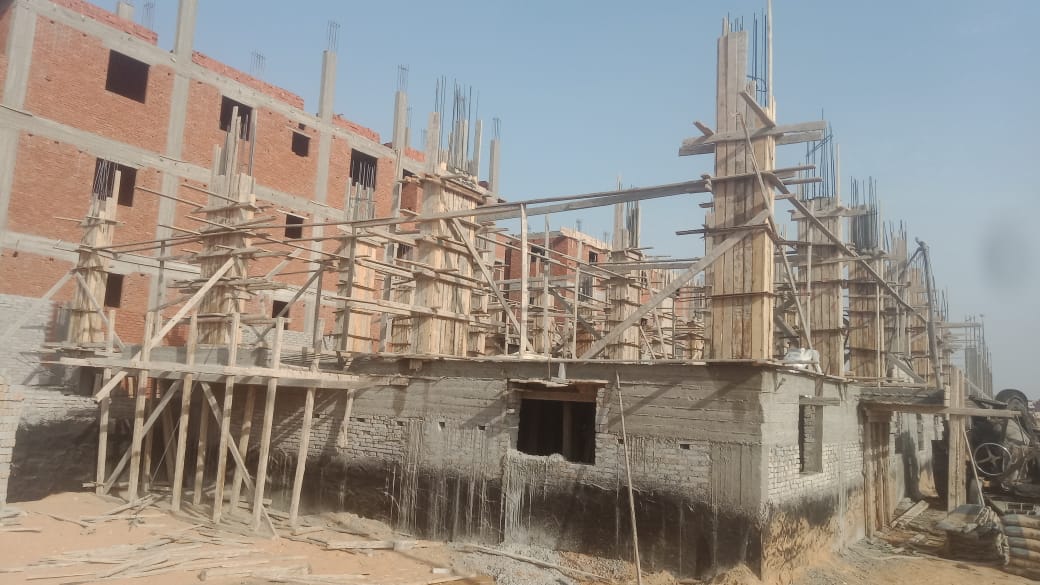

First floor columns
December 8, 2023

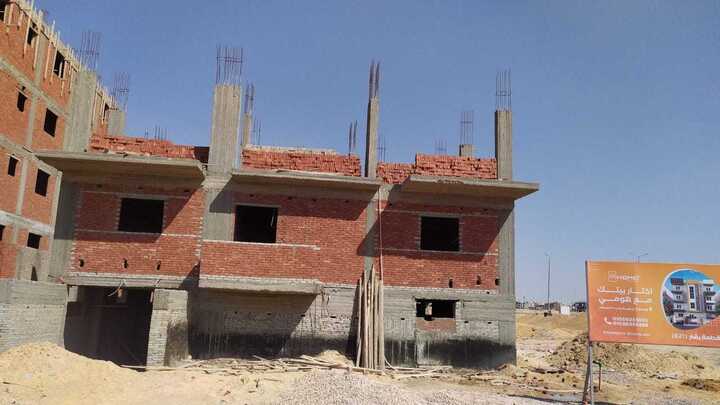

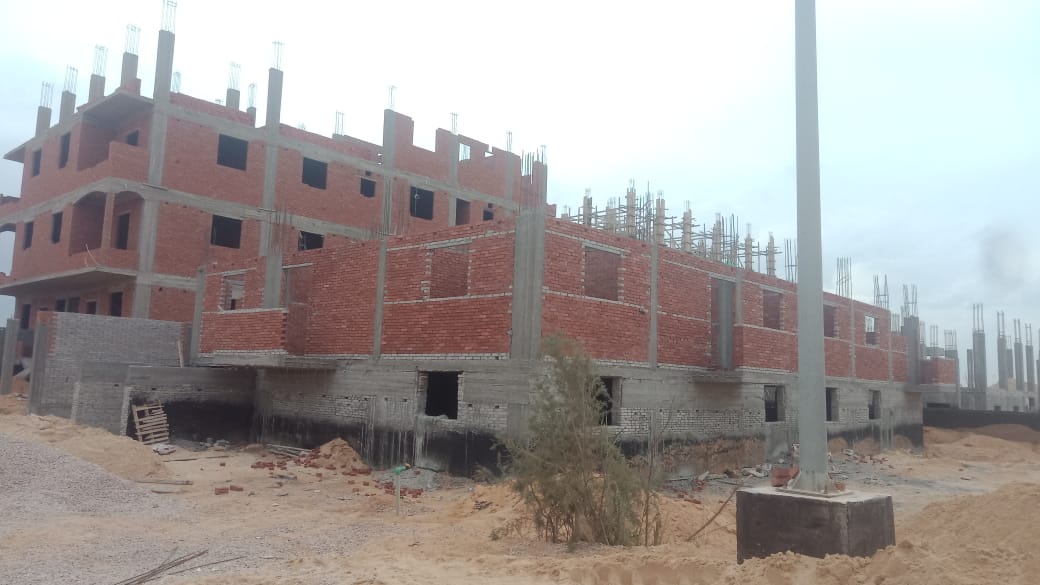

First floor walls
December 18, 2023

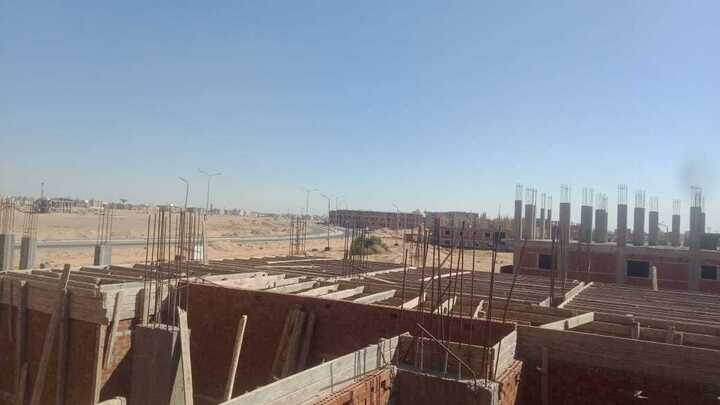

First floor slab
December 28, 2023

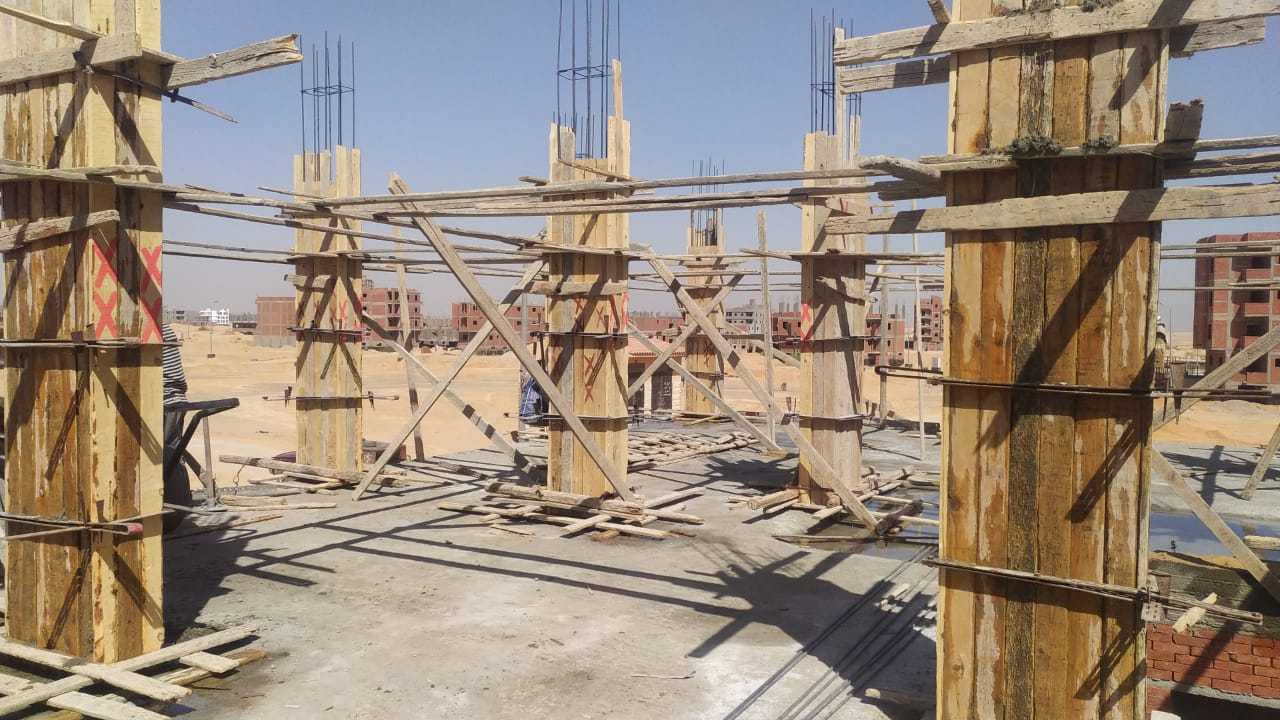

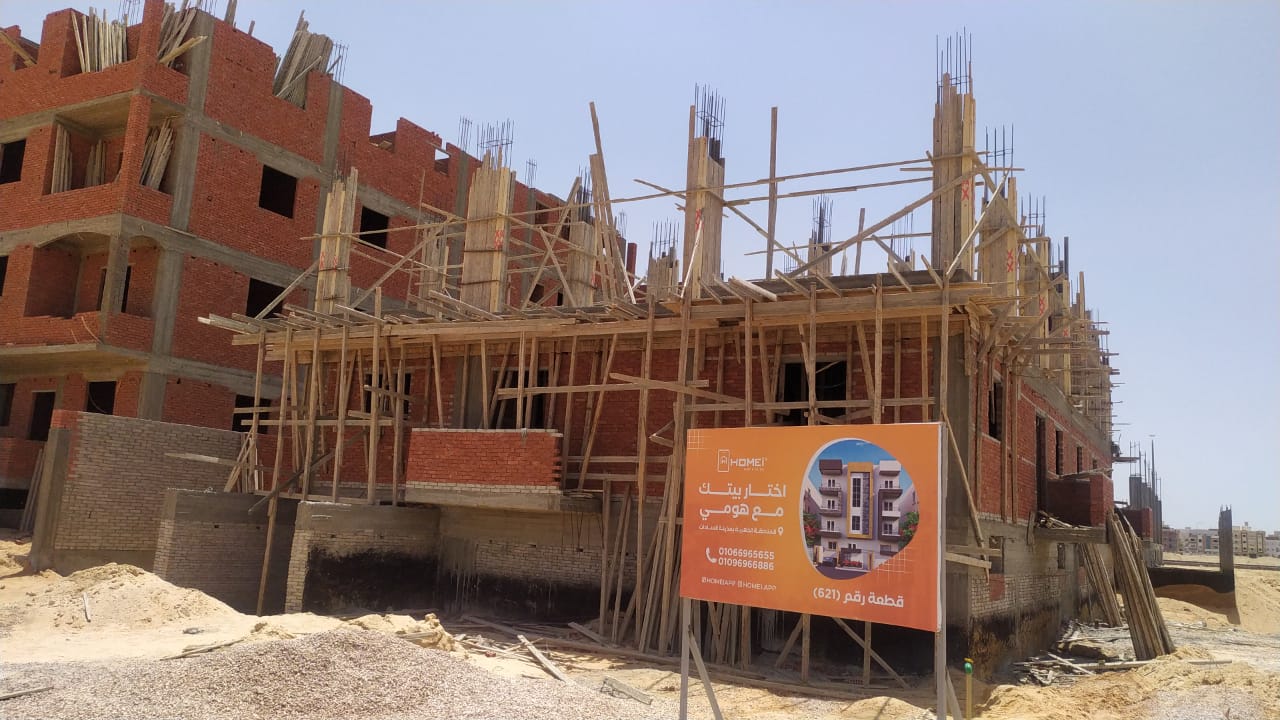

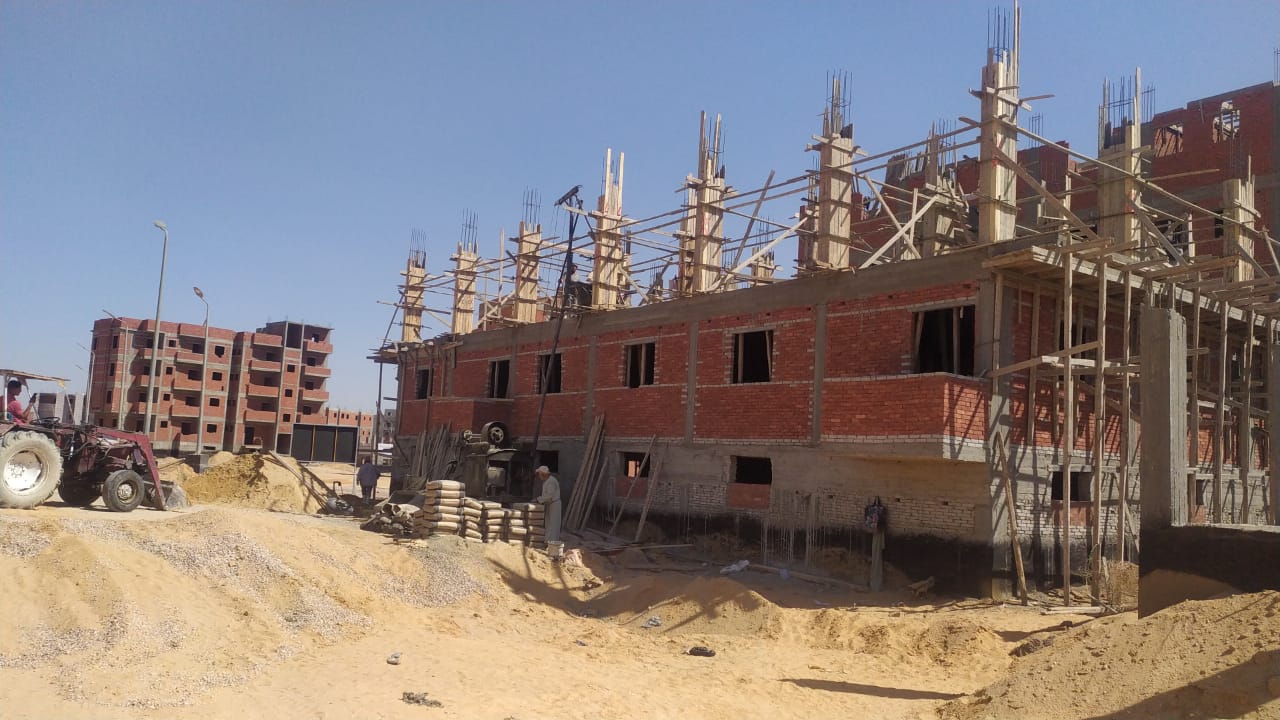

Second floor columns
January 7, 2024

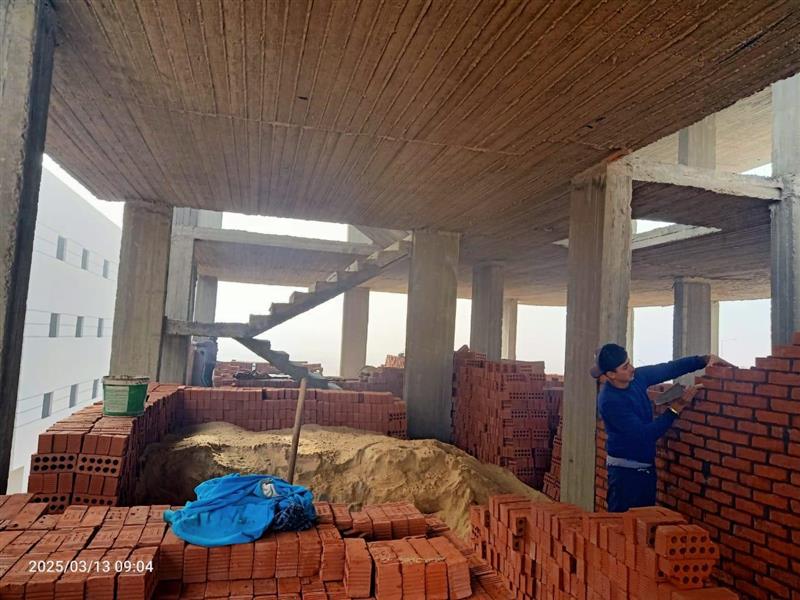

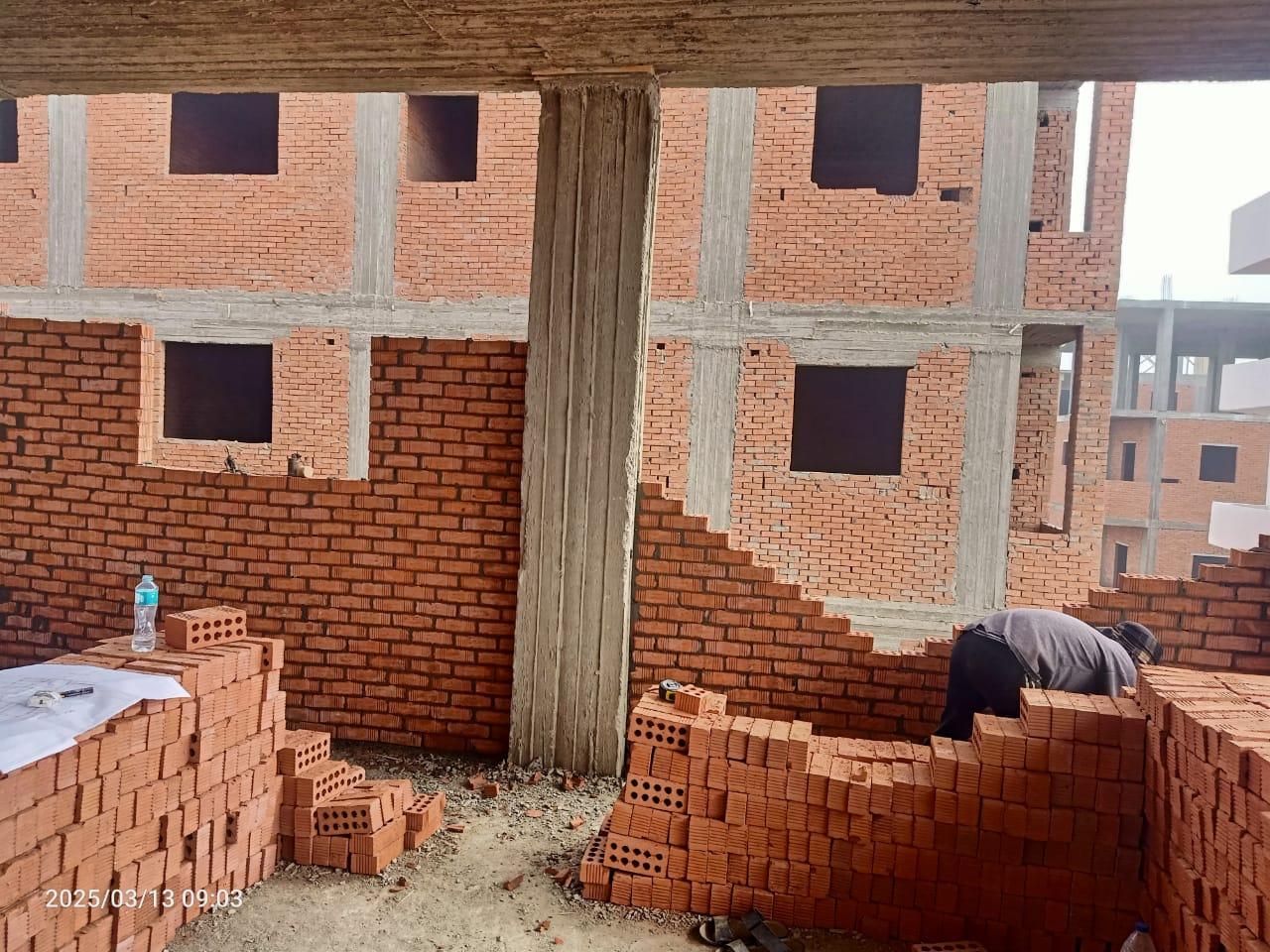

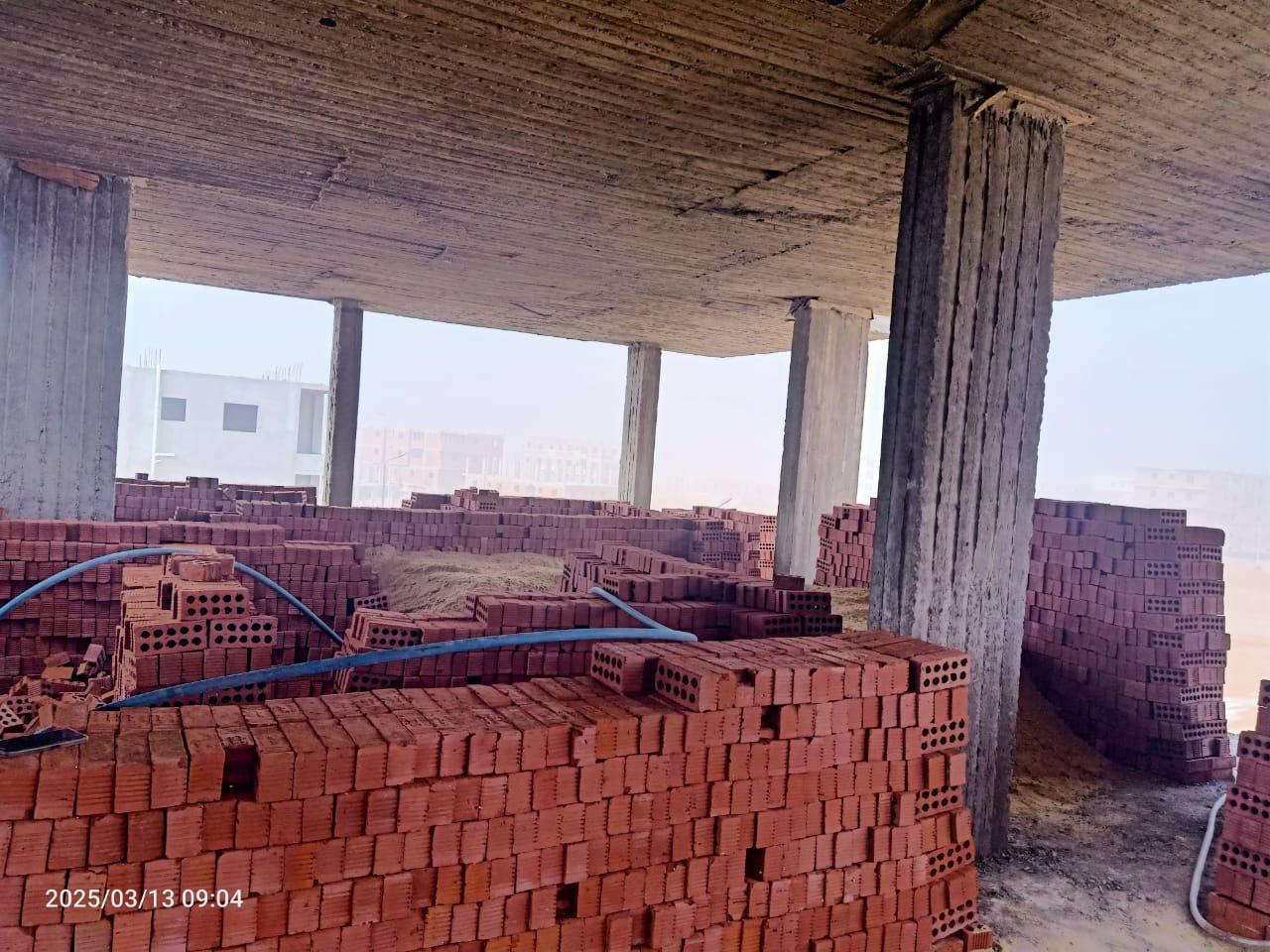

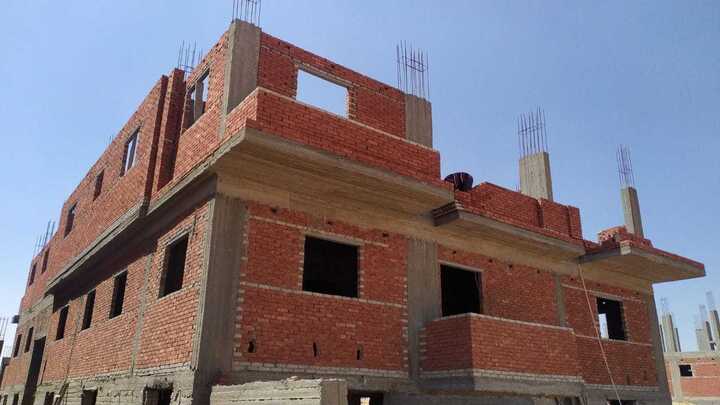

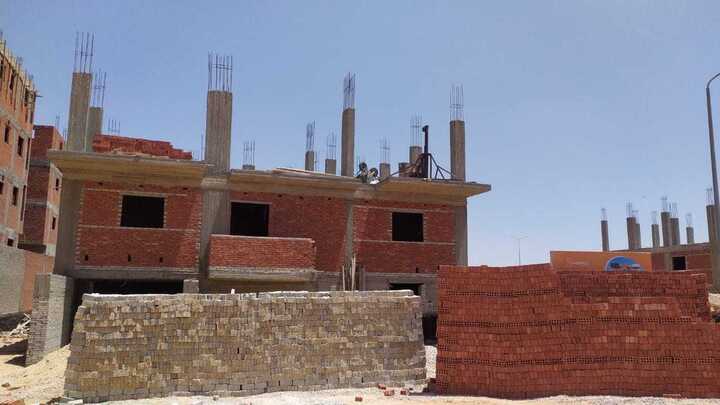

Second floor walls
January 17, 2024

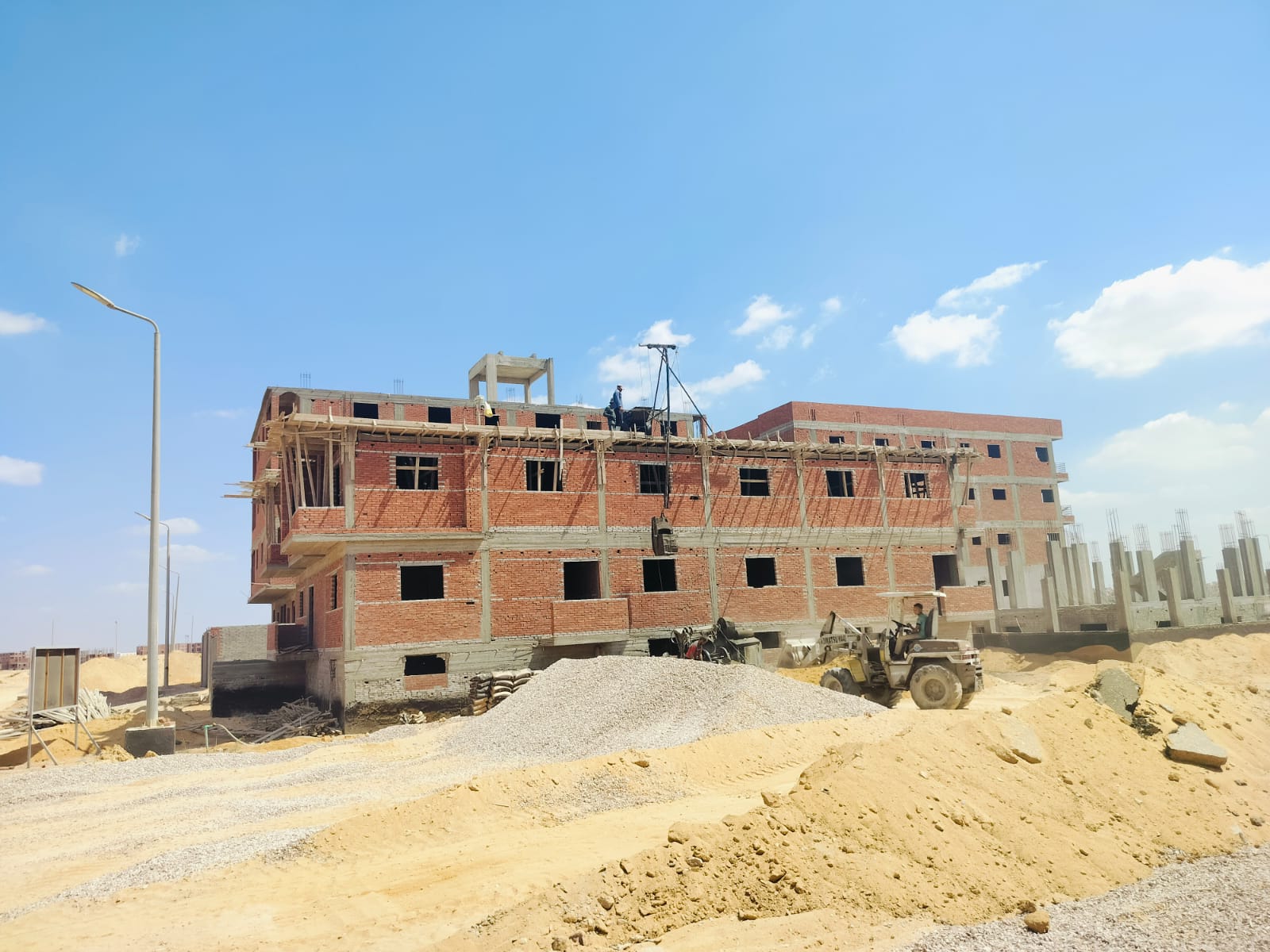

Second floor slab

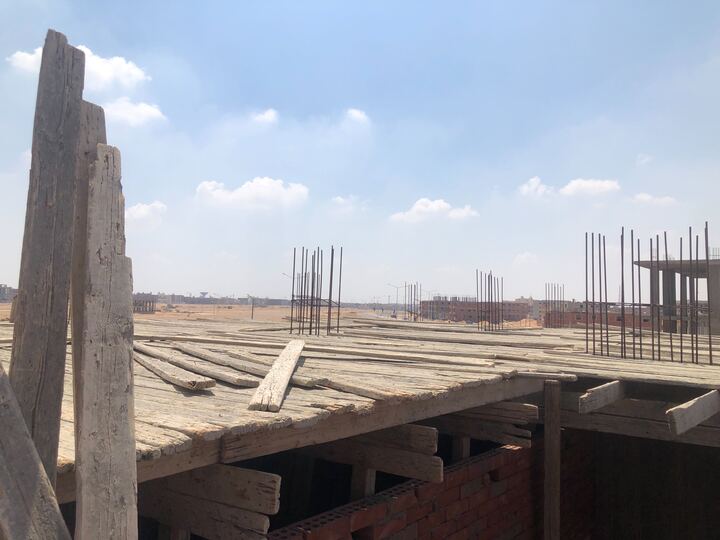

January 27, 2024

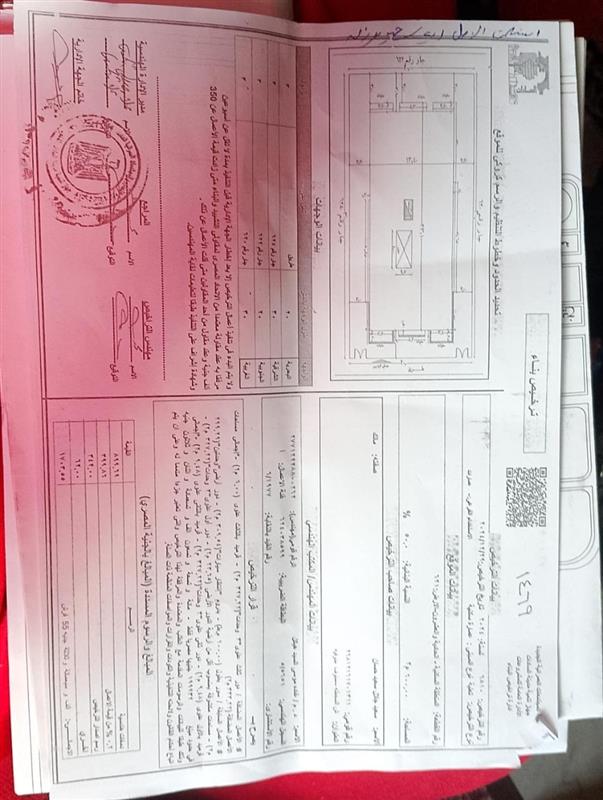

Third-floor addition permit
December 1, 2024
Obtaining an insurance certificate for a third-floor extension
December 15, 2024

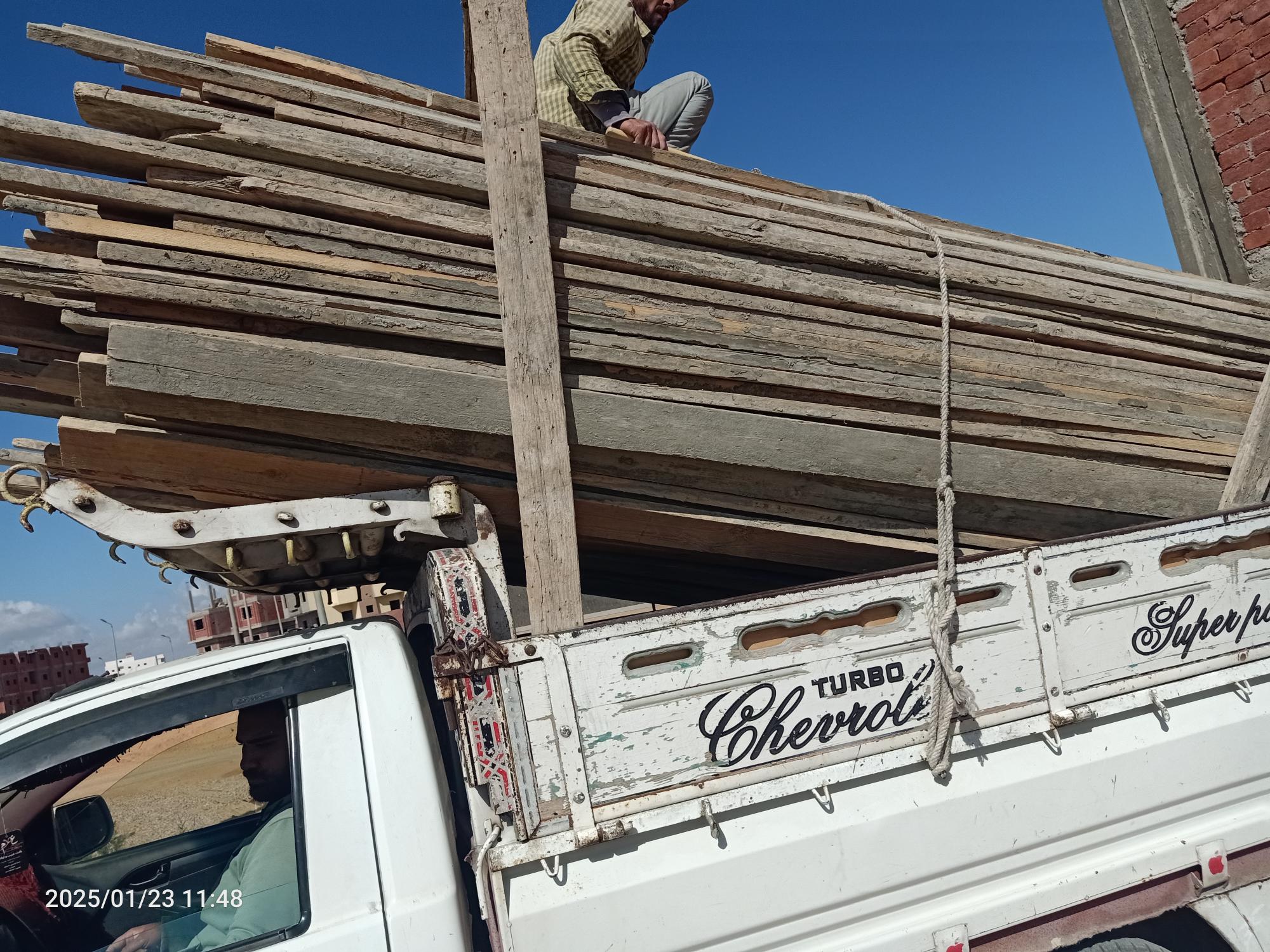

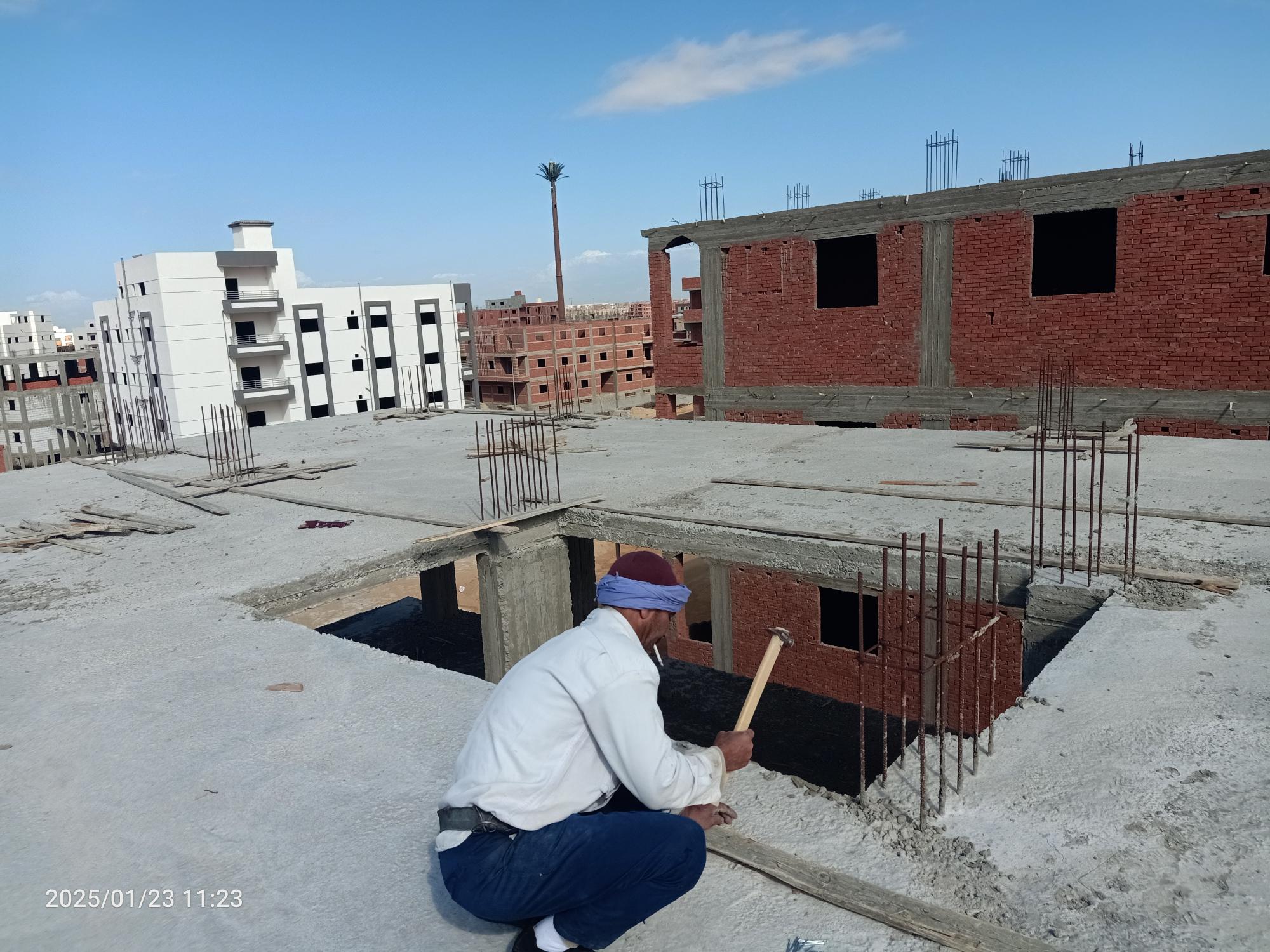

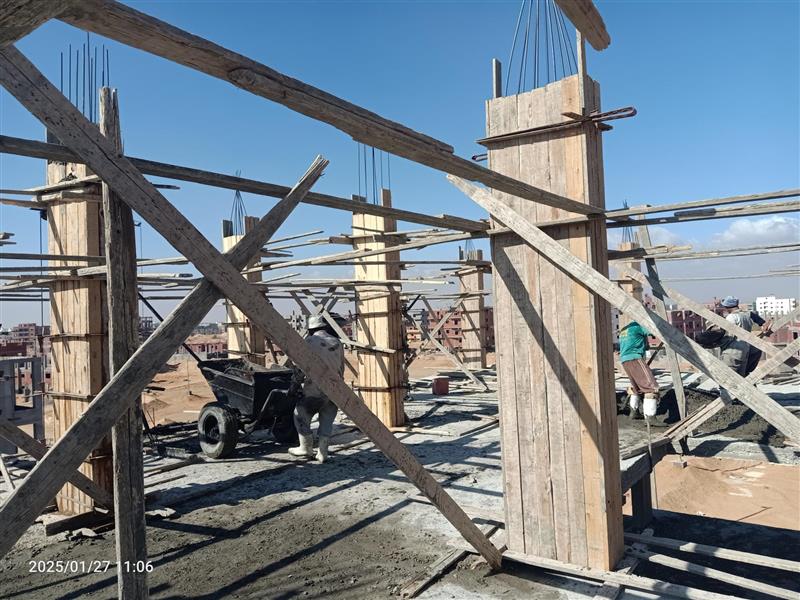

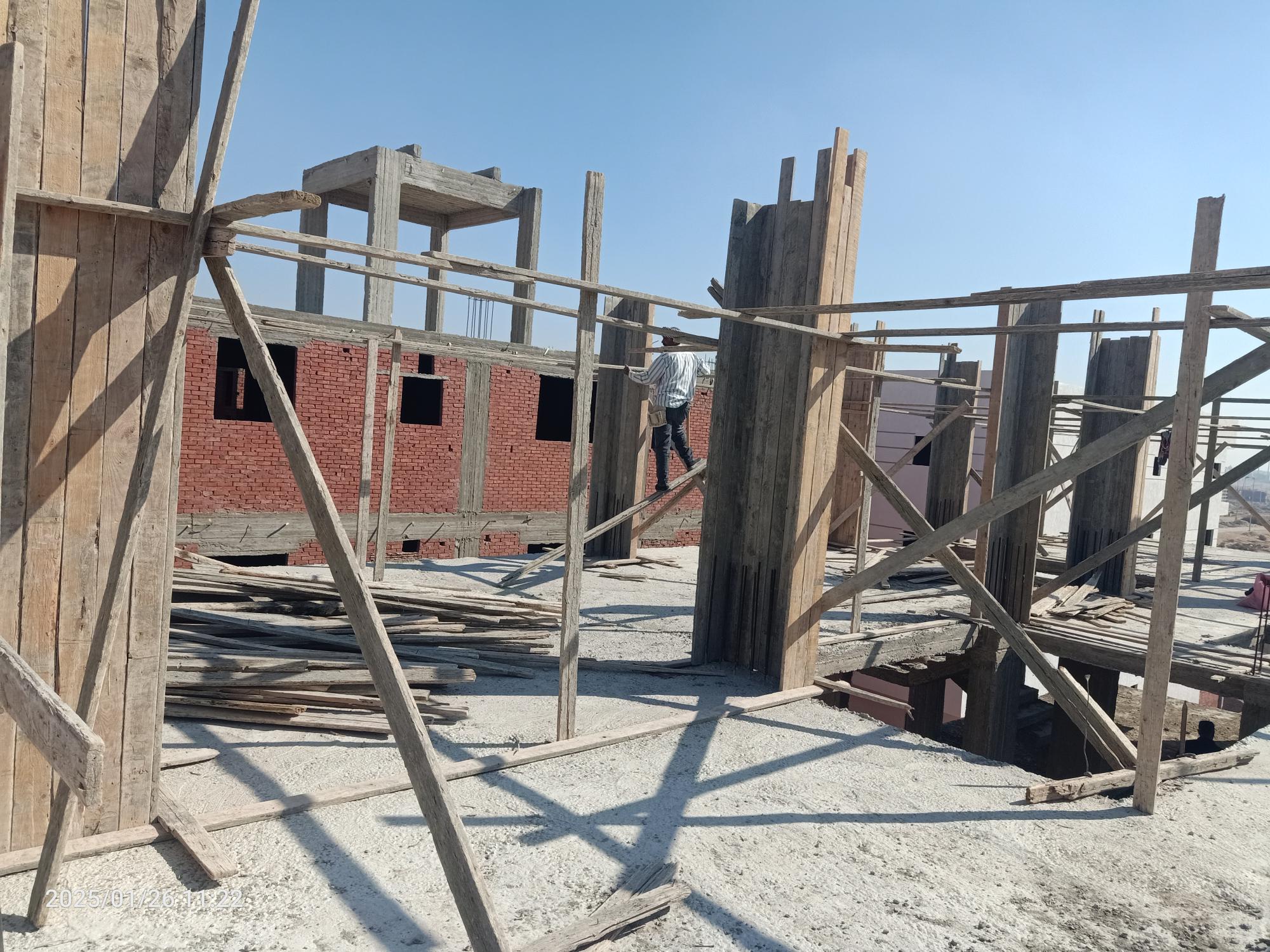

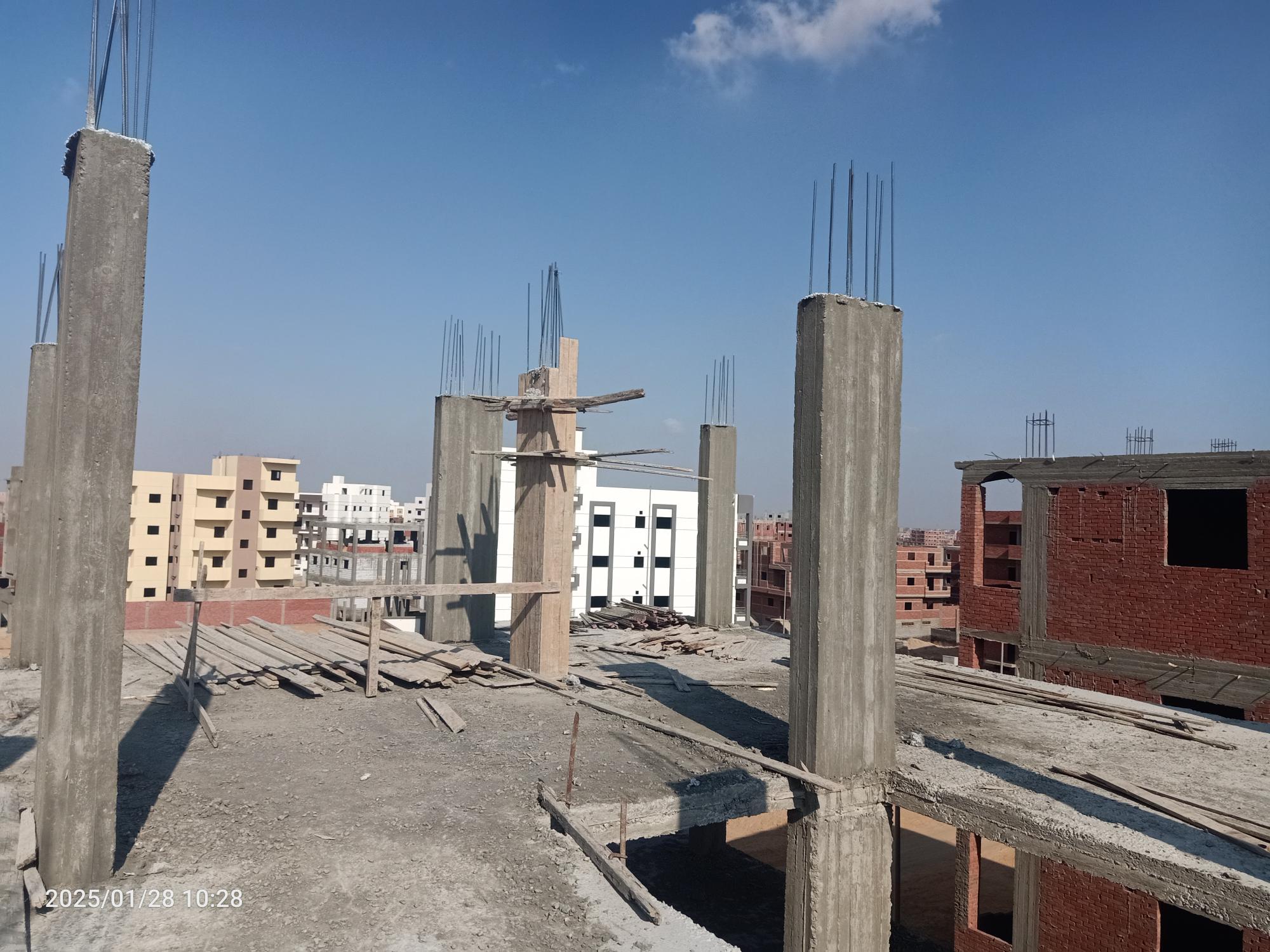

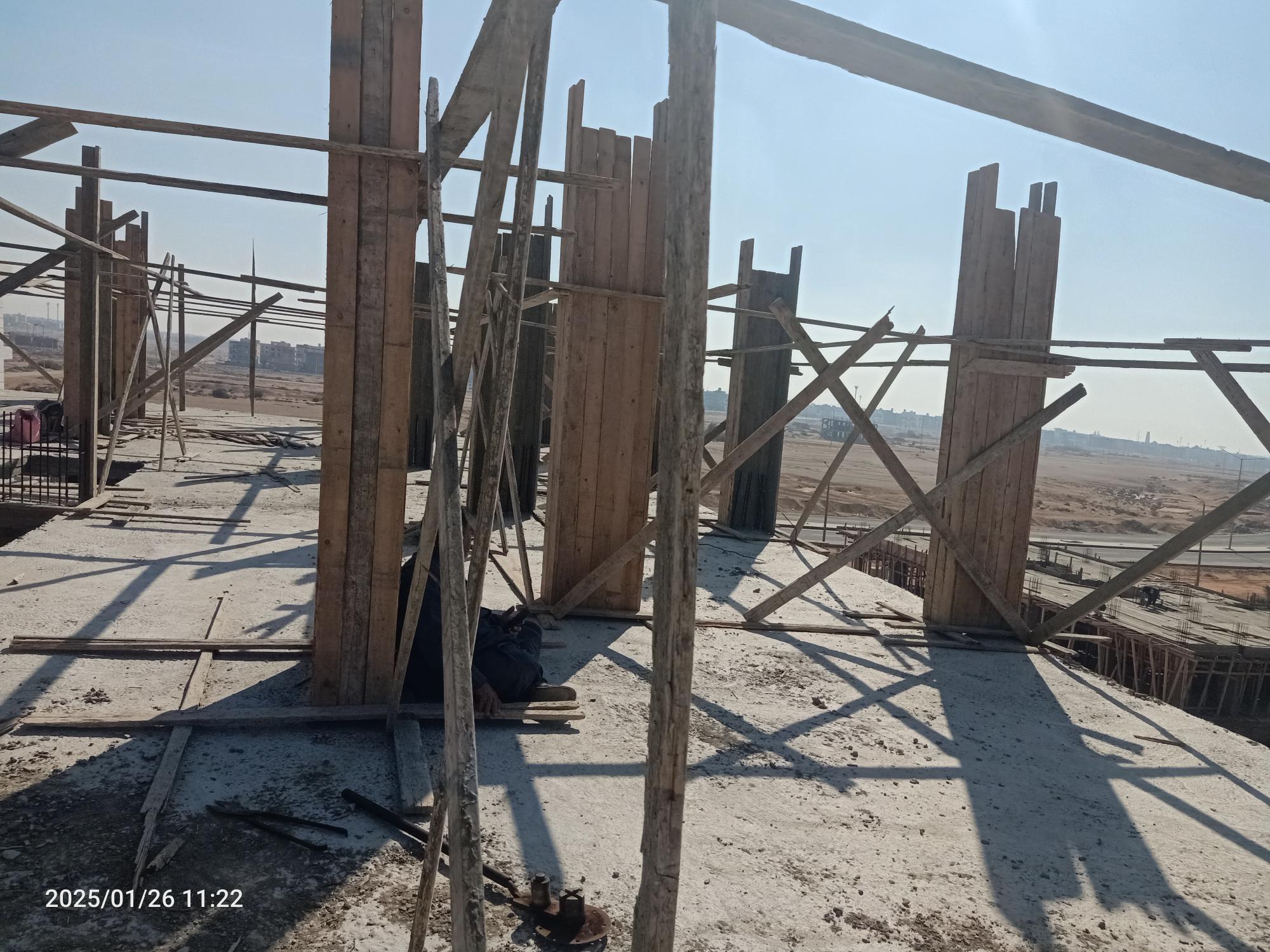

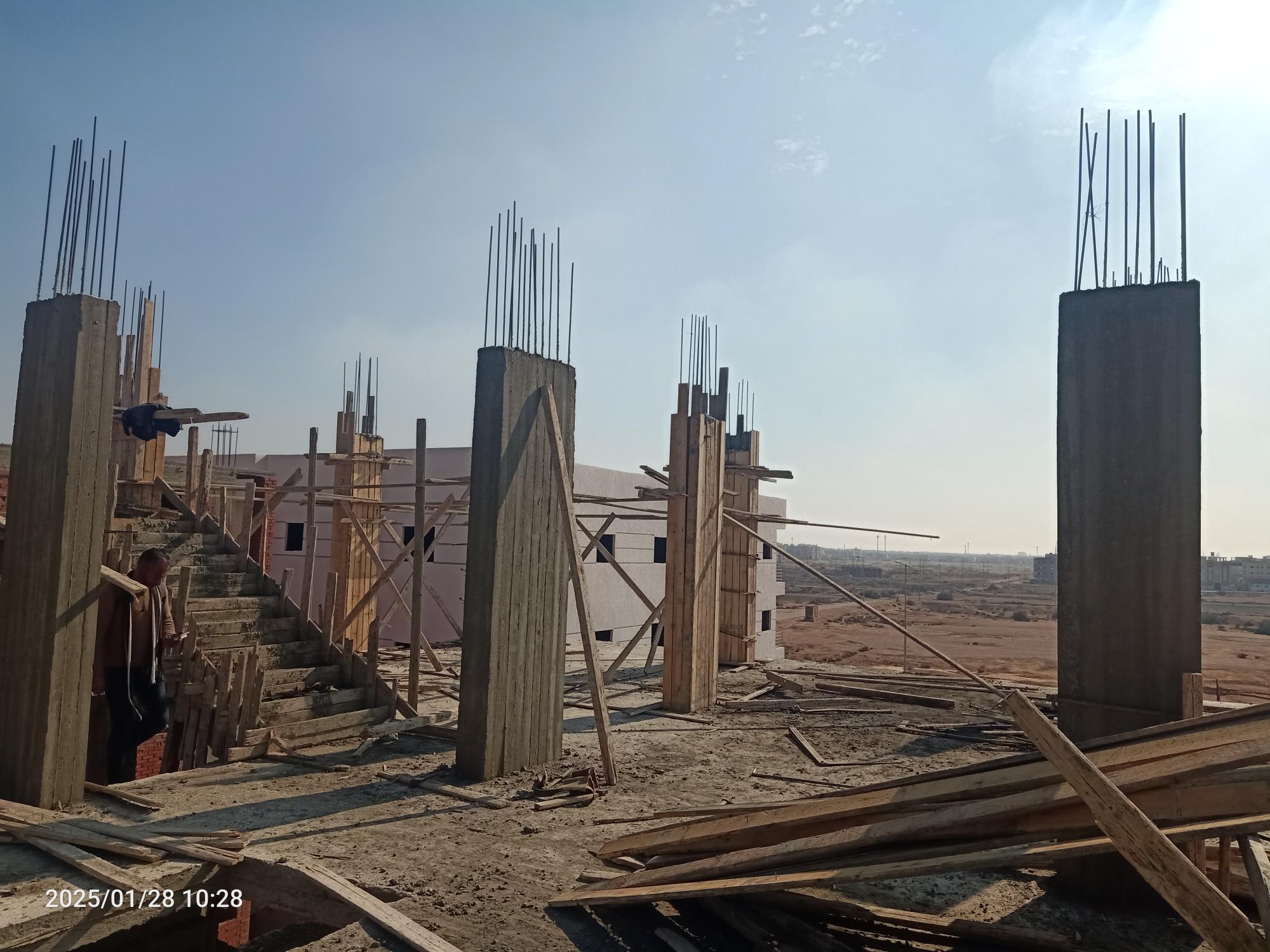

Third floor columns

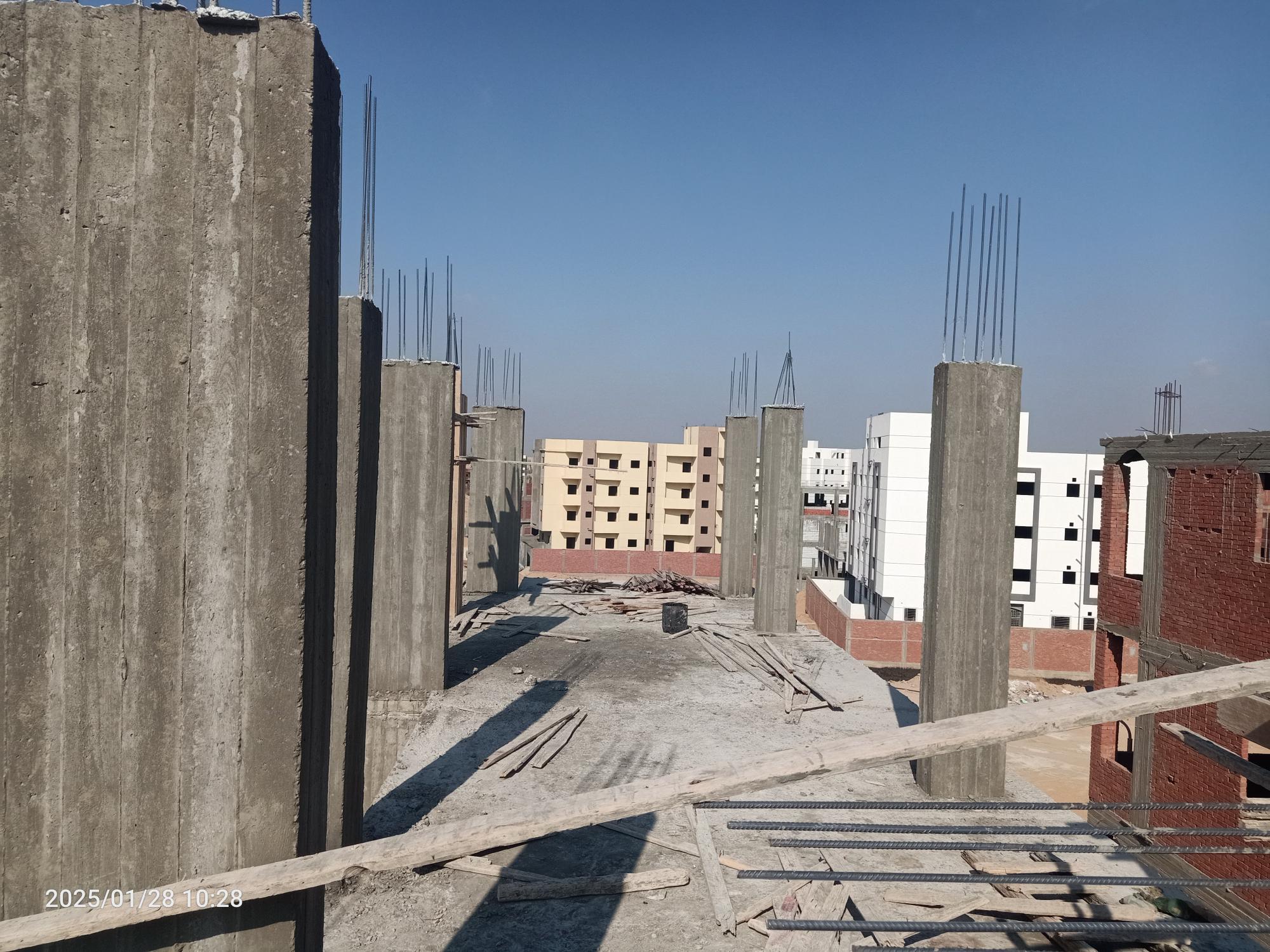

January 24, 2025

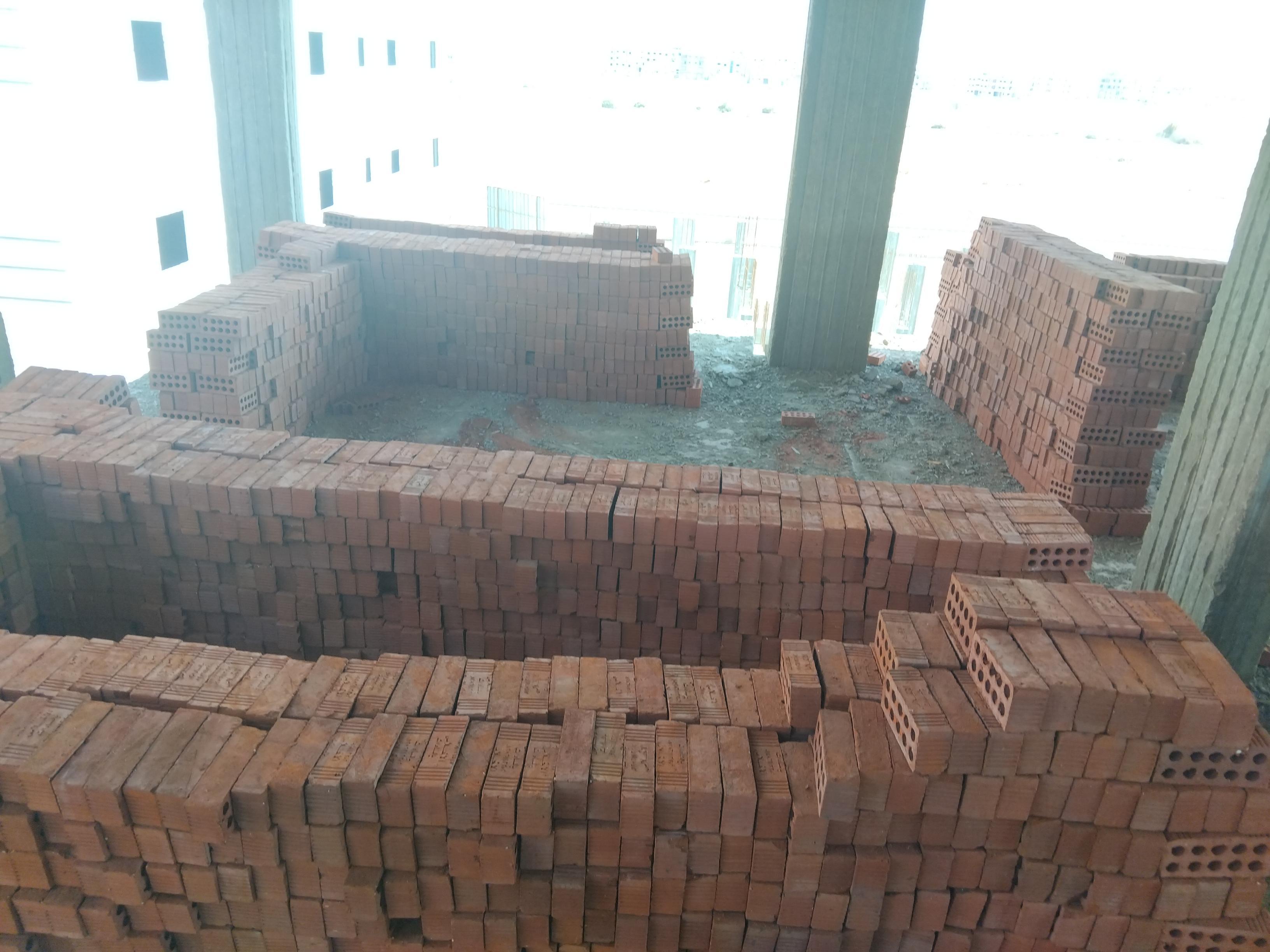

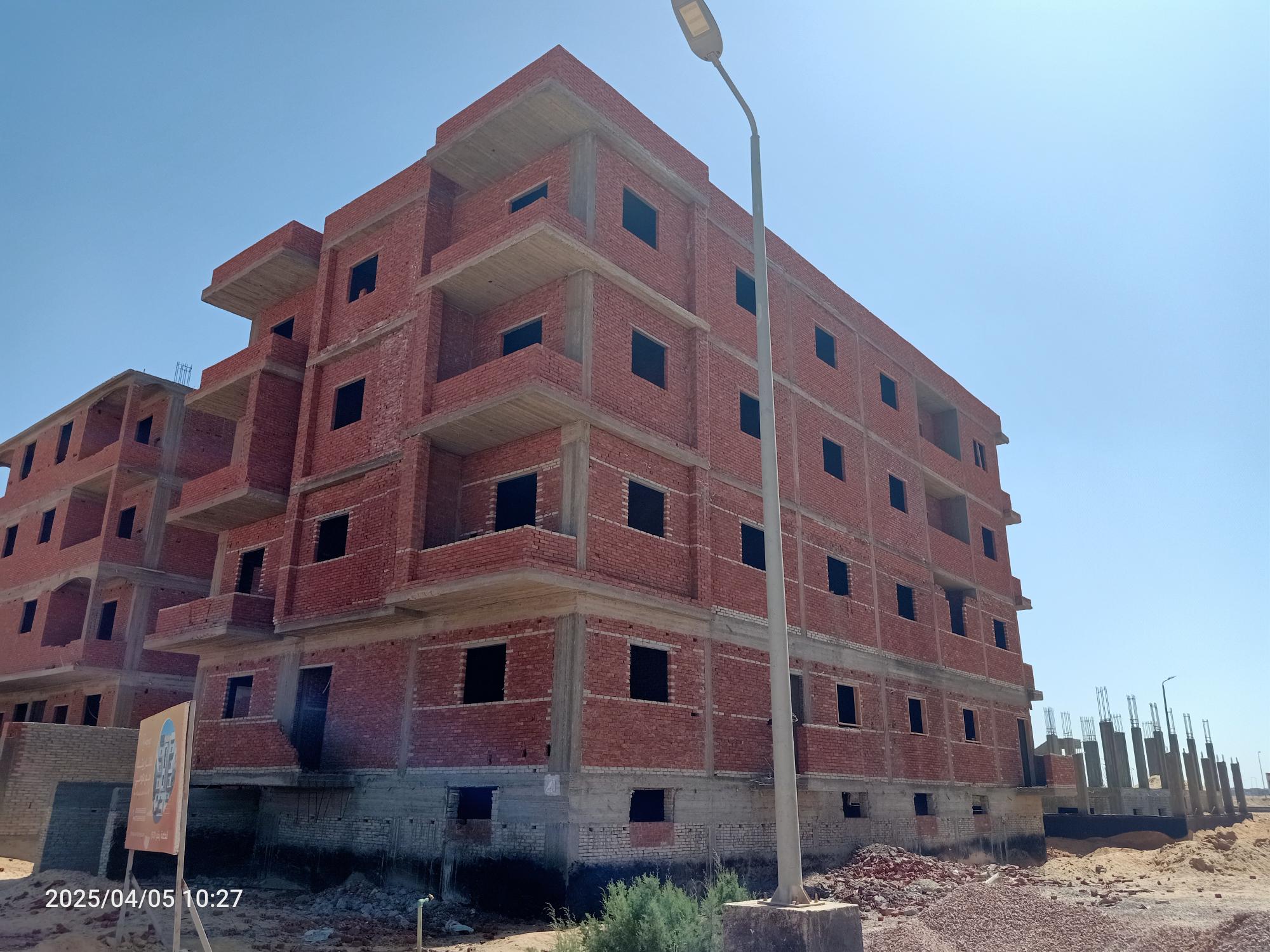

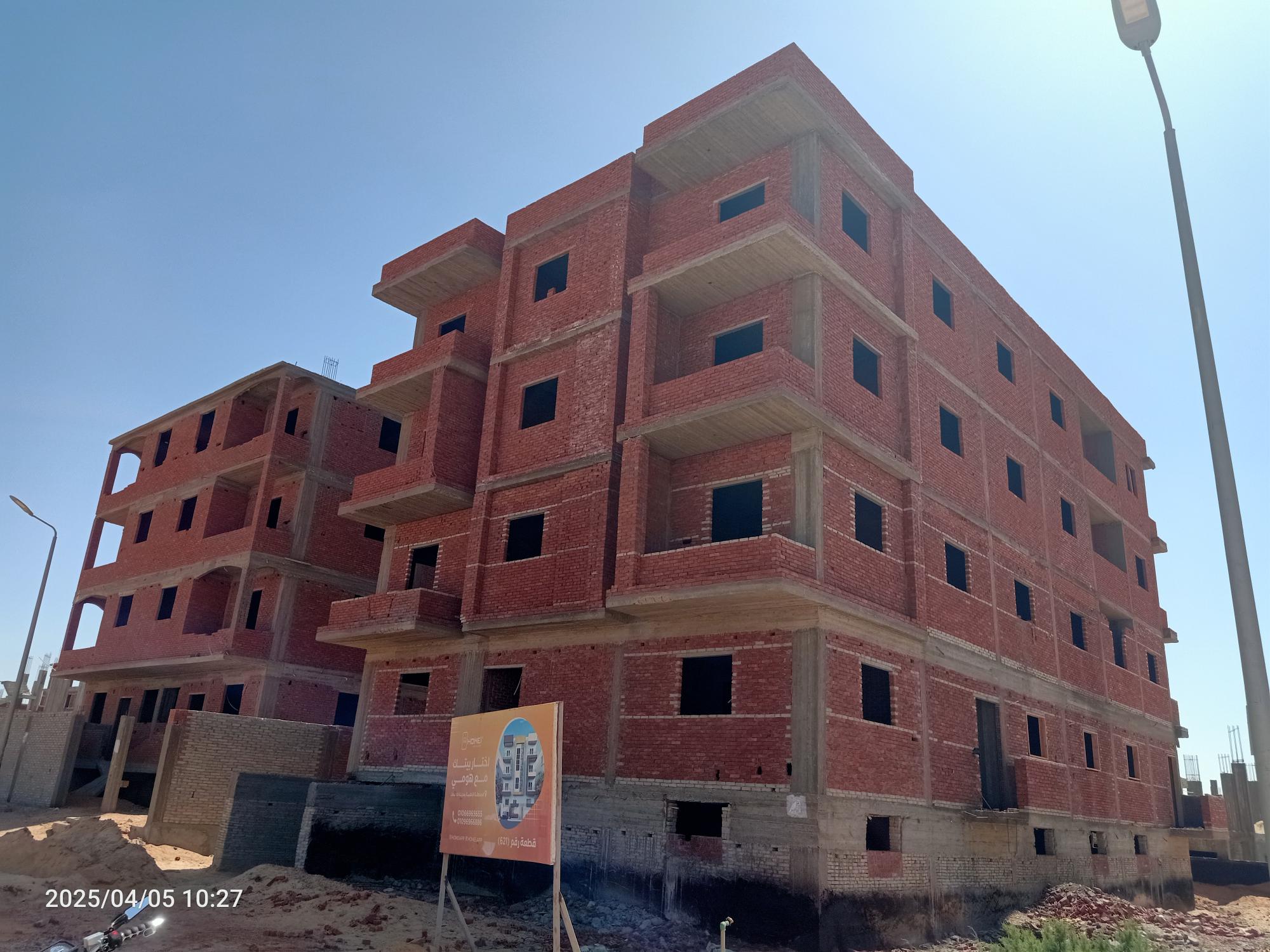

Third floor walls

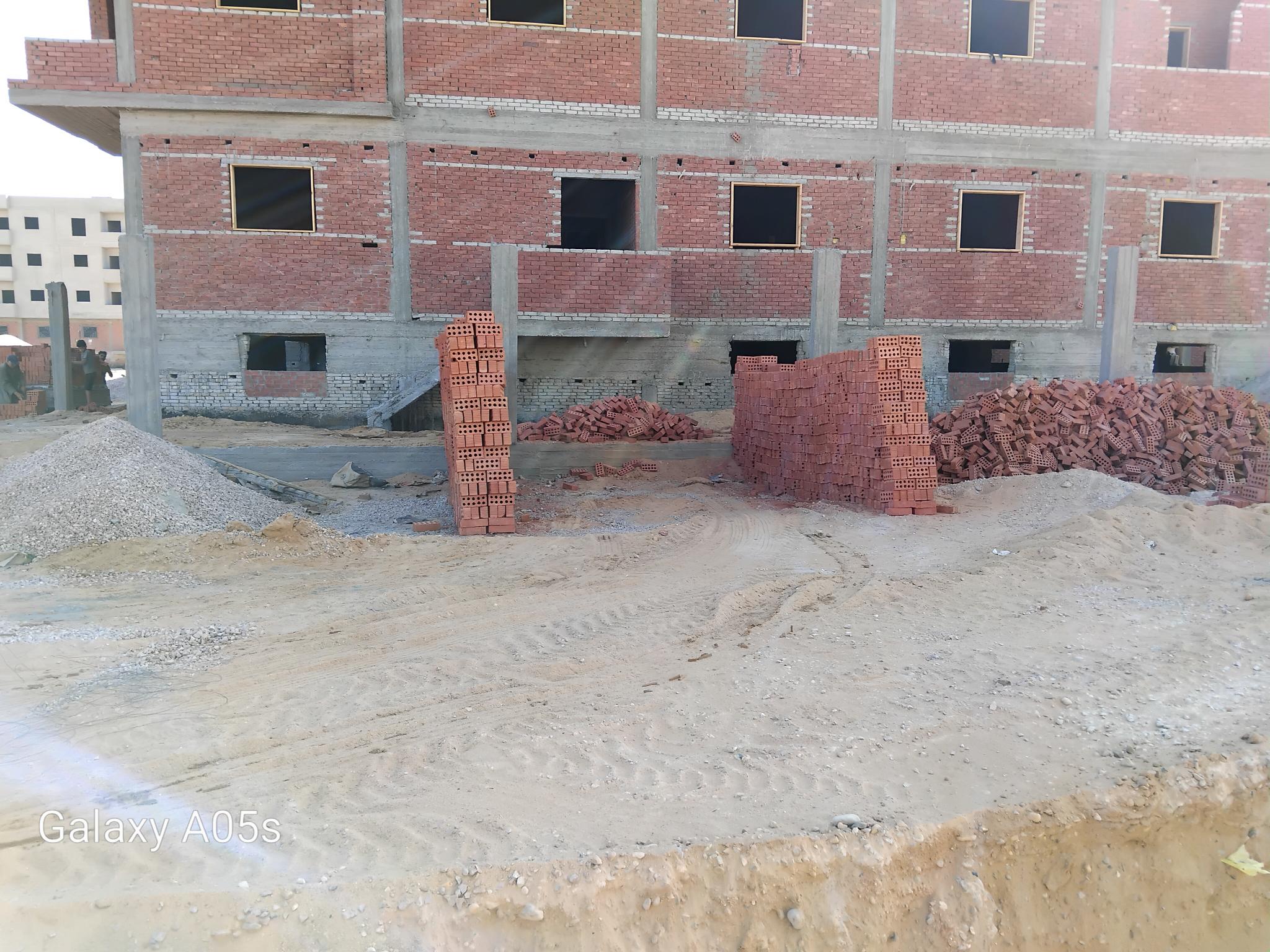

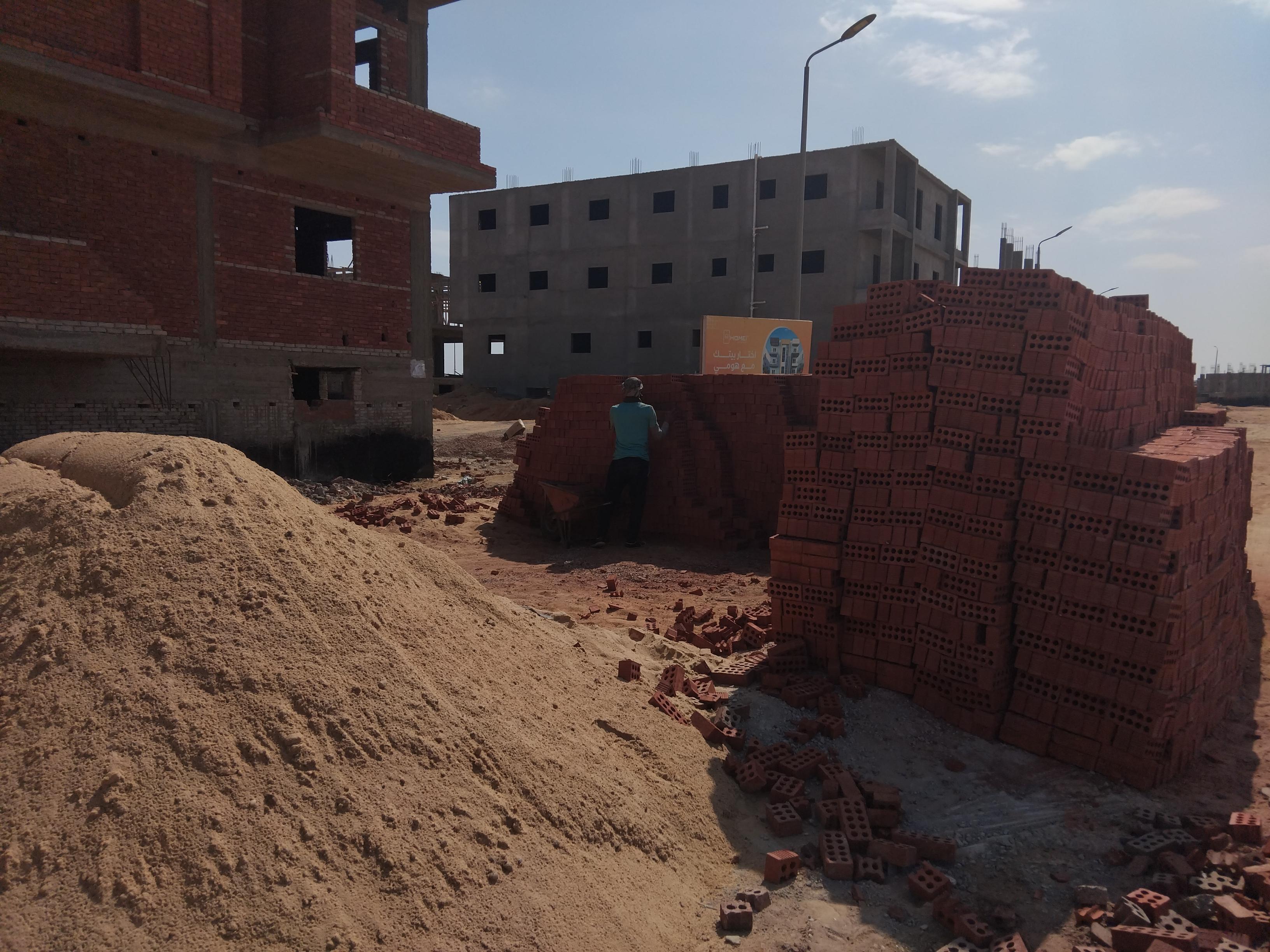

January 28, 2025

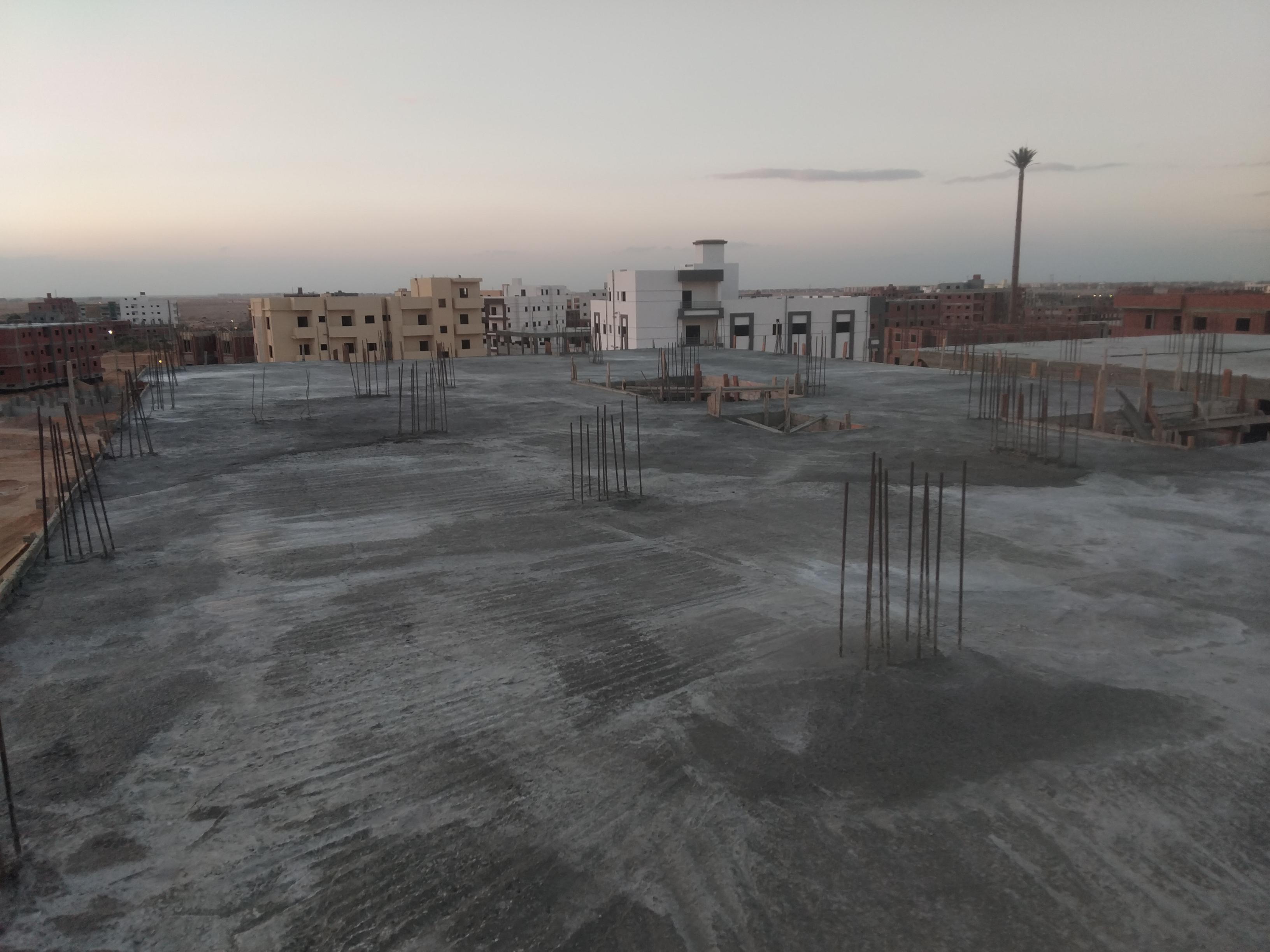

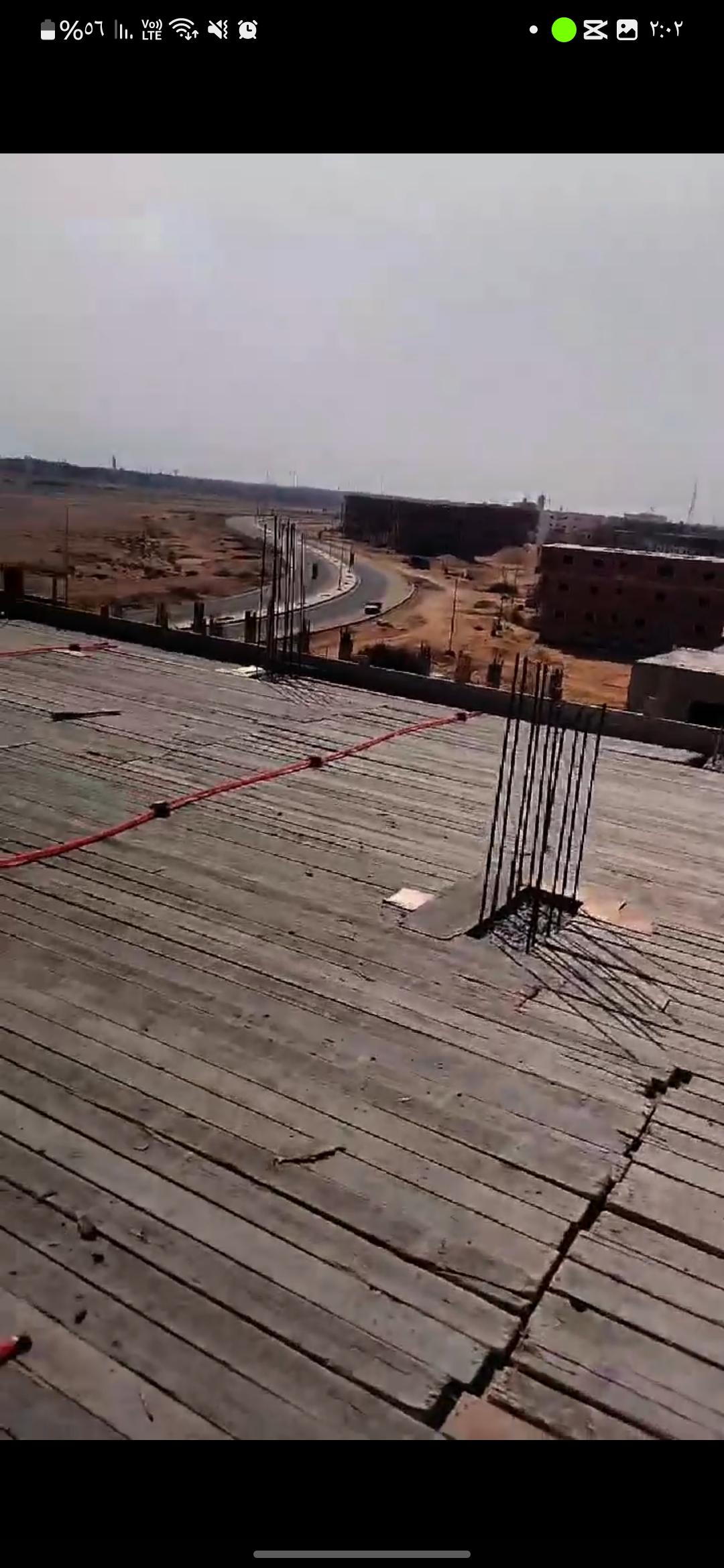

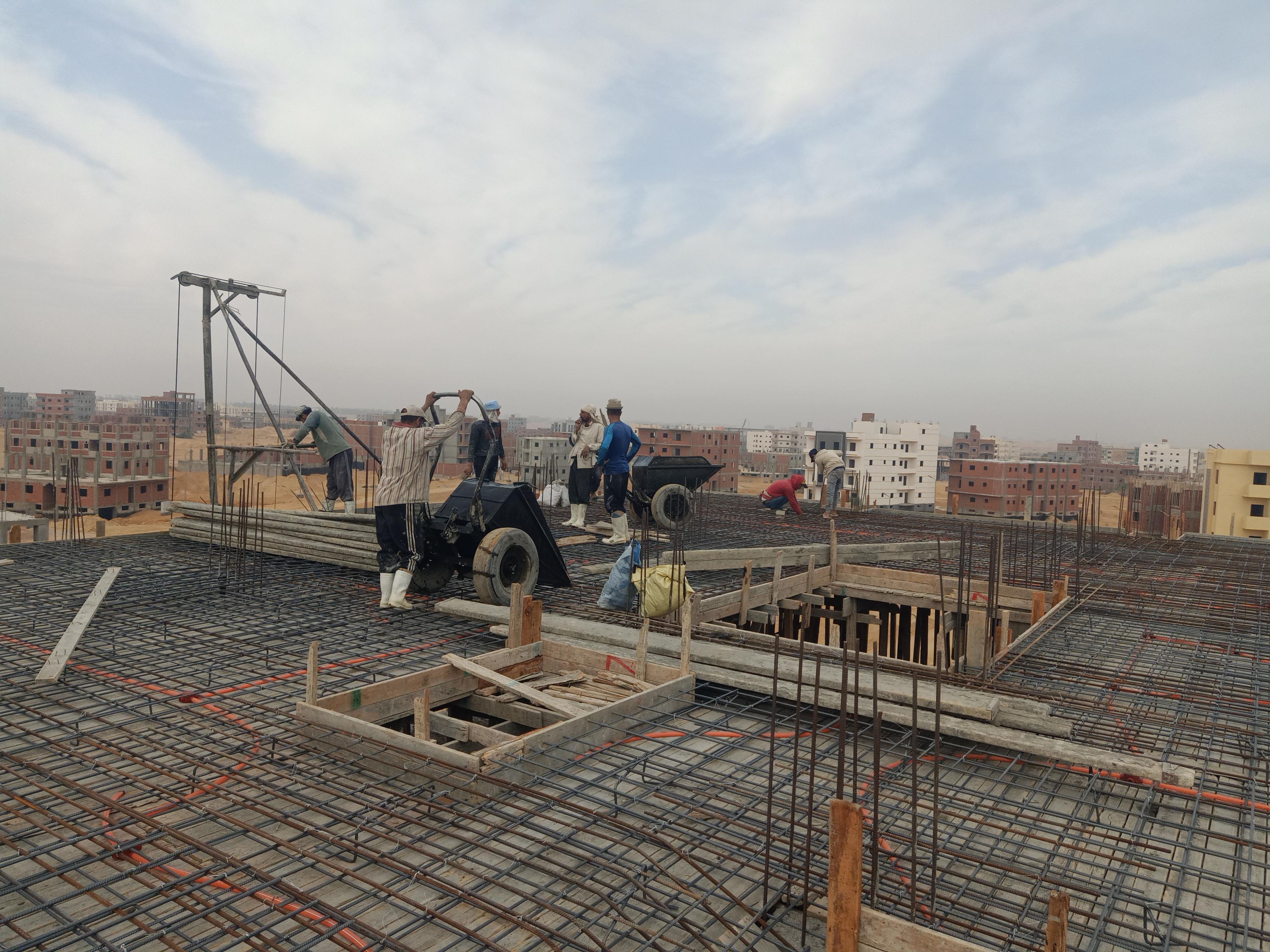

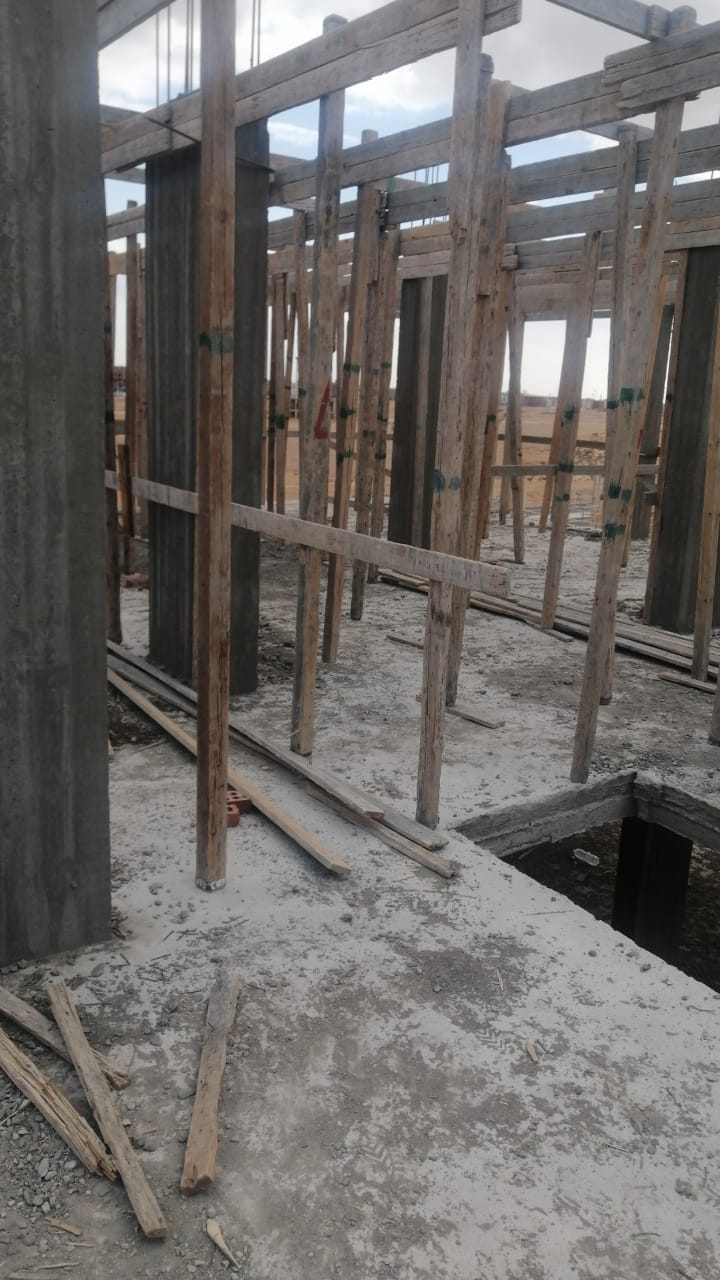

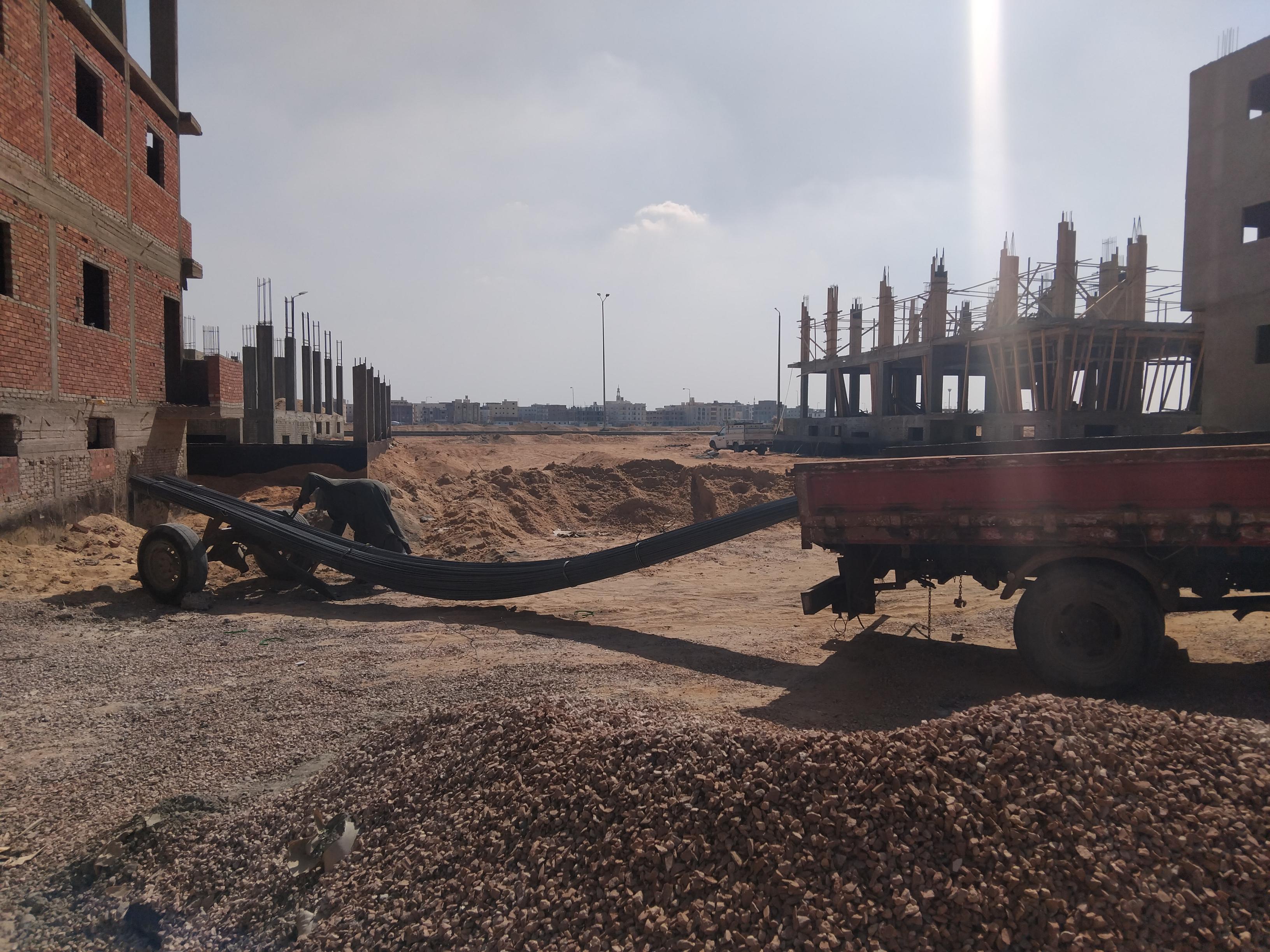

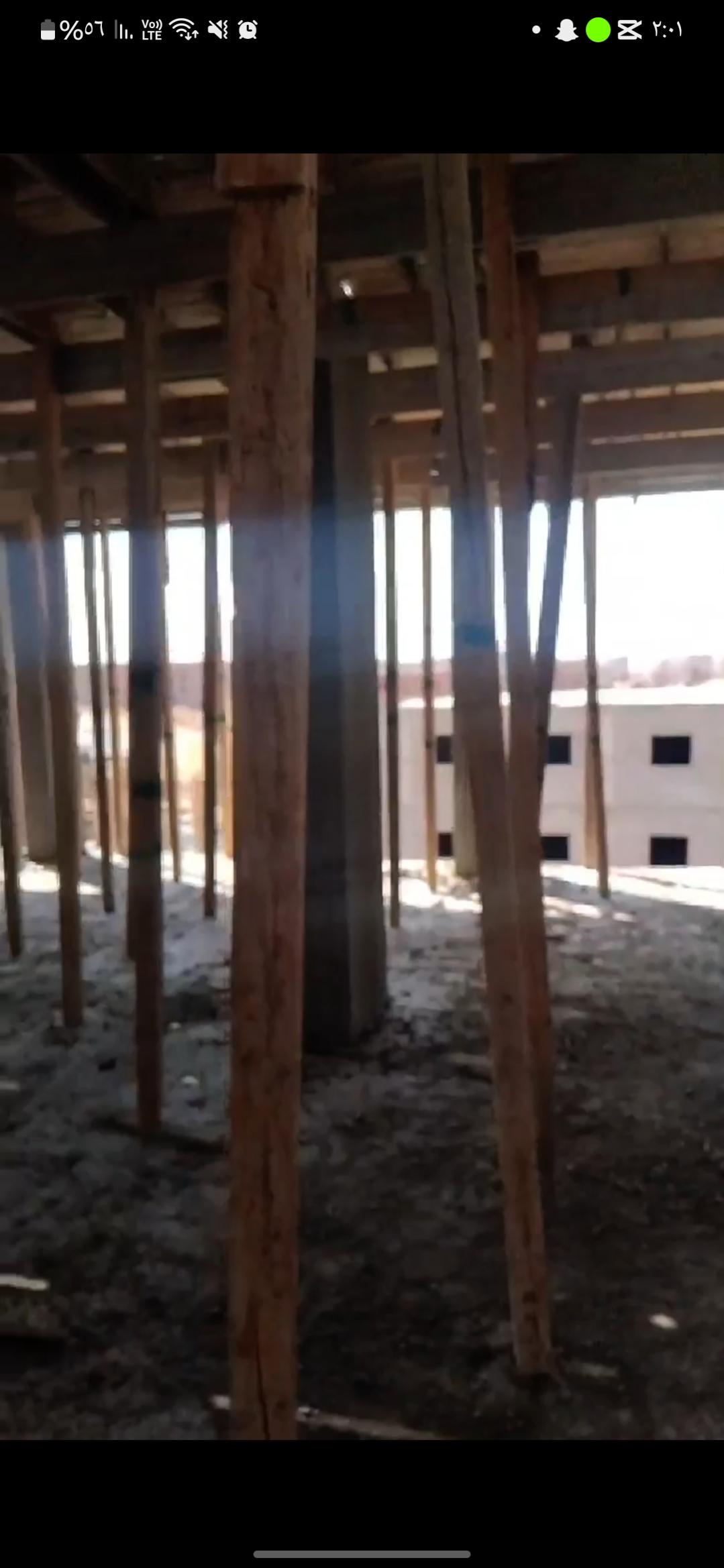

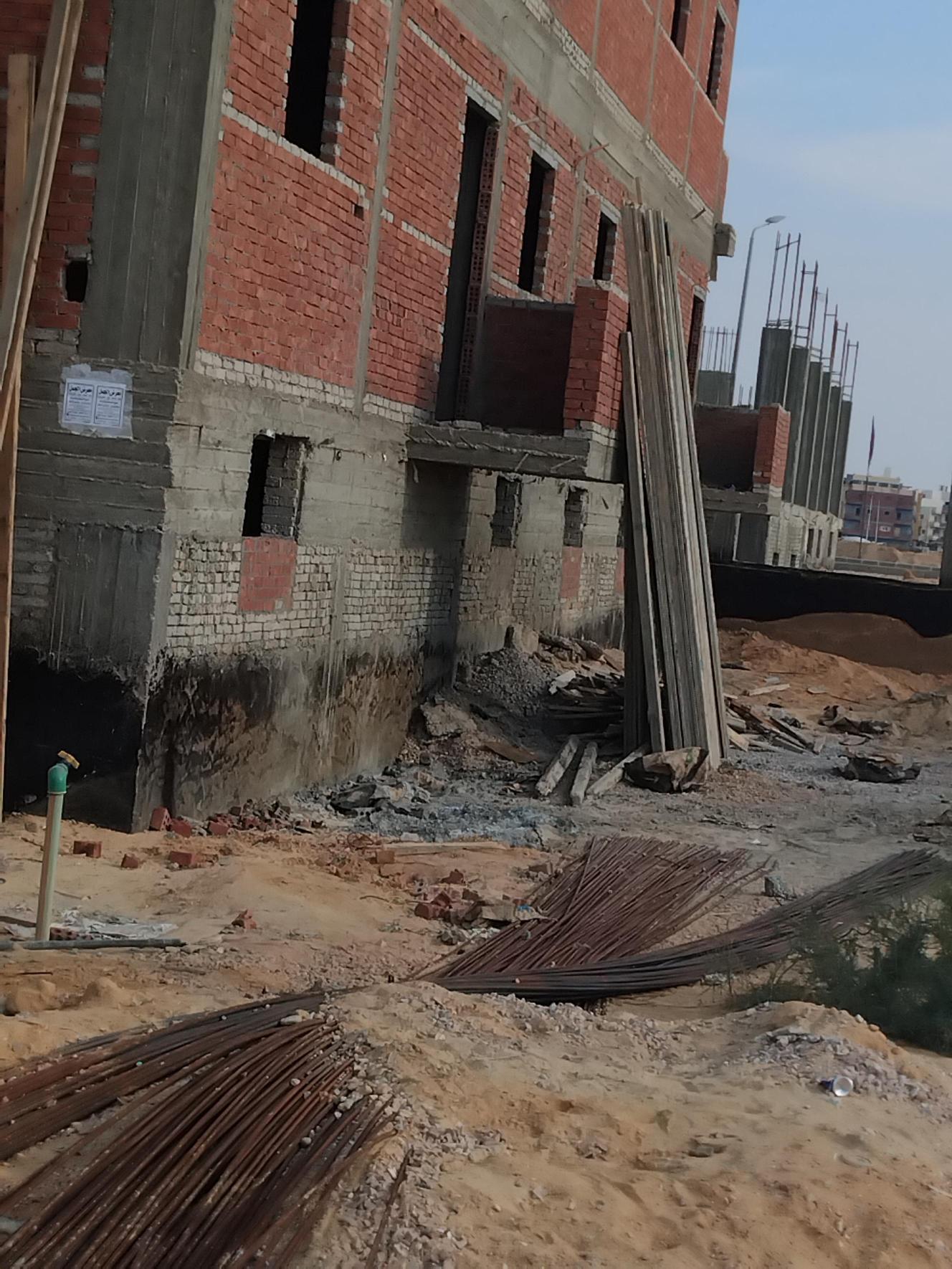

Third floor slab

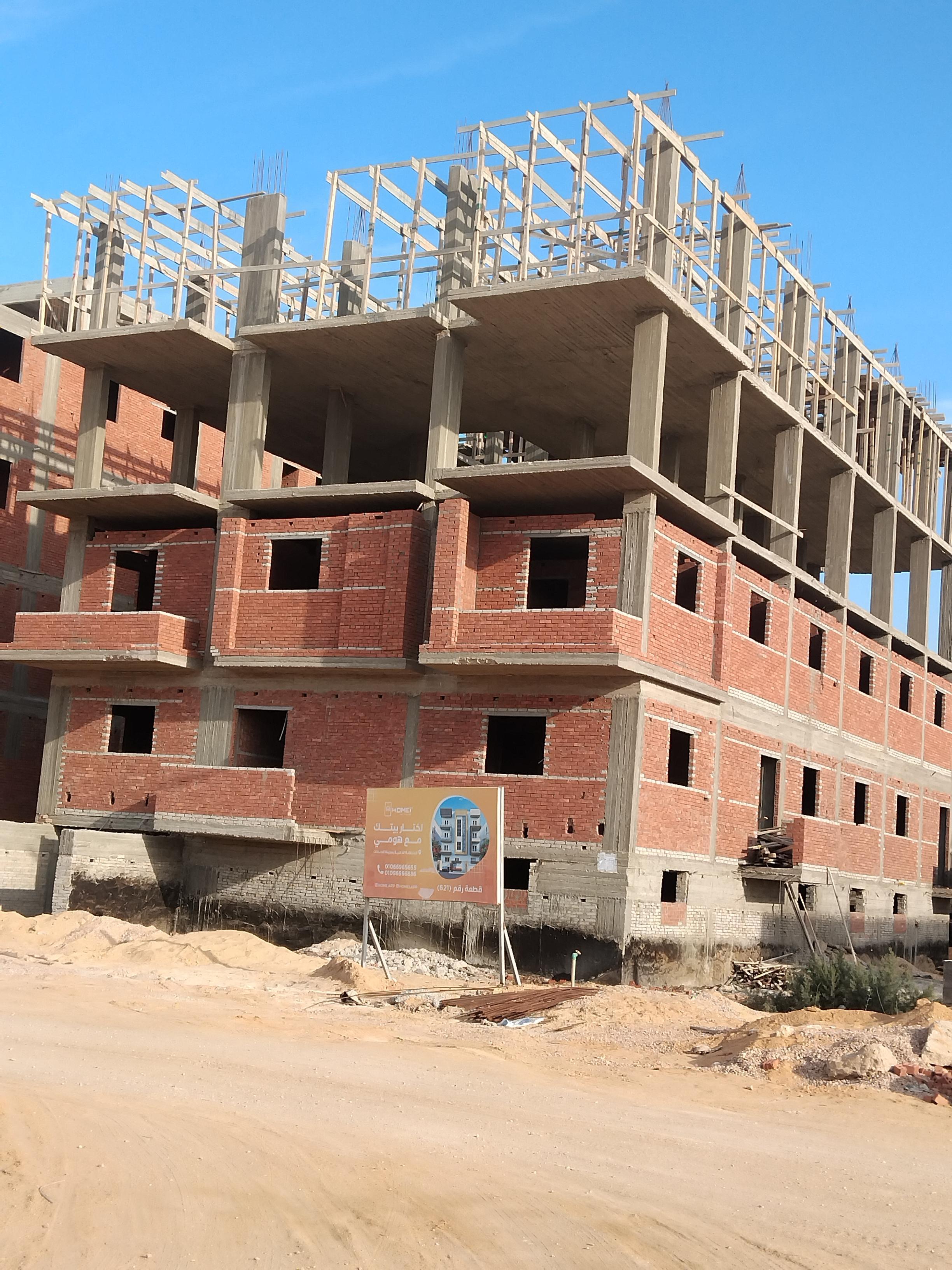

February 4, 2025
Roof extension license
February 5, 2025
Obtaining a roof insurance certificate
February 10, 2025
Roof concrete works
February 20, 2025

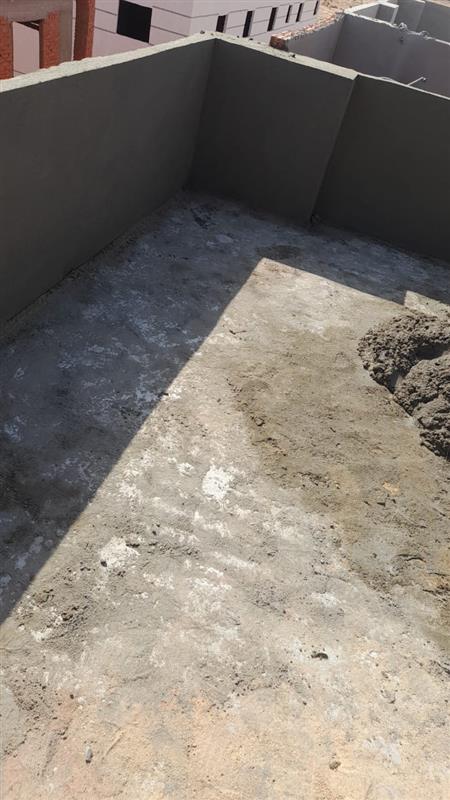

Roof walls
March 5, 2025

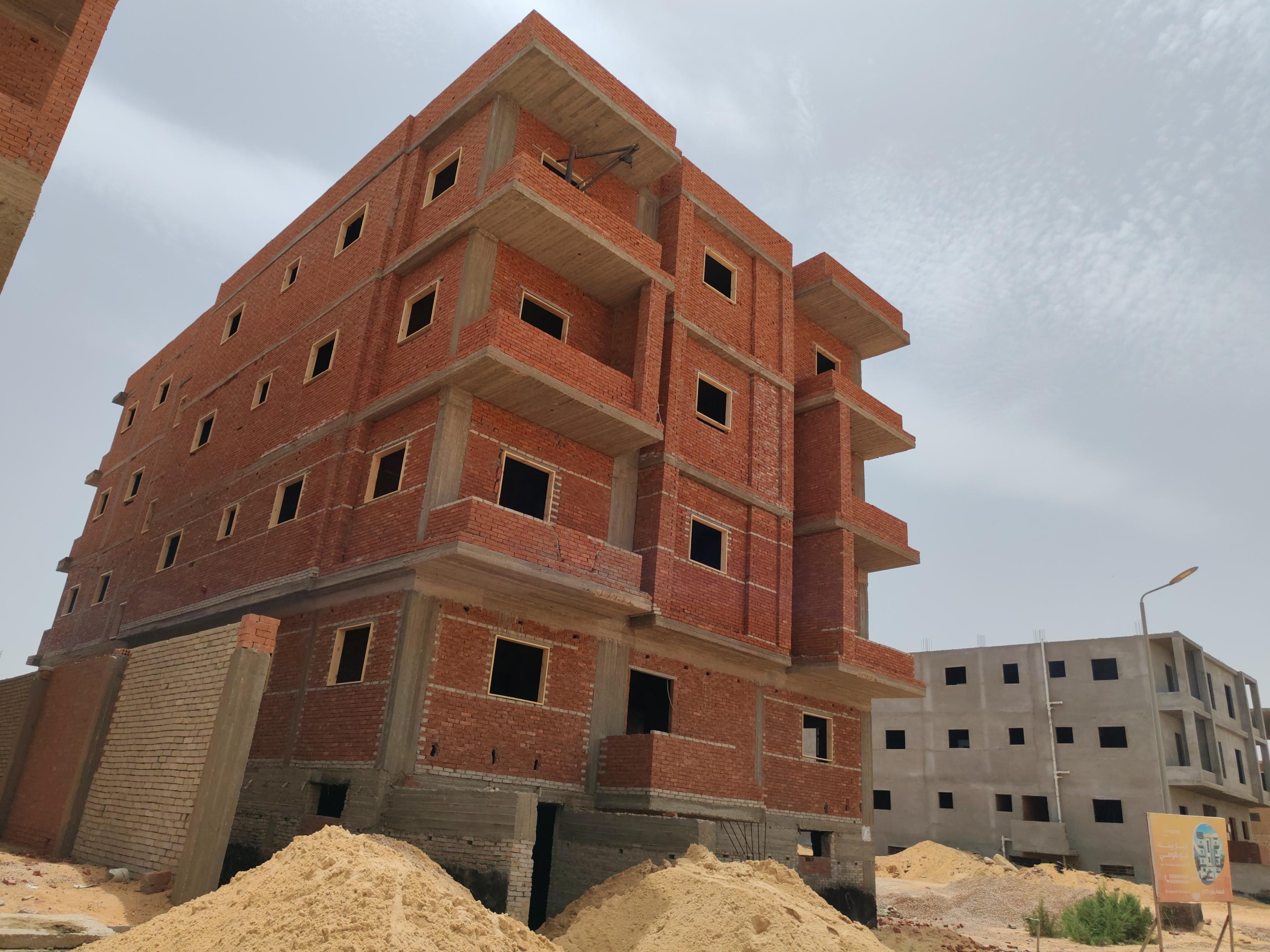

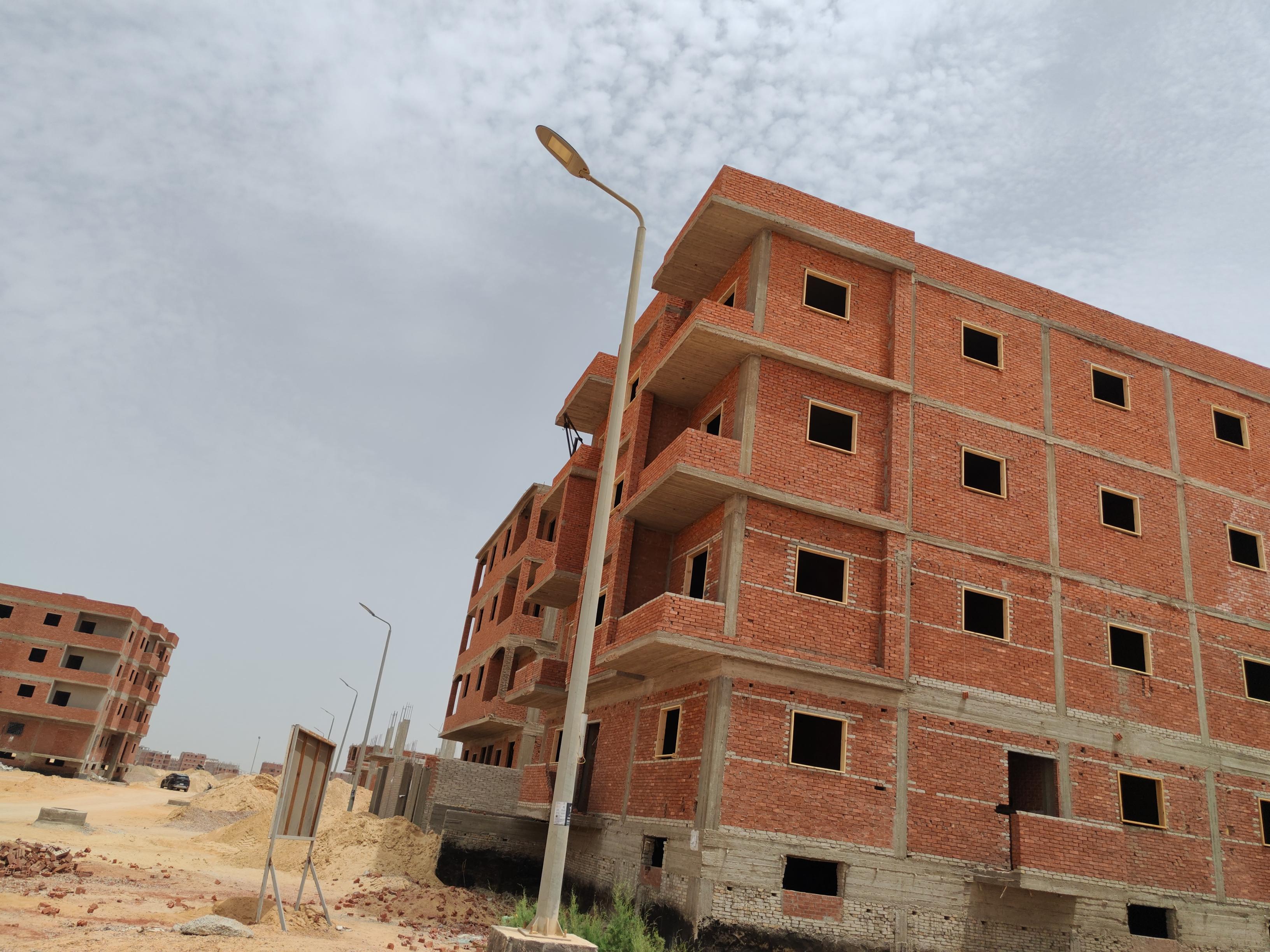

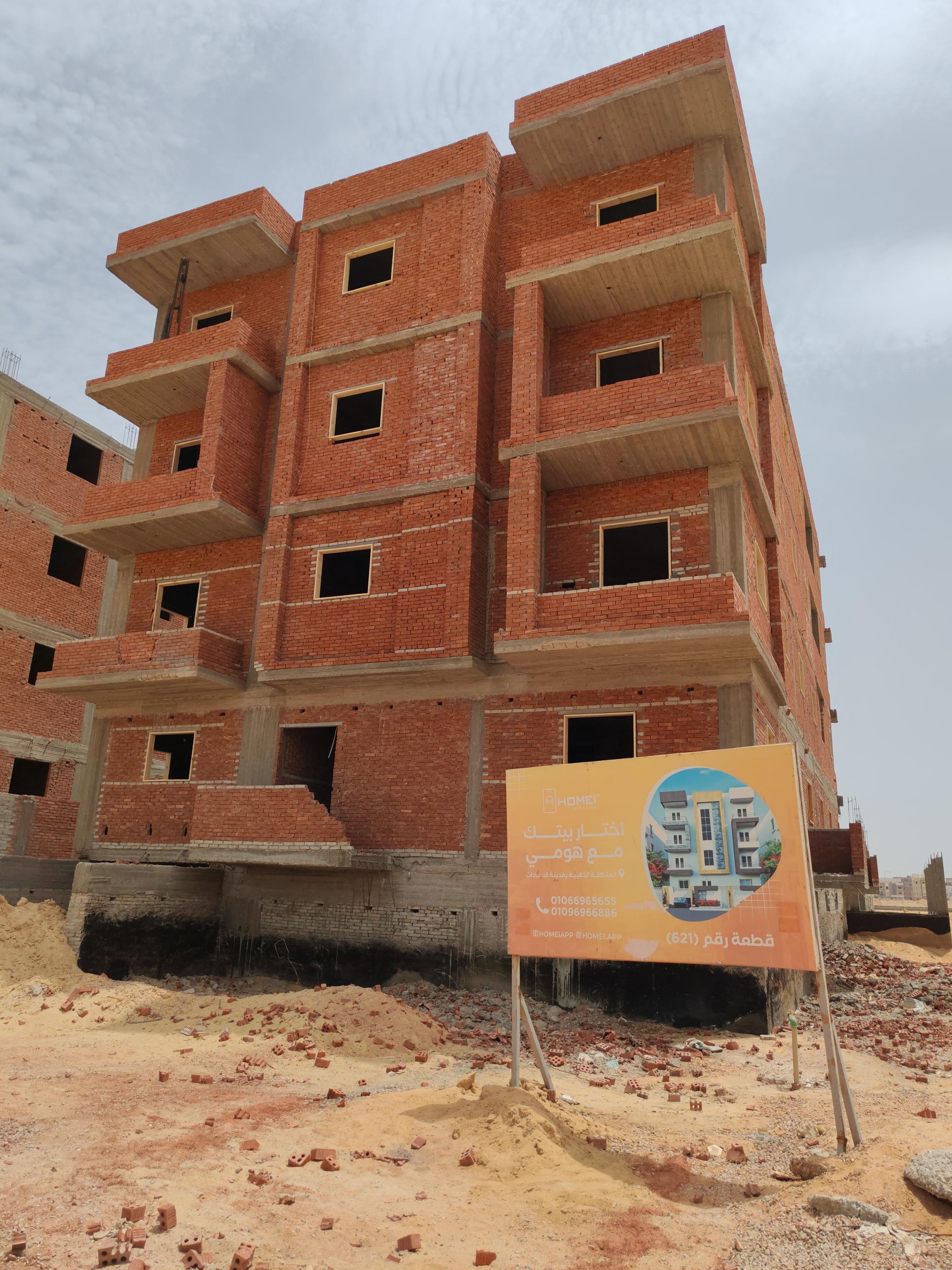

Wooden door frames
April 23, 2025

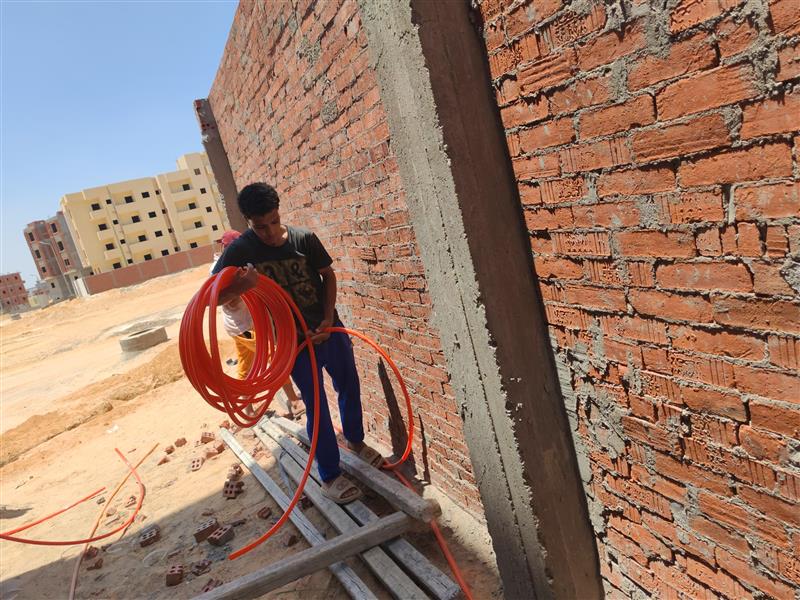

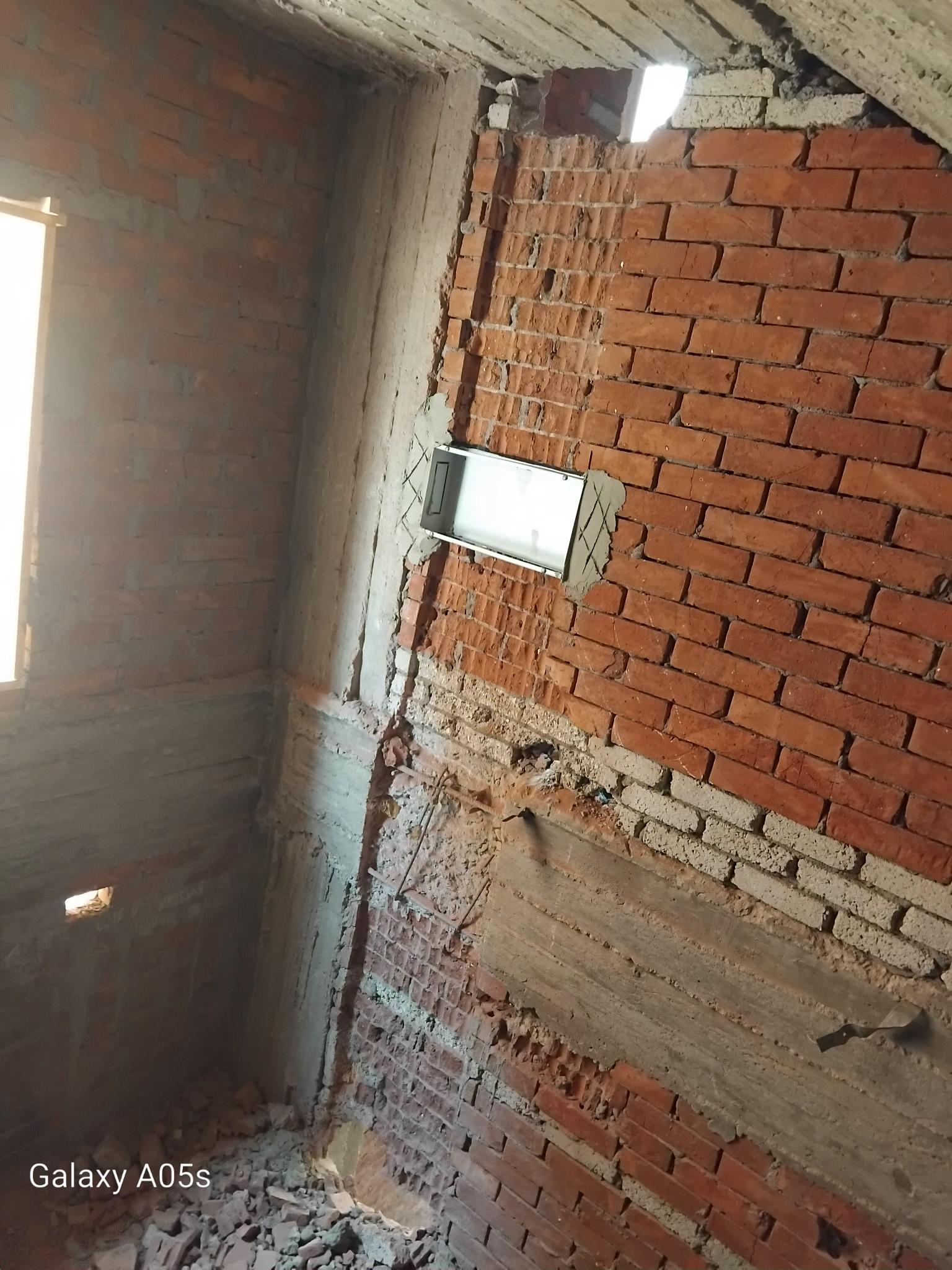

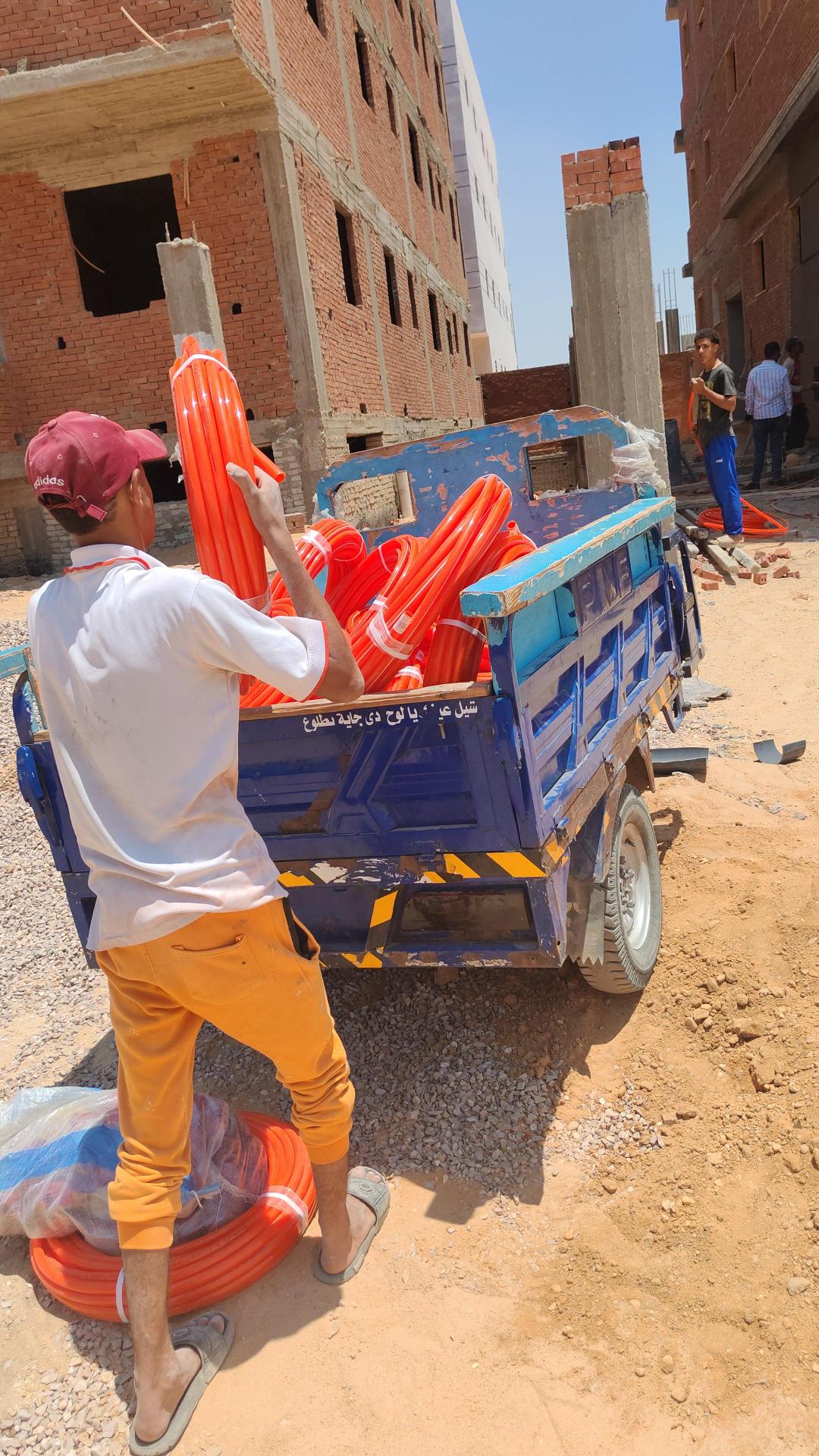

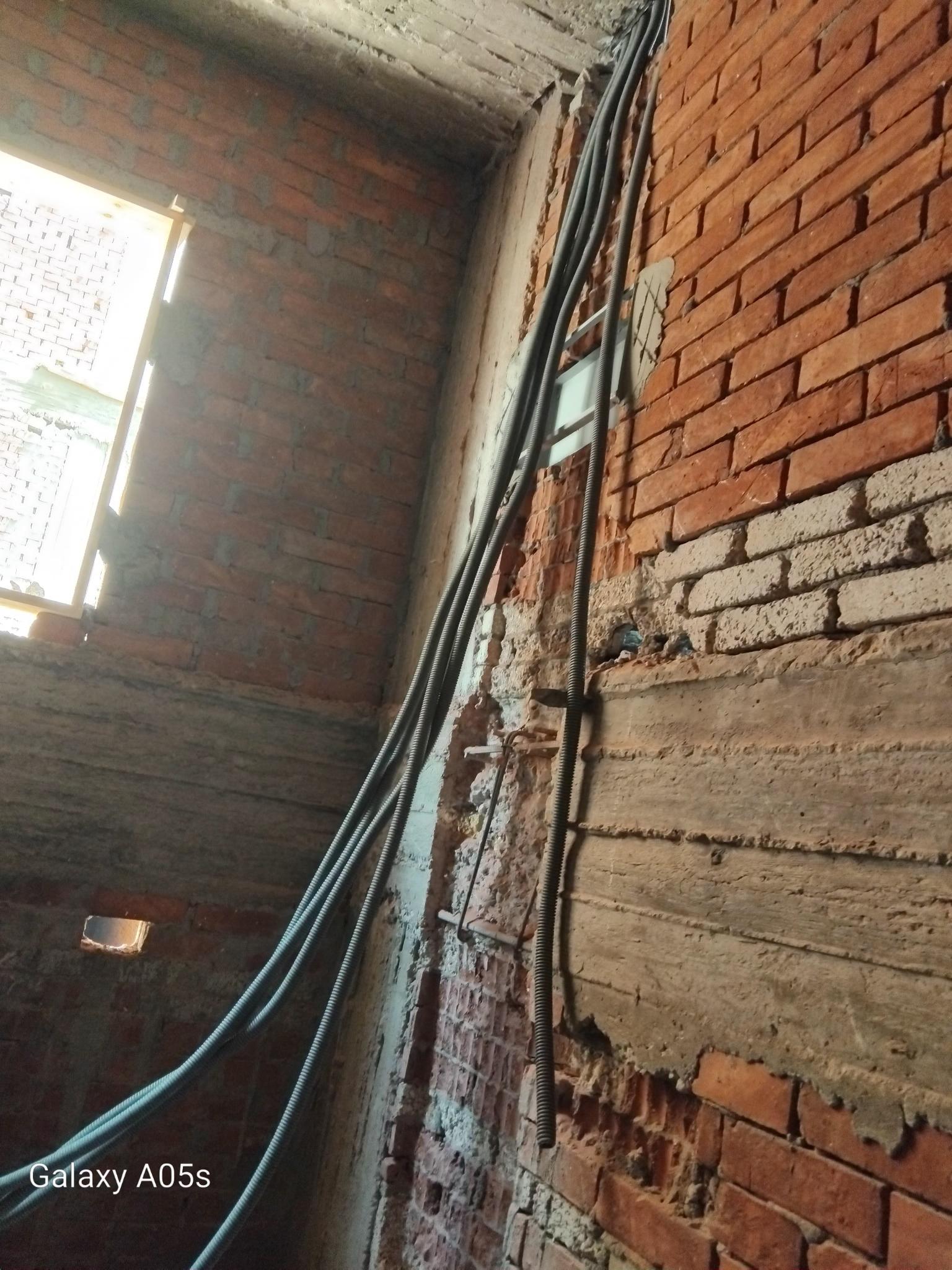

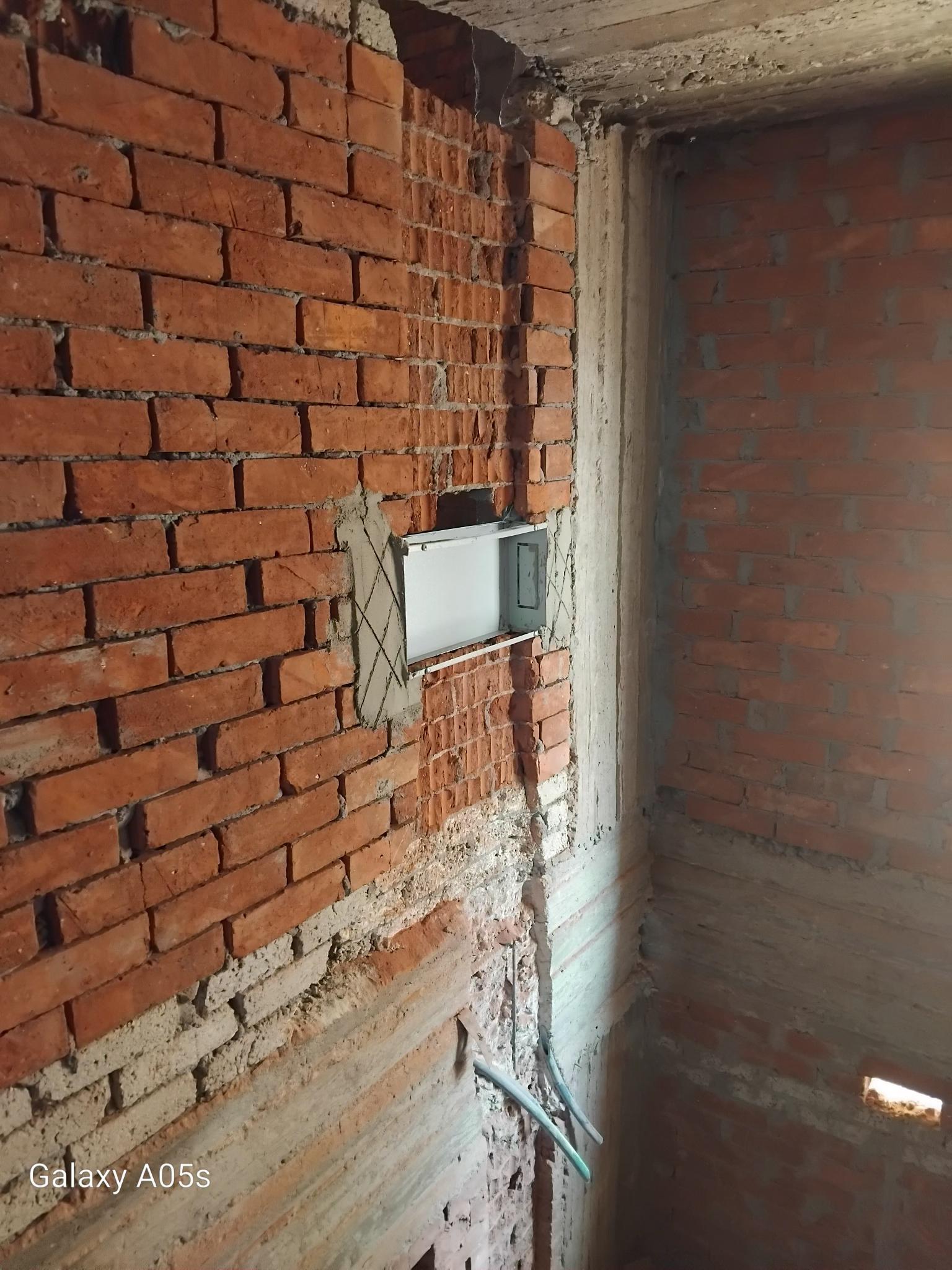

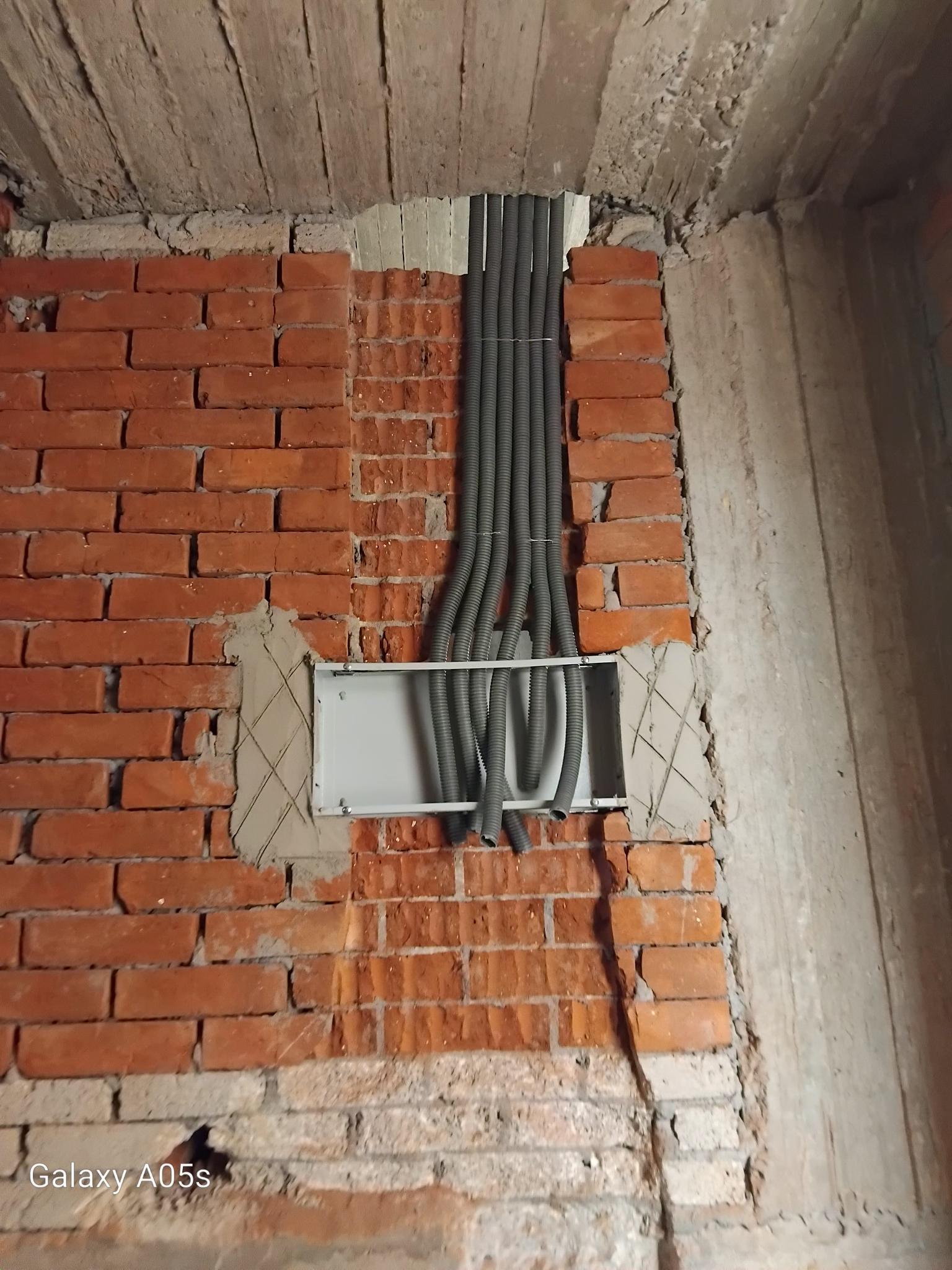

Electrical works

April 26, 2025

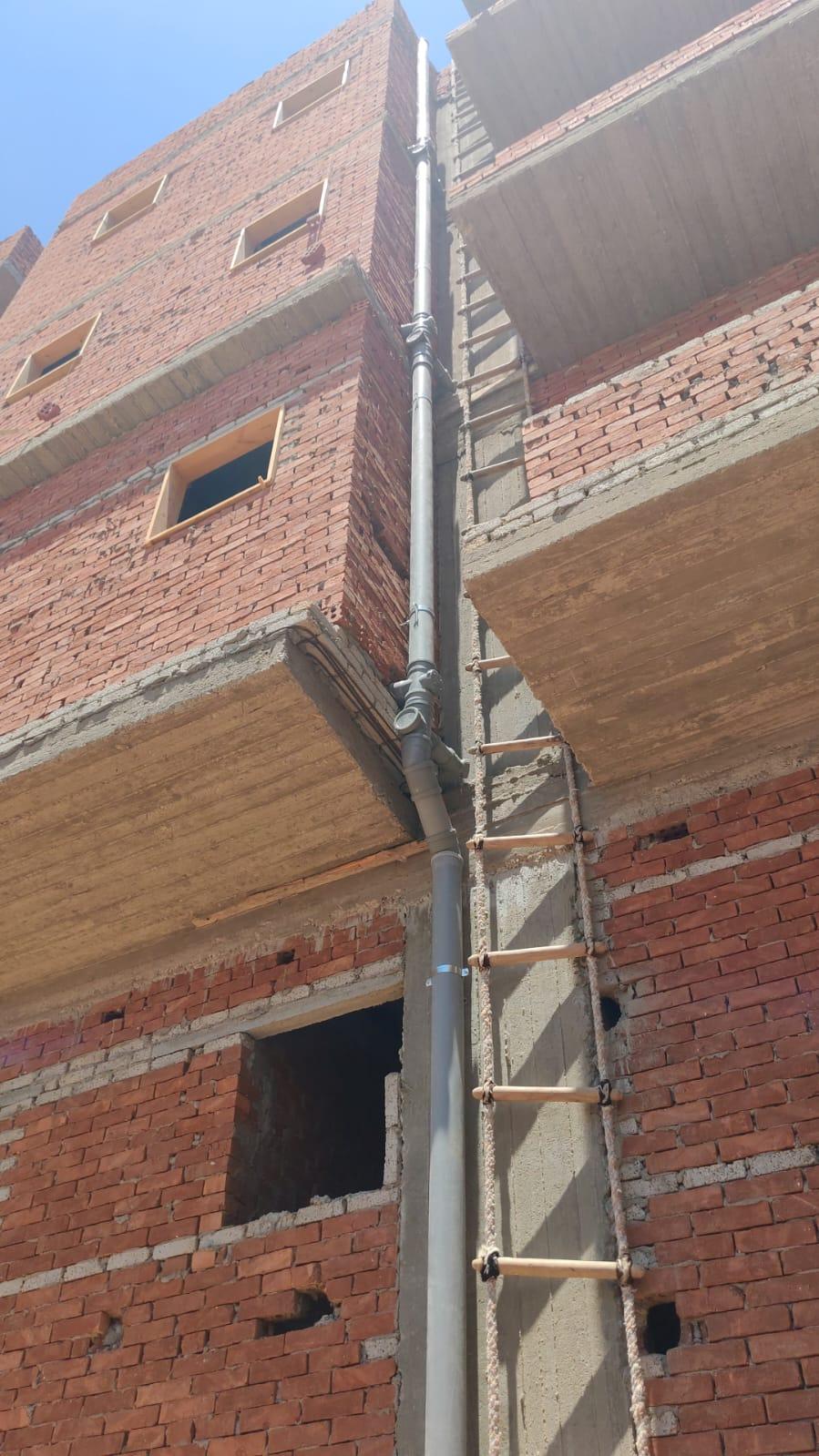

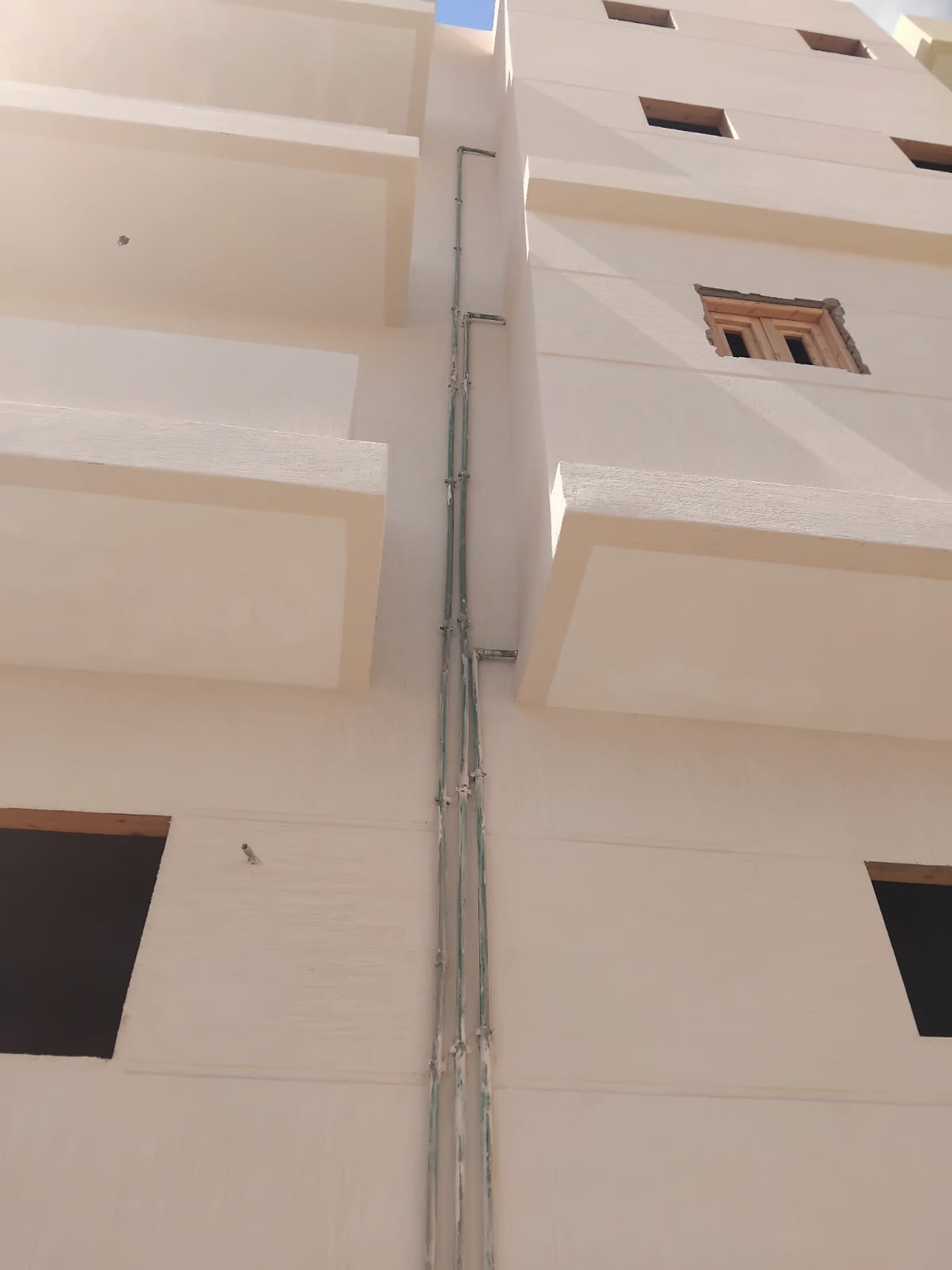

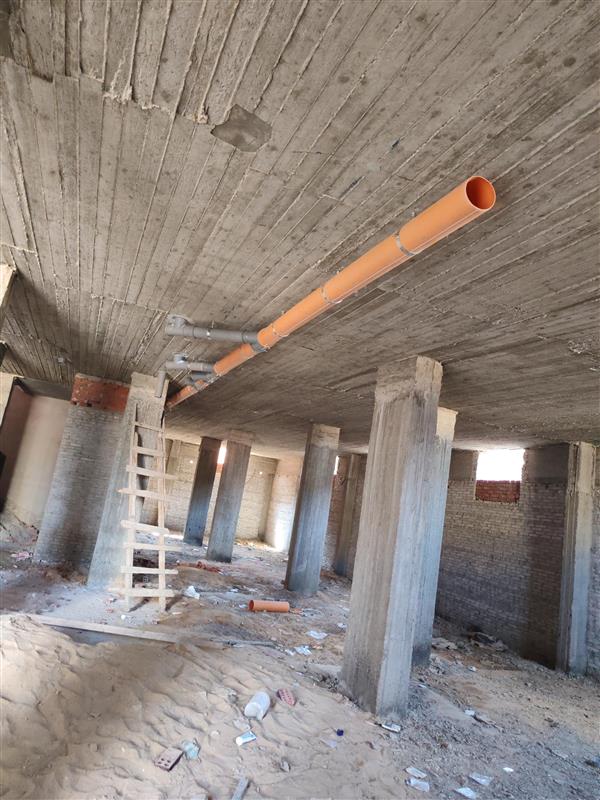

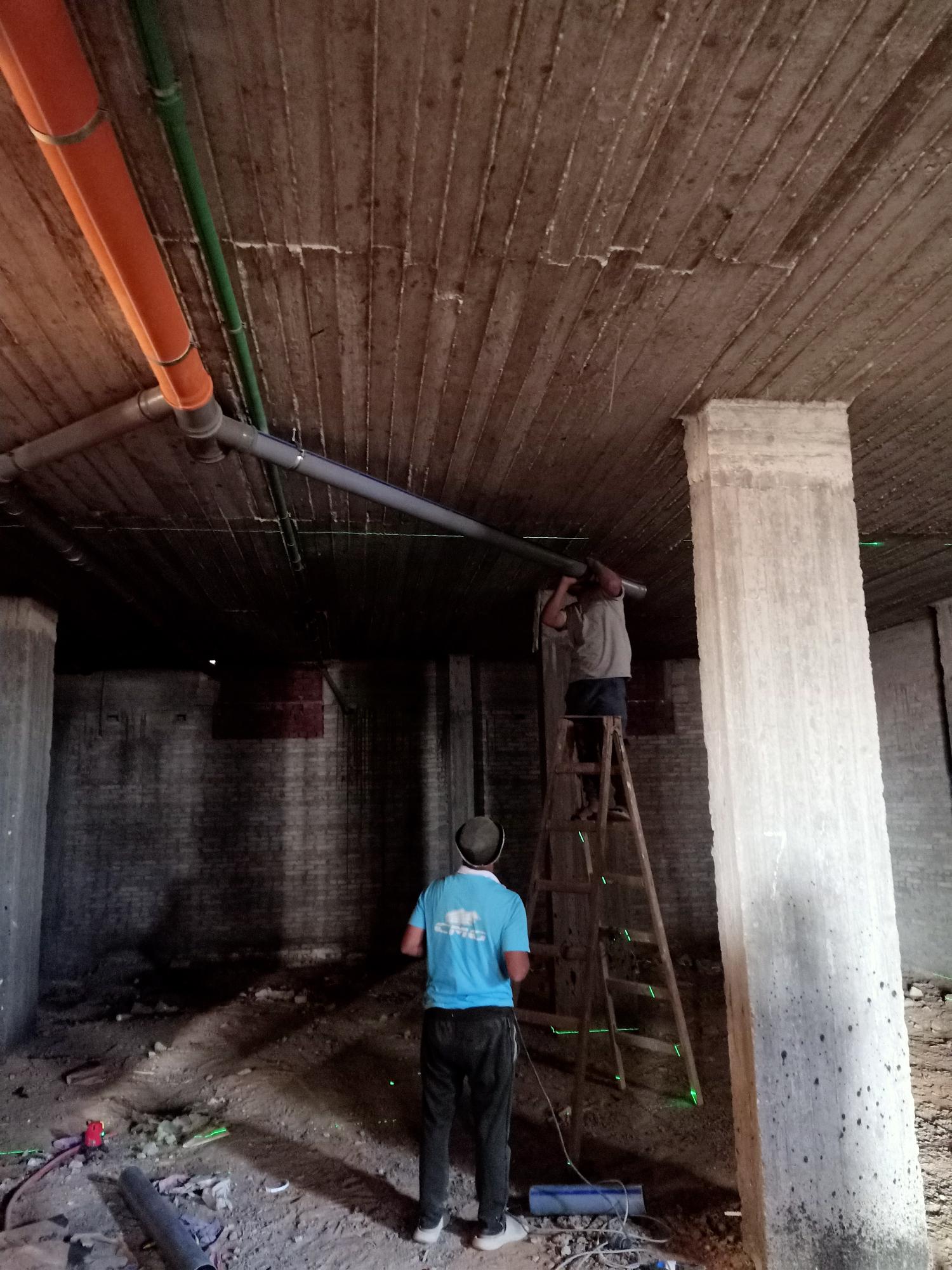

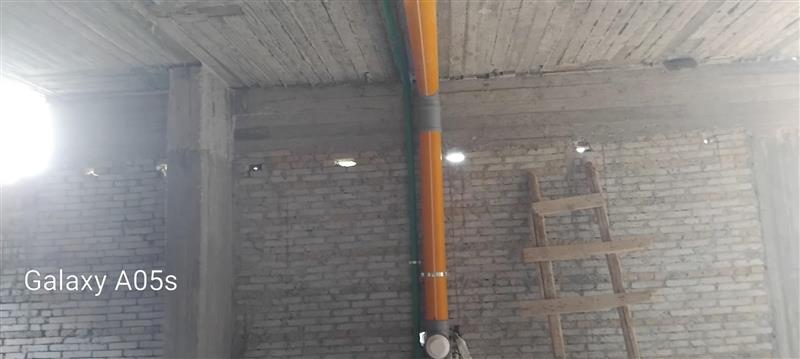

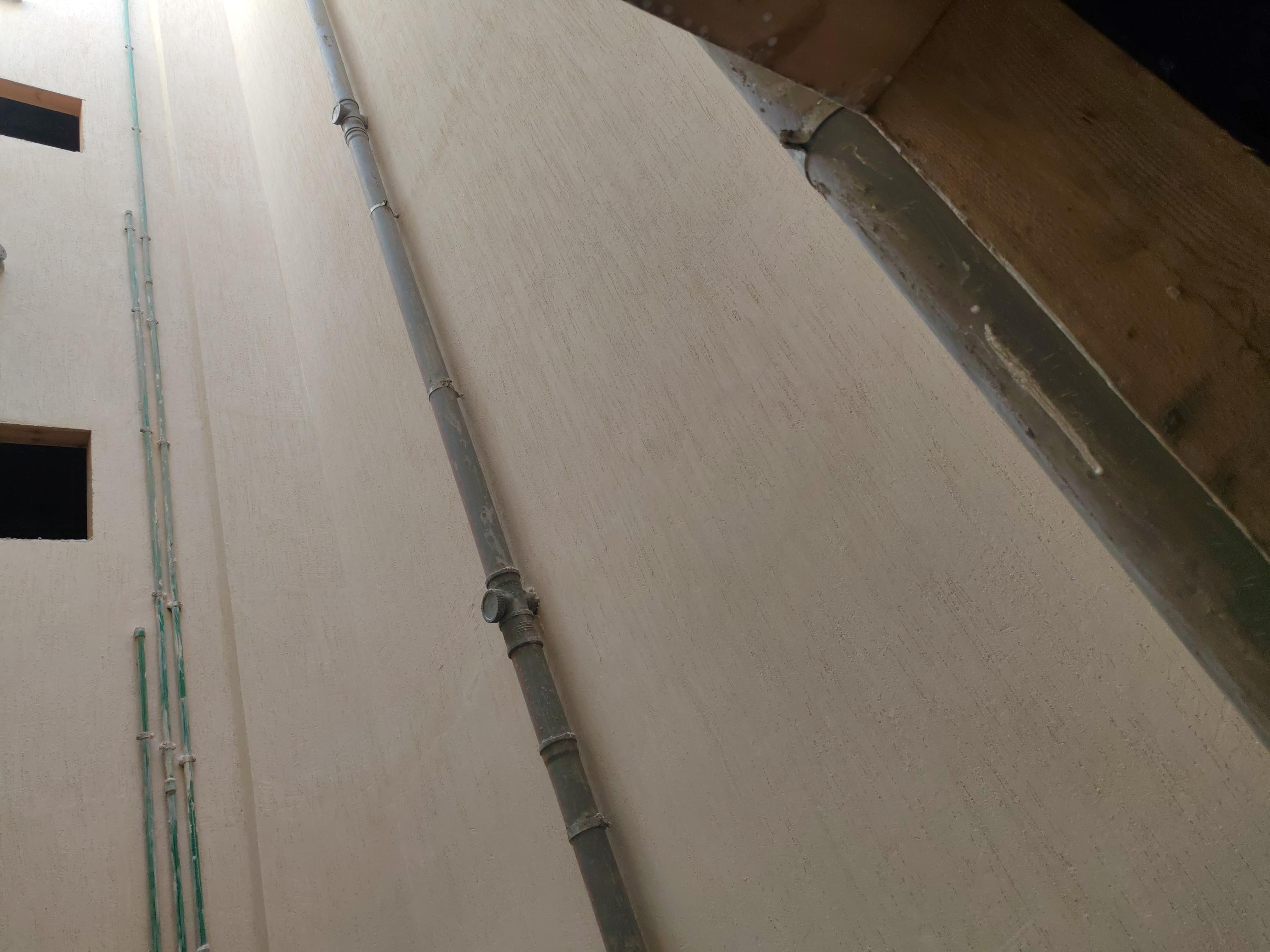

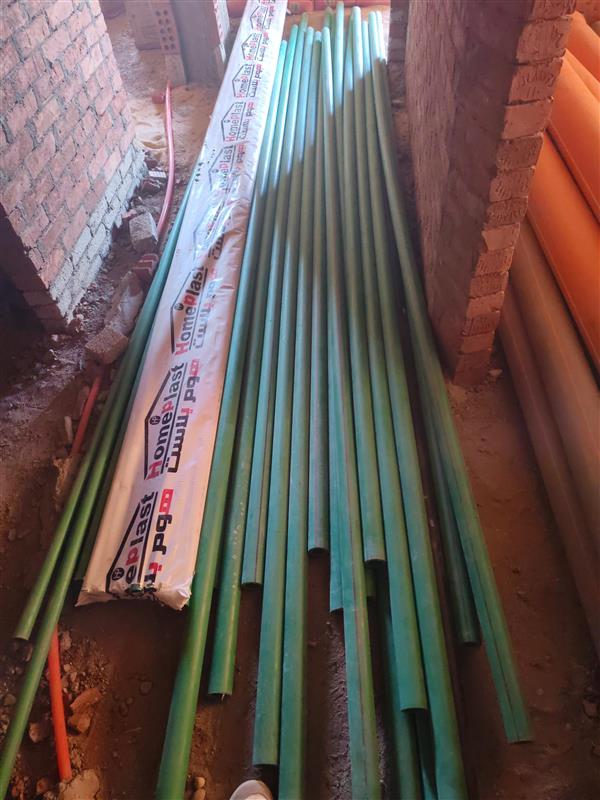

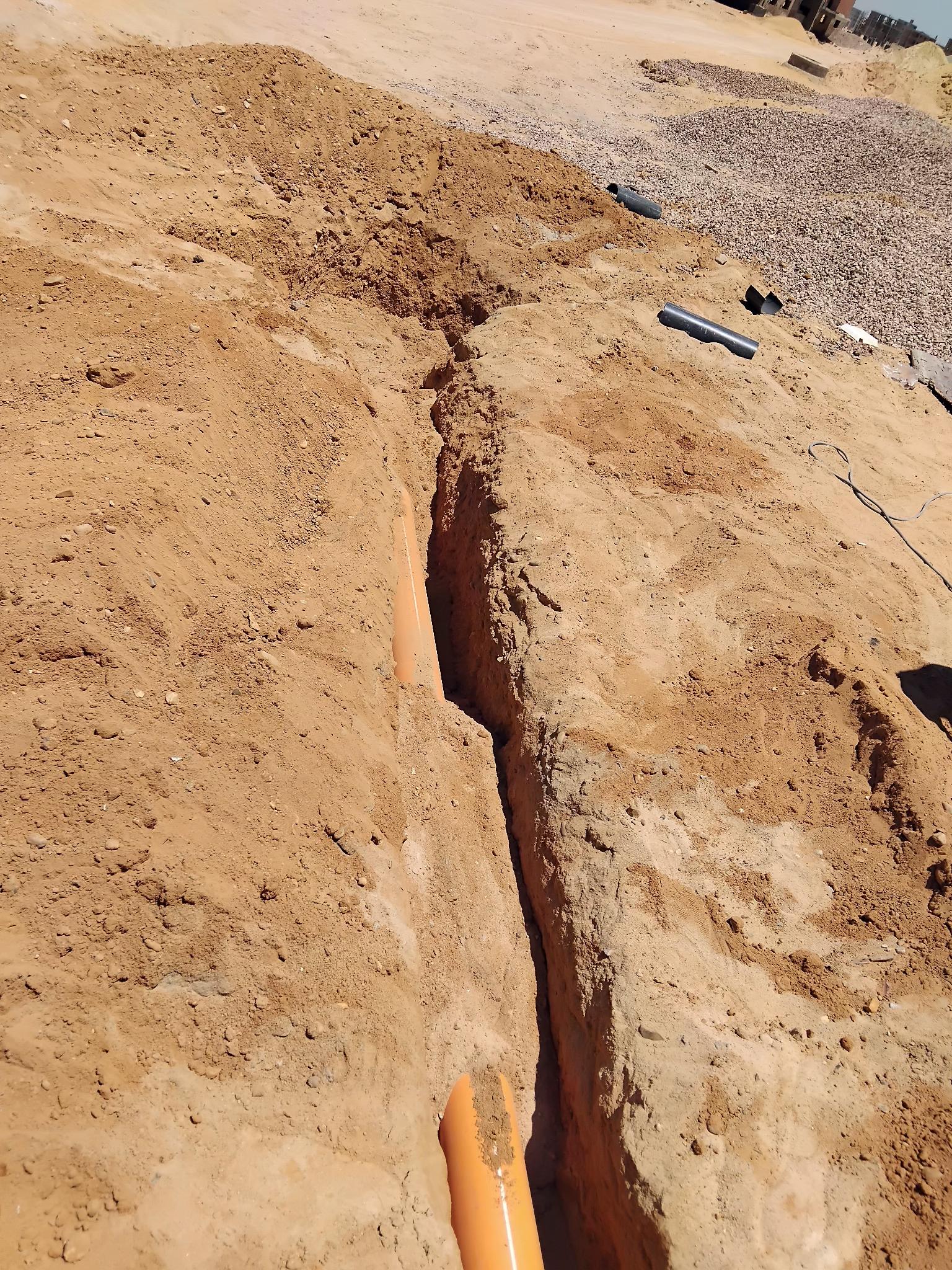

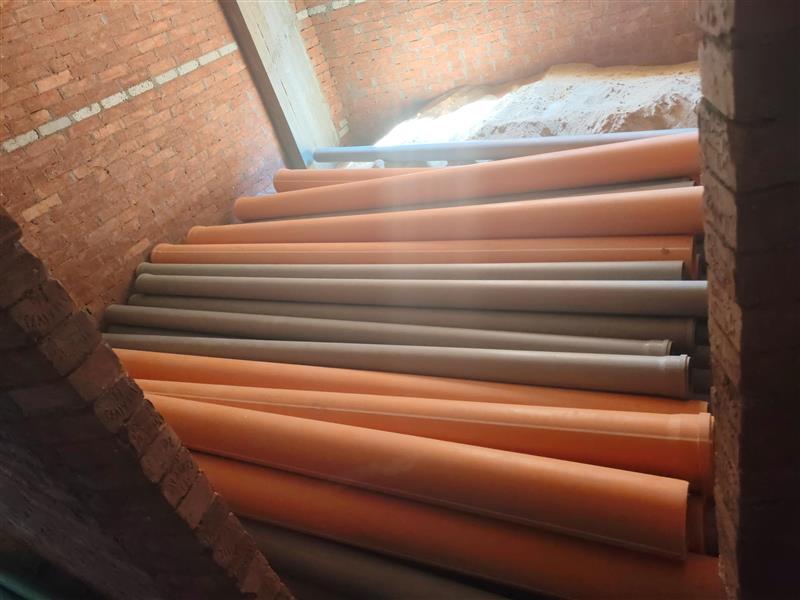

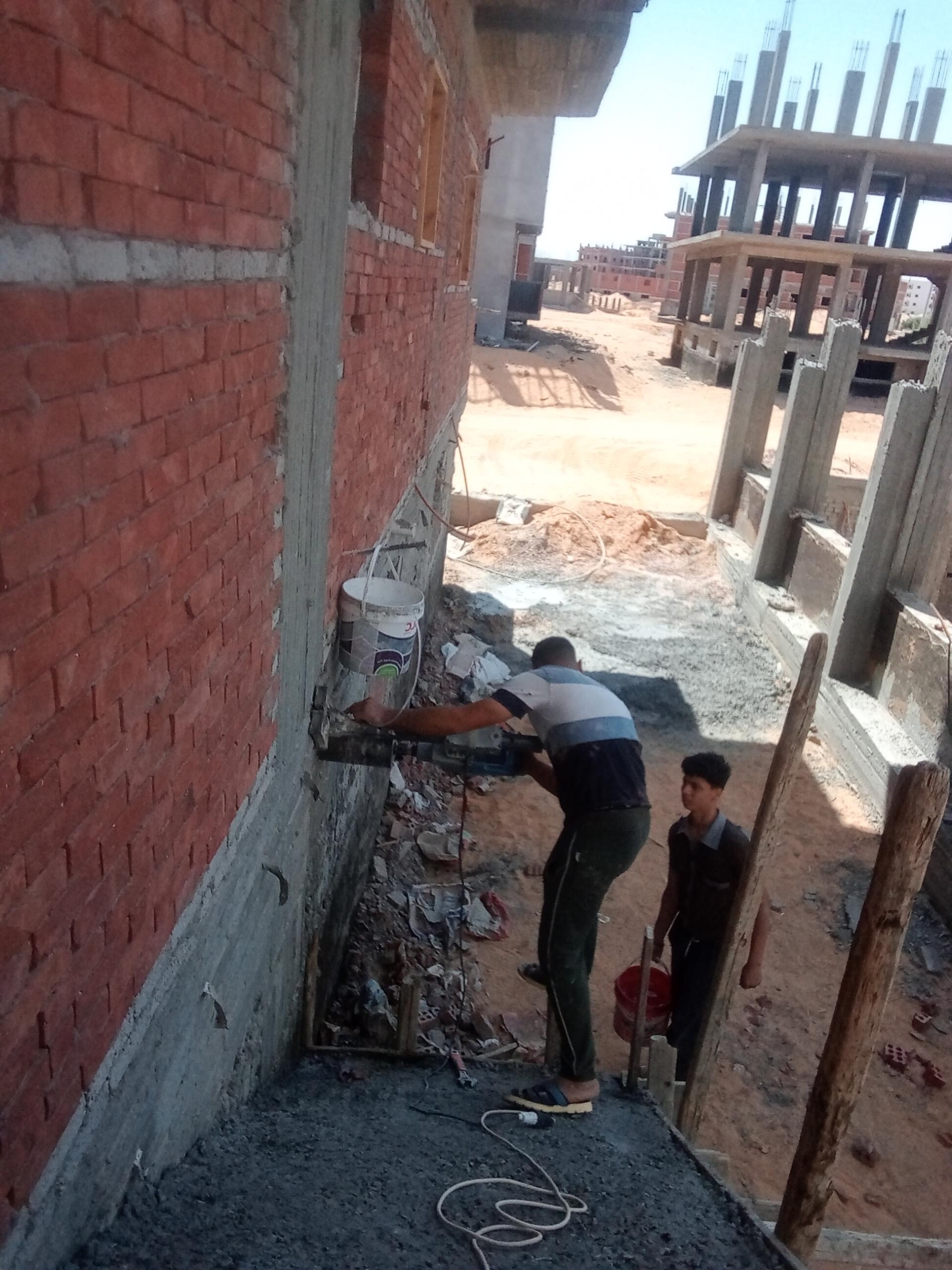

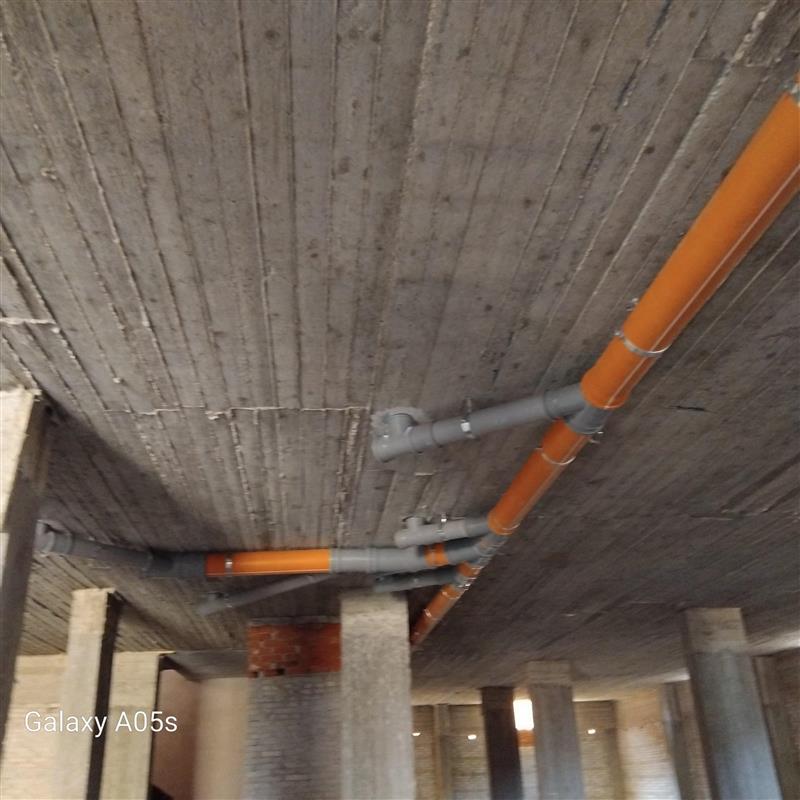

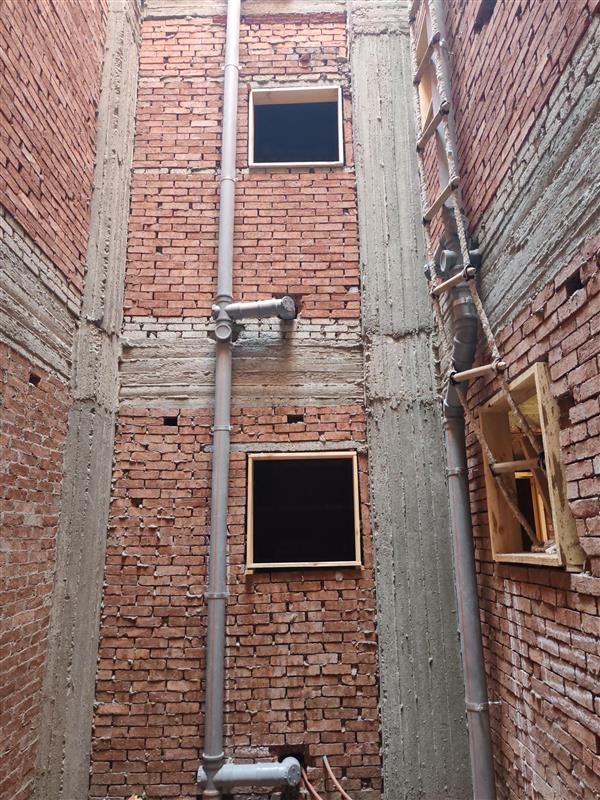

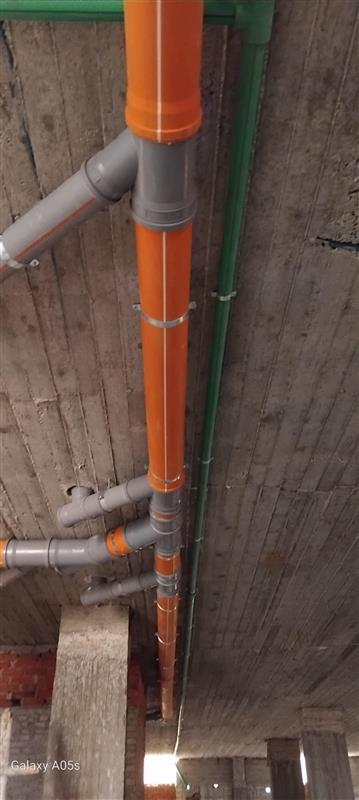

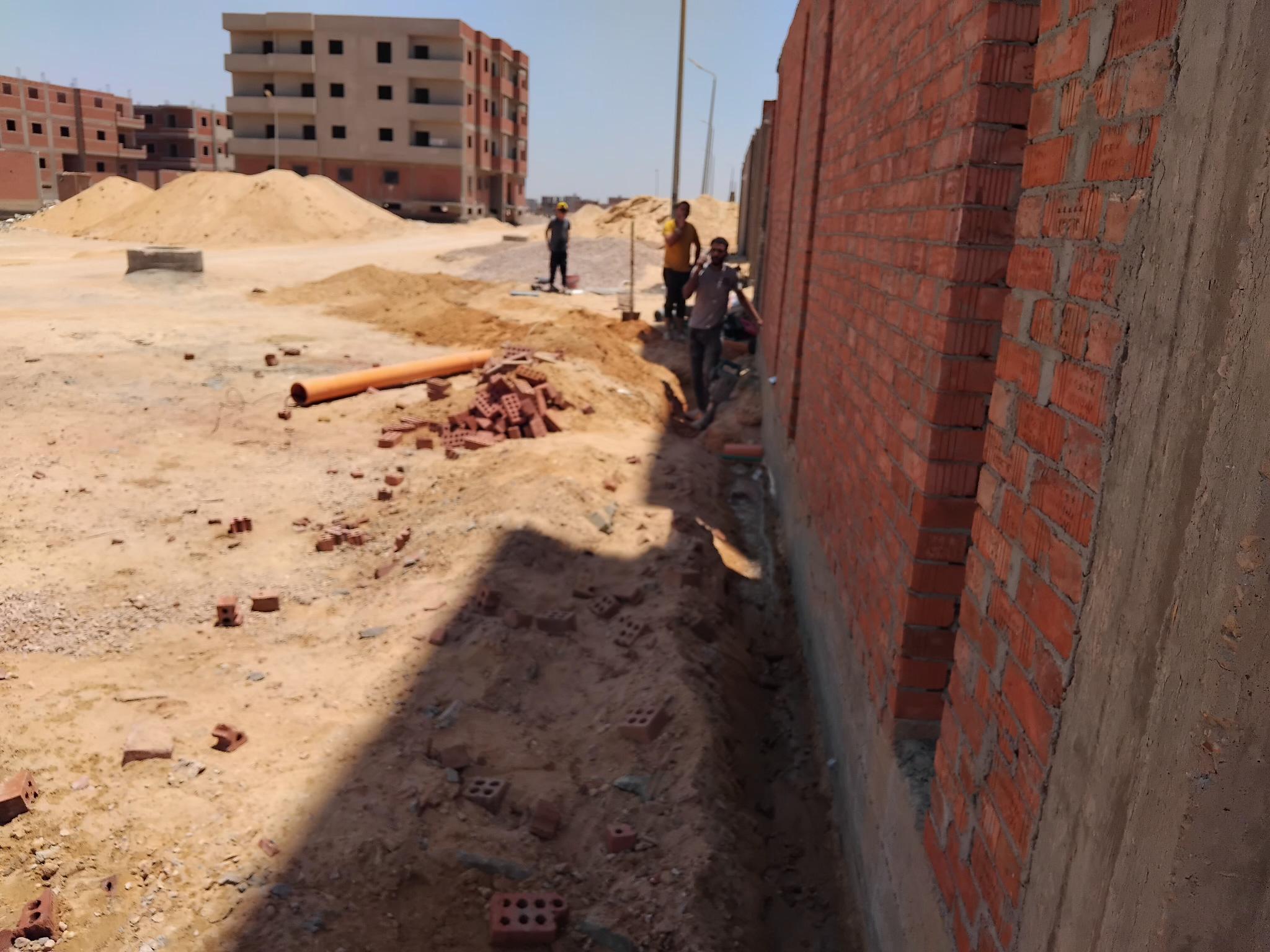

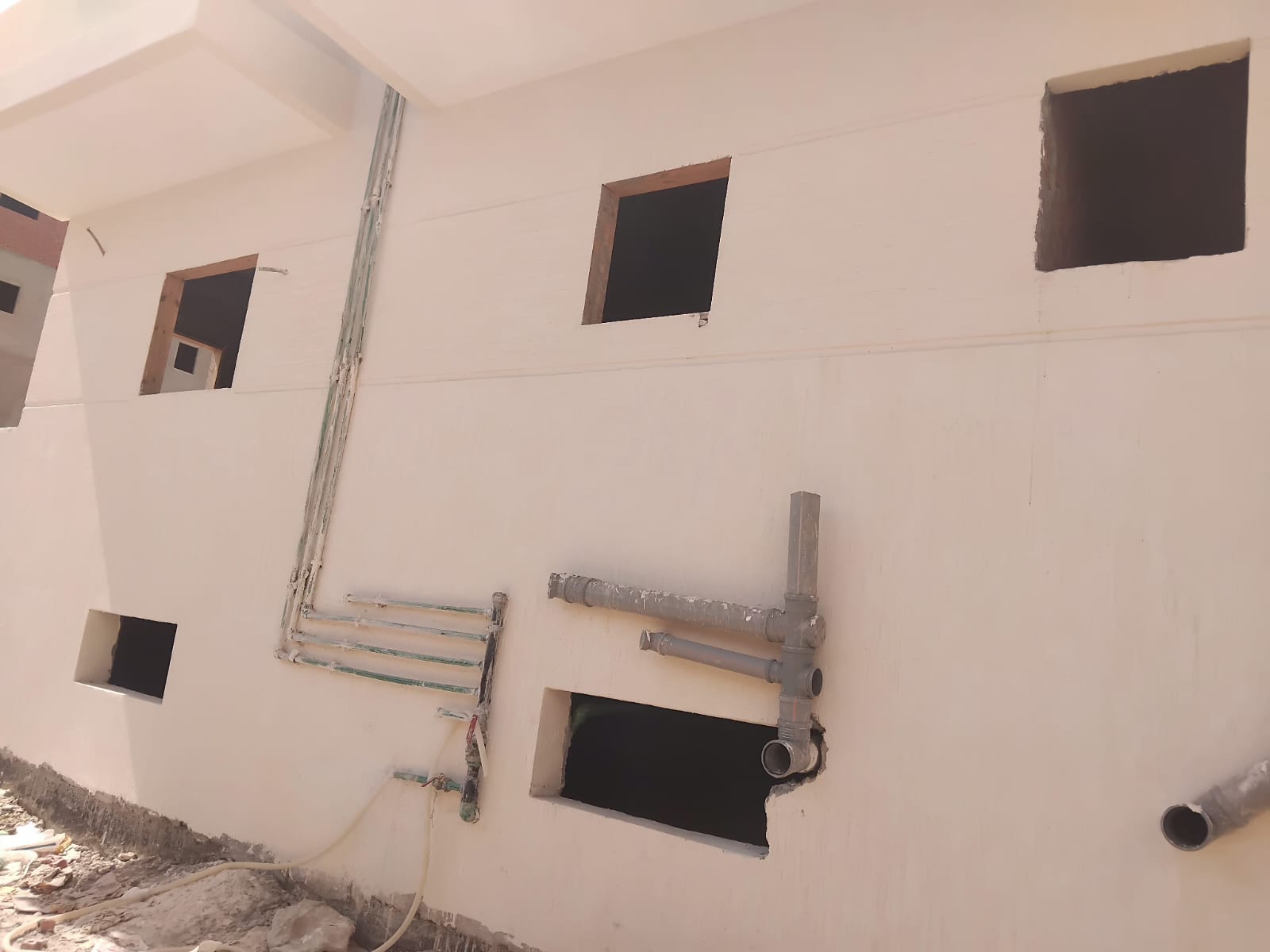

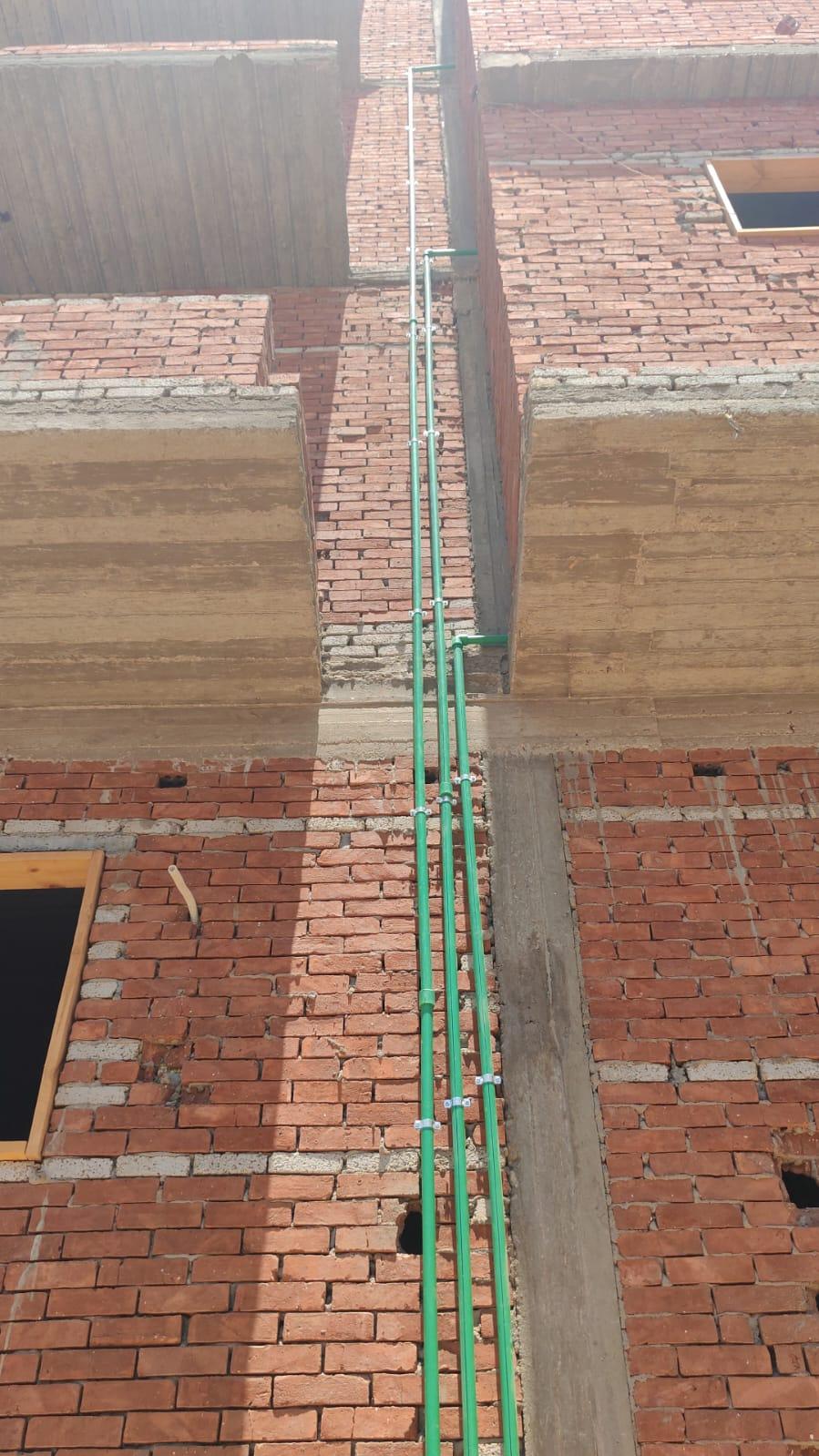

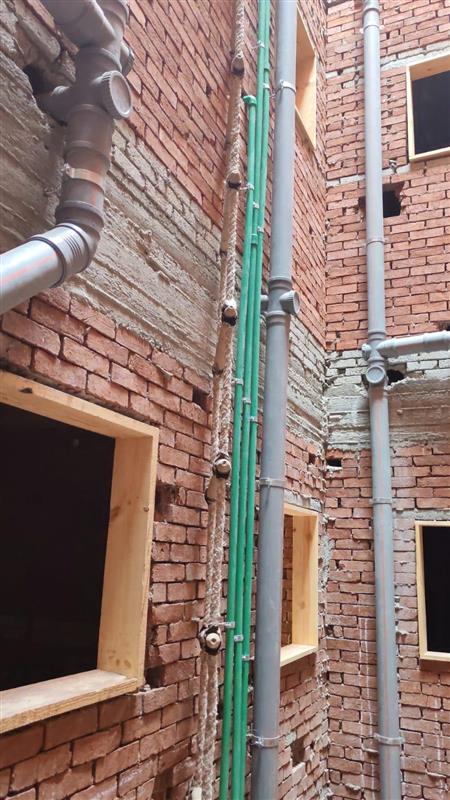

Plumbing works

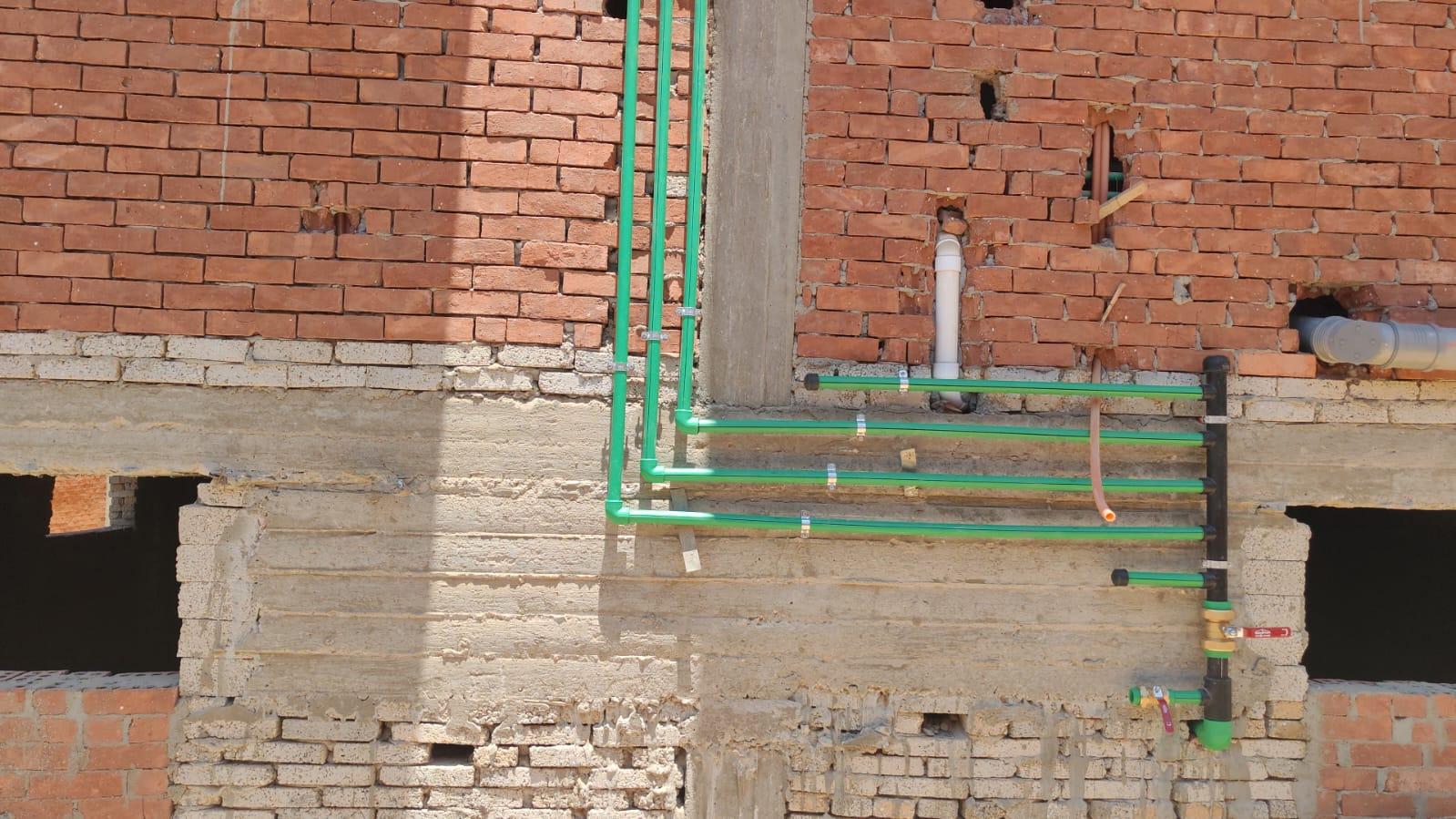

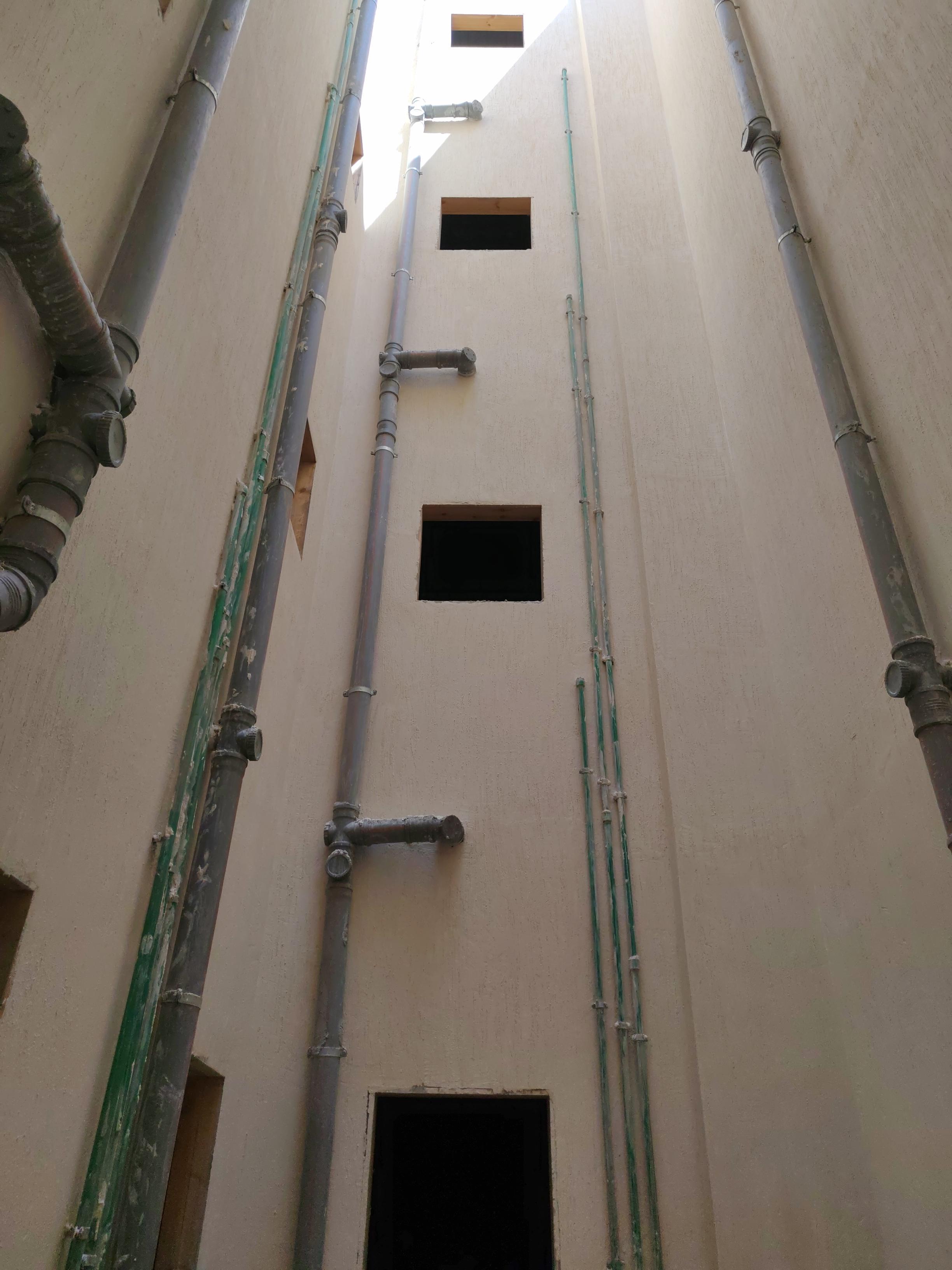

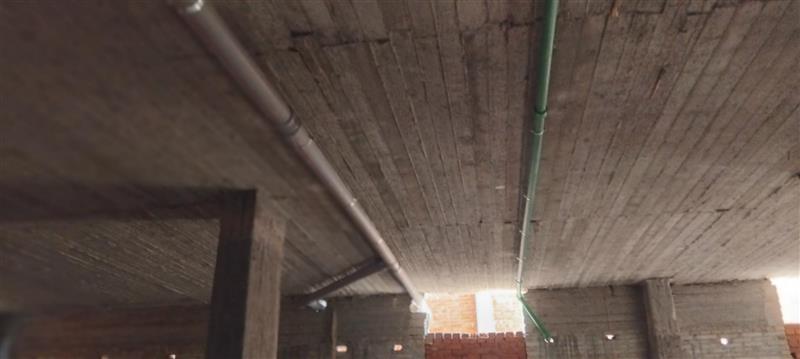

May 20, 2025

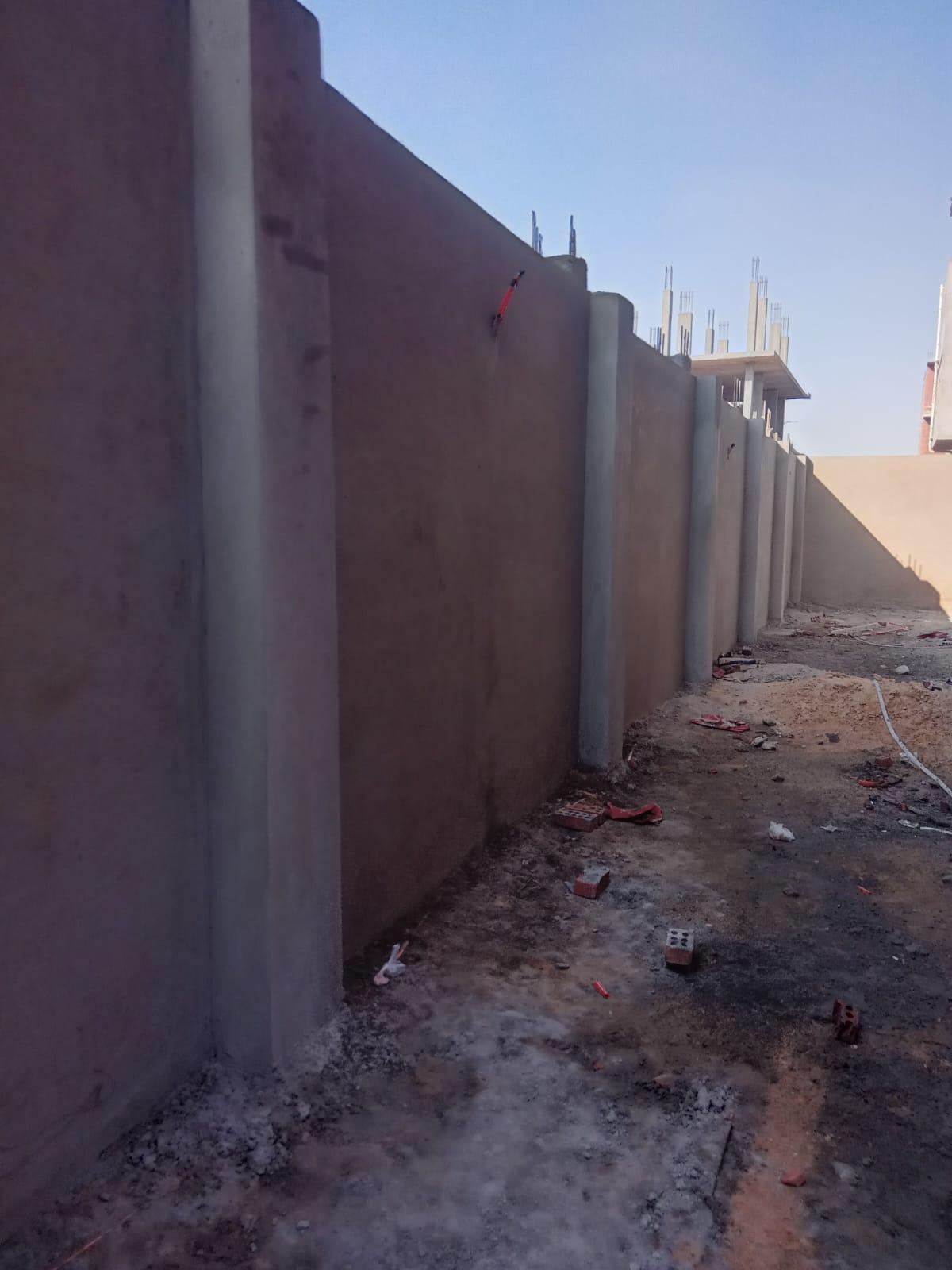

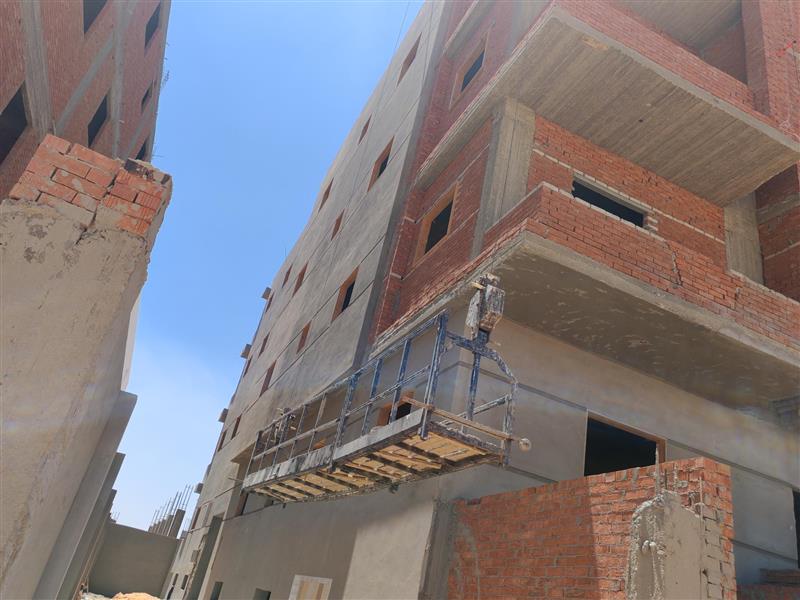

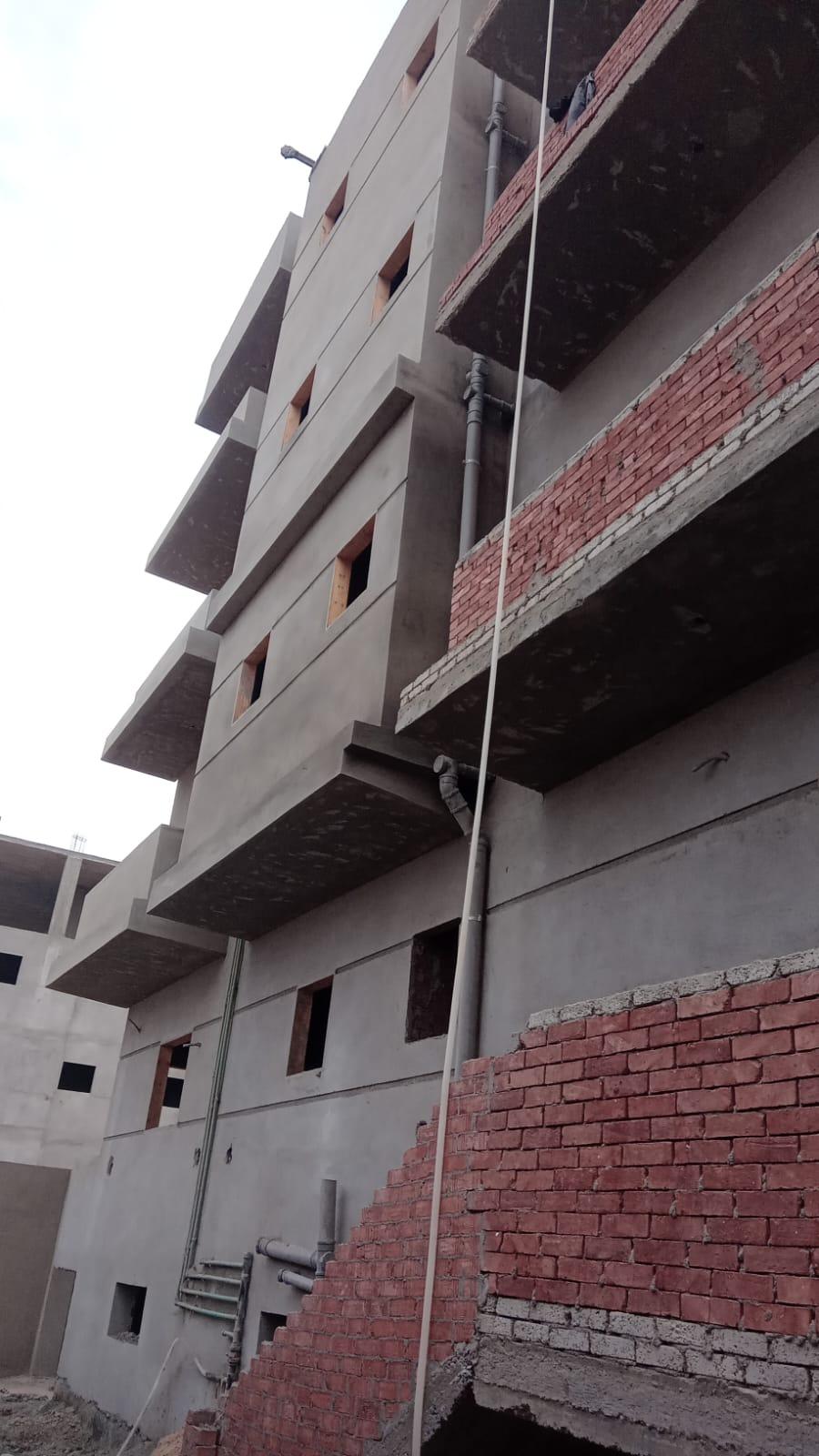

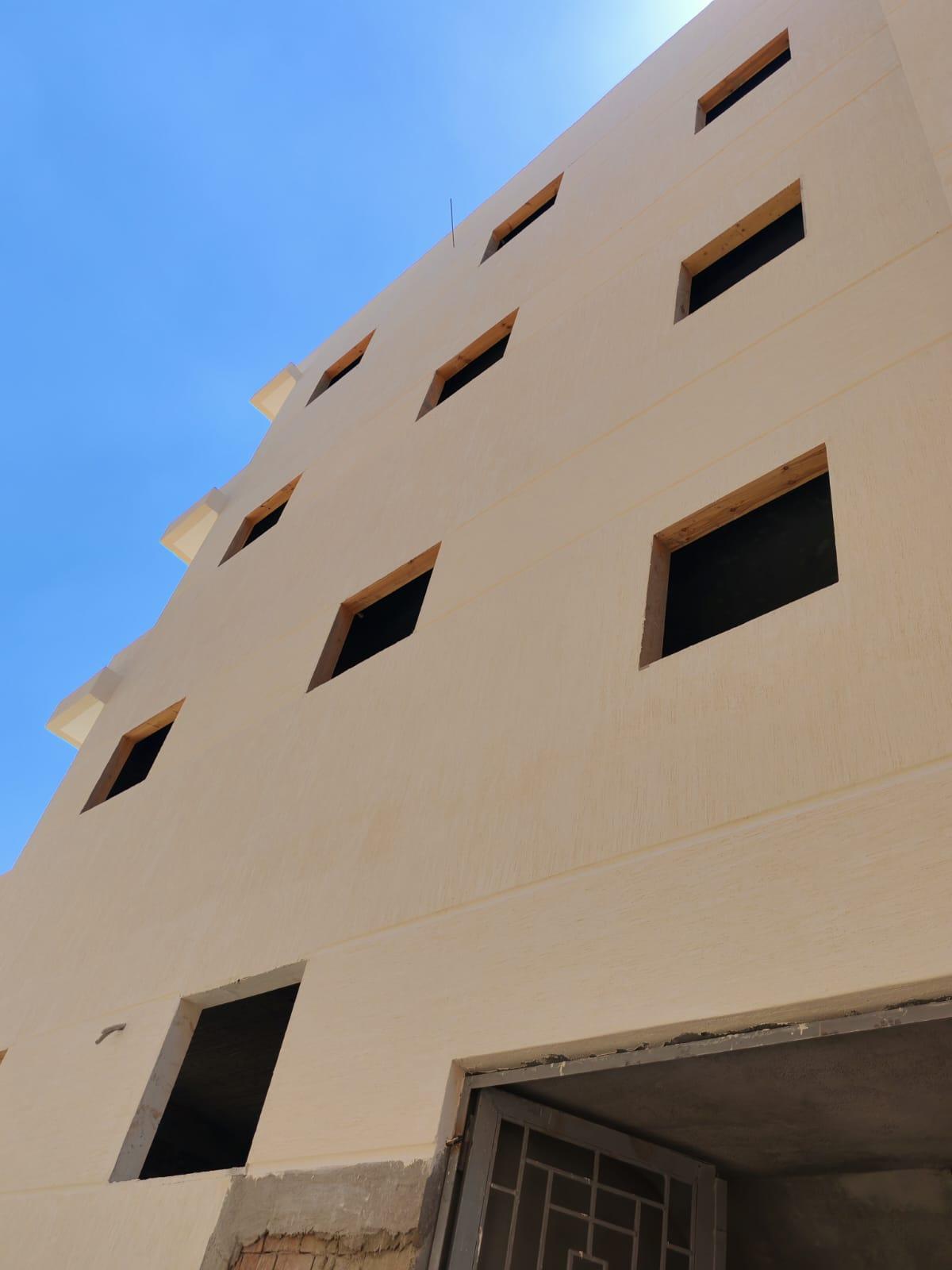

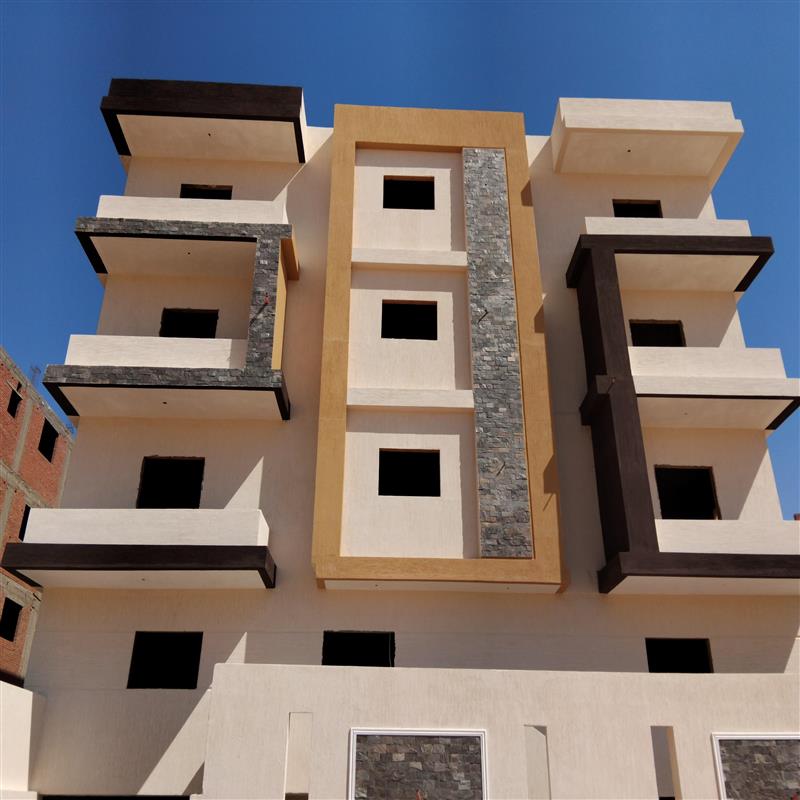

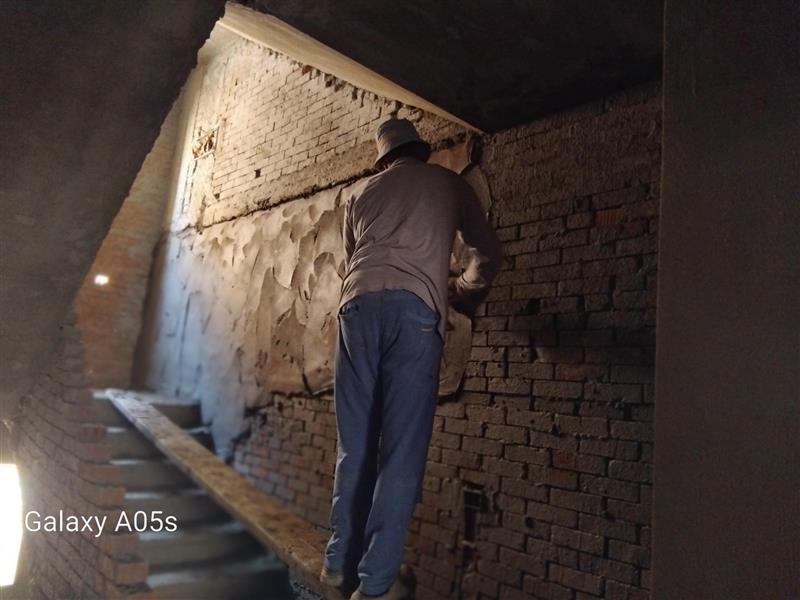

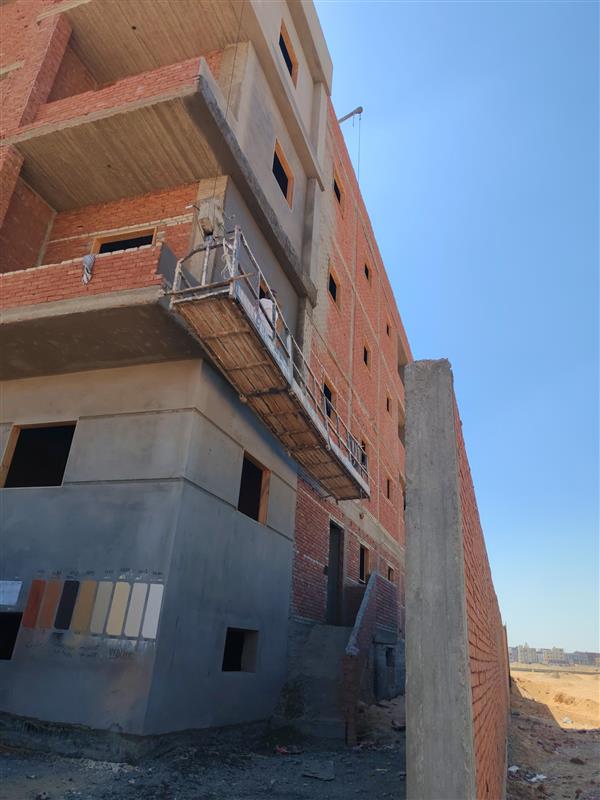

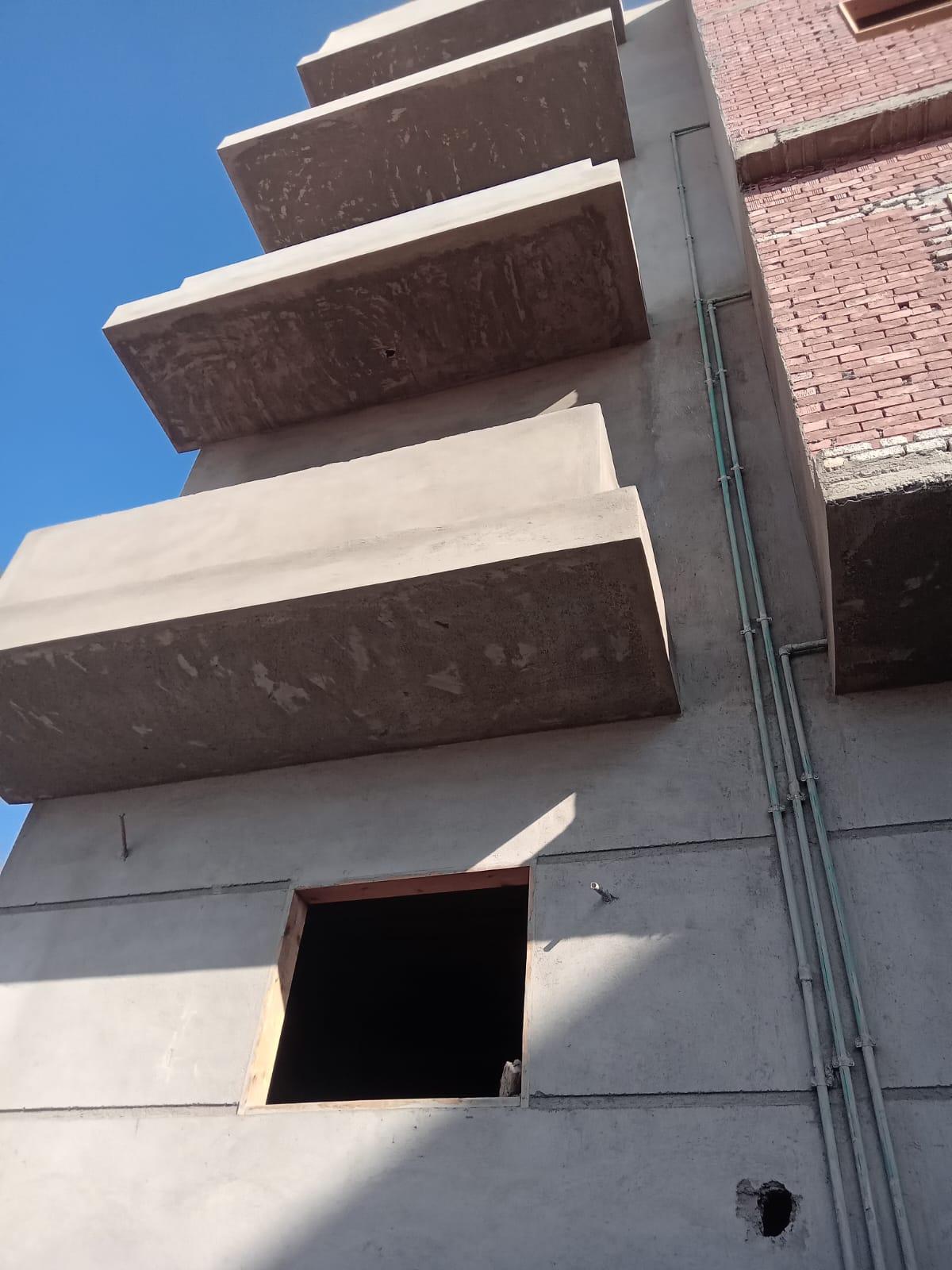

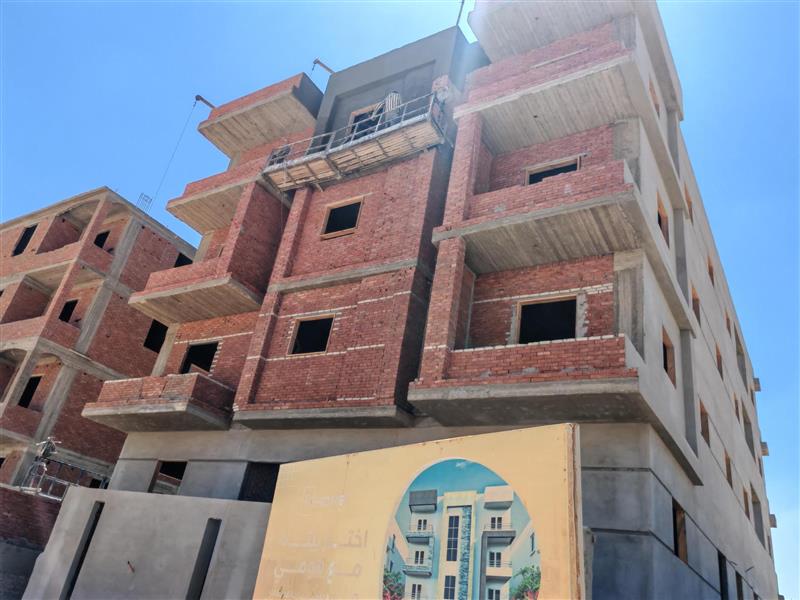

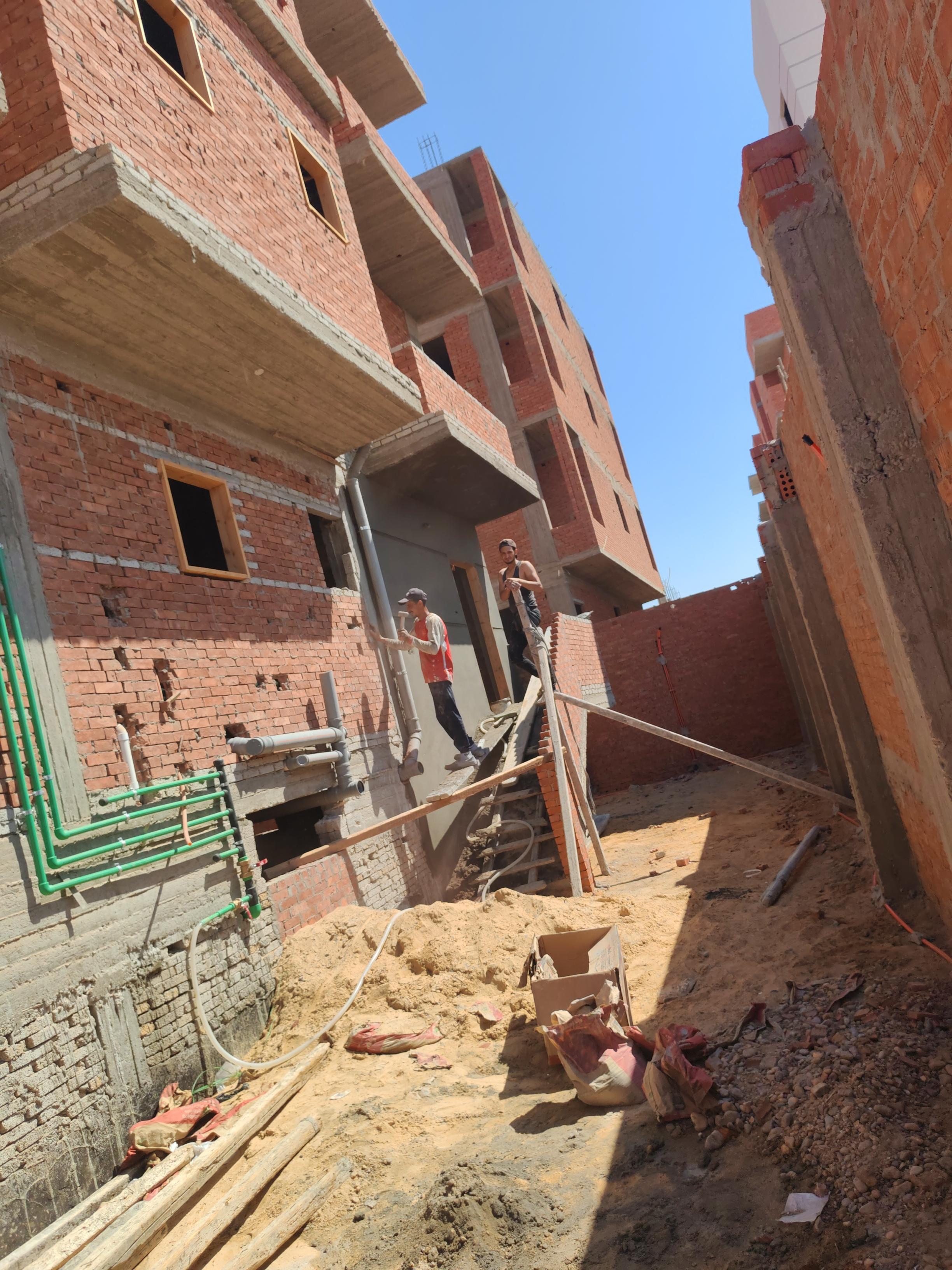

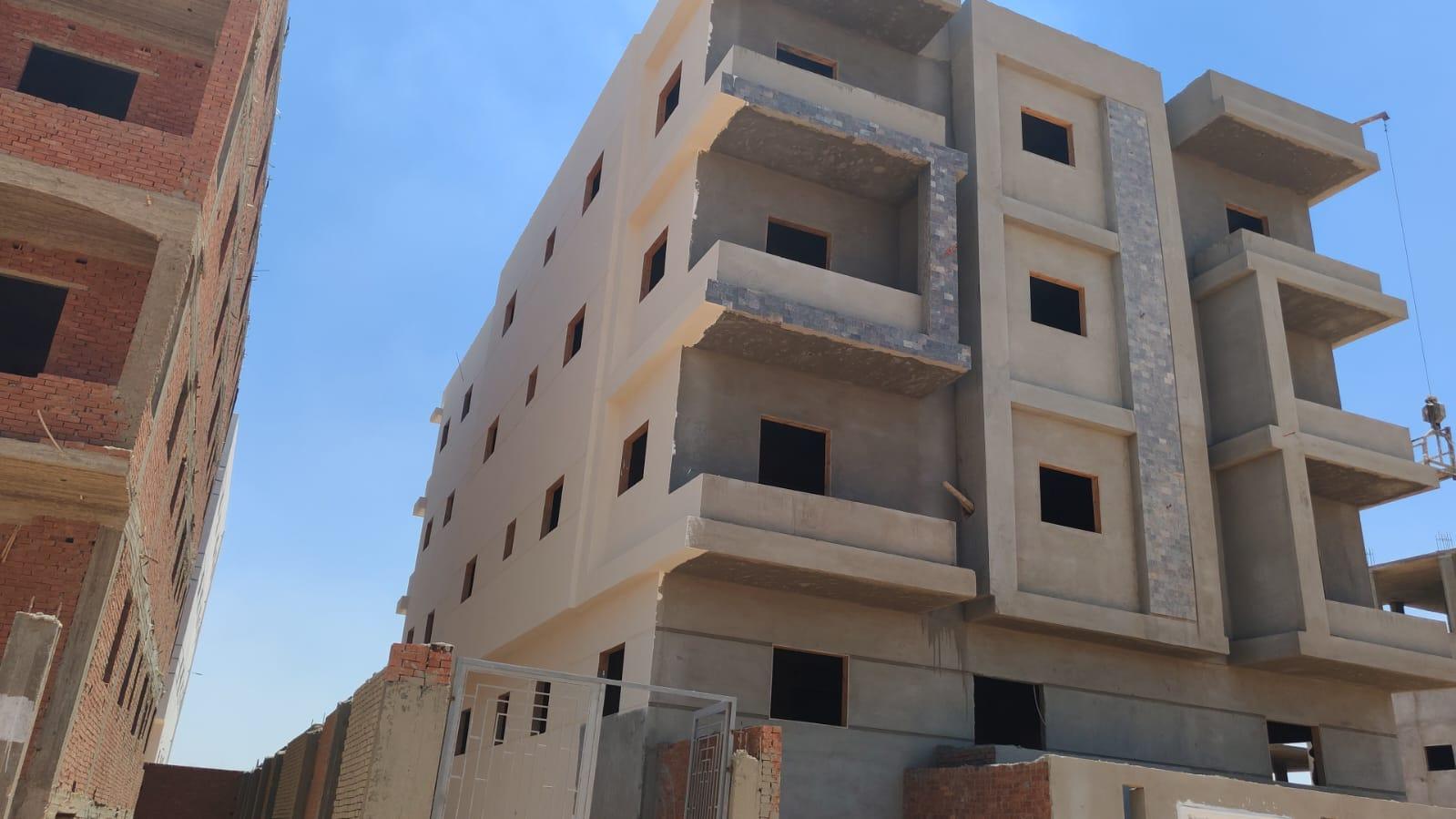

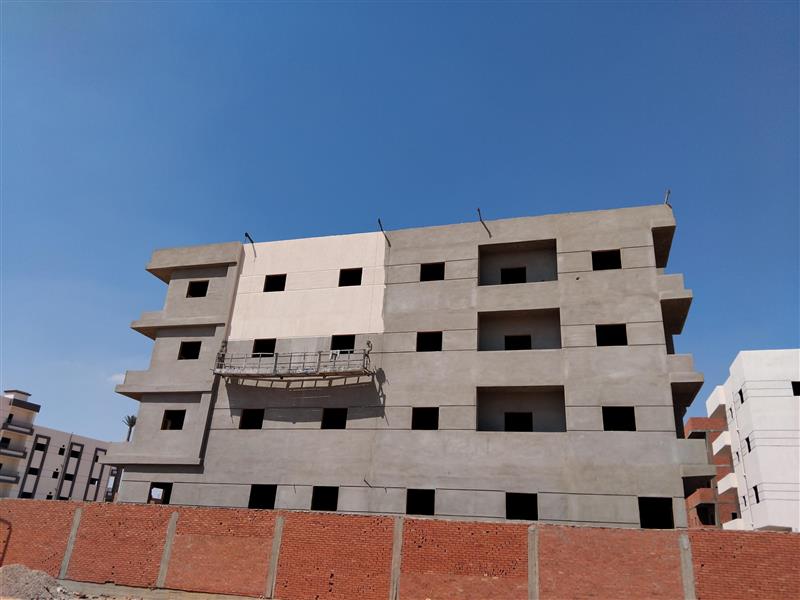

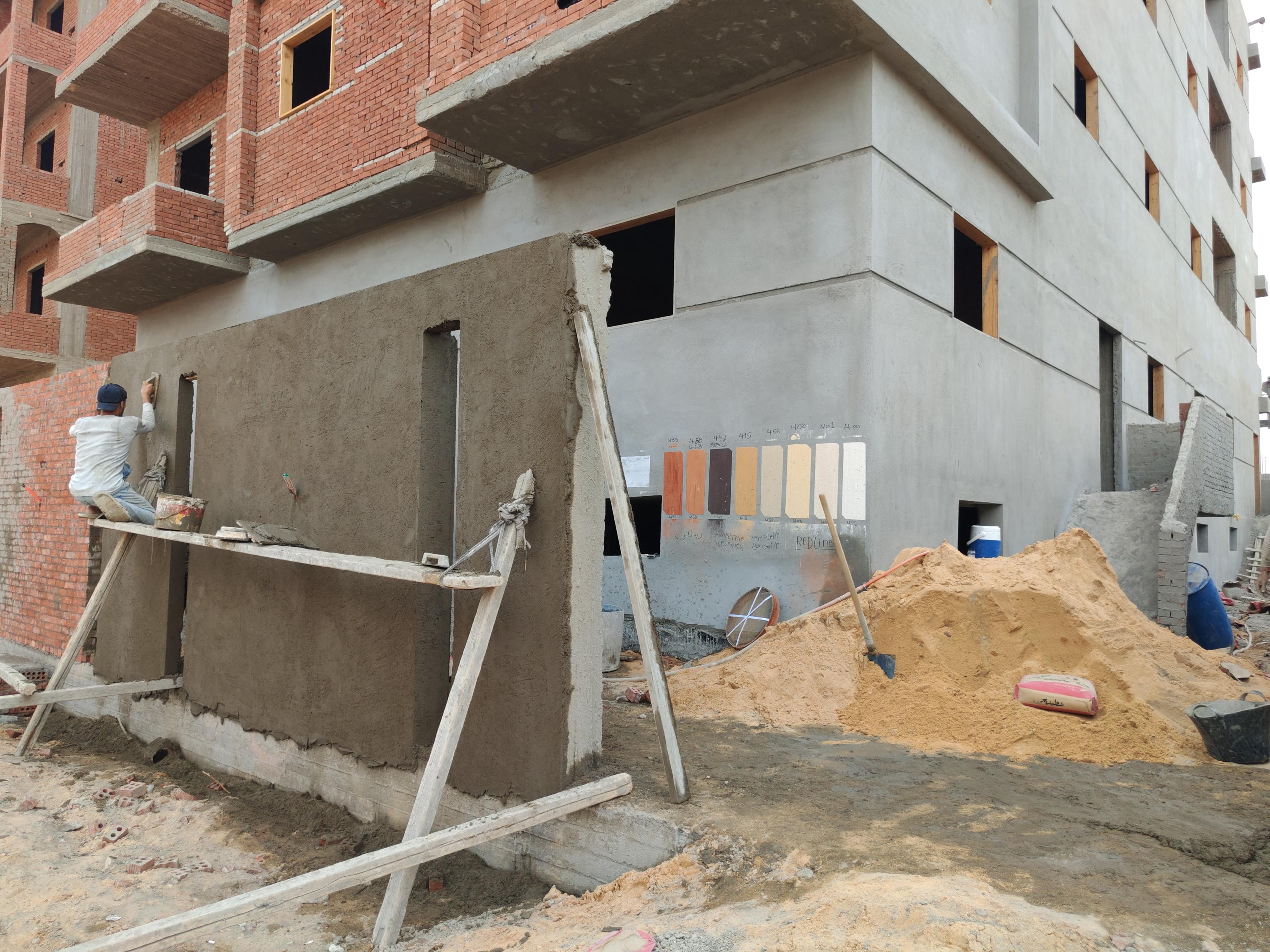

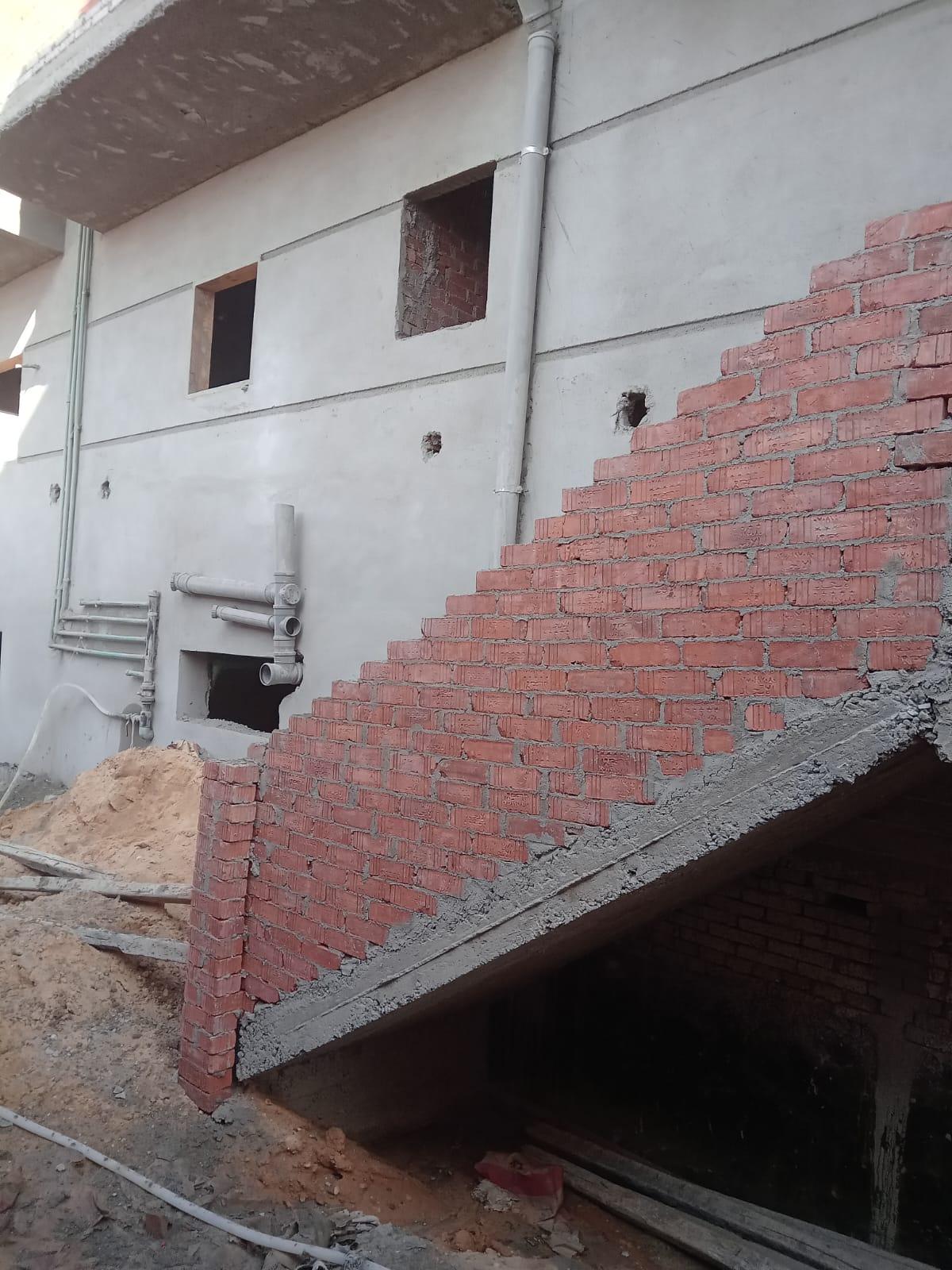

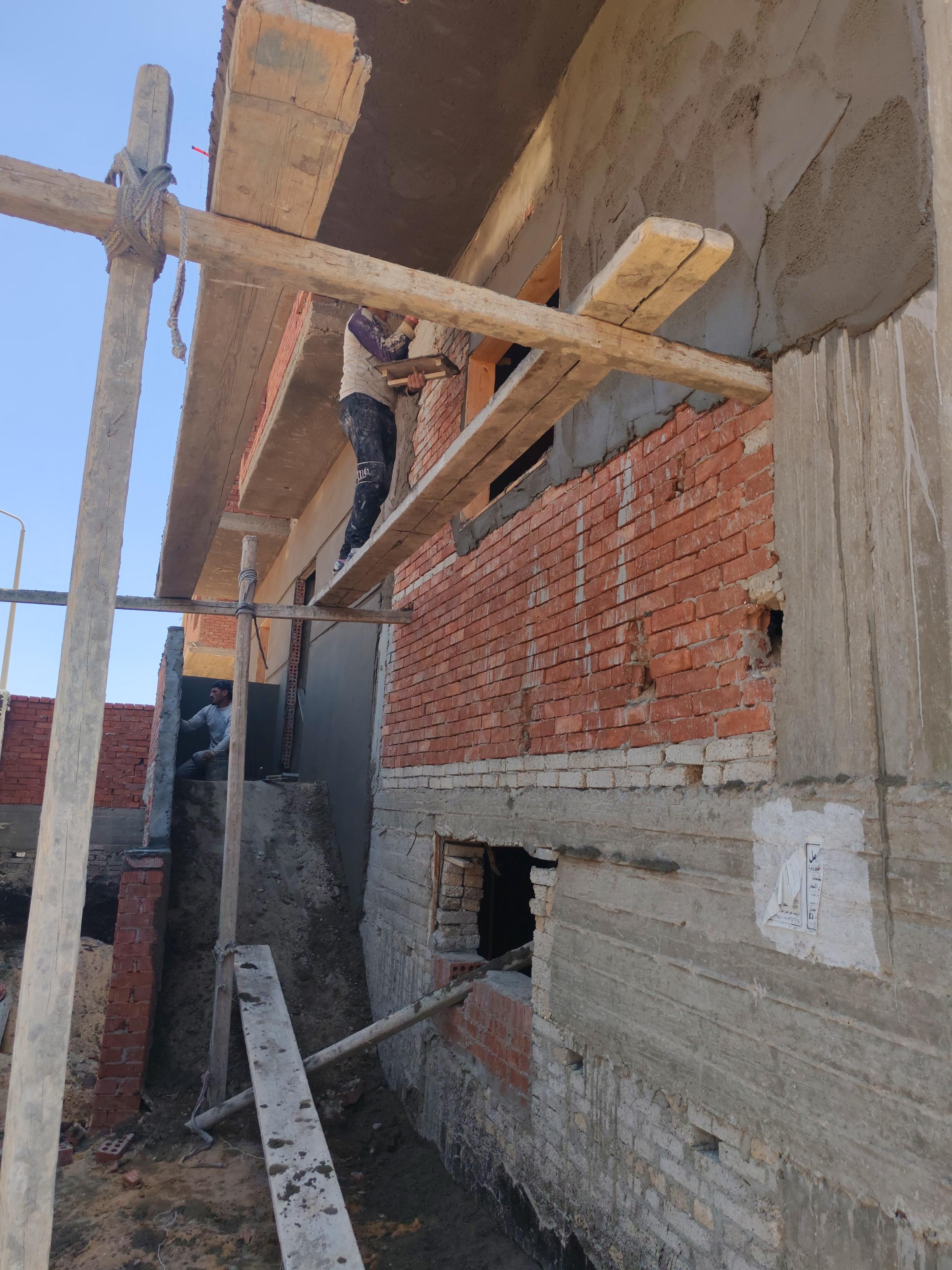

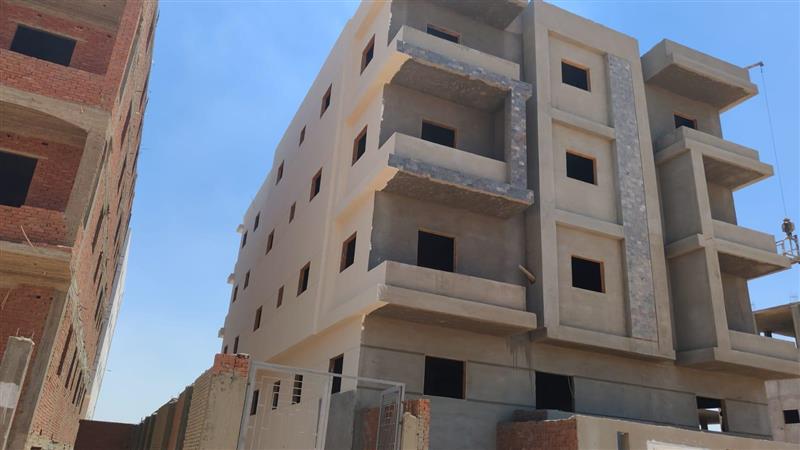

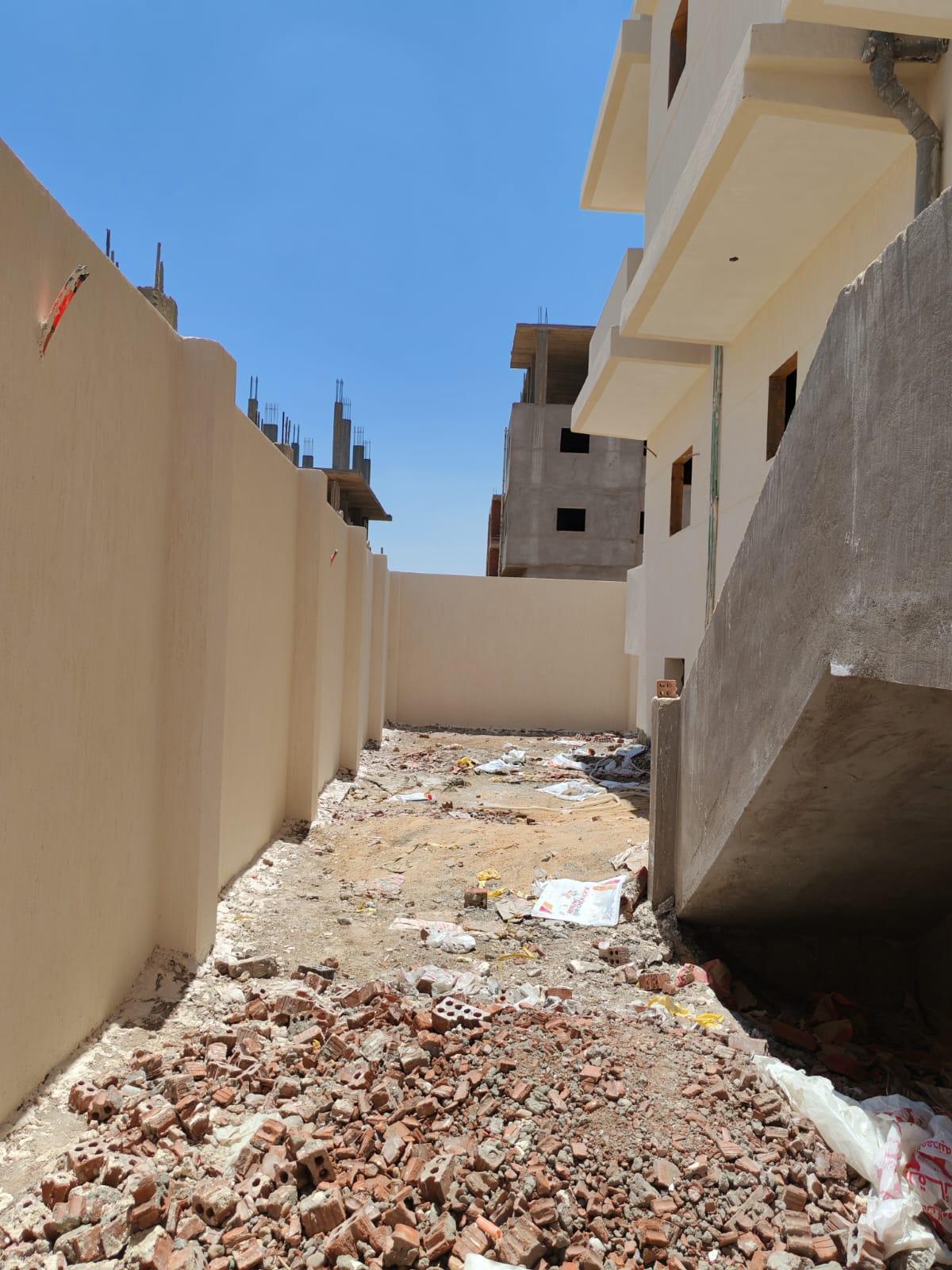

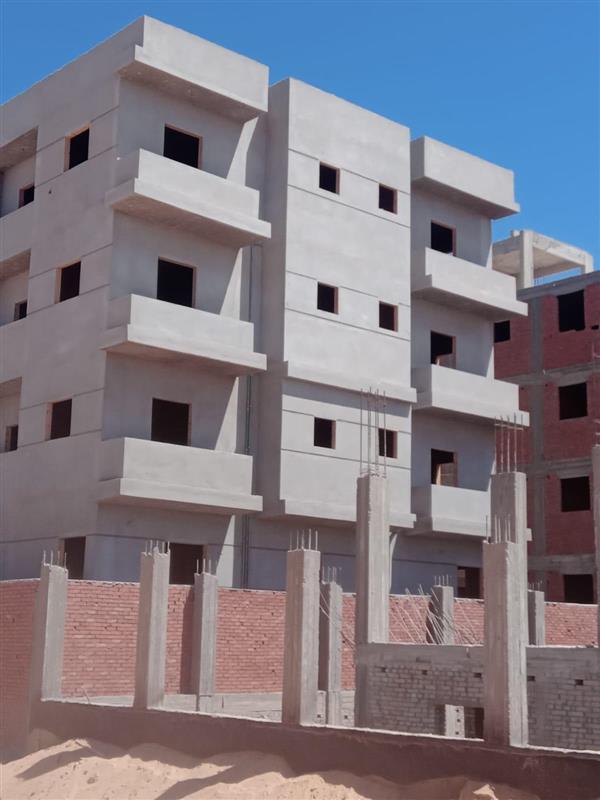

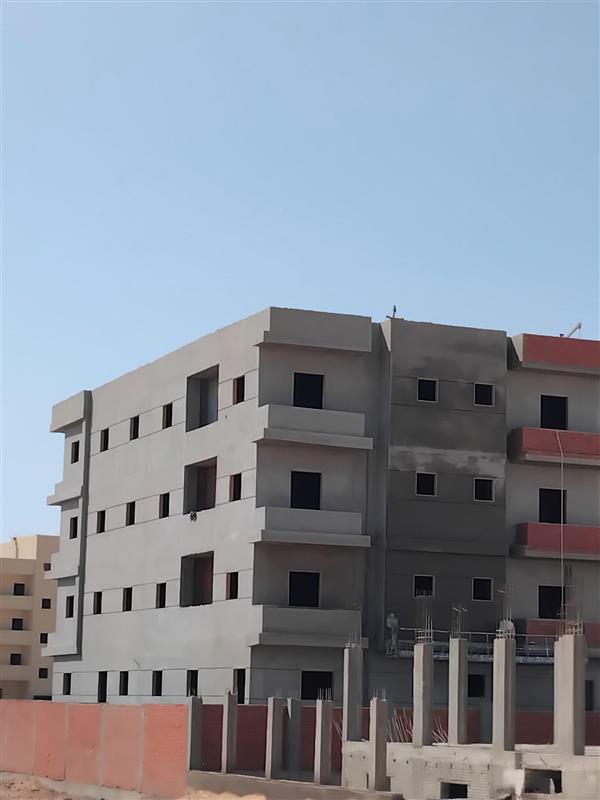

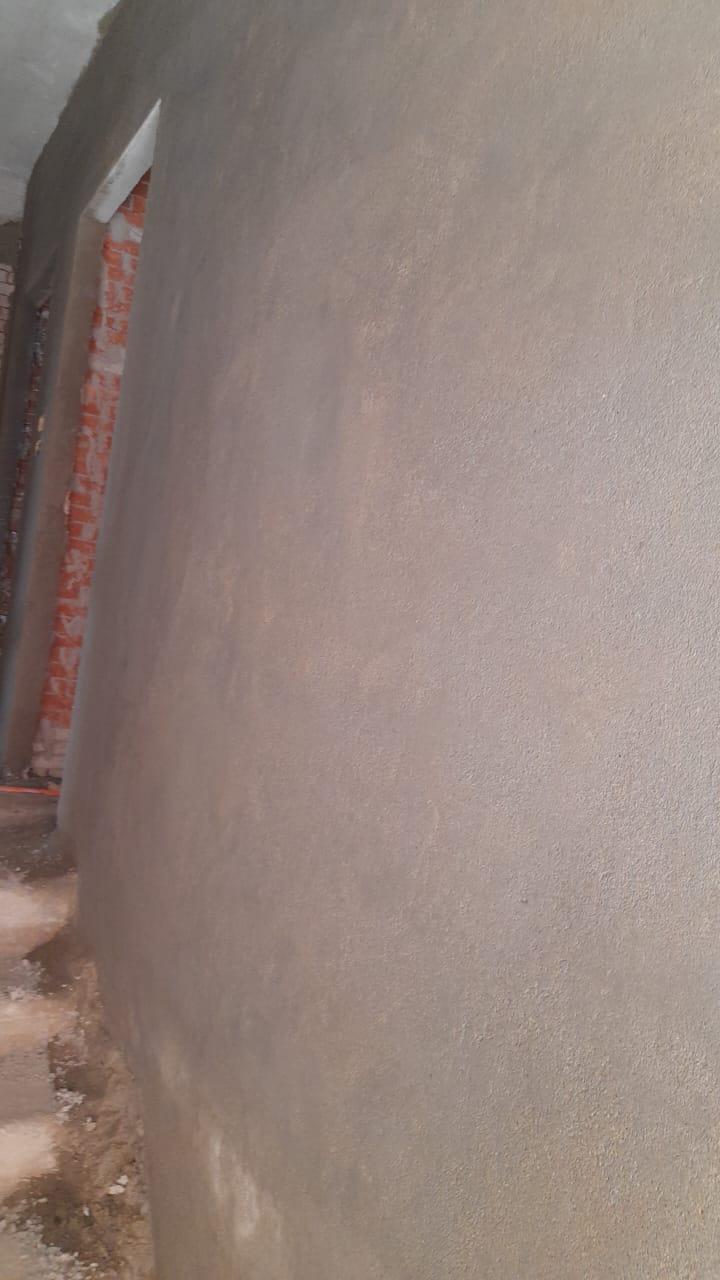

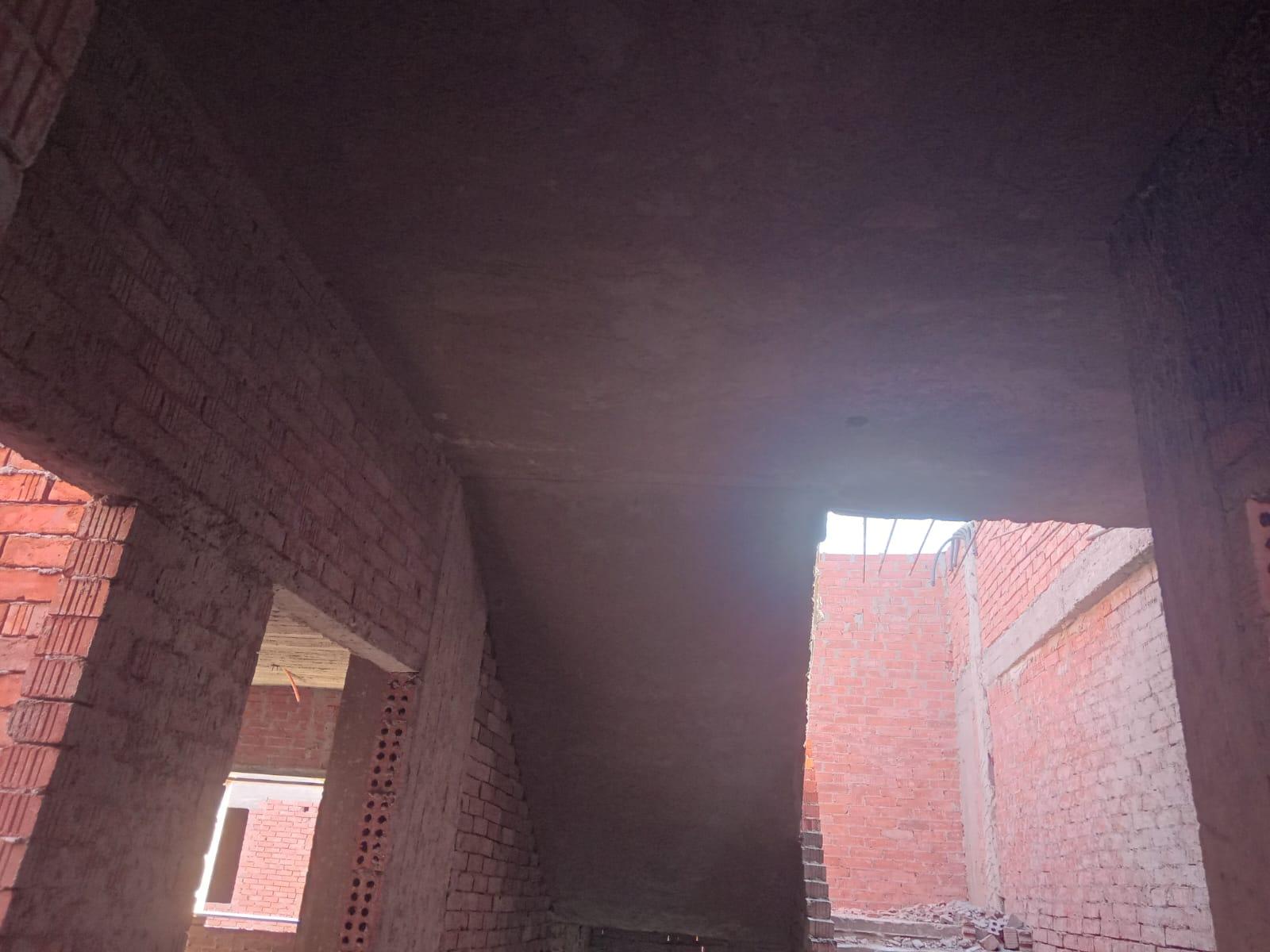

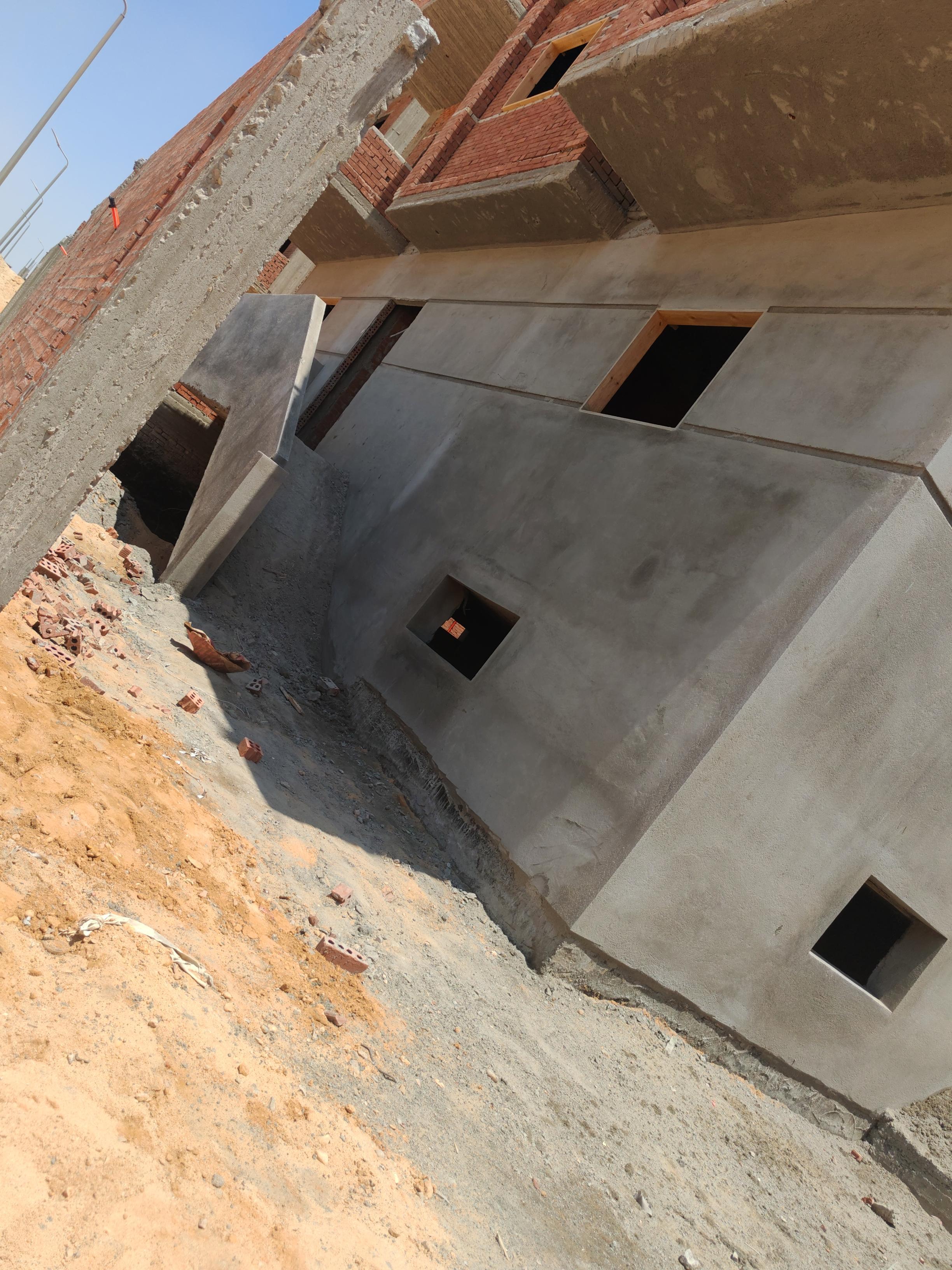

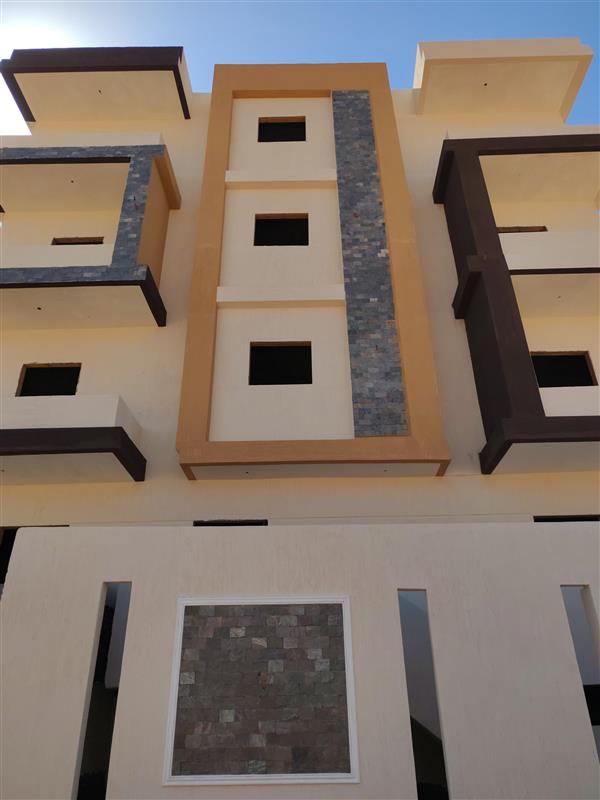

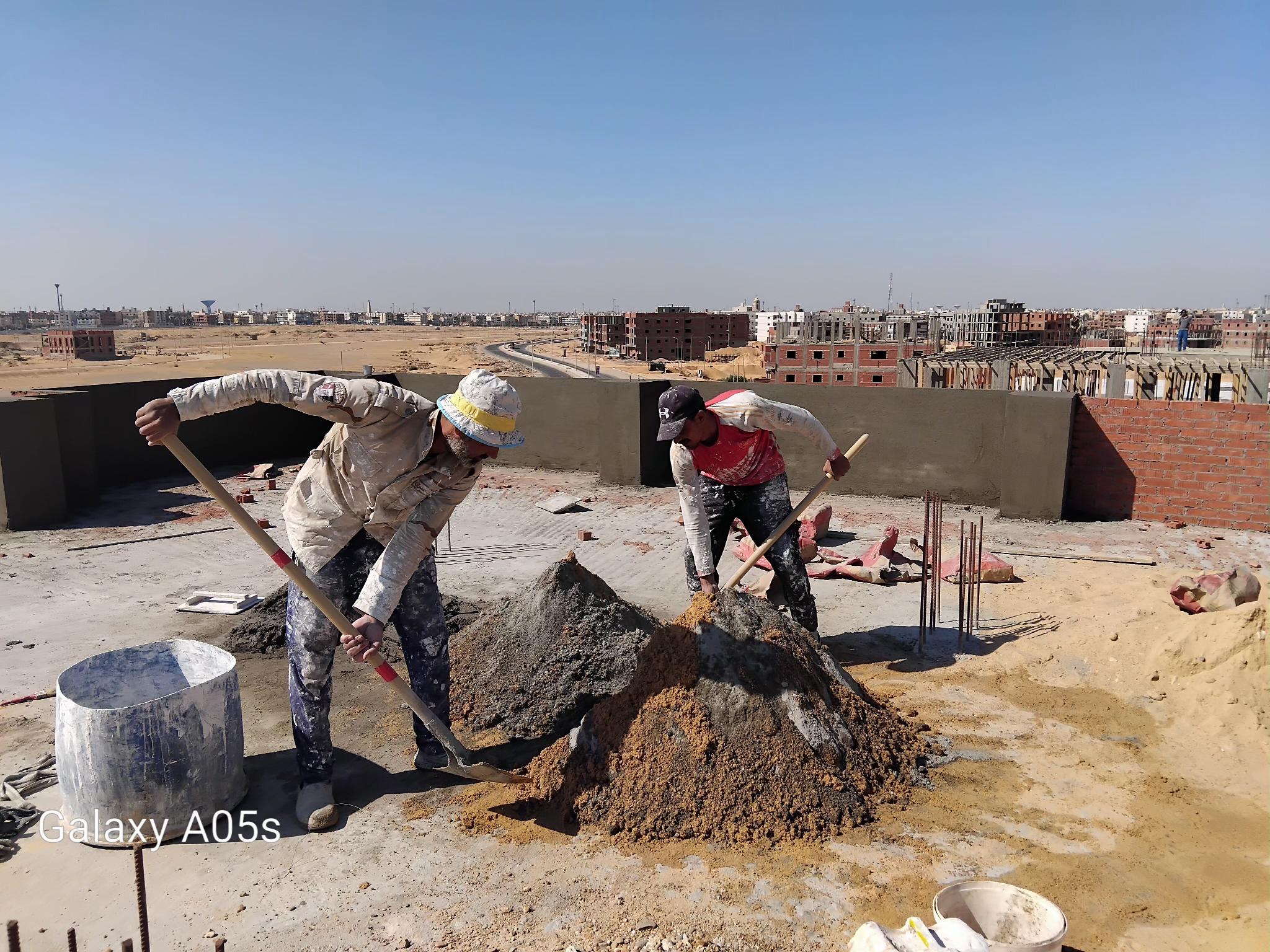

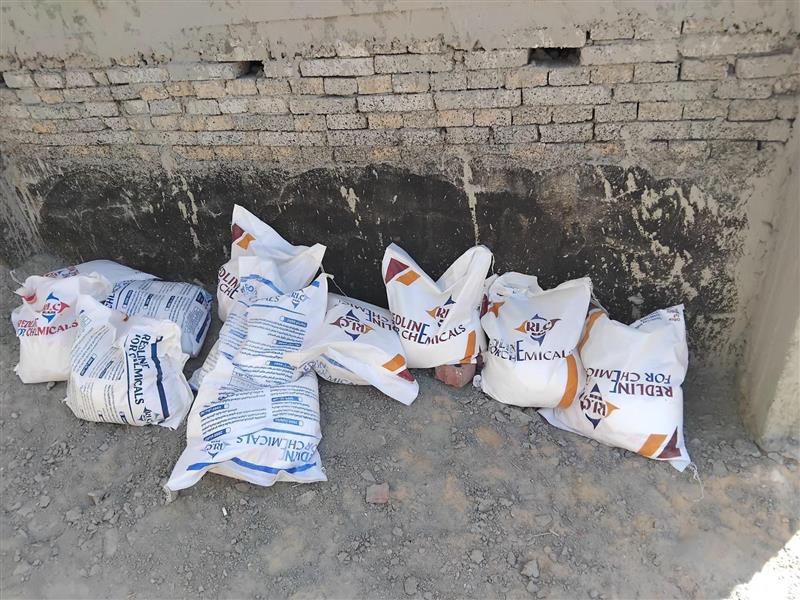

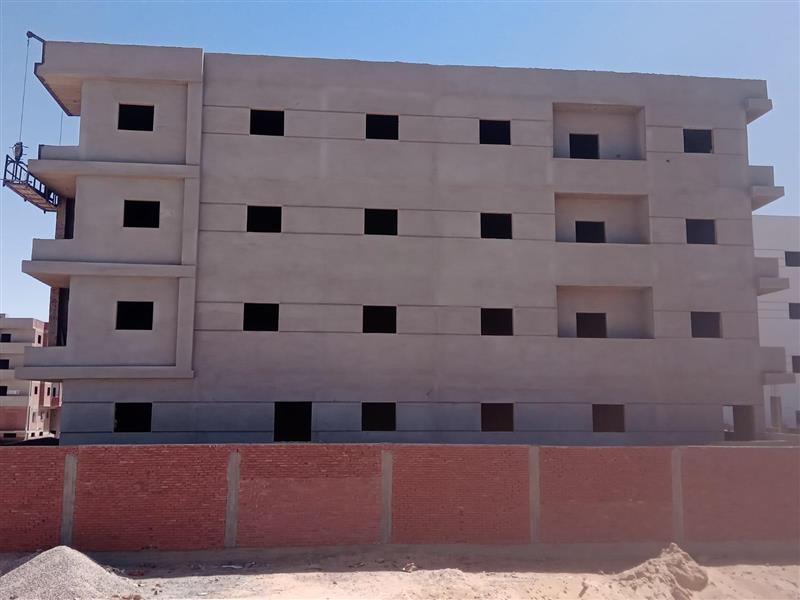

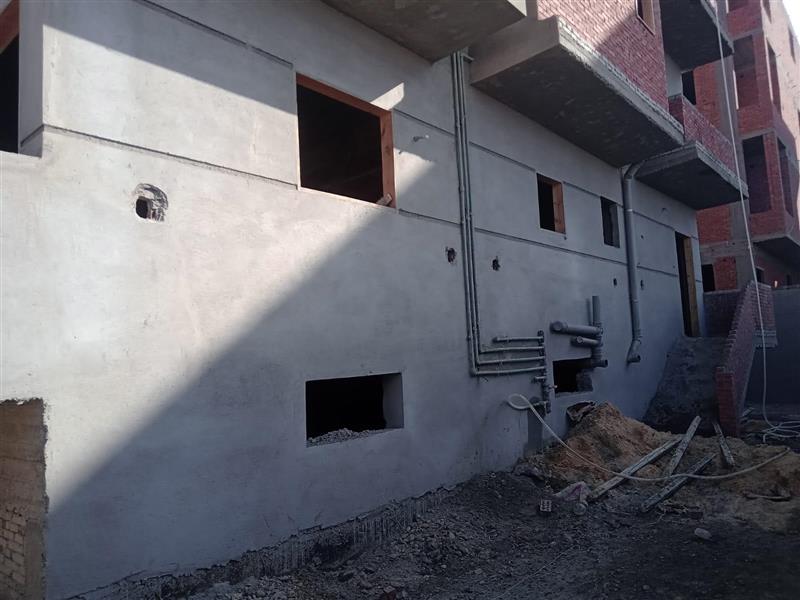

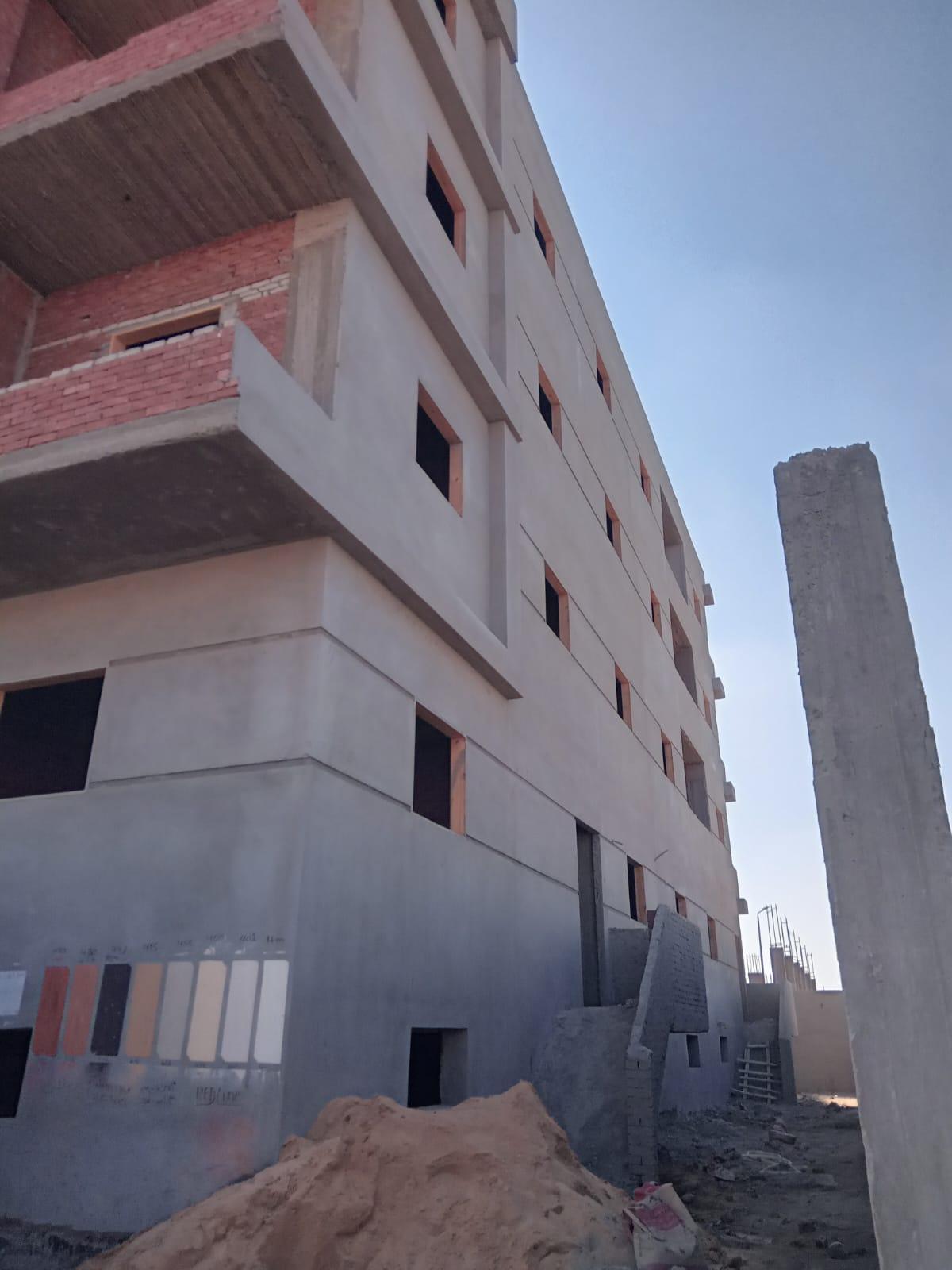

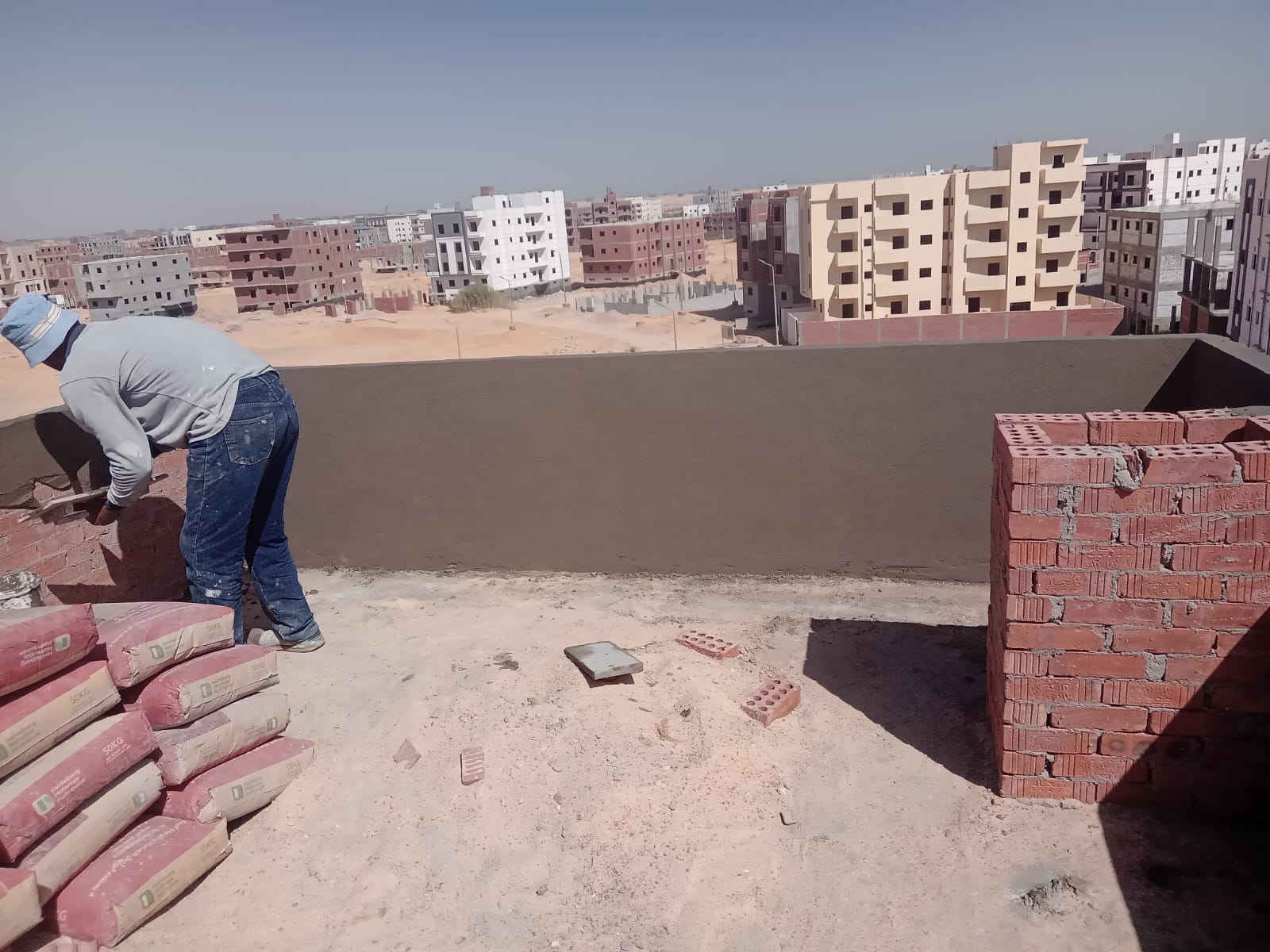

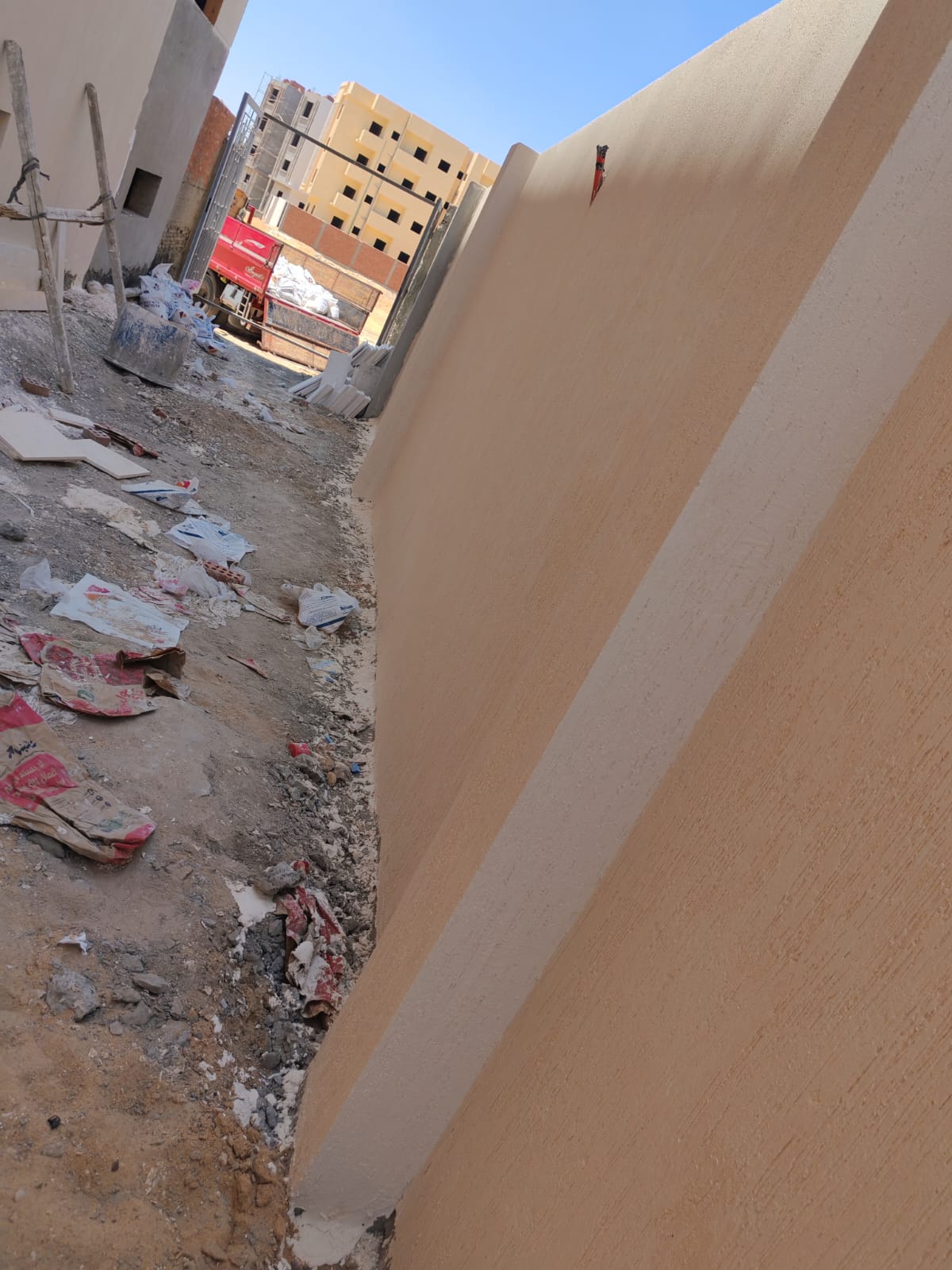

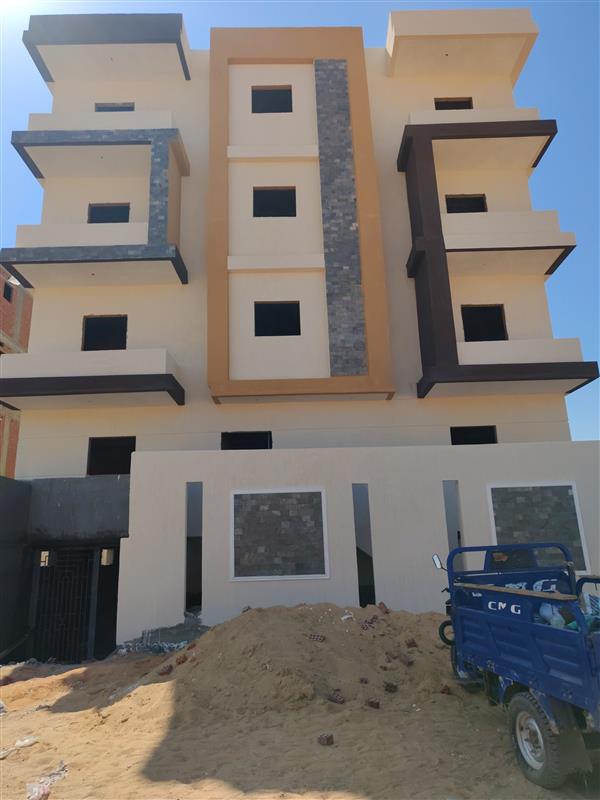

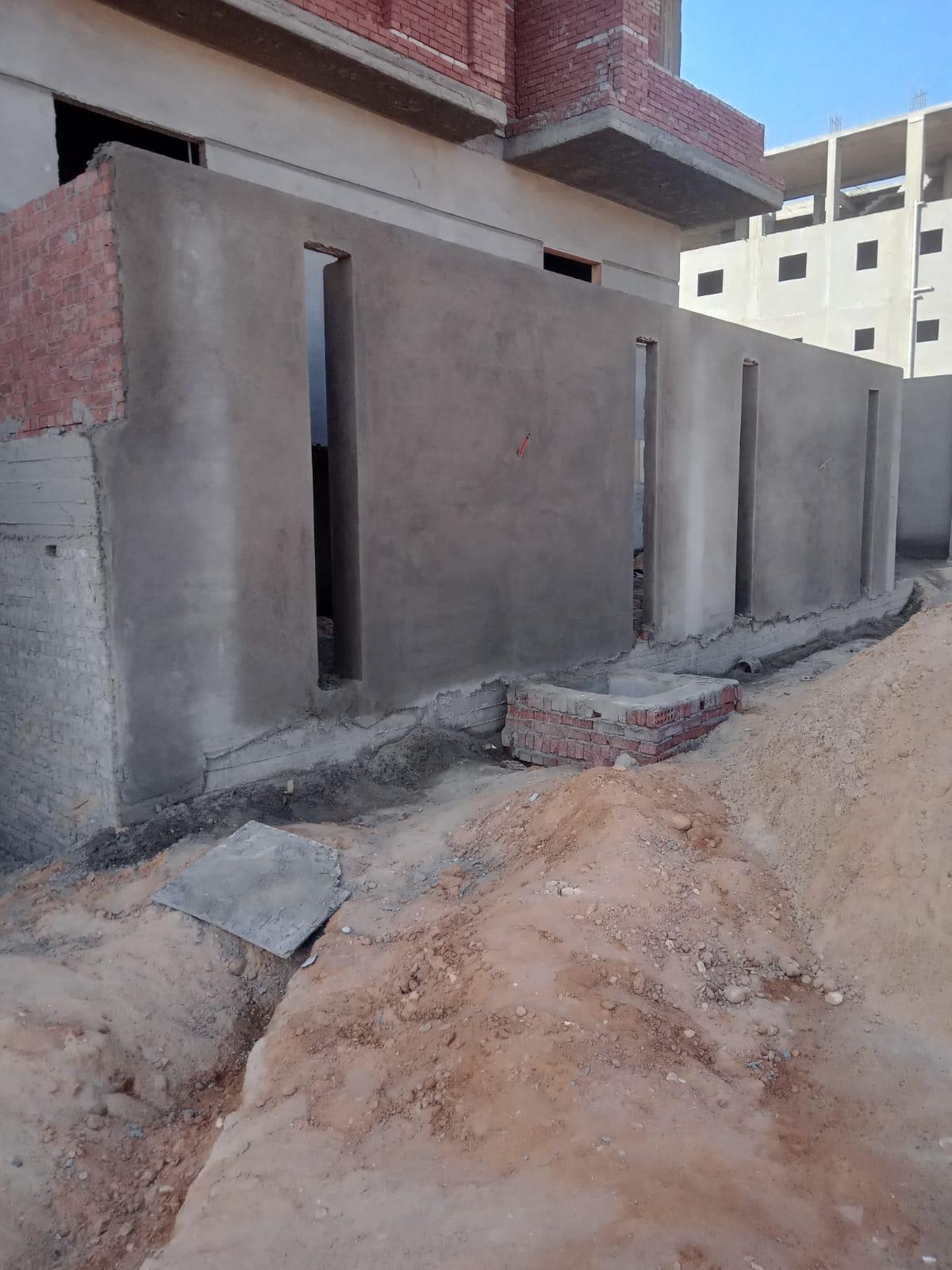

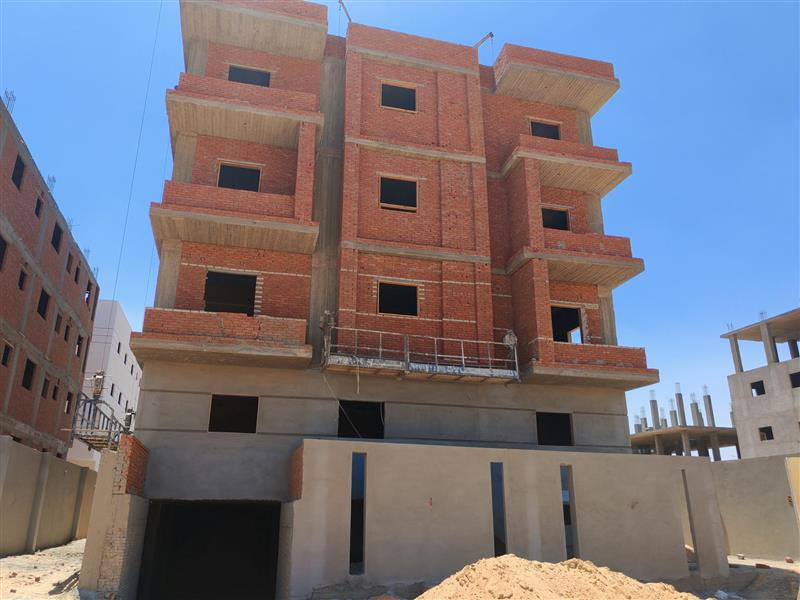

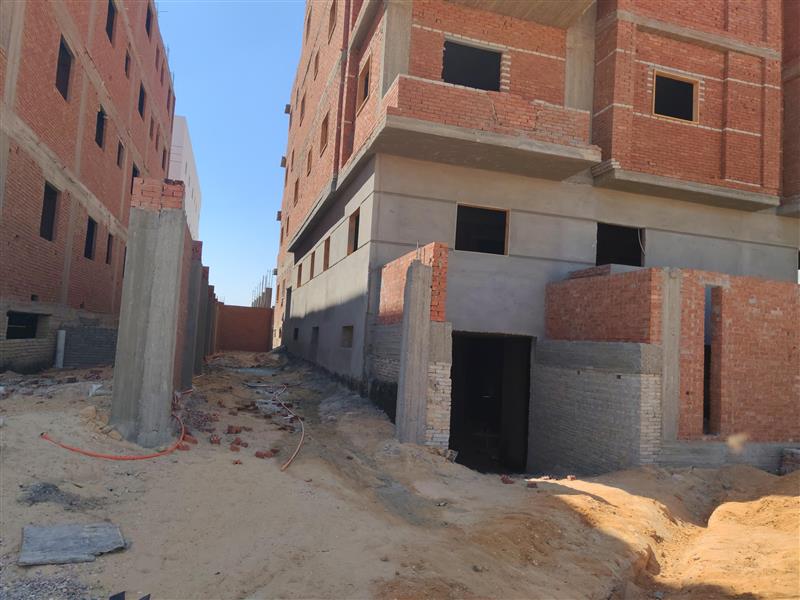

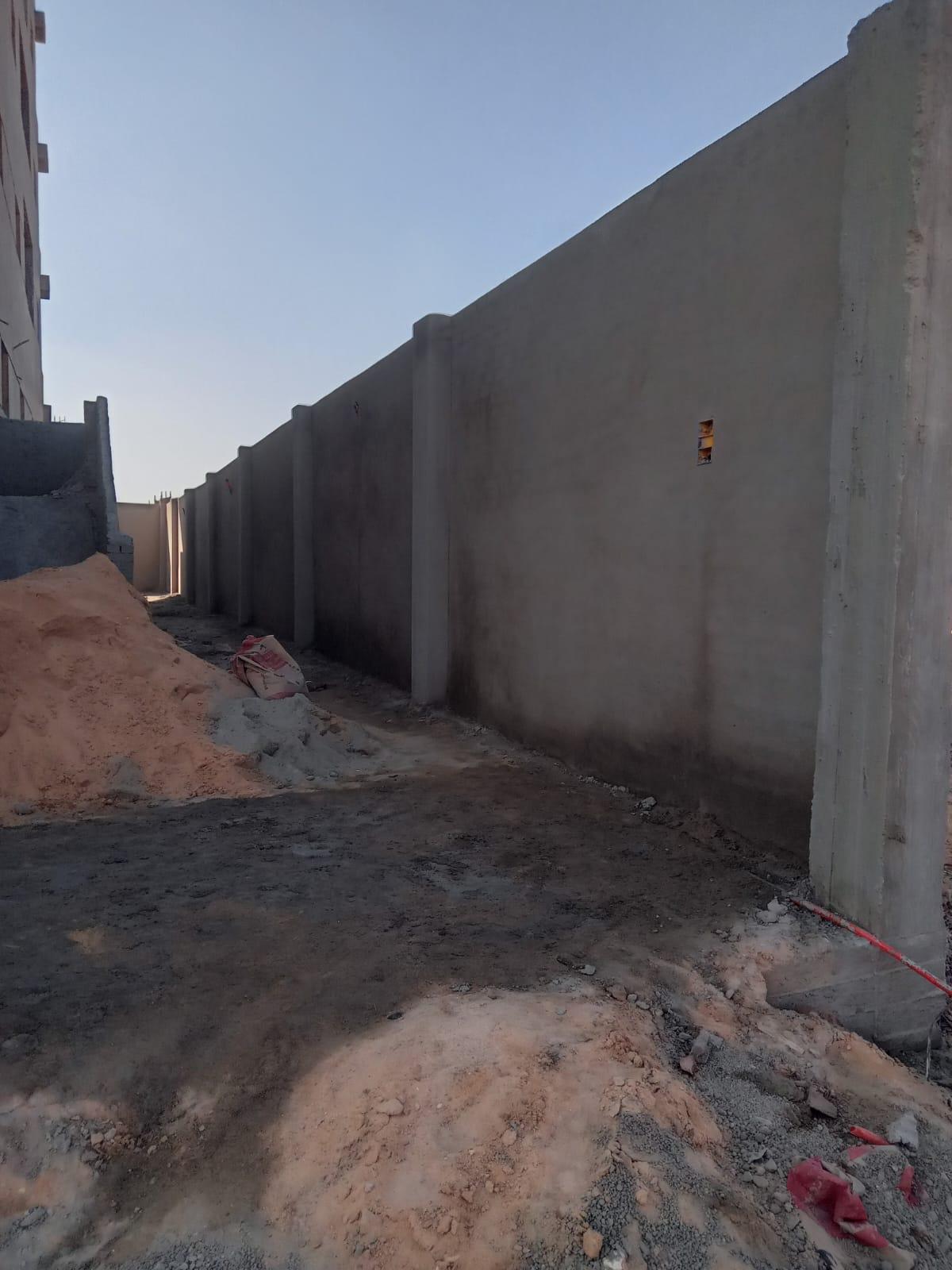

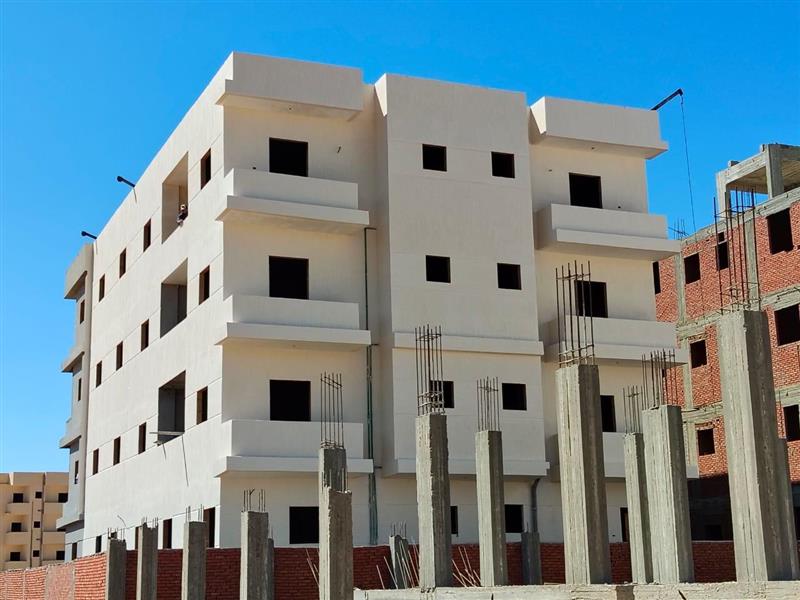

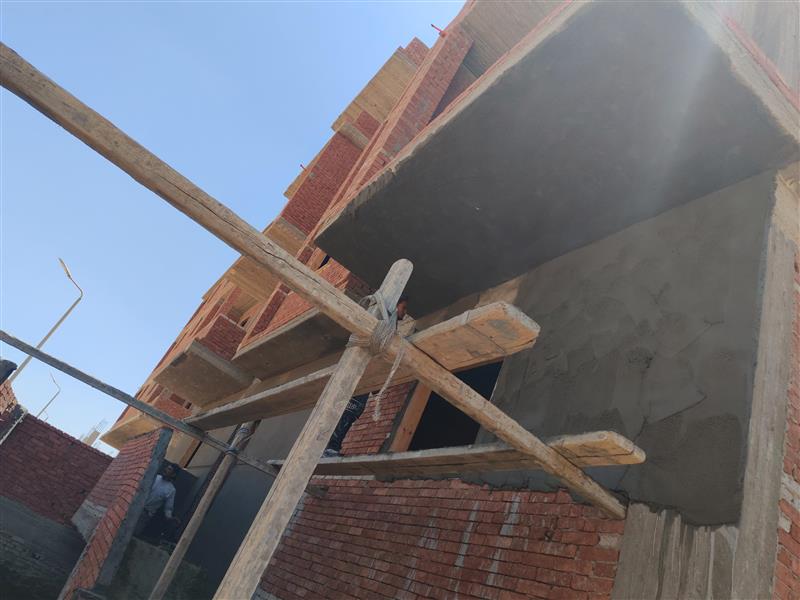

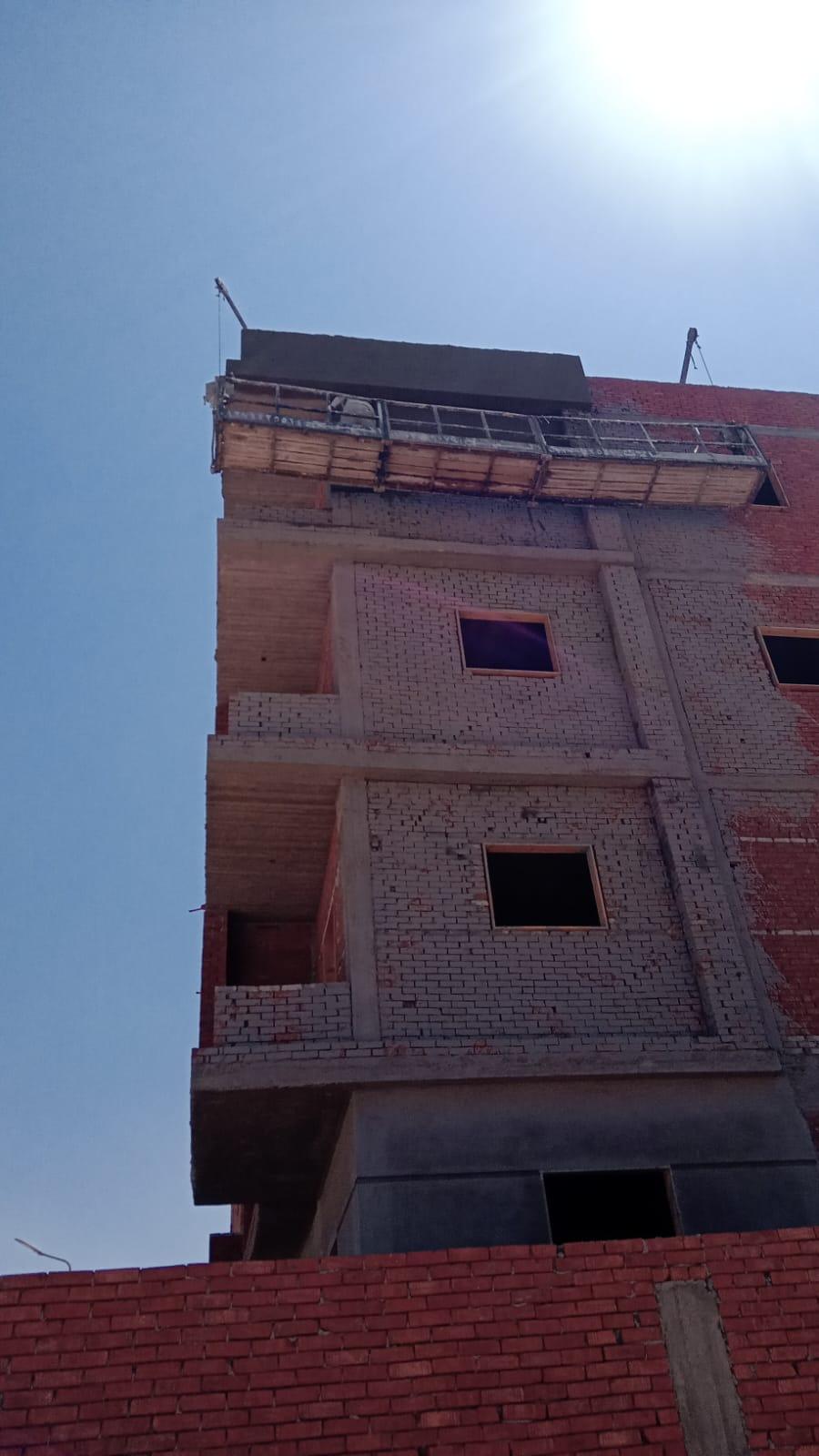

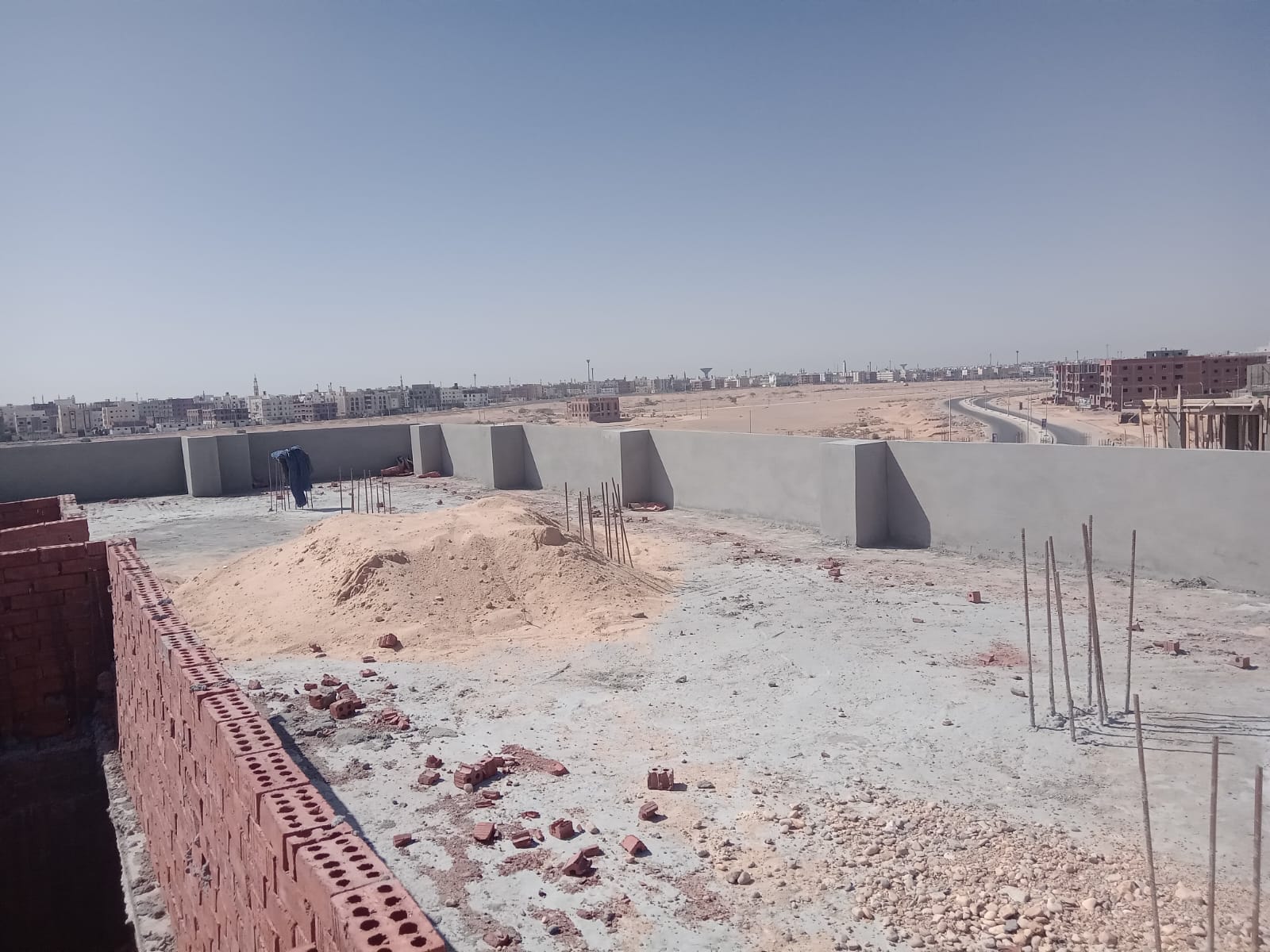

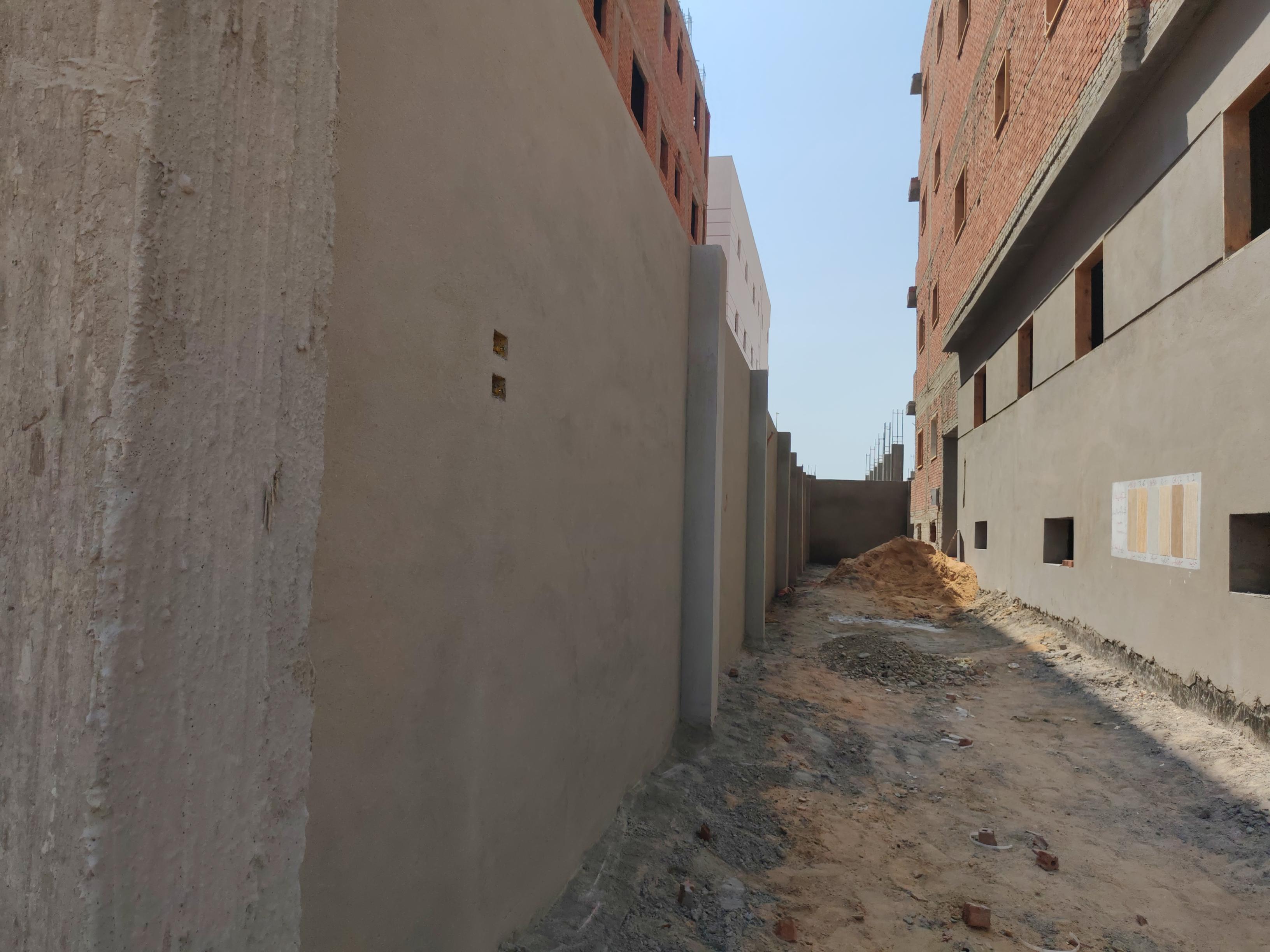

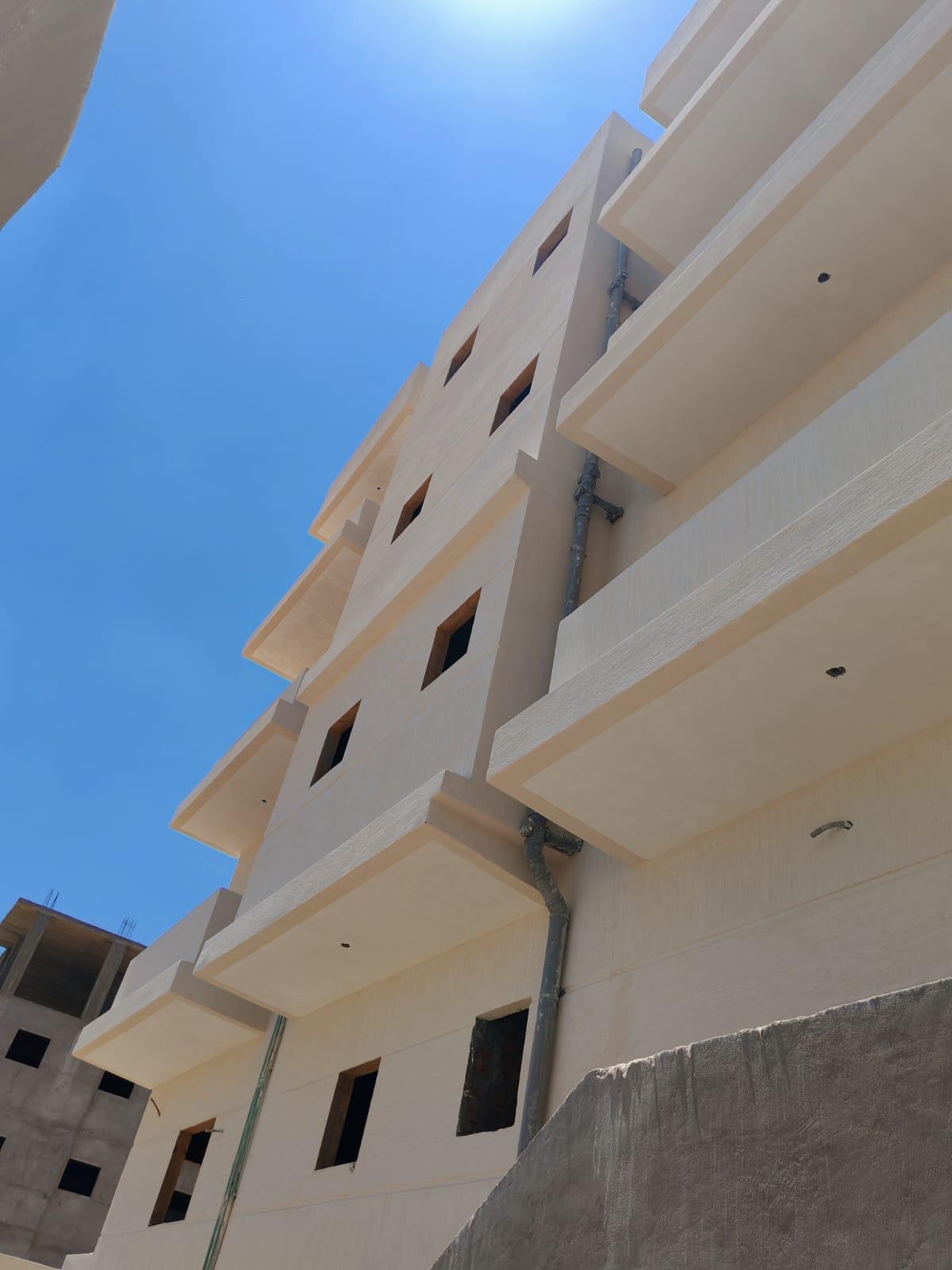

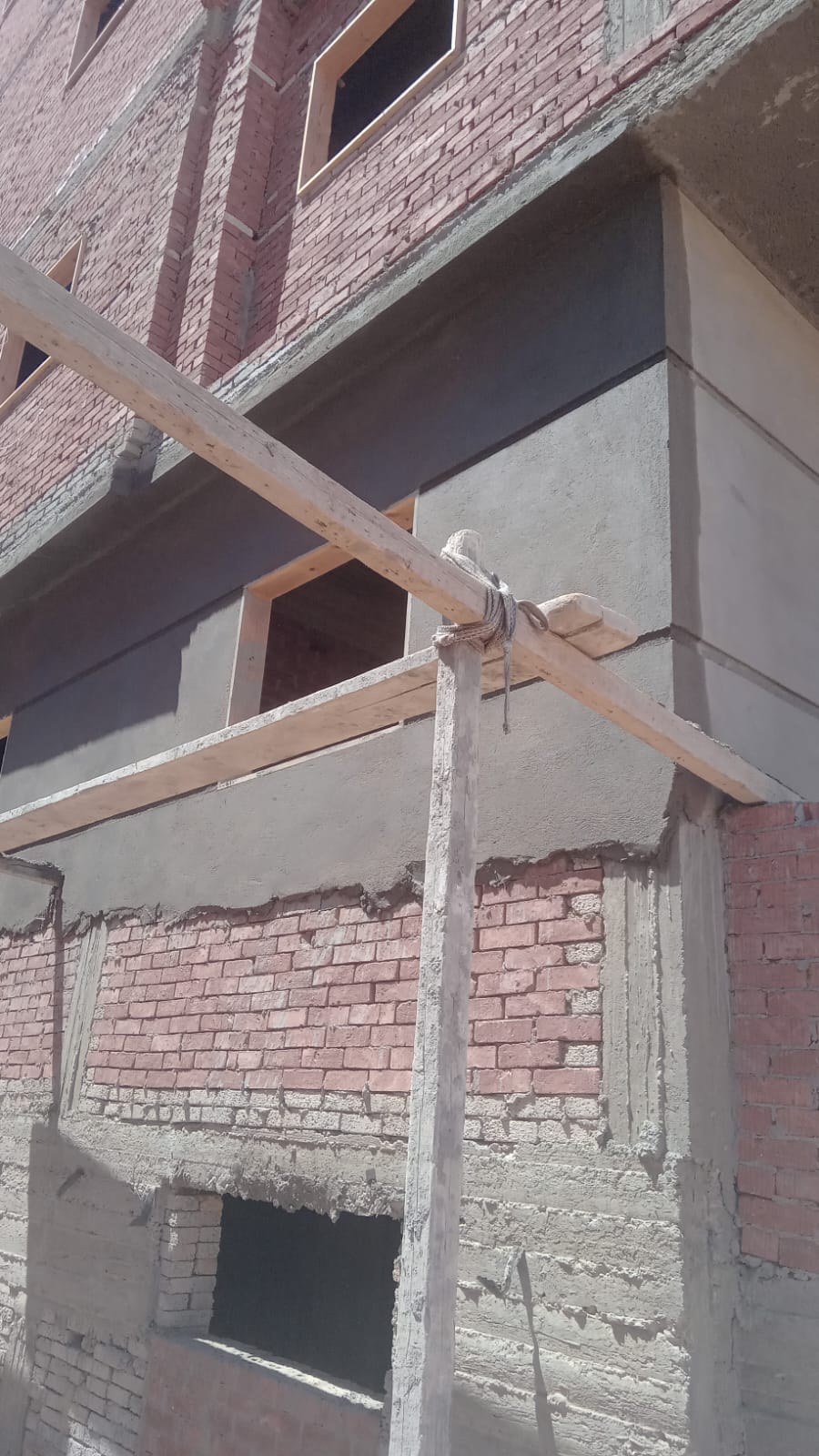

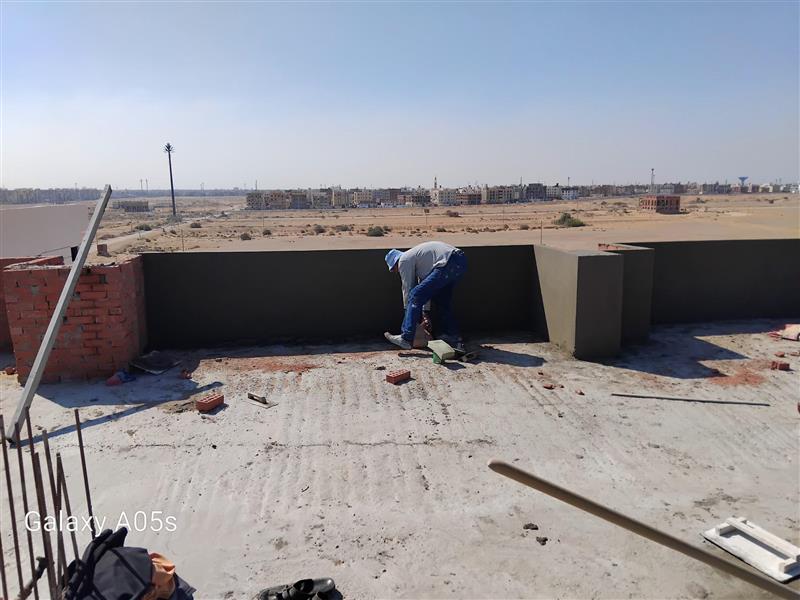

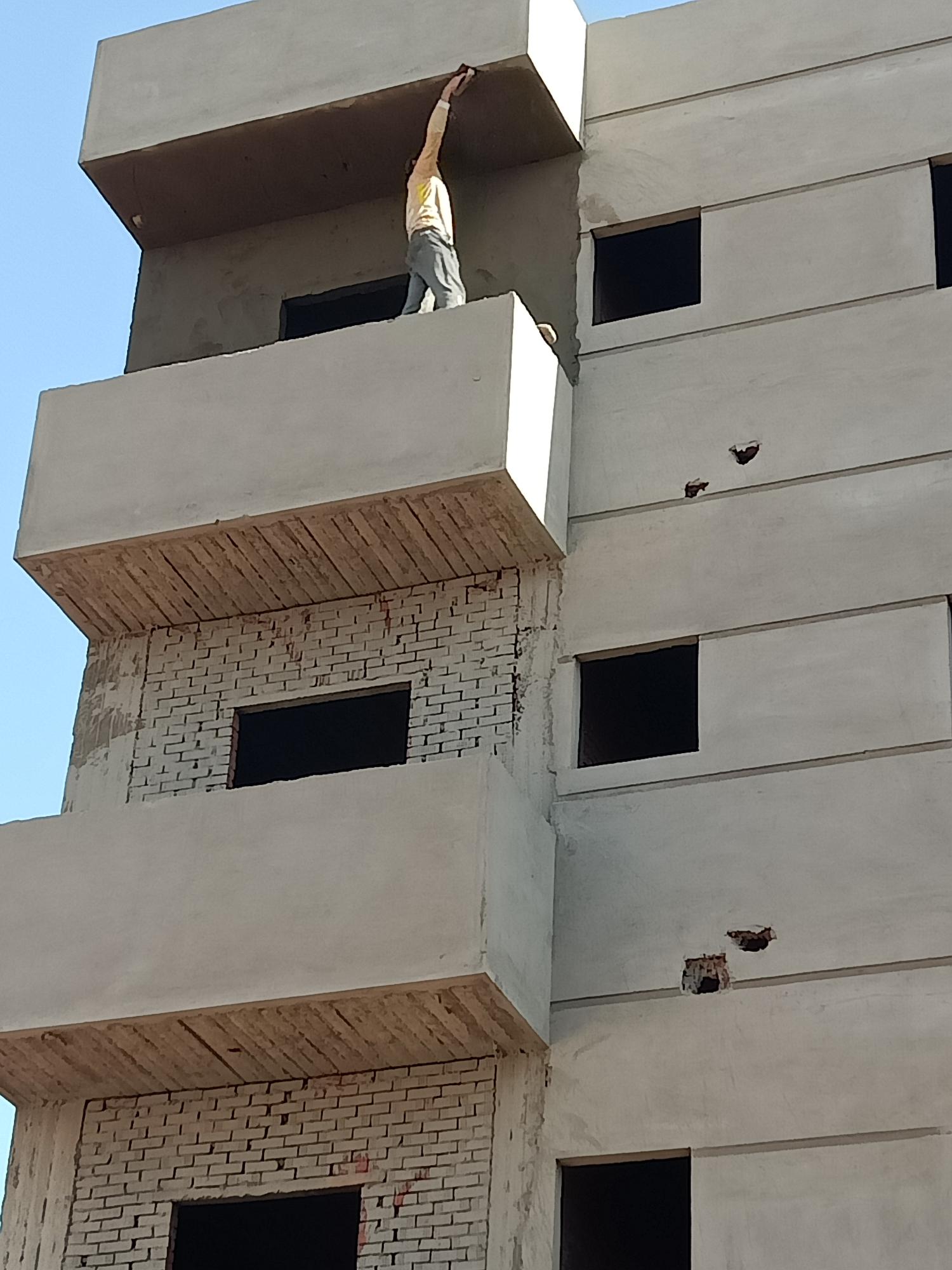

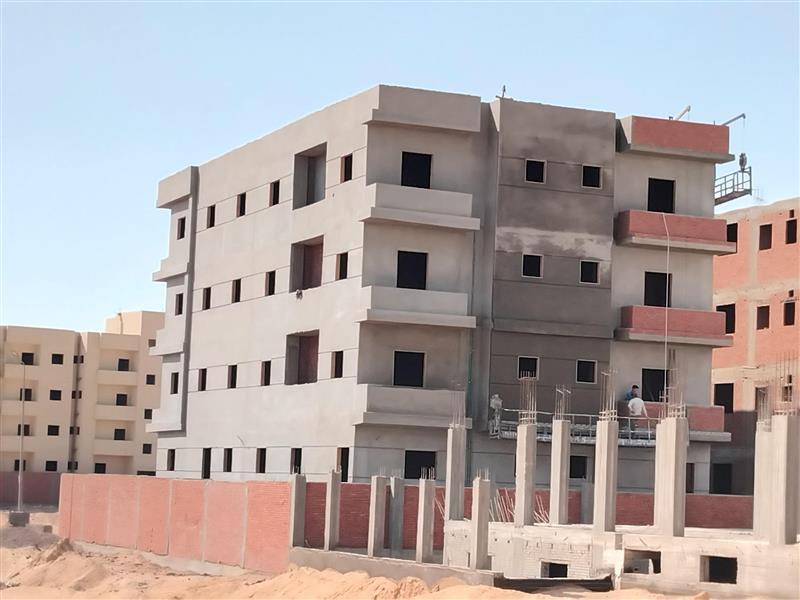

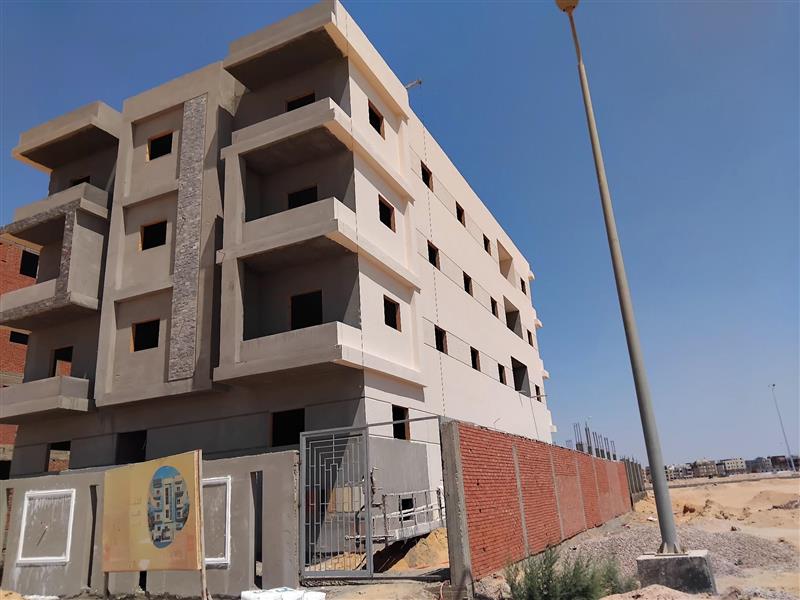

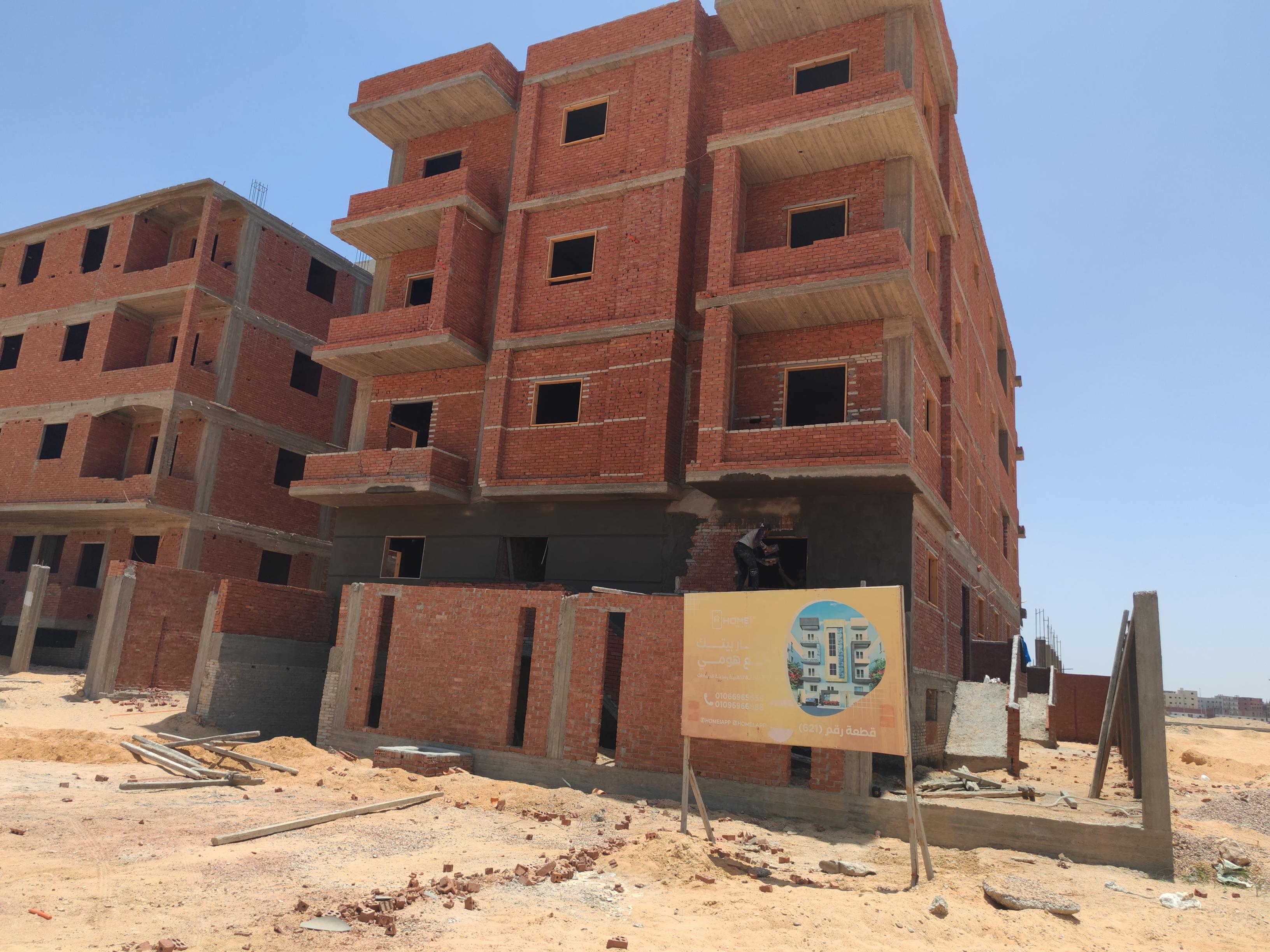

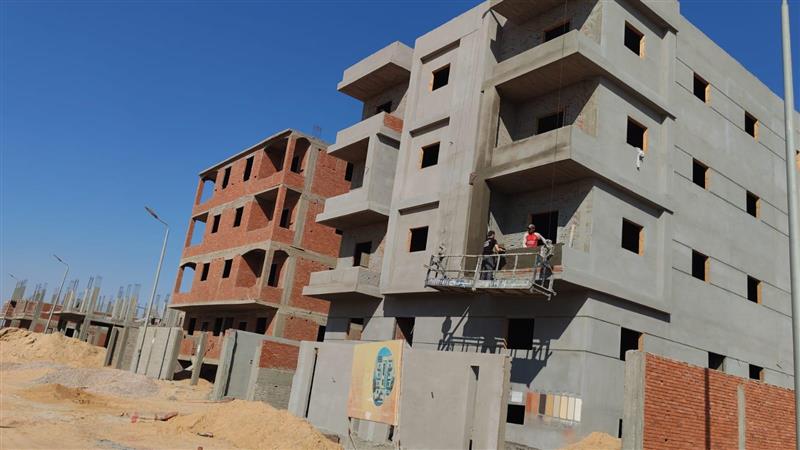

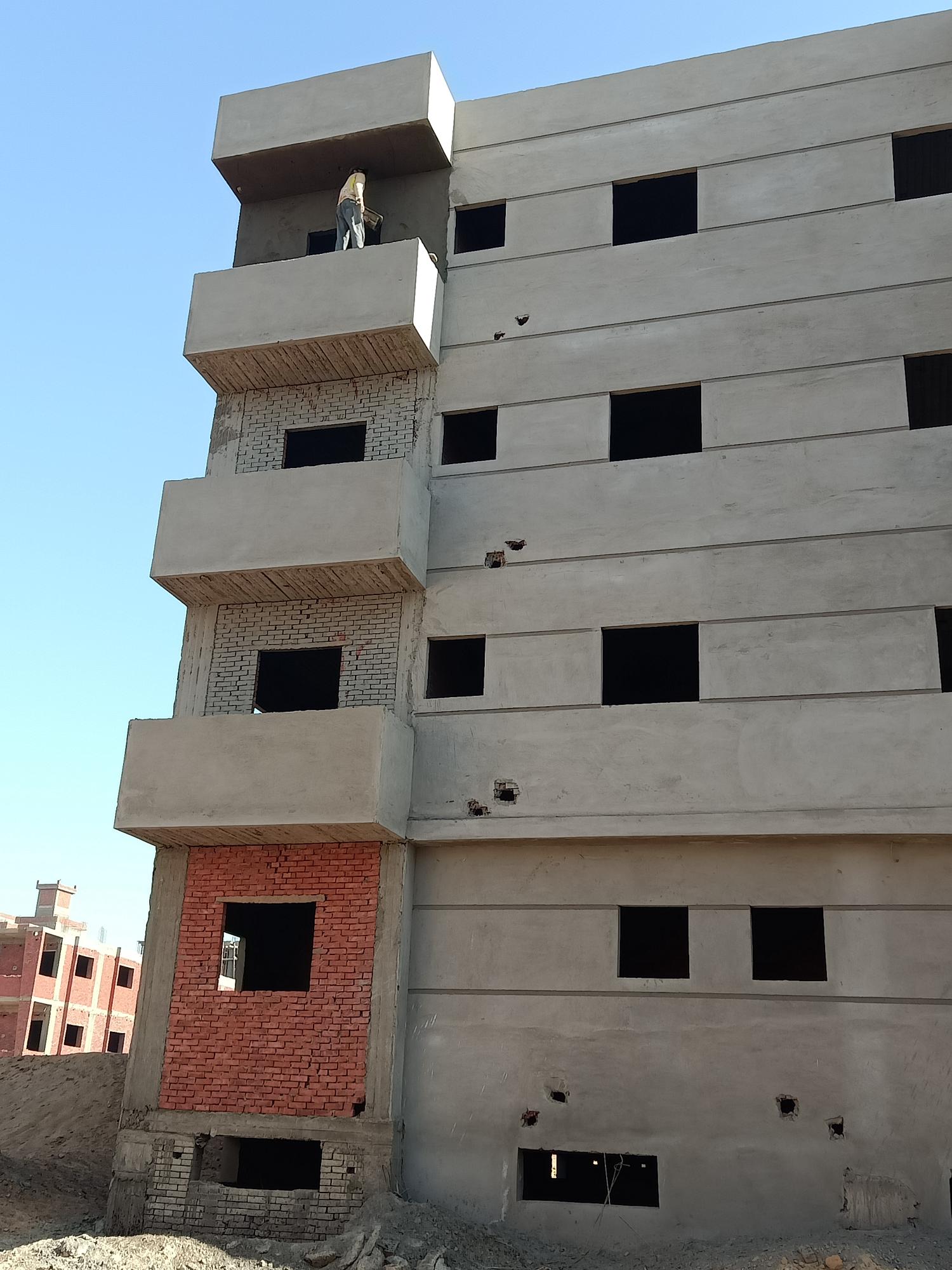

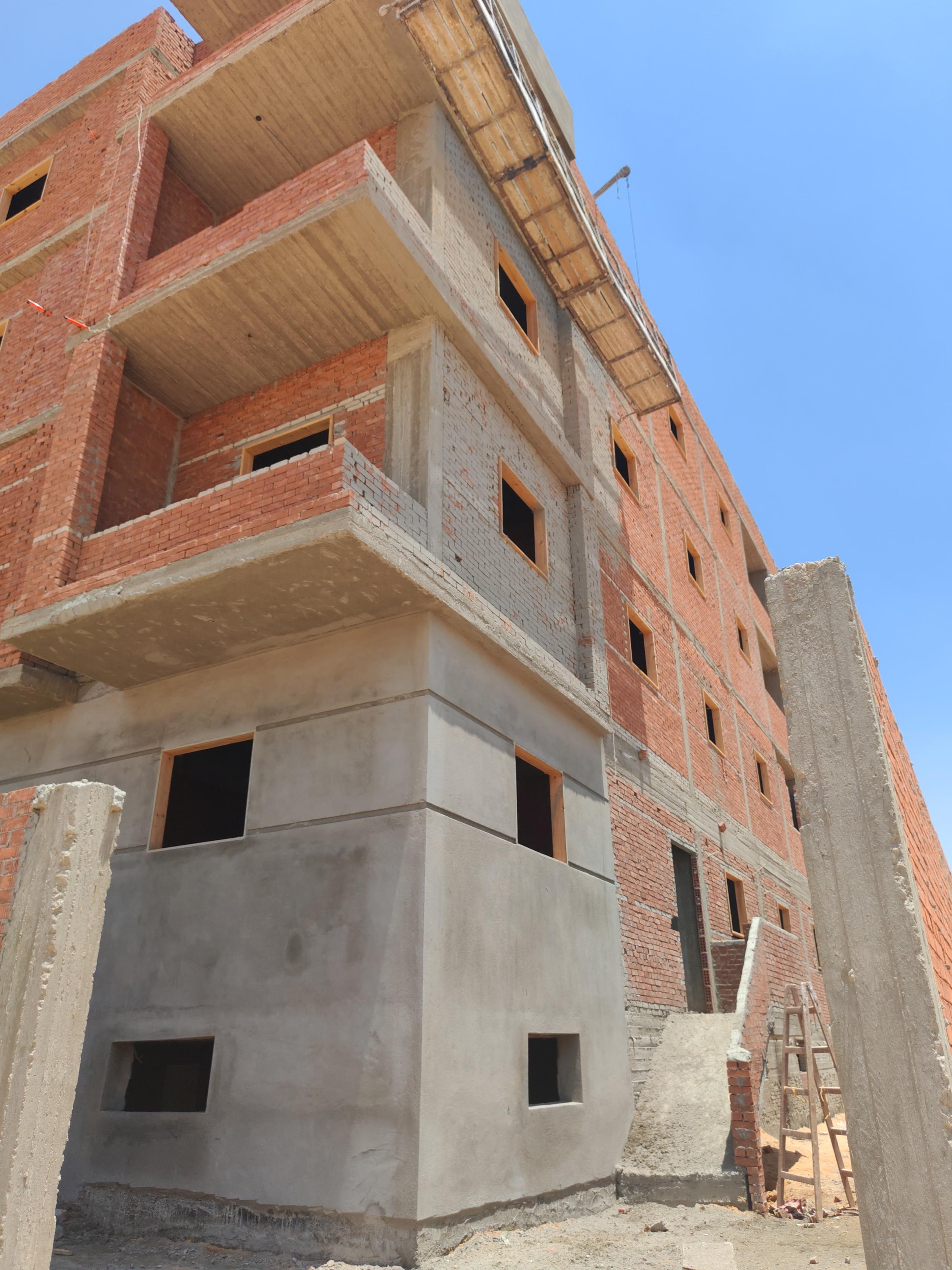

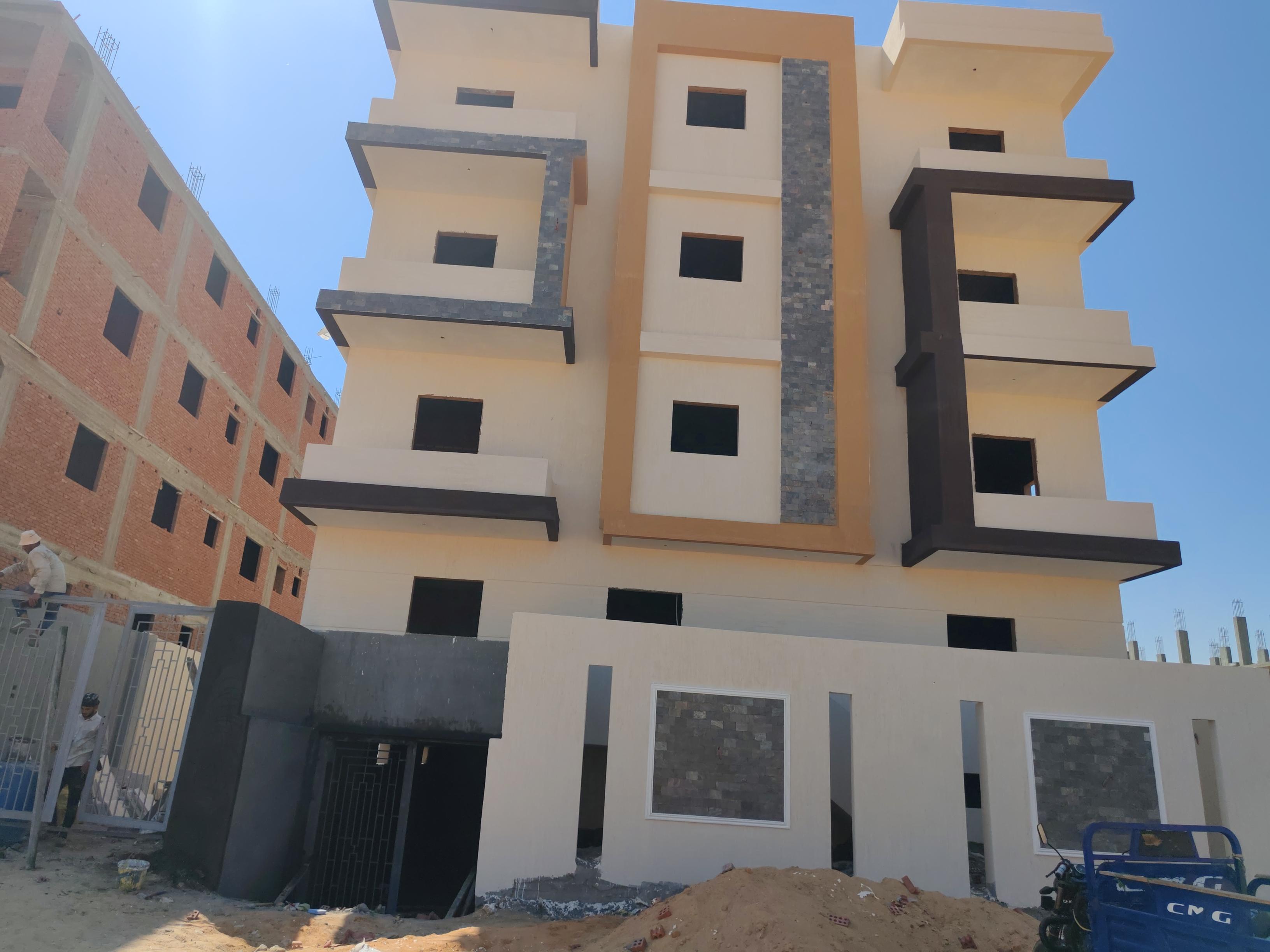

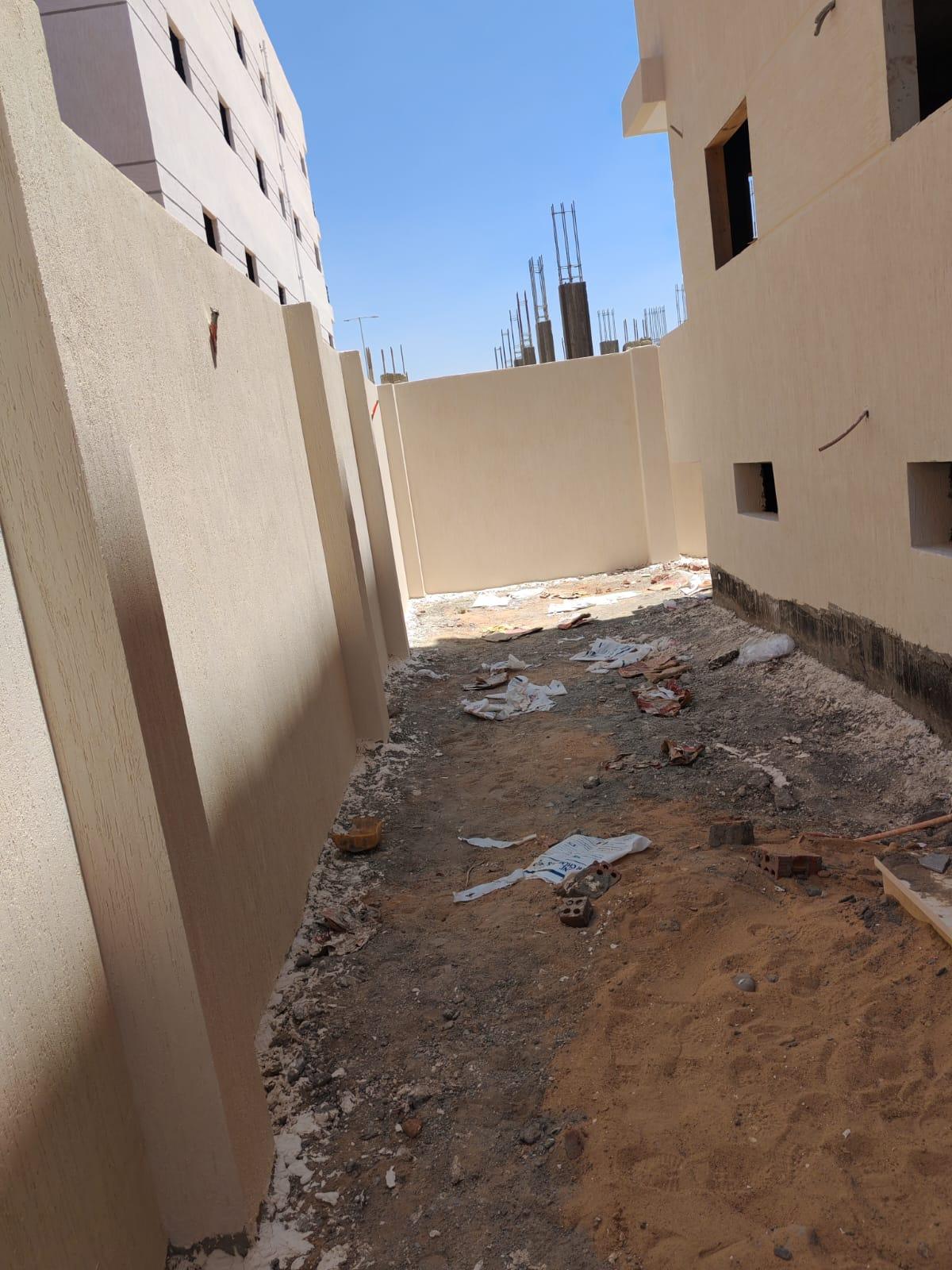

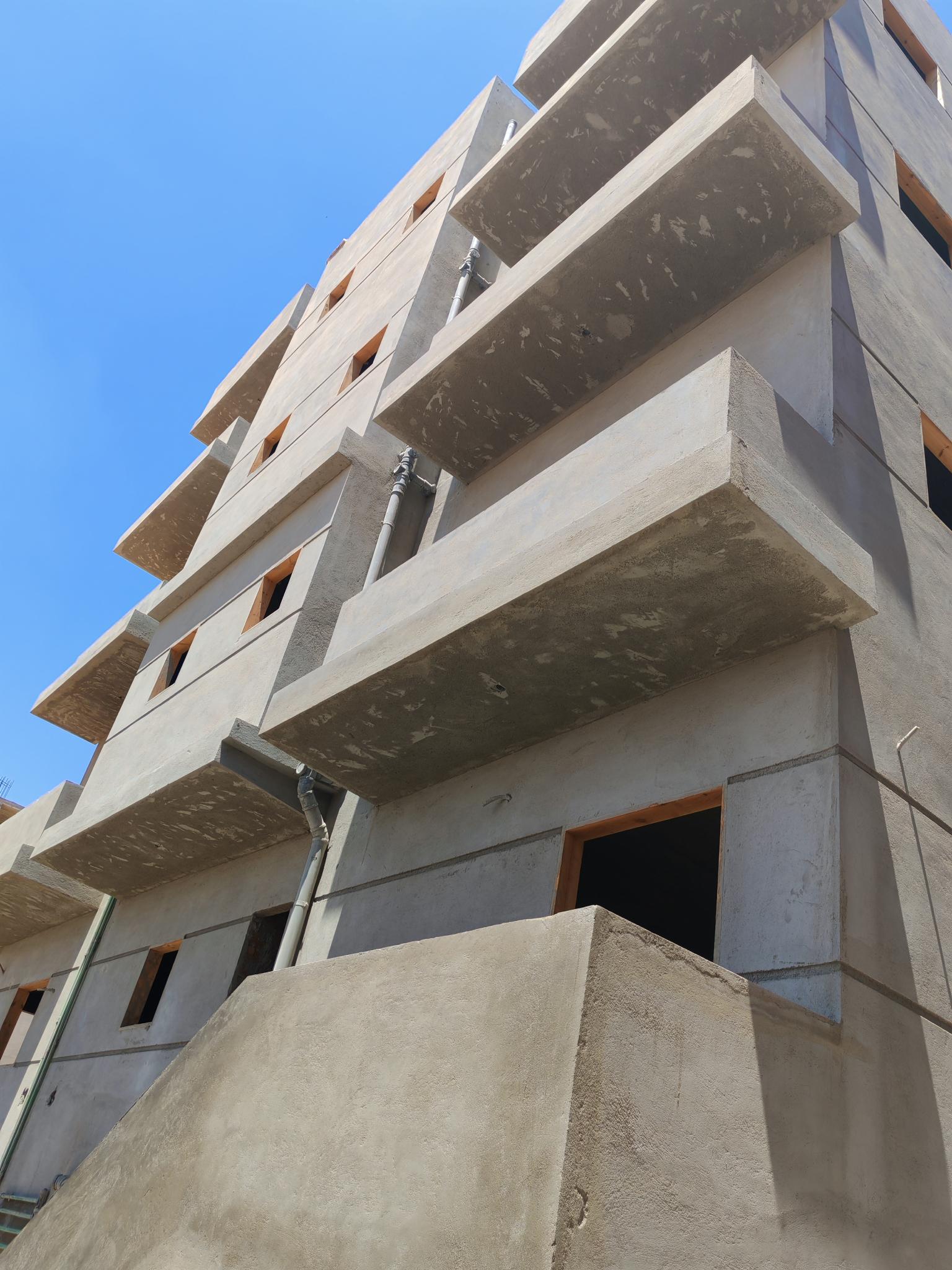

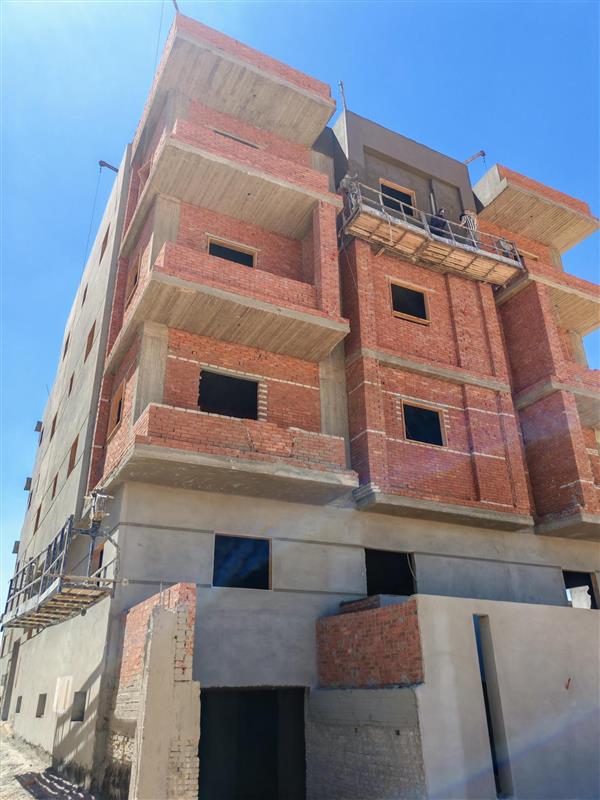

Plaster and putty

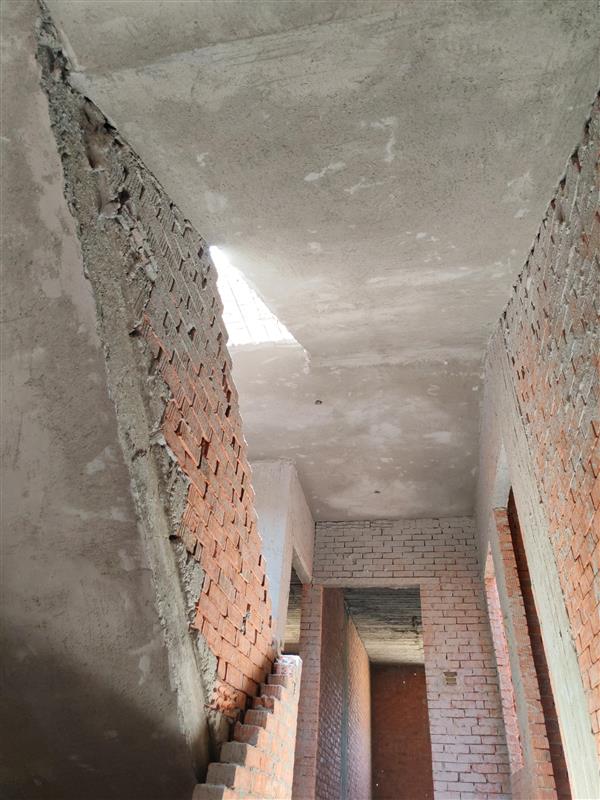

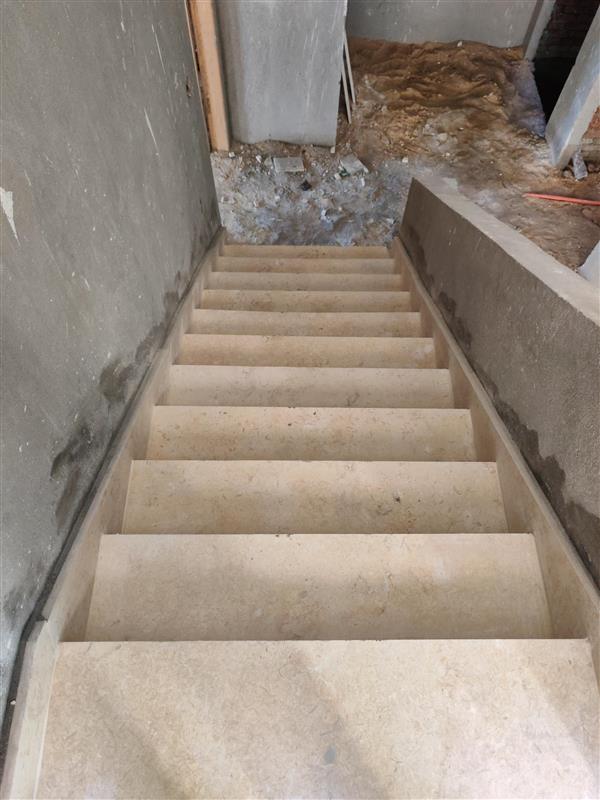

May 23, 2025

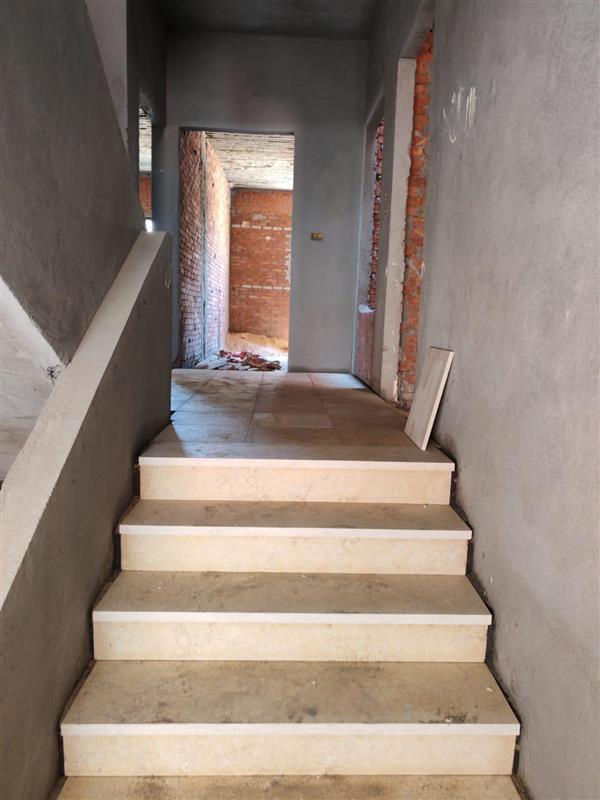

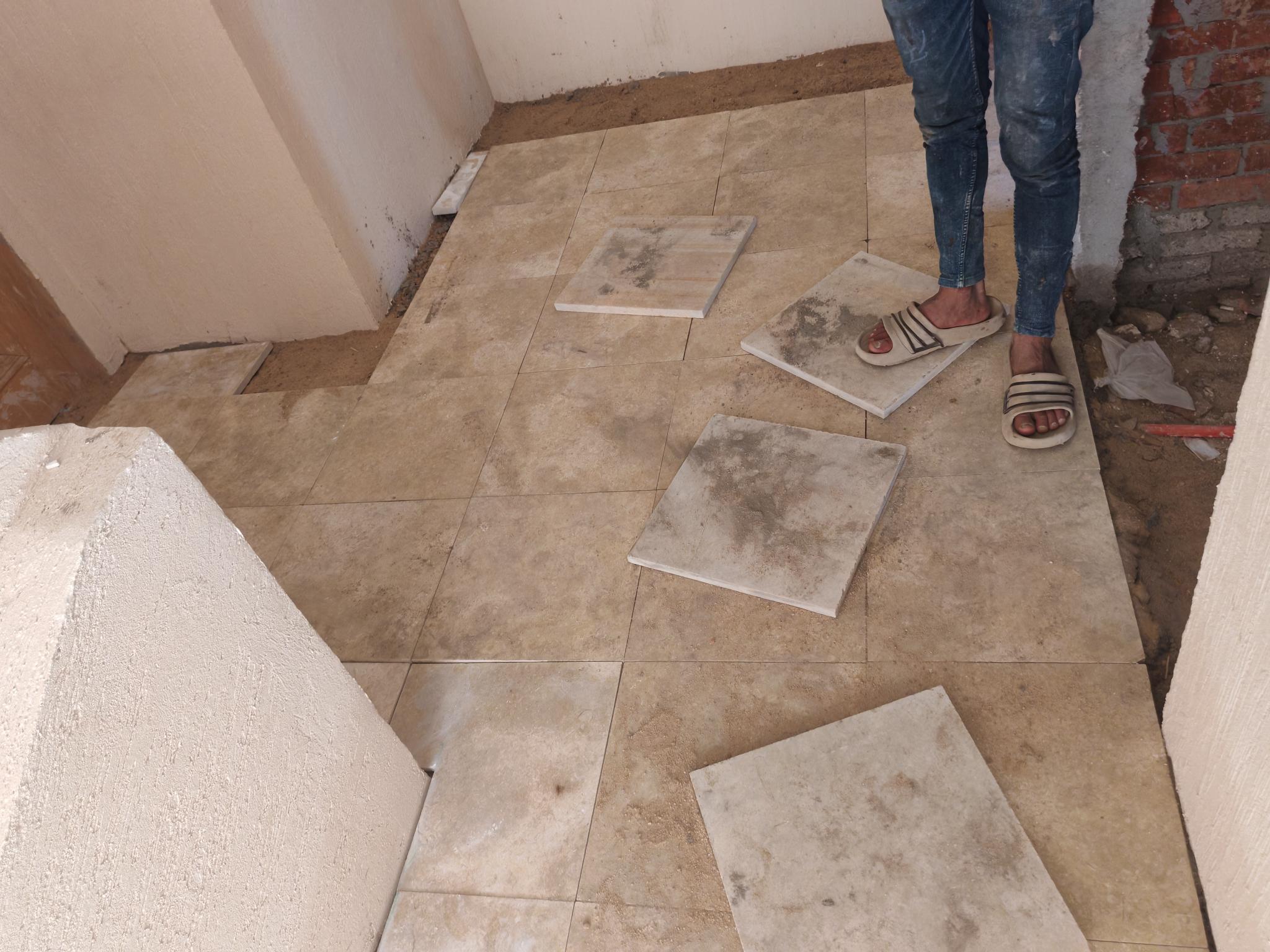

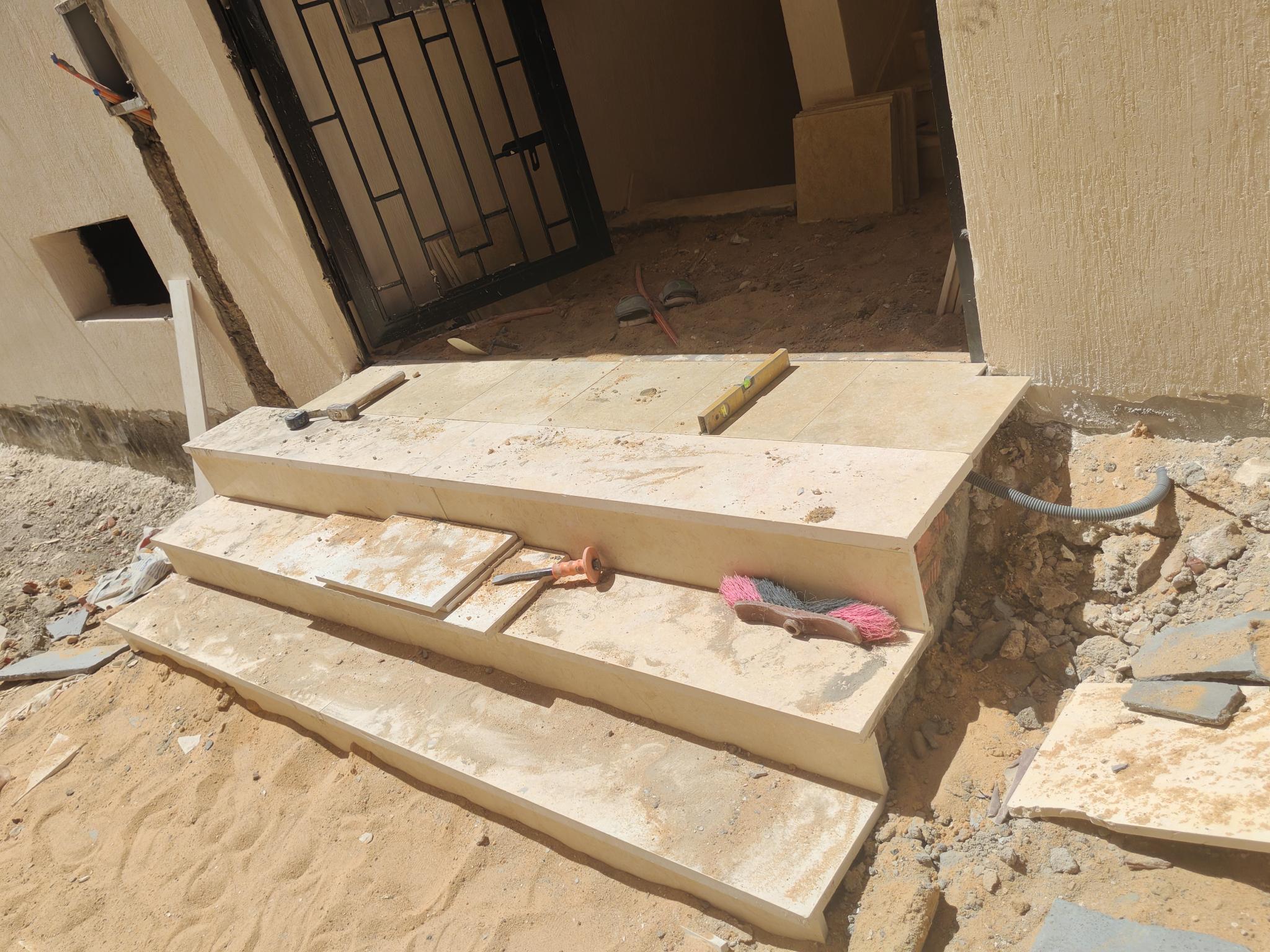

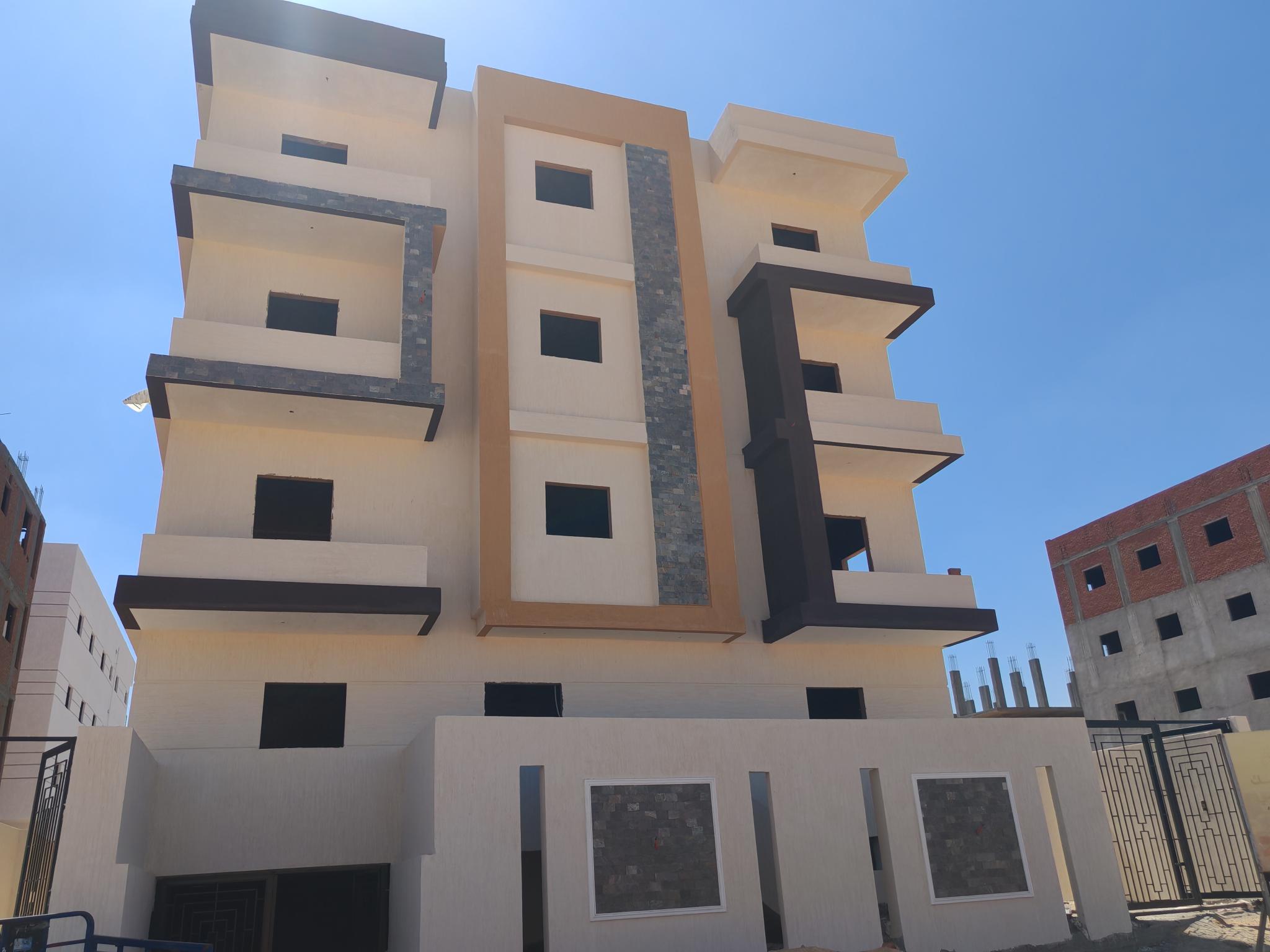

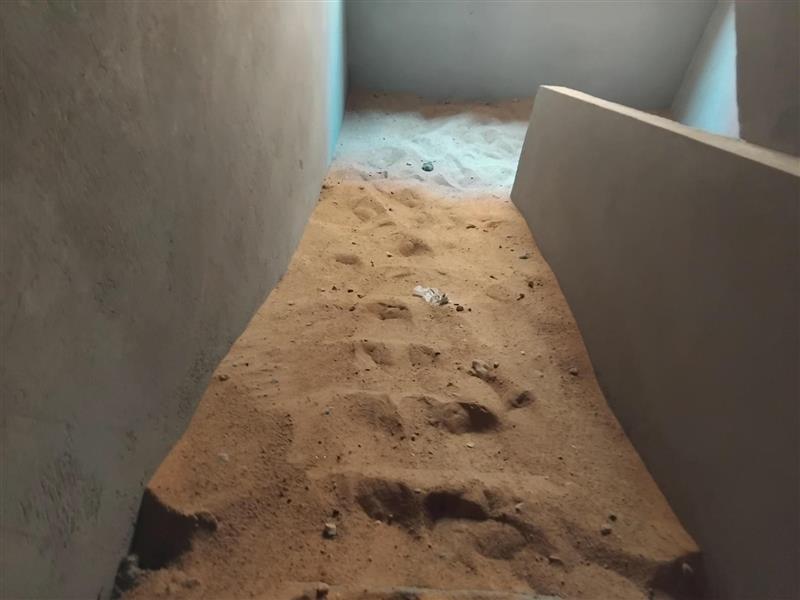

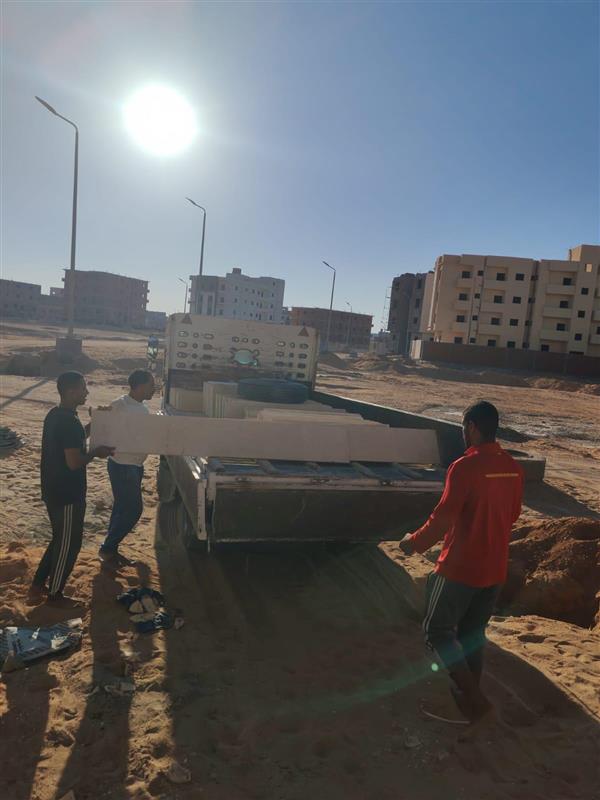

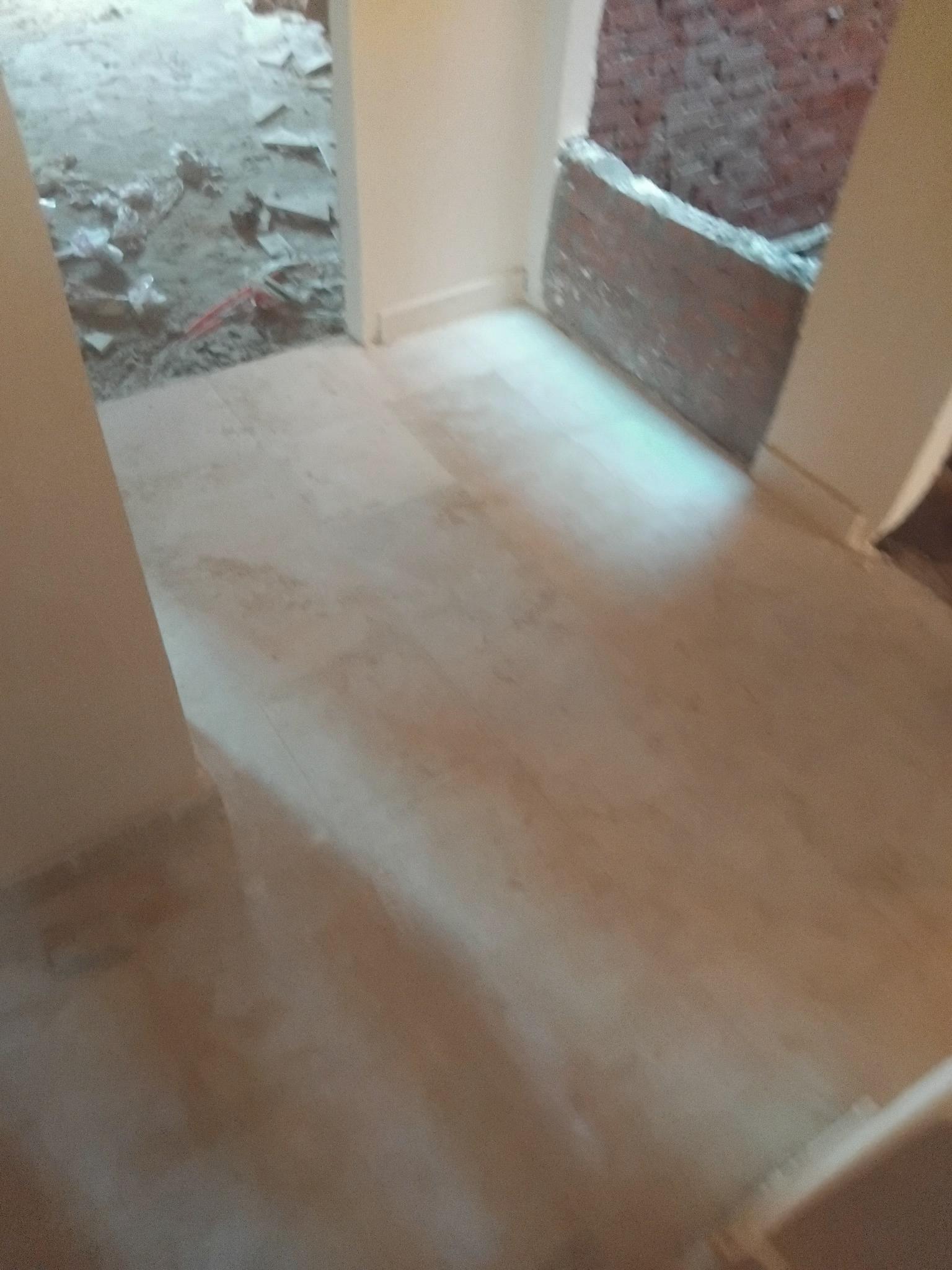

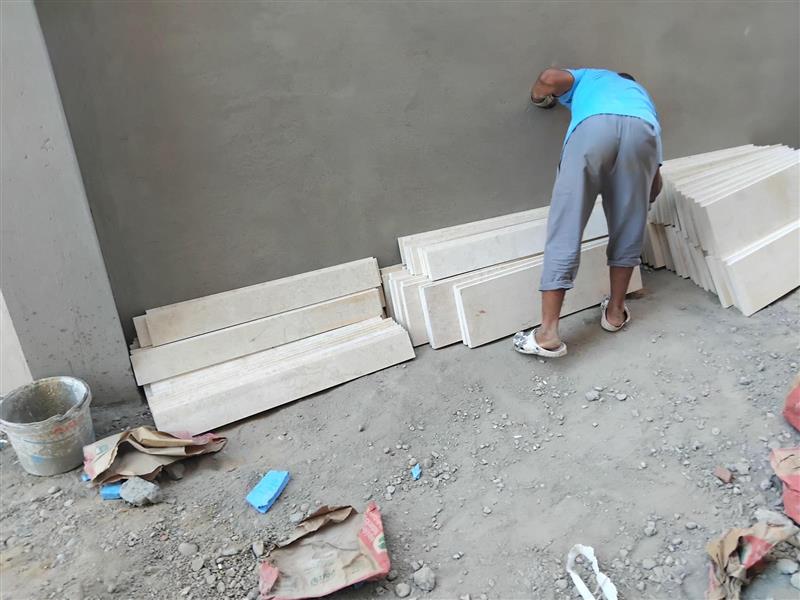

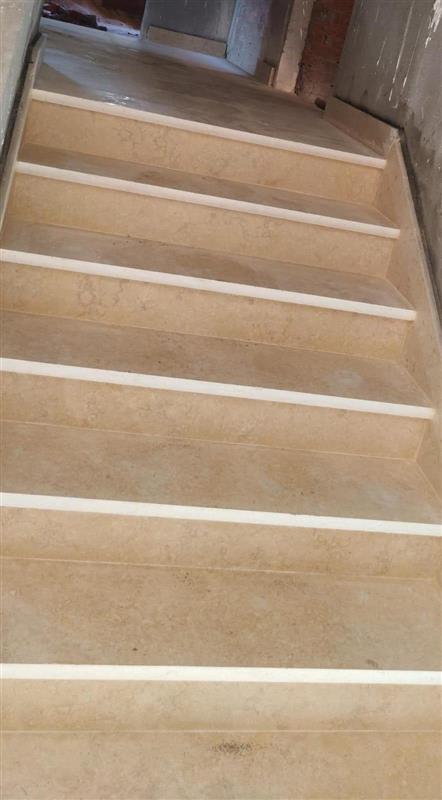

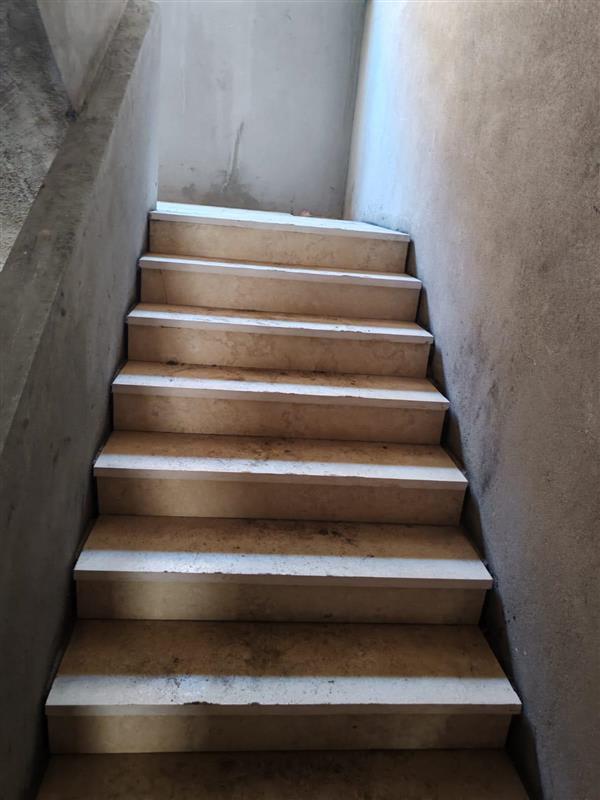

Marble works

August 10, 2025

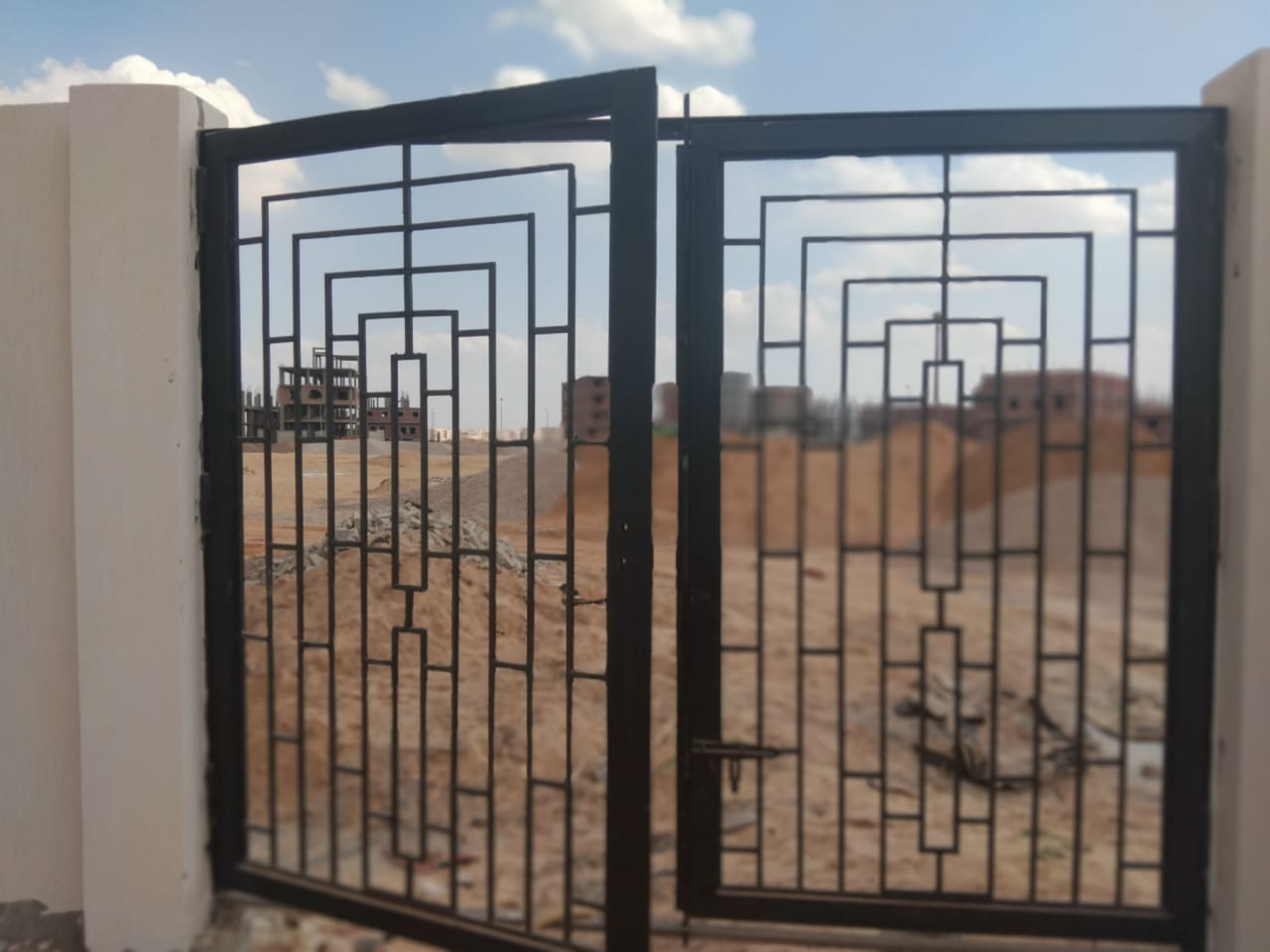

Aluminum & glass works (Krital)

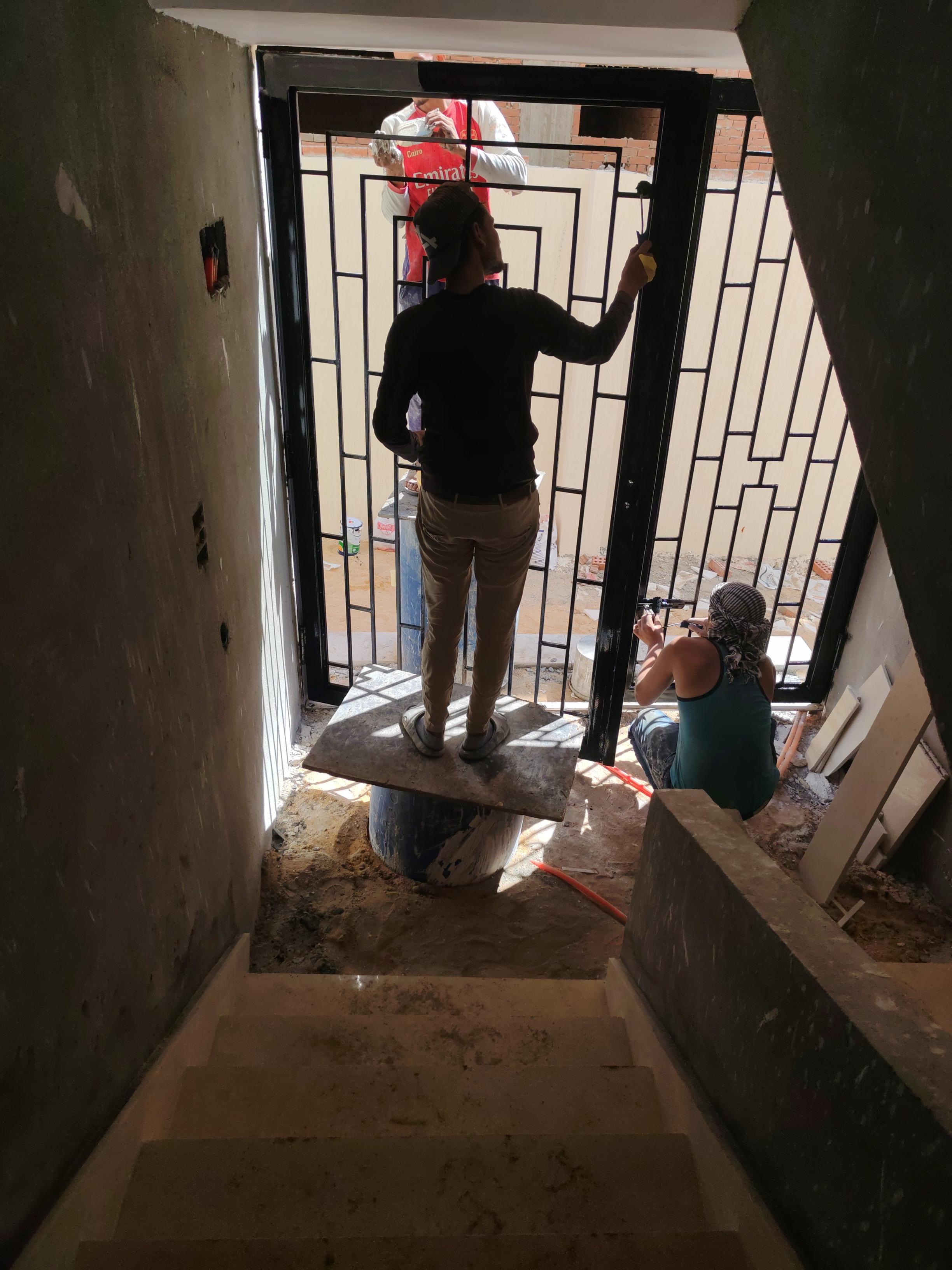

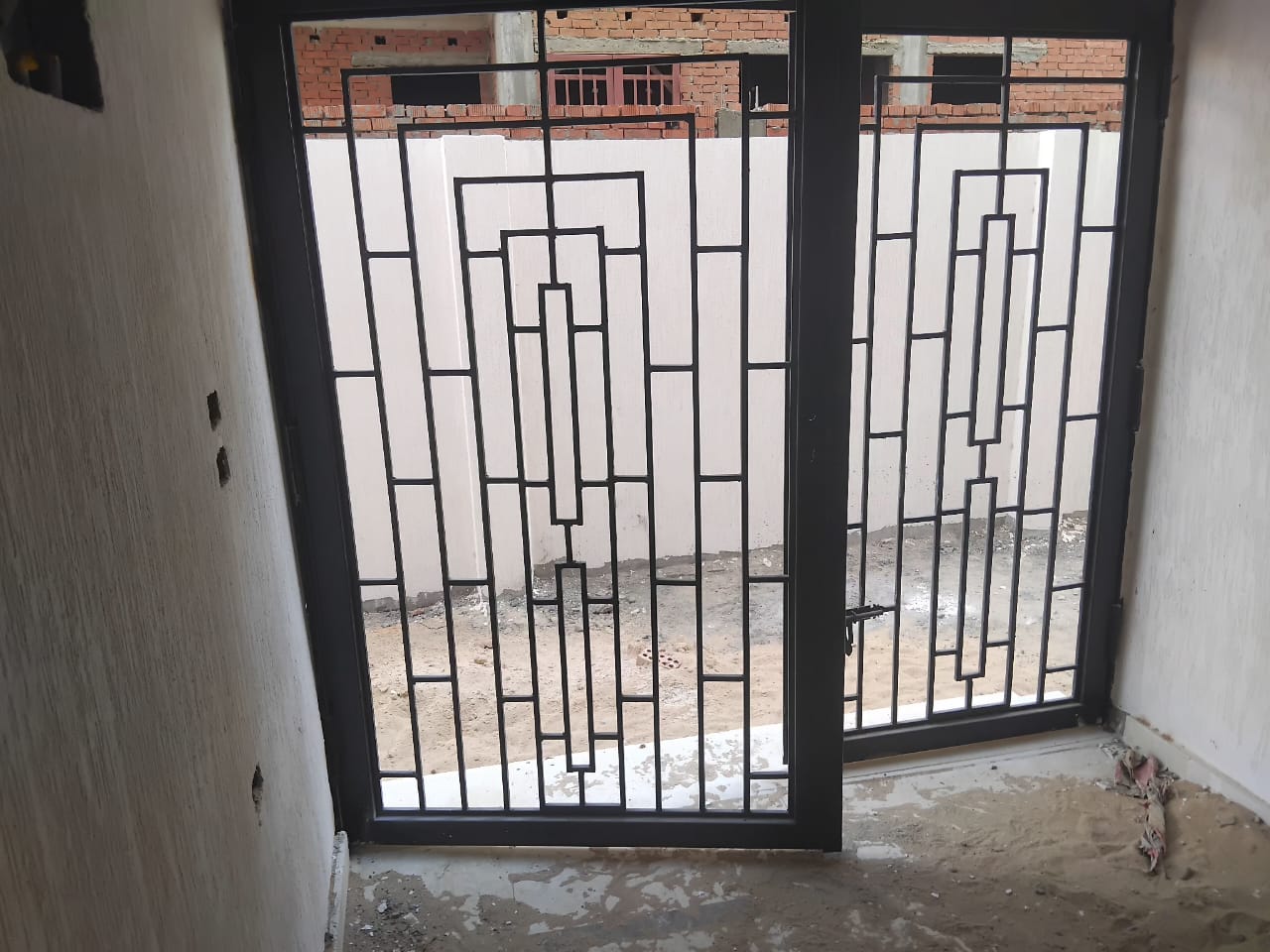

August 11, 2025
Elevator
August 12, 2025
Project handover to the authority
August 15, 2025
Utilities meter installation
August 30, 2025
